Production Update – Assembly 1

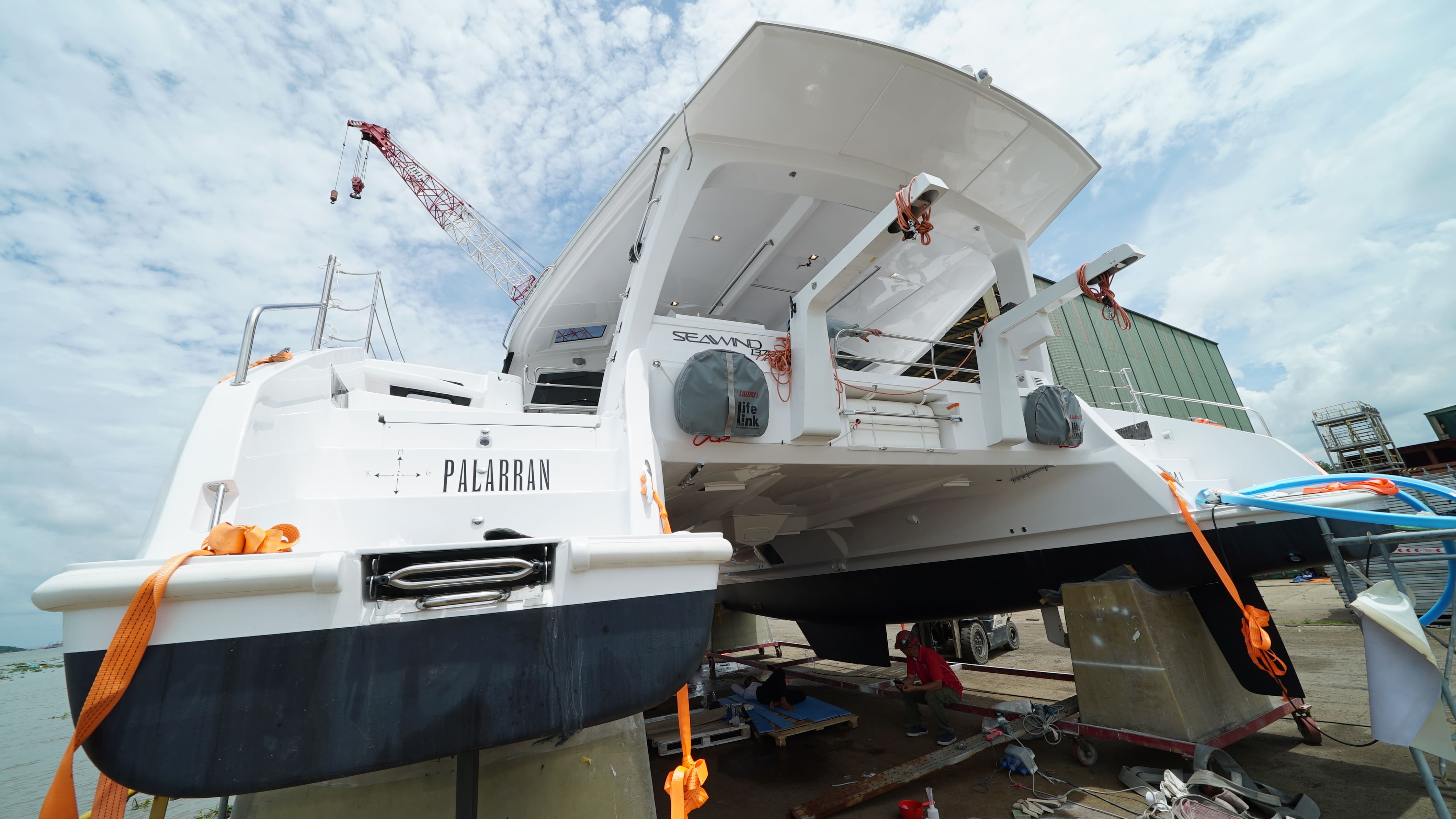

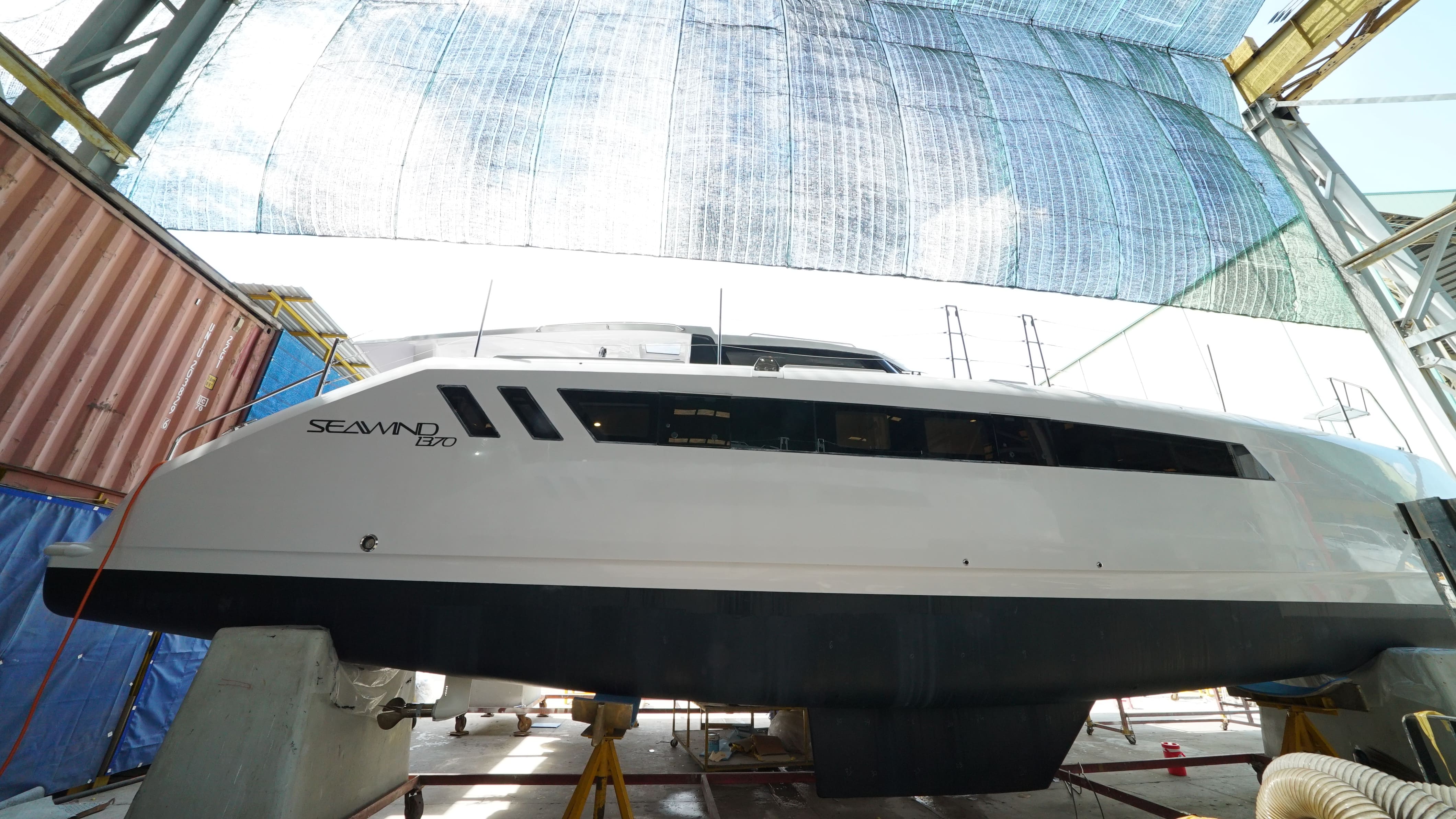

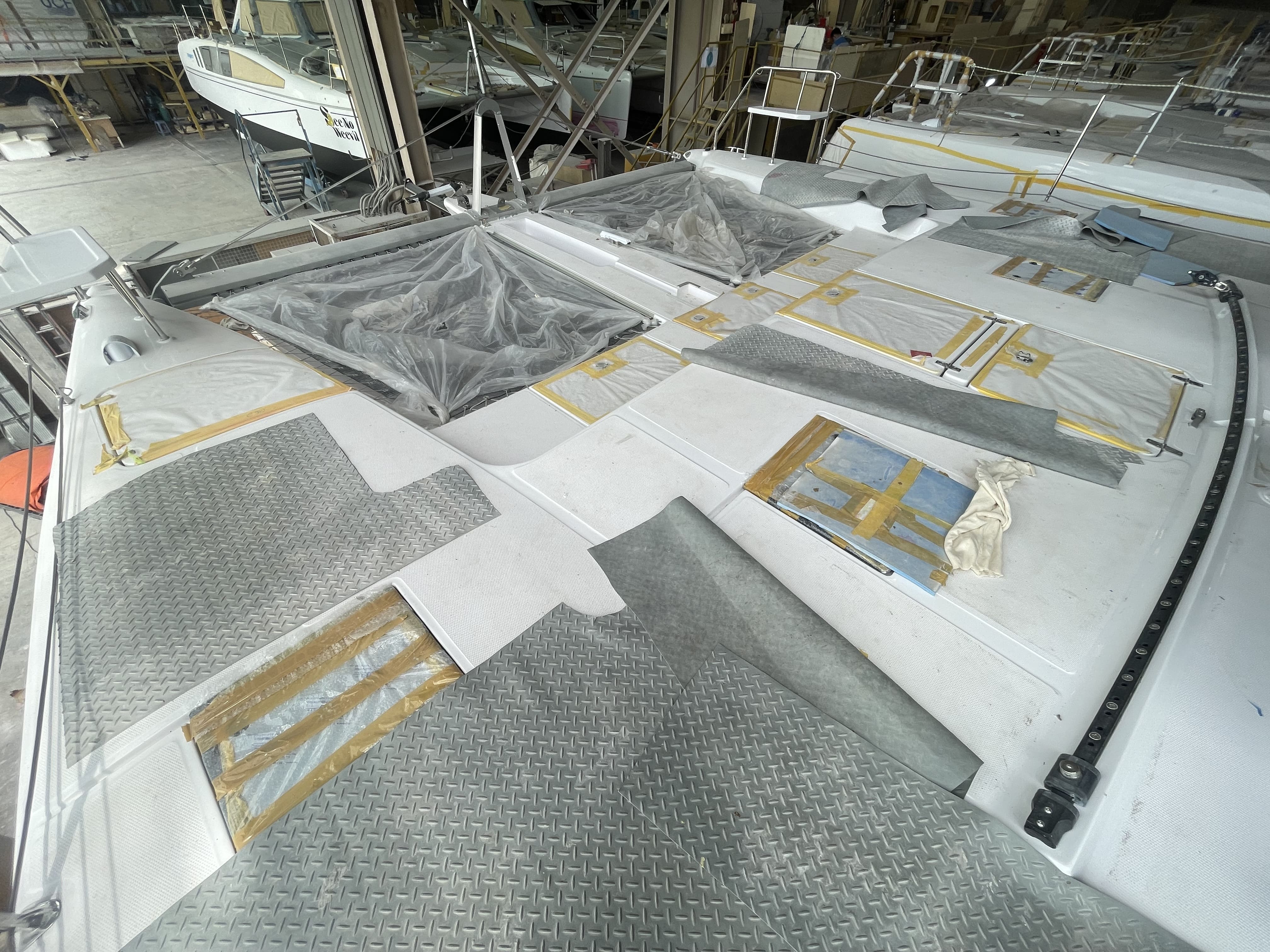

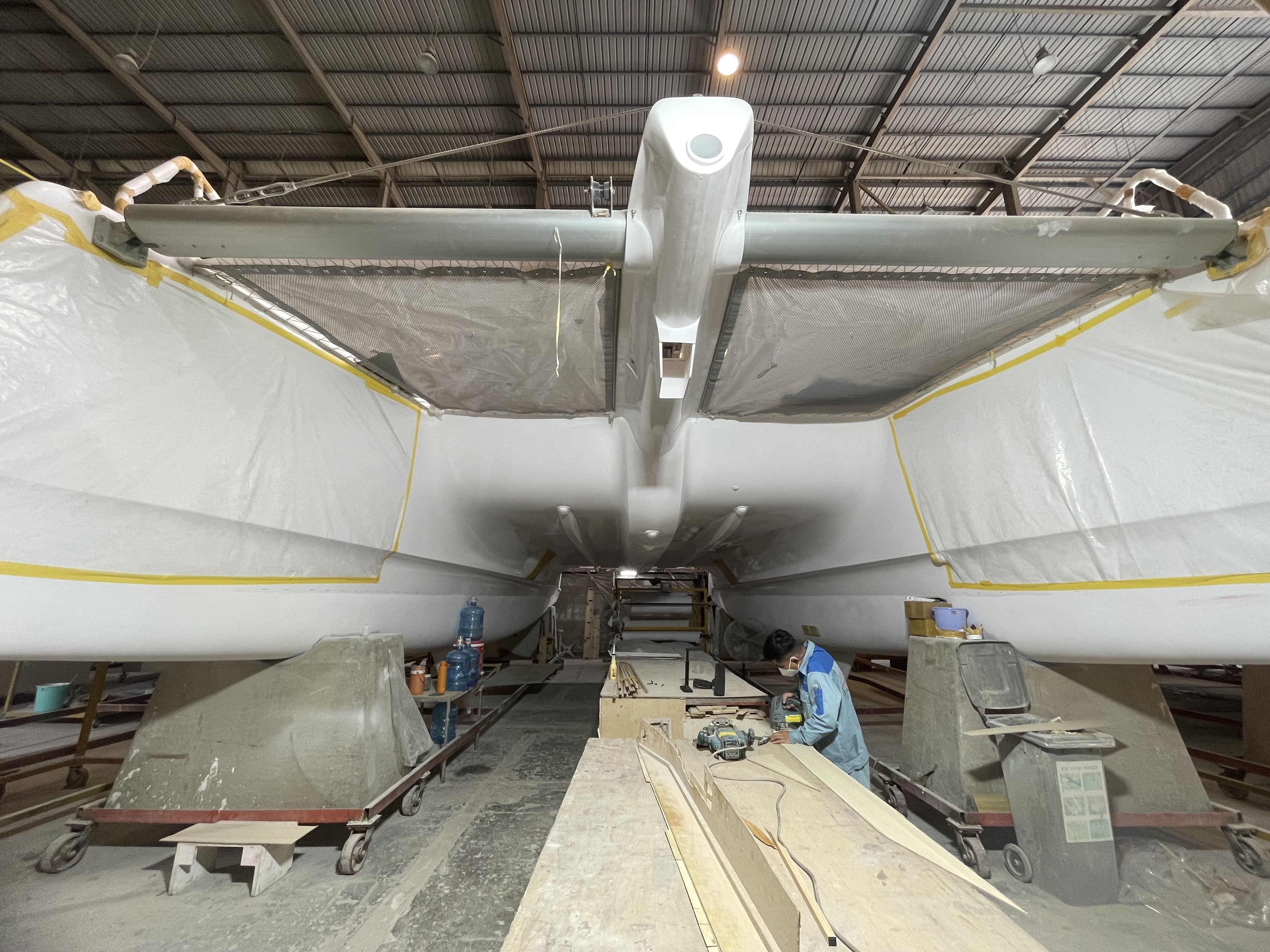

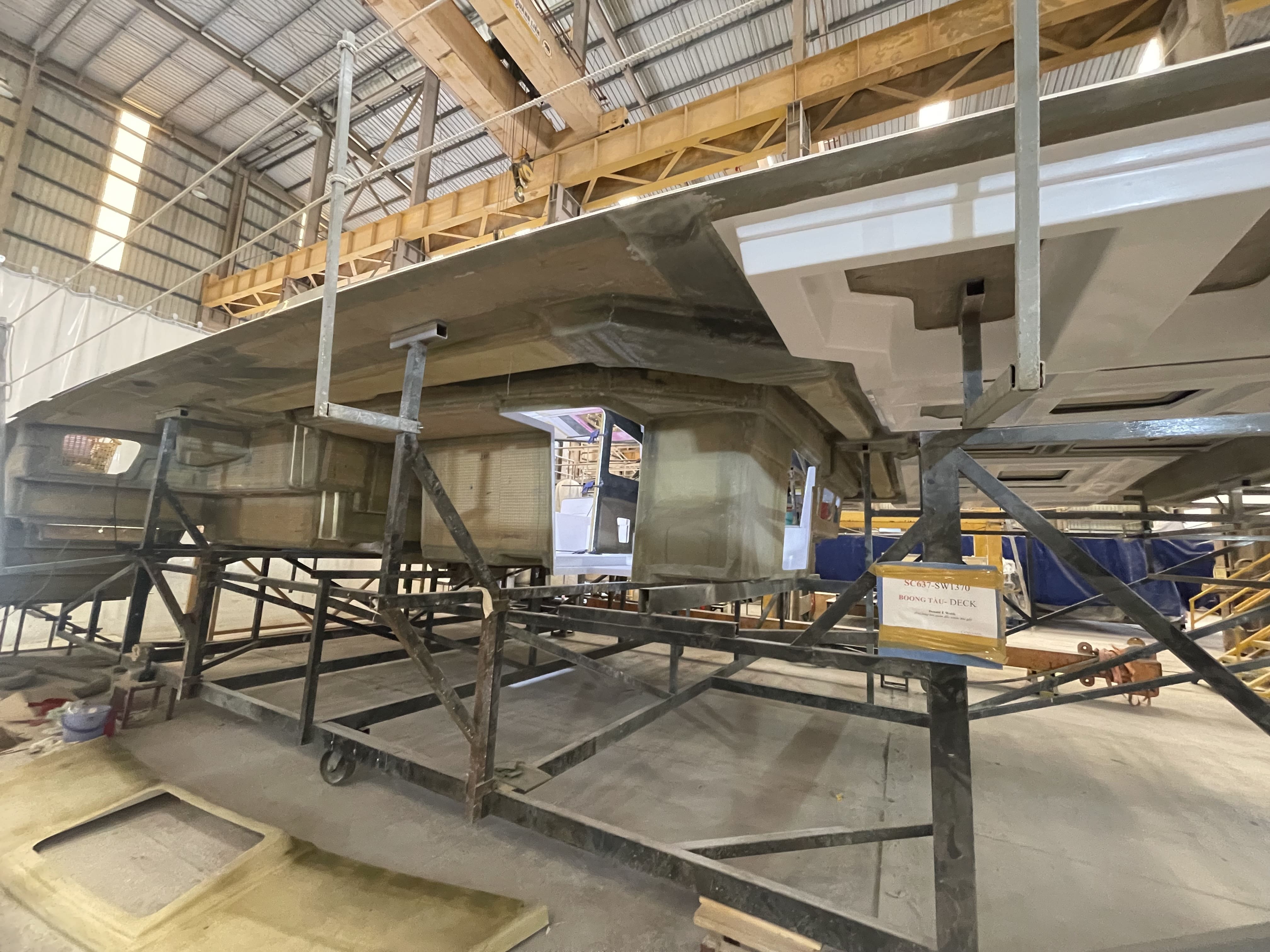

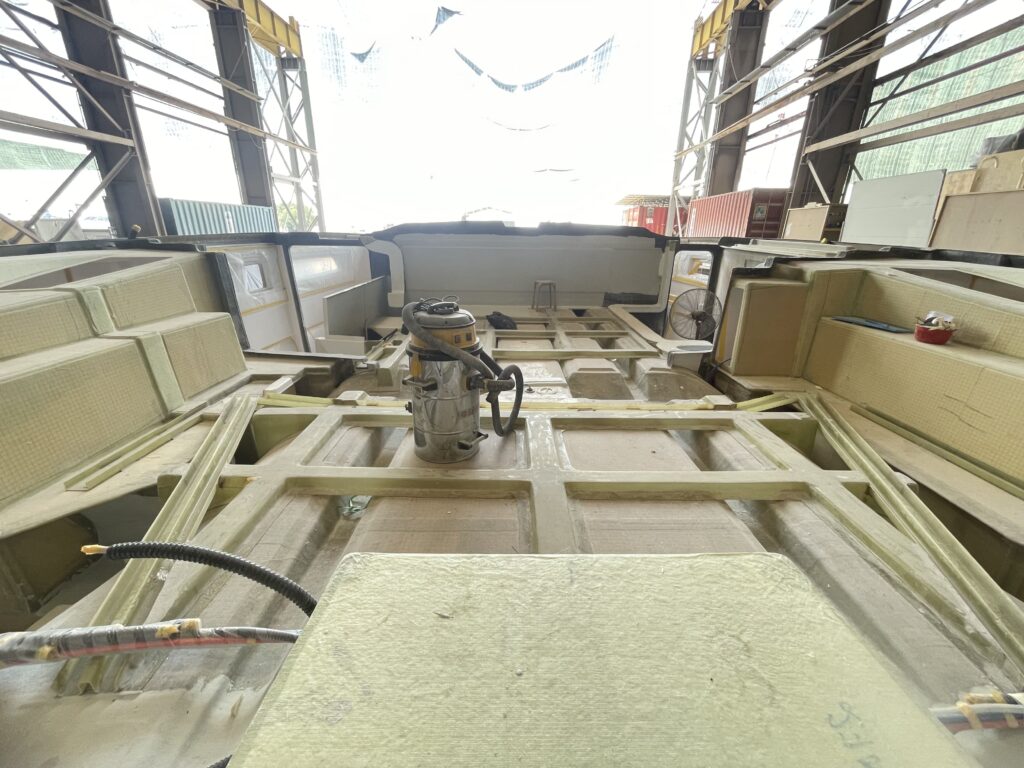

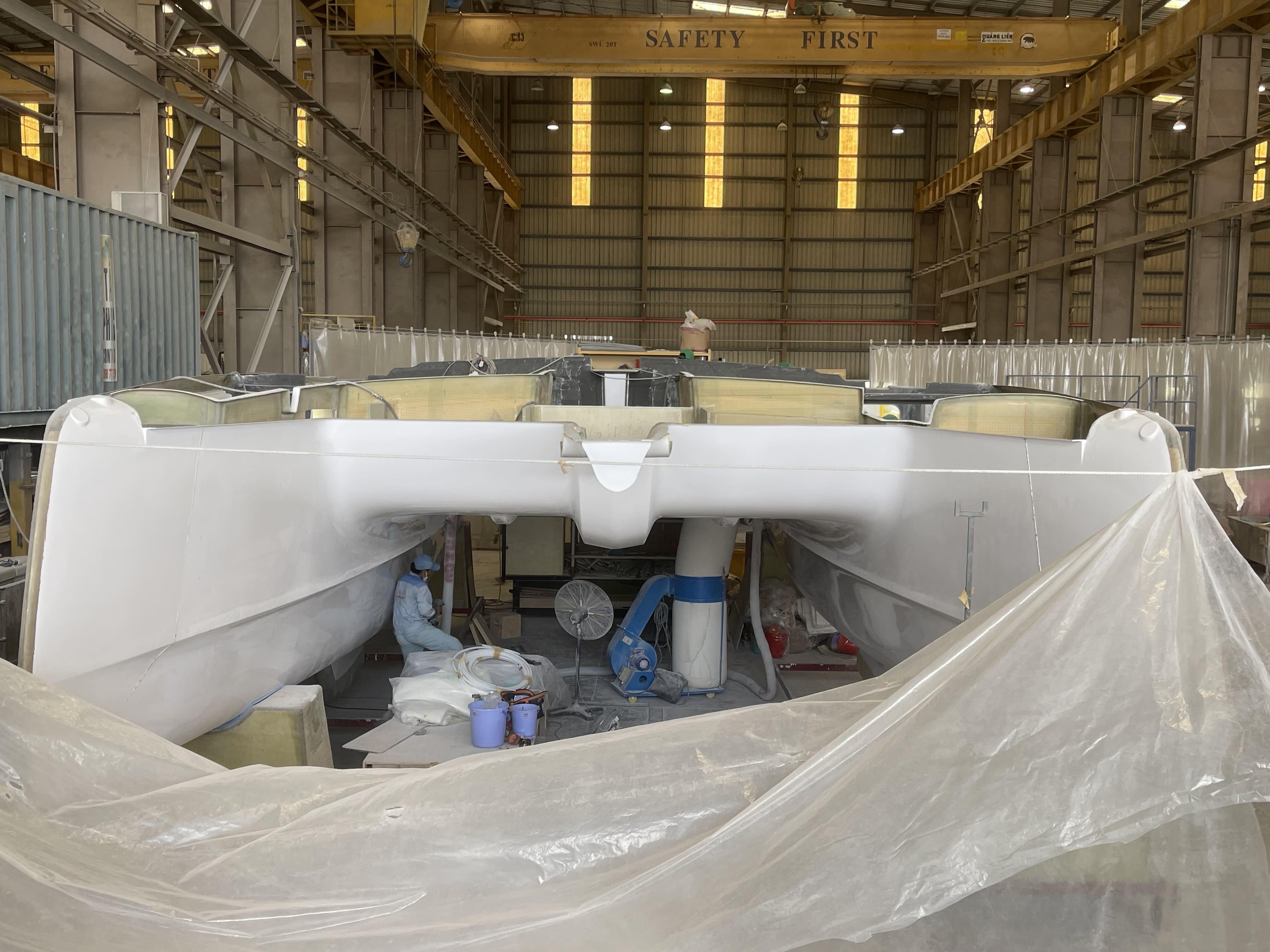

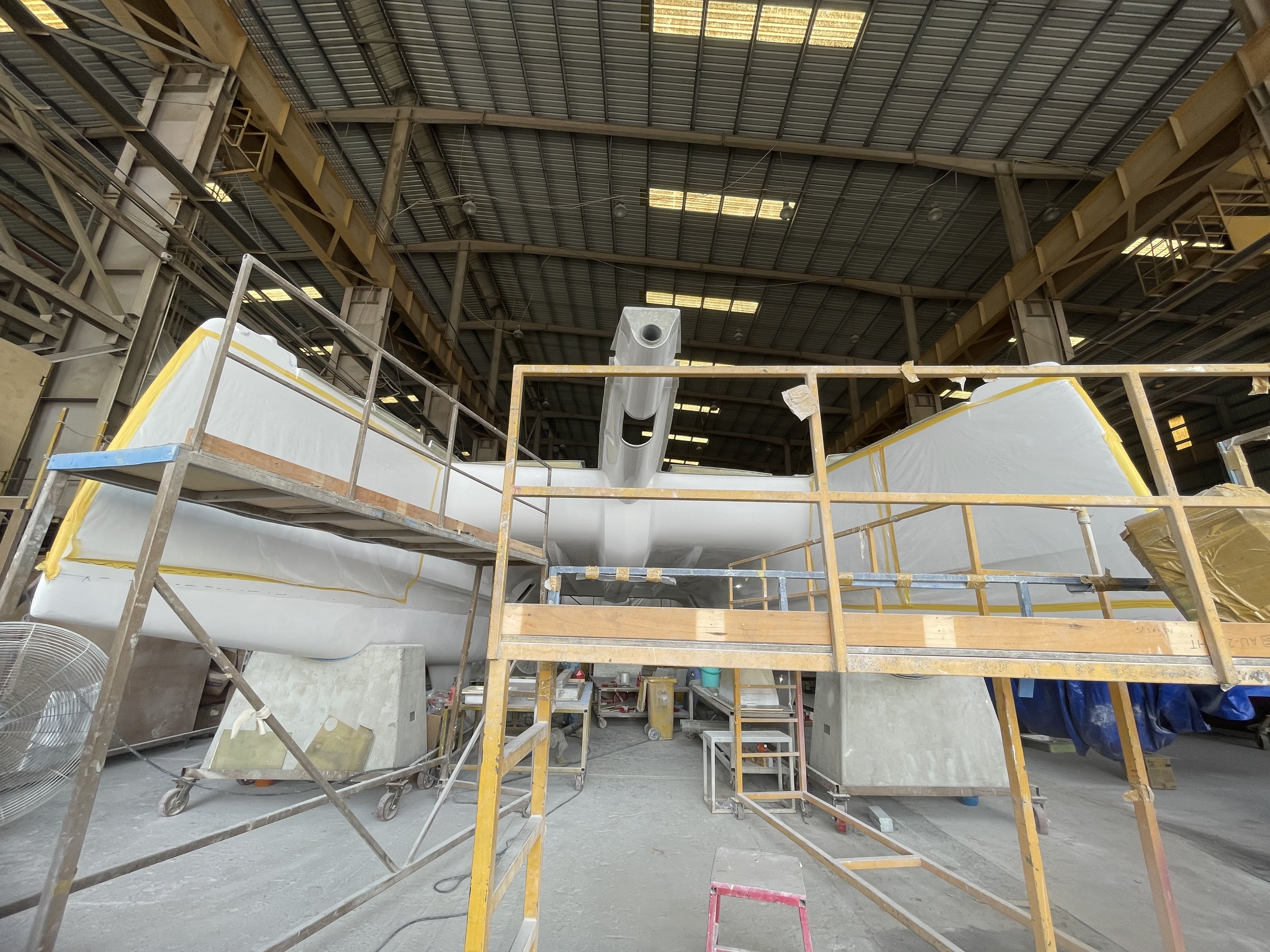

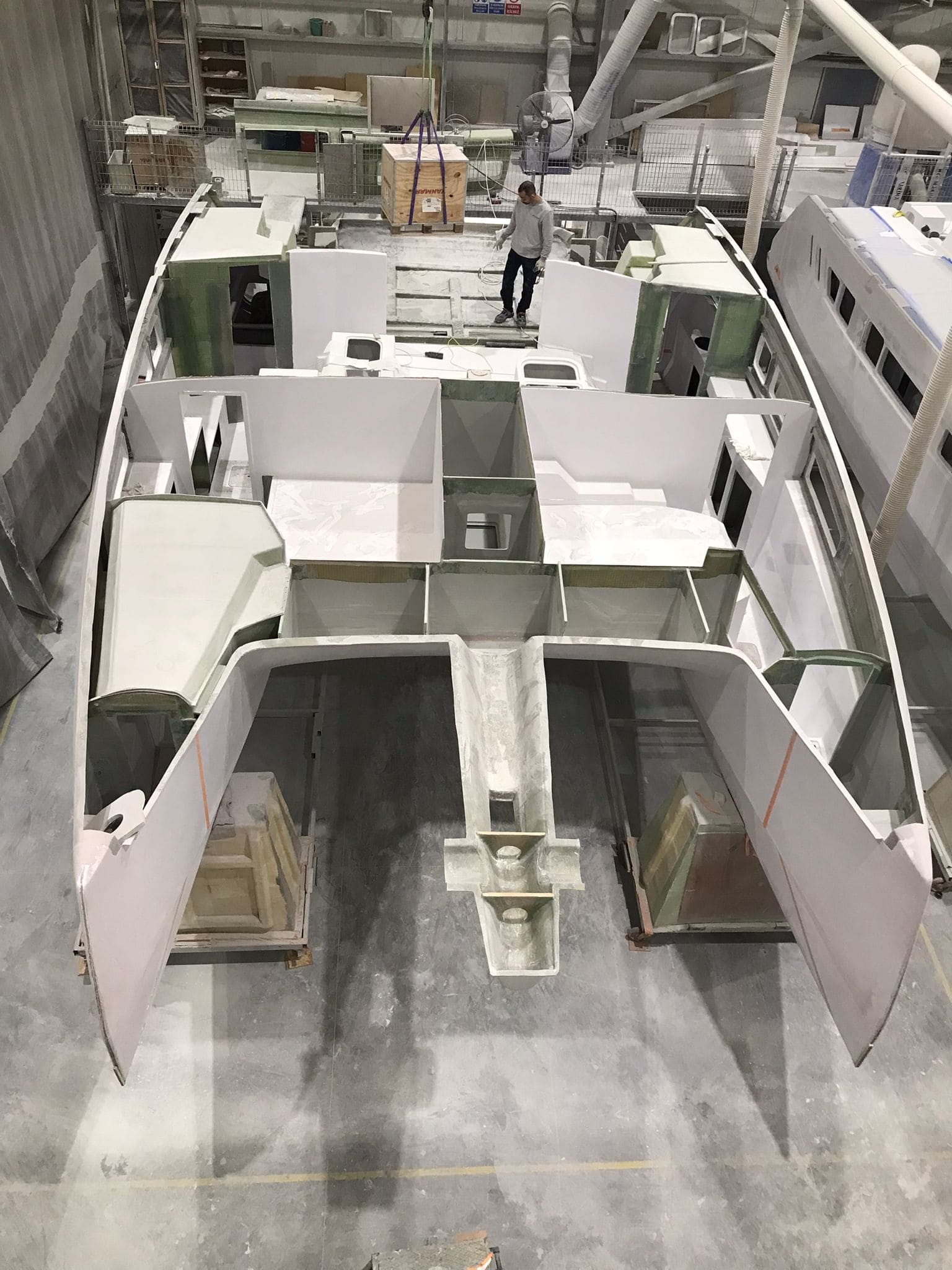

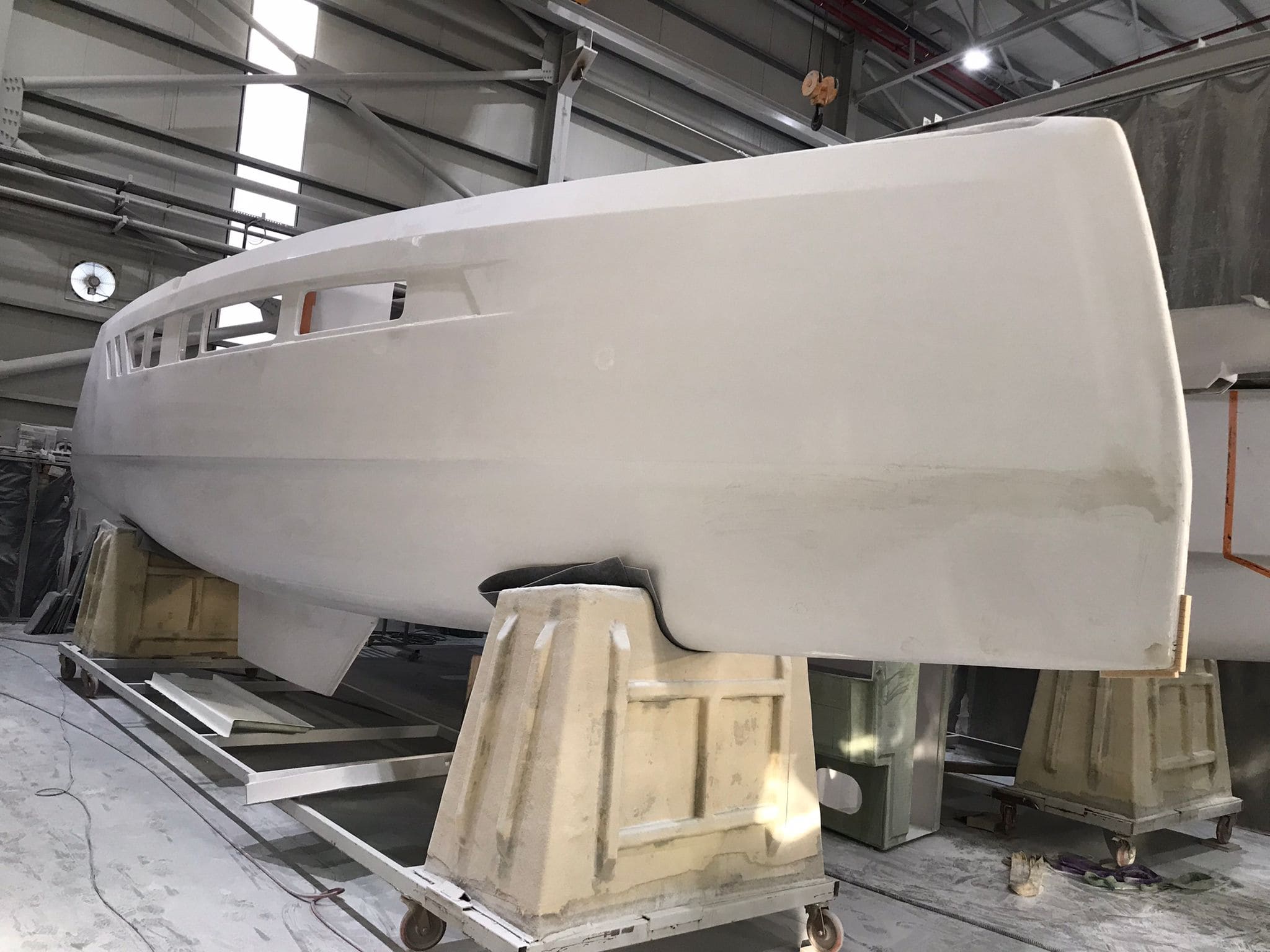

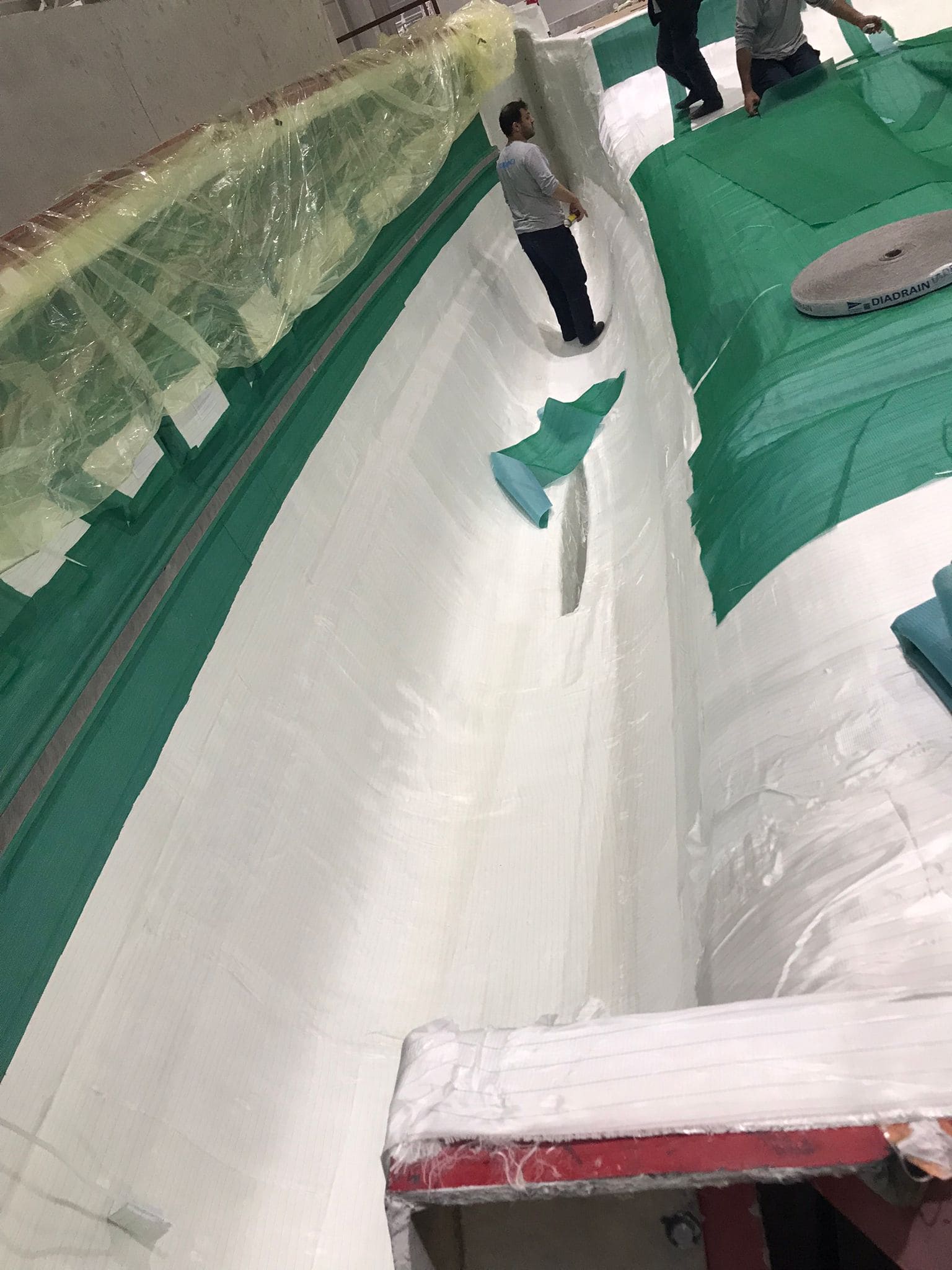

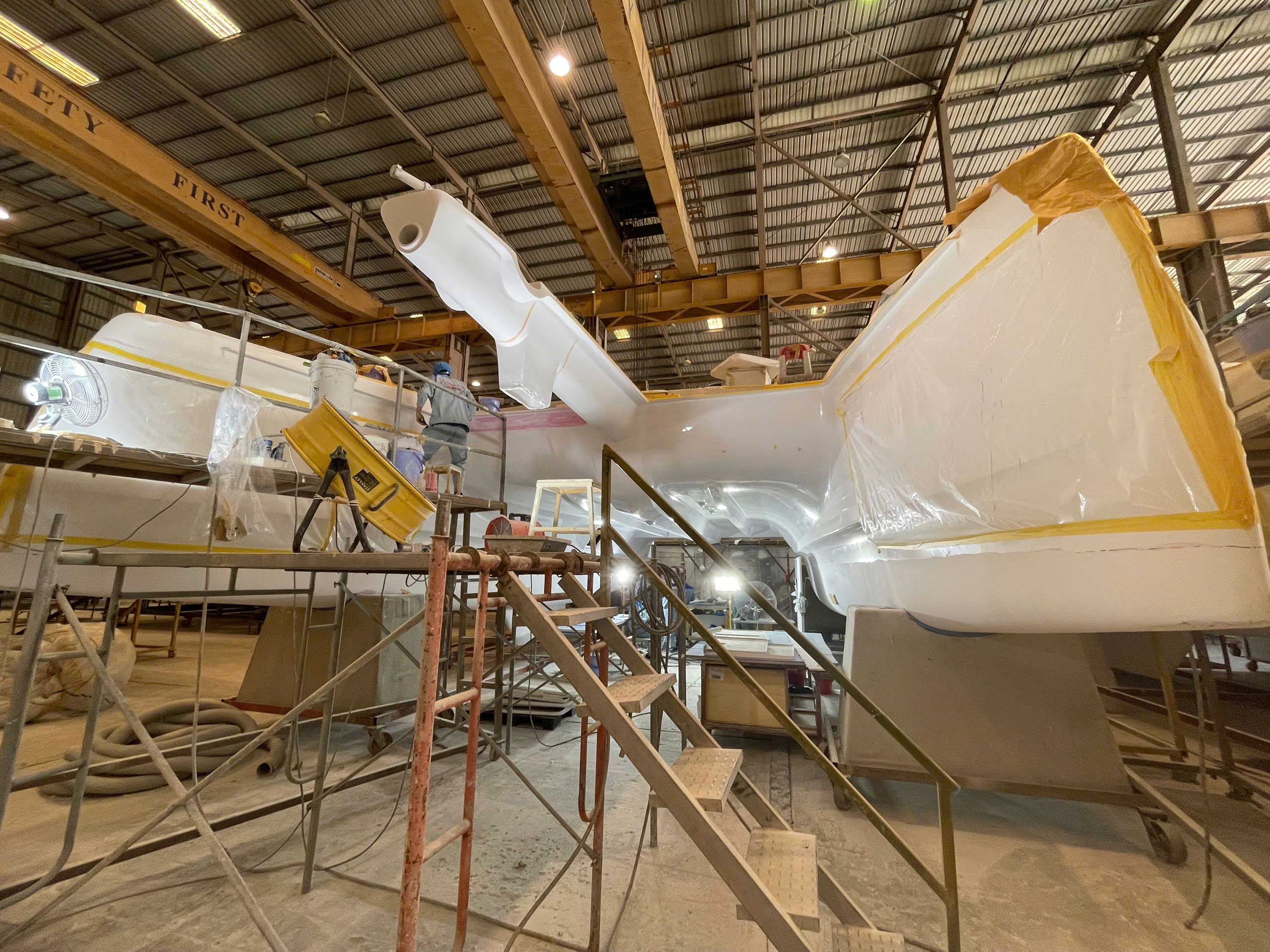

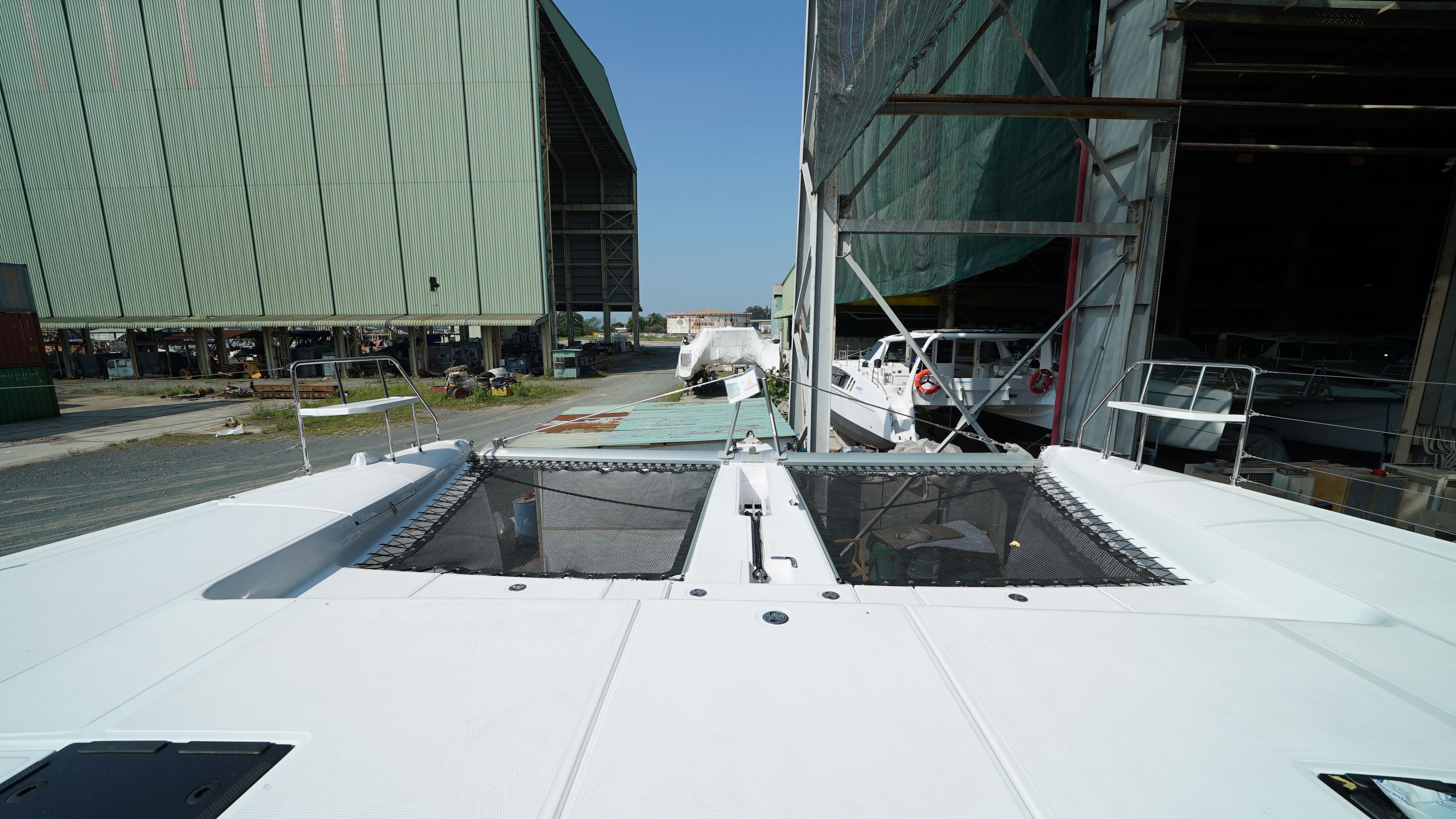

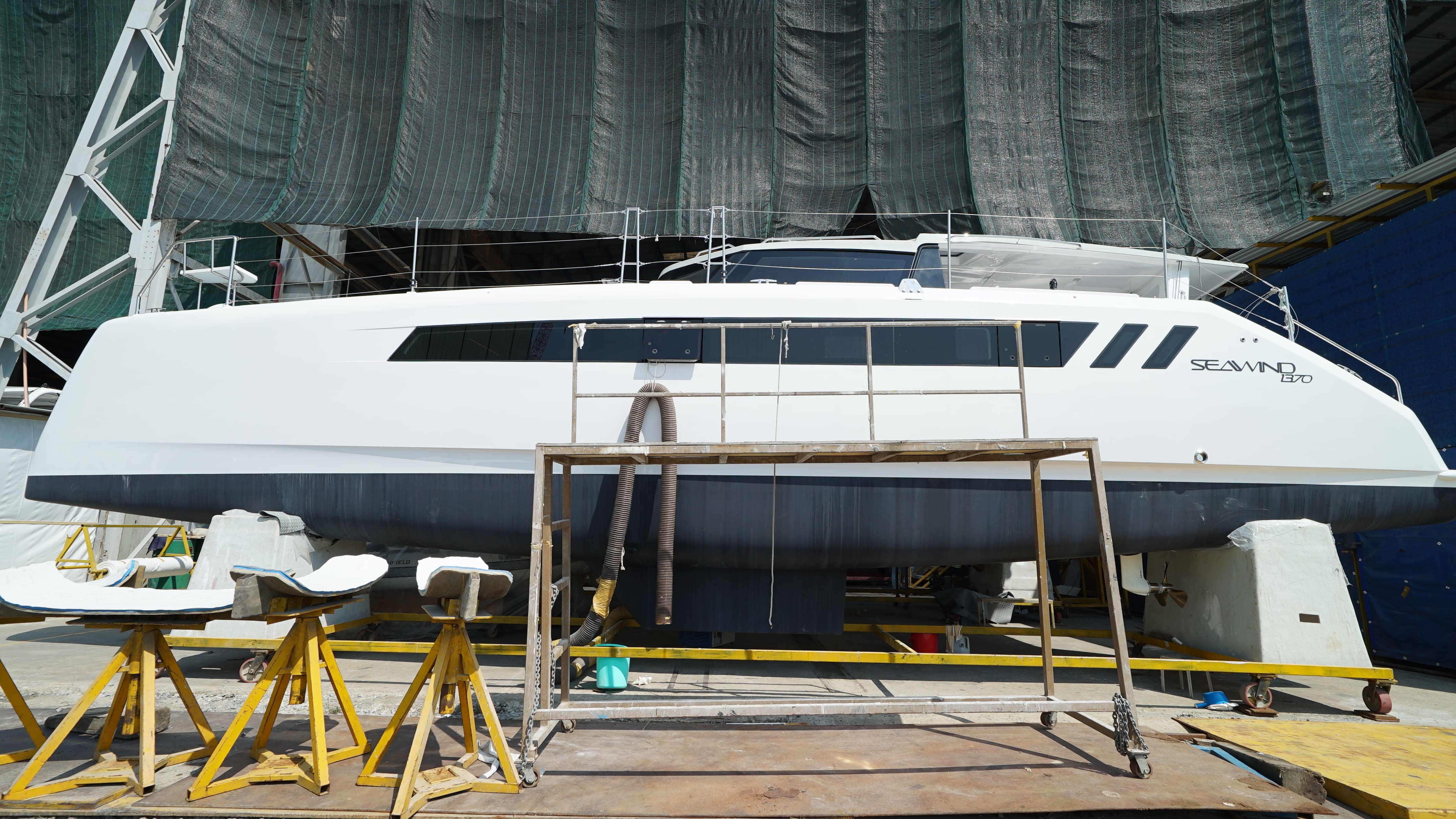

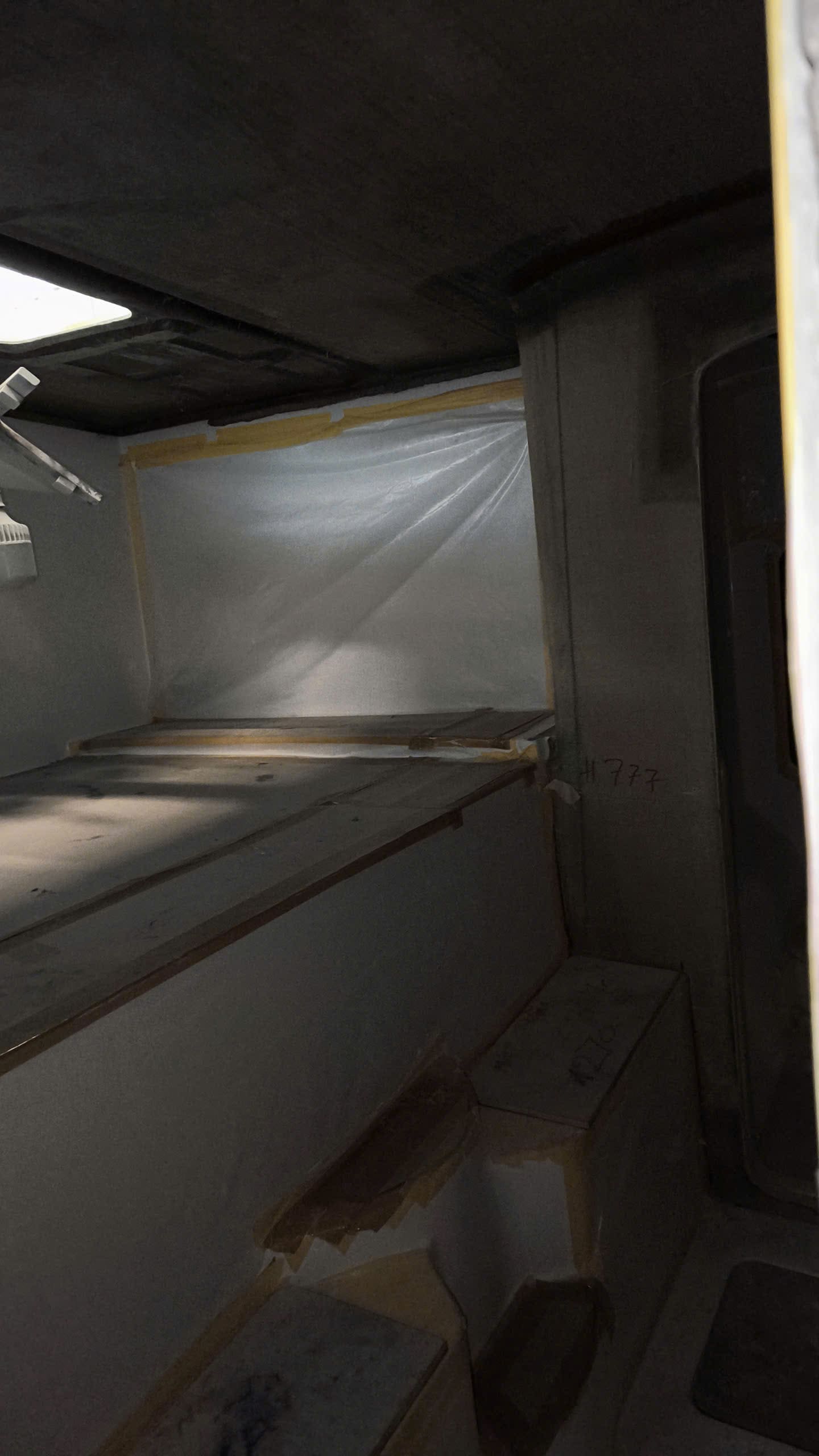

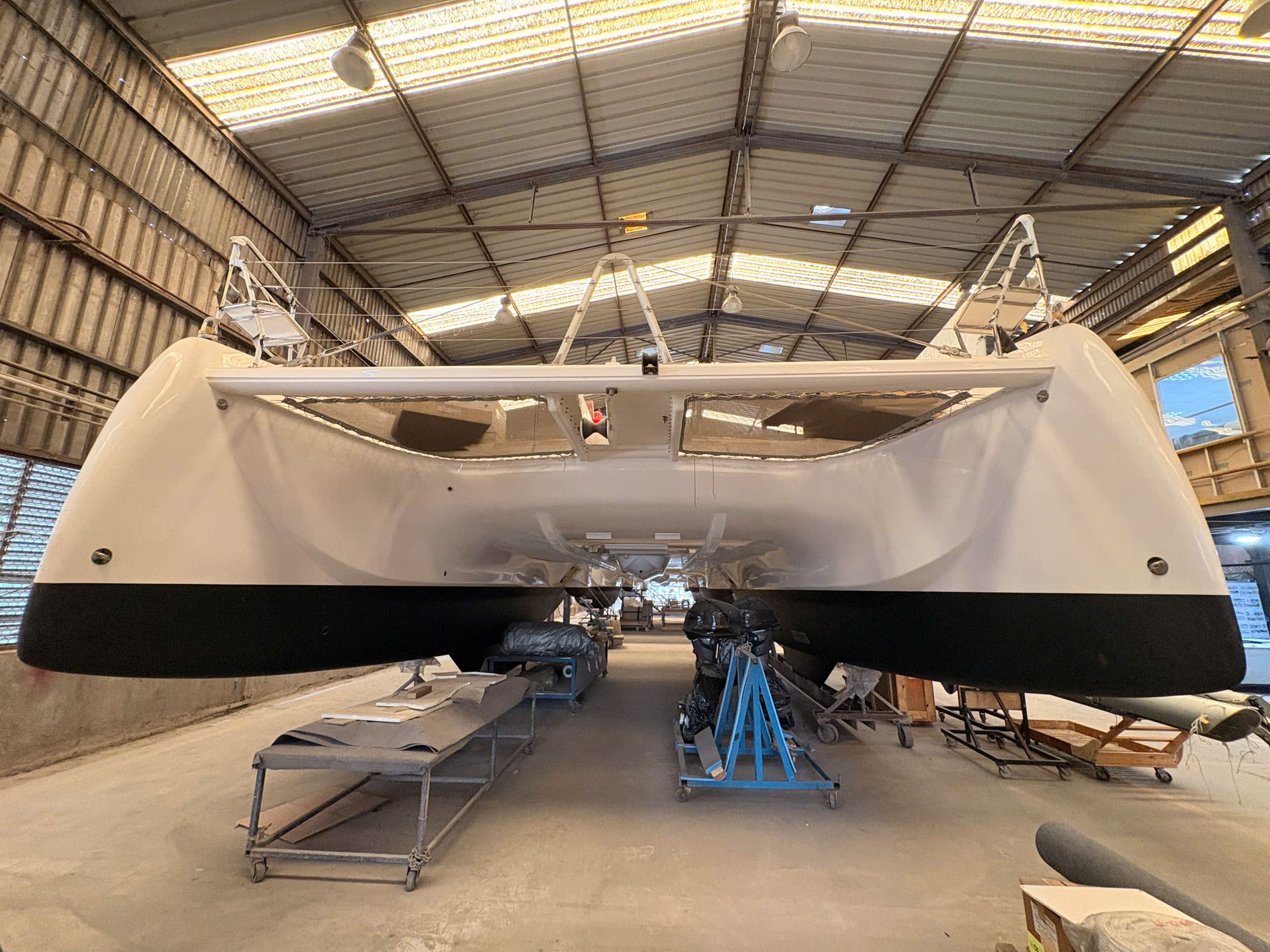

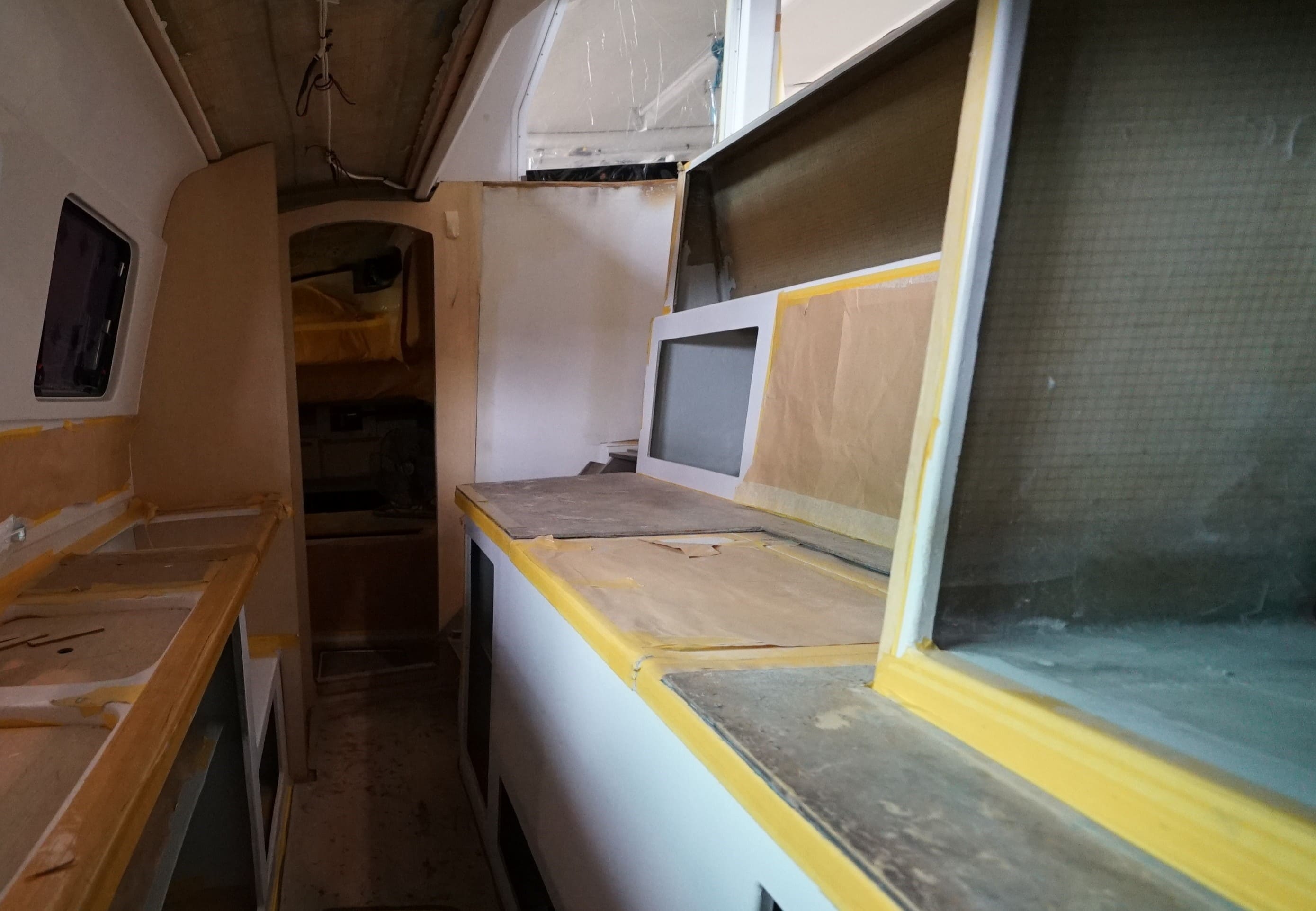

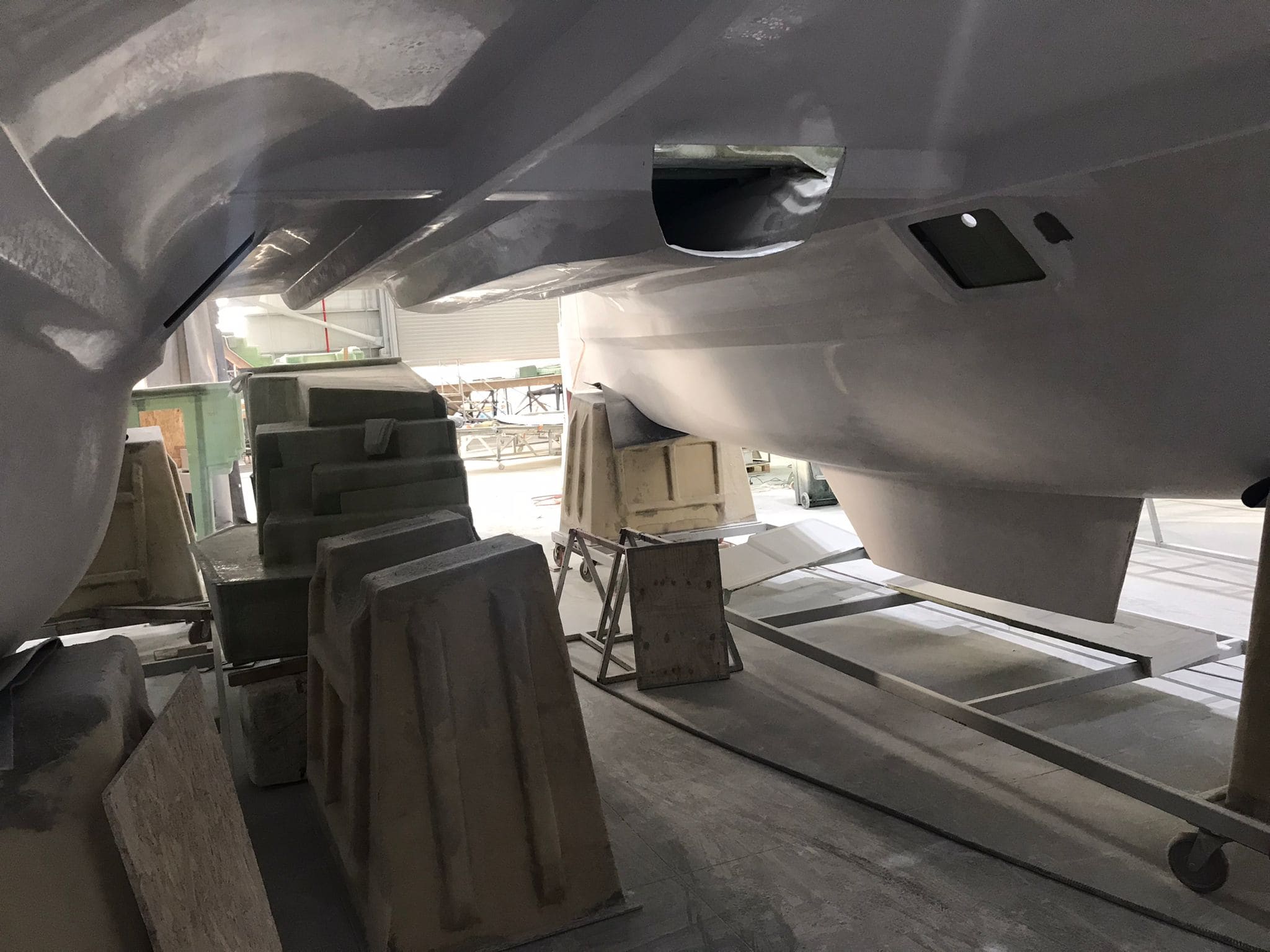

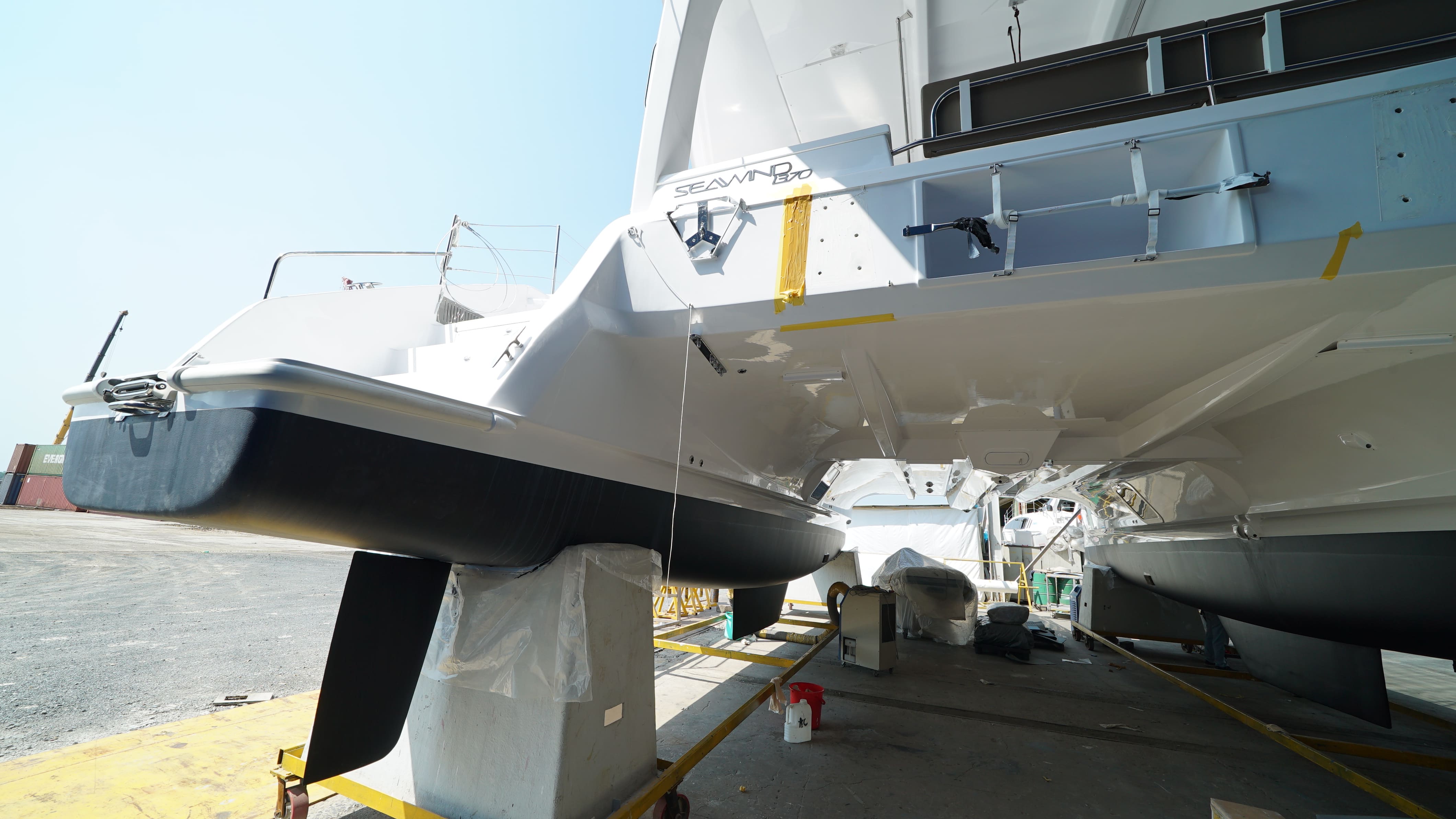

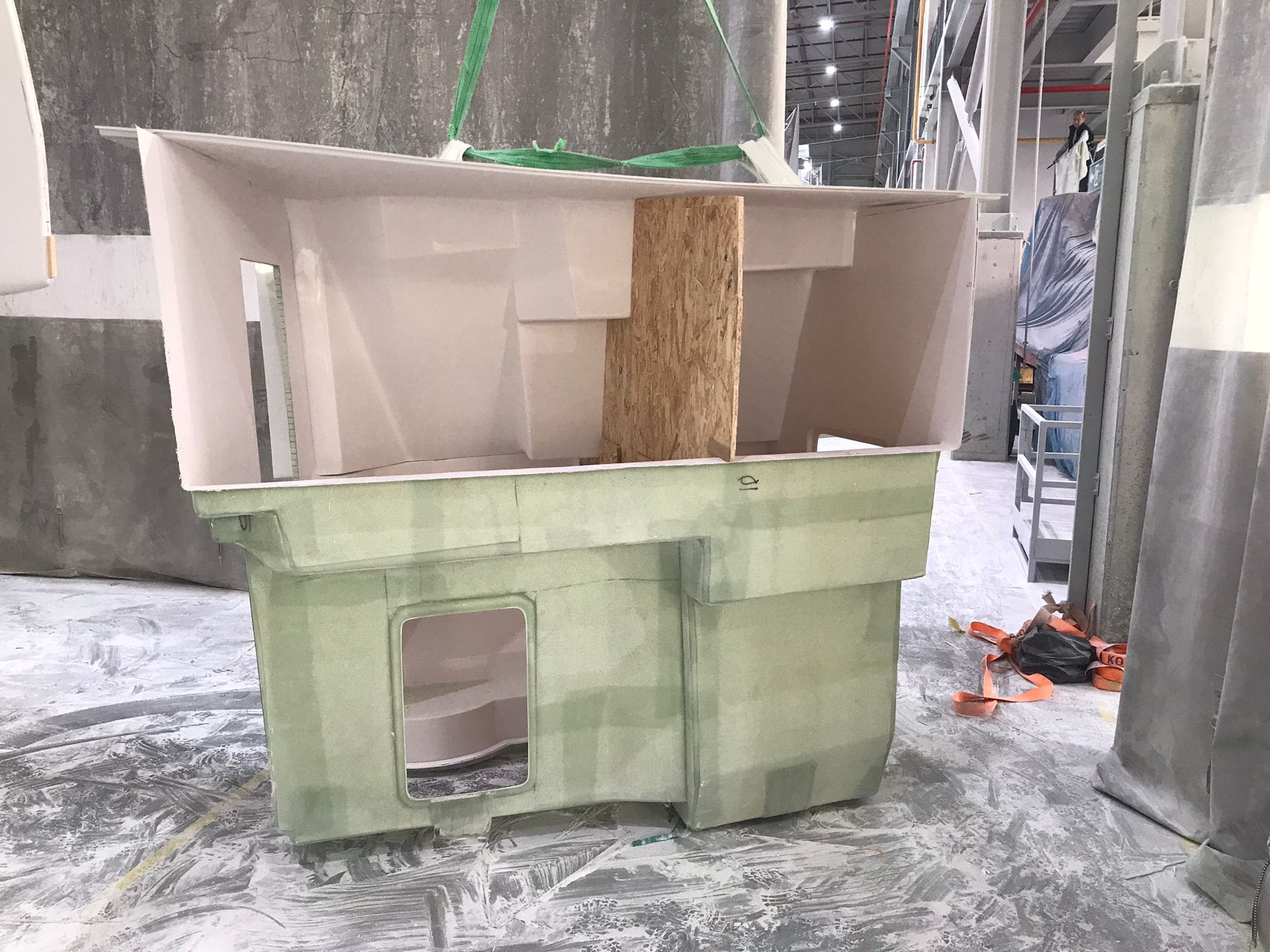

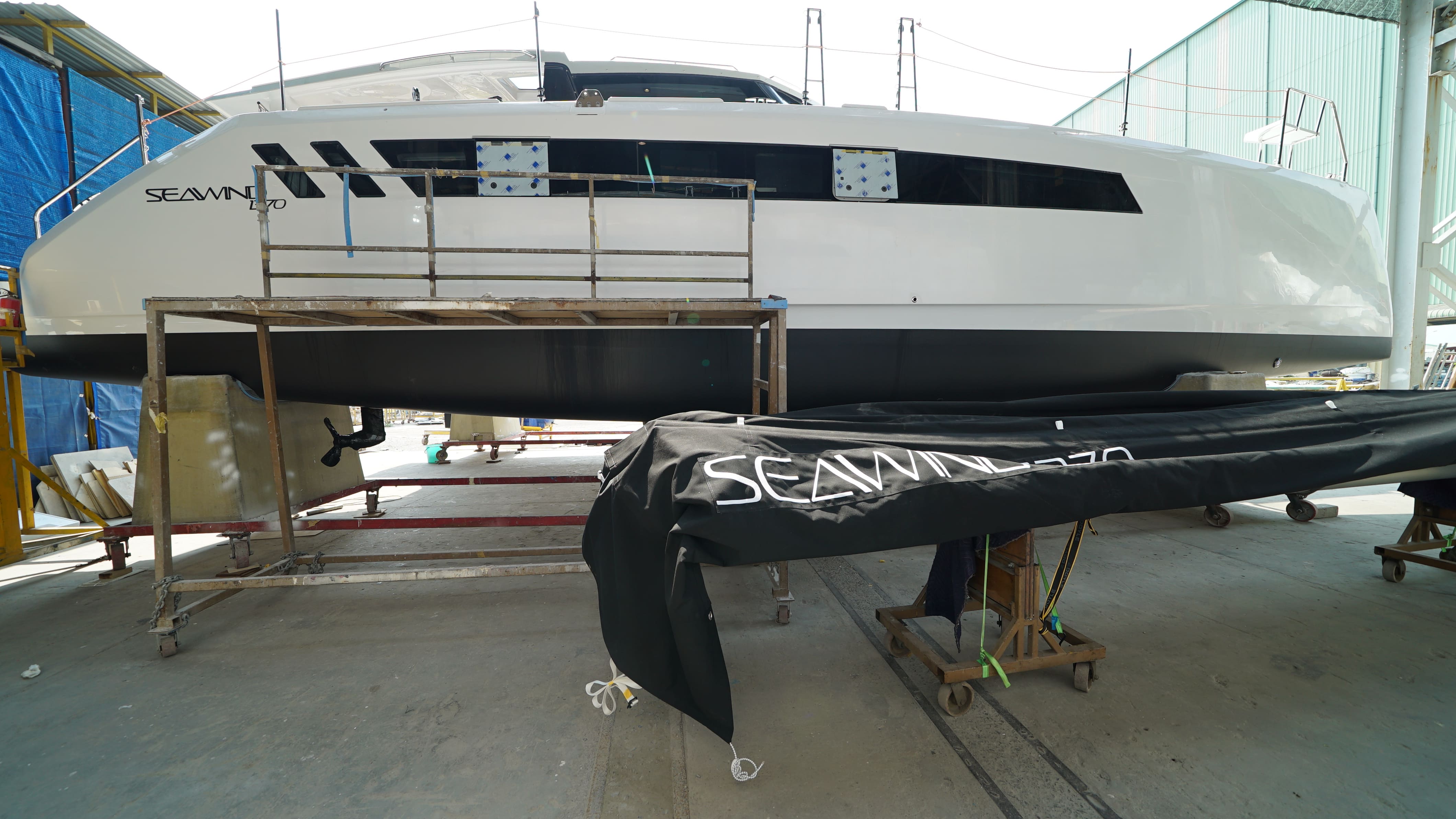

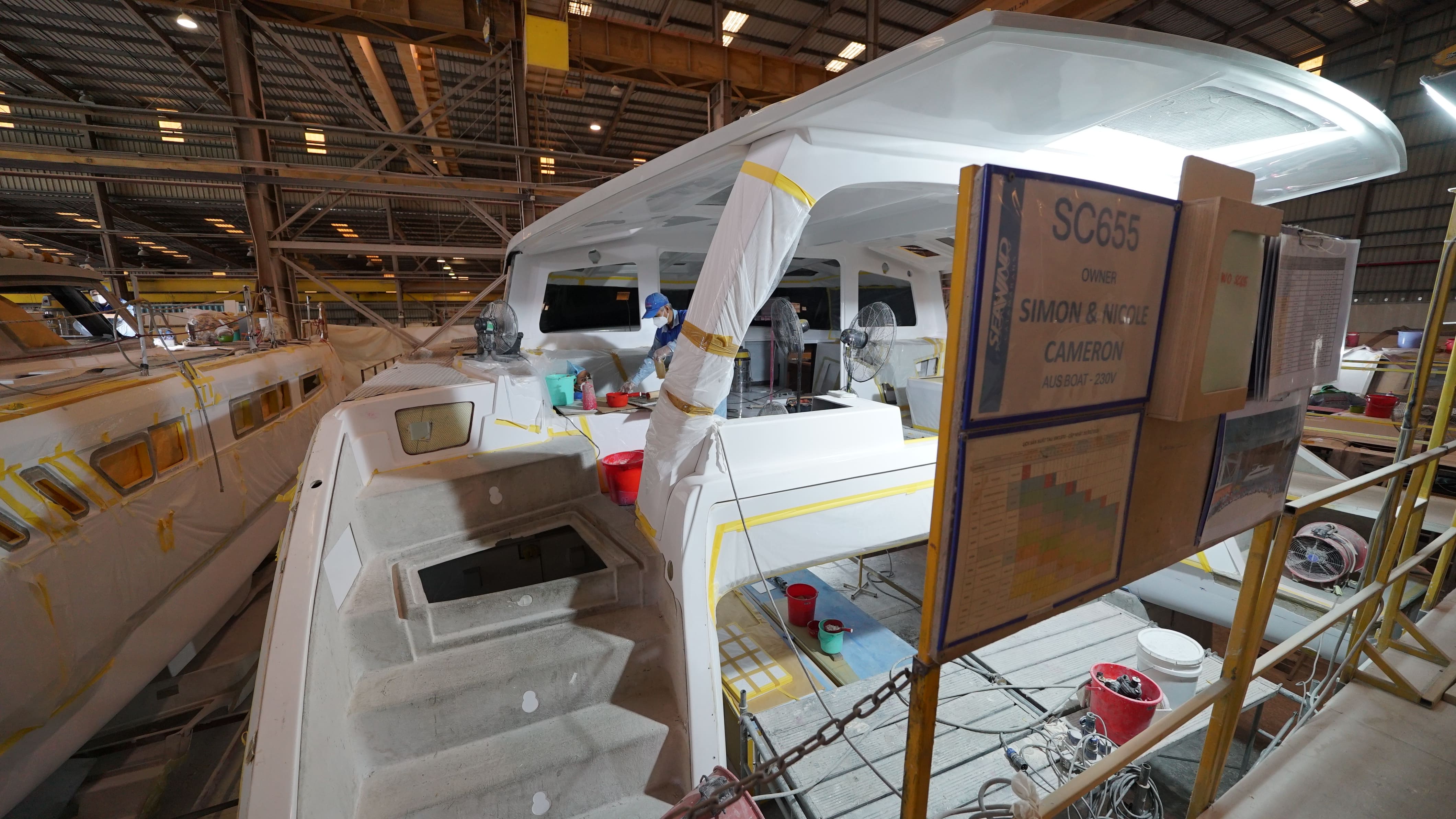

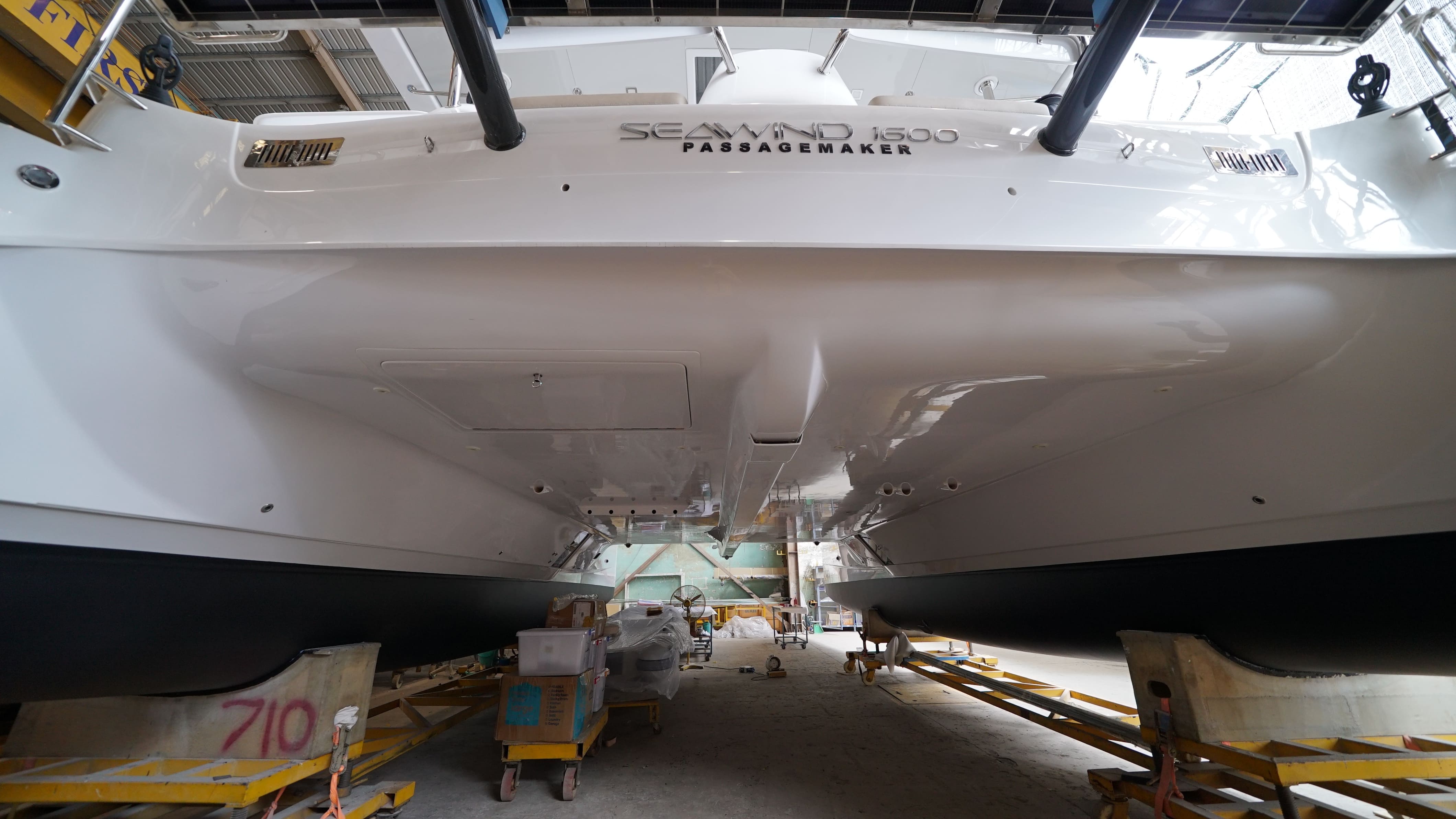

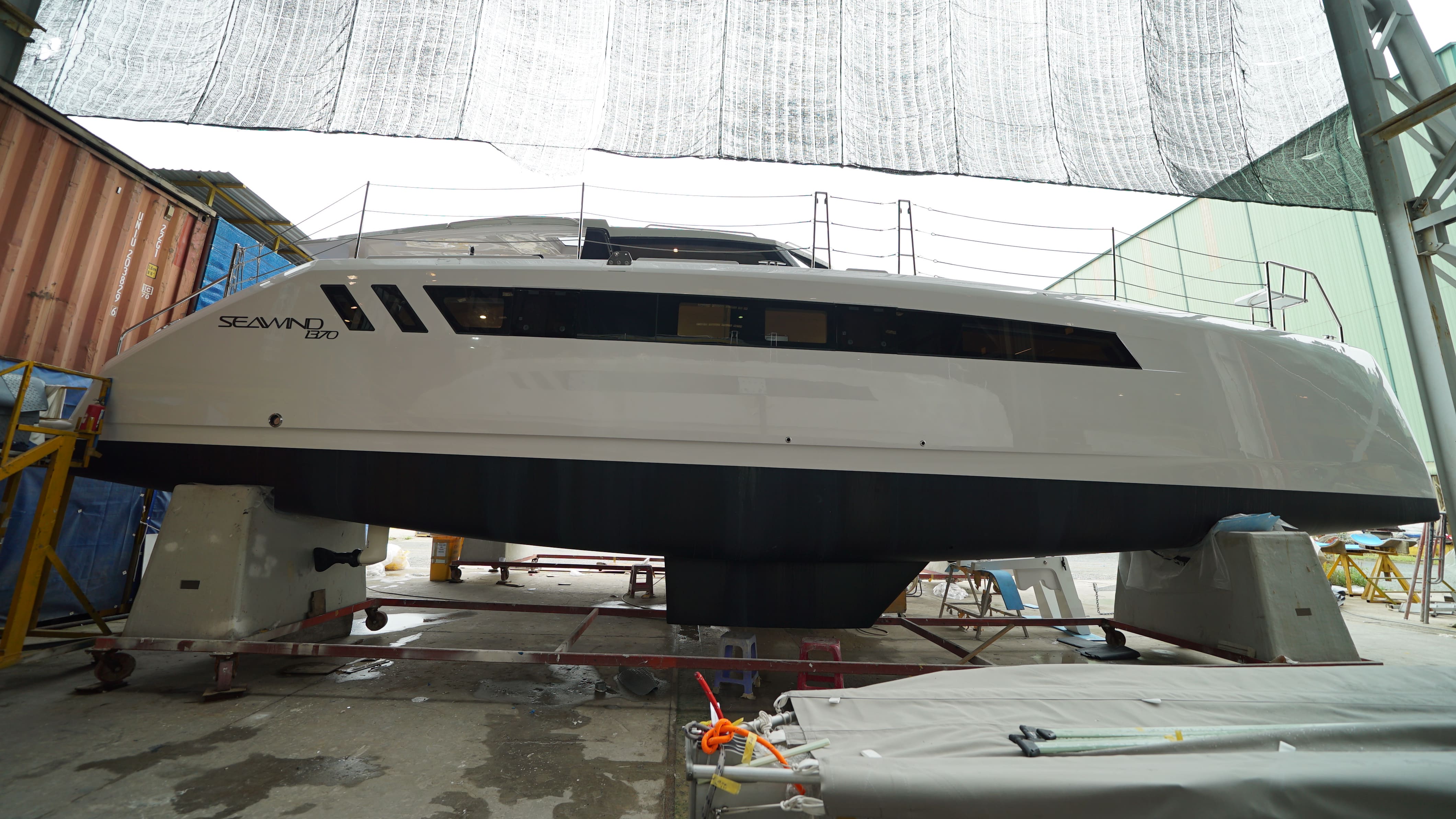

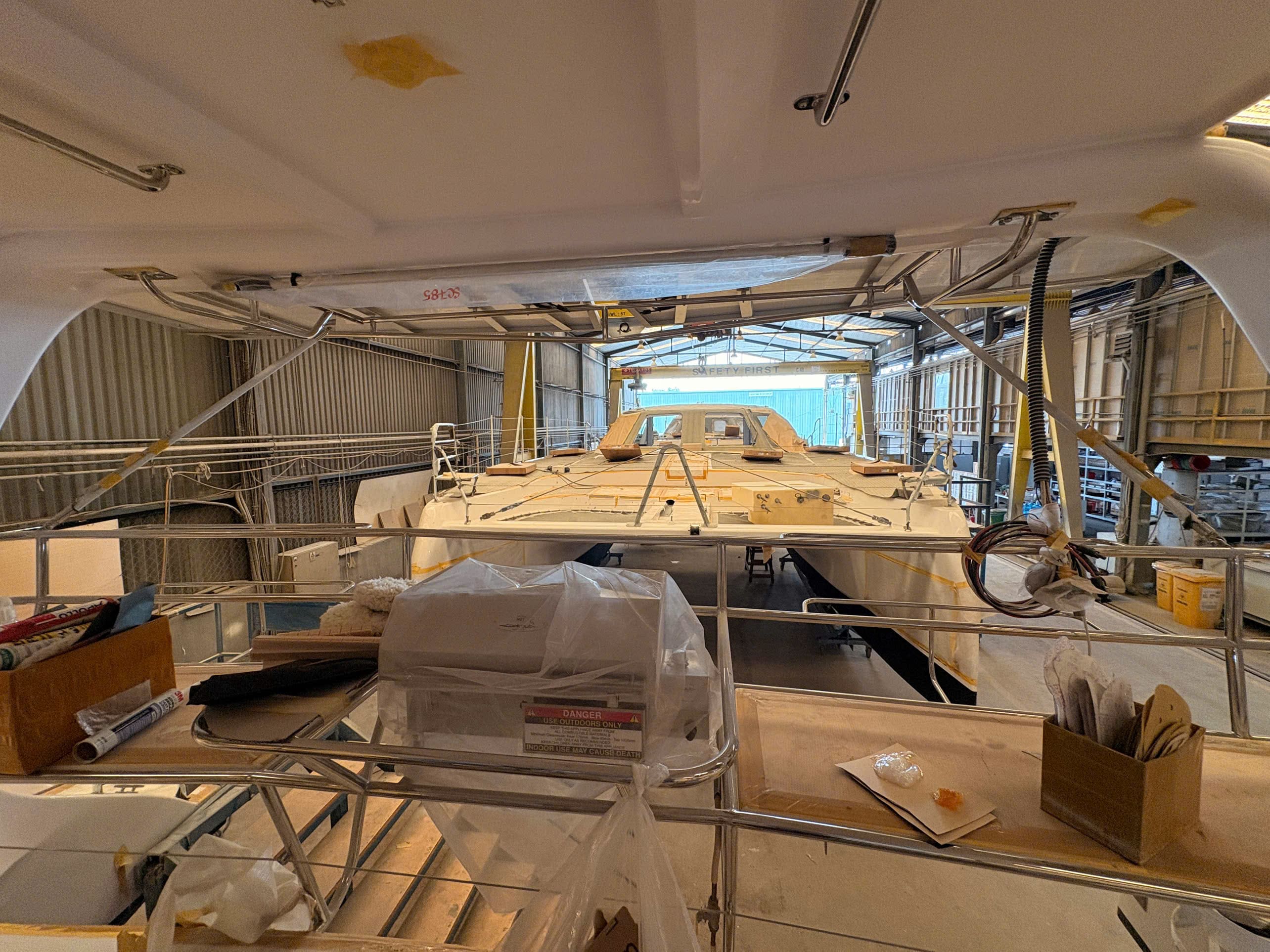

Deck moved to our Seawind shed on 6th October for the first Assembly stage. Work is being carried out on transom extension. Hull is in our driveway waiting for some Lam parts to be handed over. Deck joining is scheduled for 20th October, 2020.

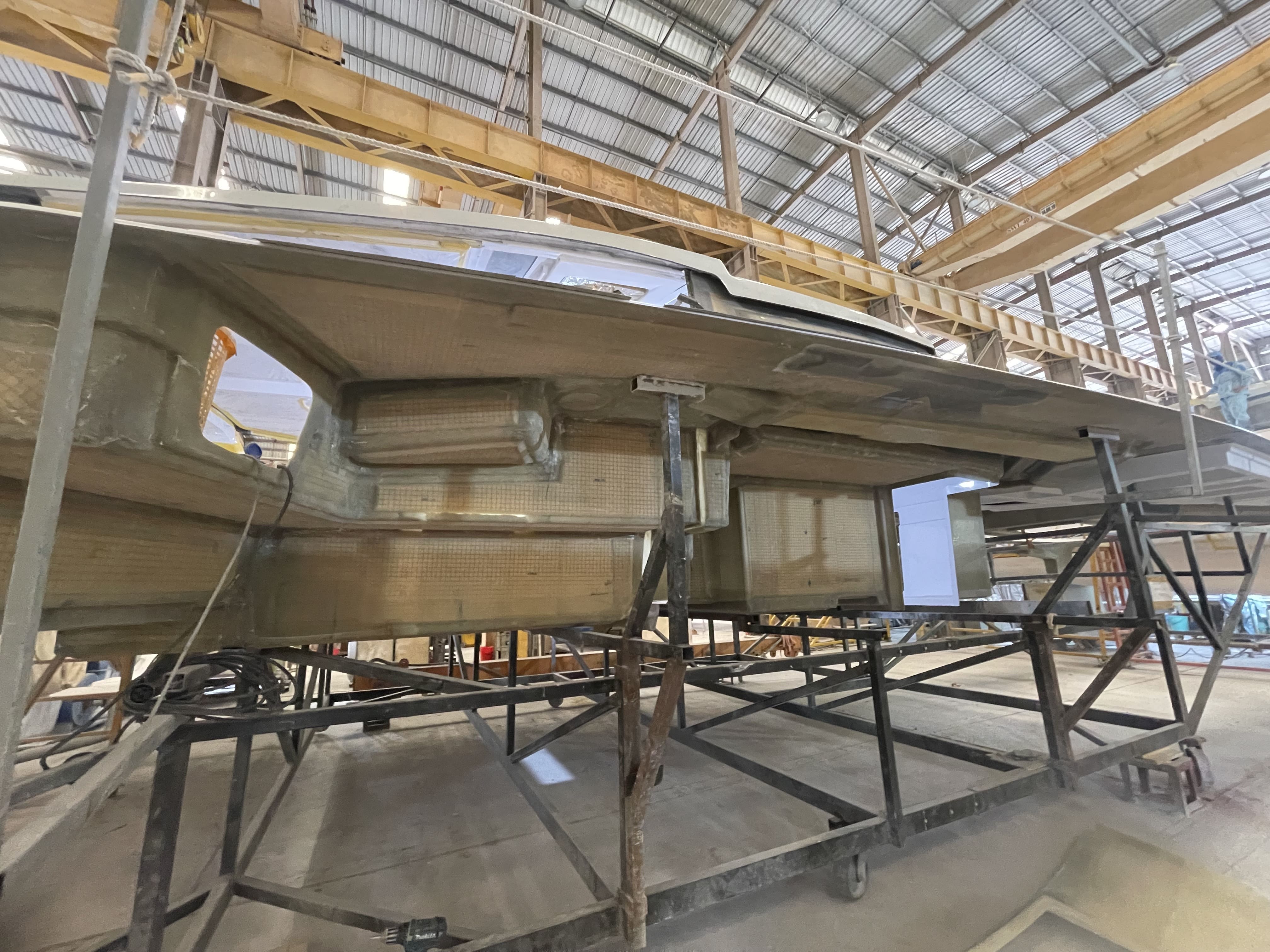

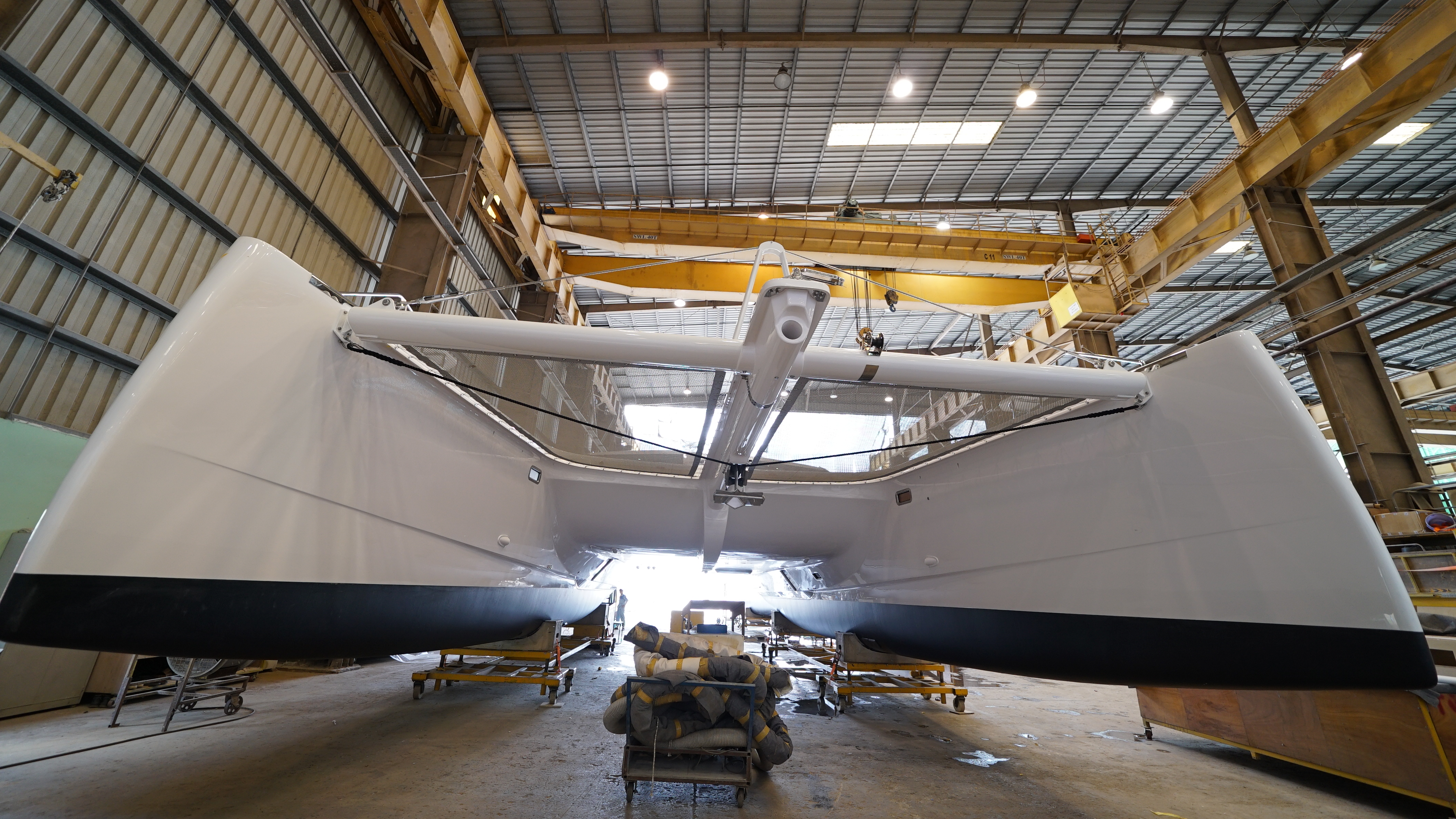

Production Update – Assembly

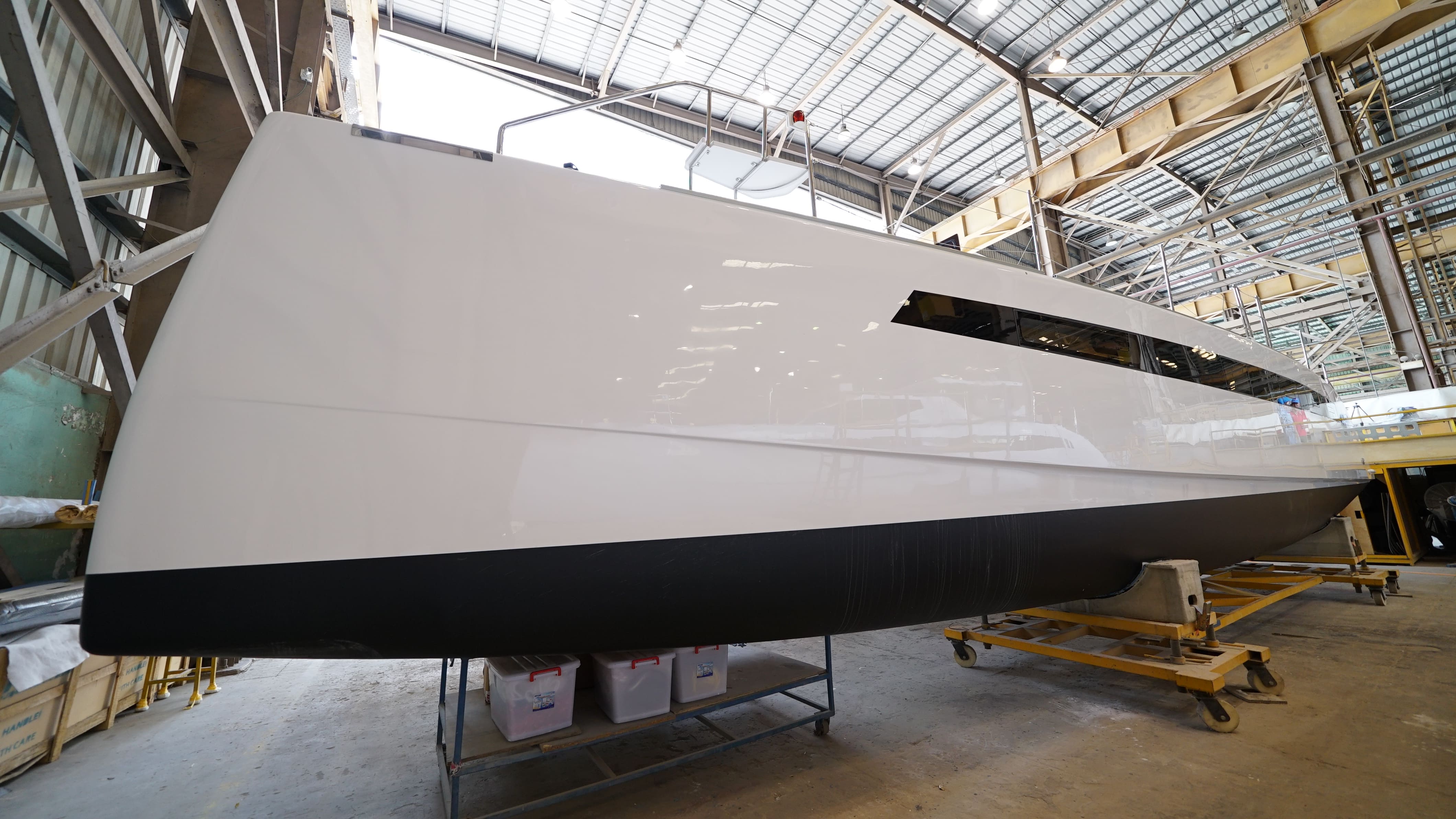

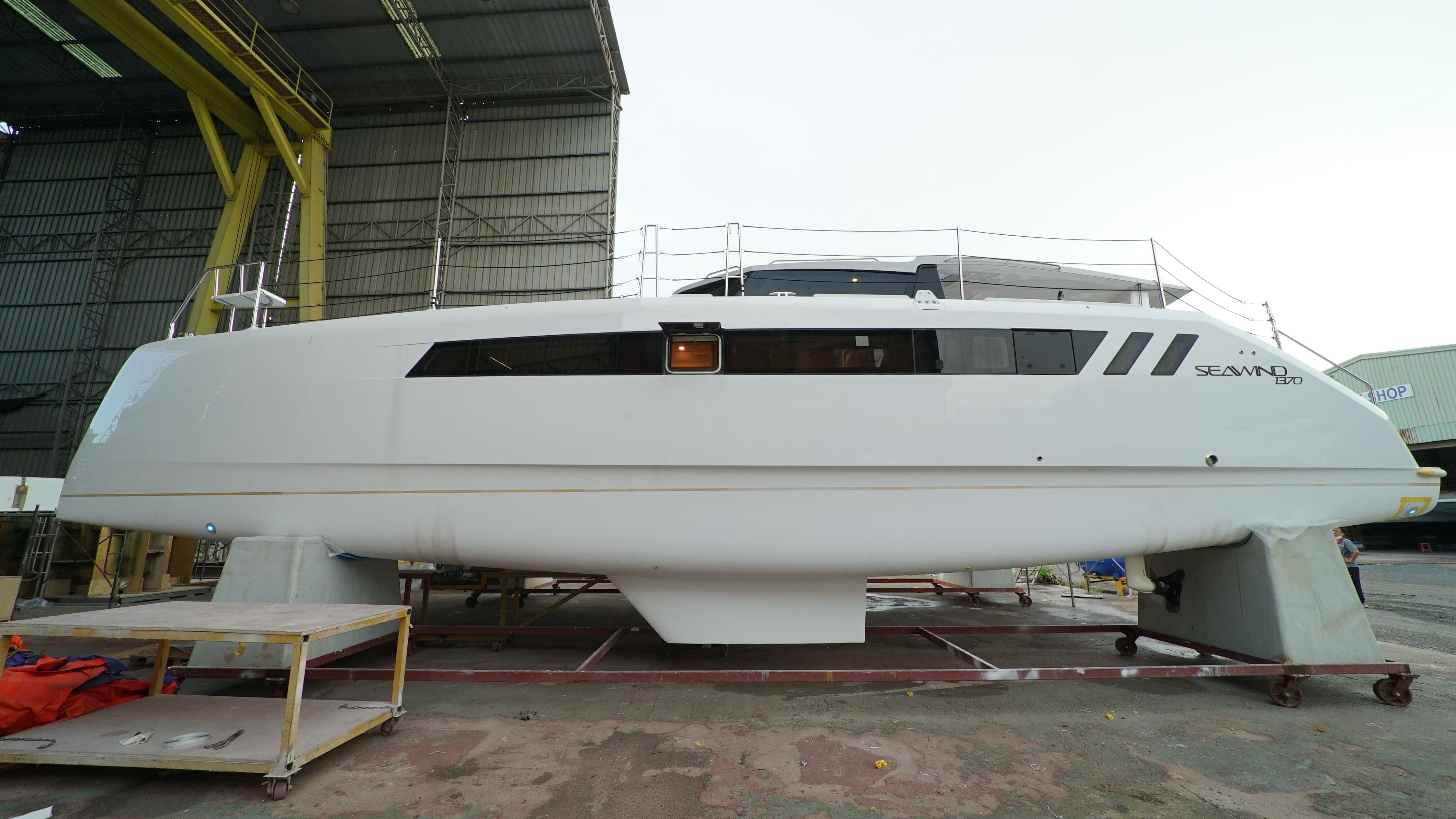

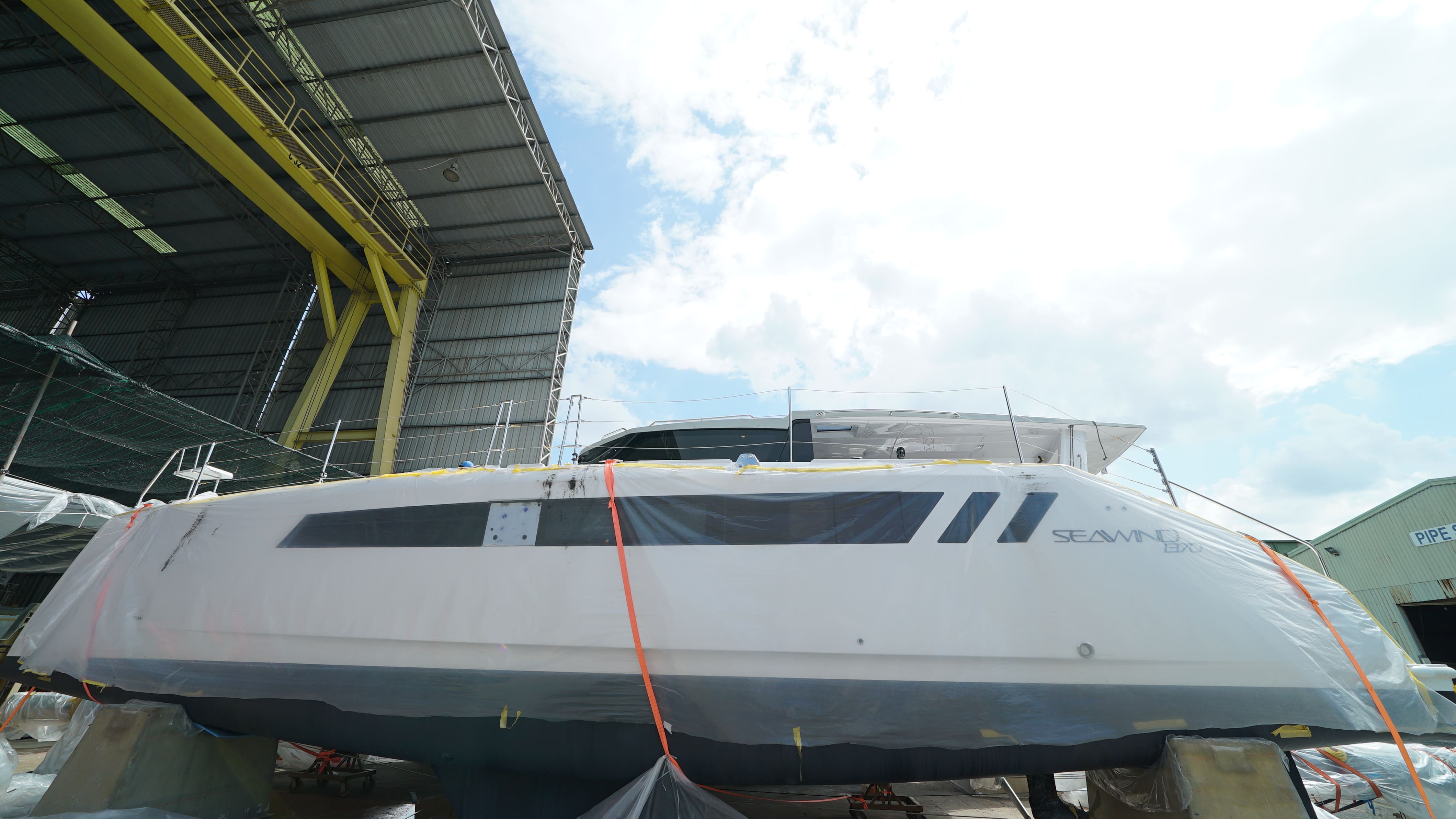

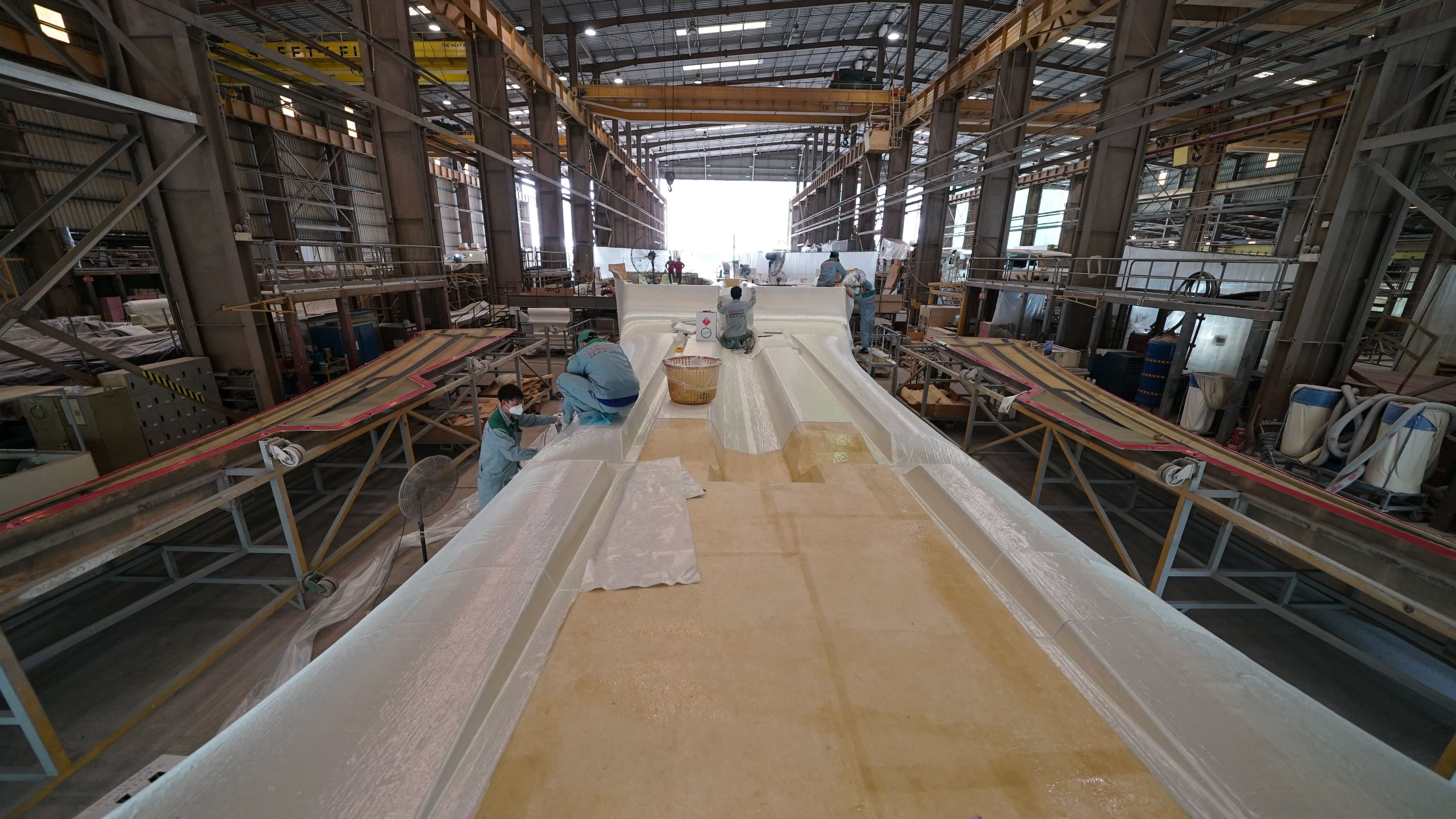

We are excited to inform you that your boat is progressing well in the first phase of Assembly stage.

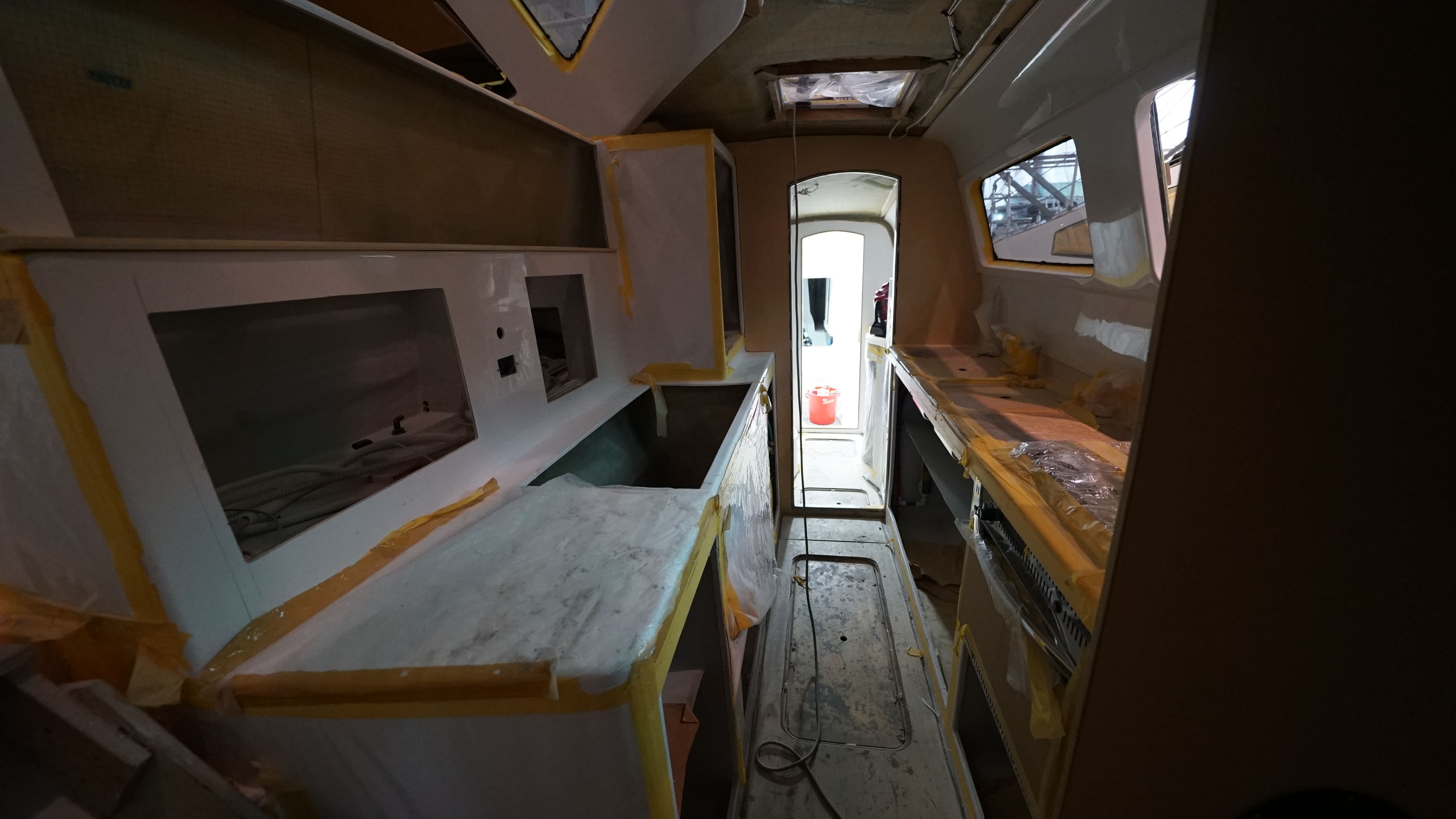

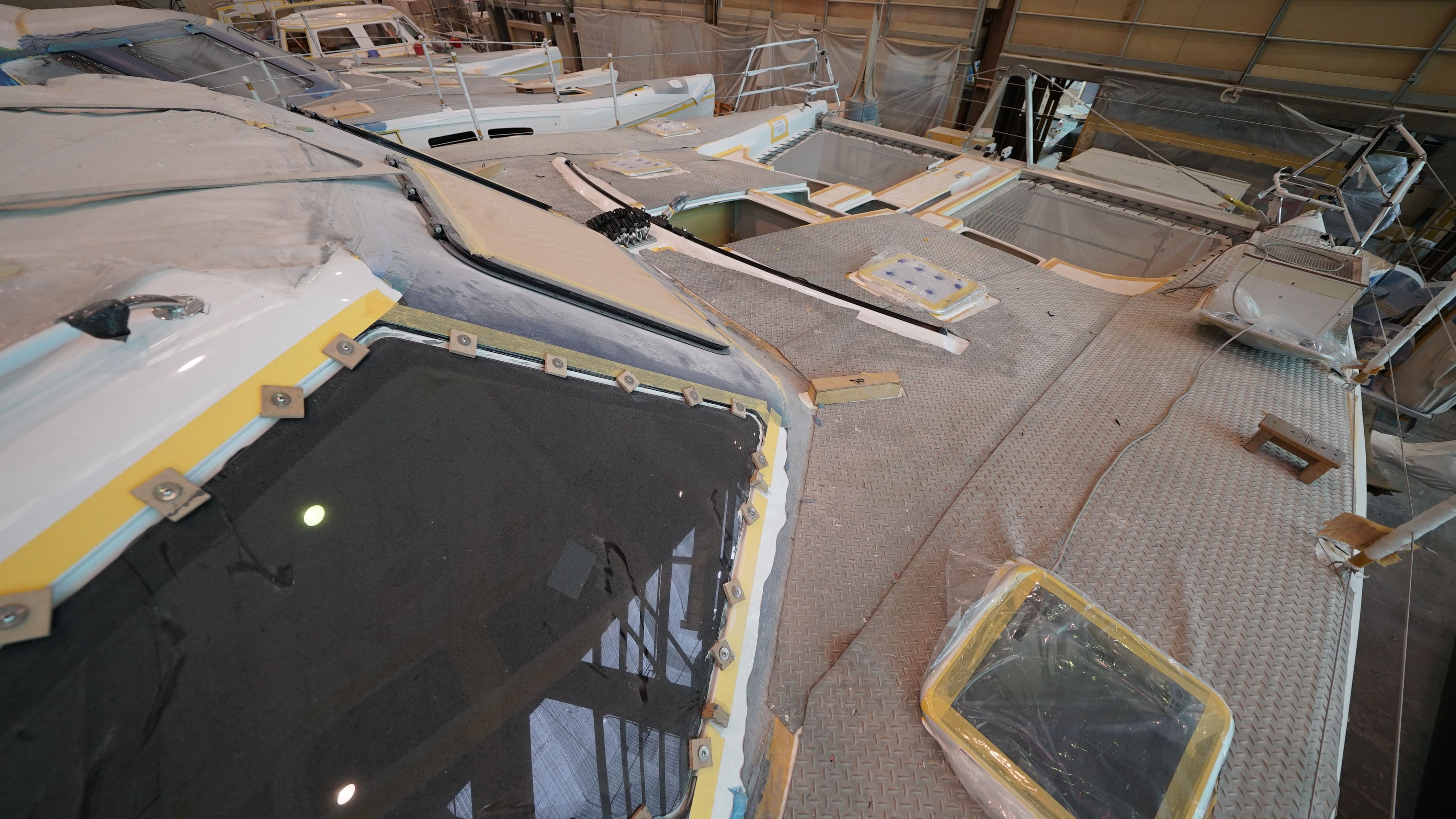

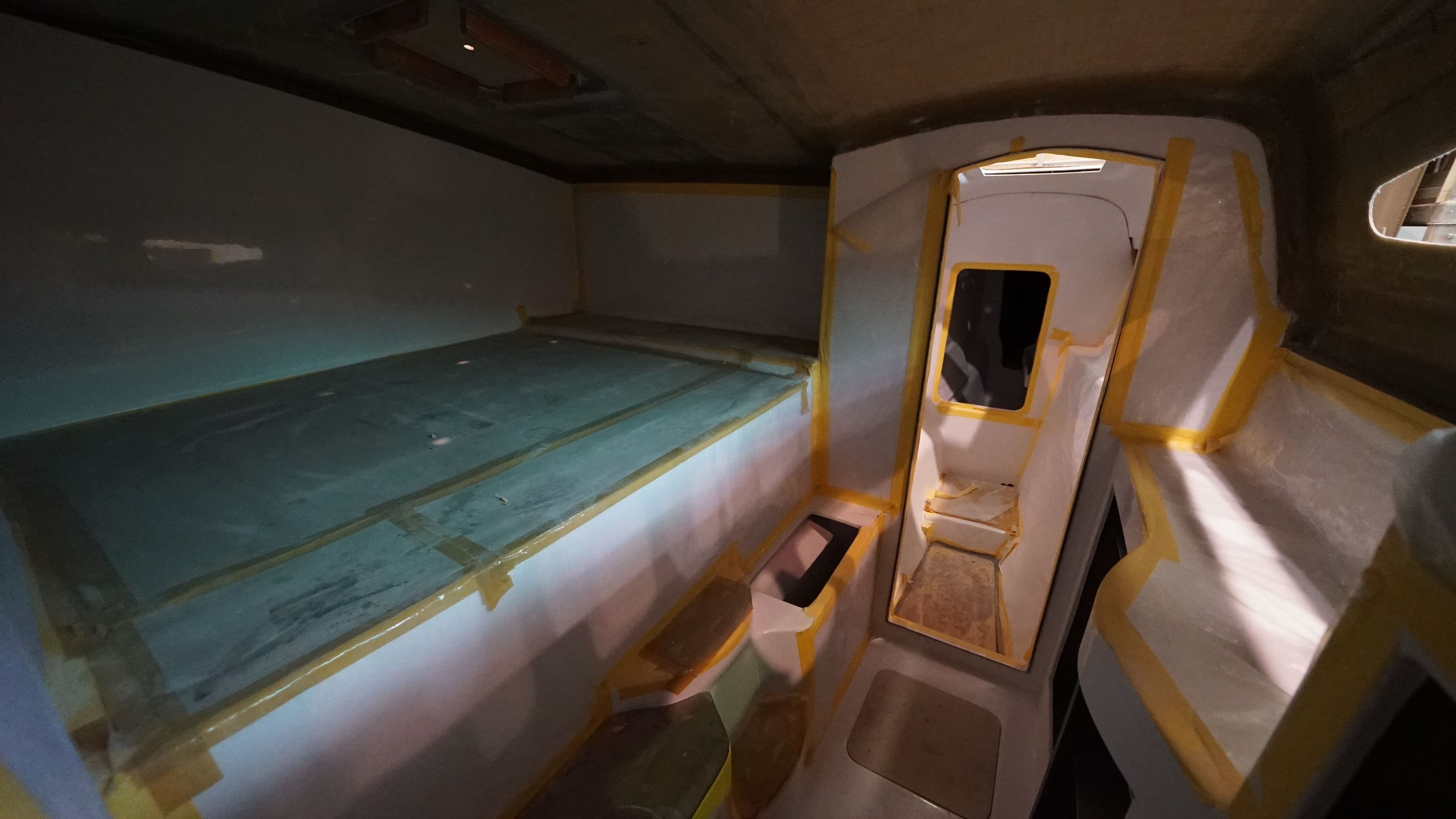

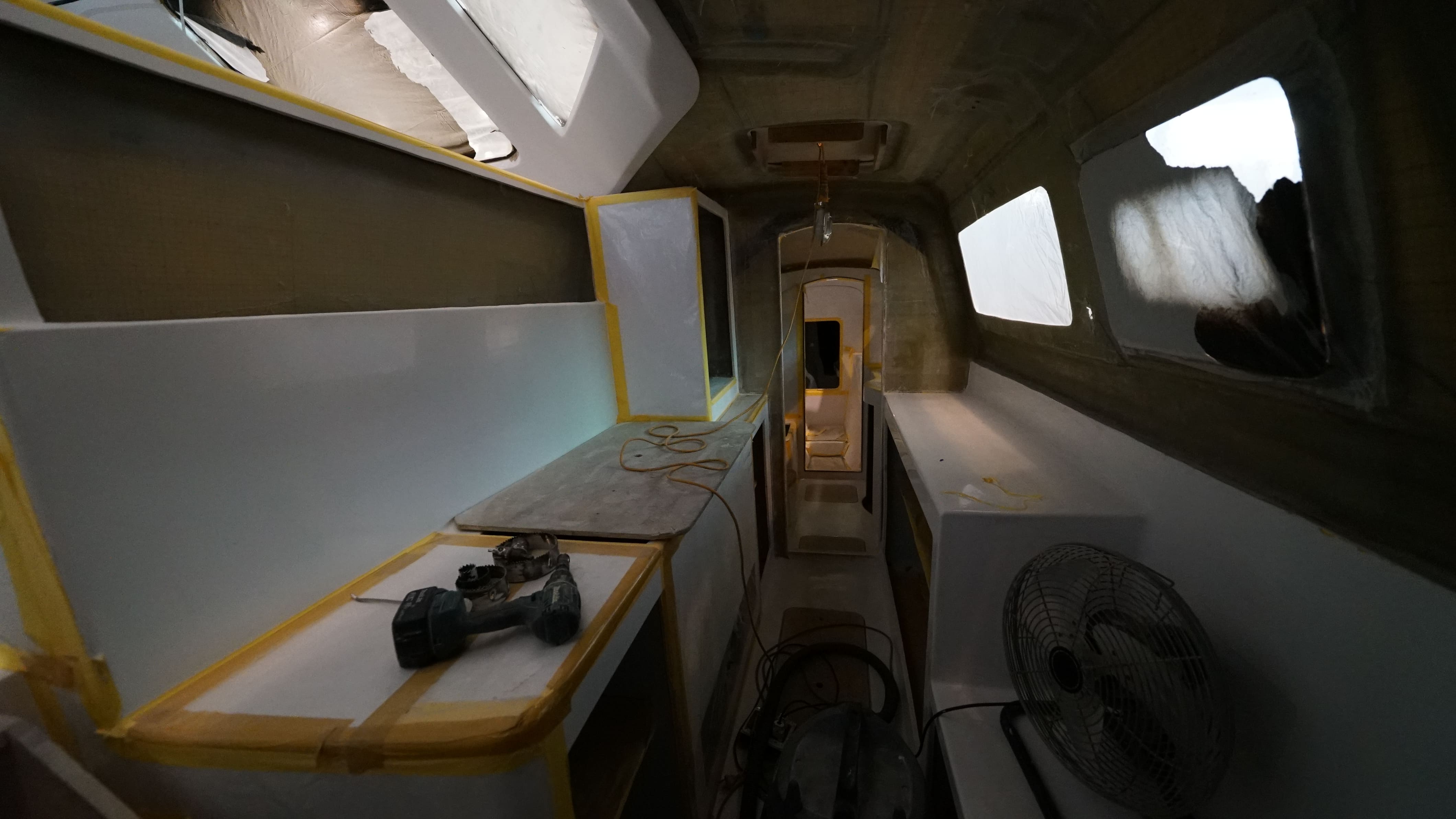

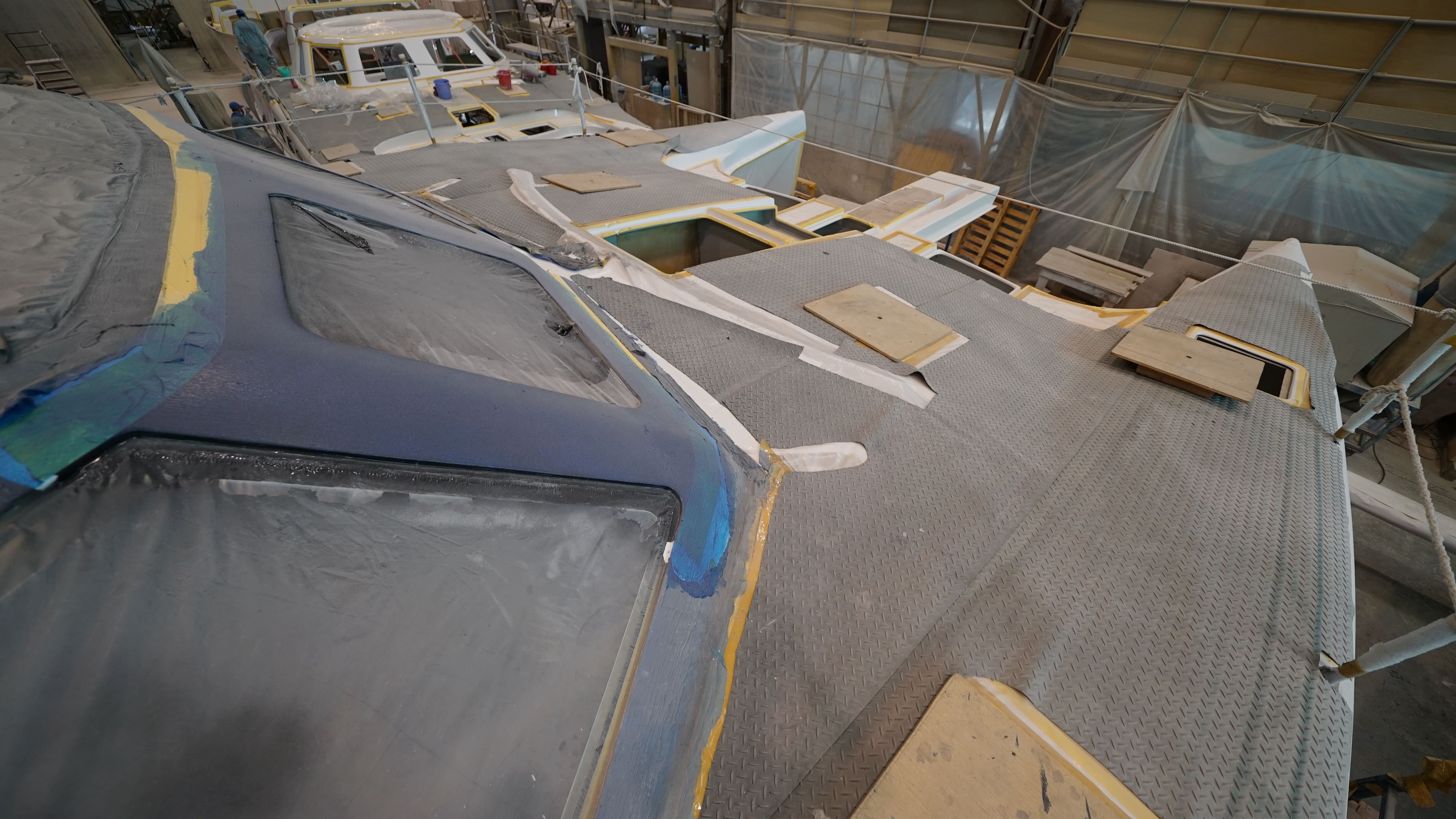

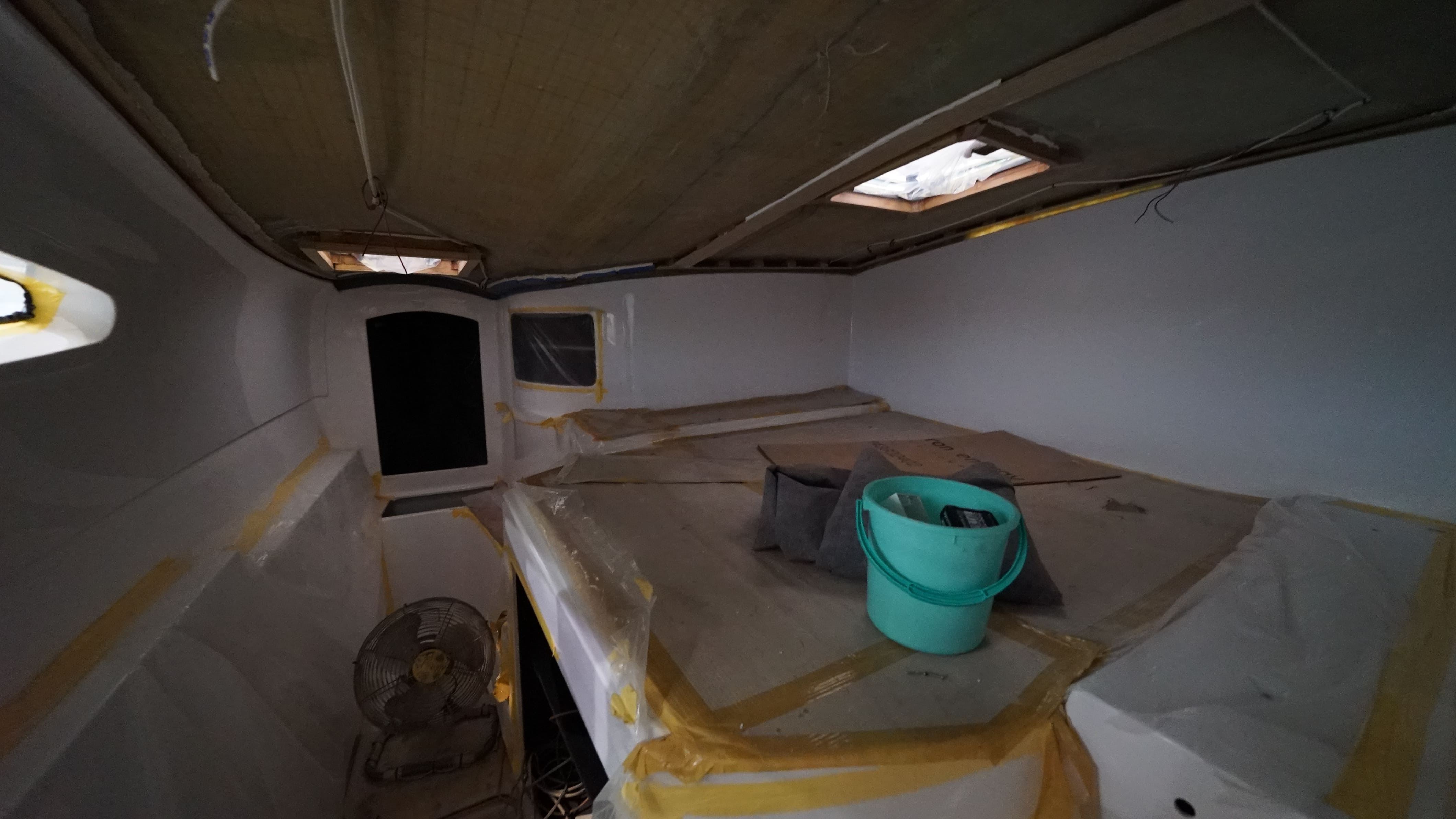

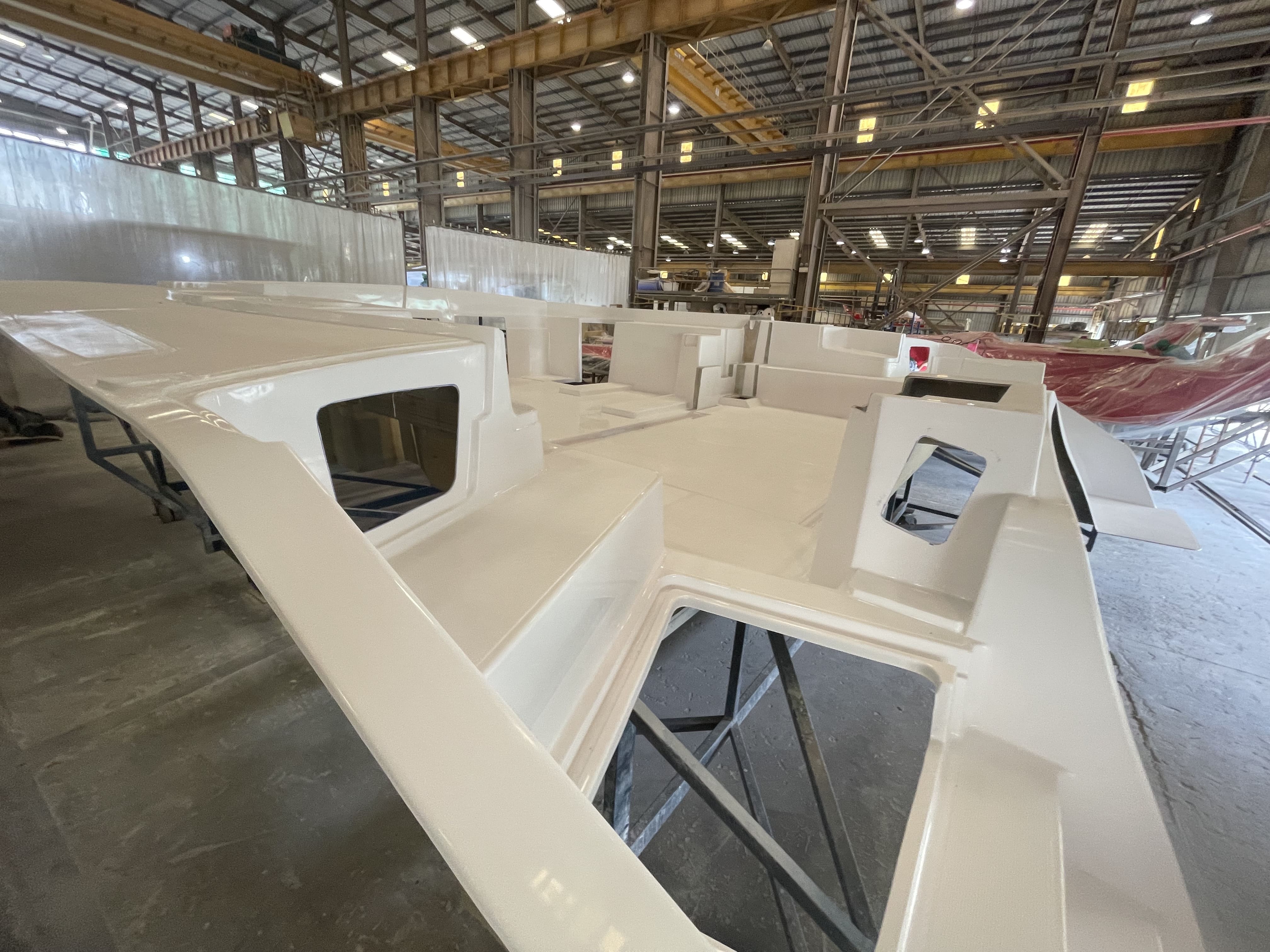

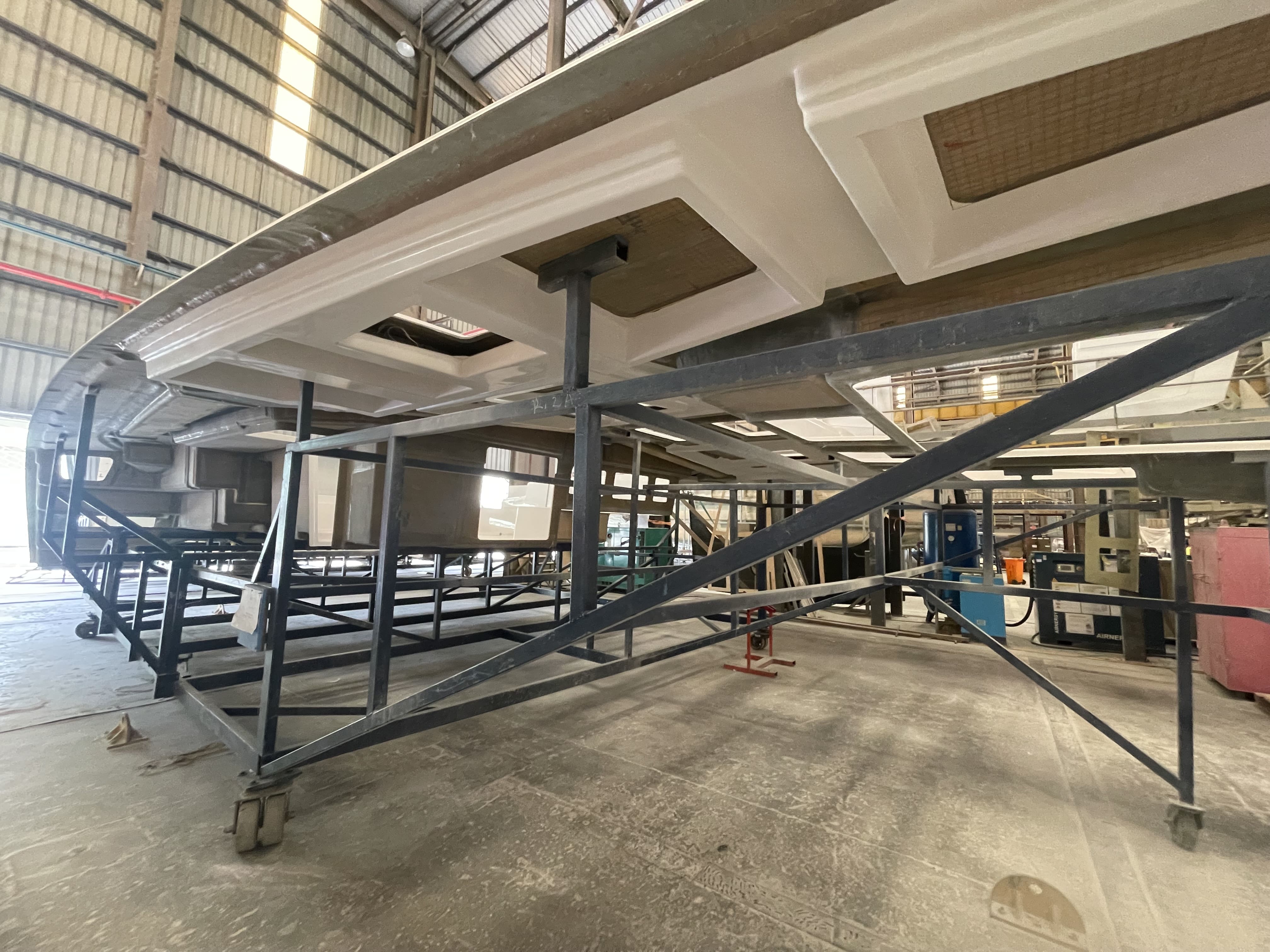

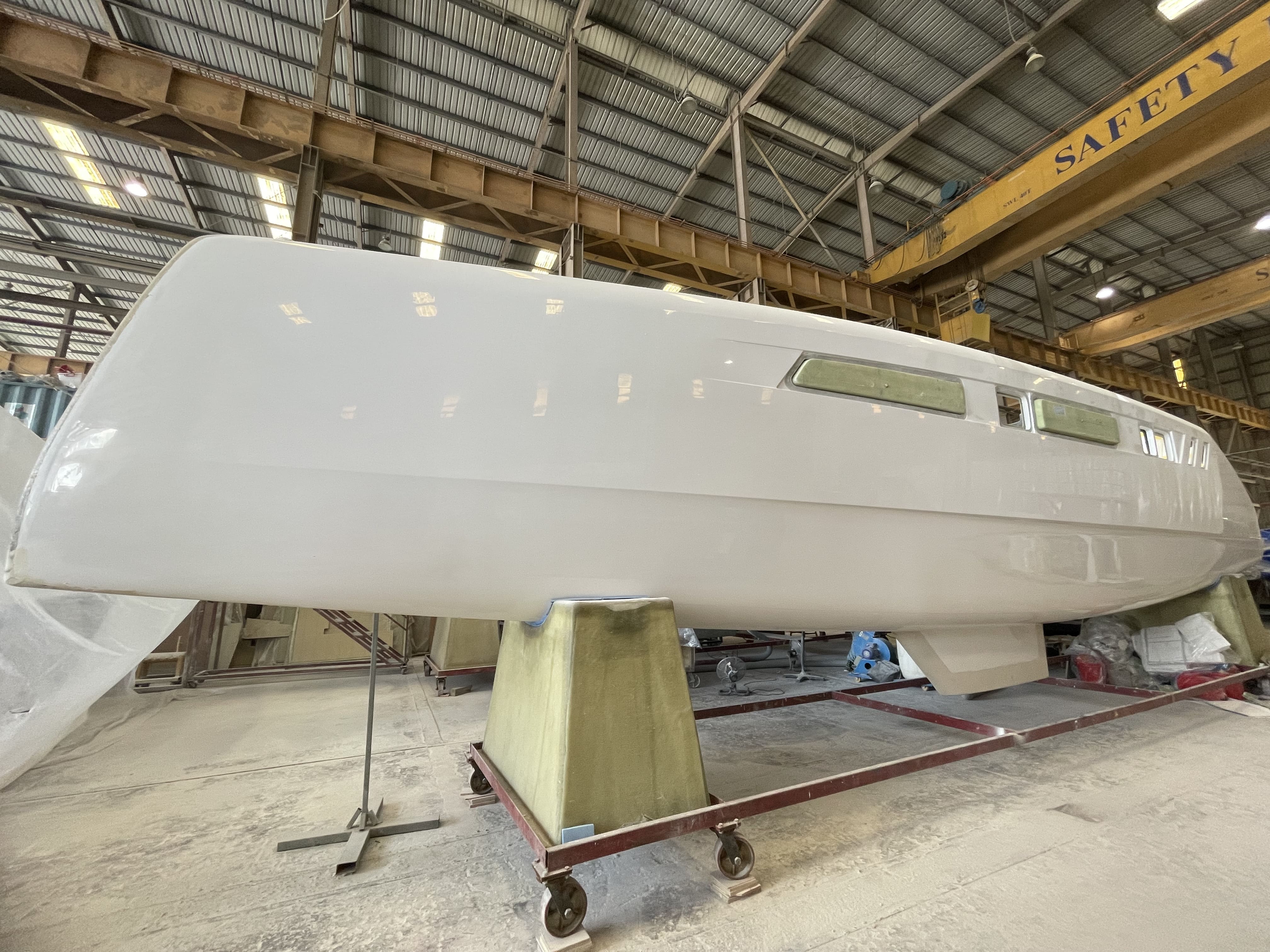

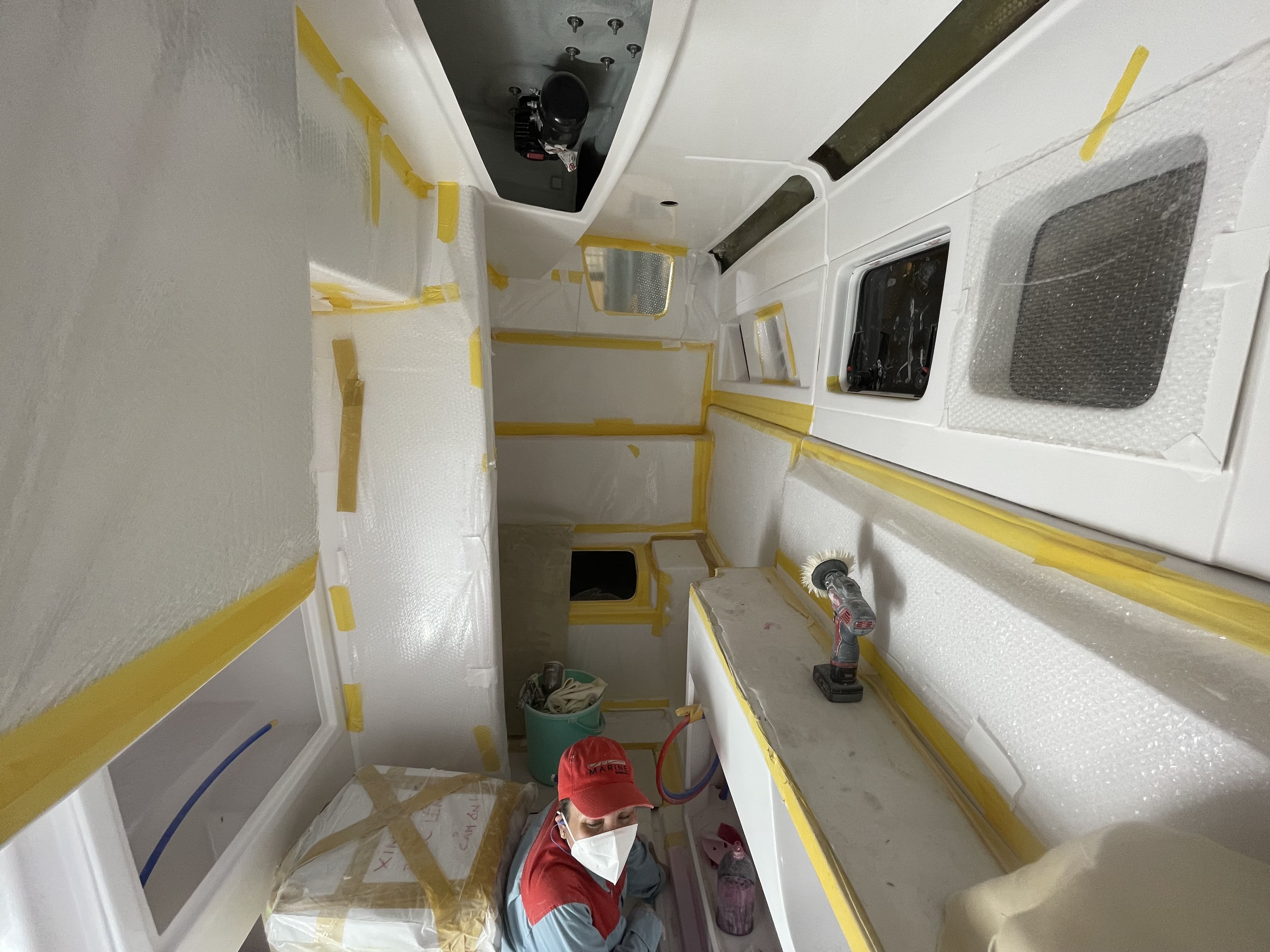

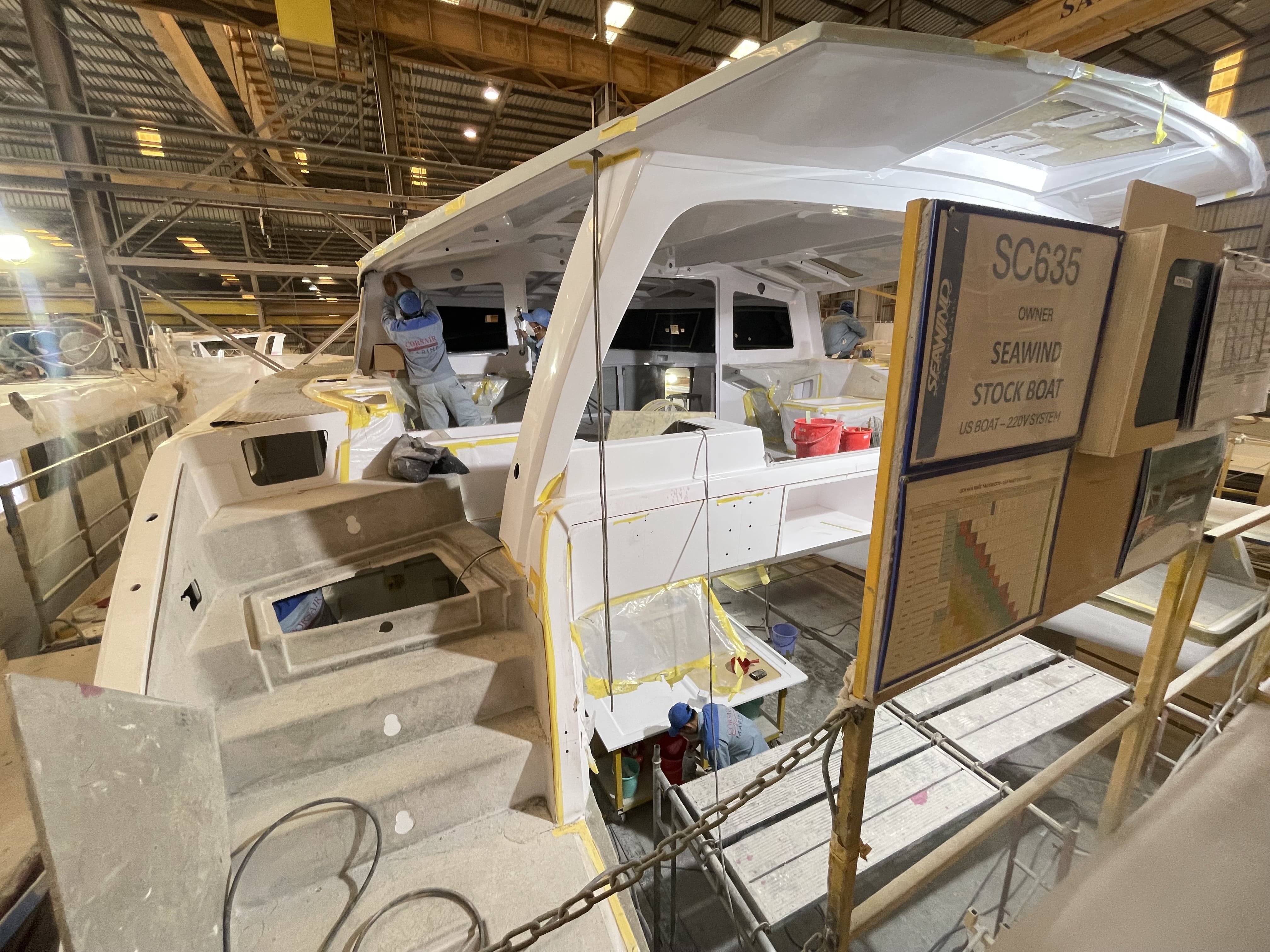

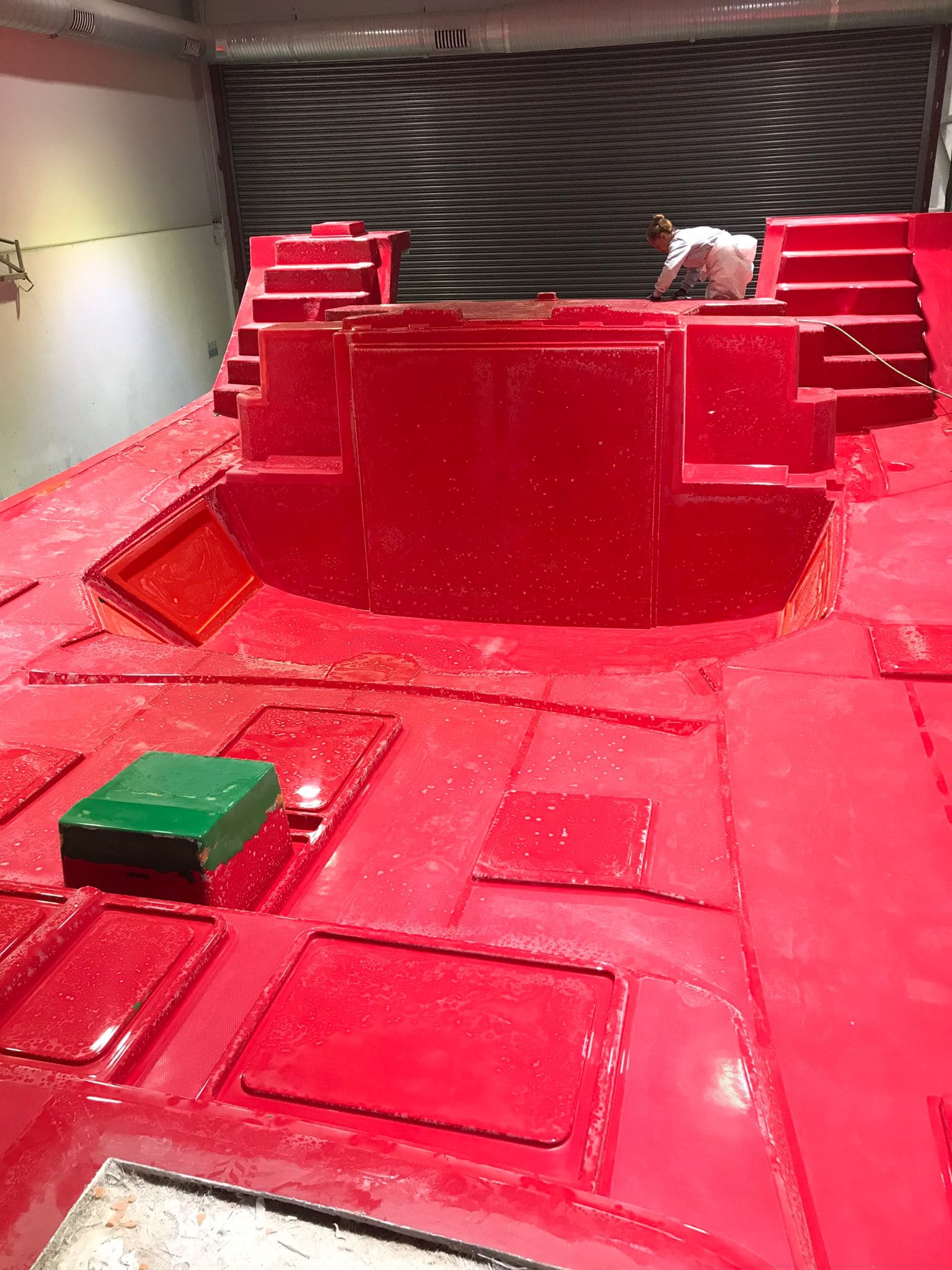

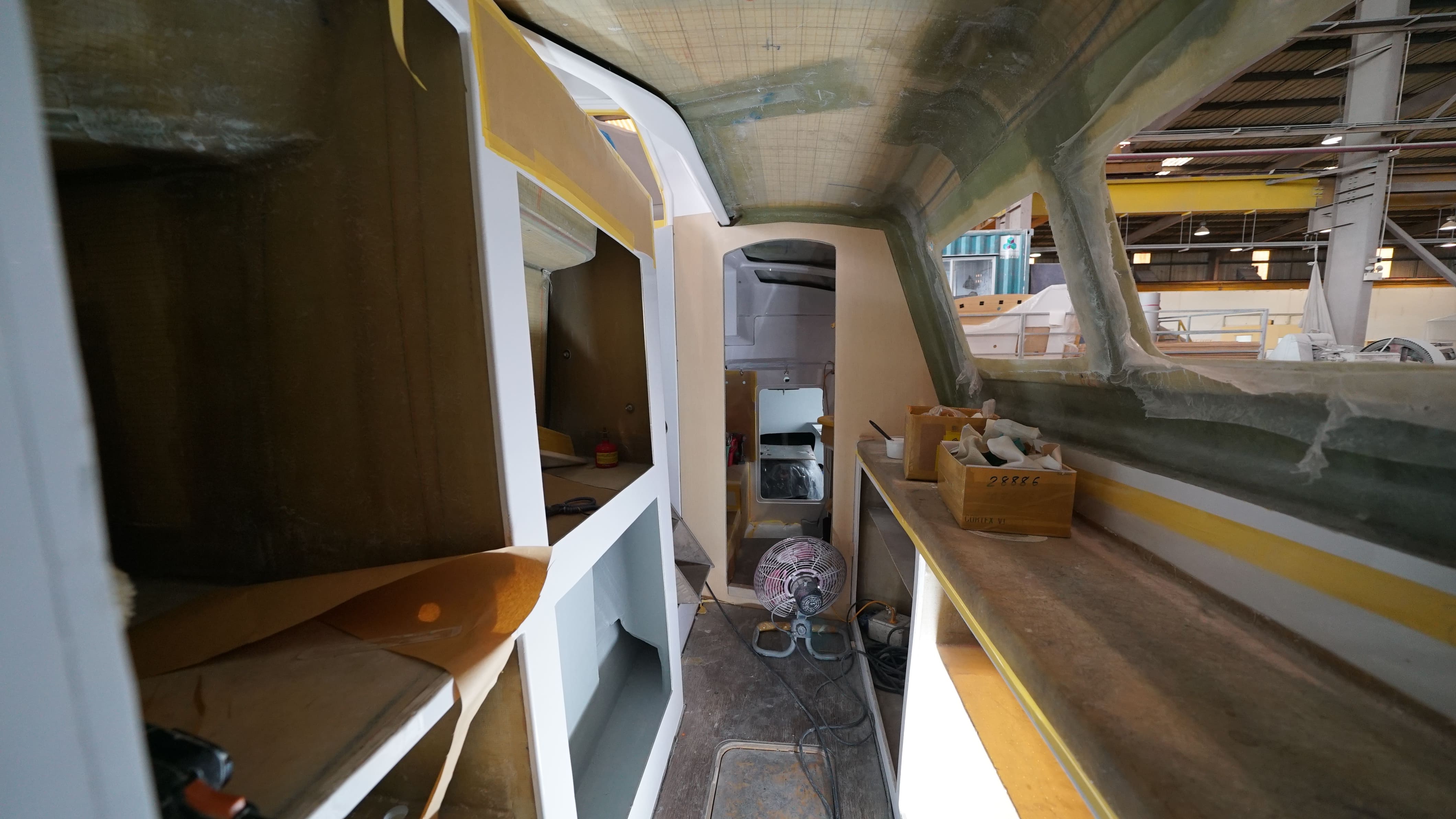

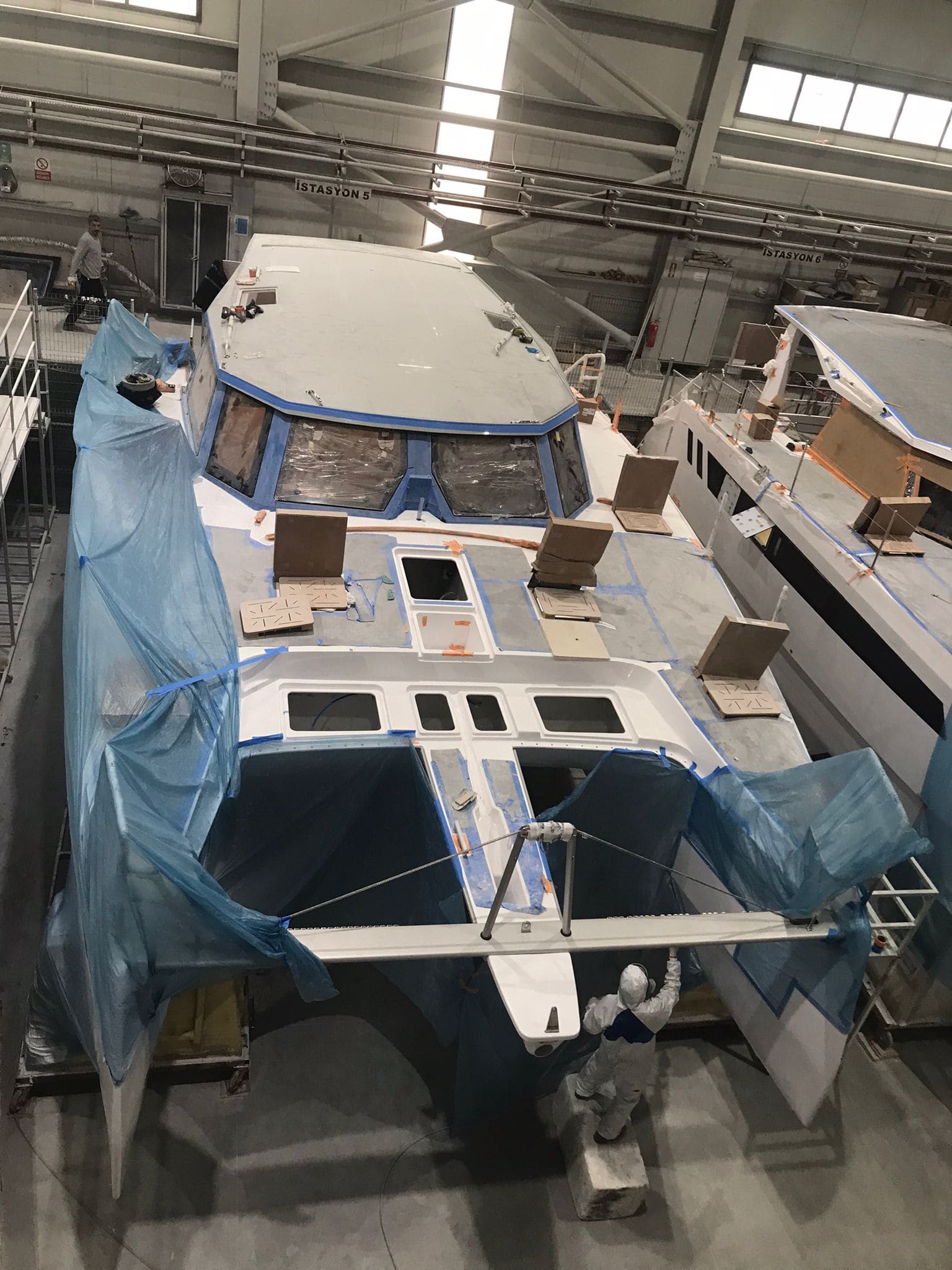

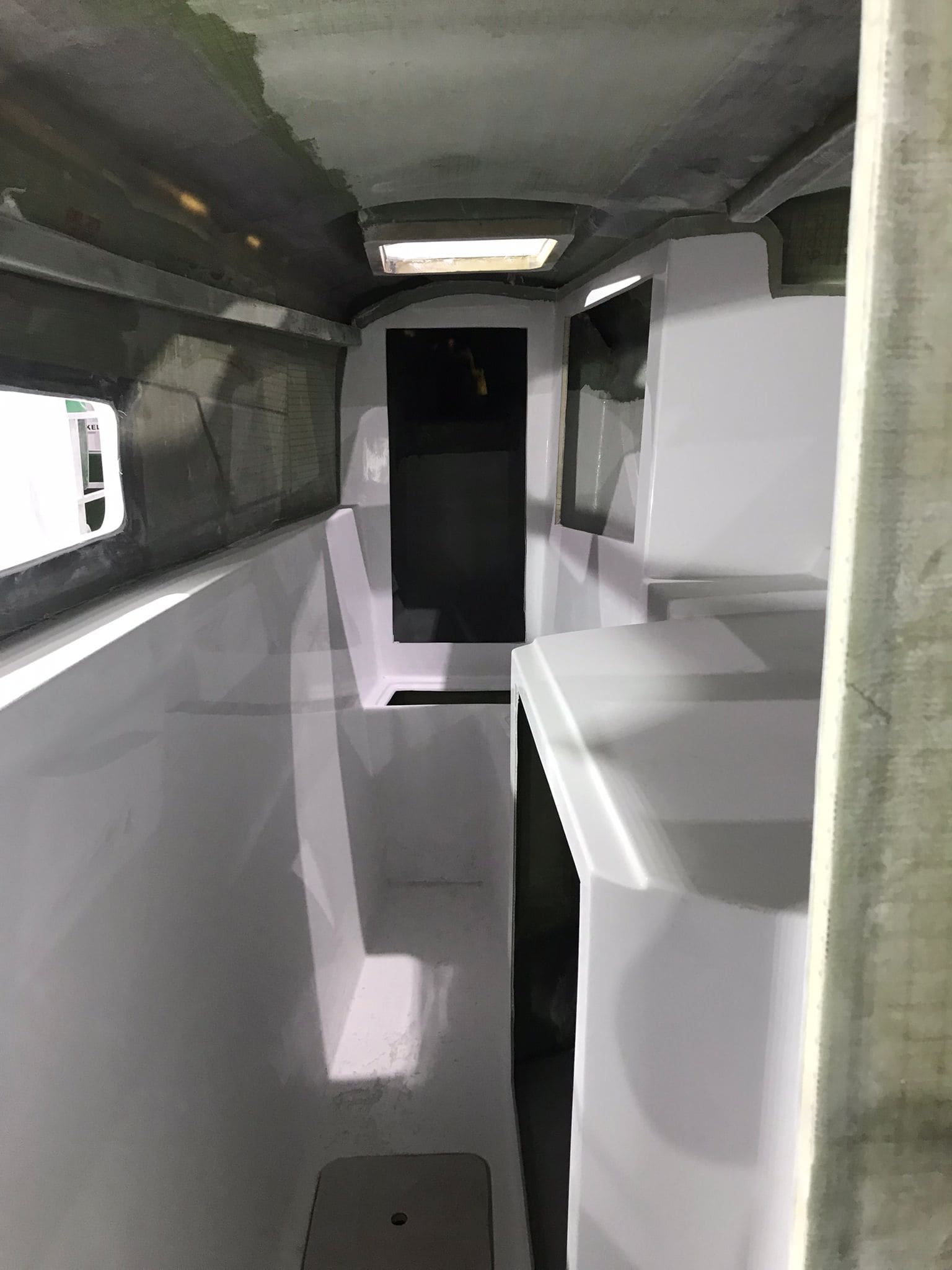

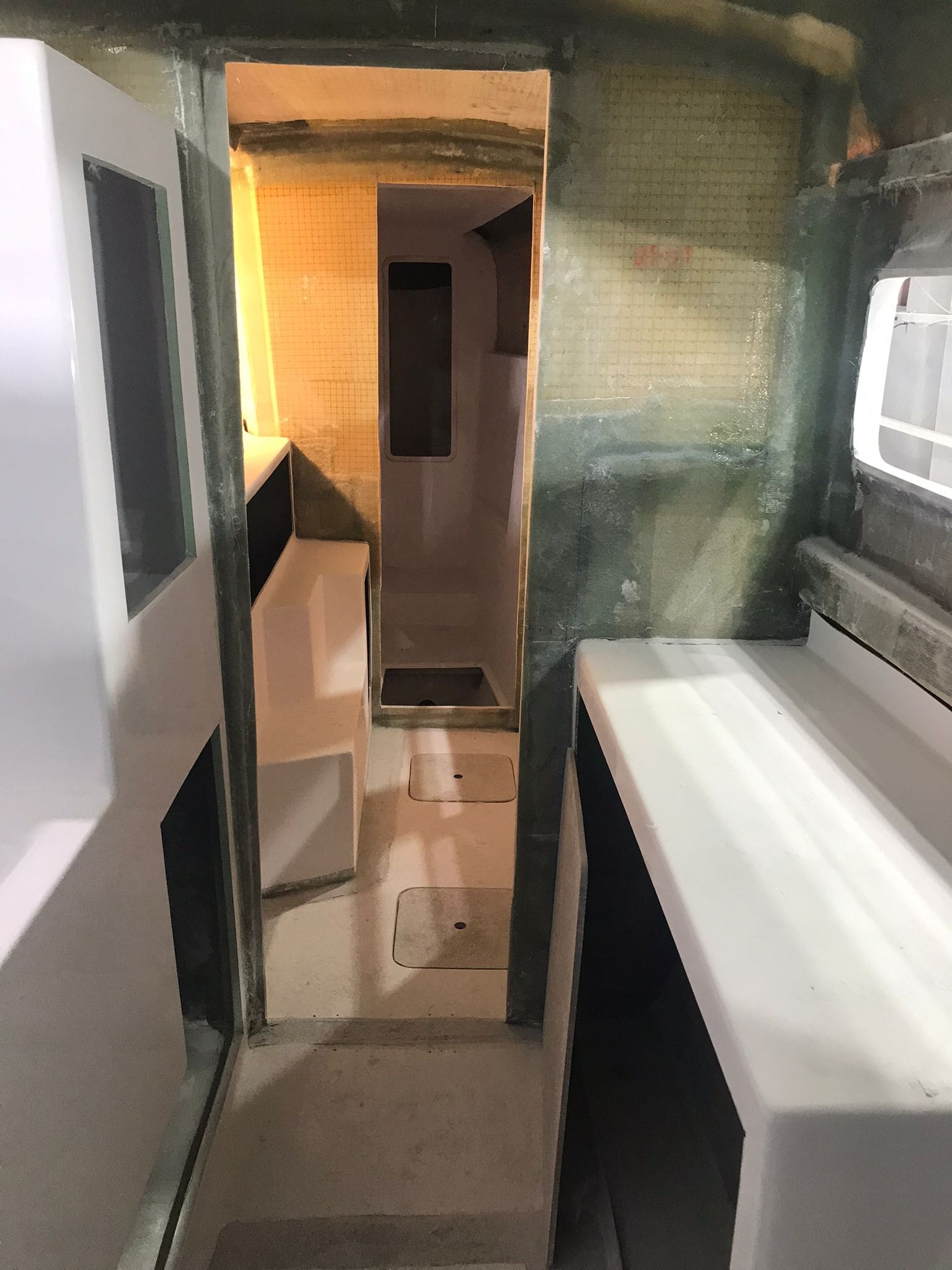

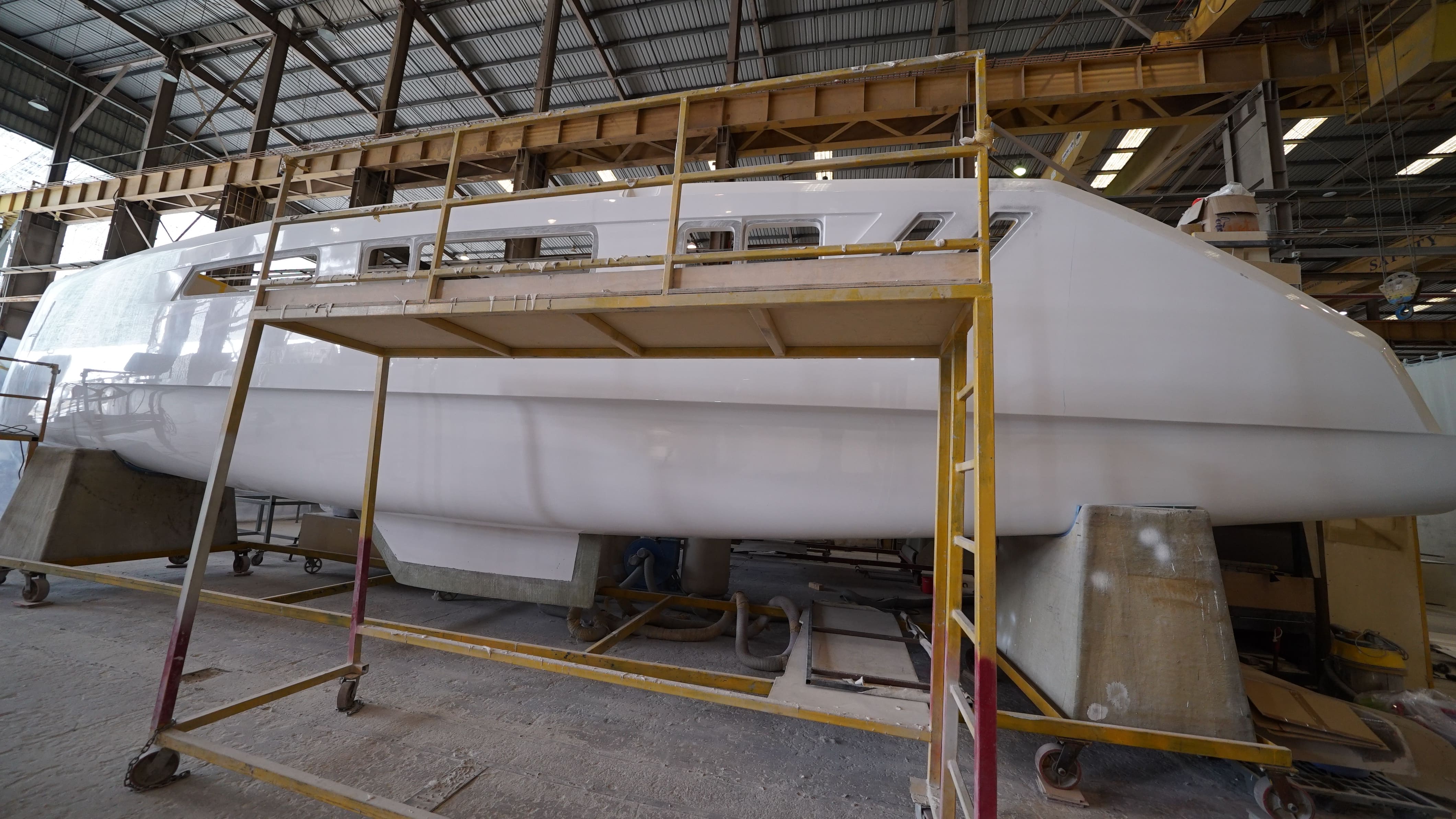

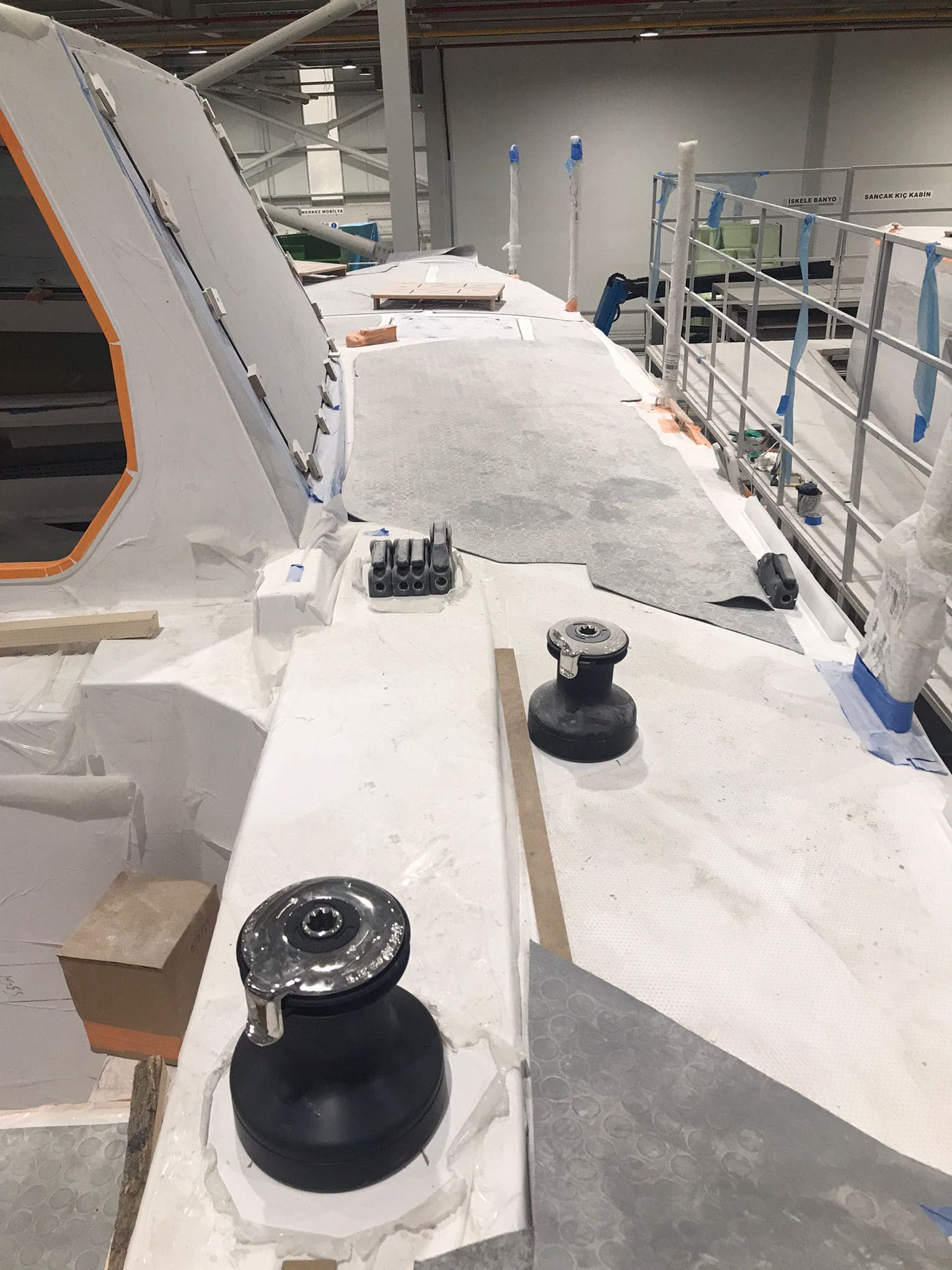

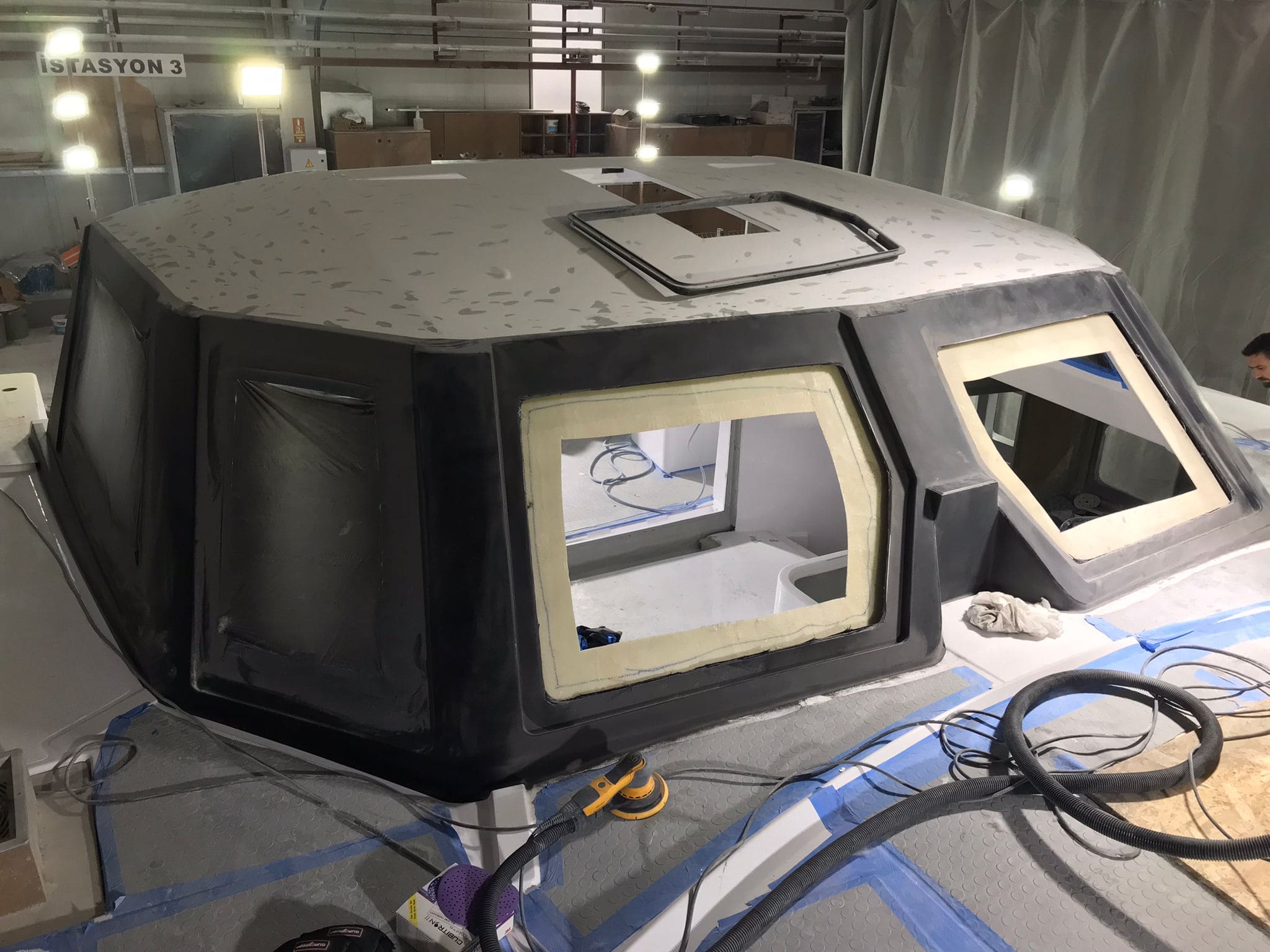

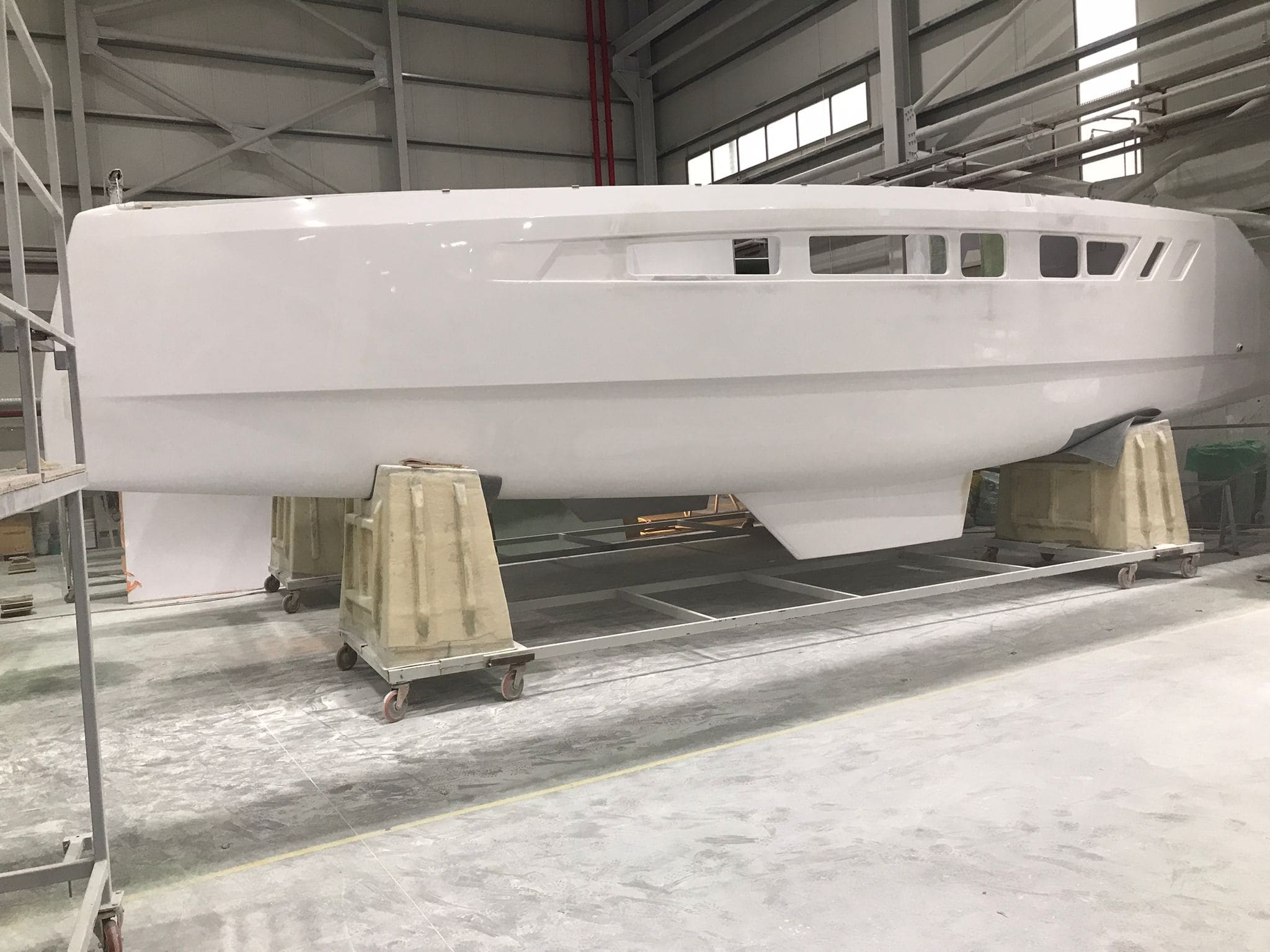

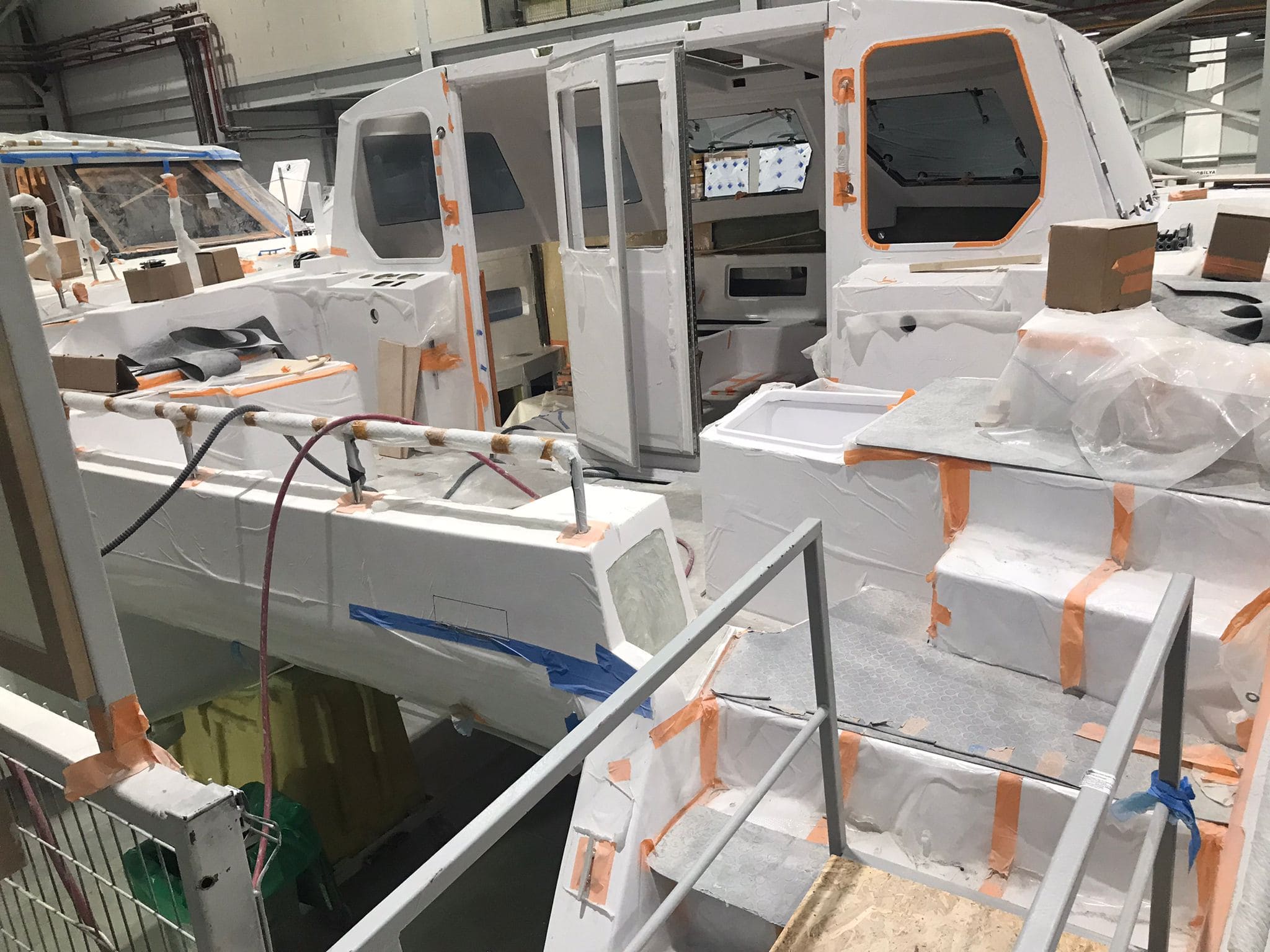

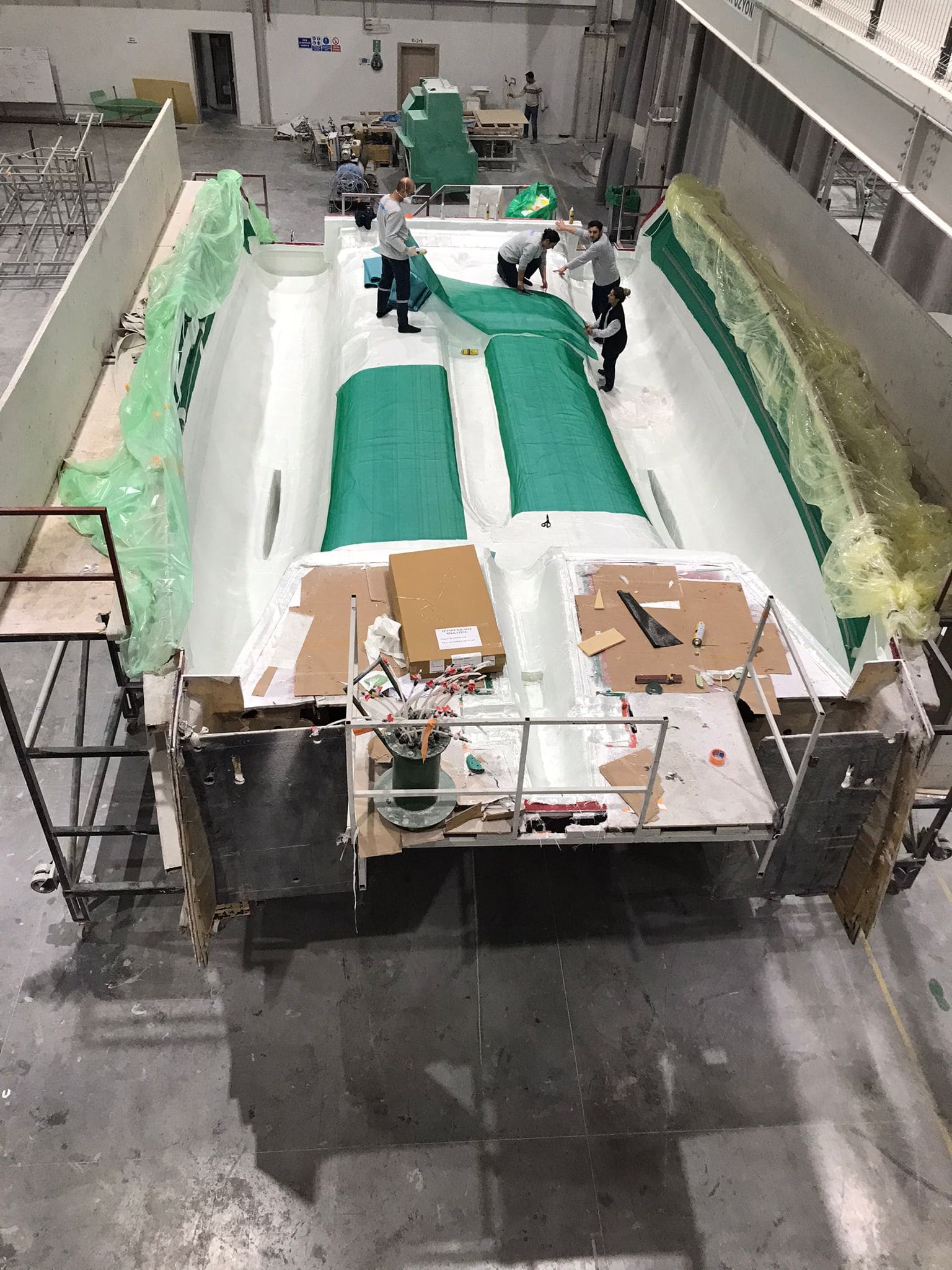

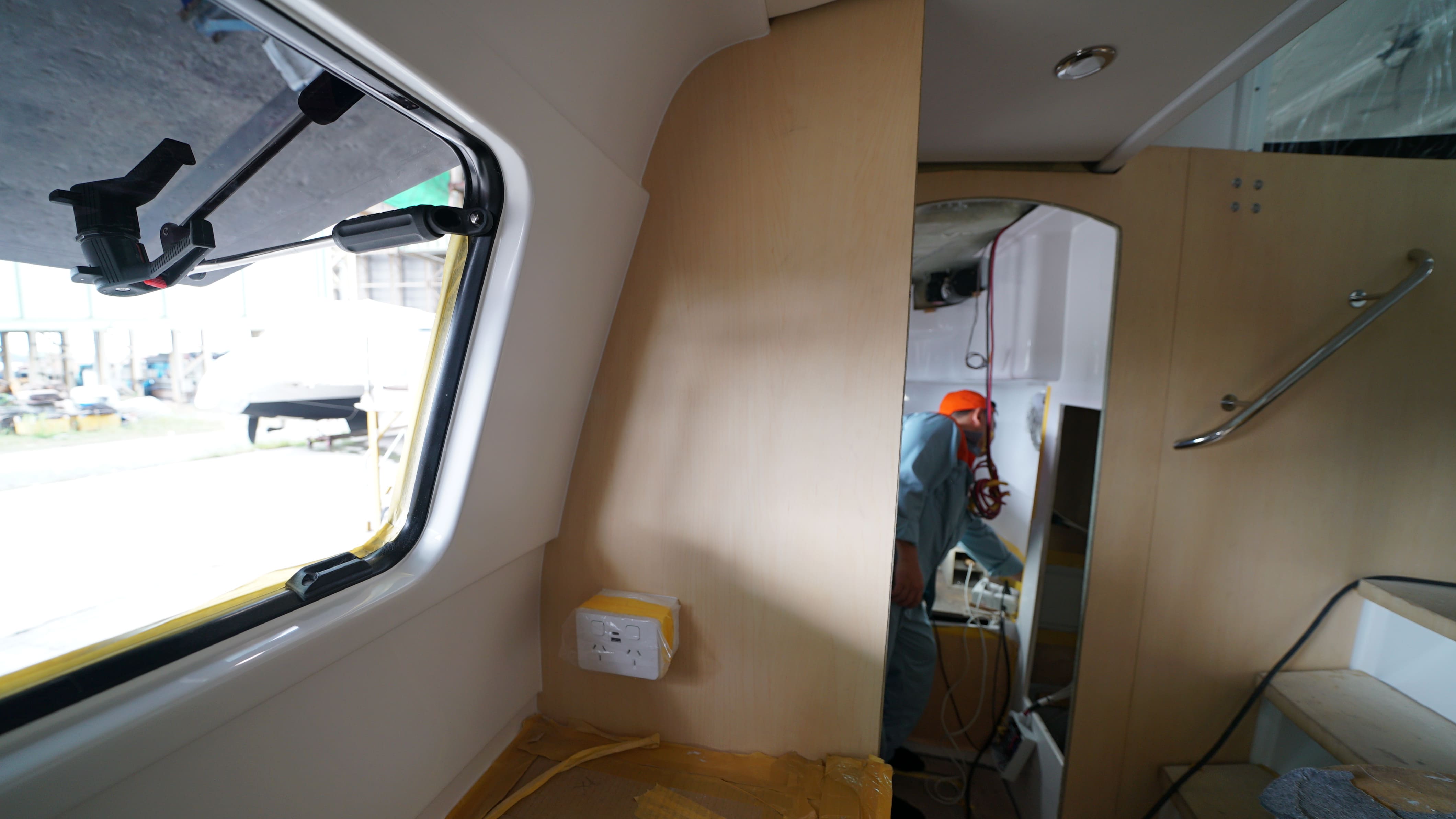

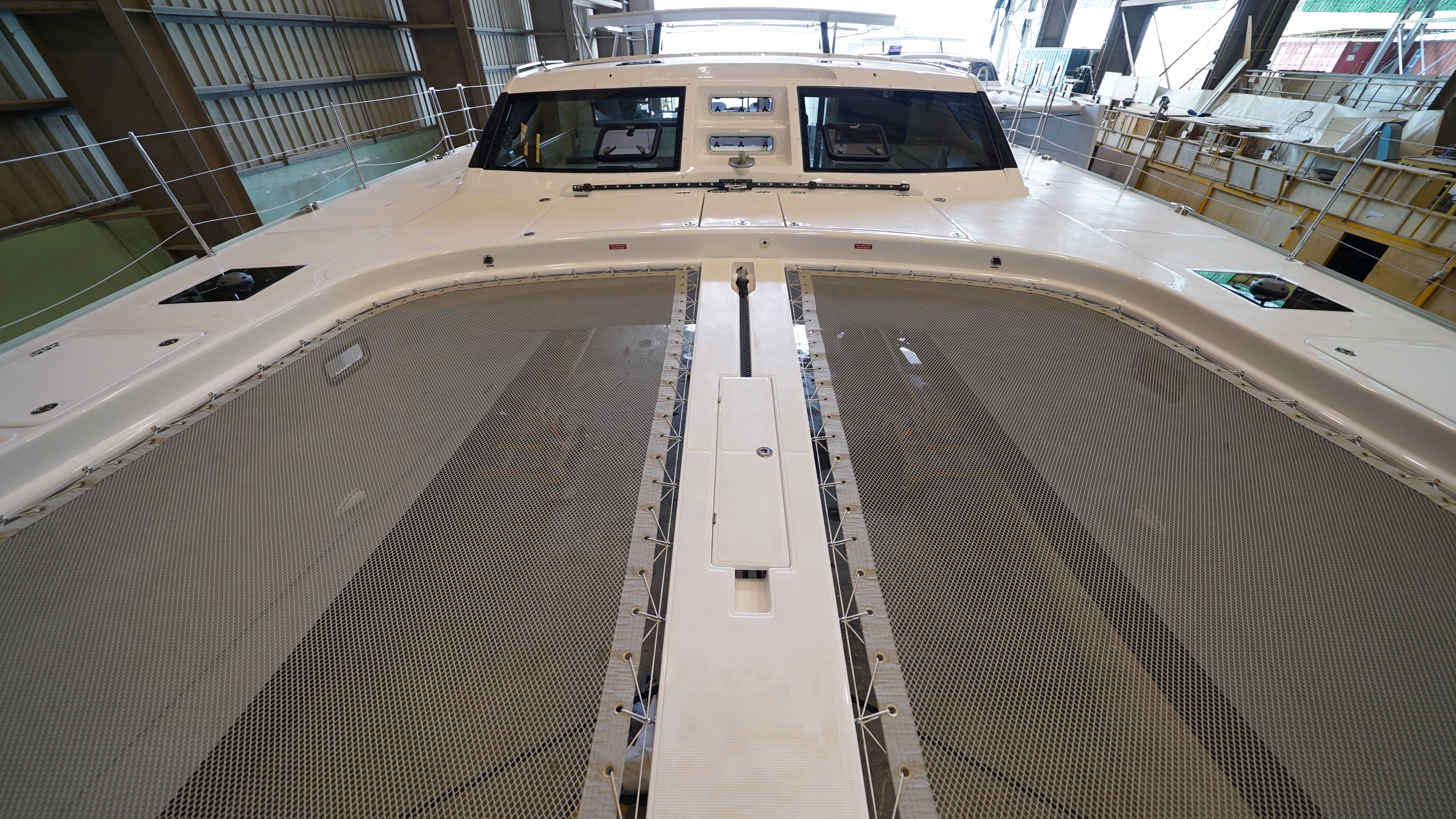

The hull and deck have been successfully demolded. Our Production team is working on furniture module installation inside the hull. The coach roof is also ready to be joined with the deck.

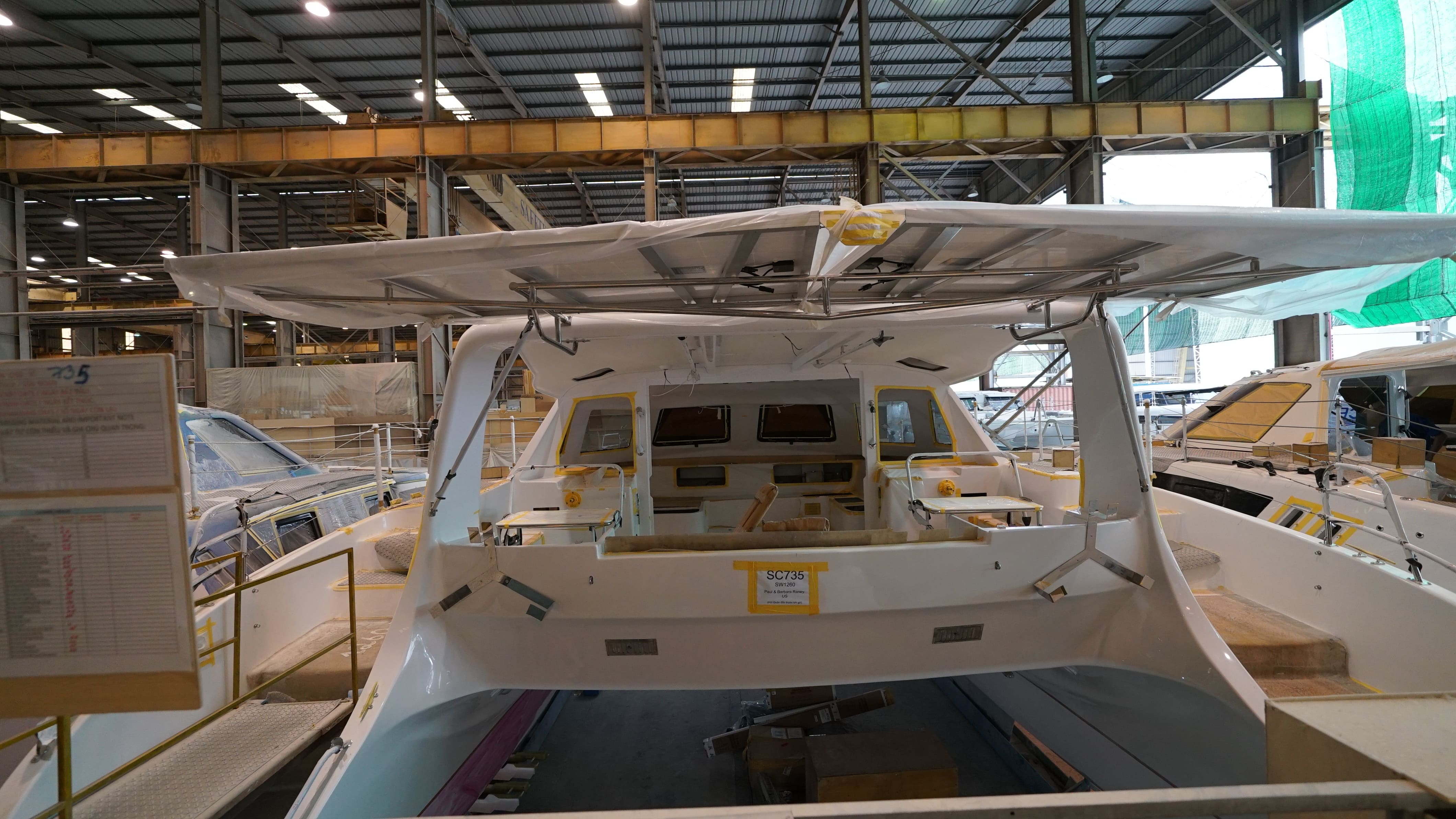

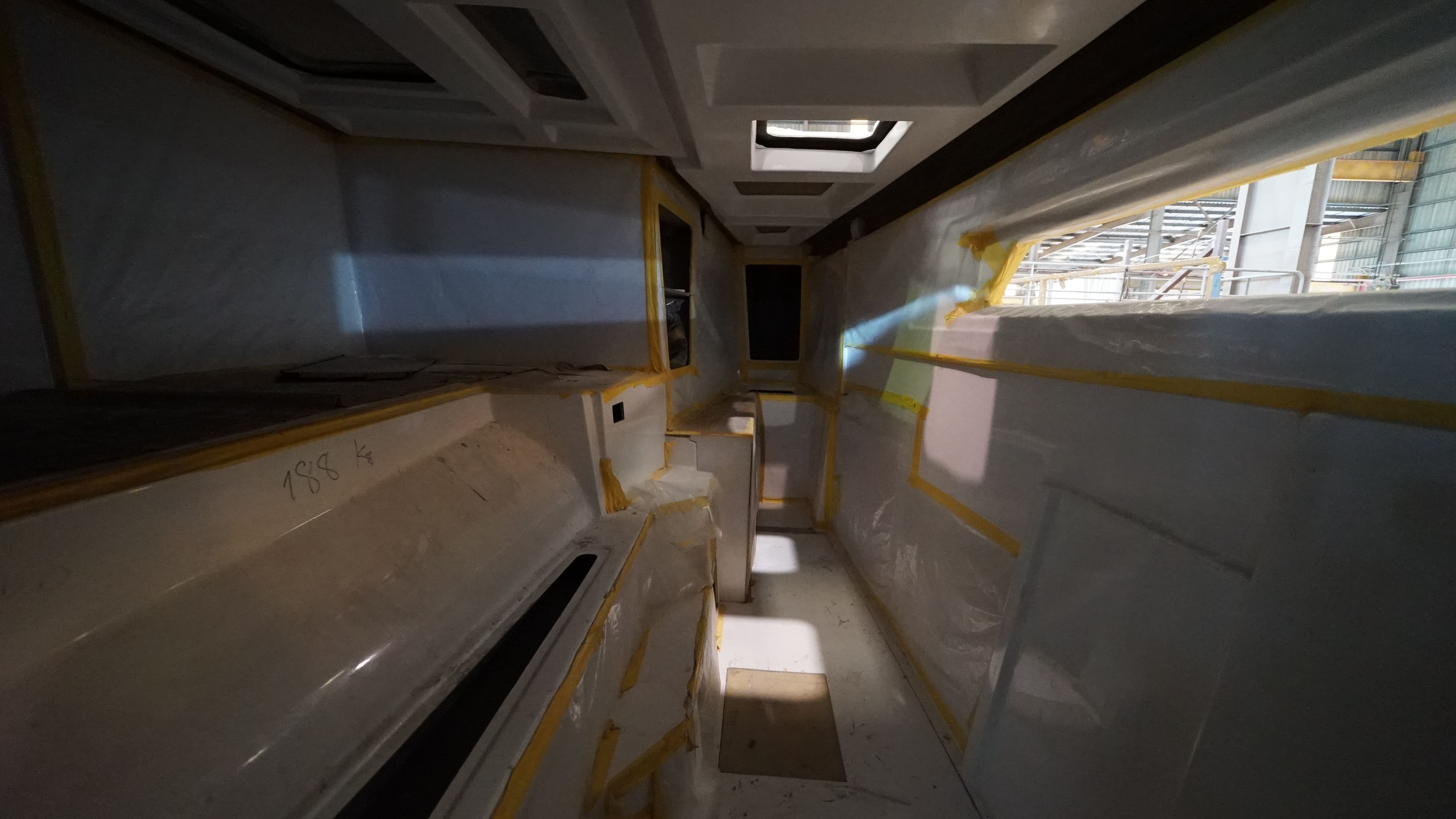

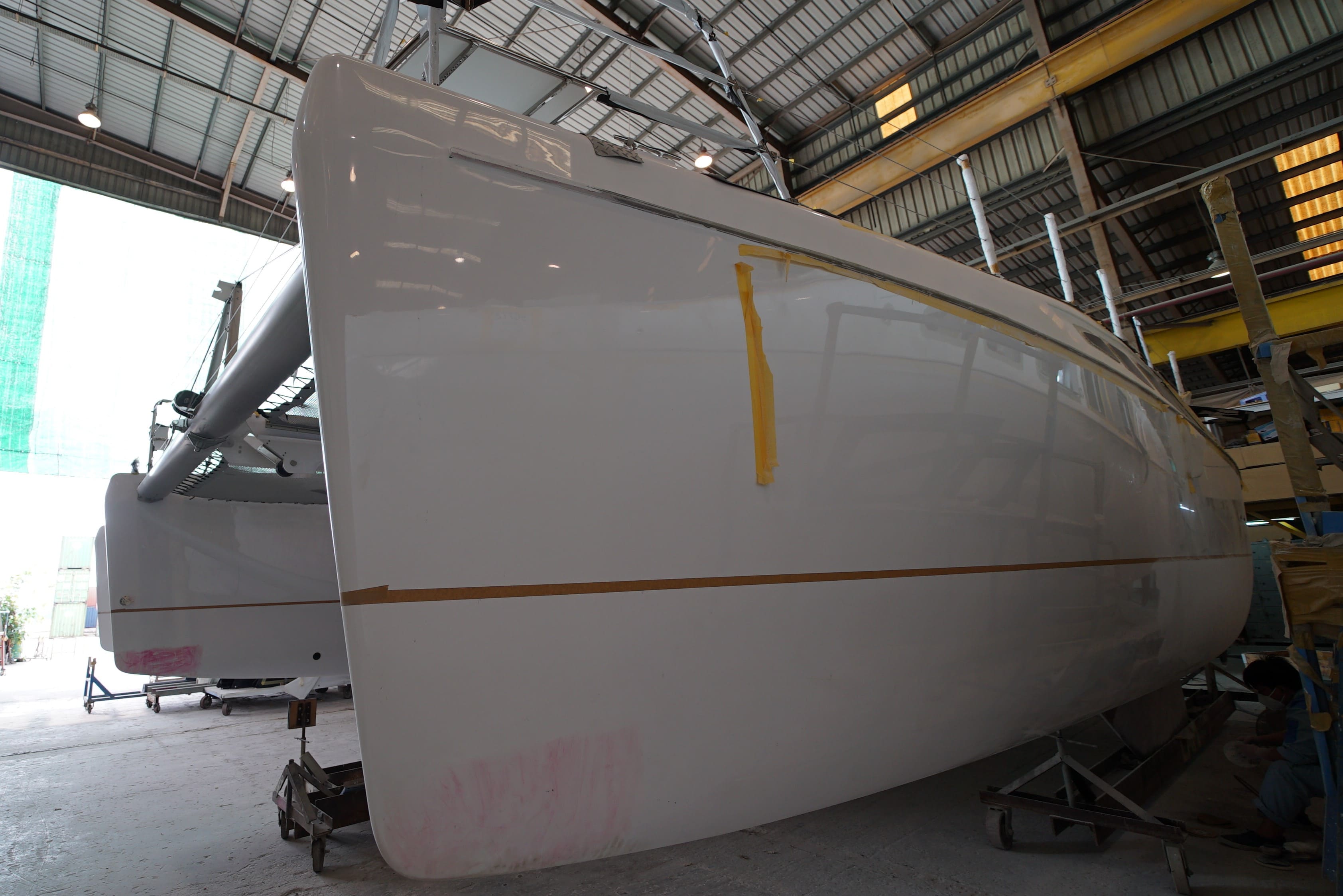

Production Update – Assembly

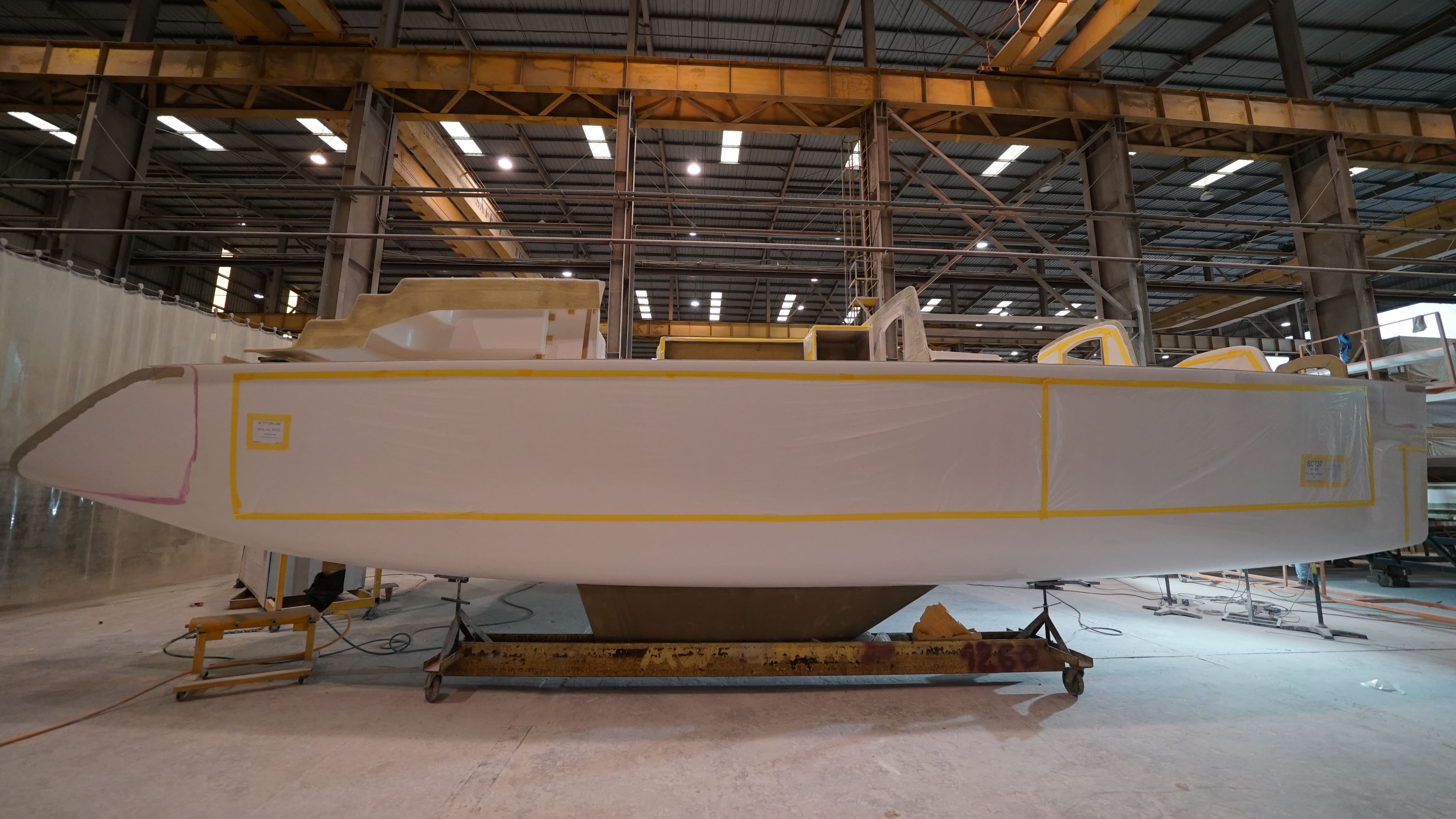

We are excited to inform you that your boat is progressing well in the Assembly stage.

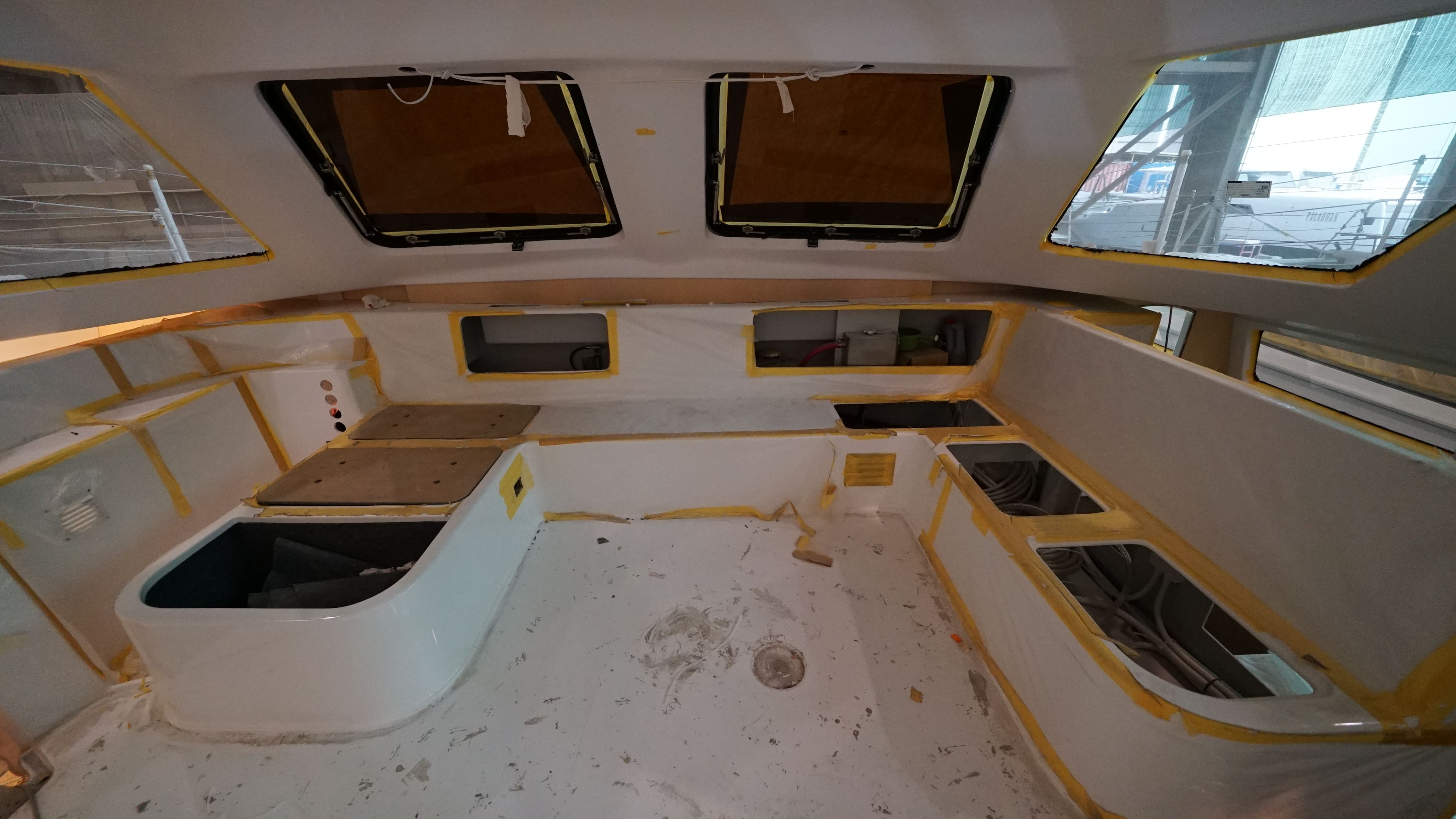

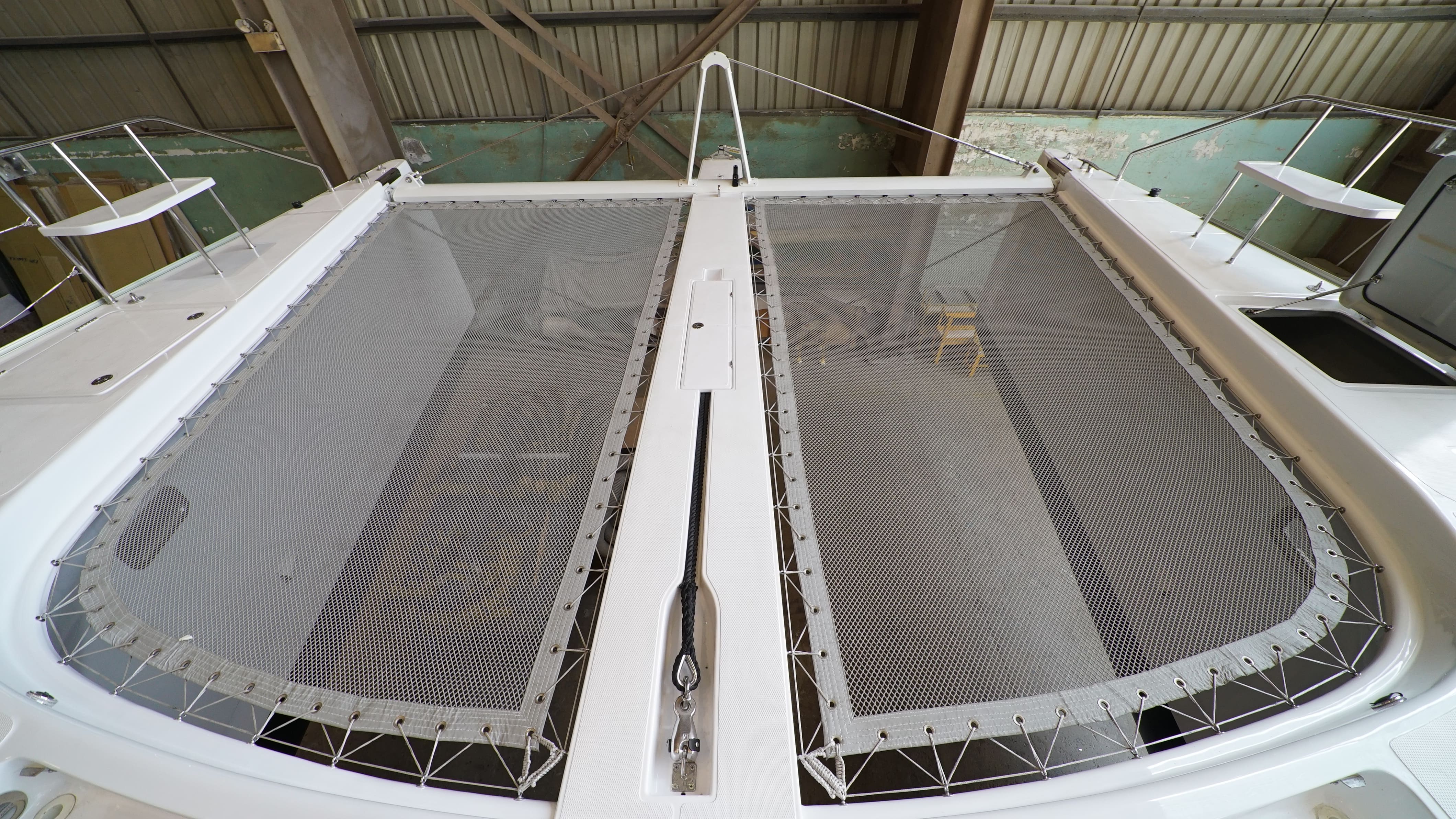

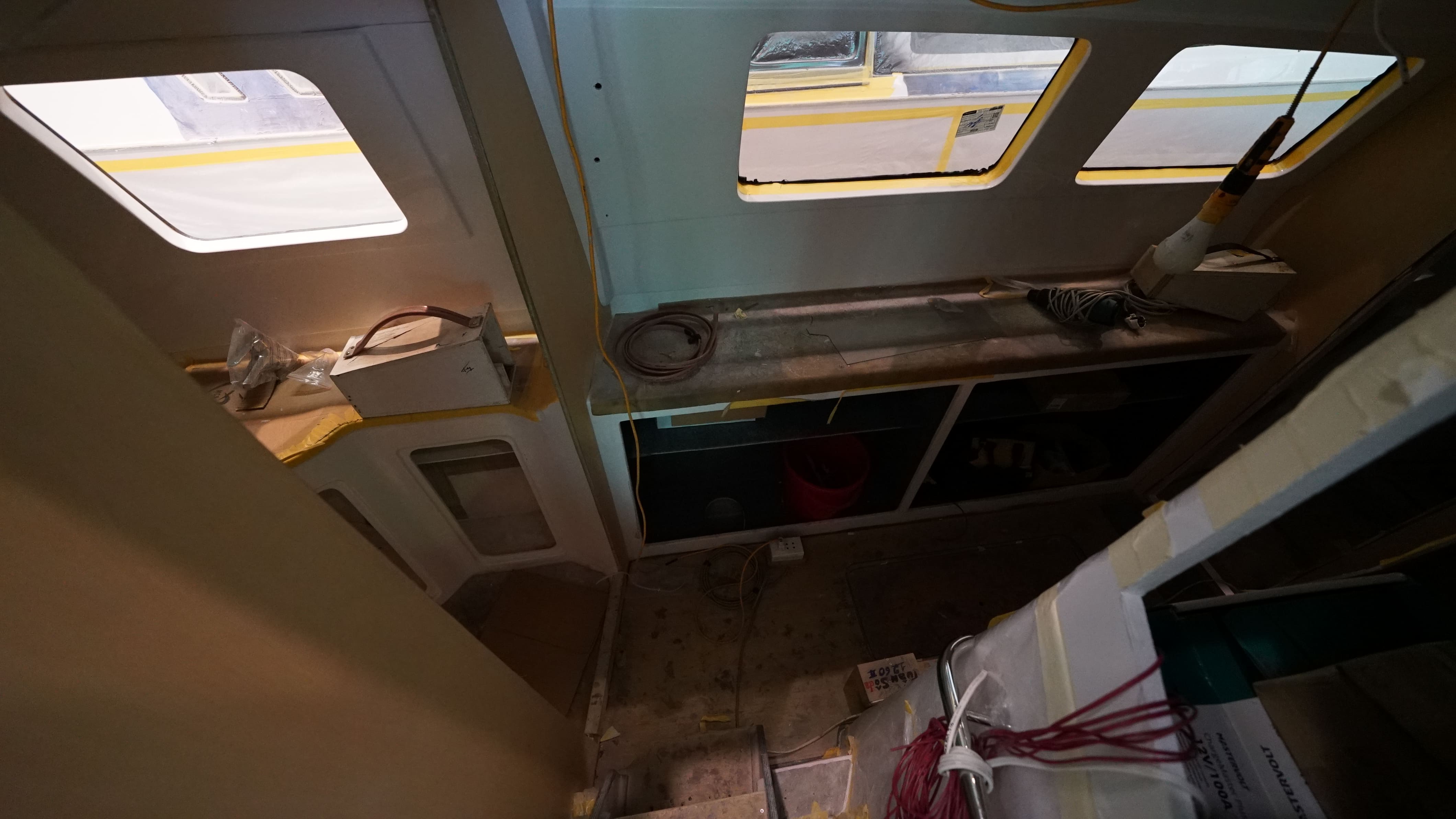

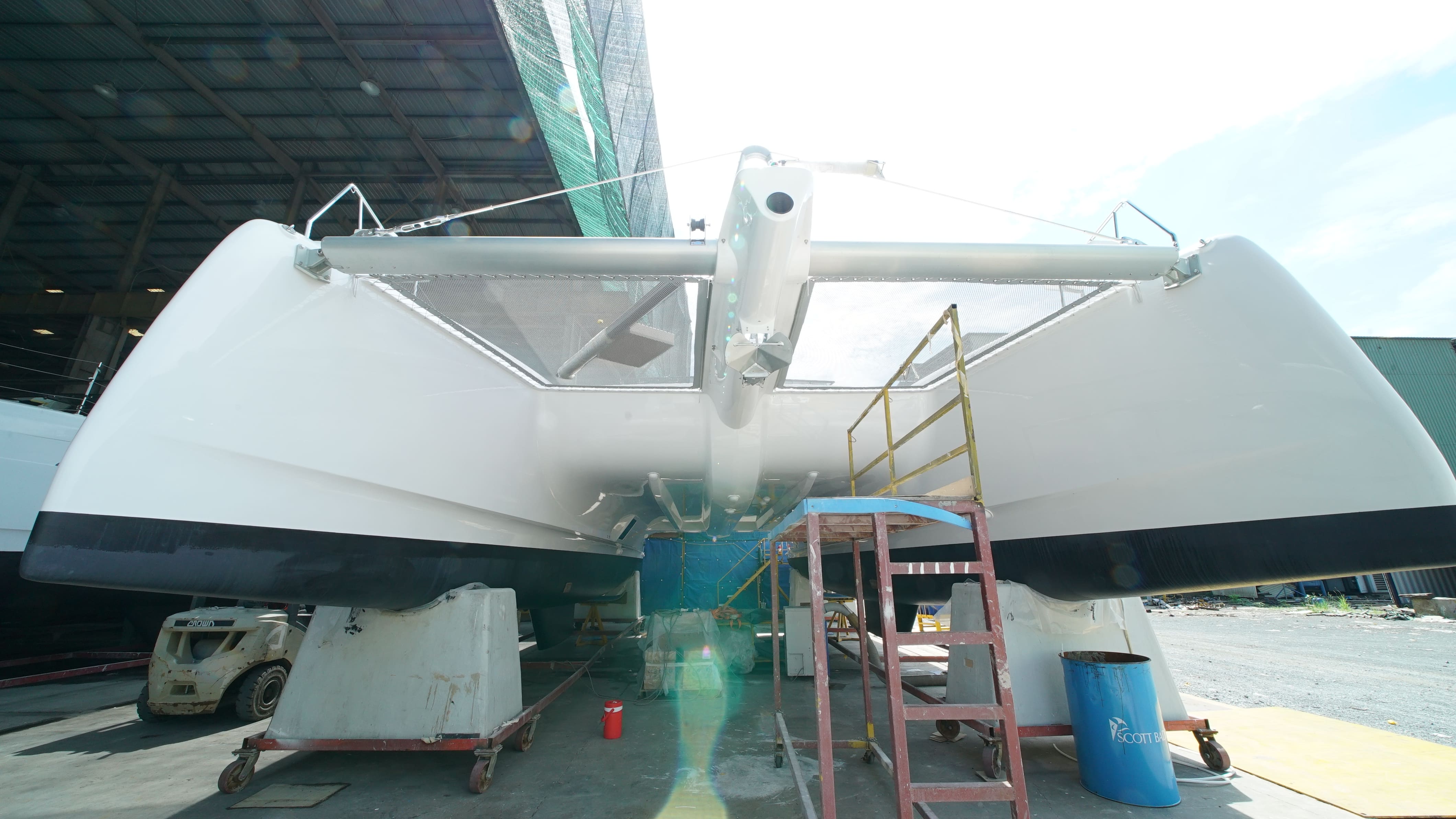

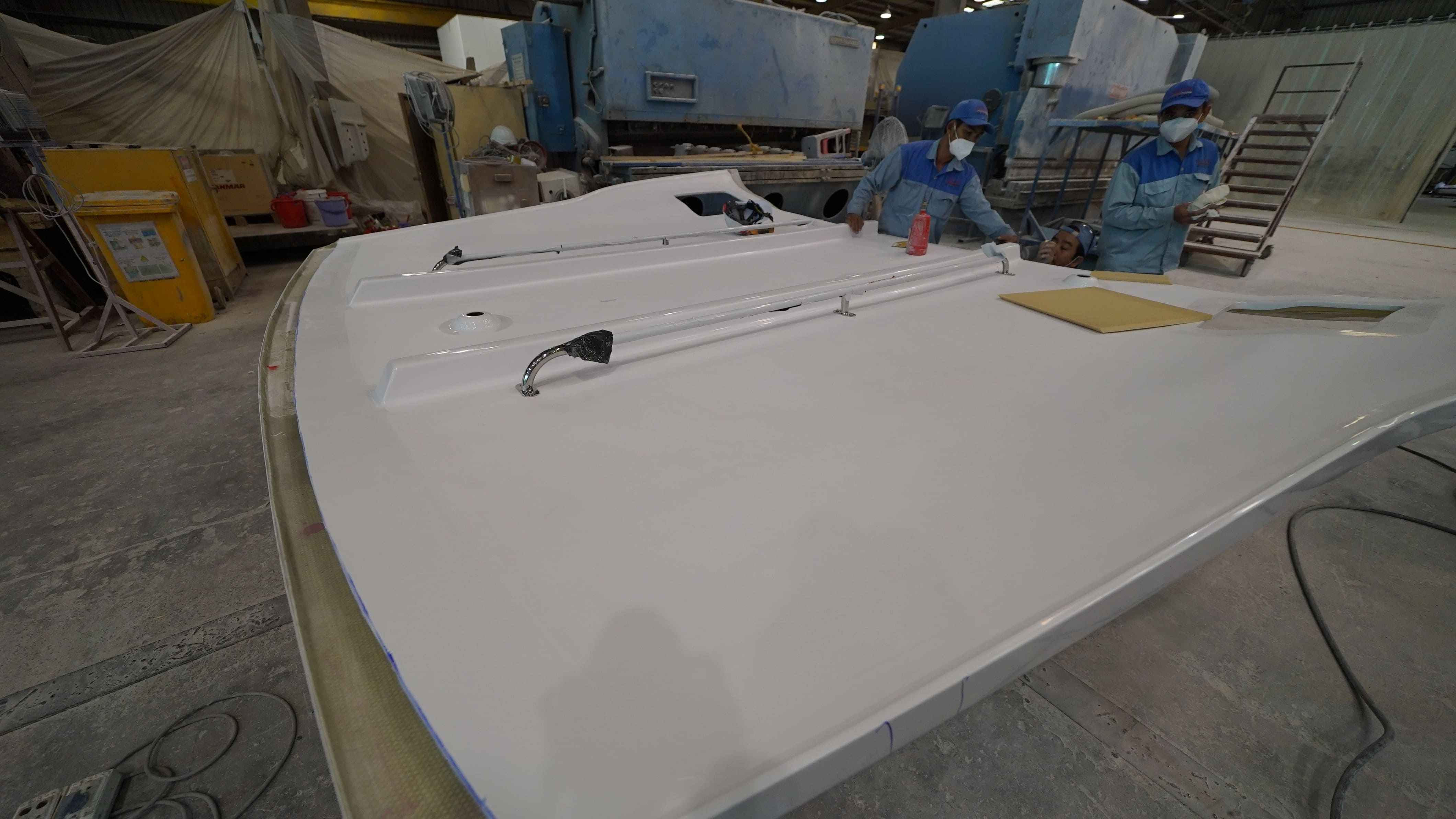

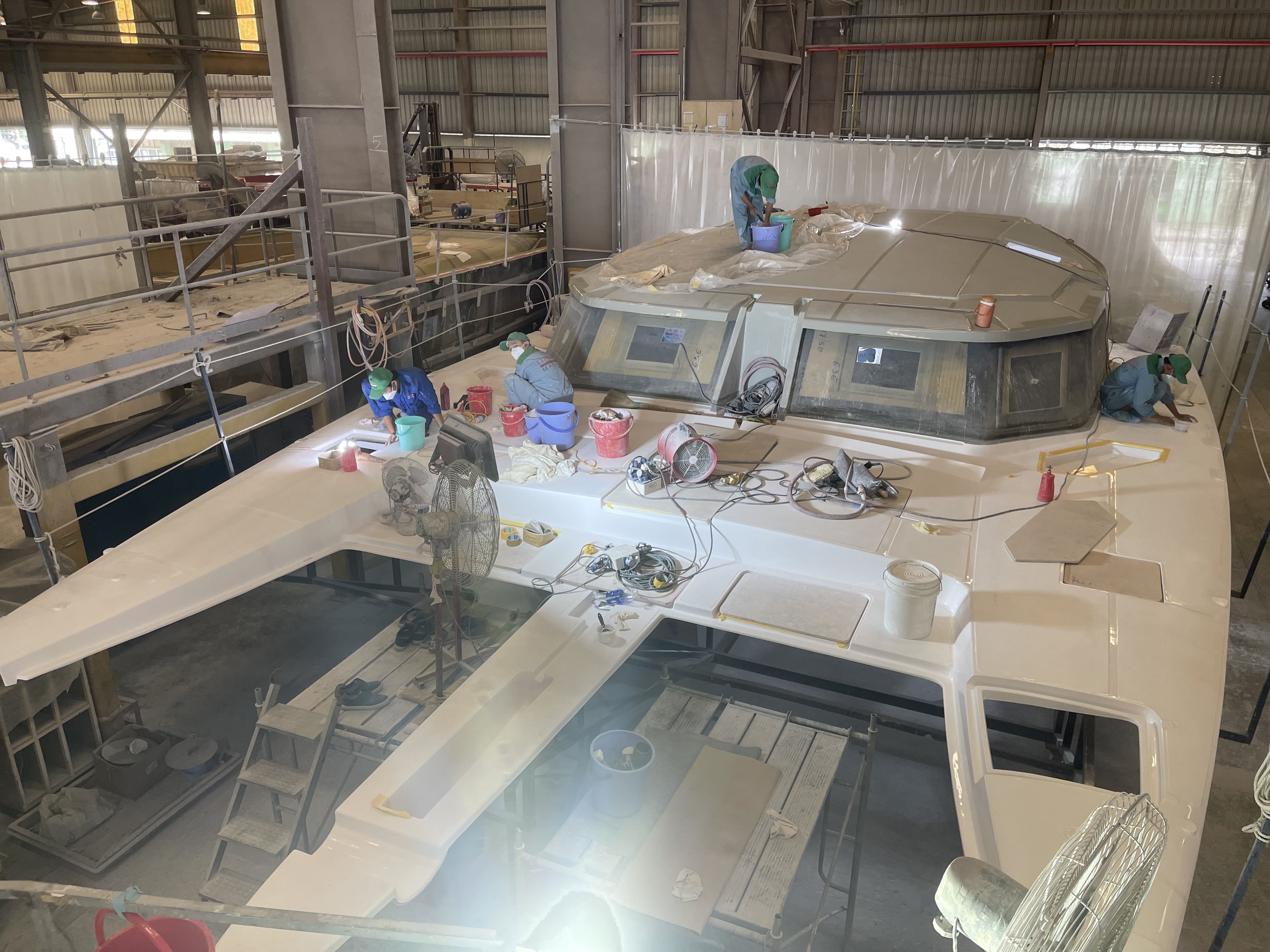

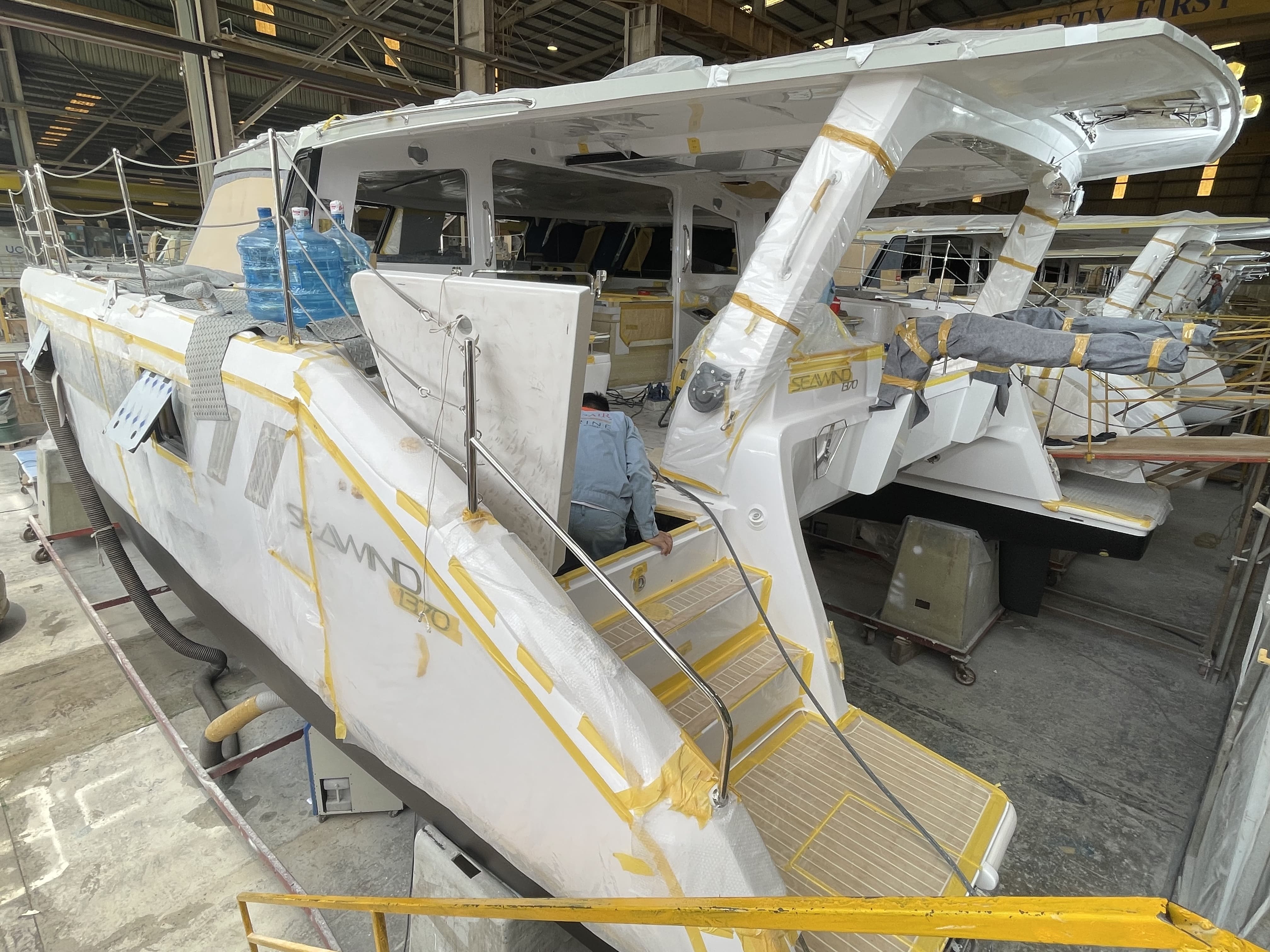

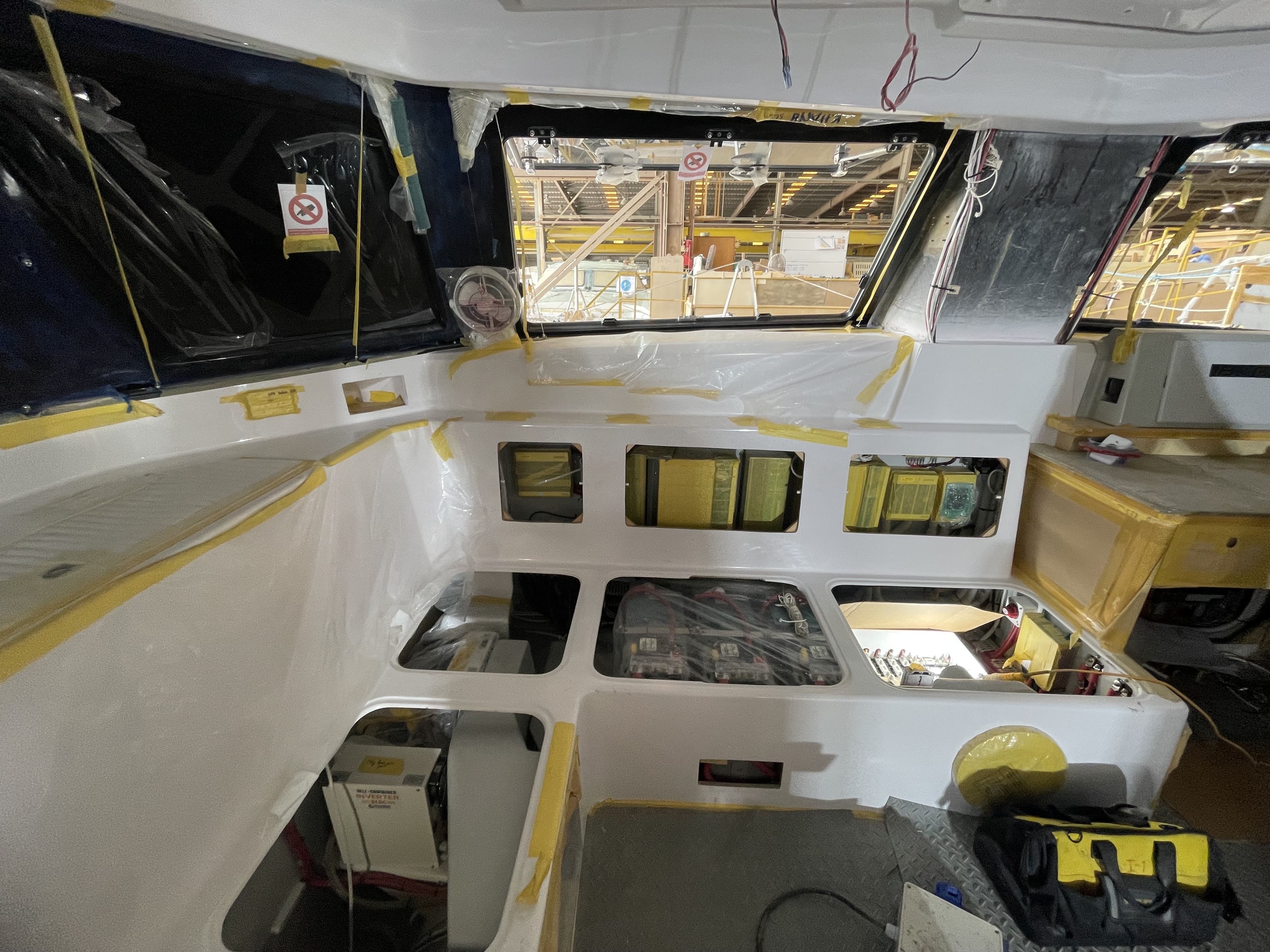

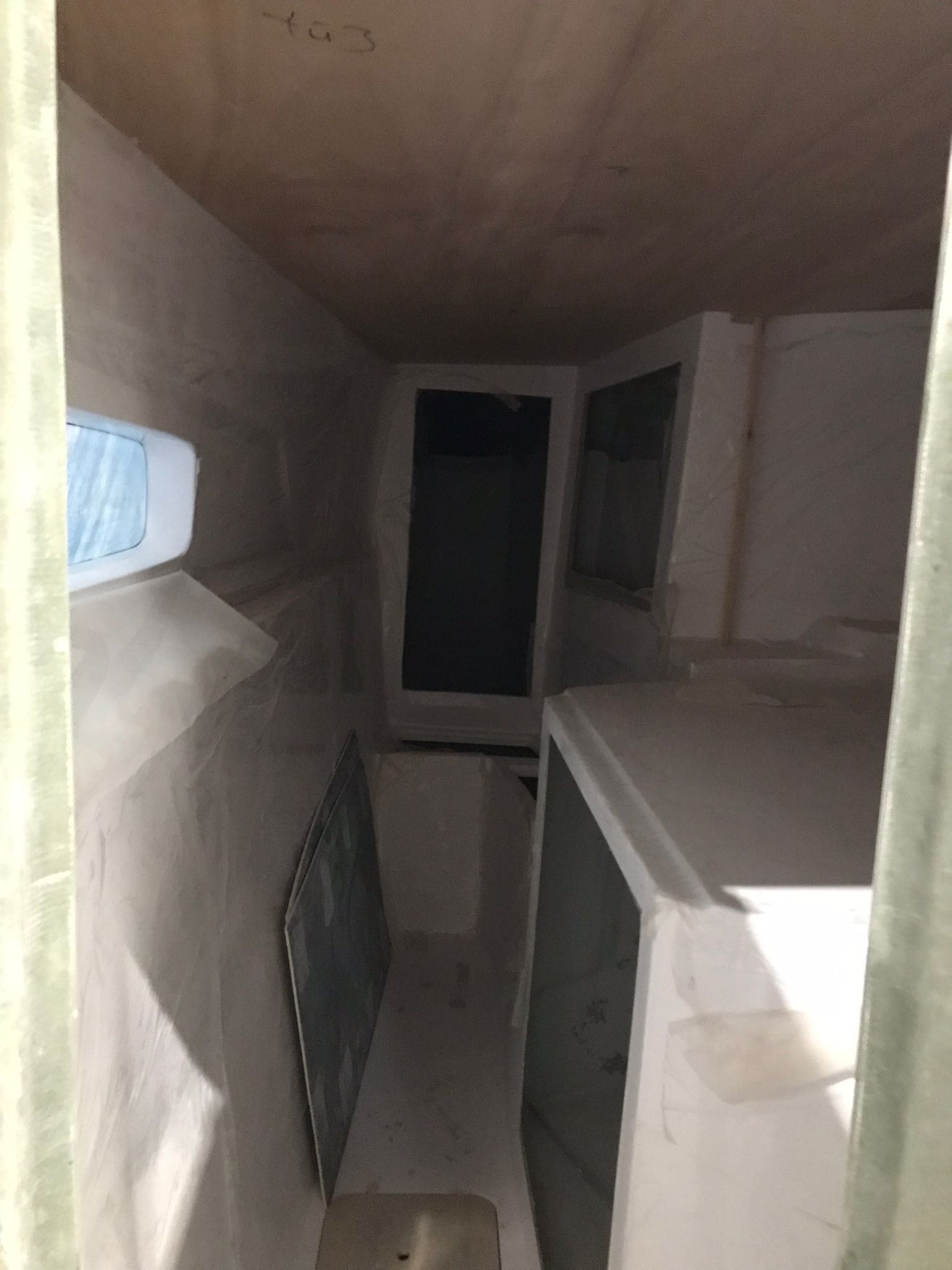

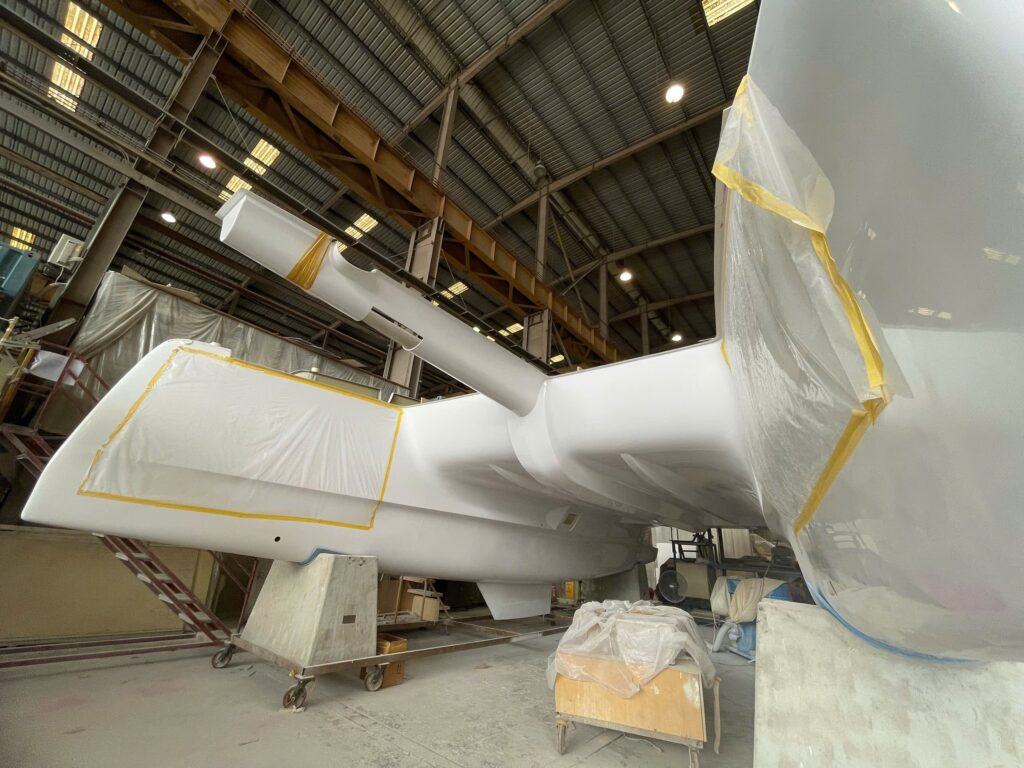

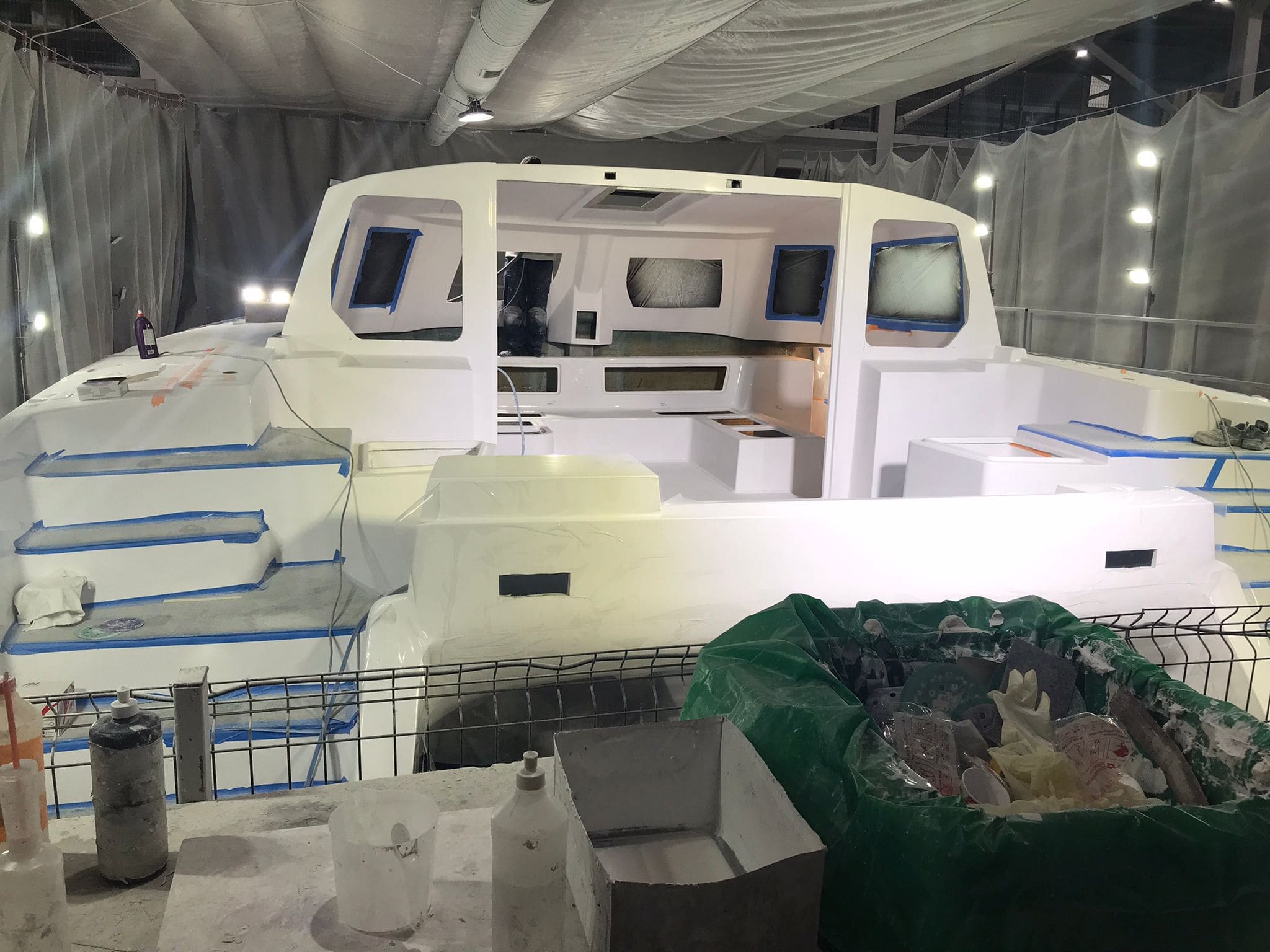

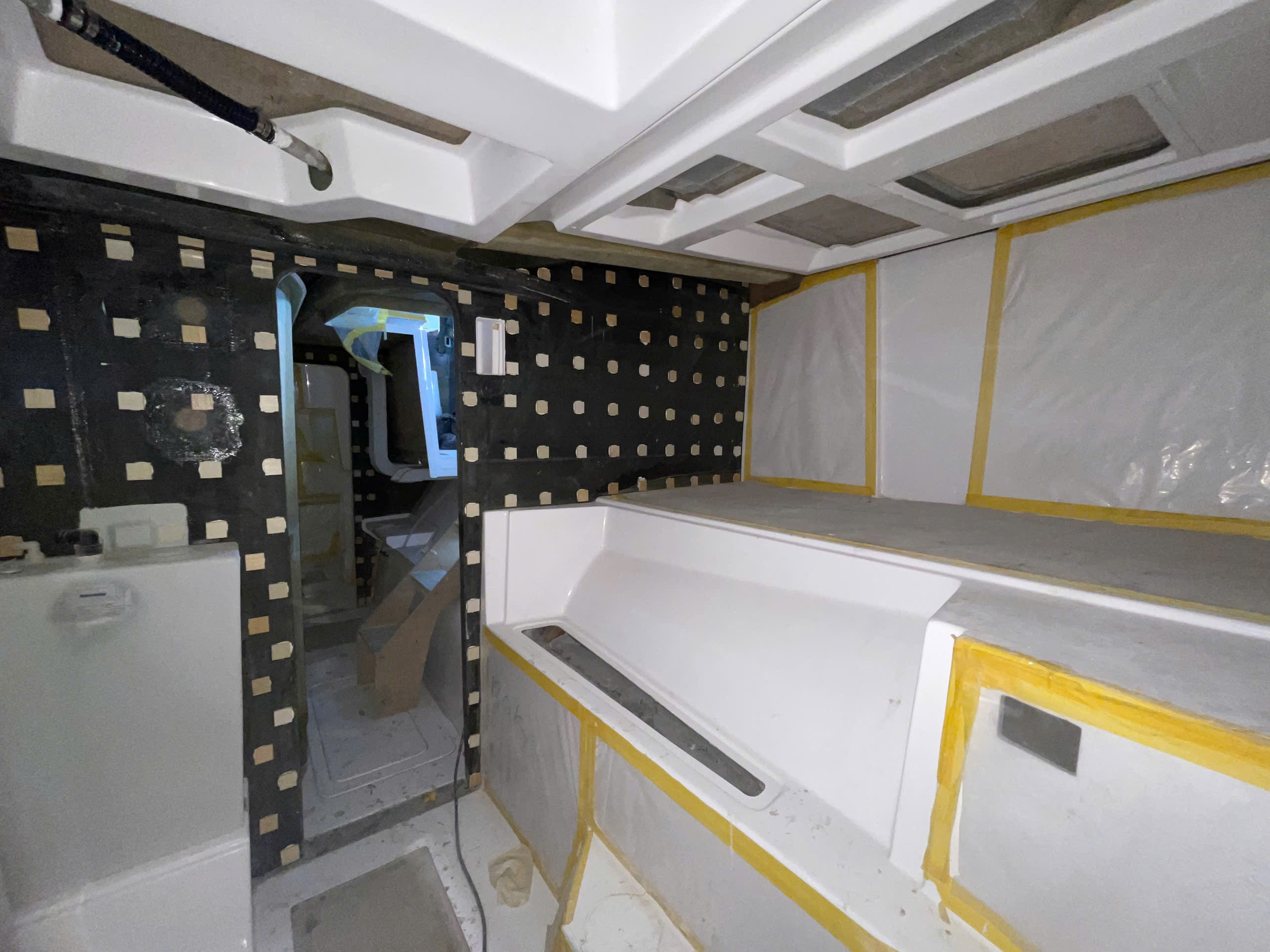

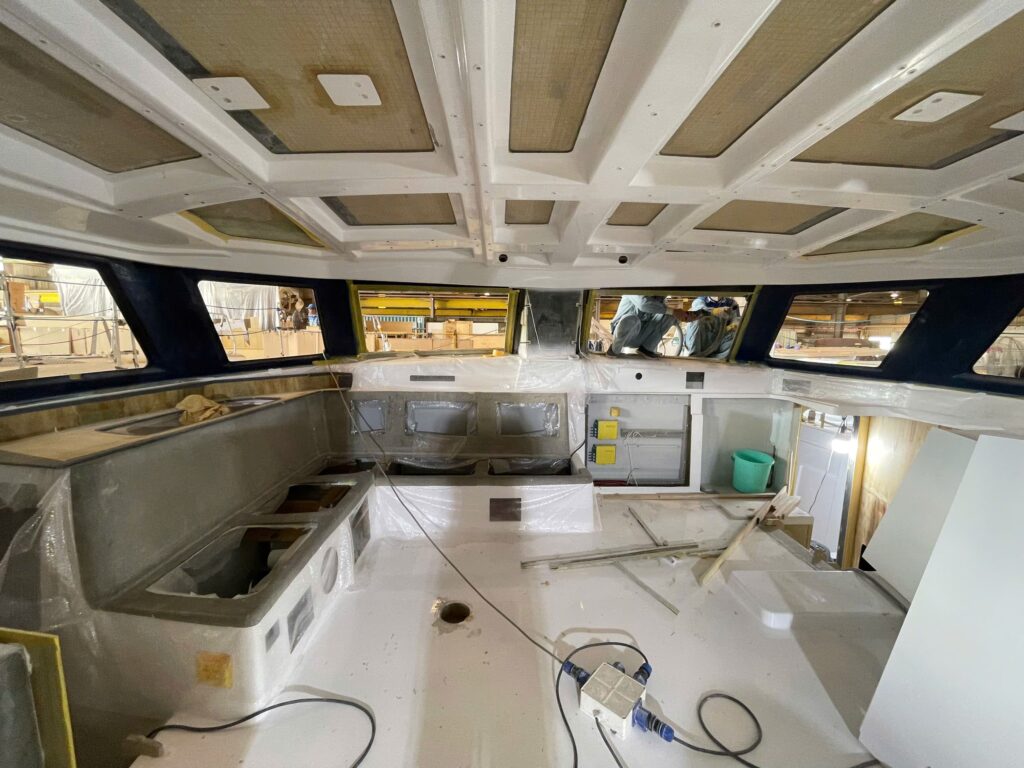

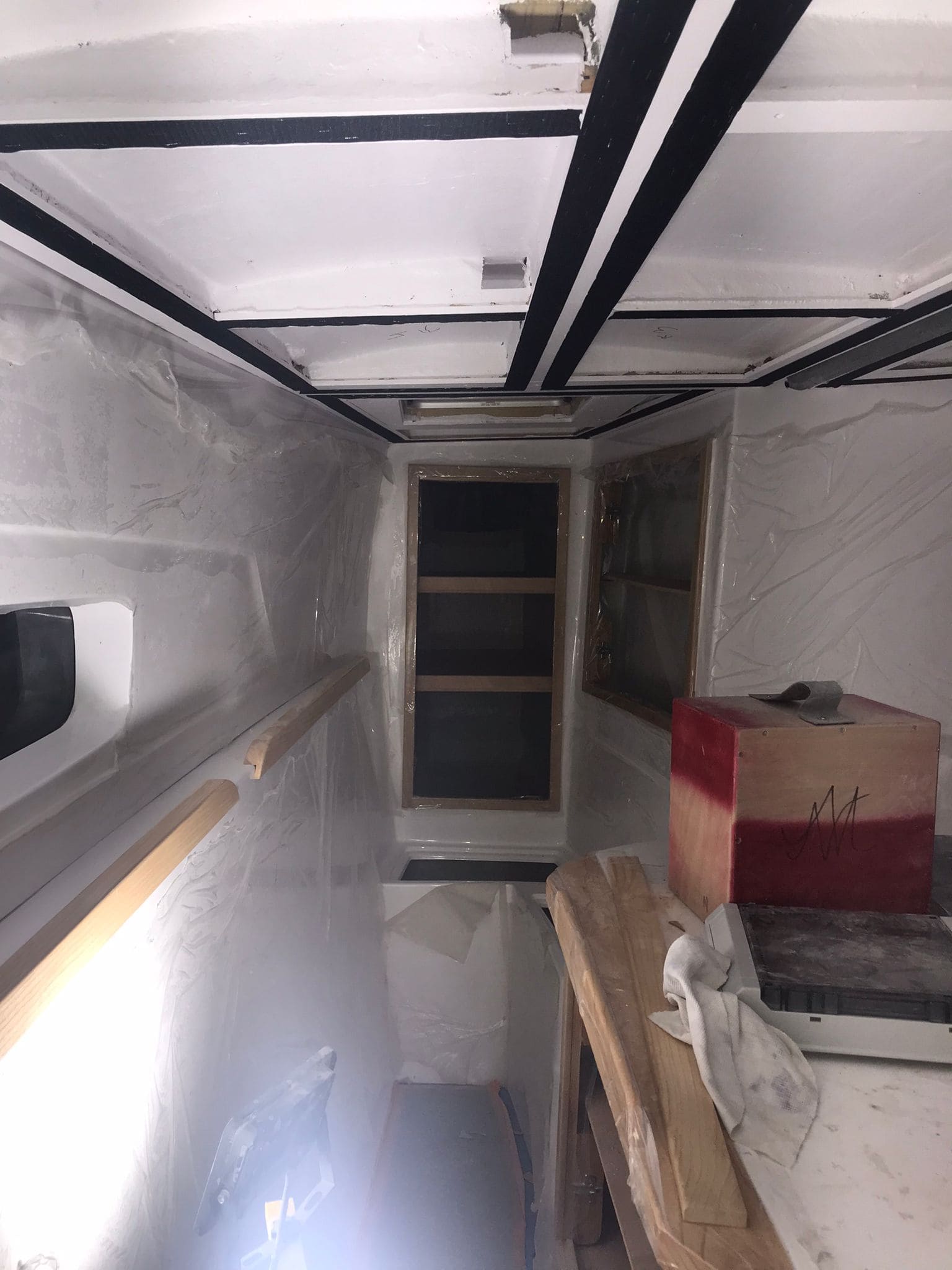

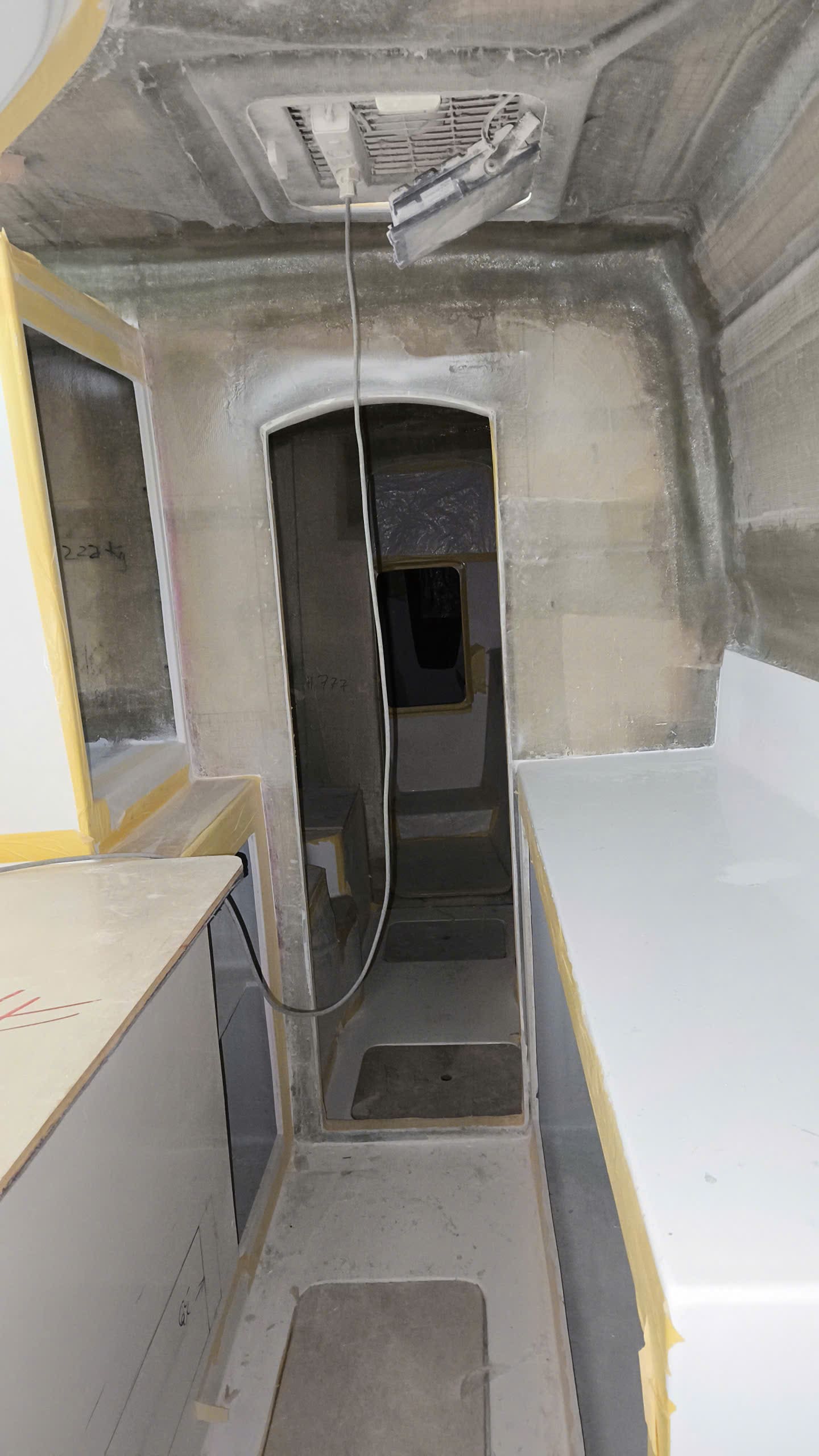

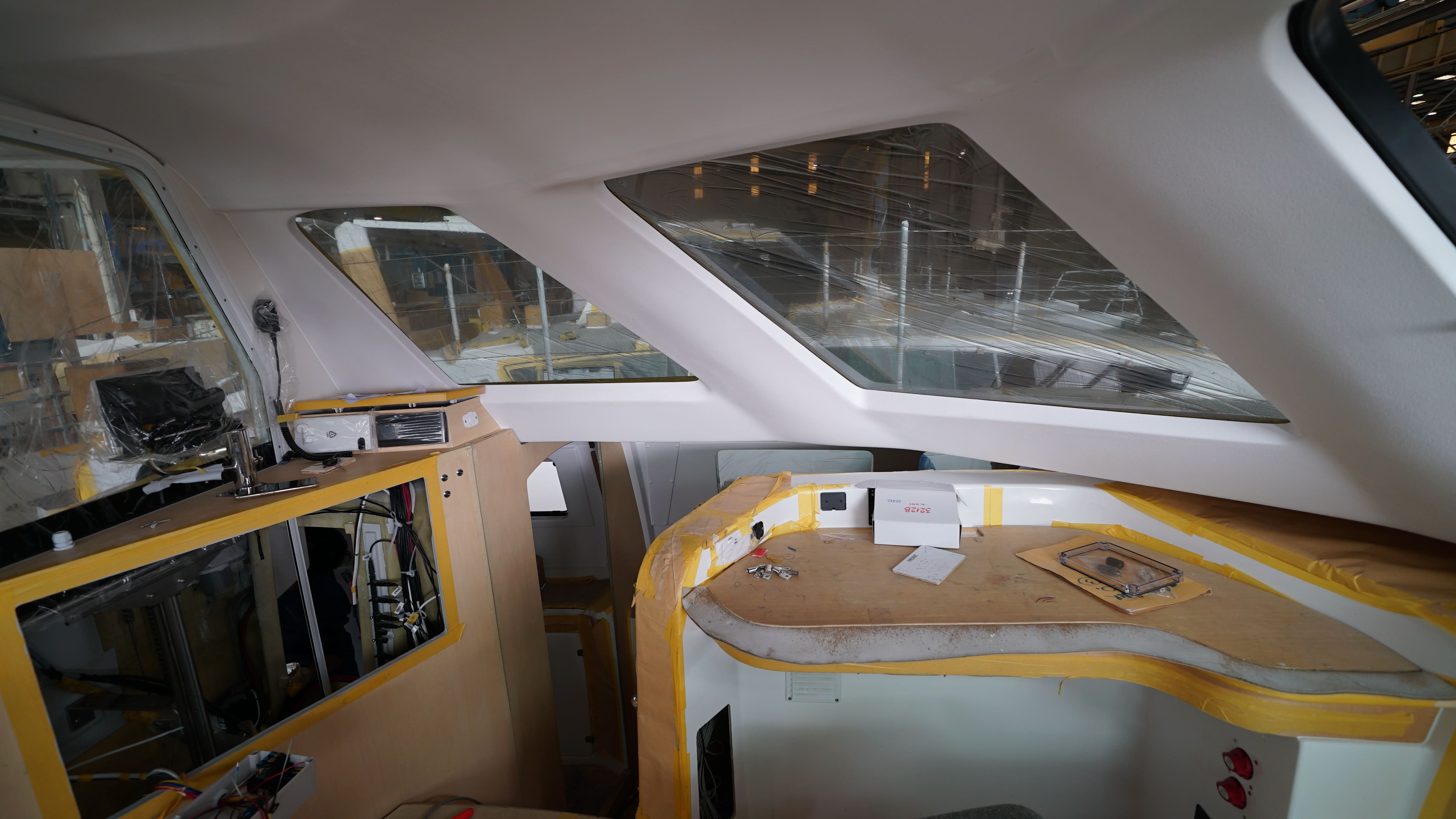

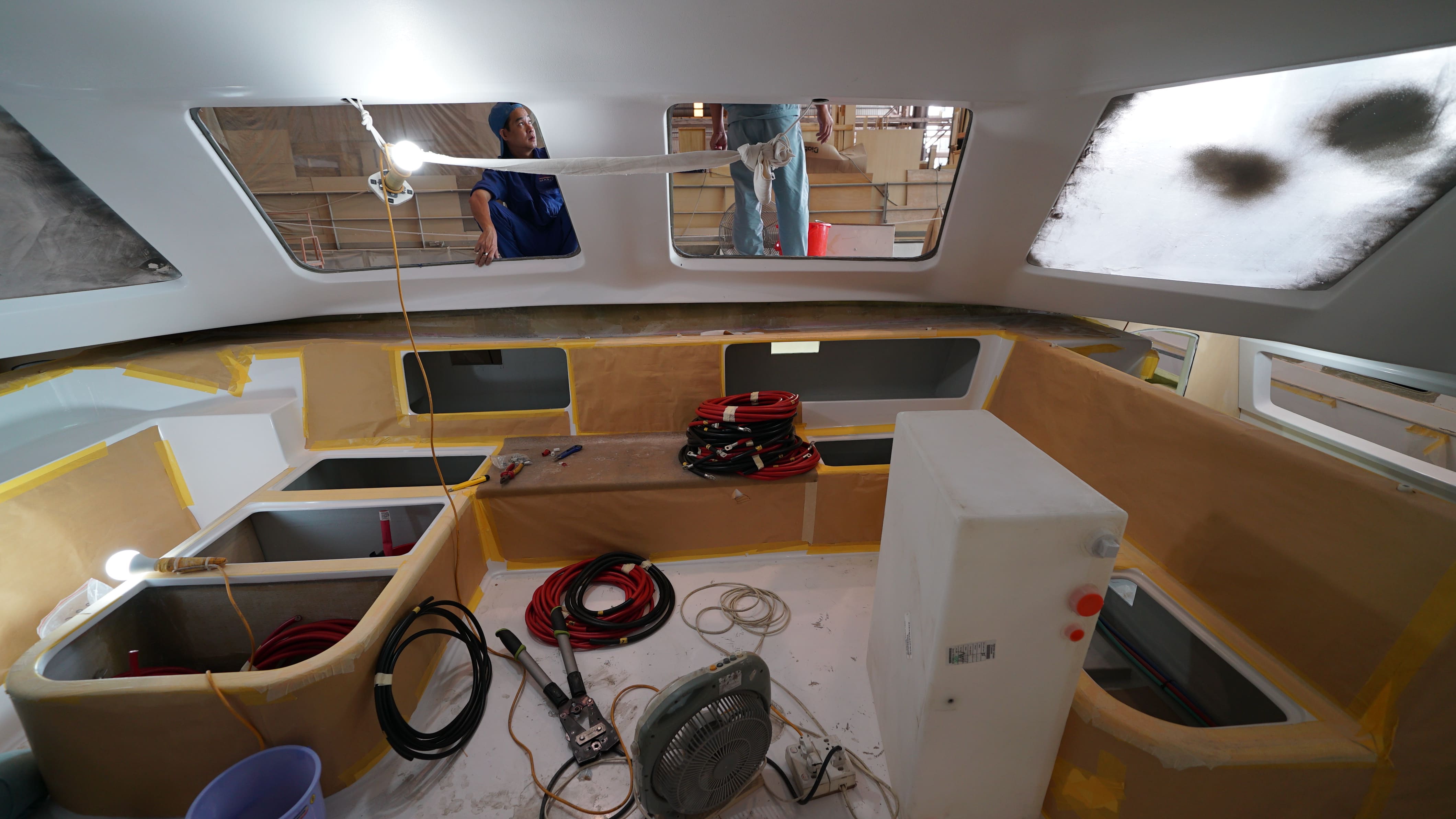

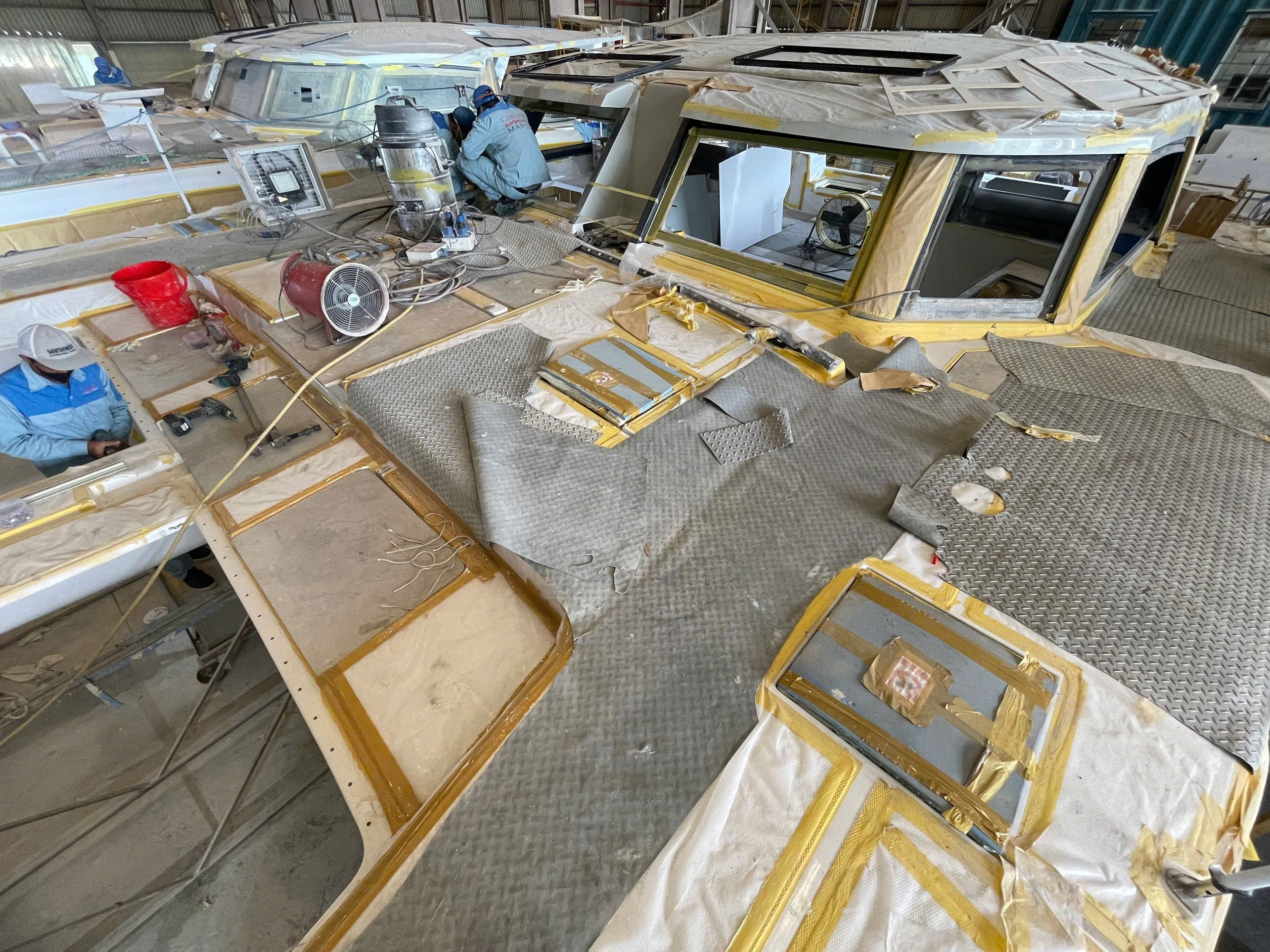

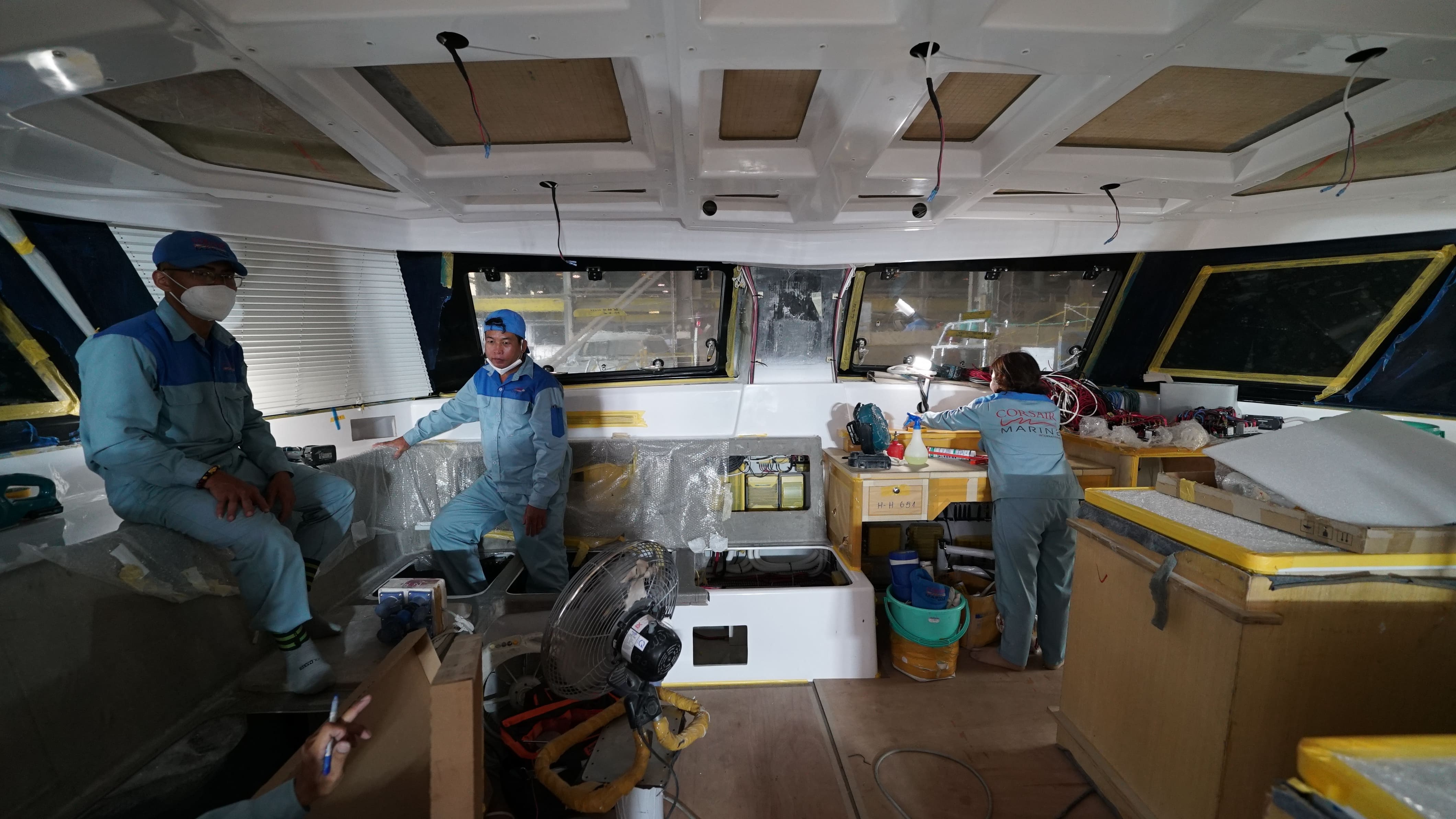

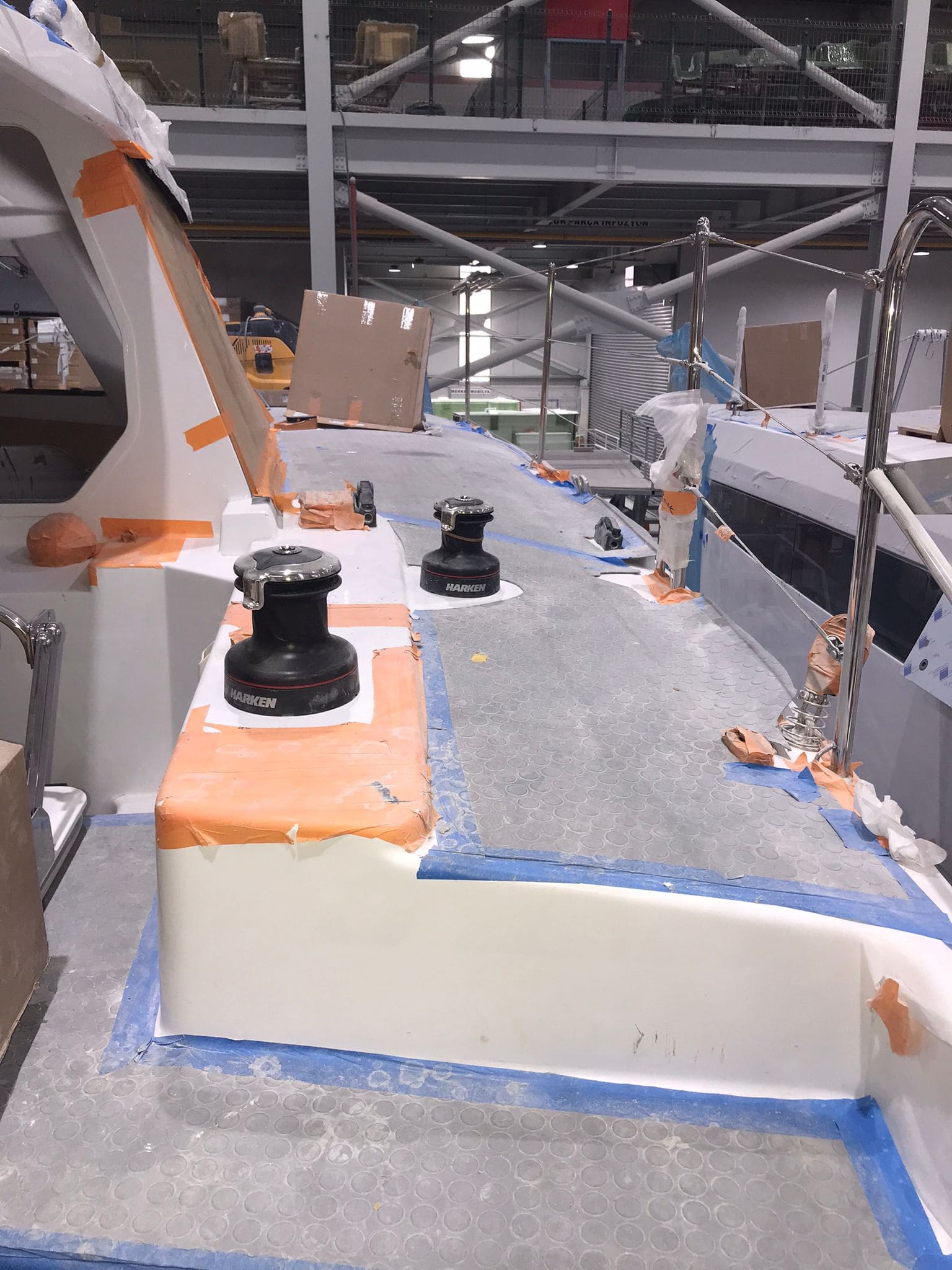

The hull and deck components have now been completed, with the interior modules properly installed and secured. Our Production team is currently carrying out the final preparations and checks to ensure everything is properly aligned and ready for the next stage. The hull and deck joining is scheduled to take place over the next few days.

Production Update – Assembly

Your boat is progressing well in the Assembly stage.

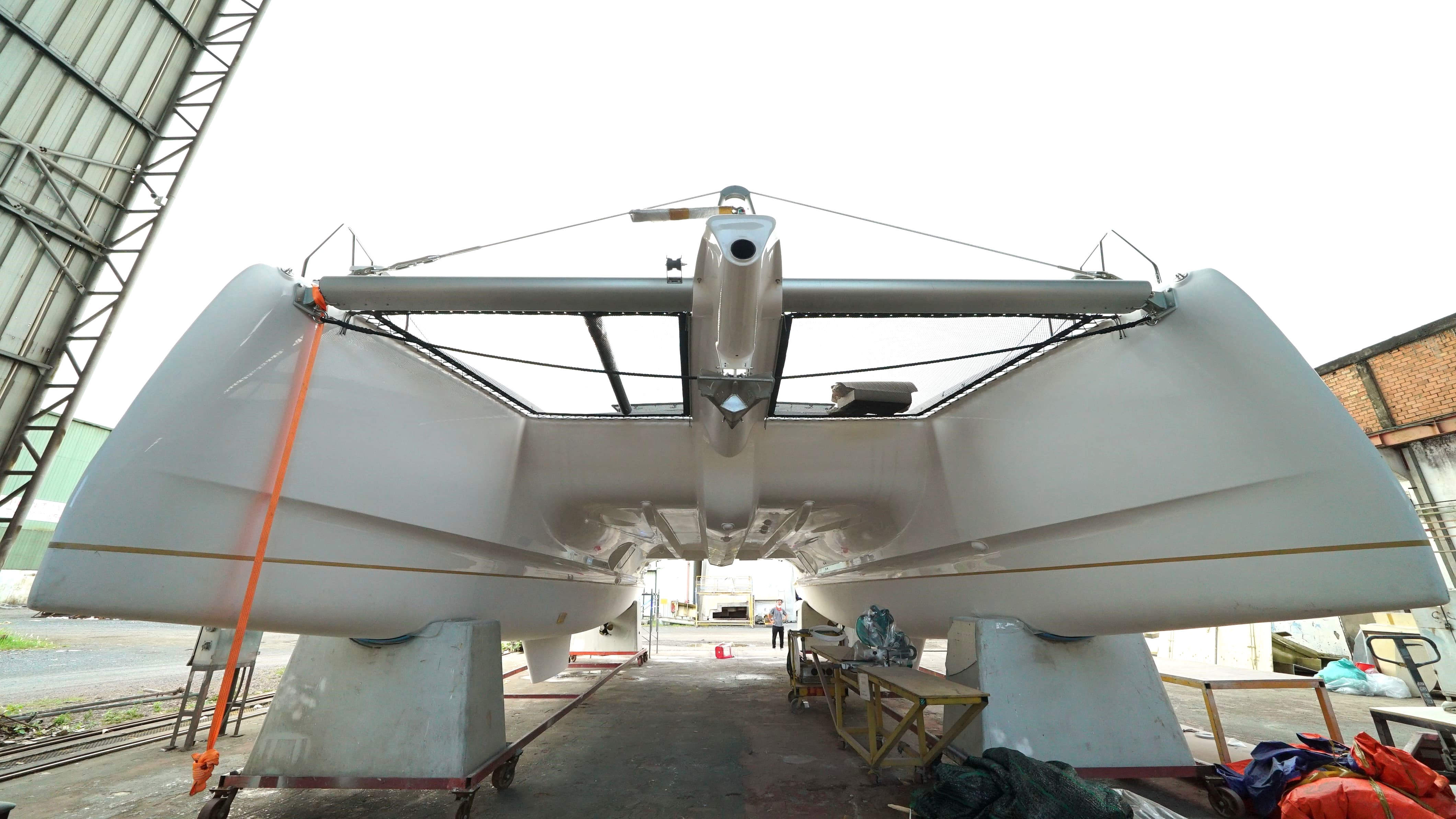

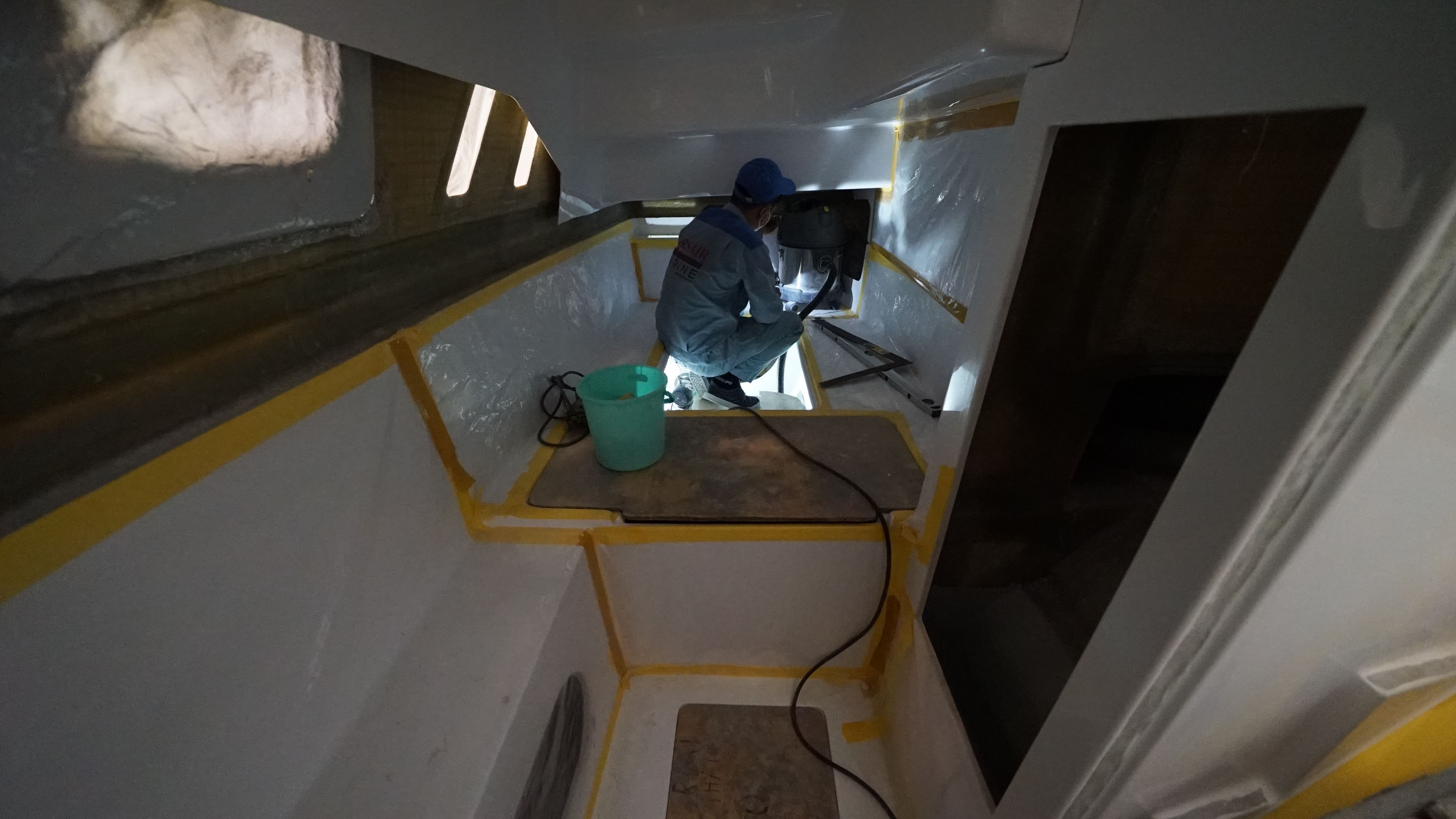

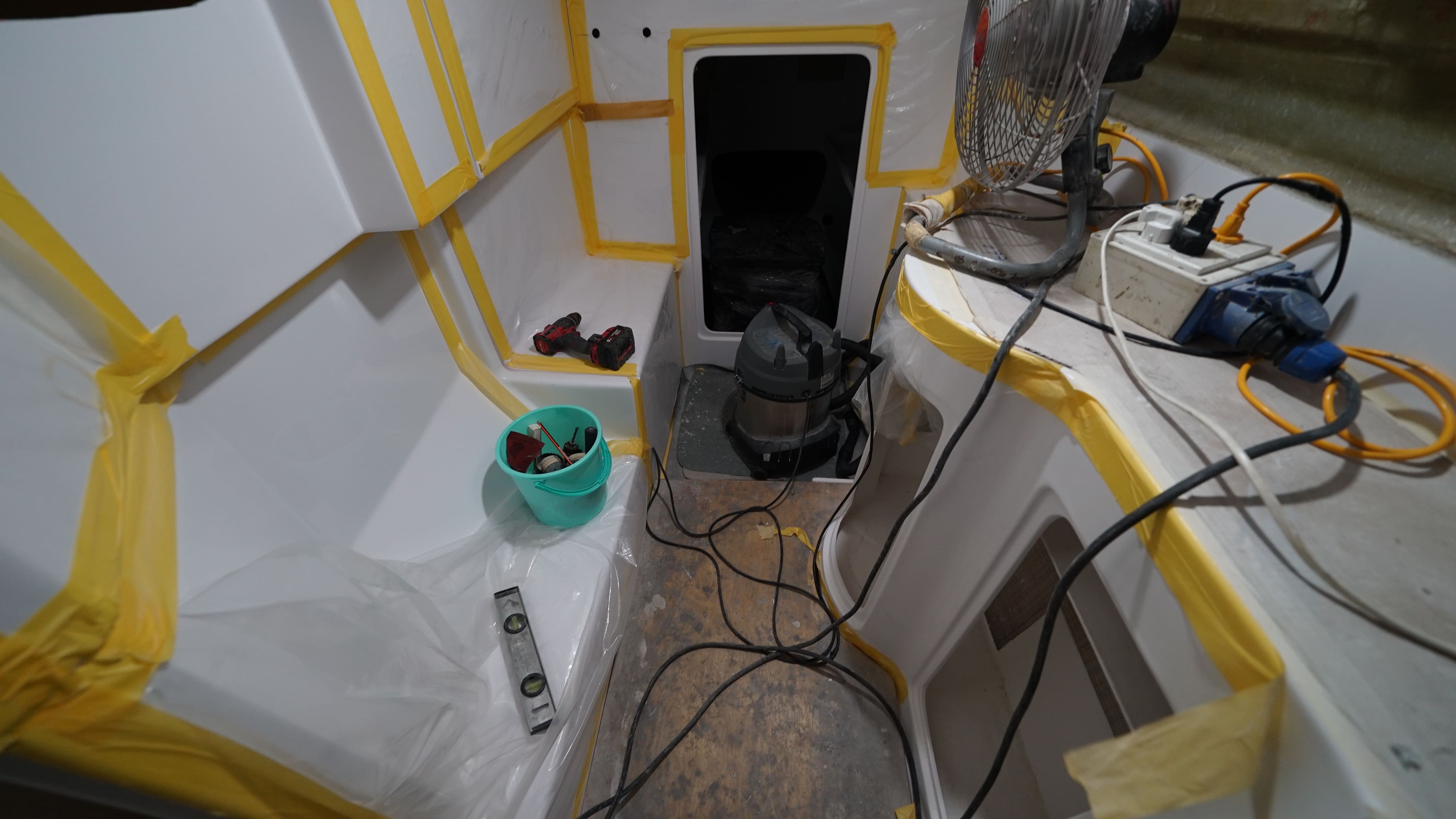

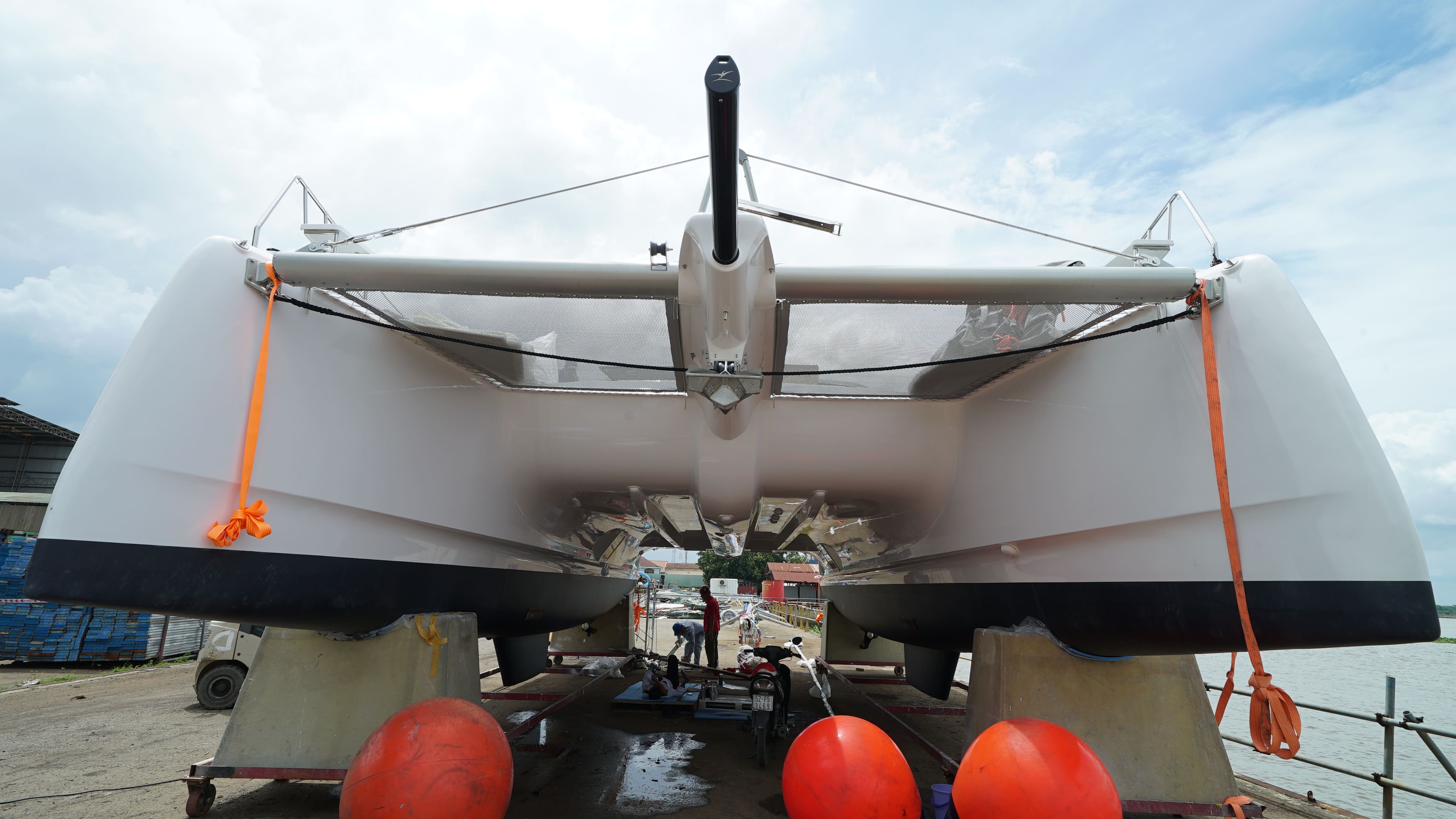

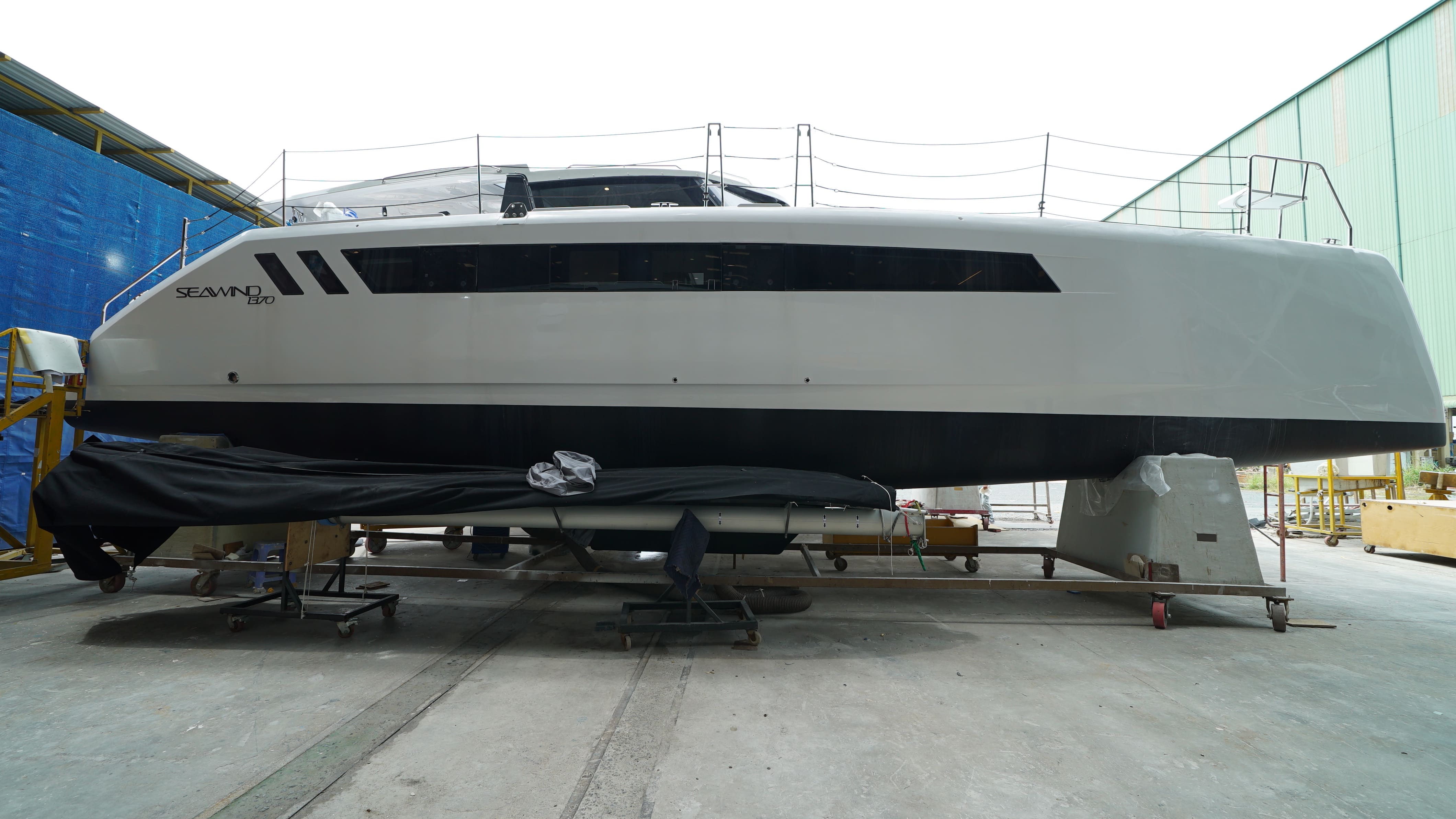

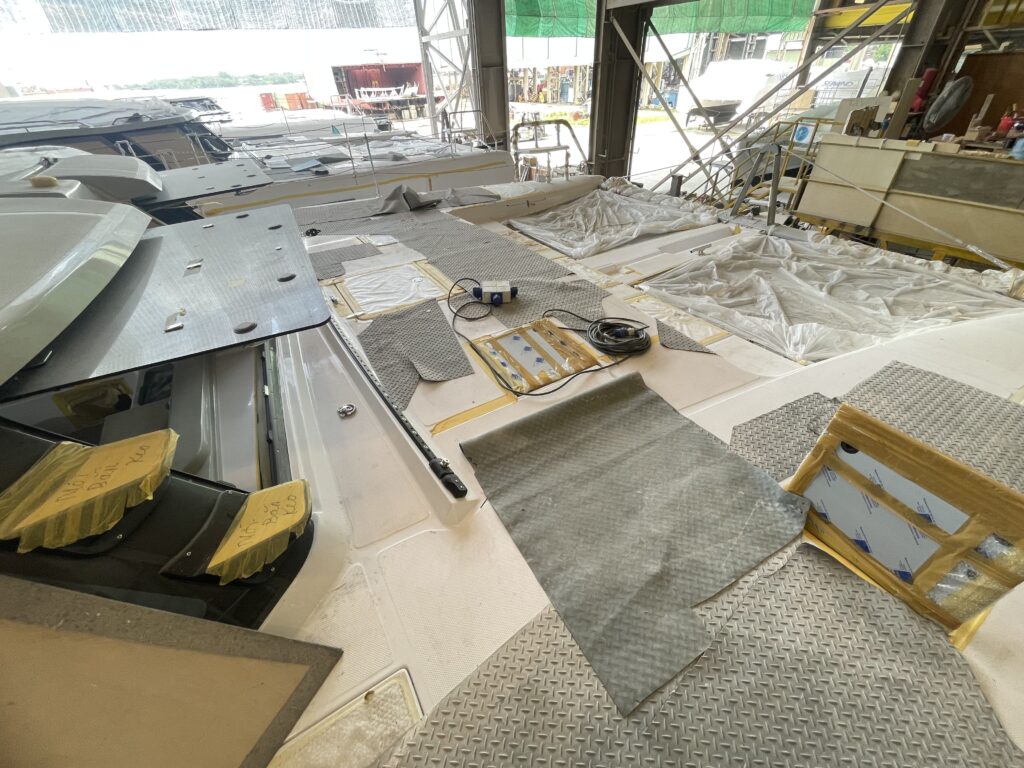

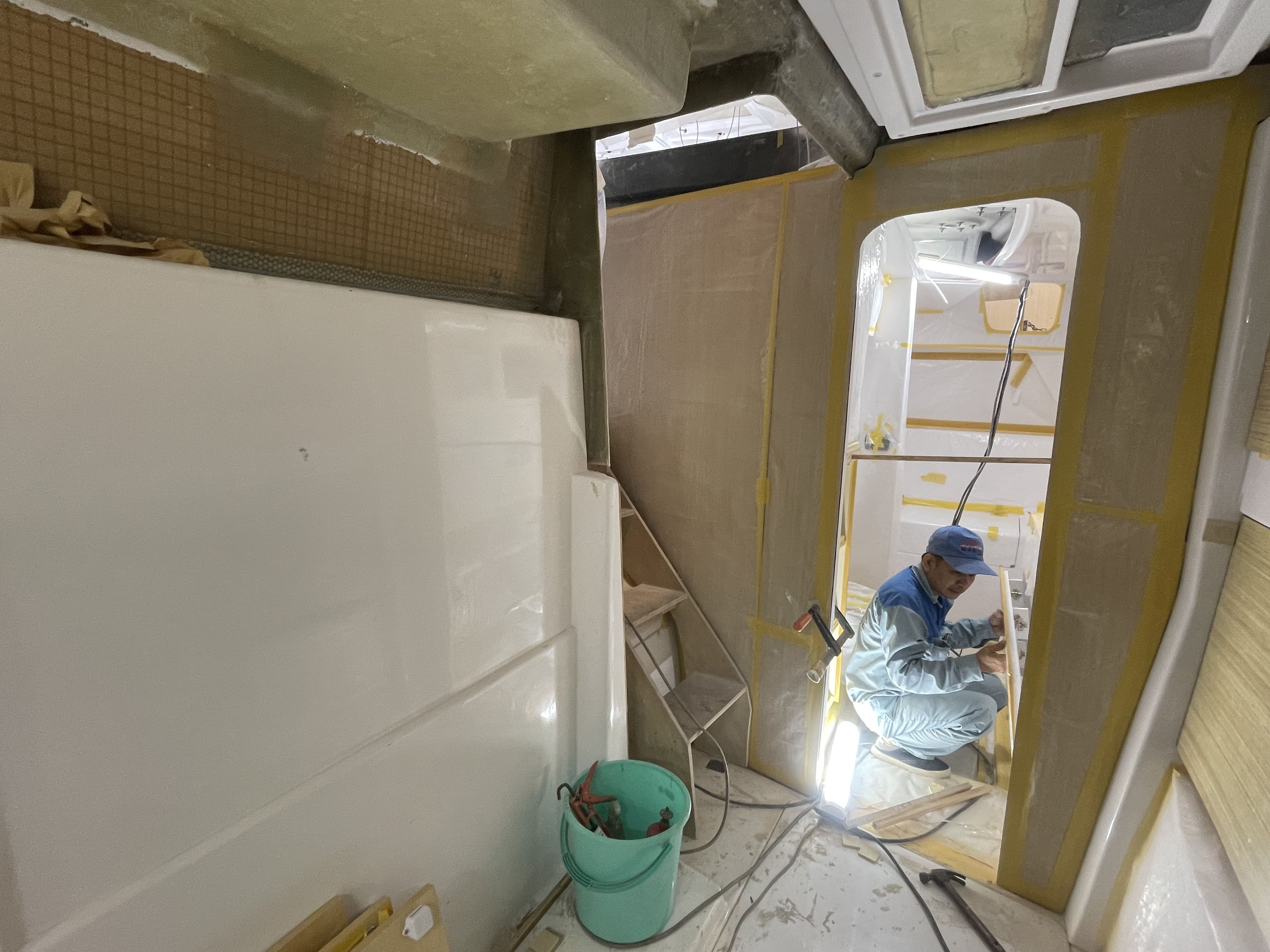

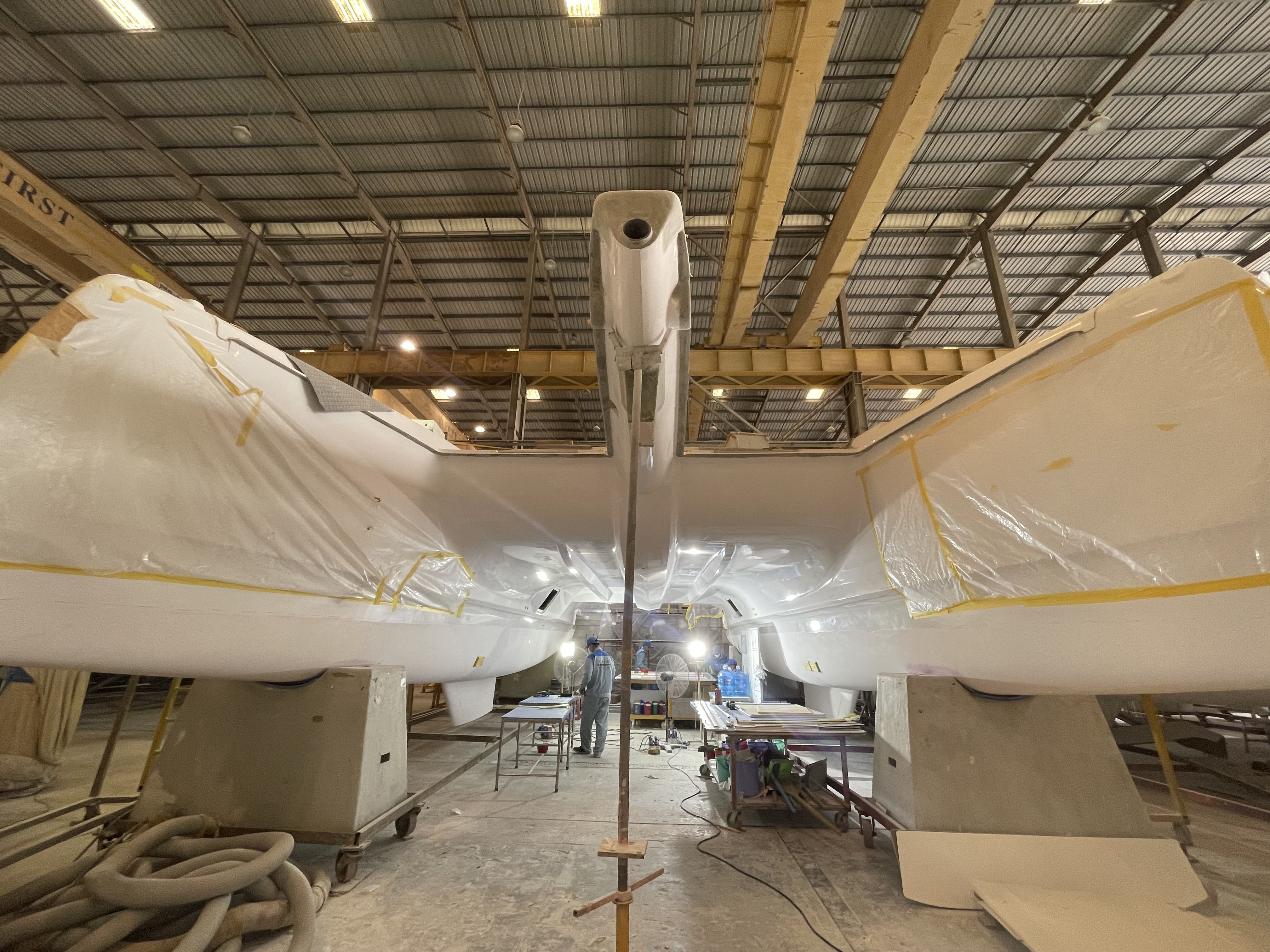

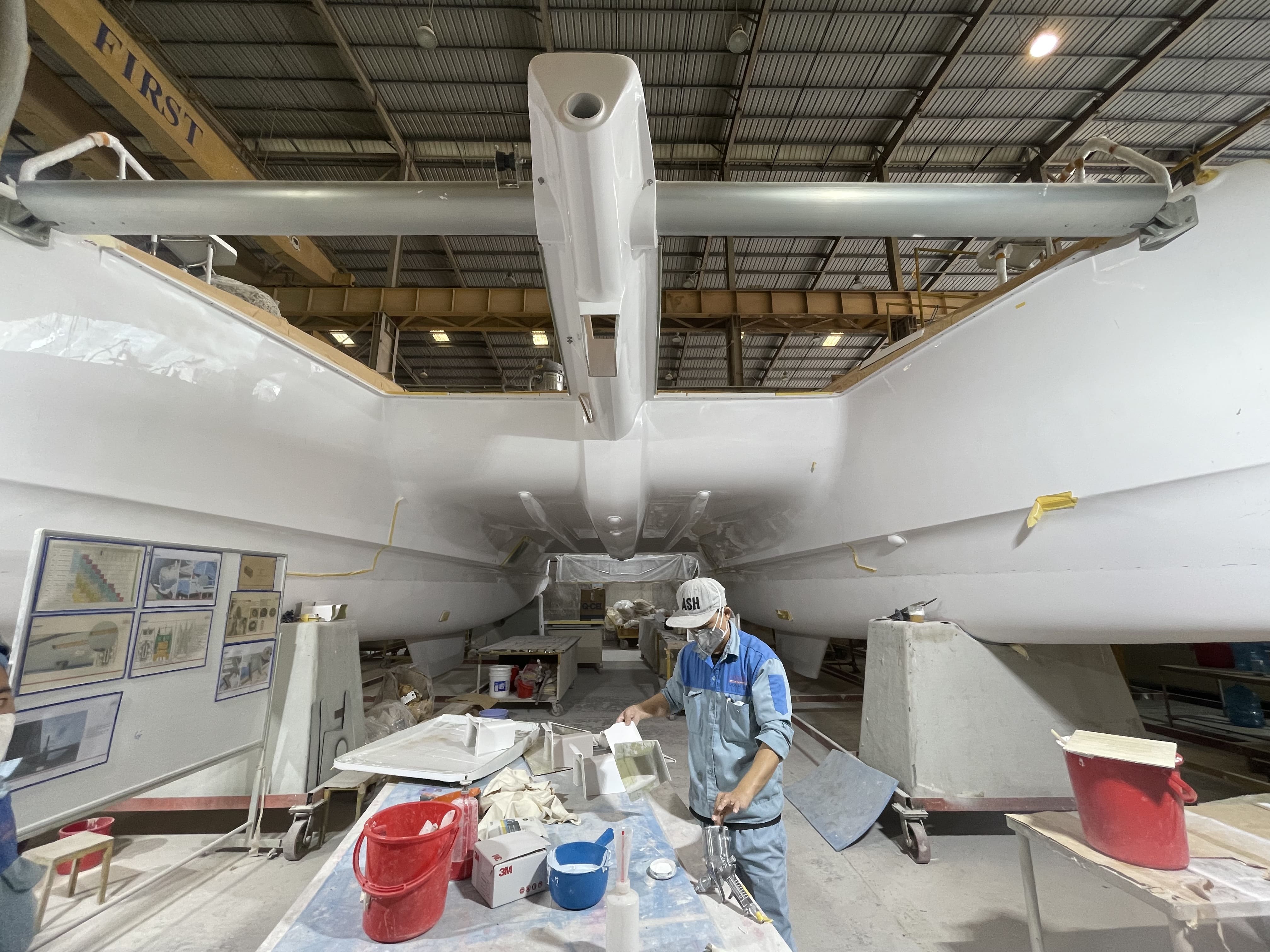

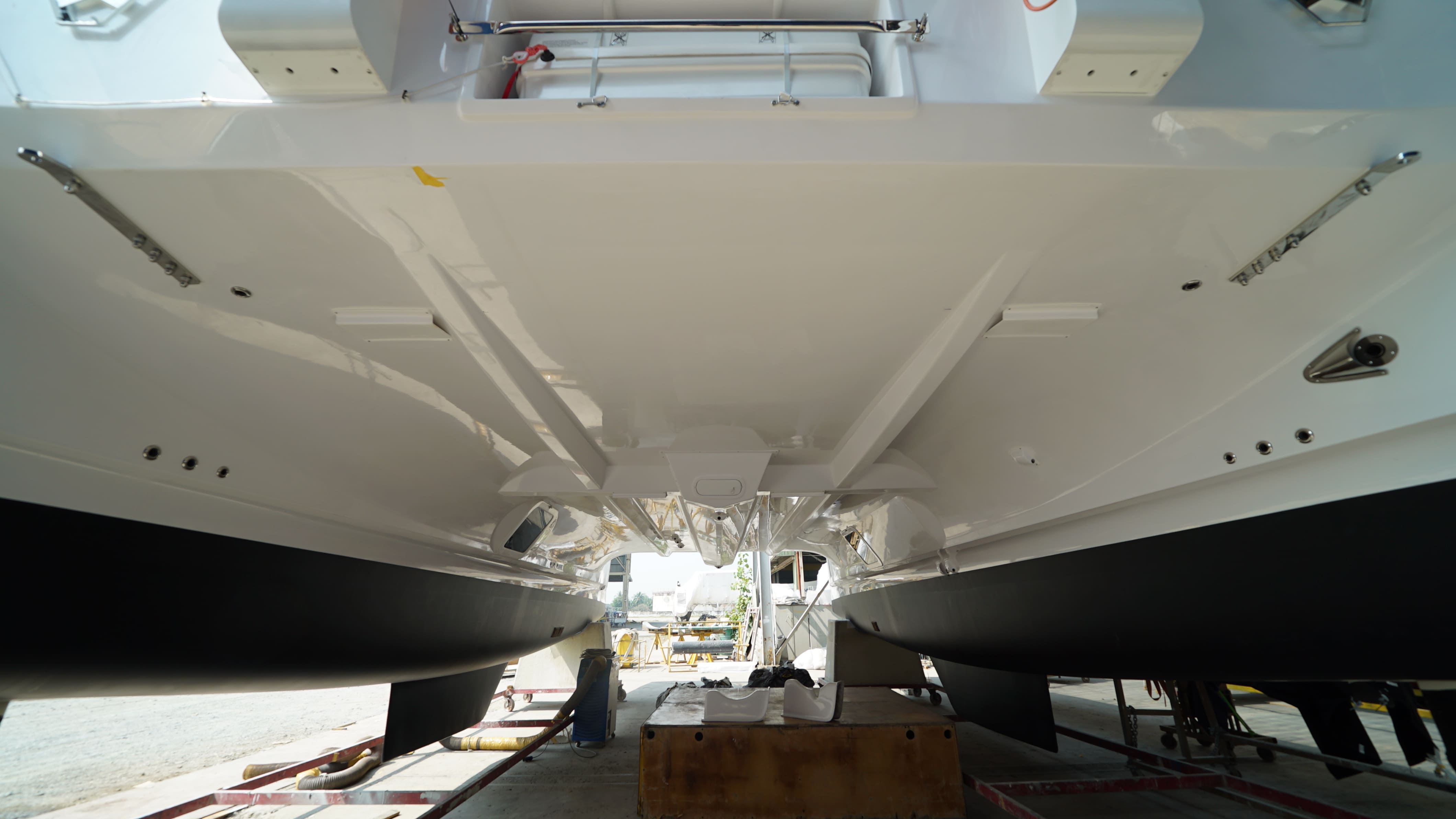

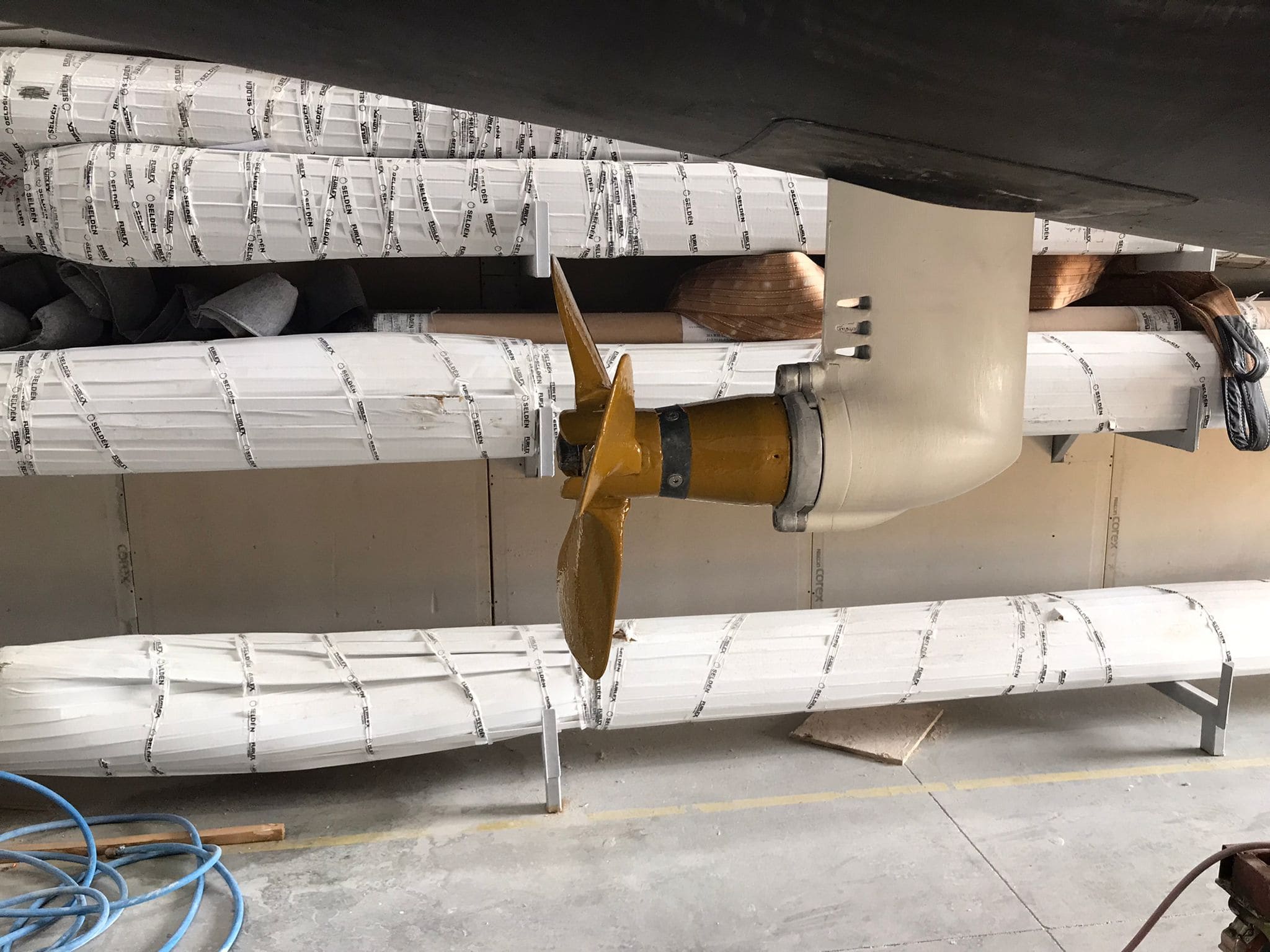

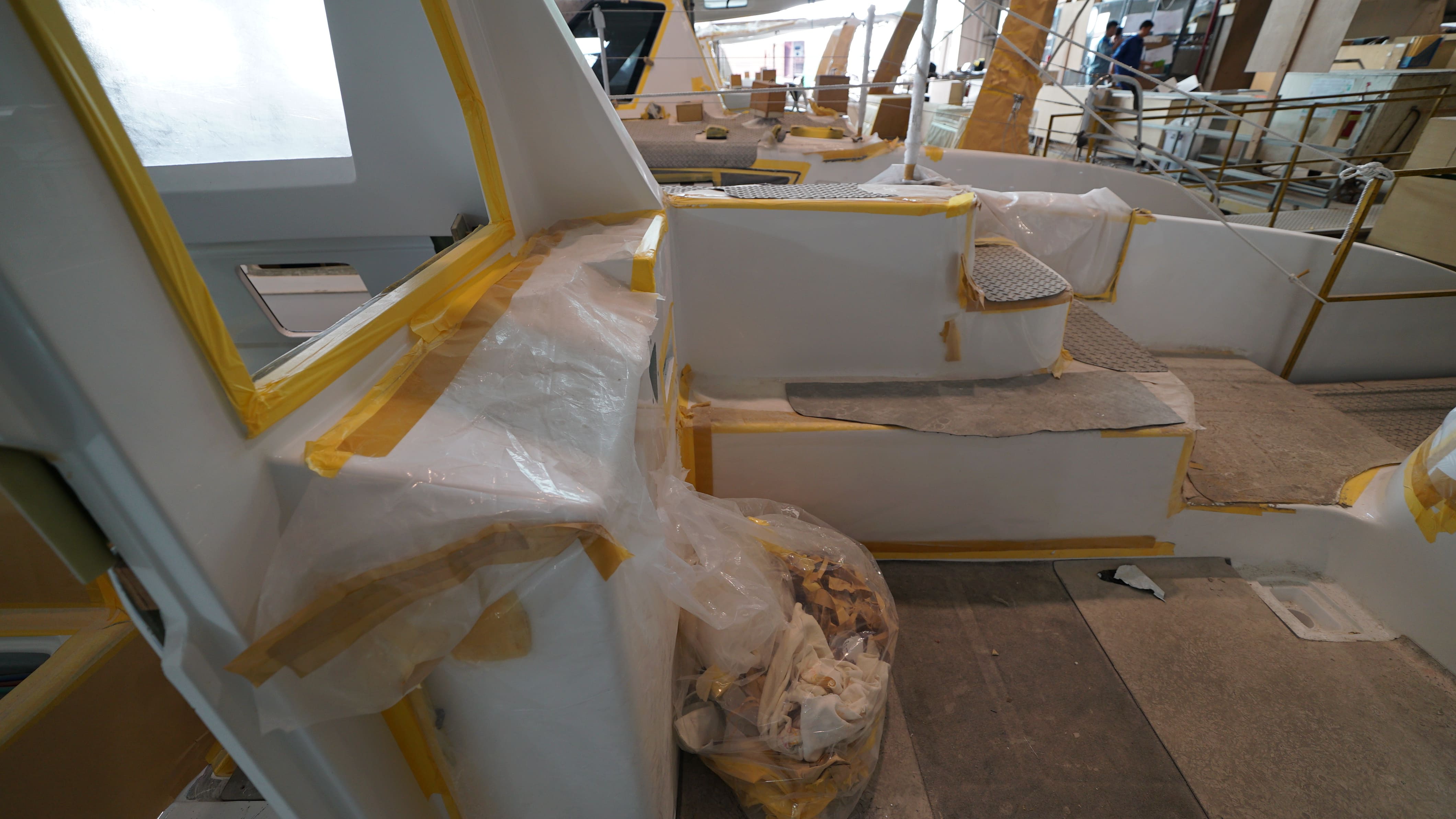

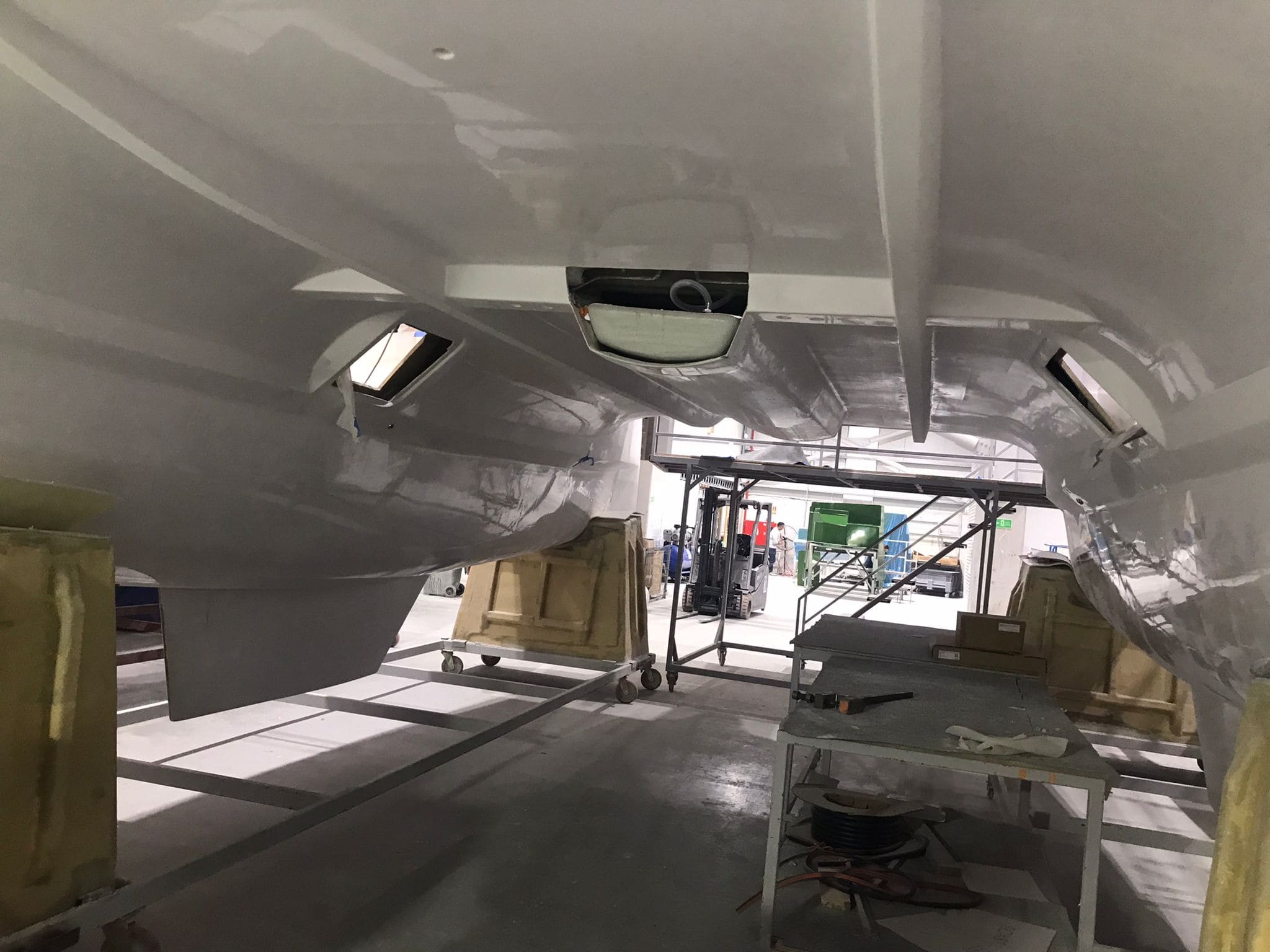

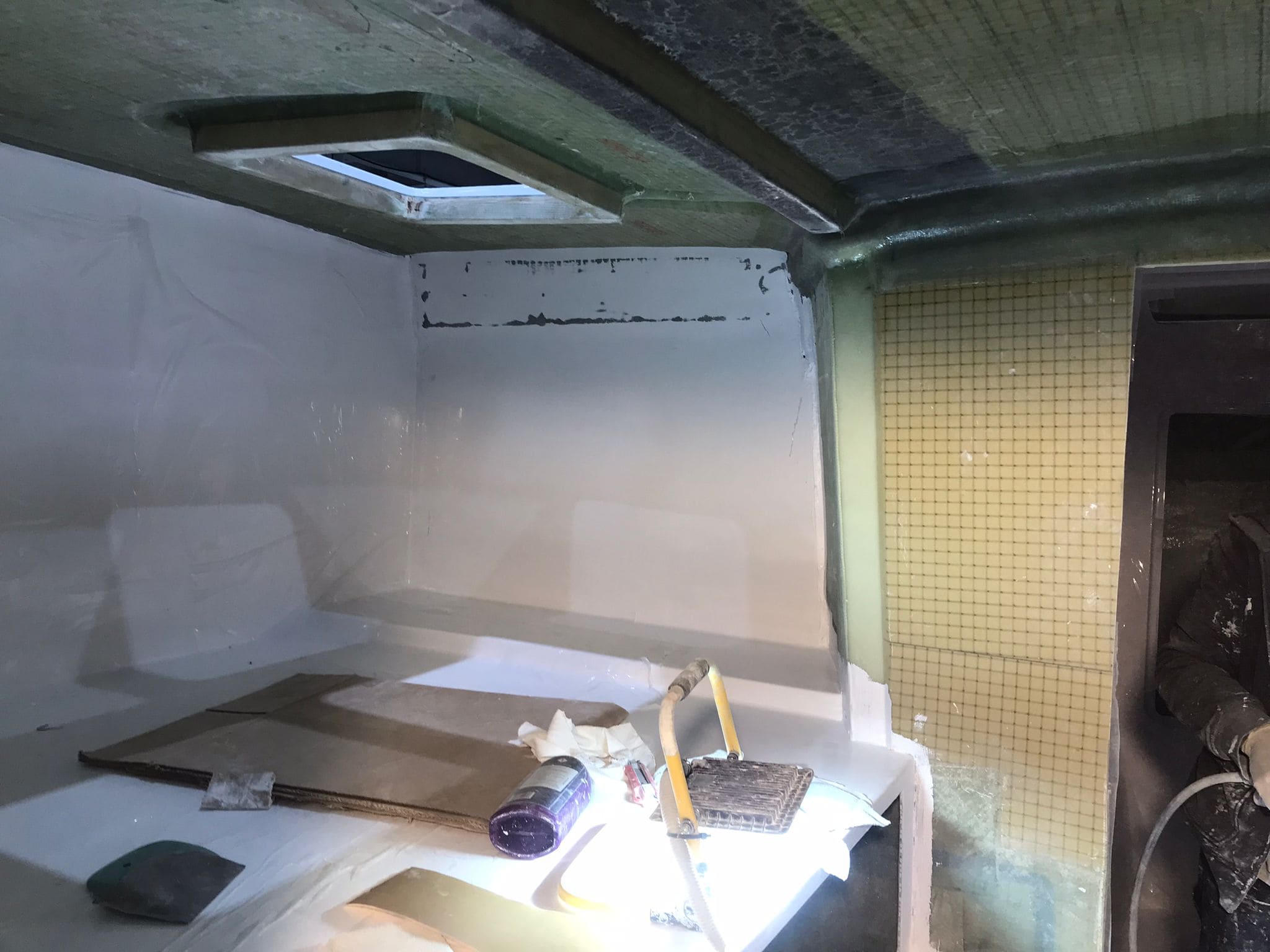

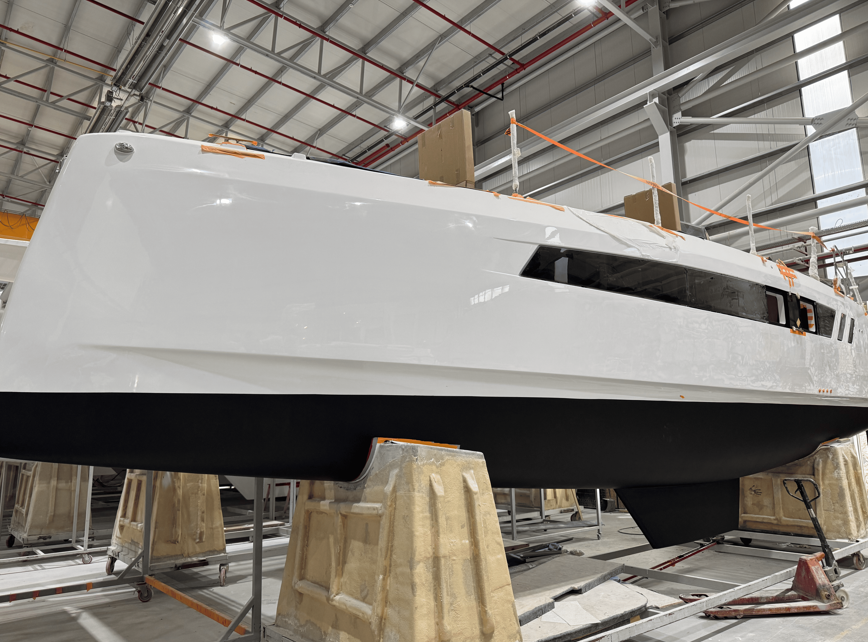

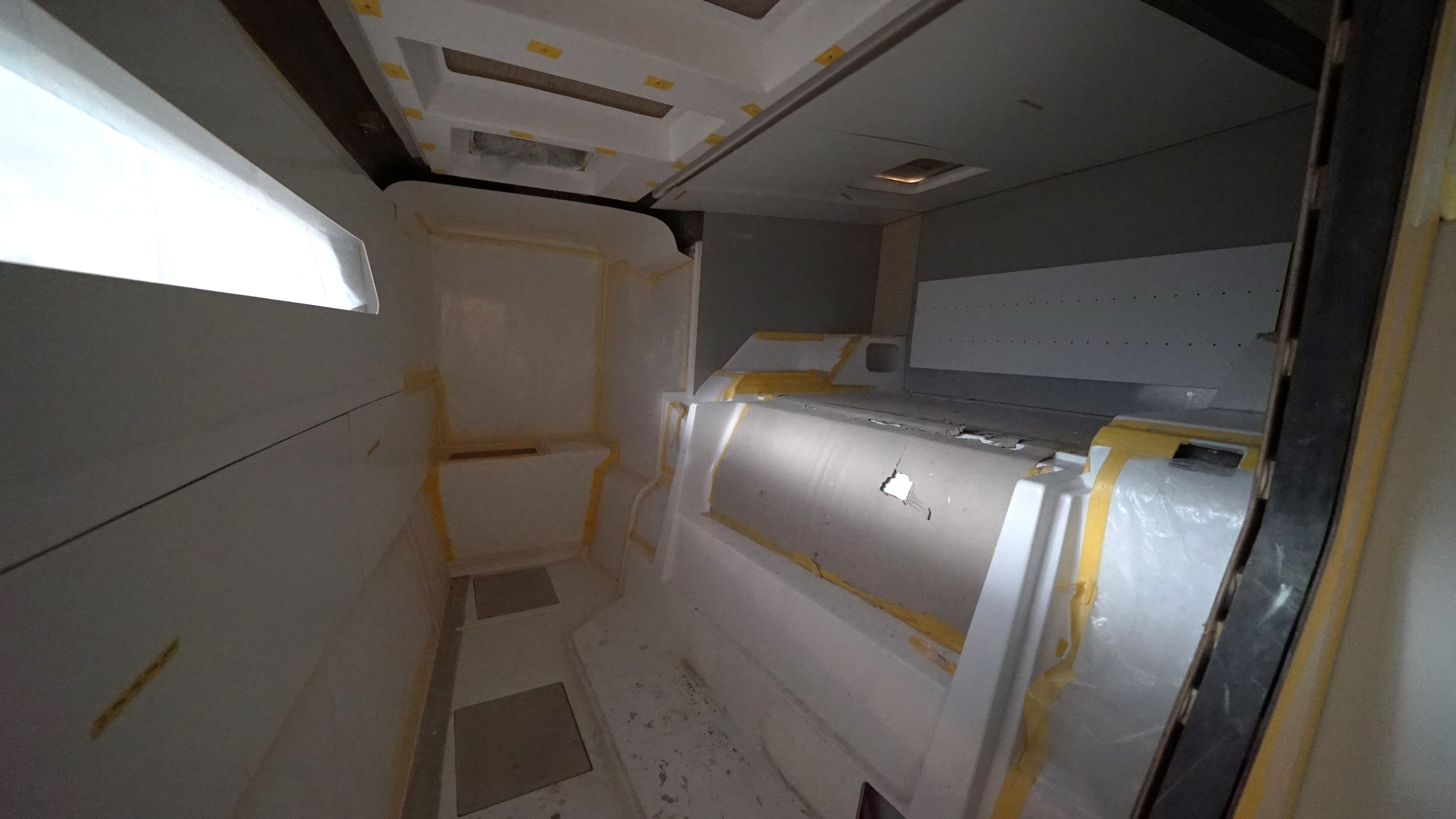

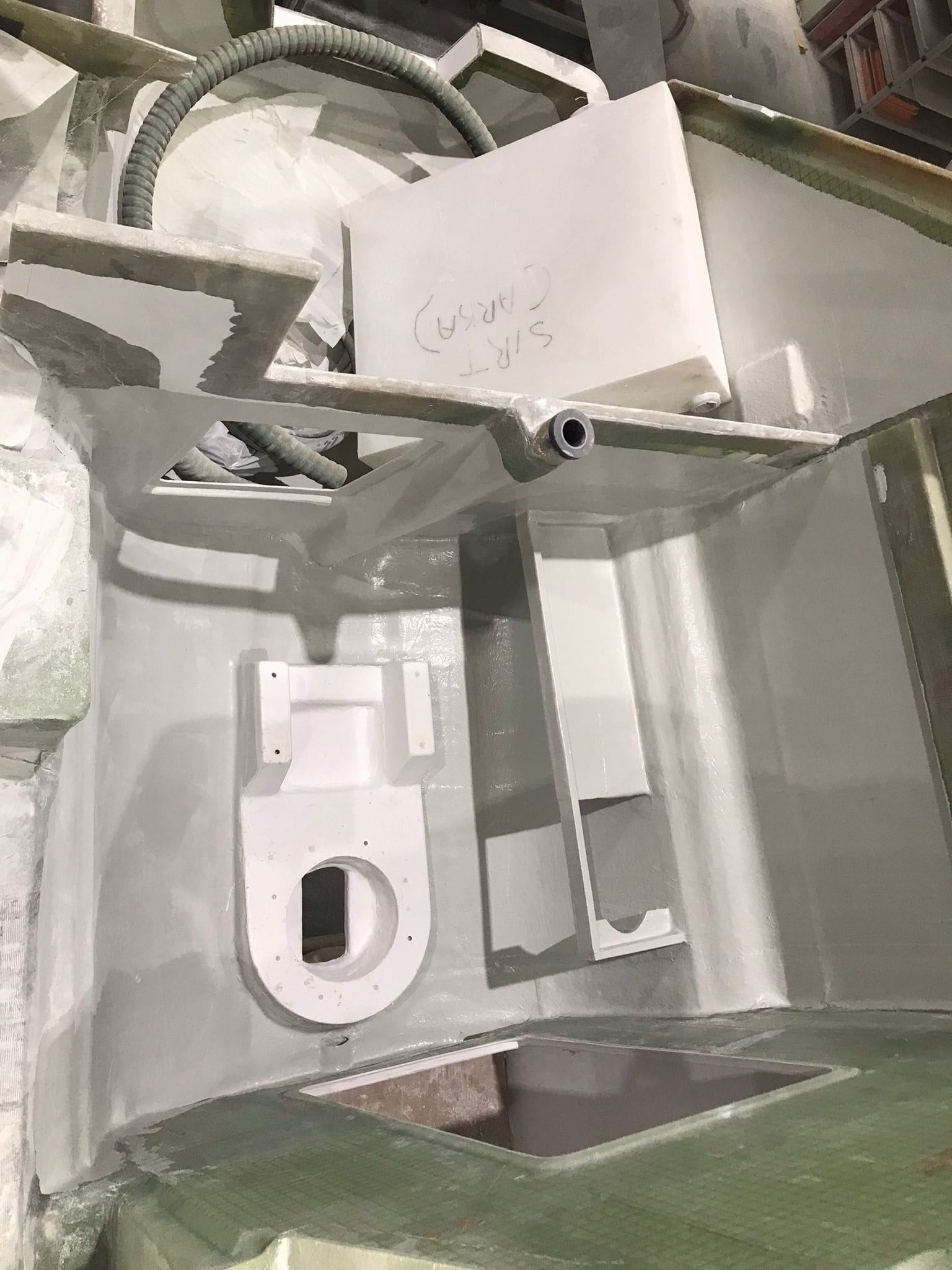

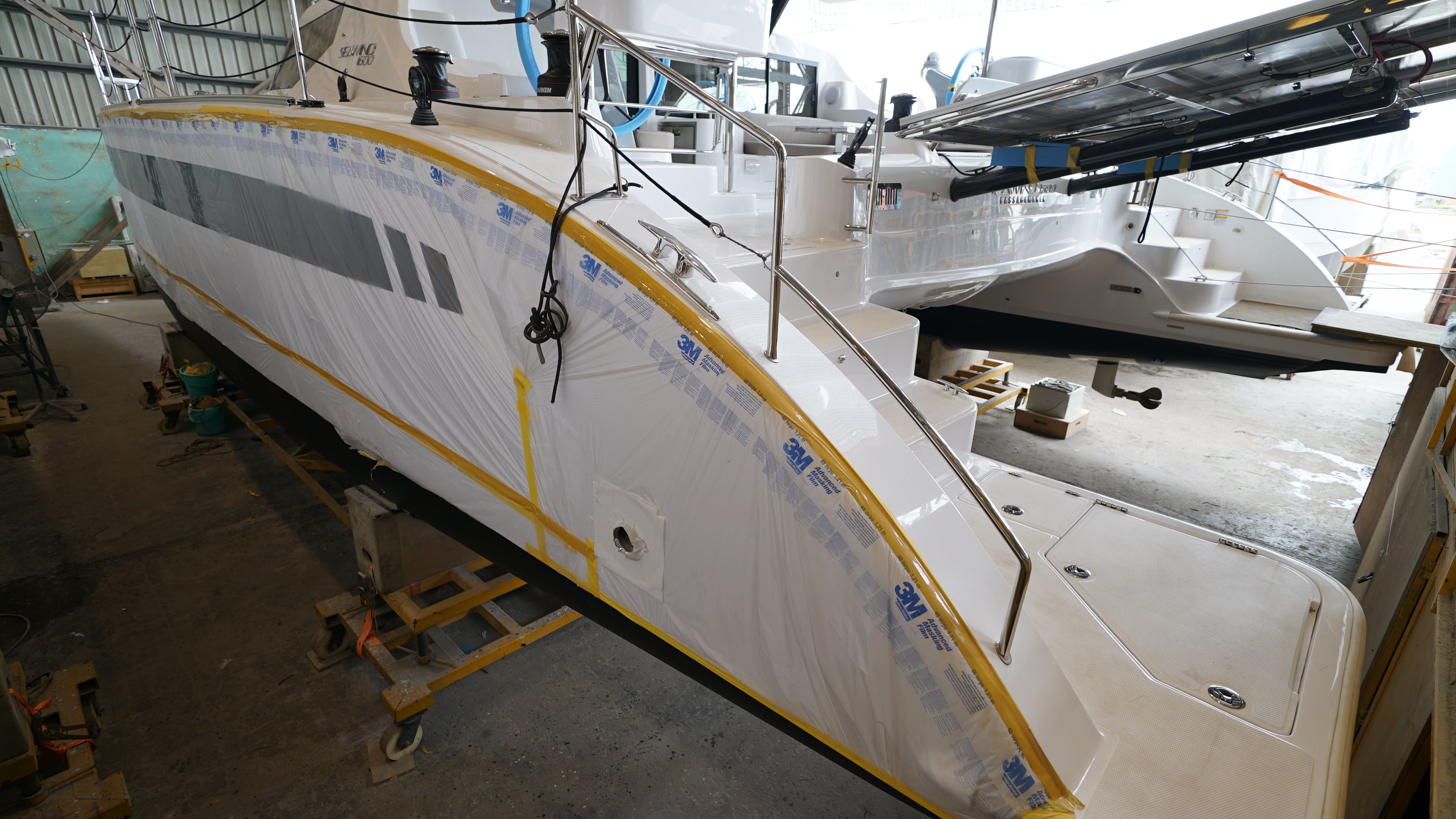

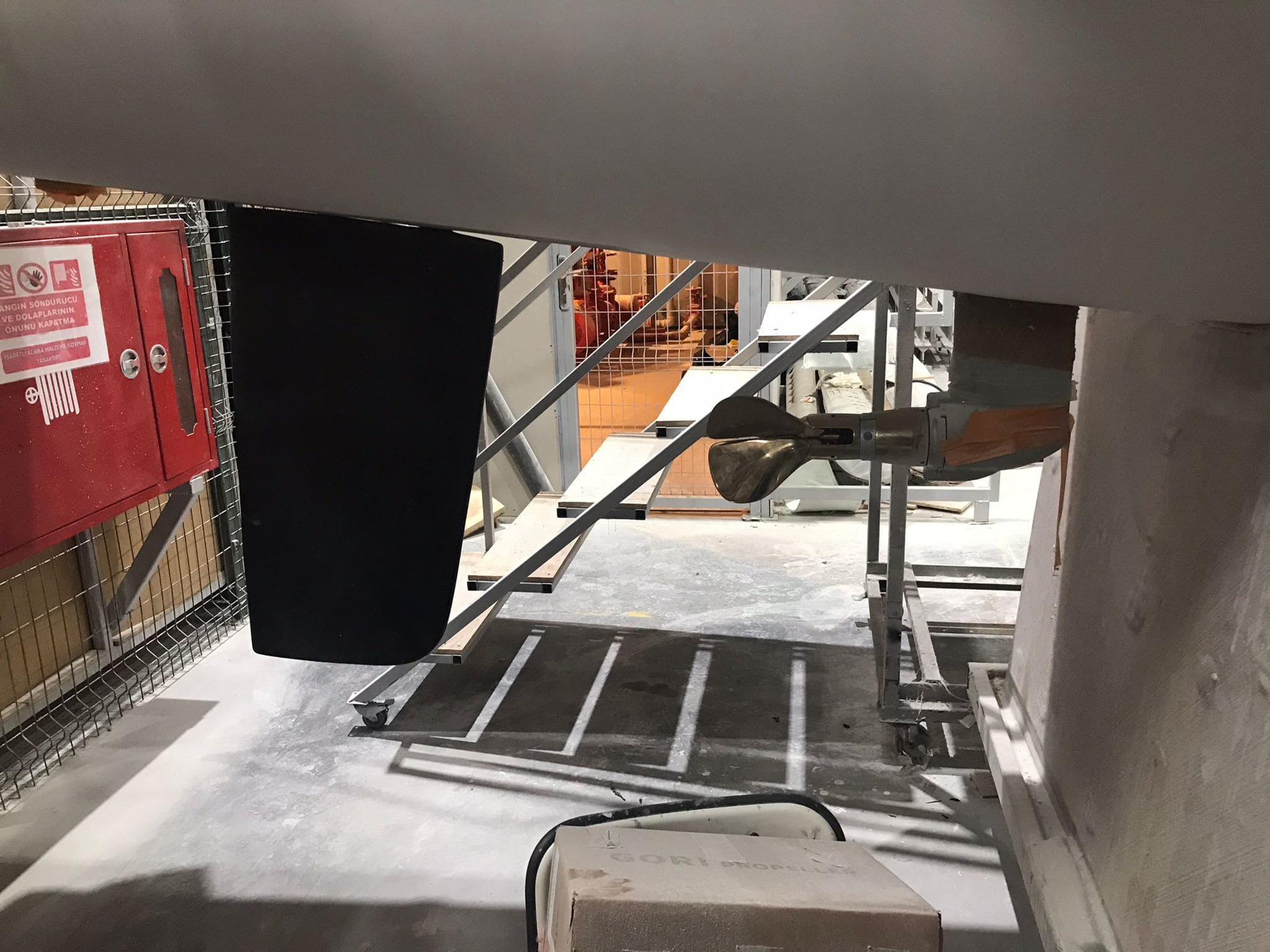

The hull and deck joining has now been completed successfully. Our Production team is currently working on gelcoat repairs and carrying out all the necessary preparations for engines & deck hardware installation.

Production Update – Fit out

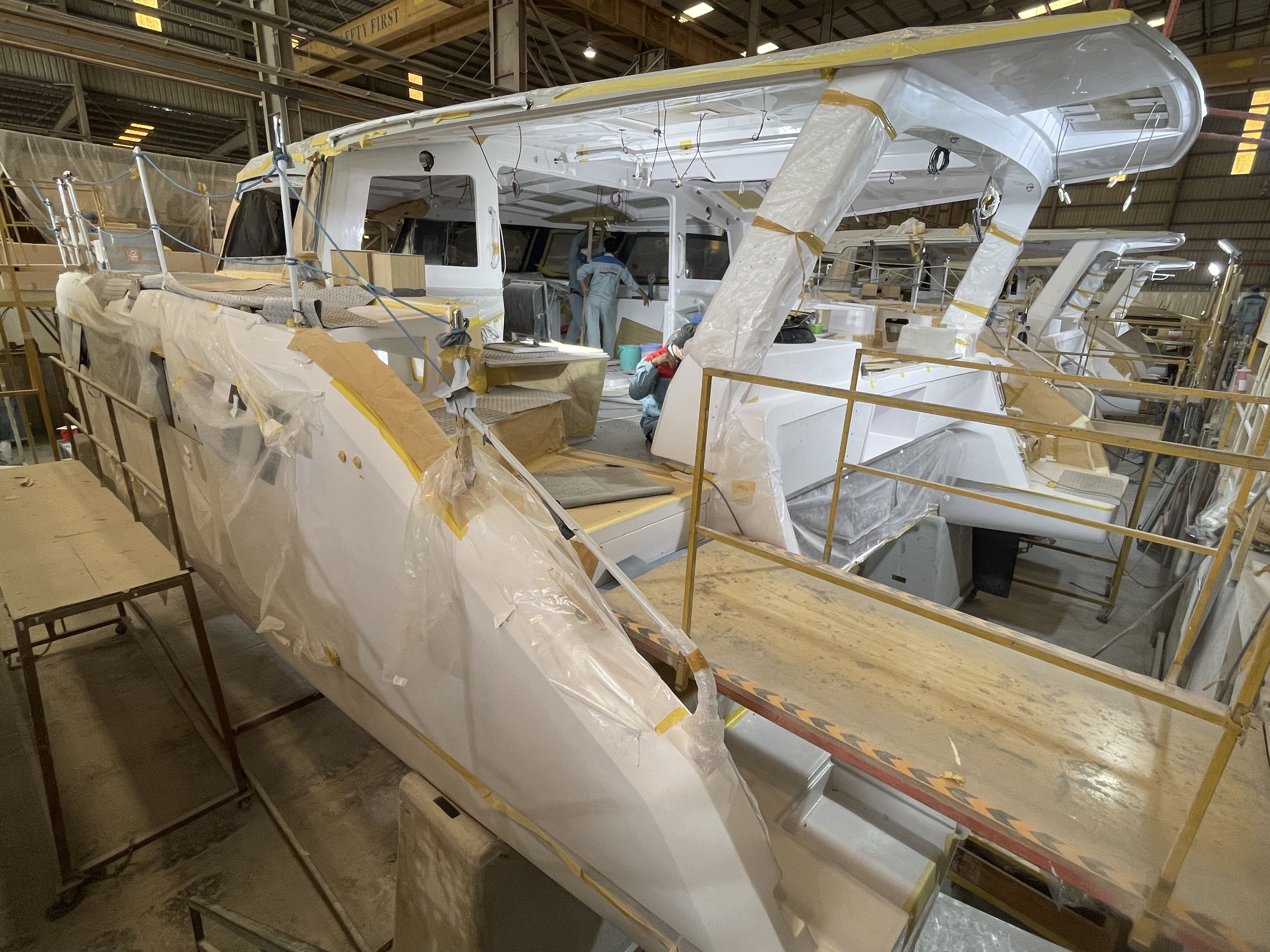

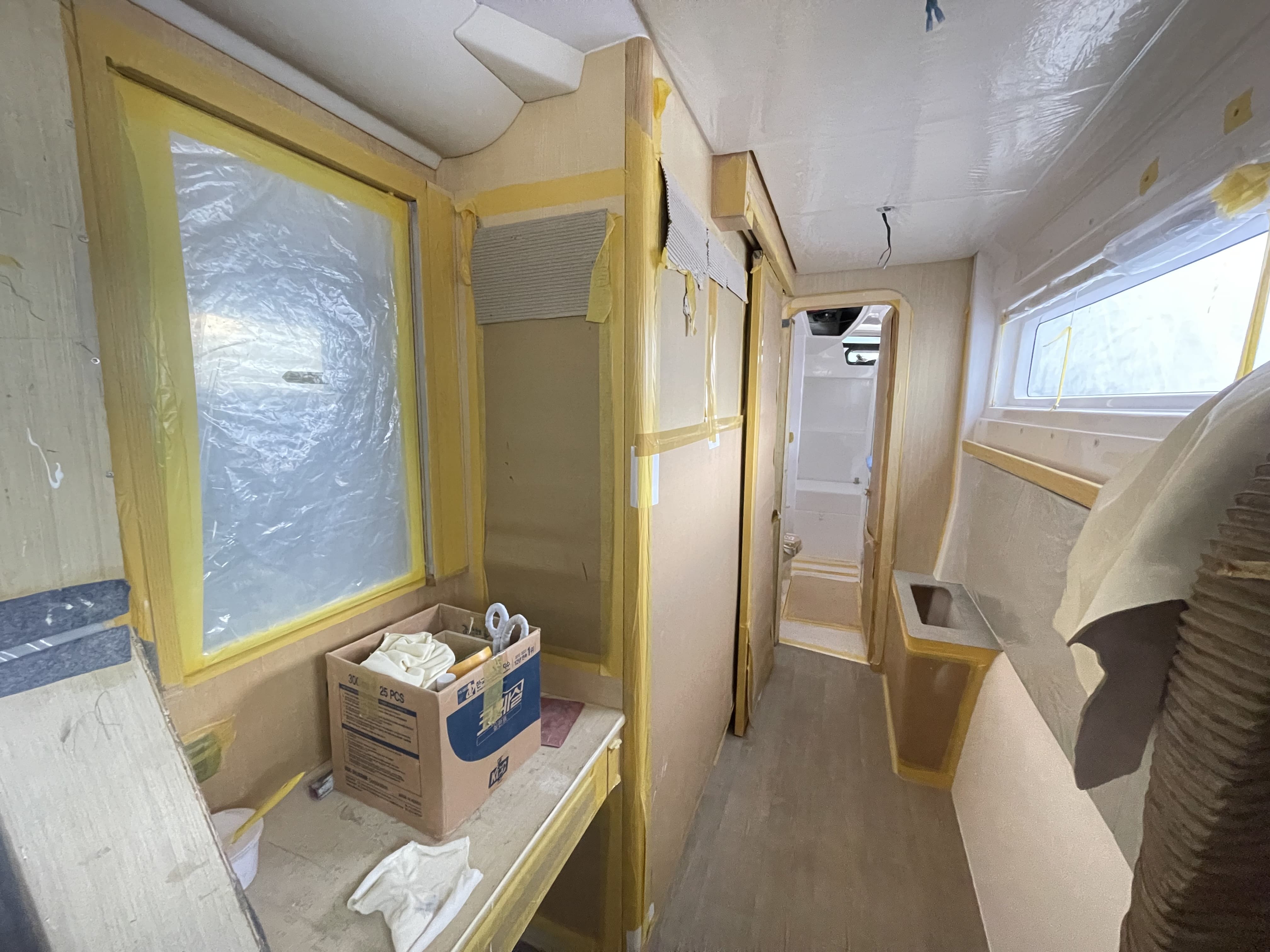

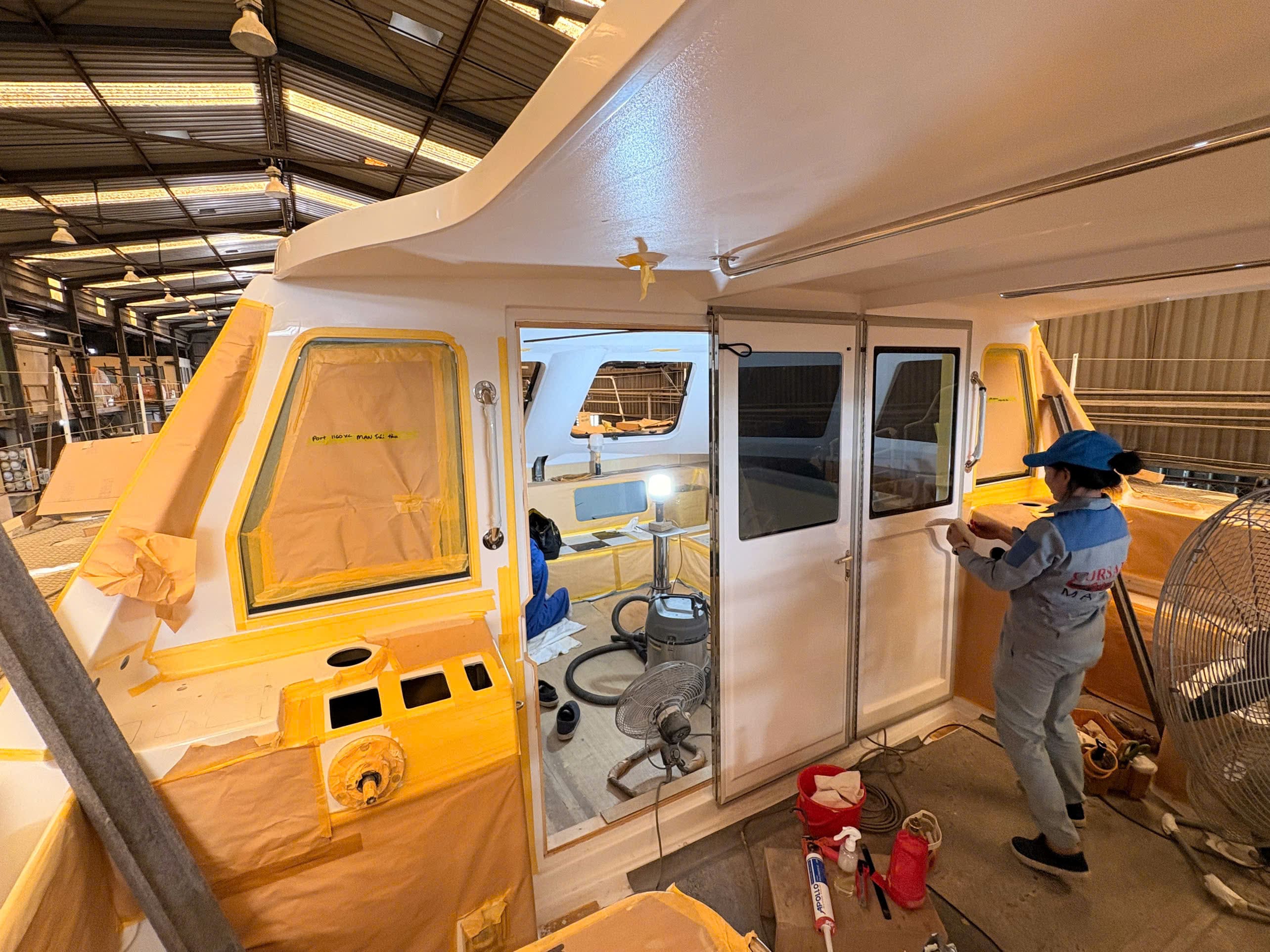

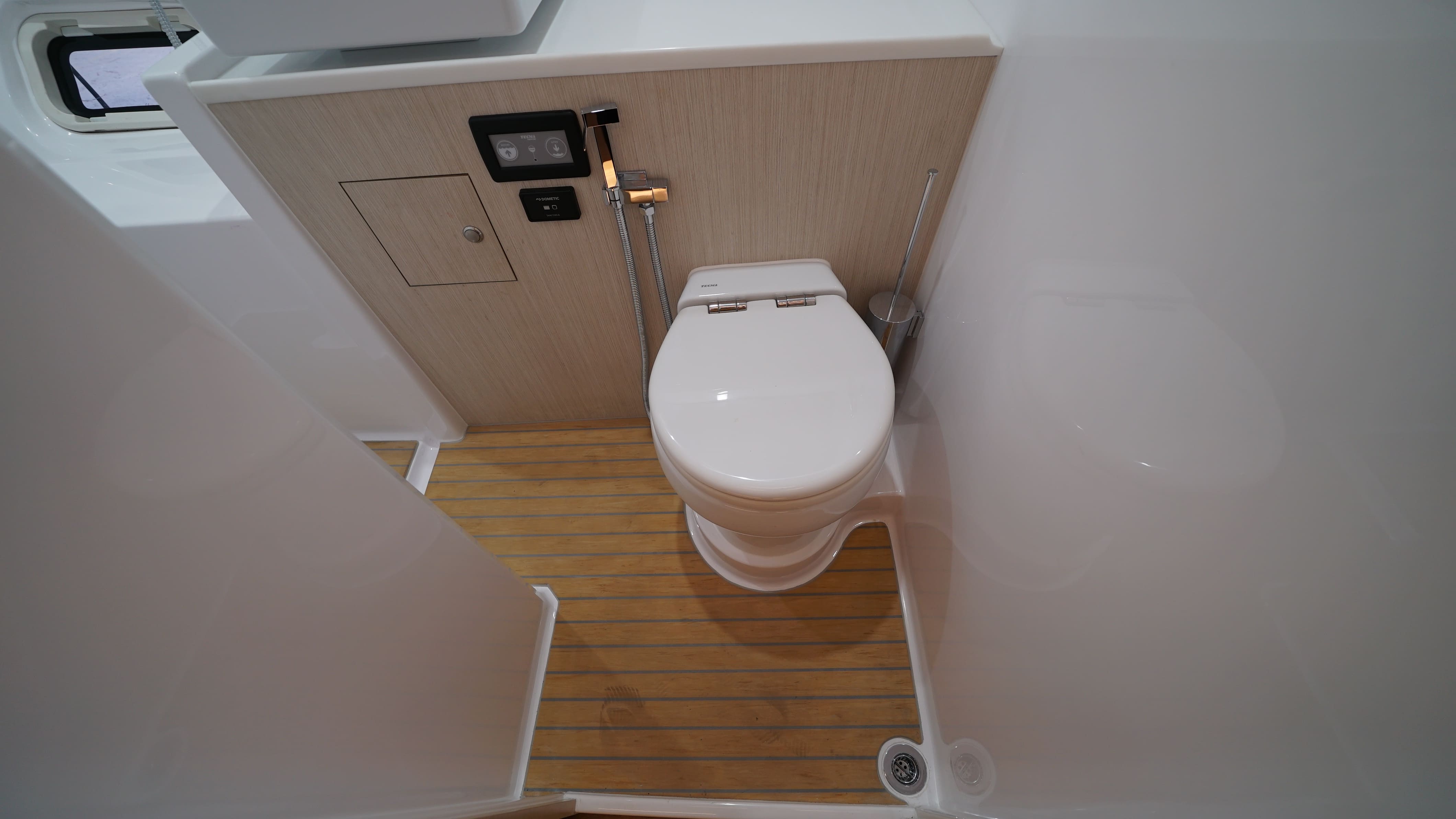

We are excited to inform you that your boat has been moved to the Fit out stage.

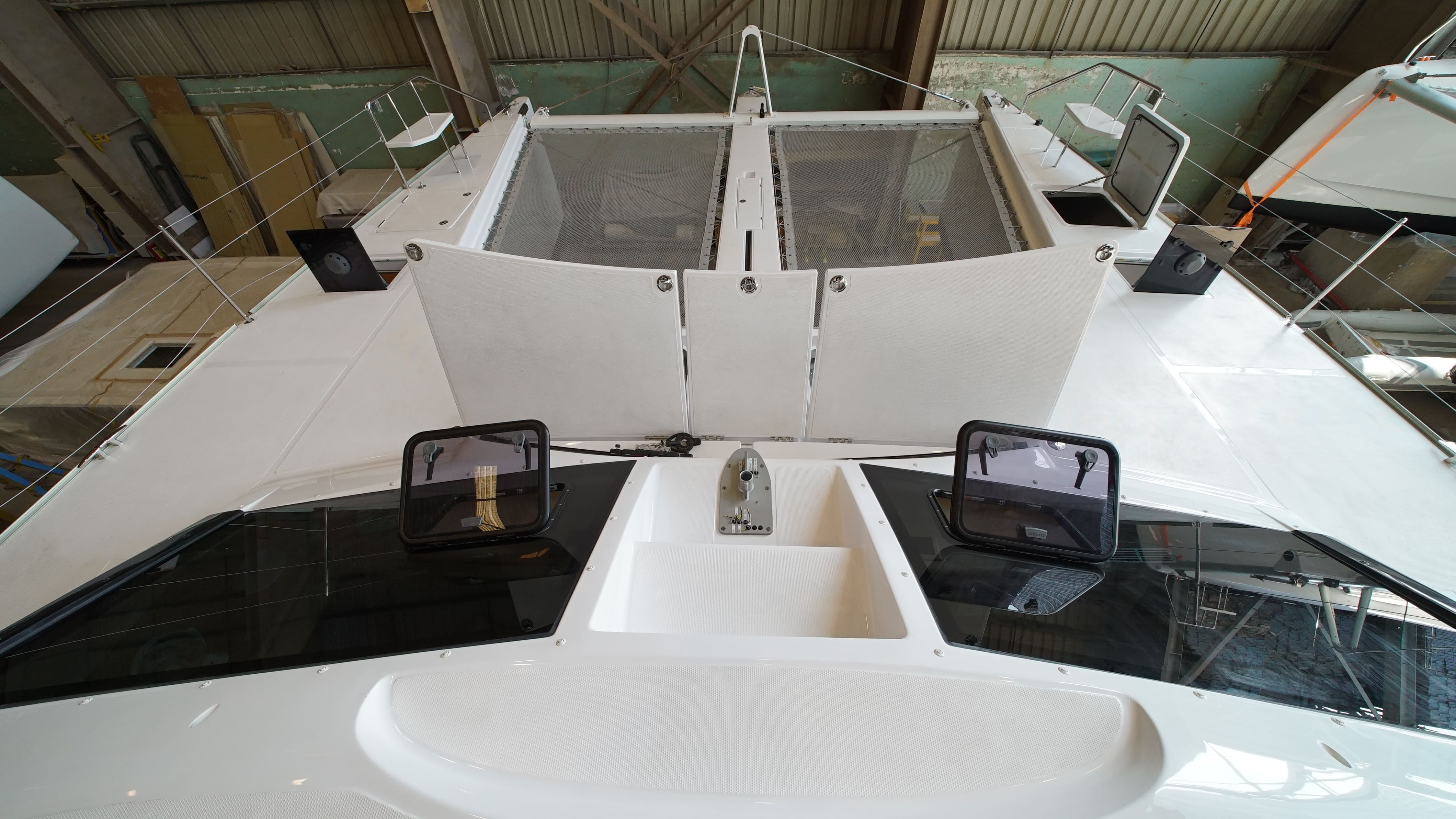

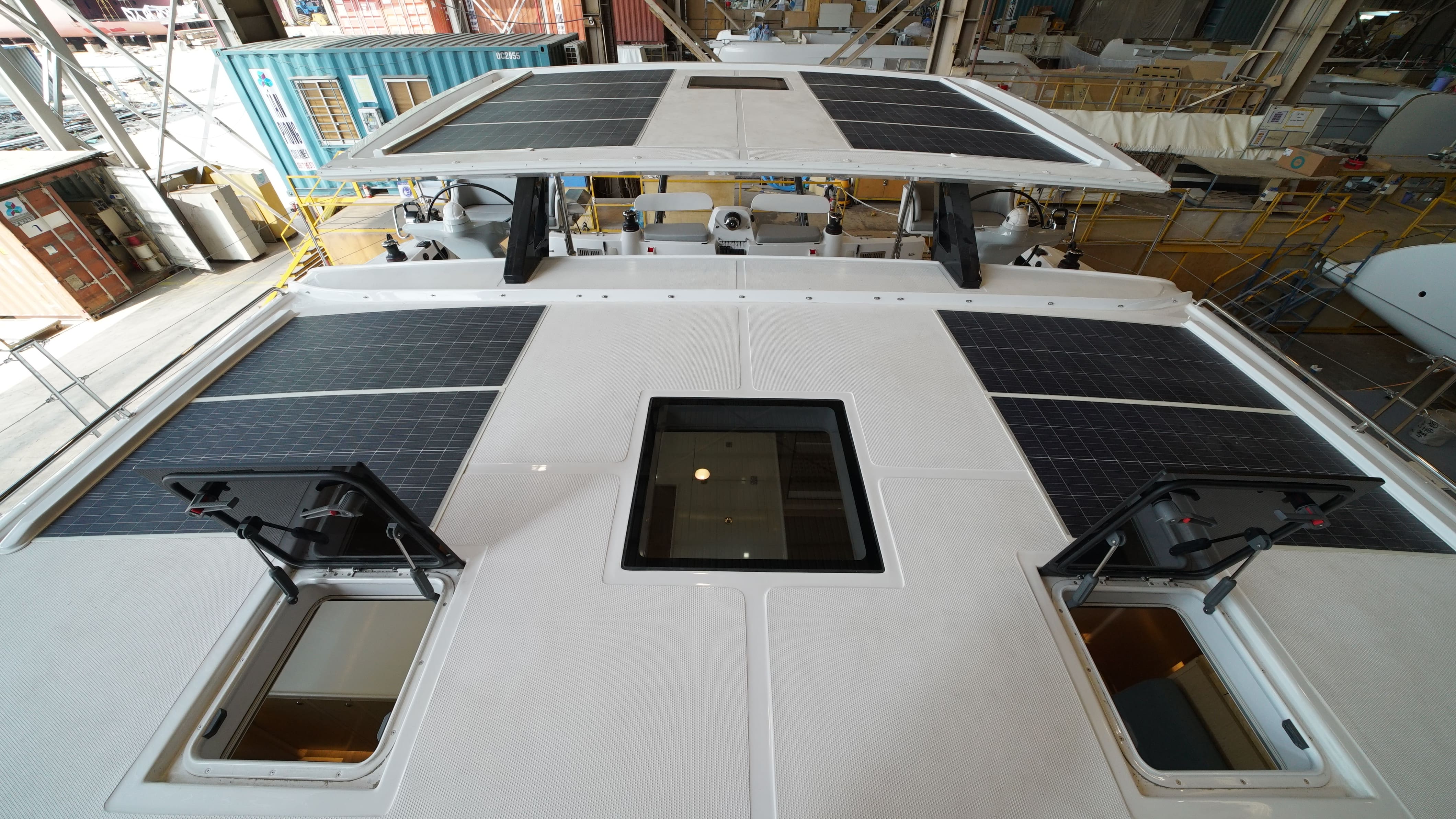

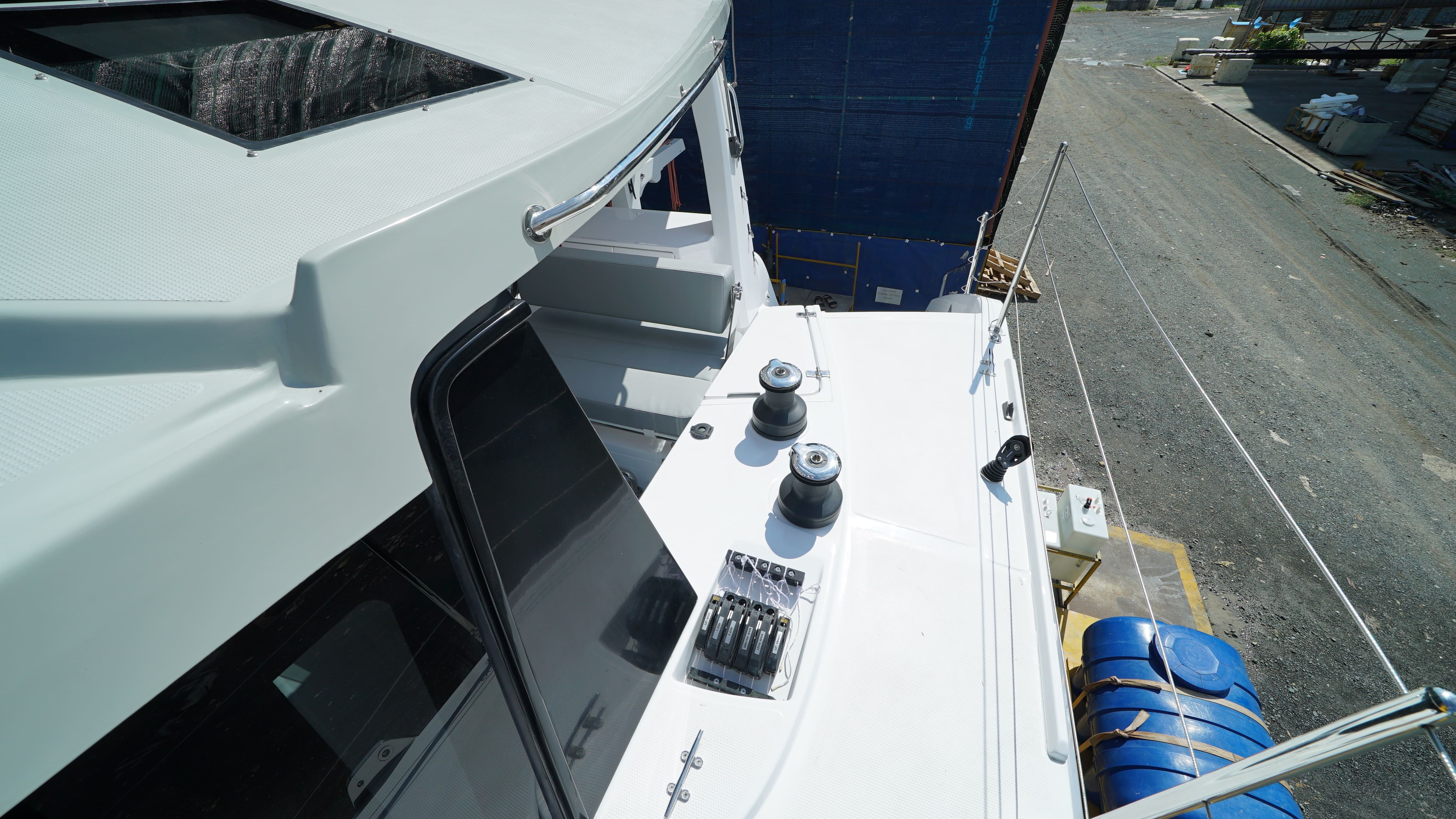

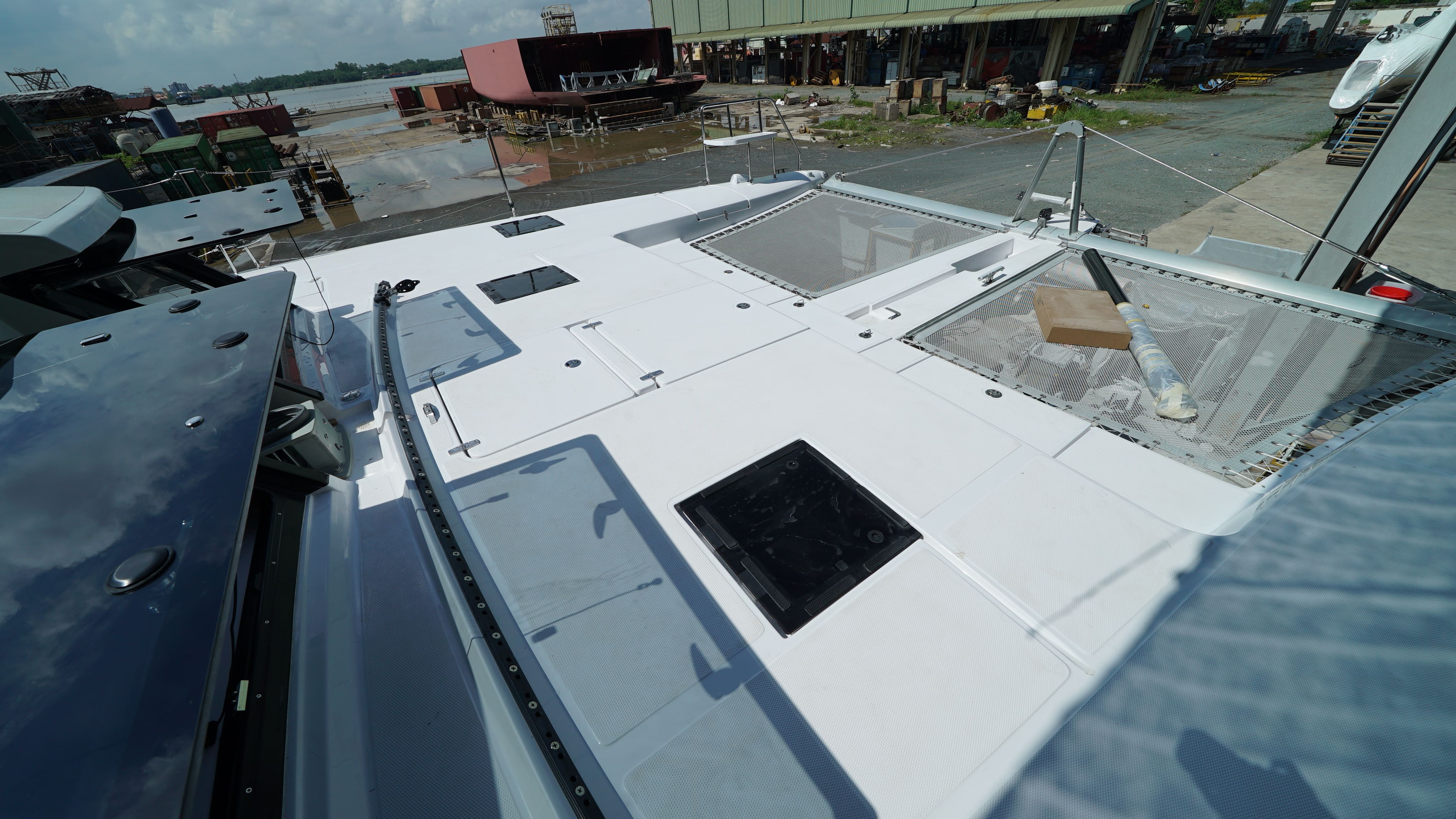

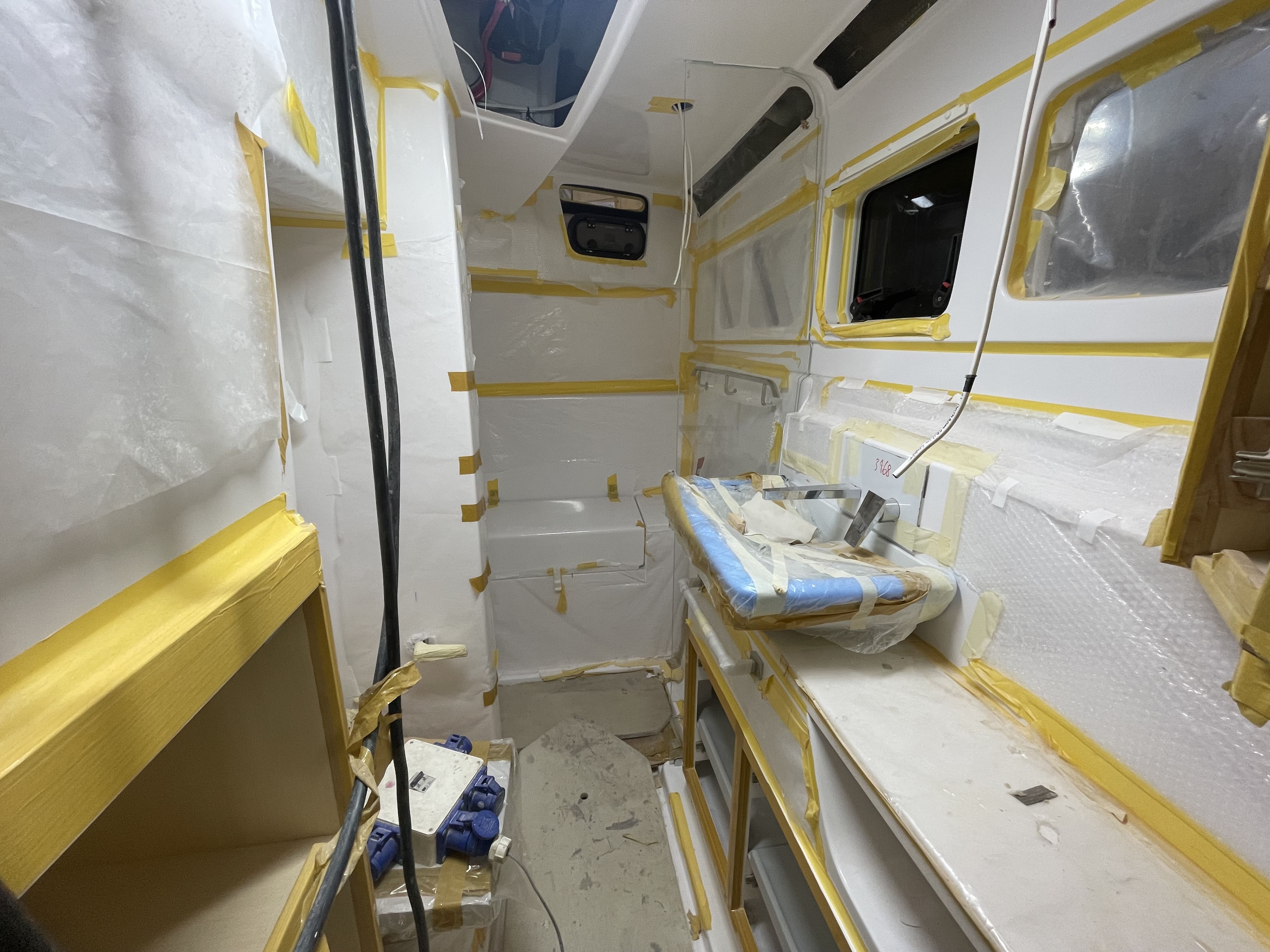

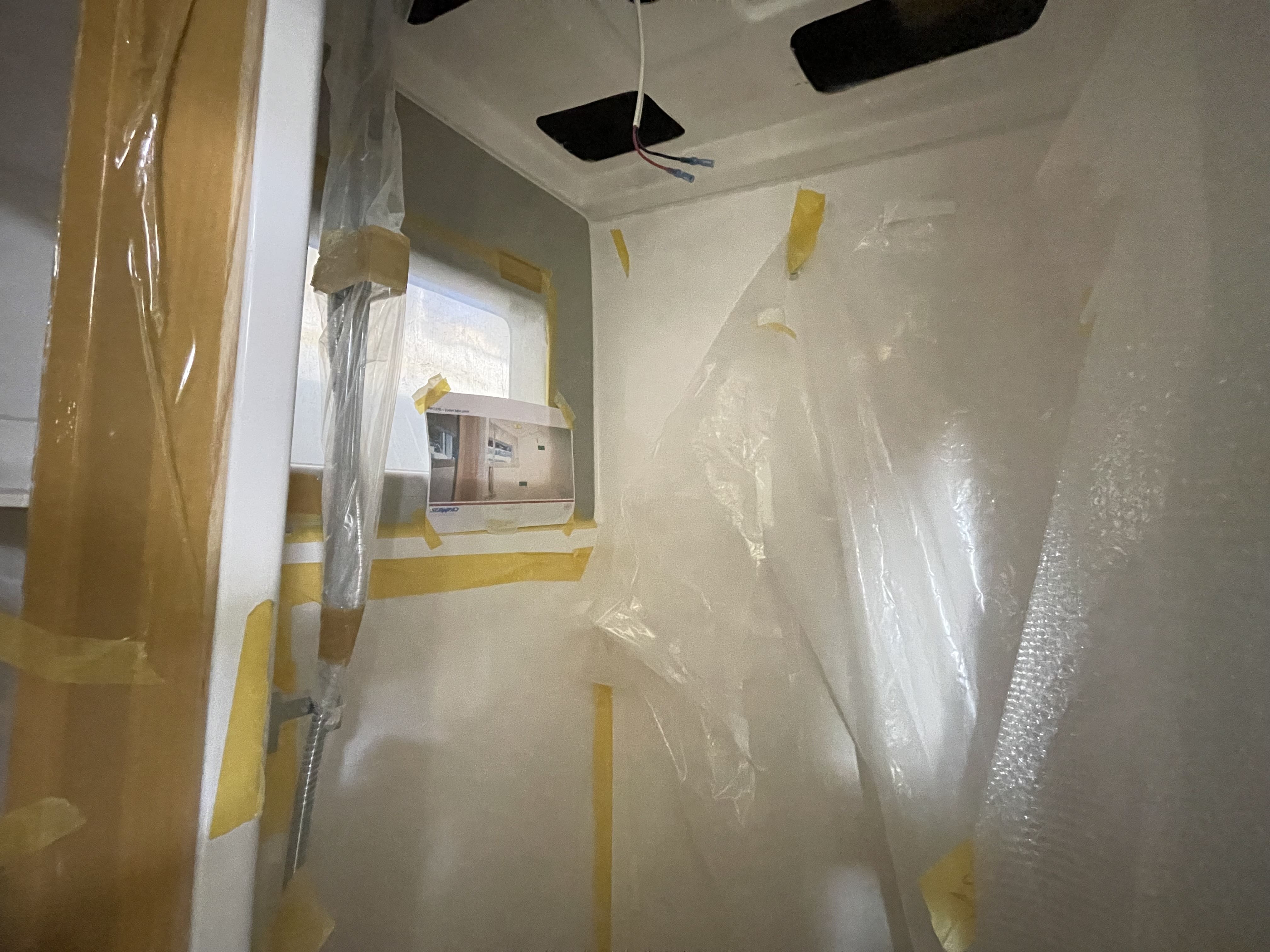

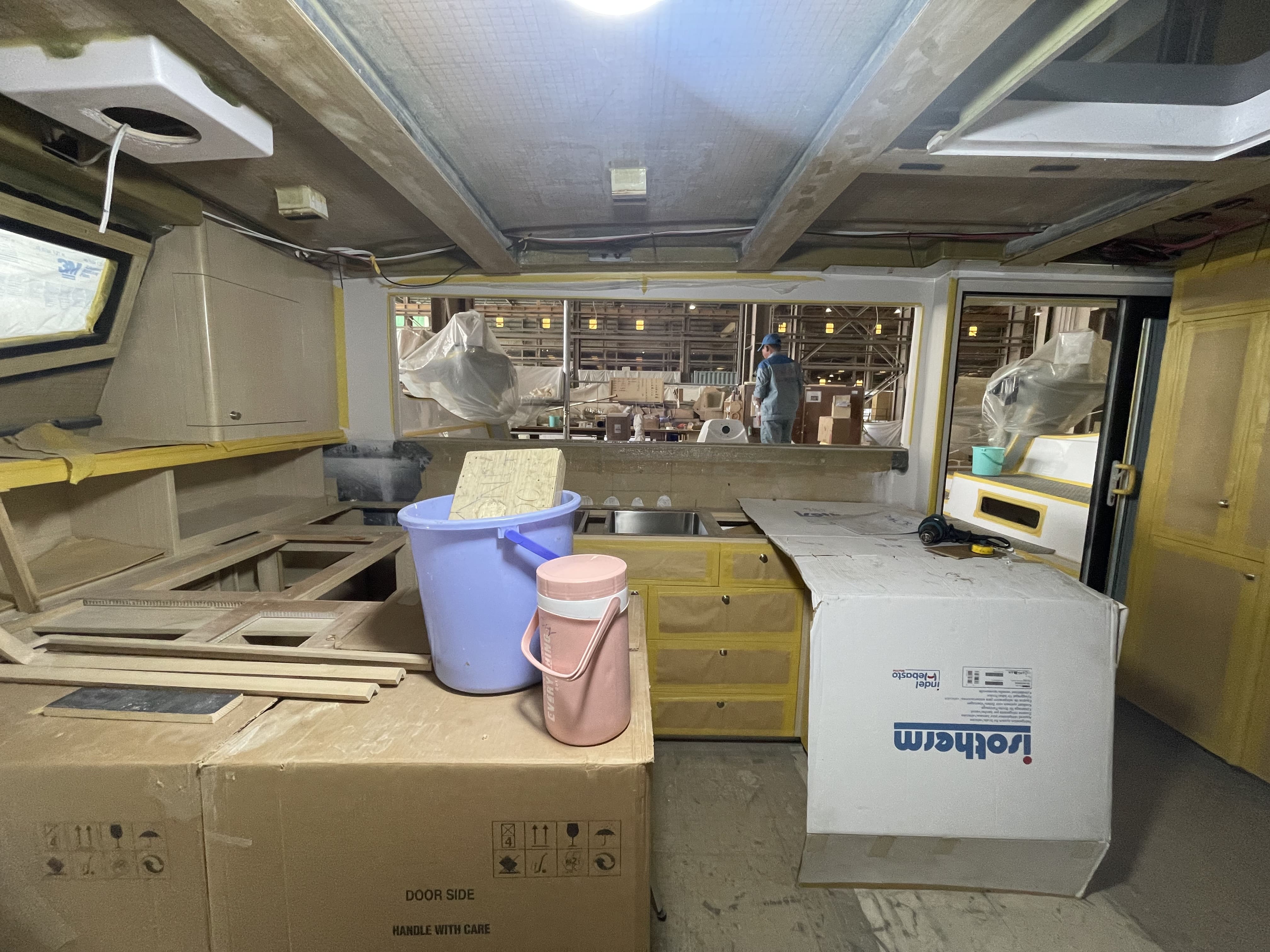

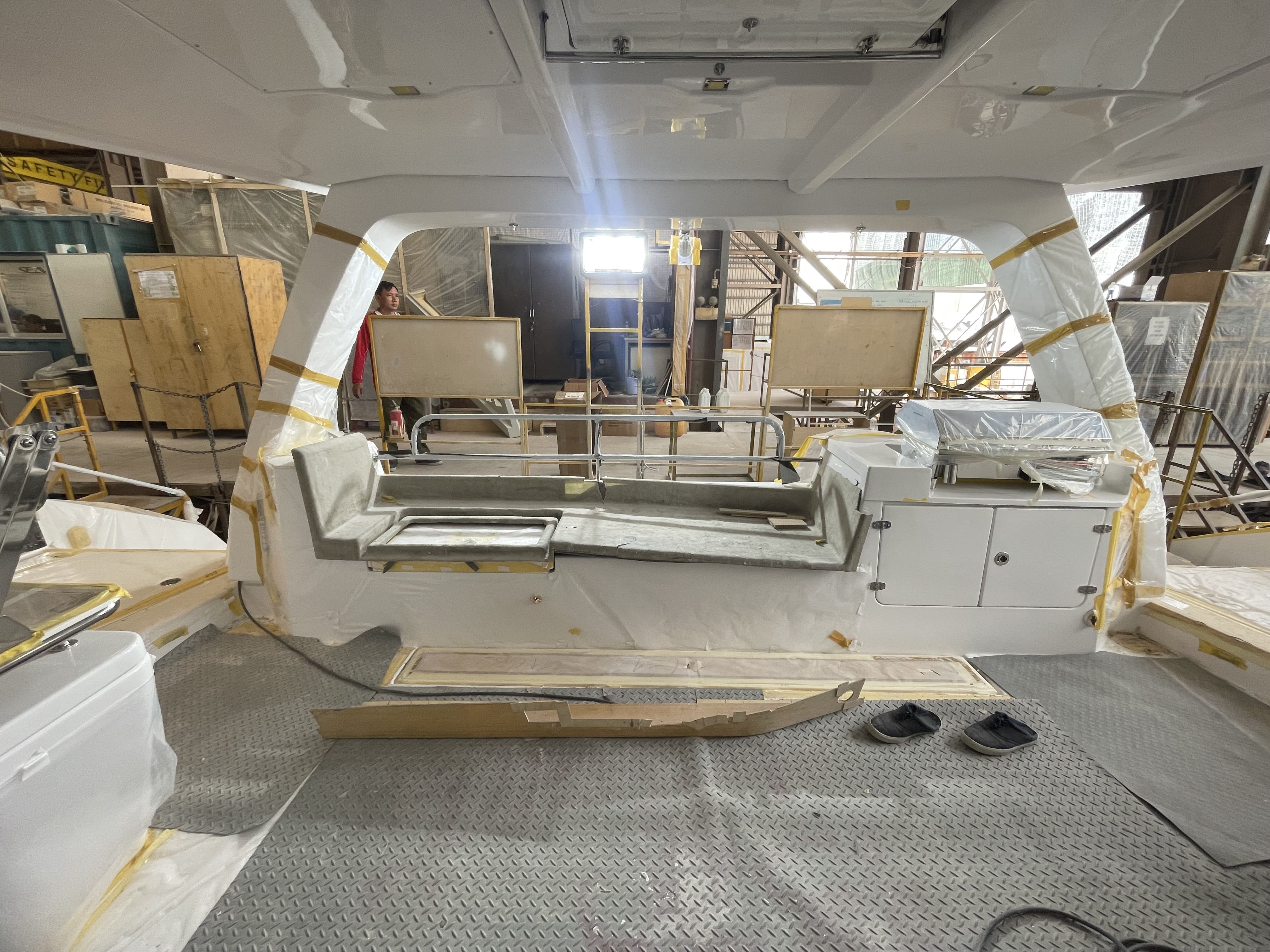

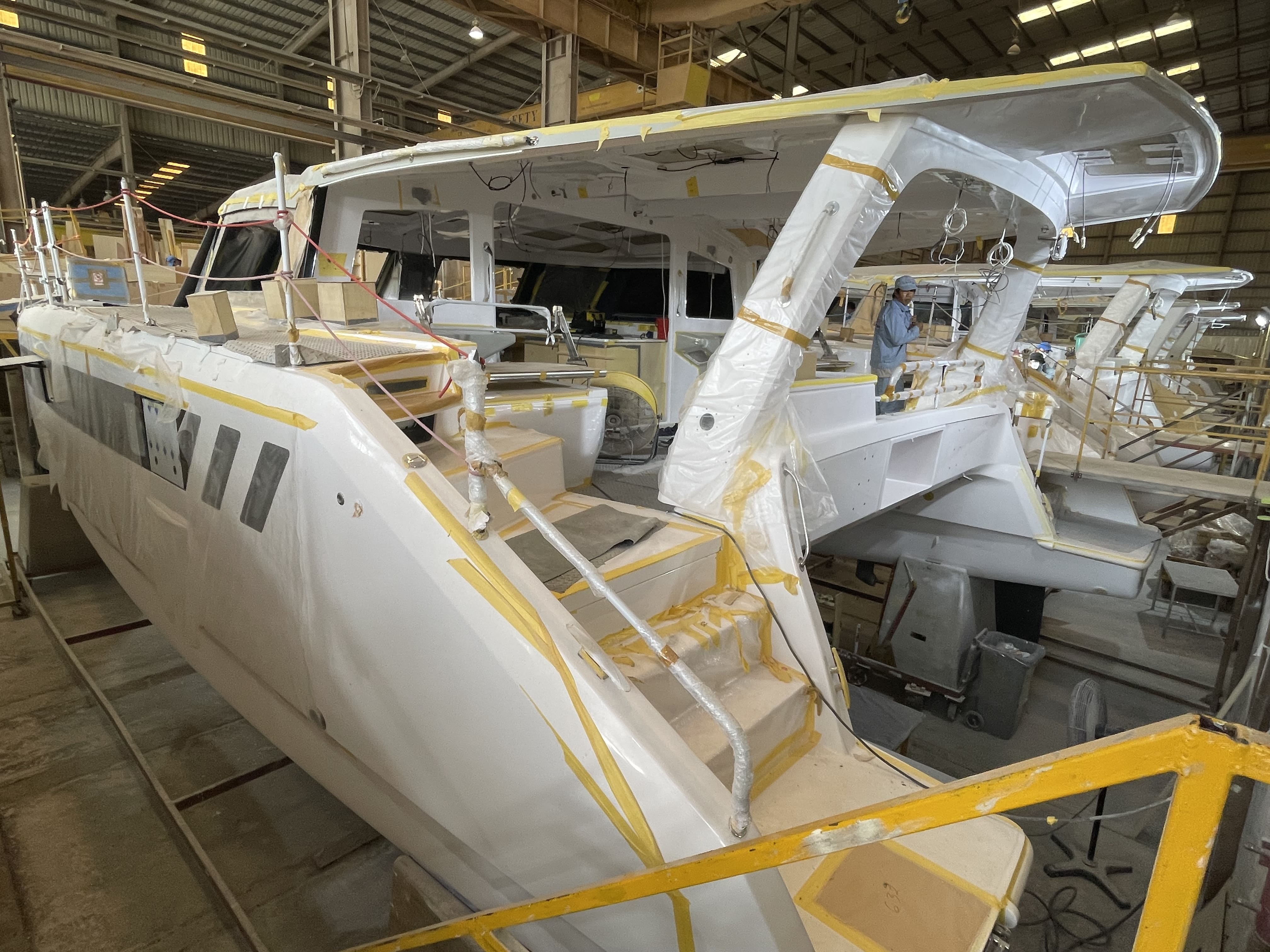

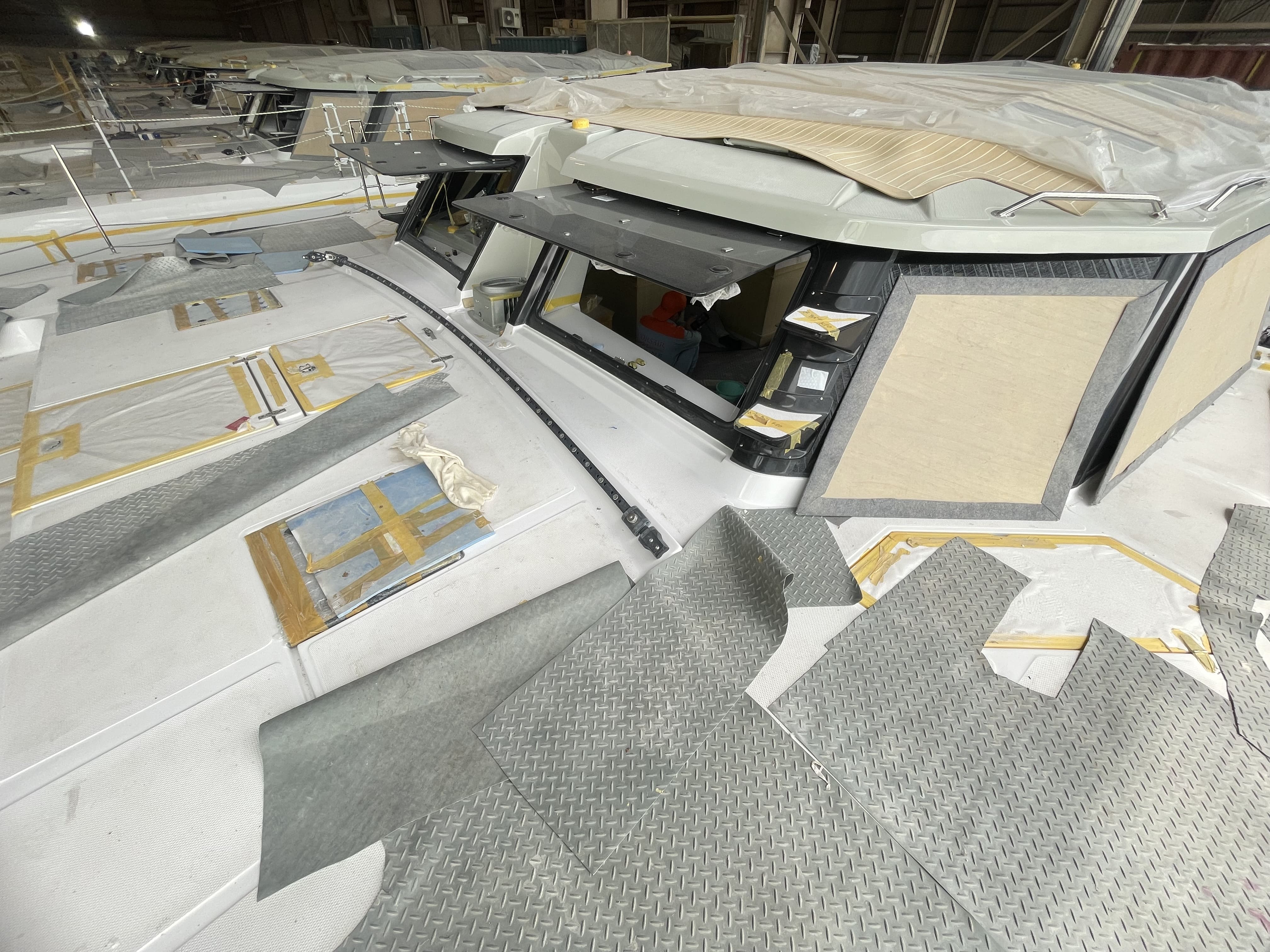

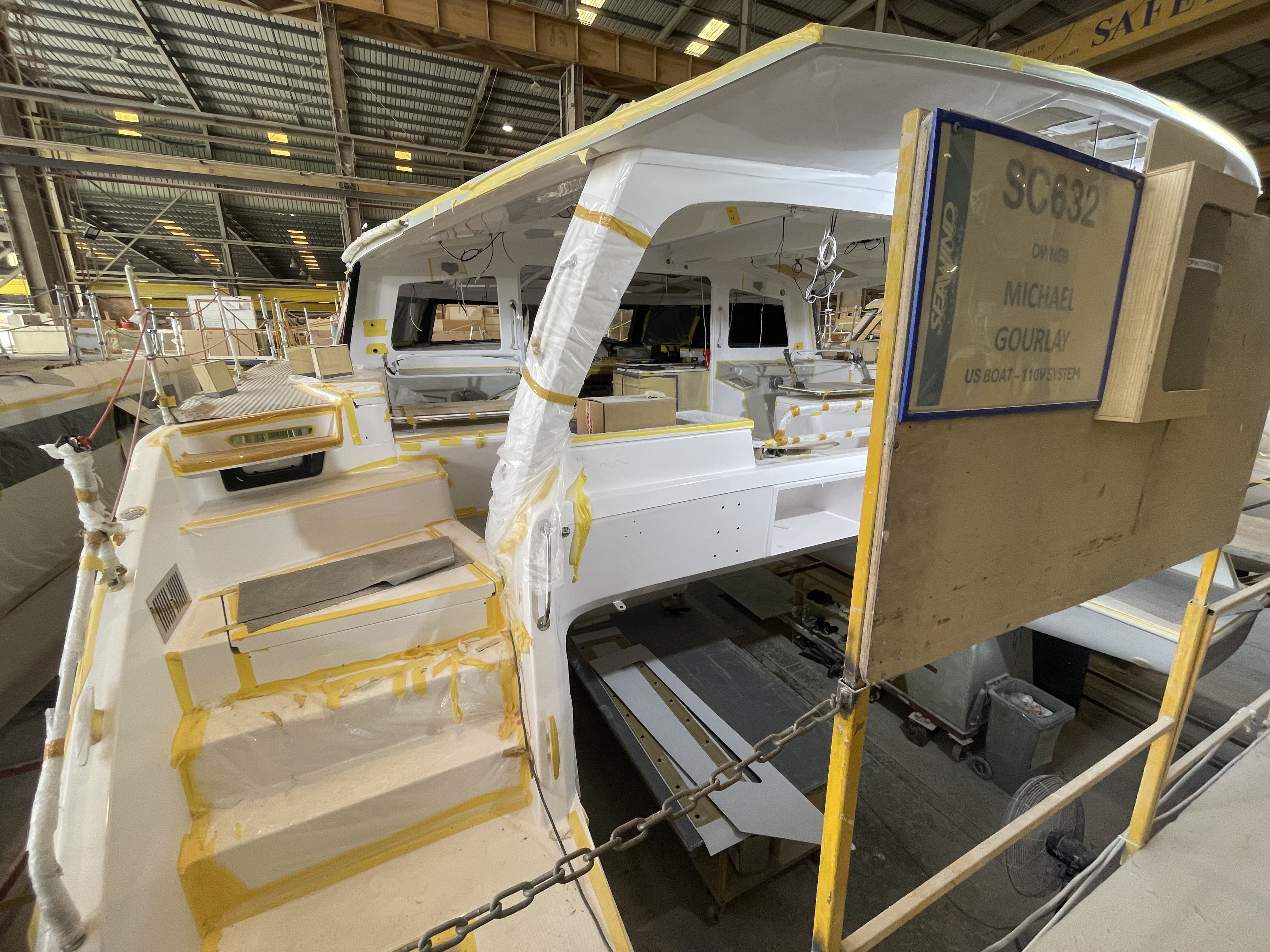

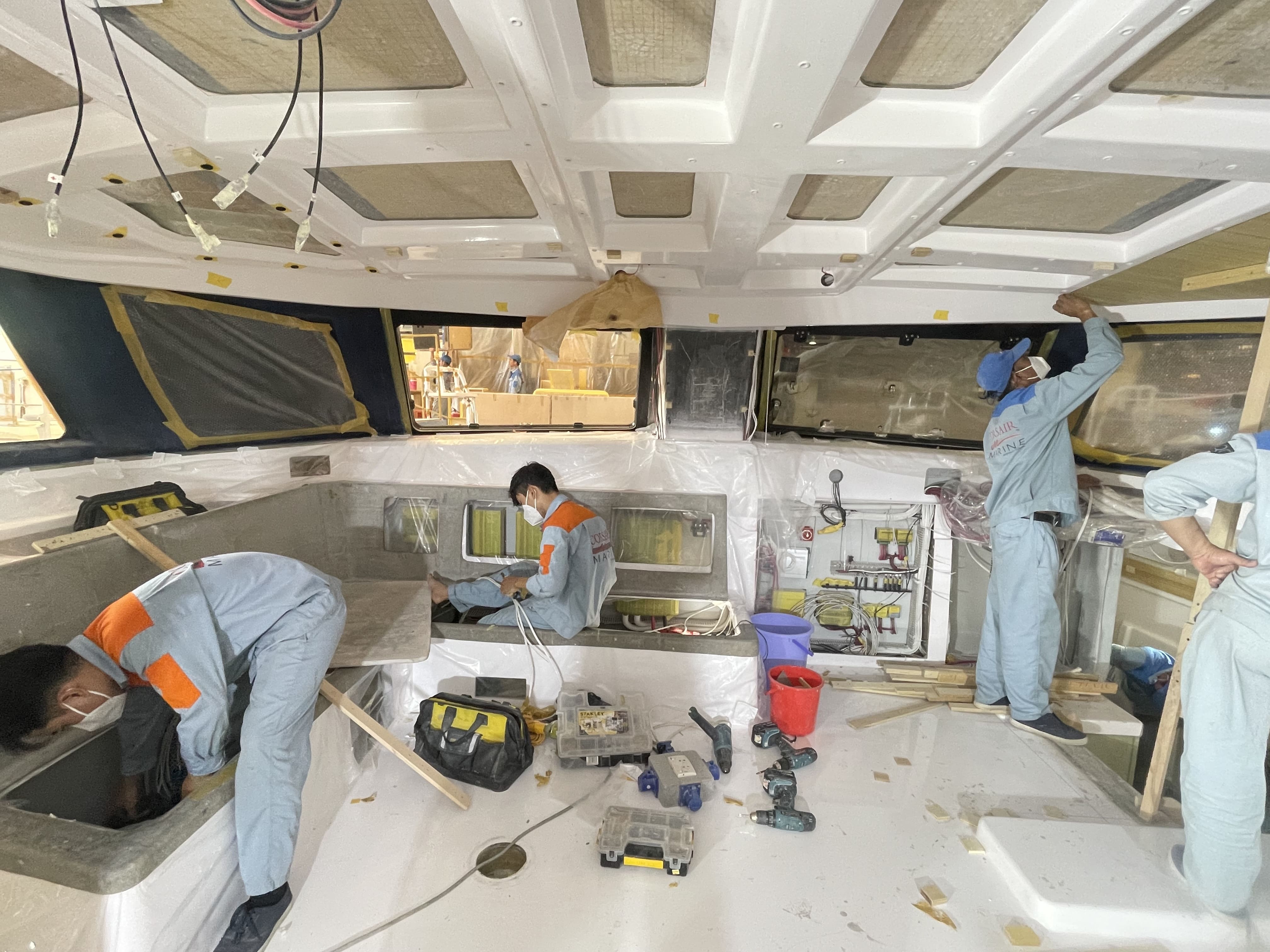

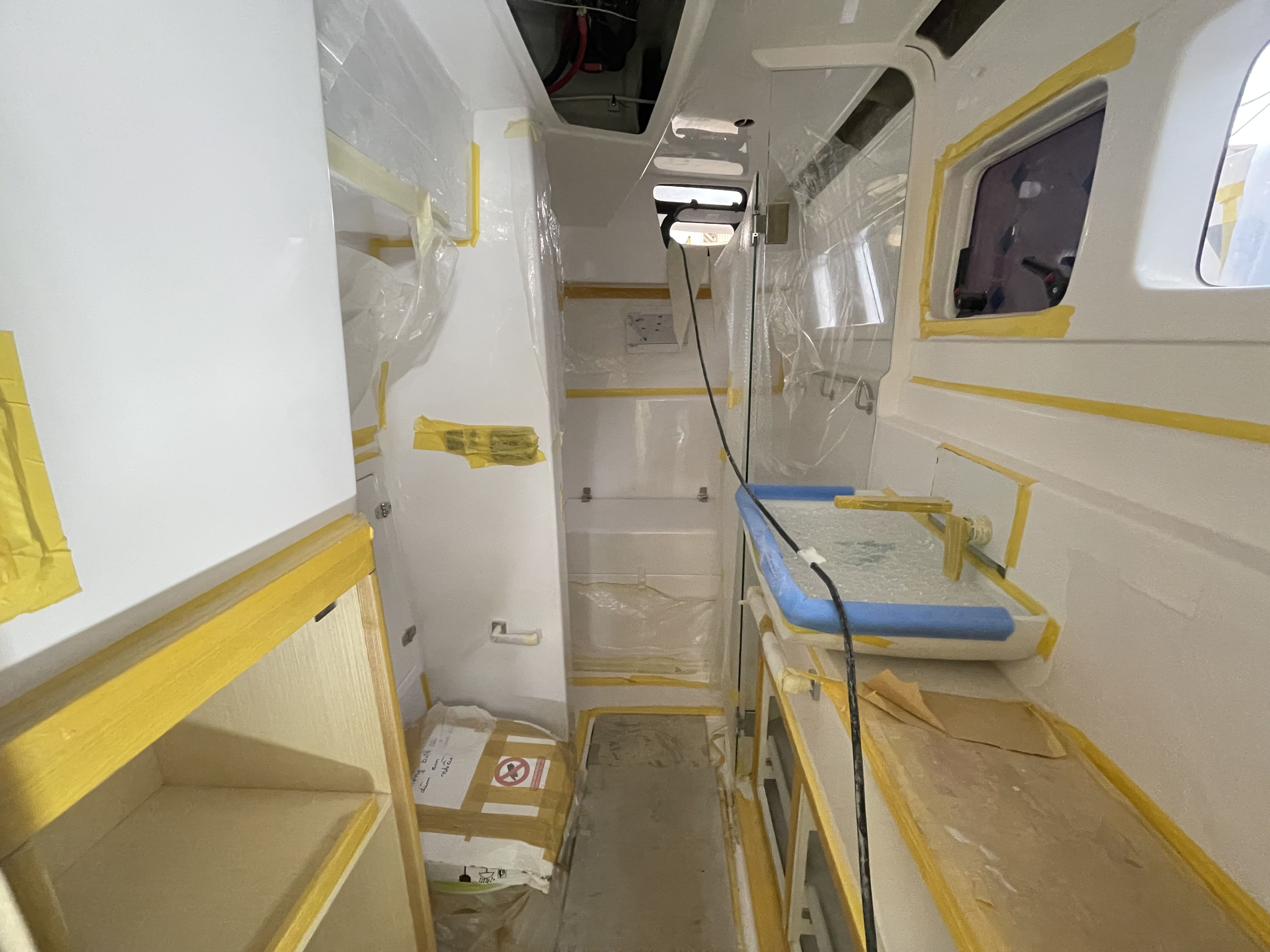

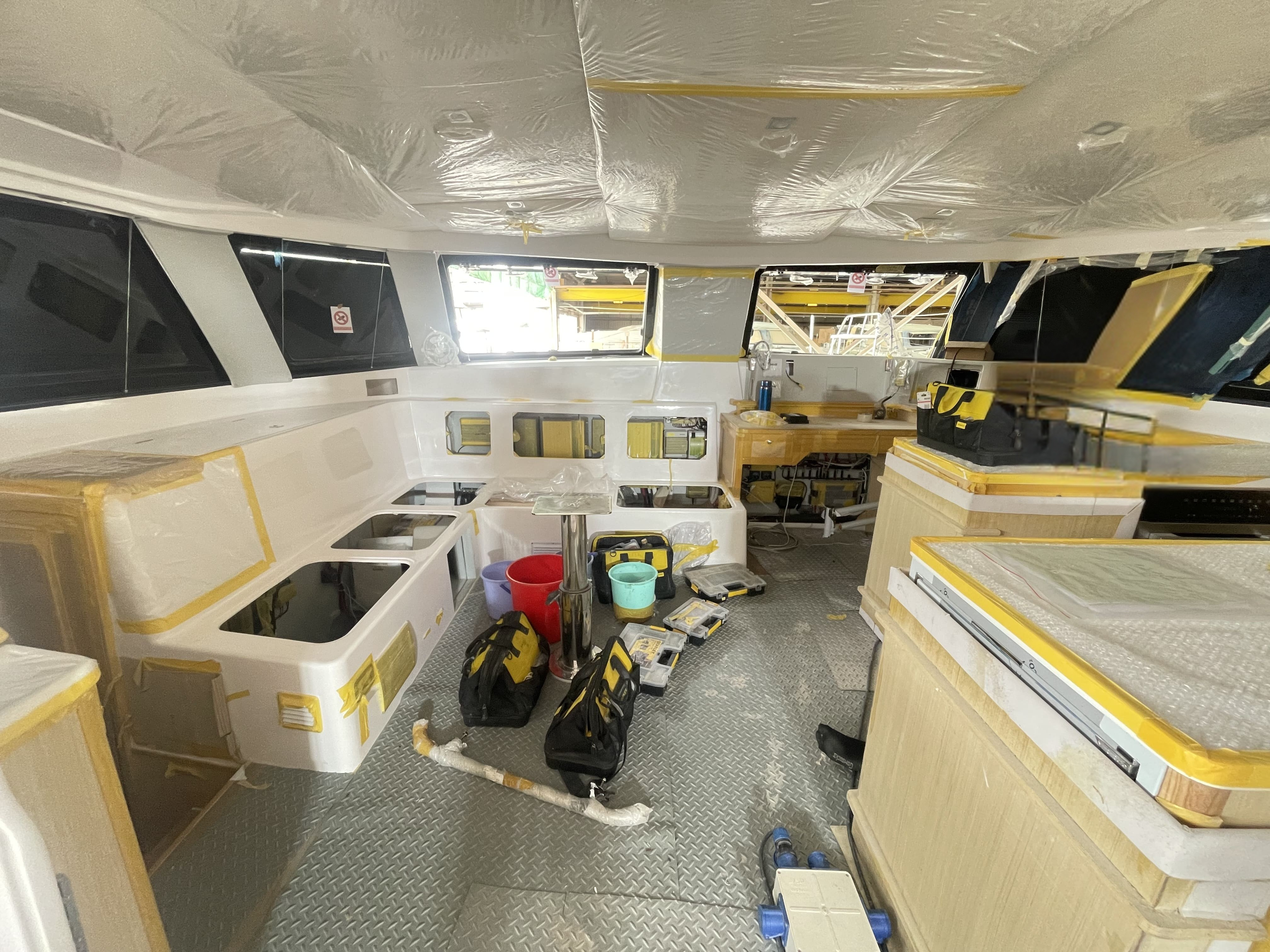

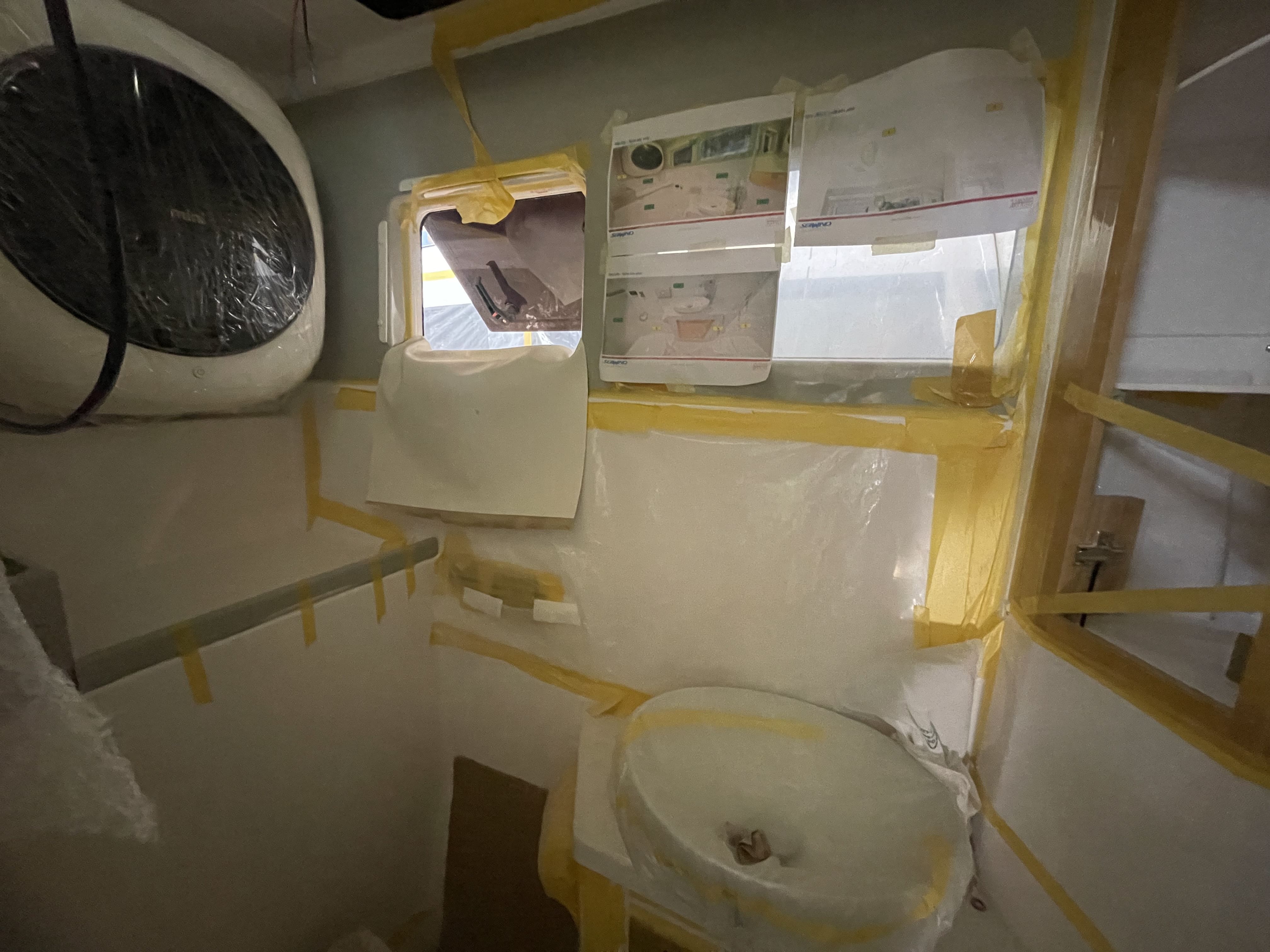

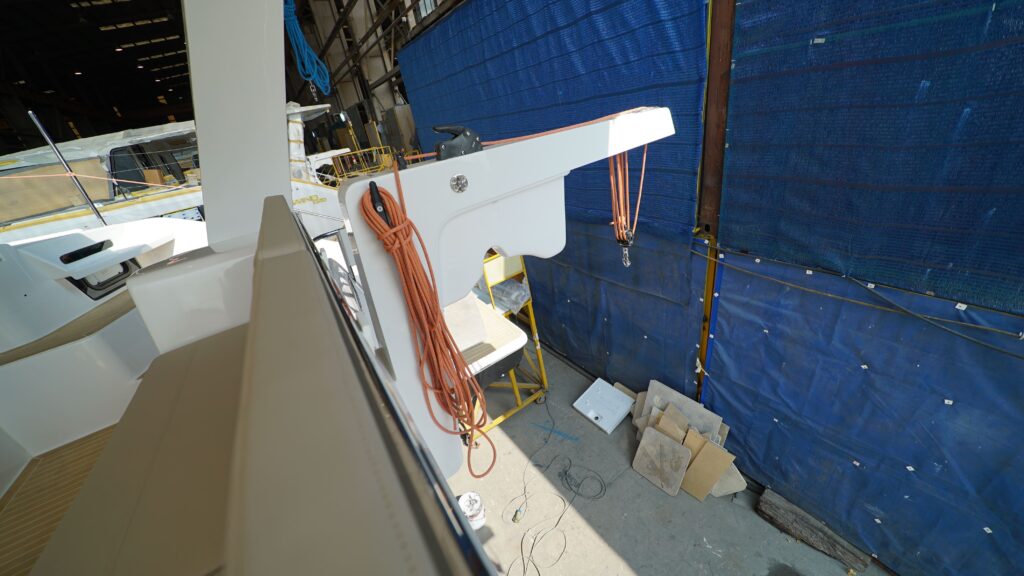

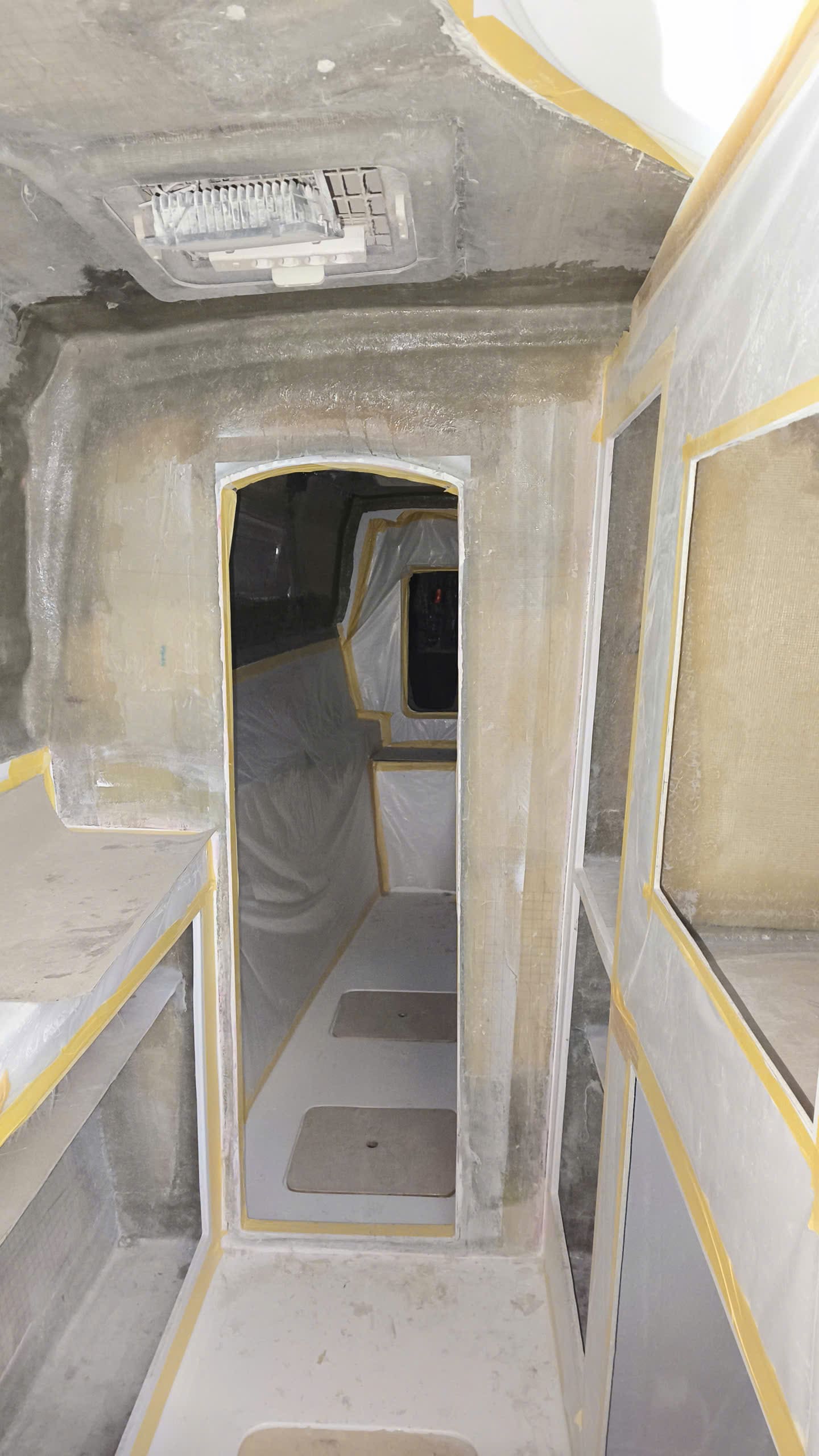

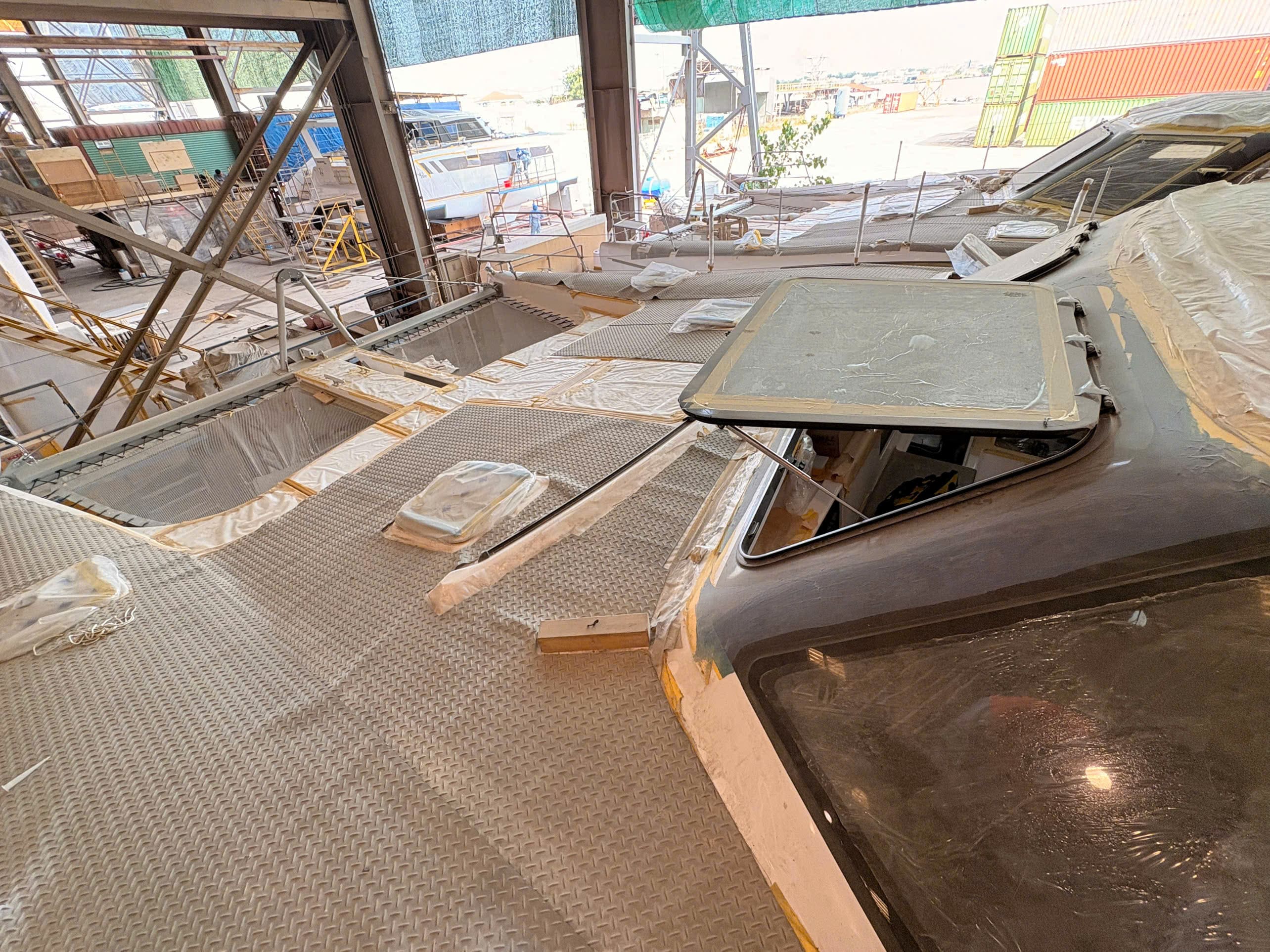

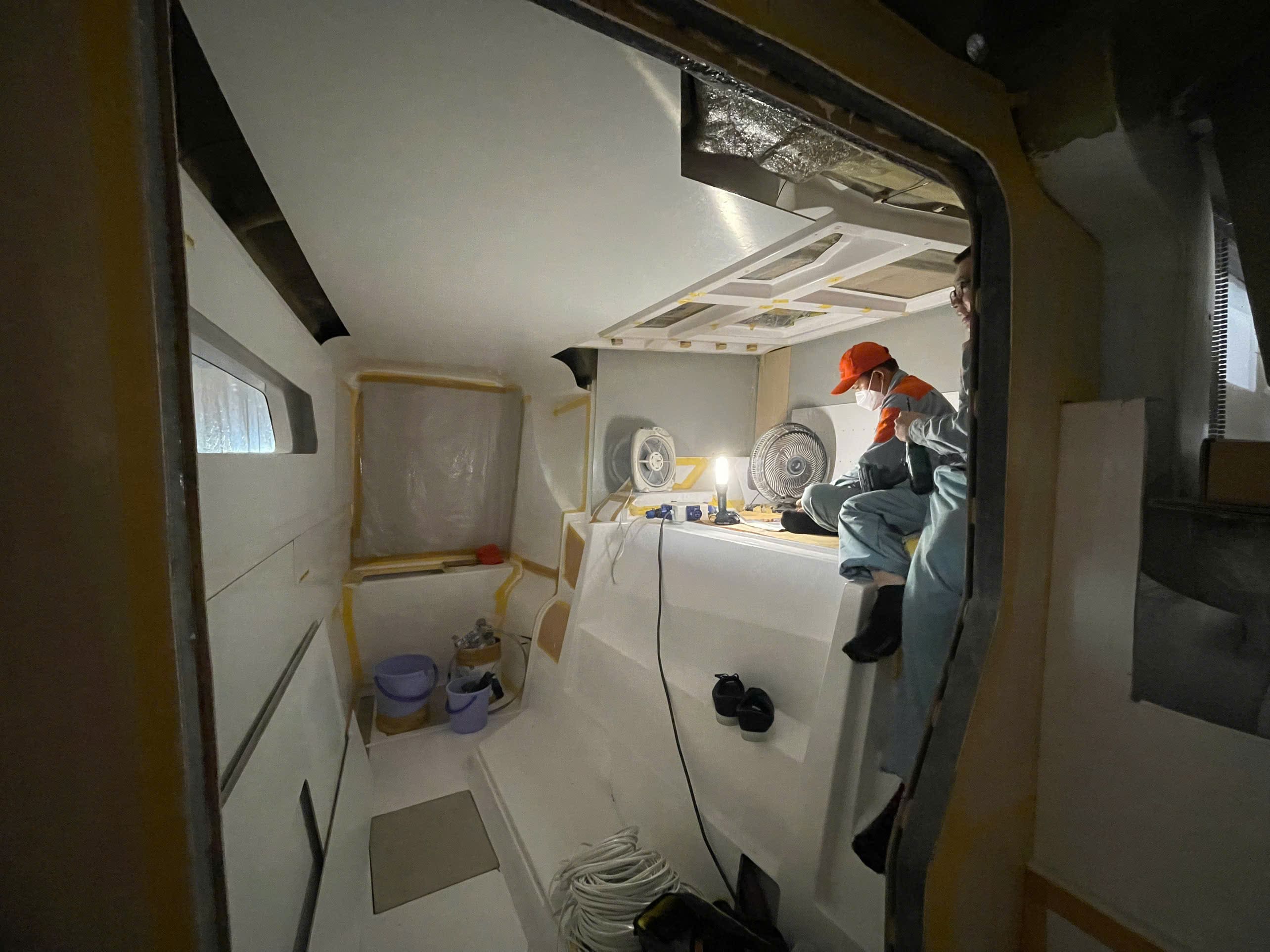

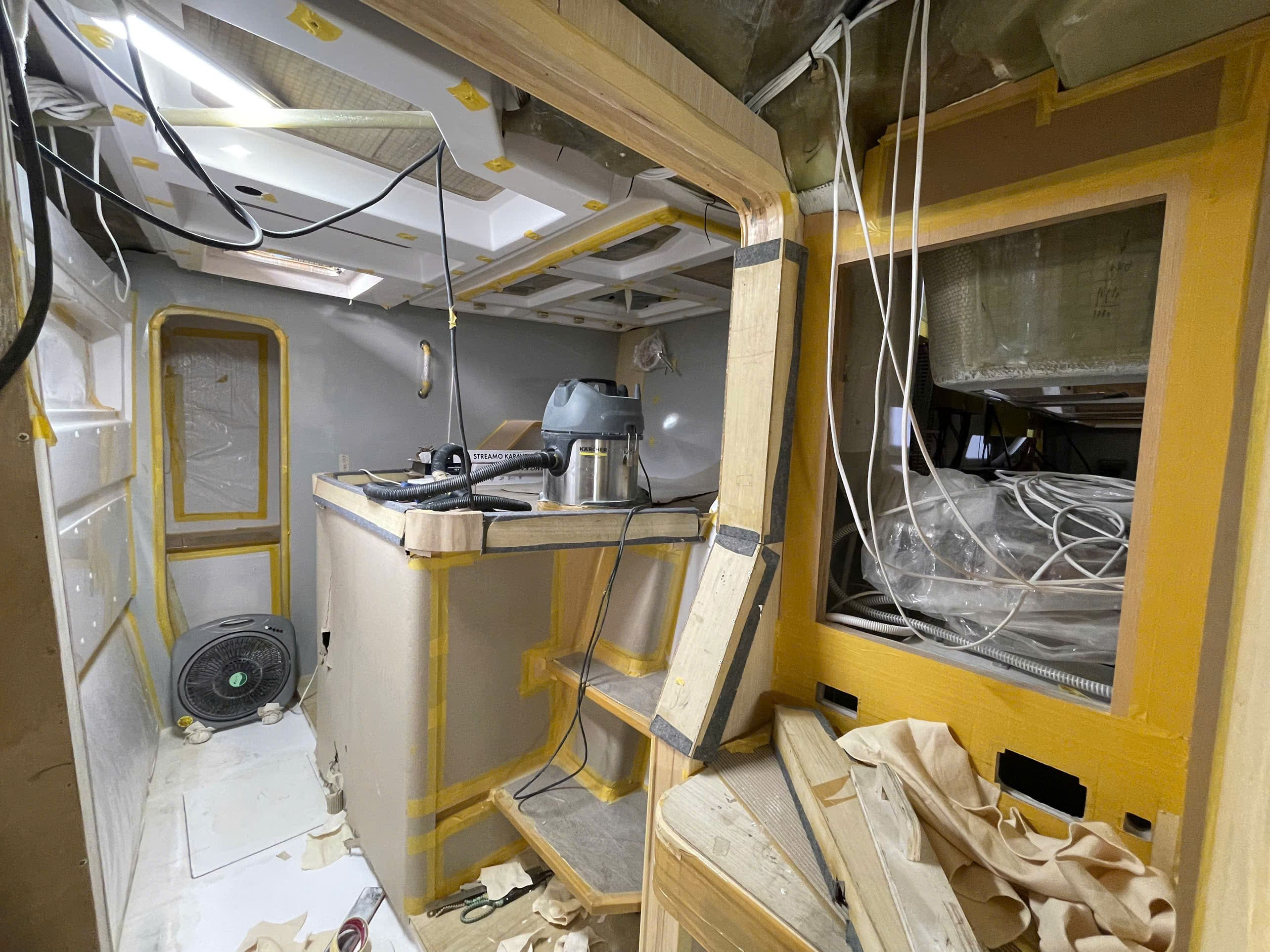

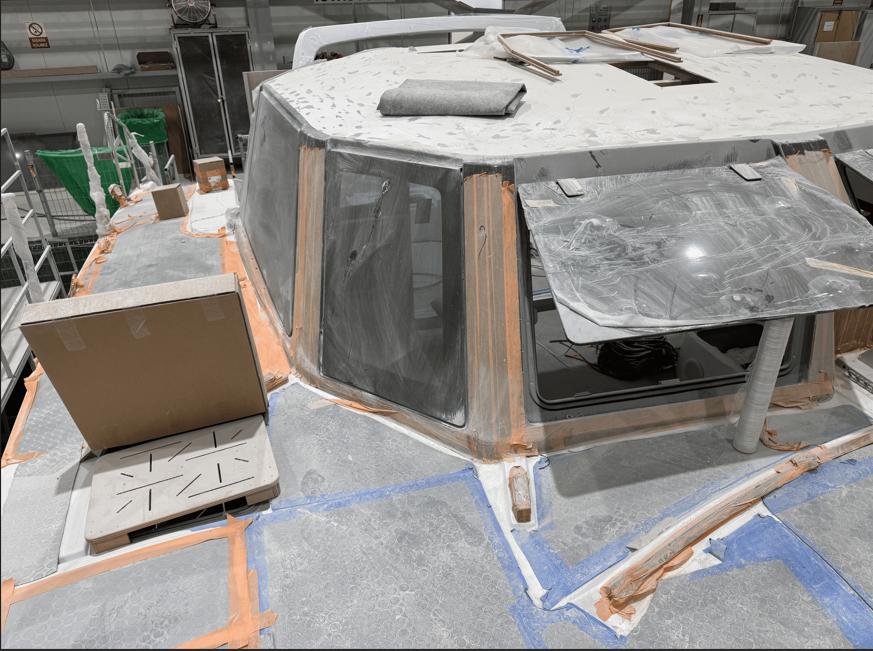

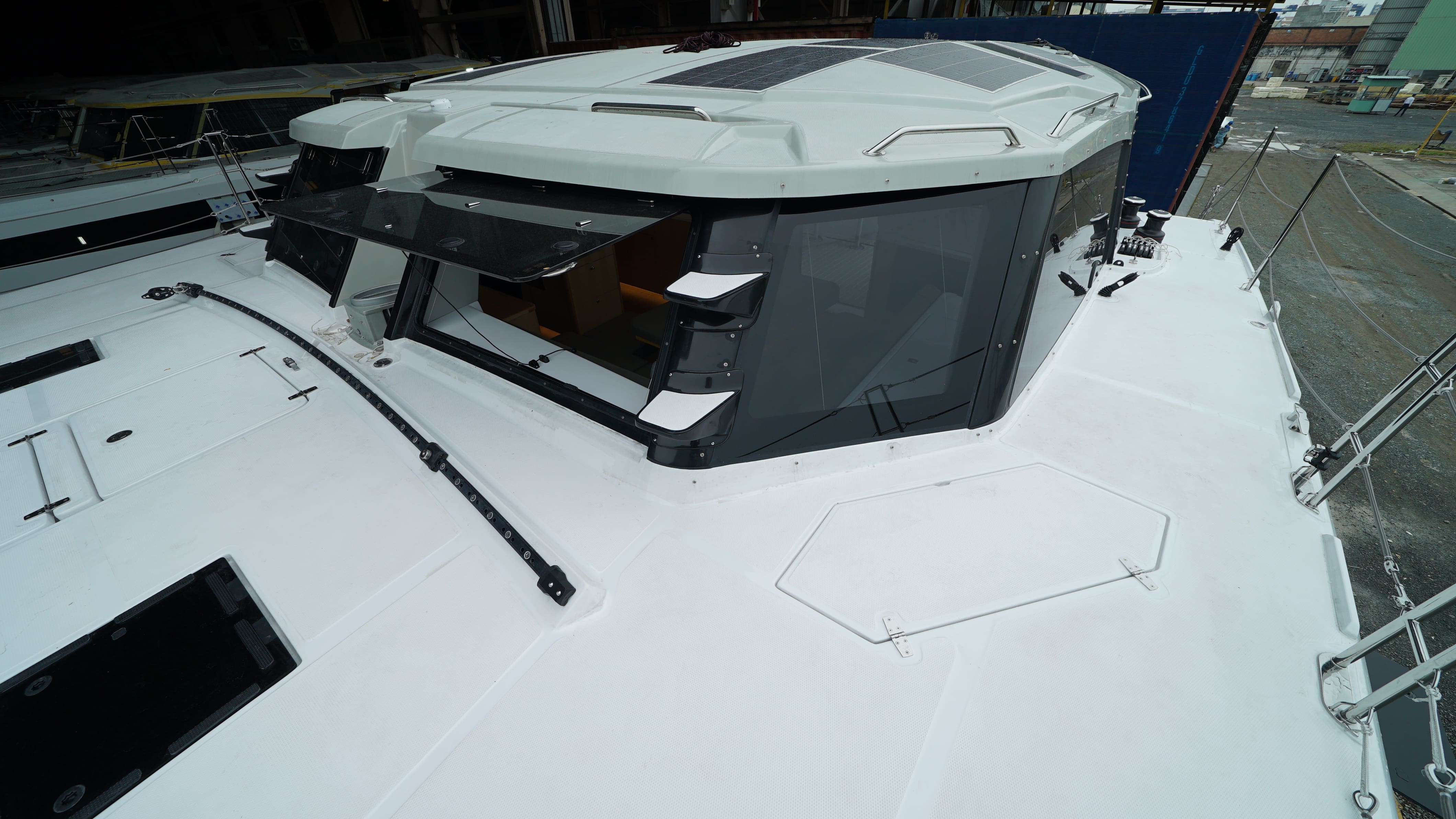

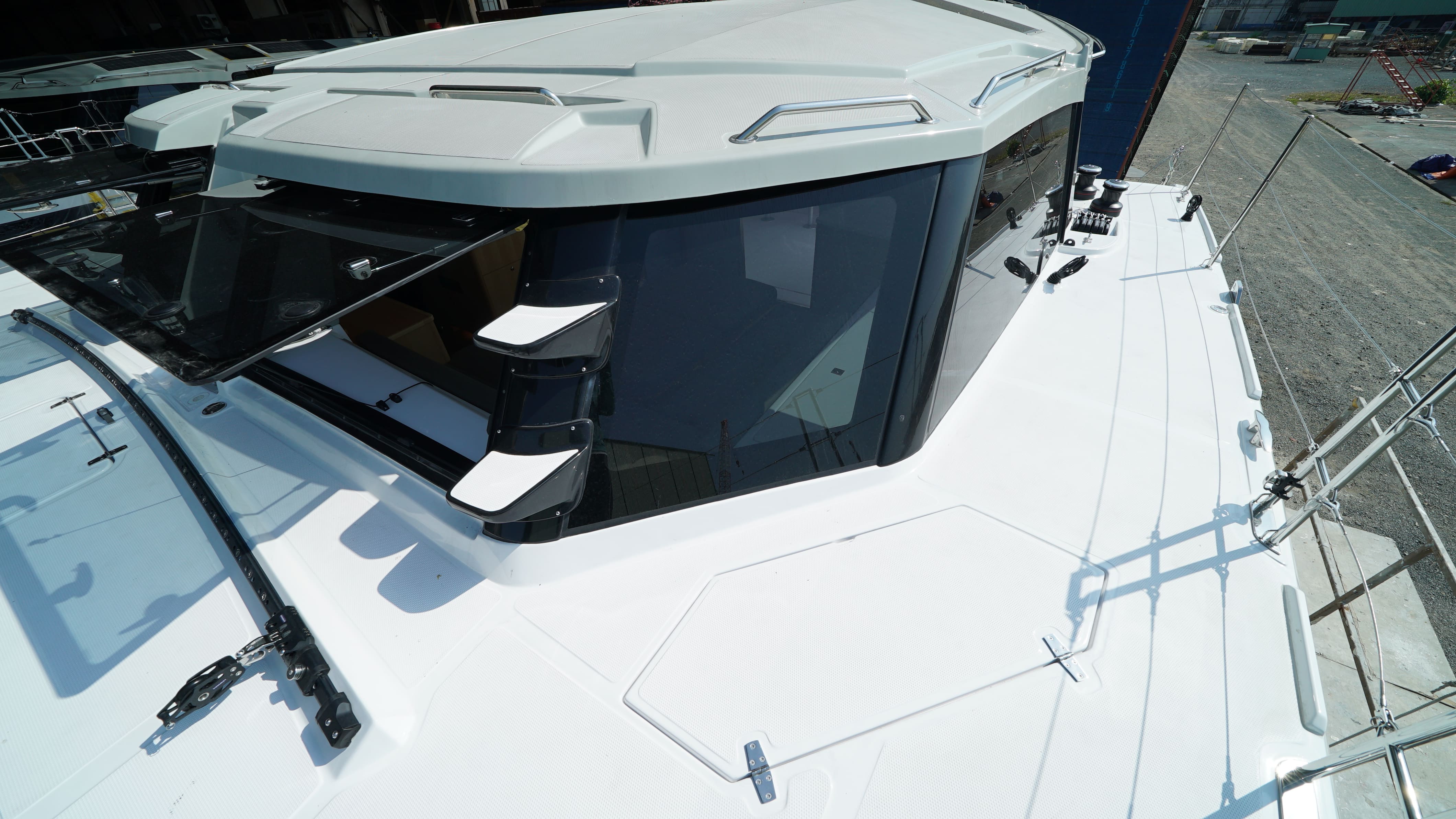

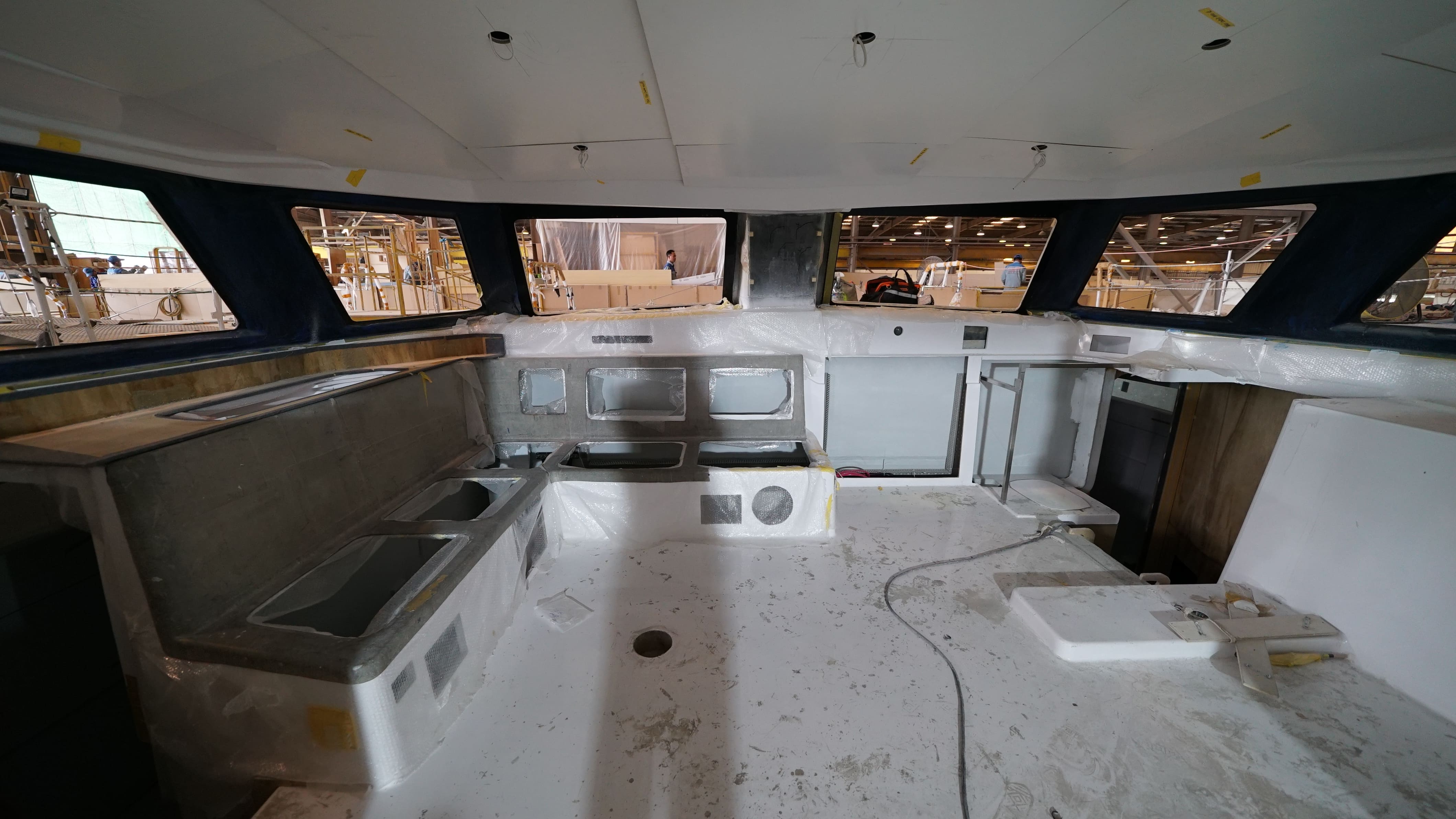

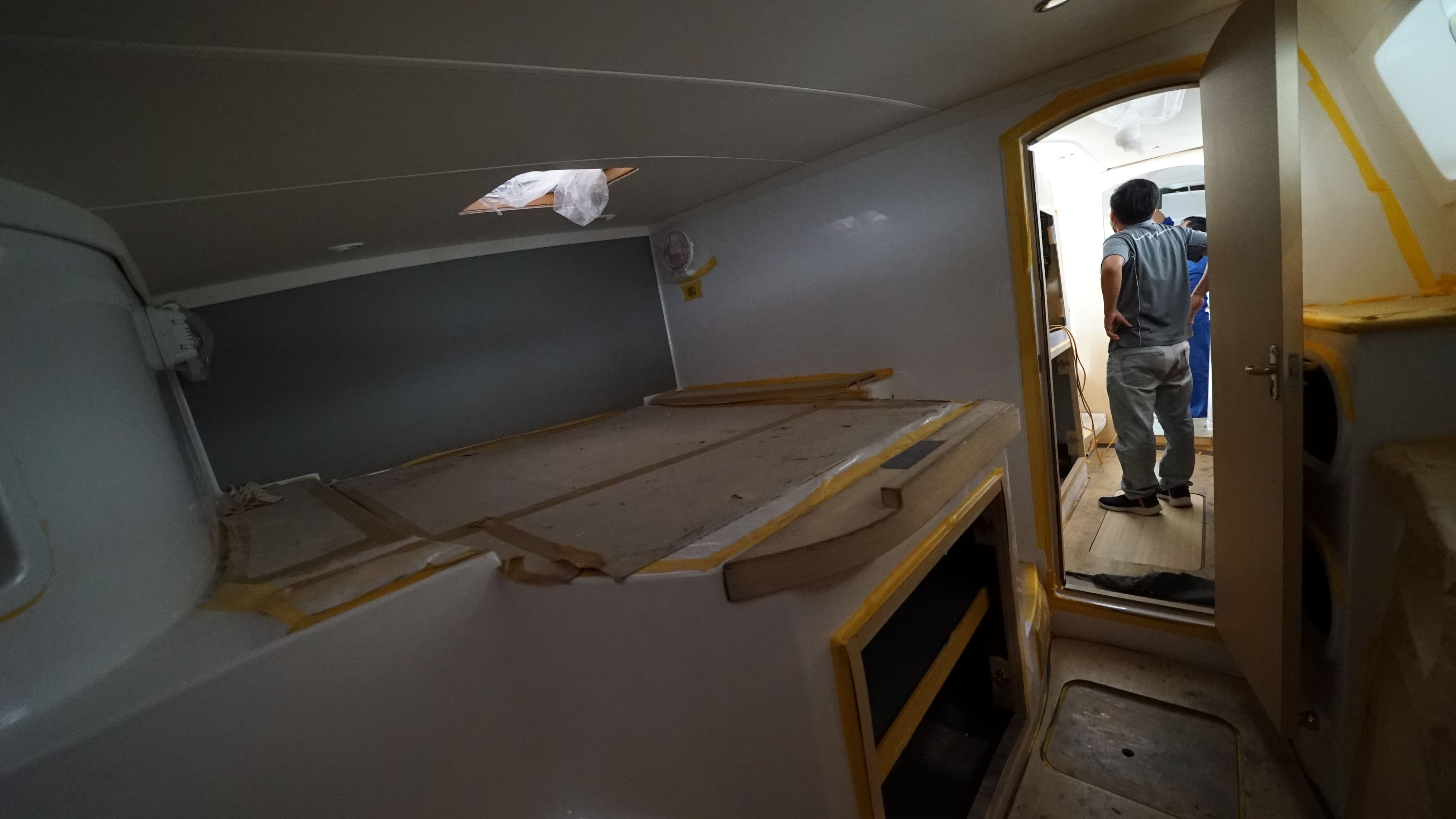

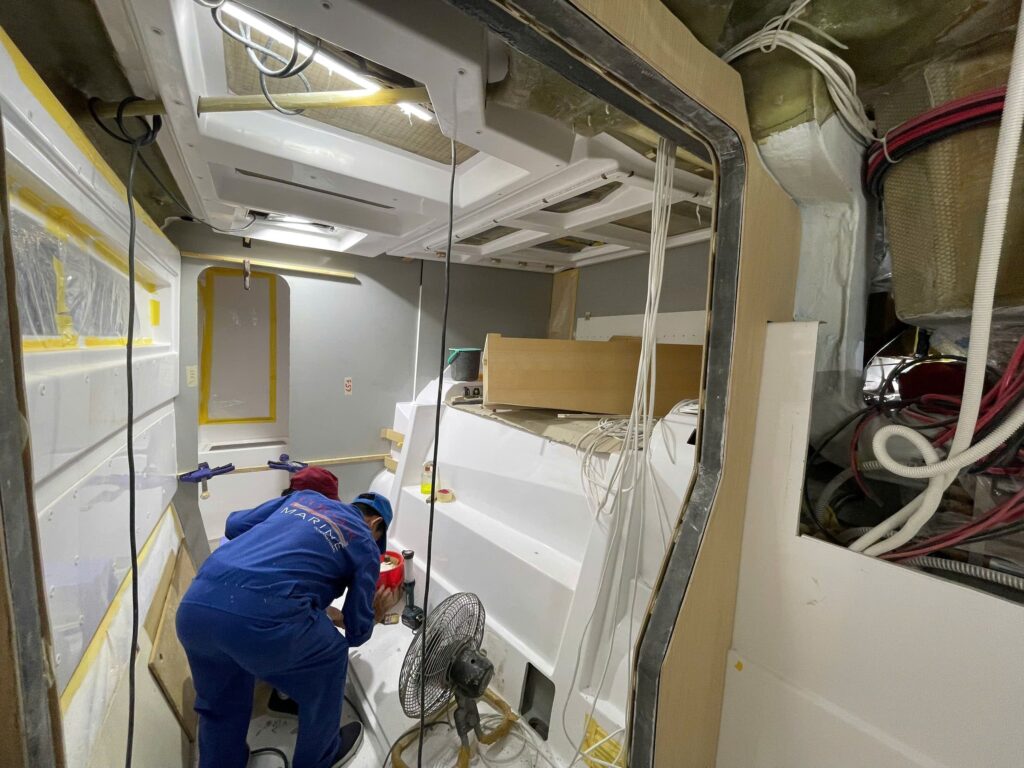

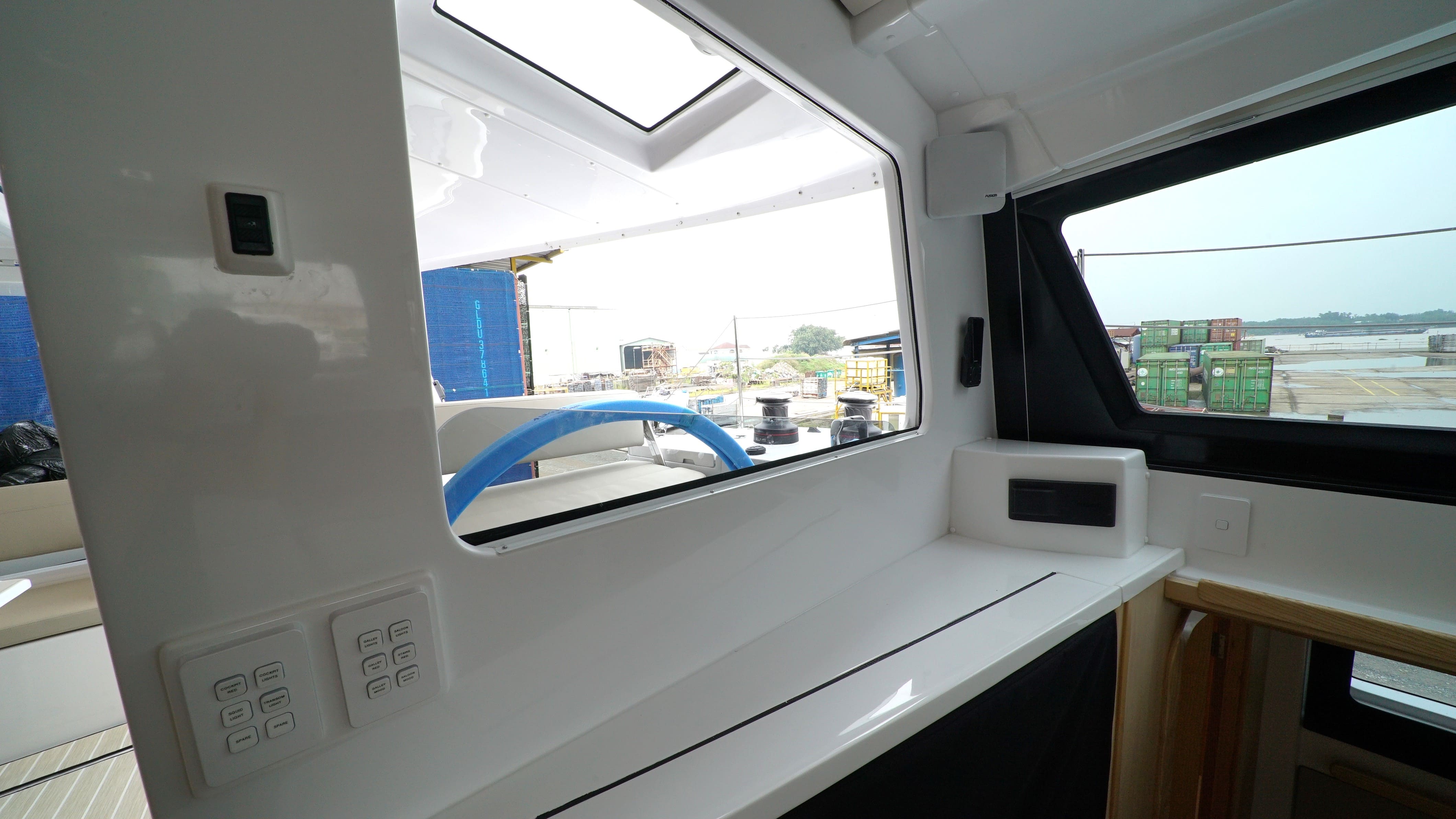

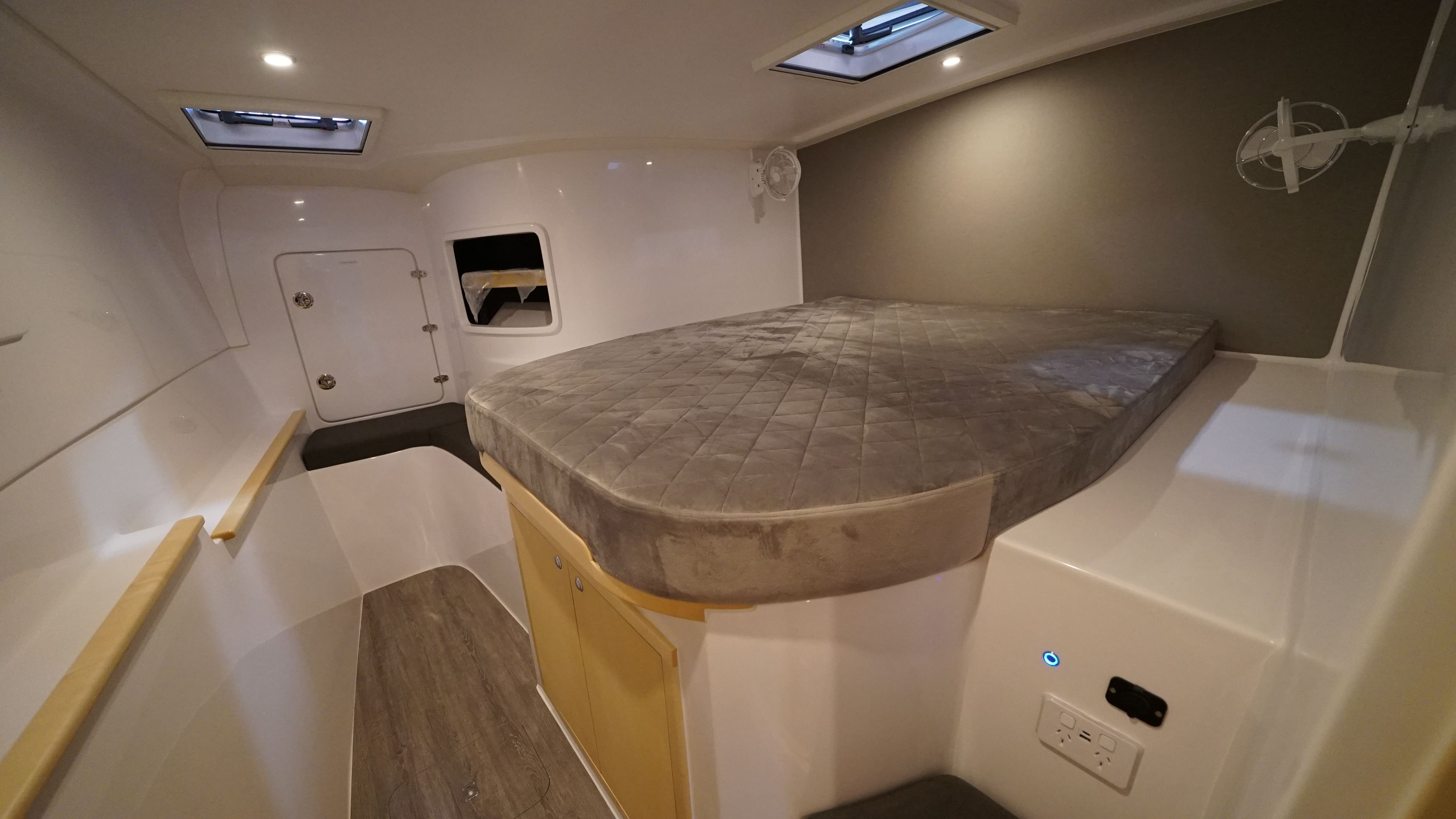

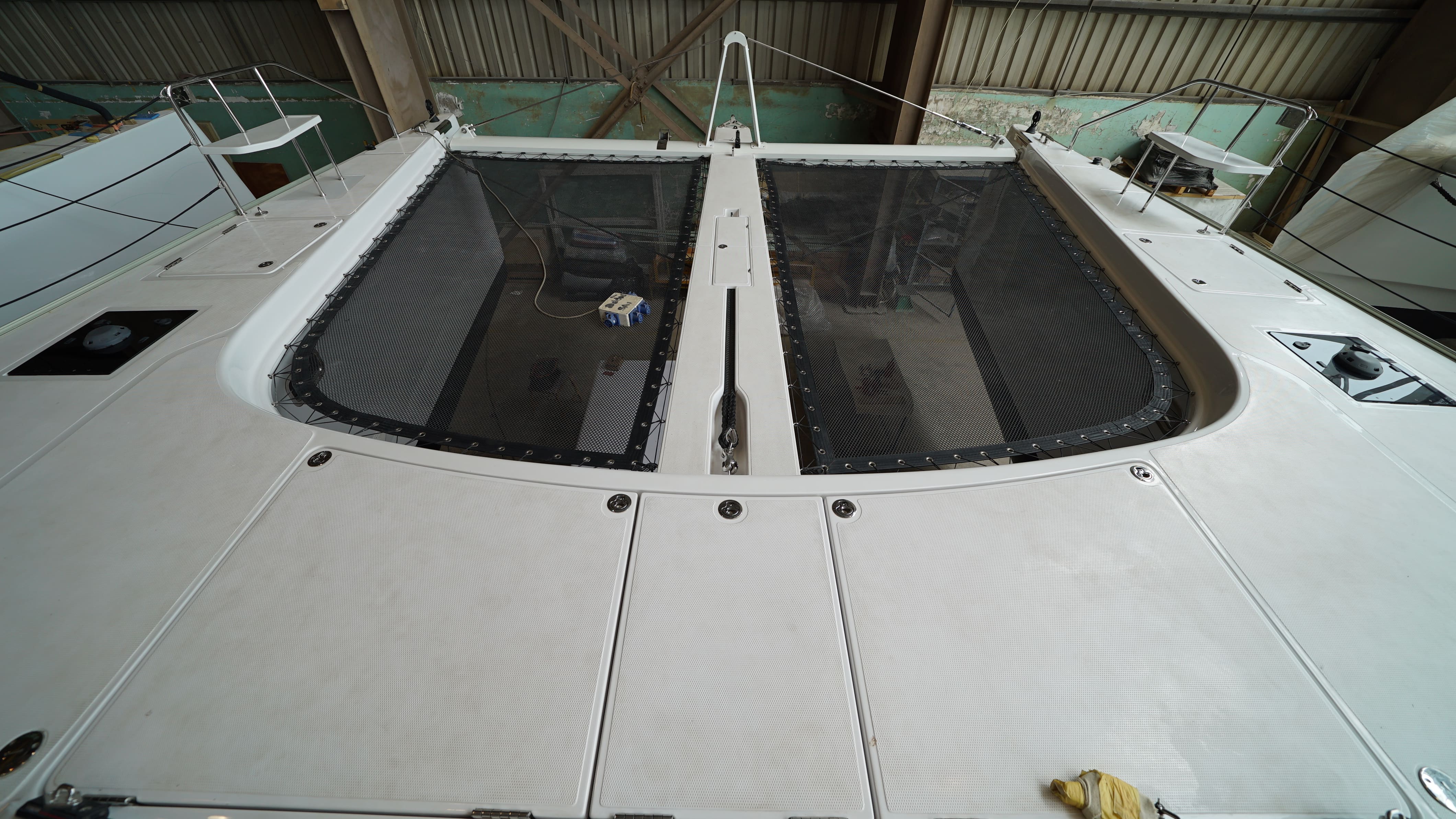

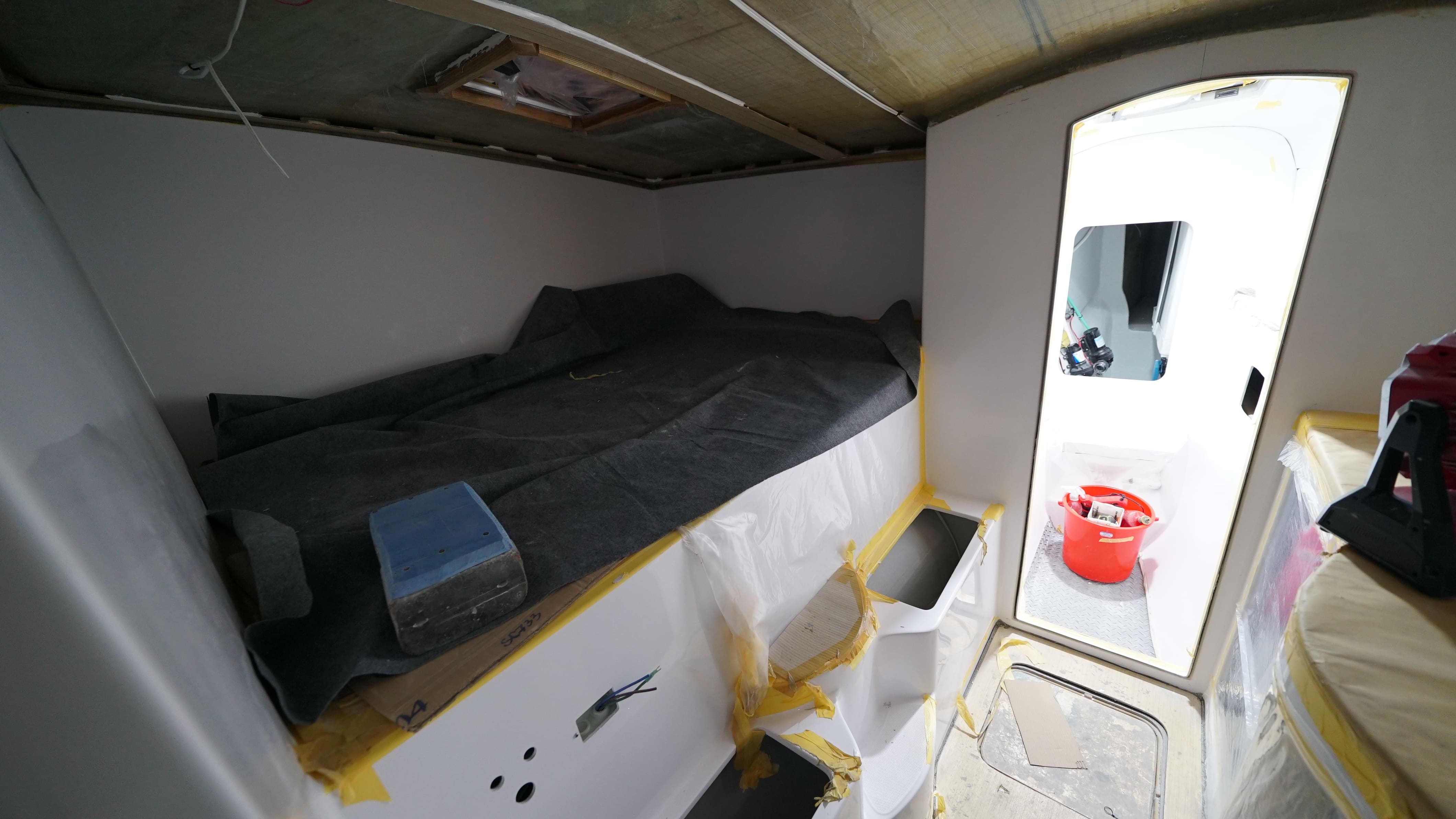

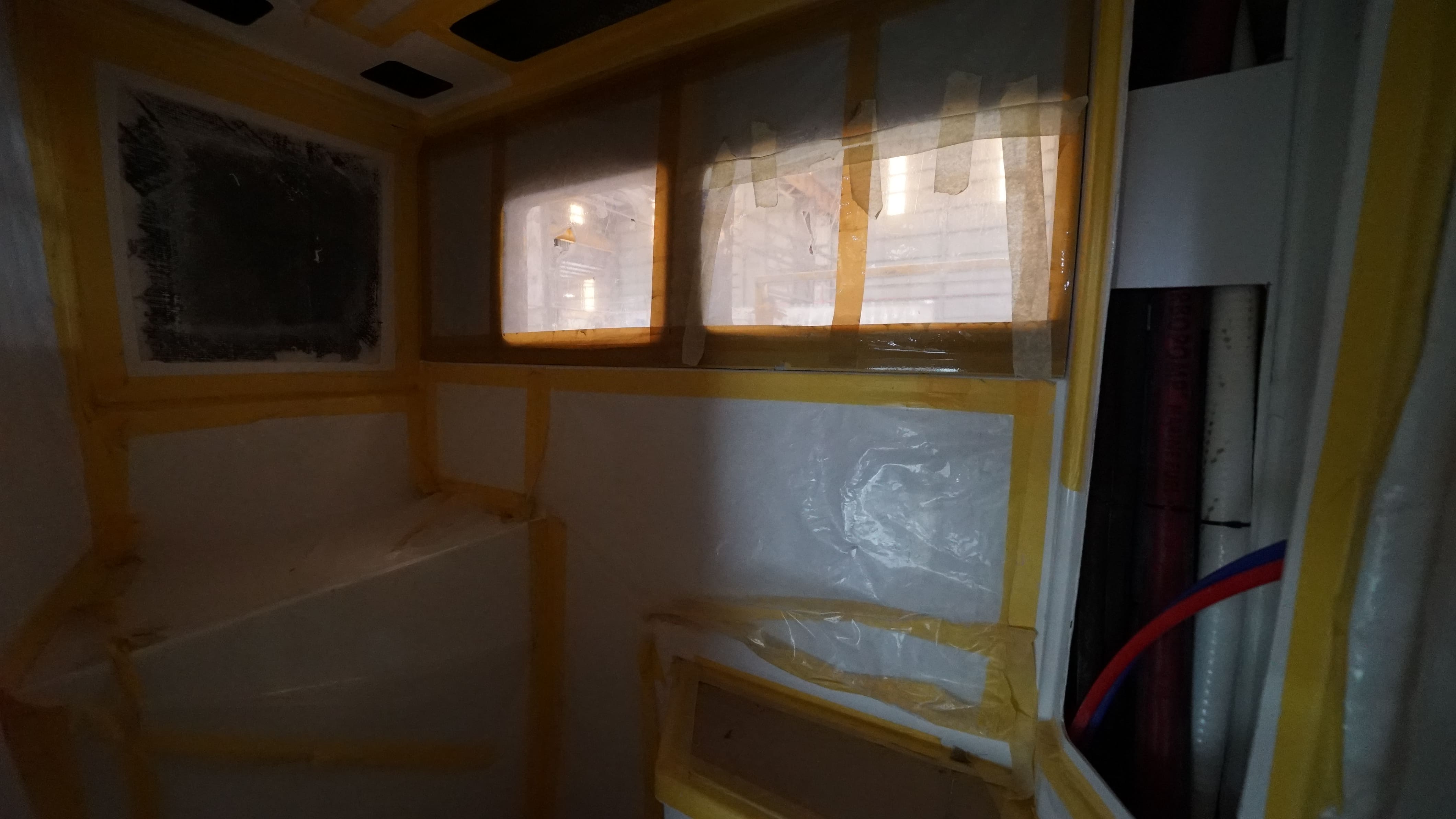

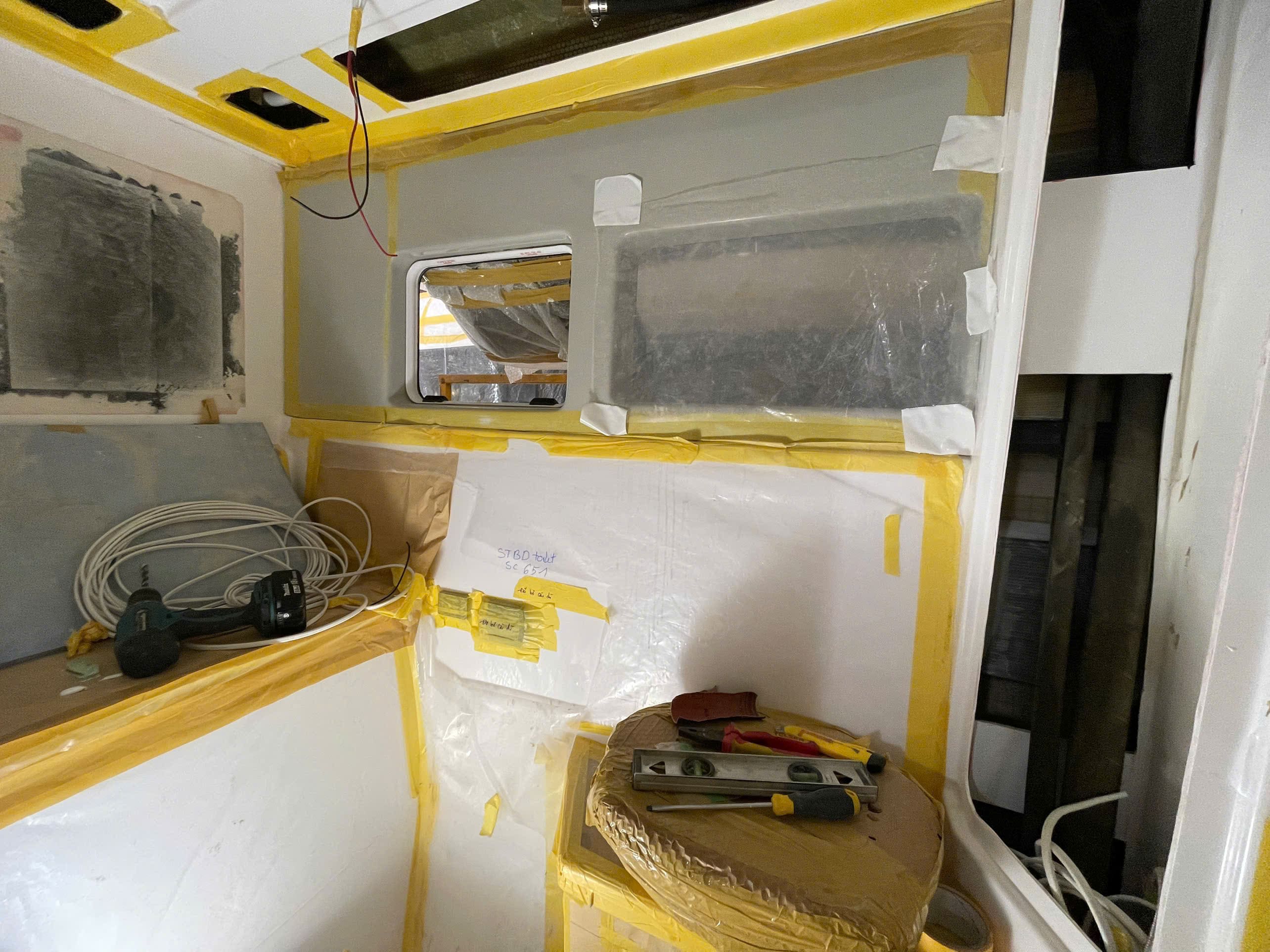

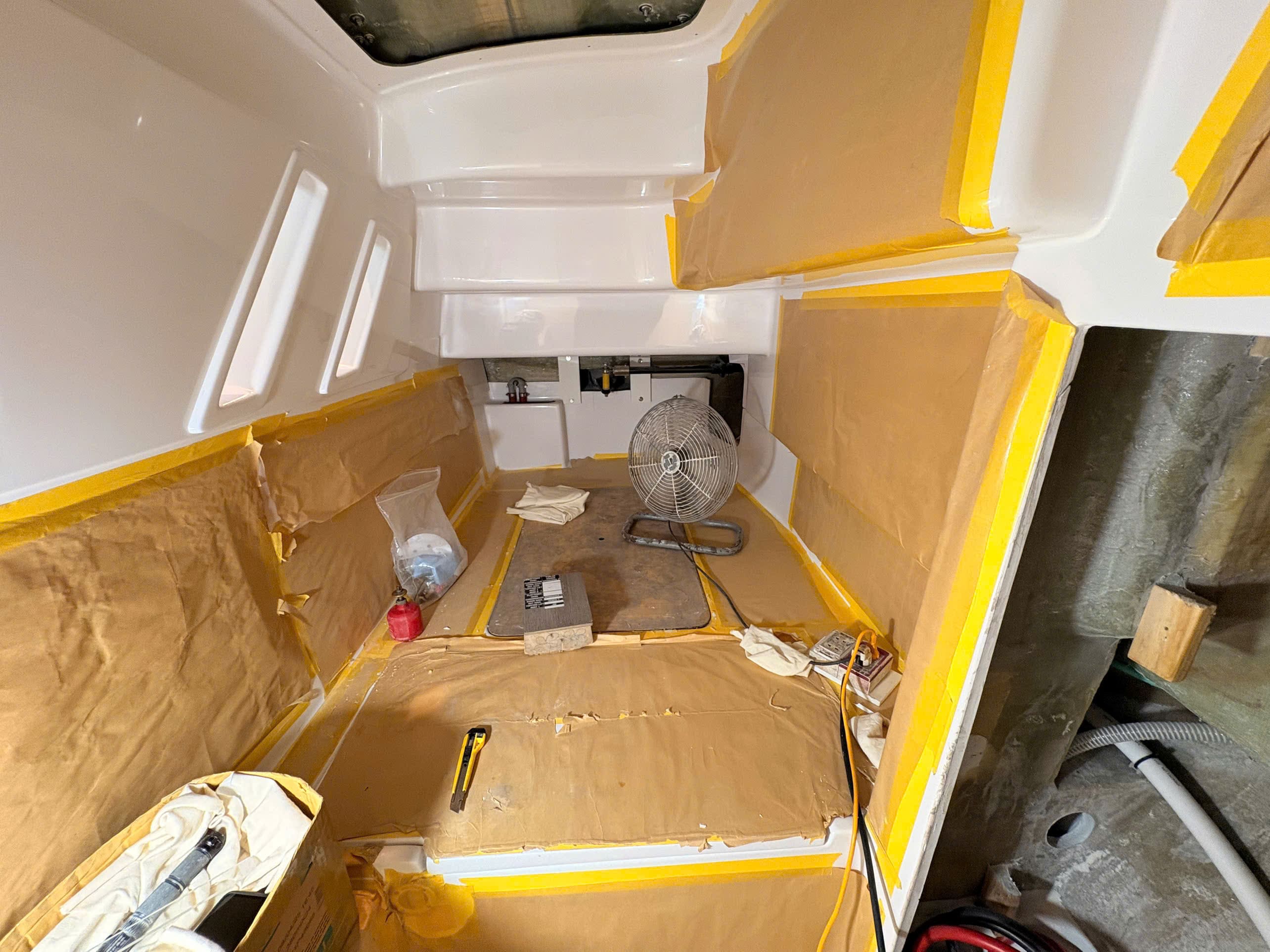

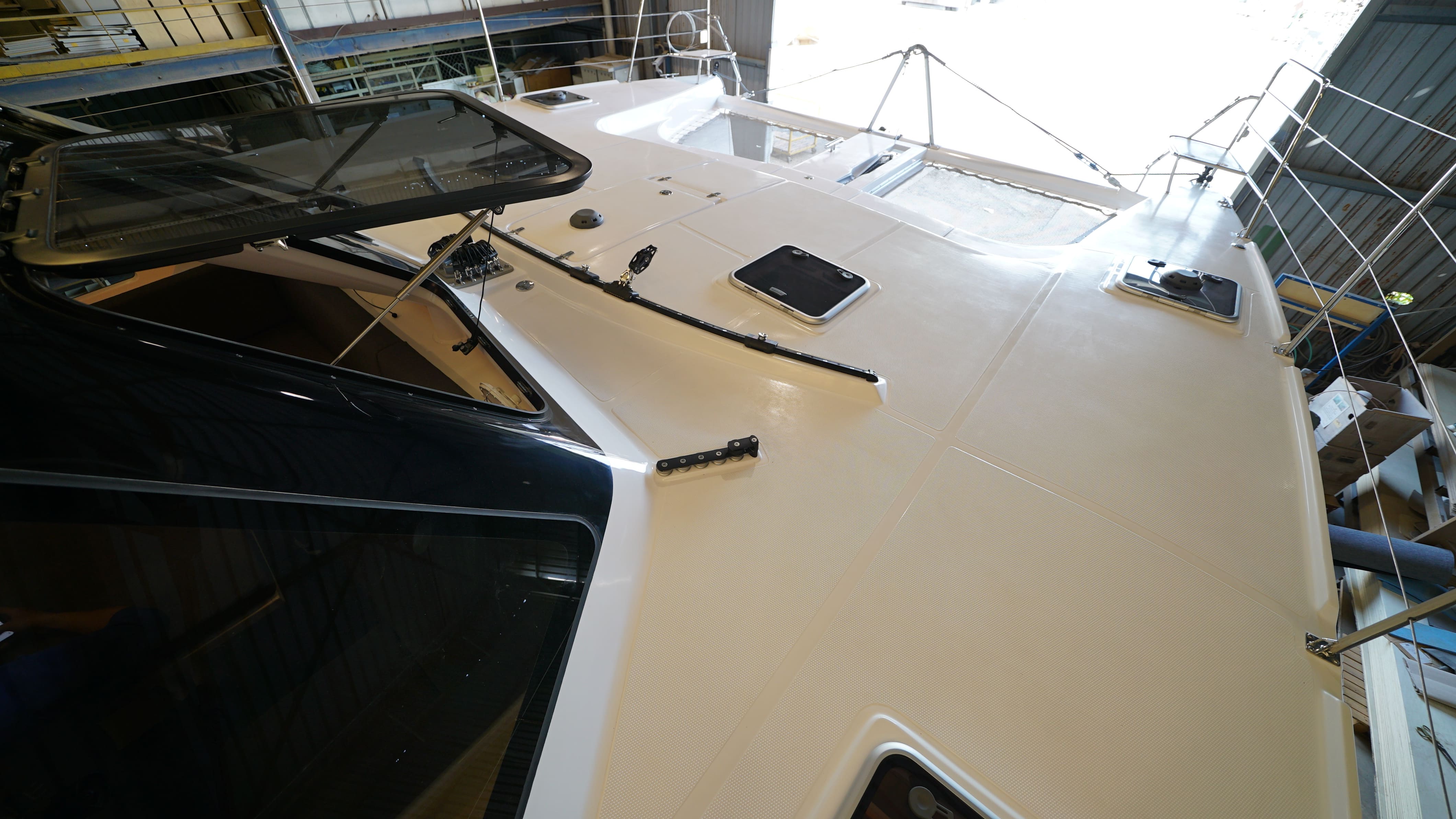

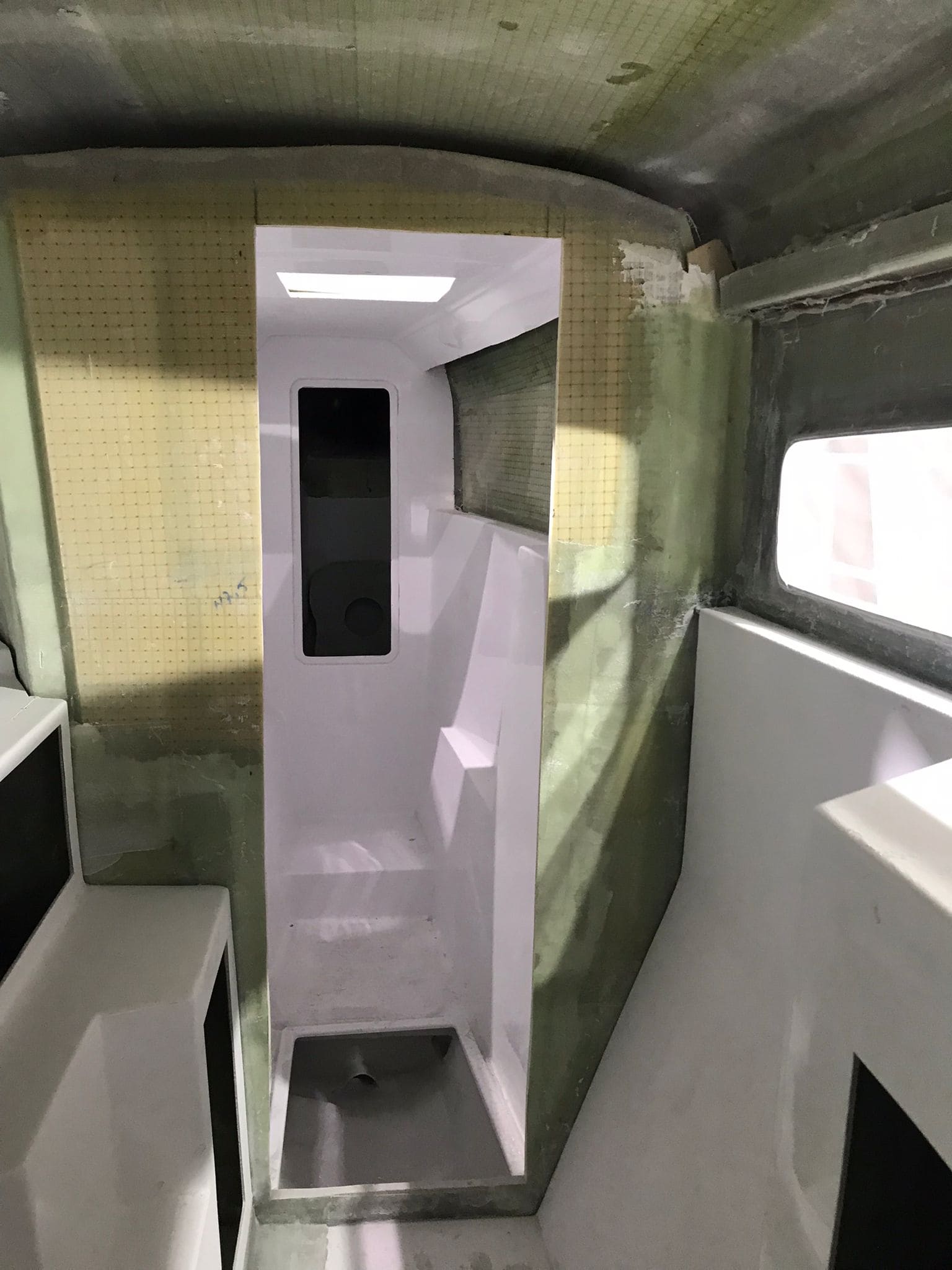

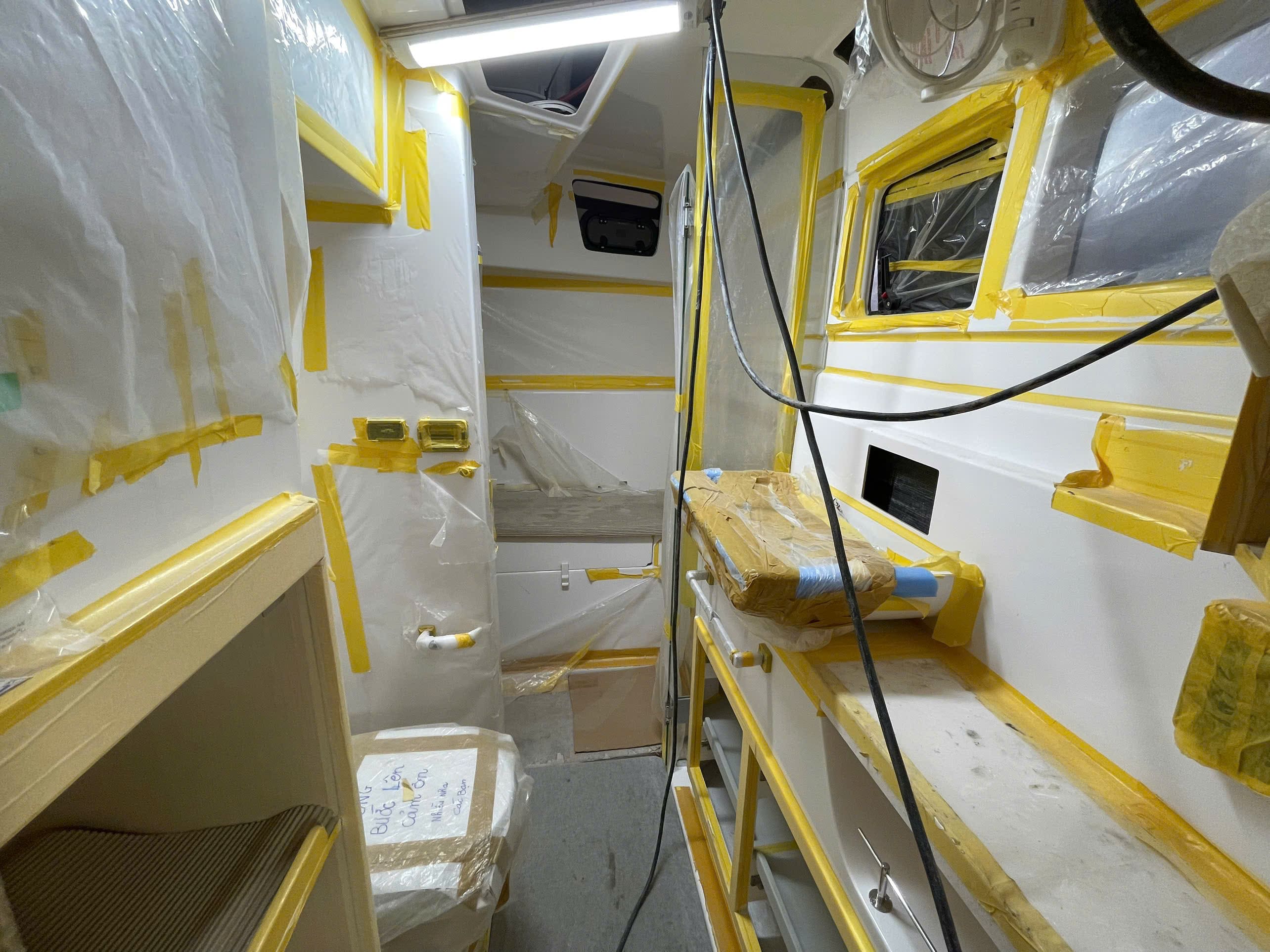

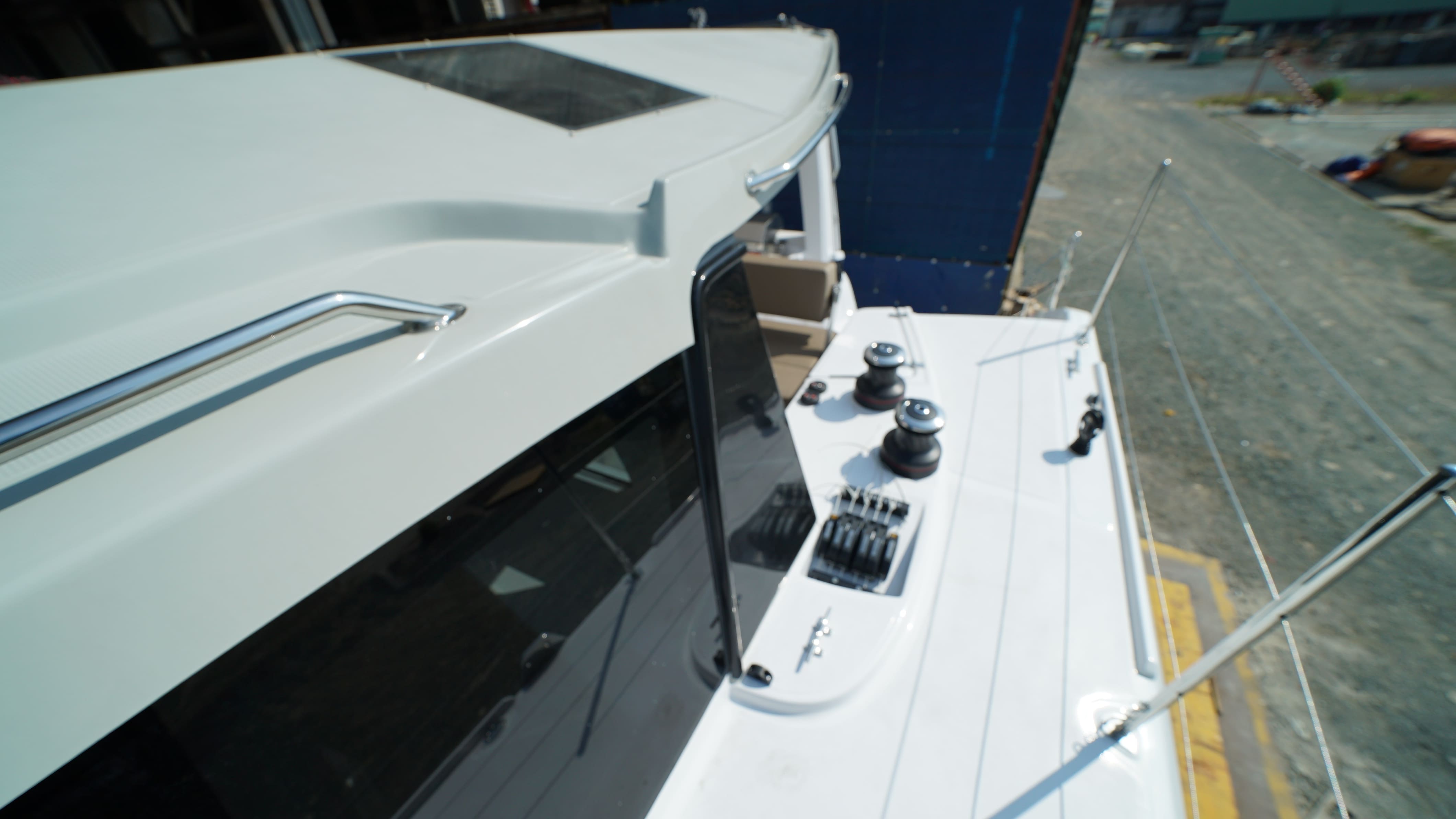

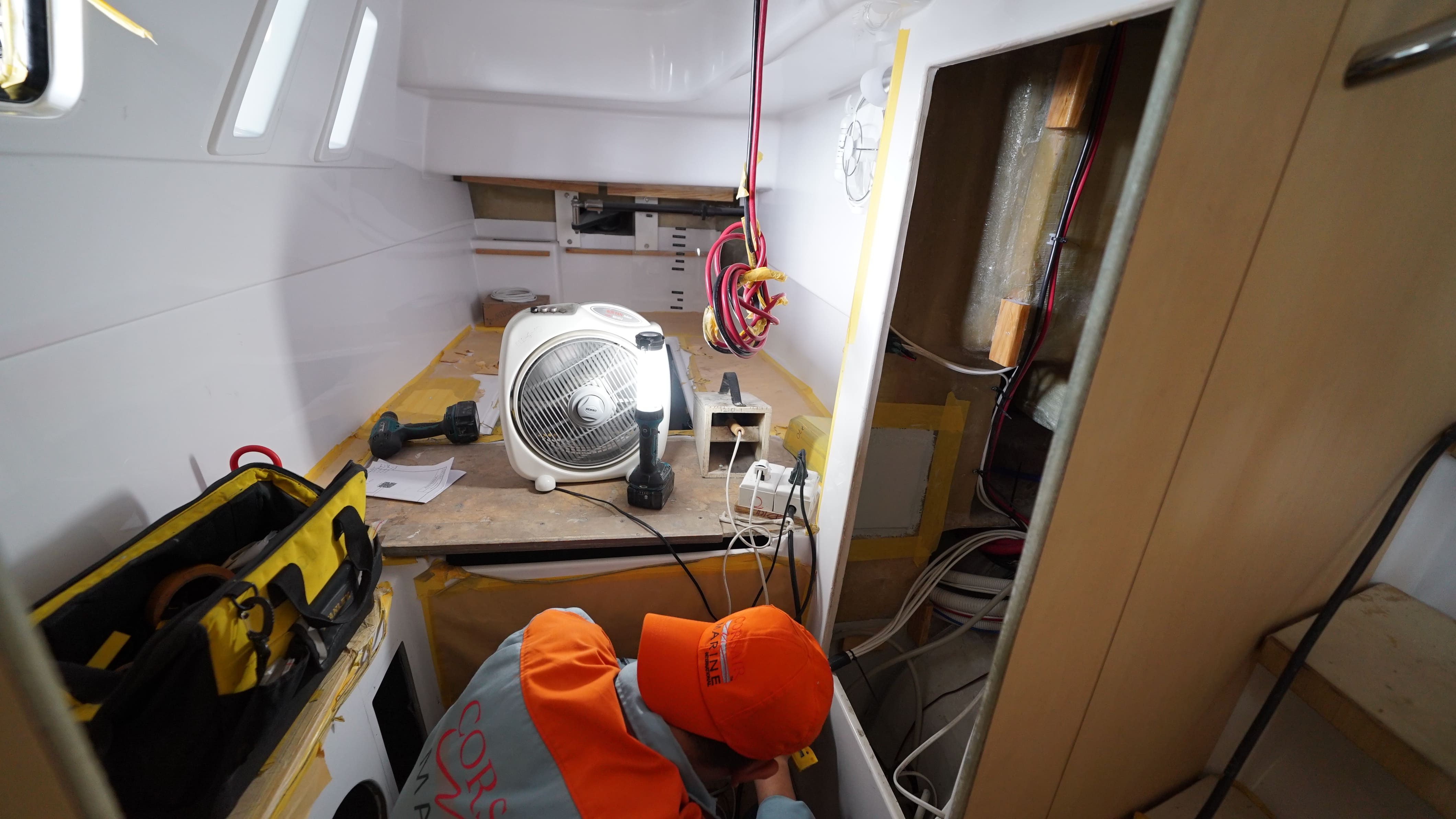

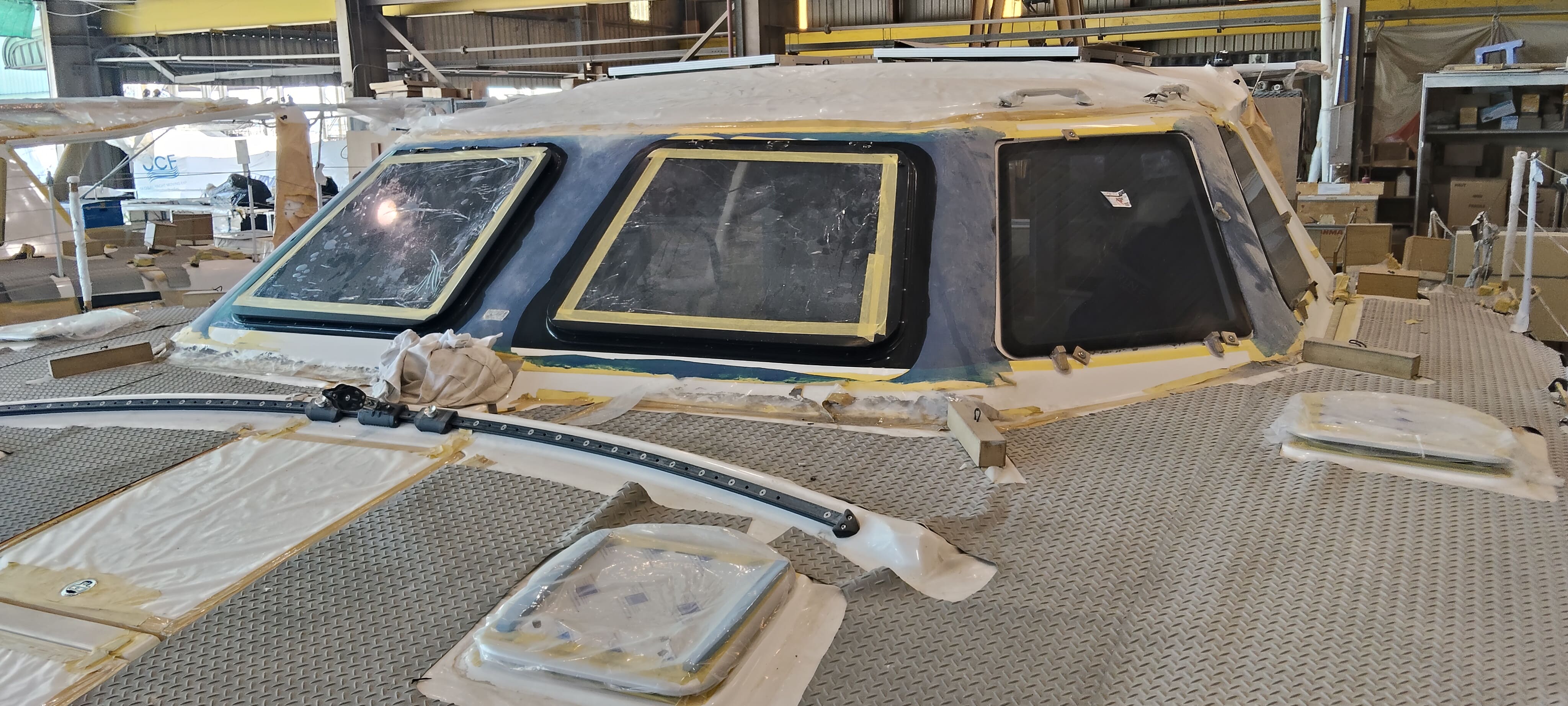

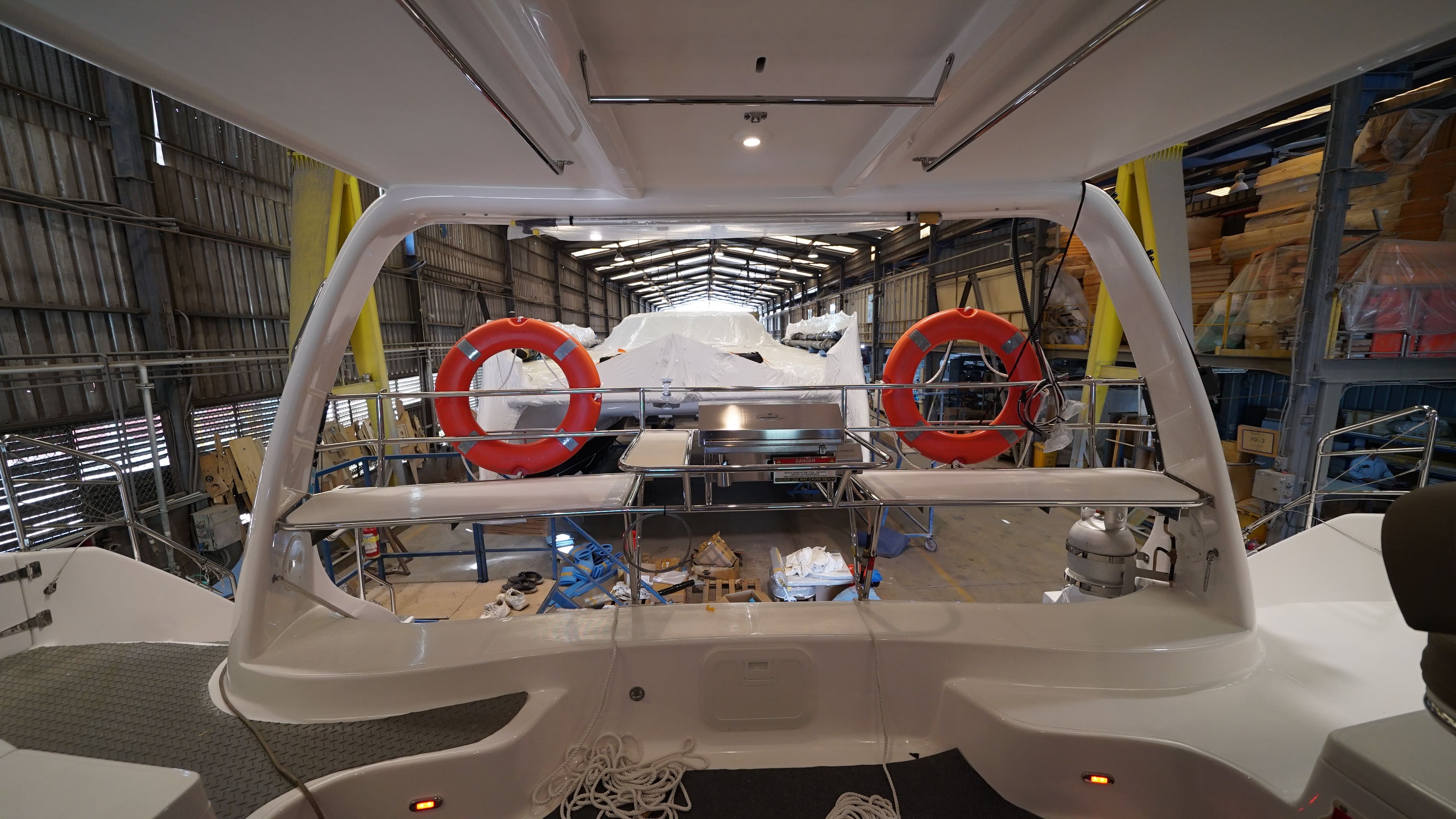

We recently completed the installation of deck hardware, deck hatches, and stanchions.

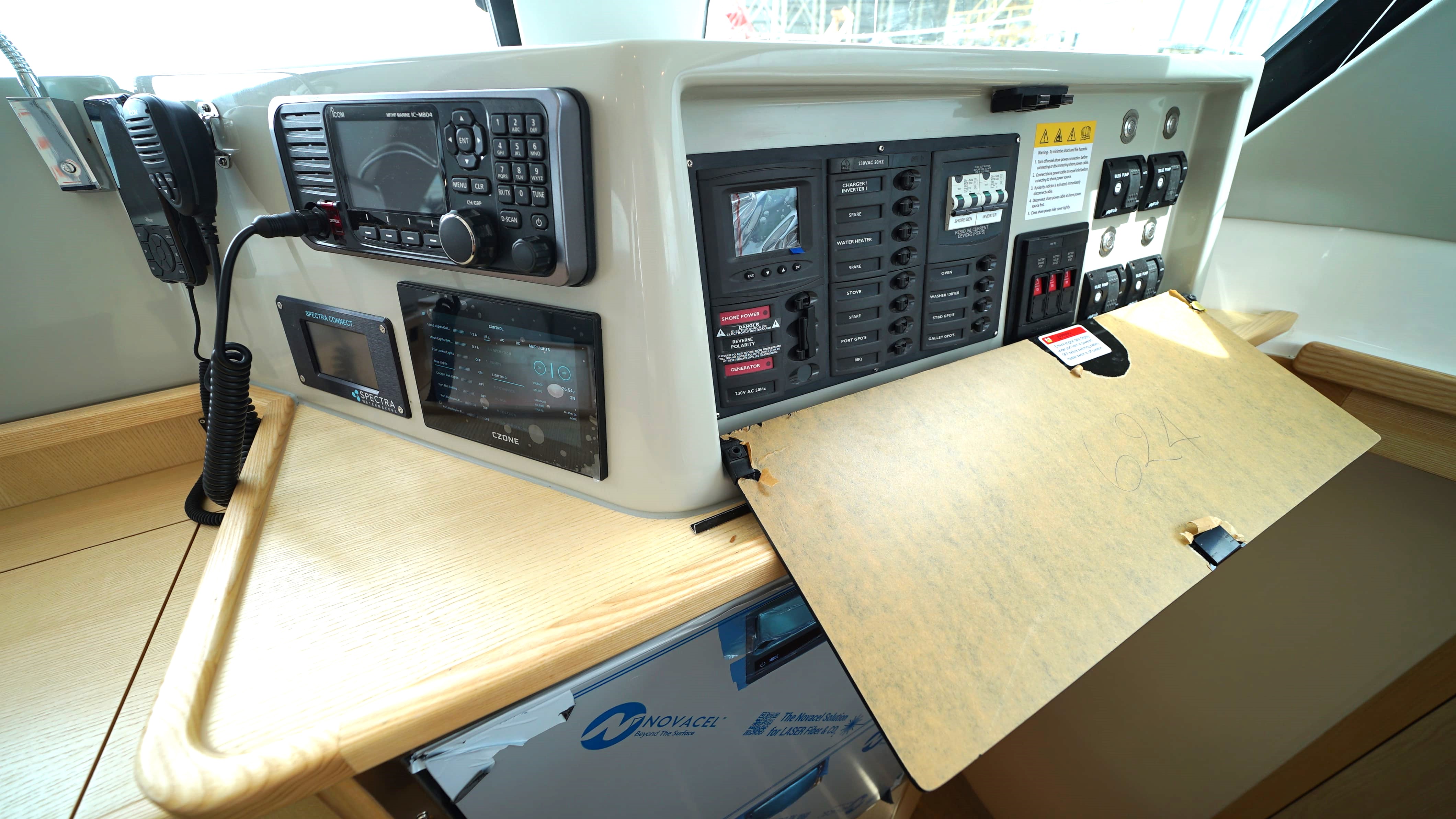

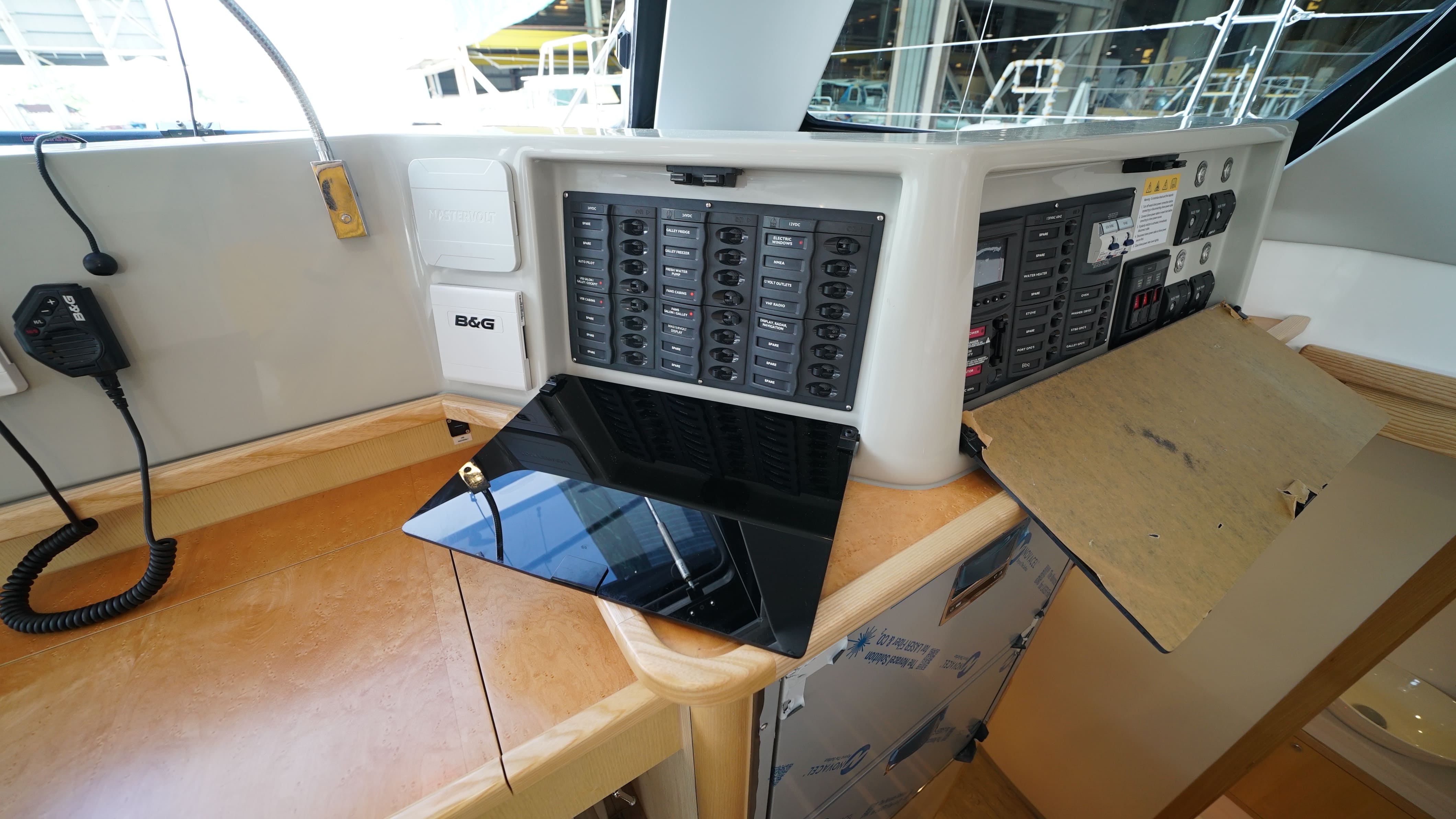

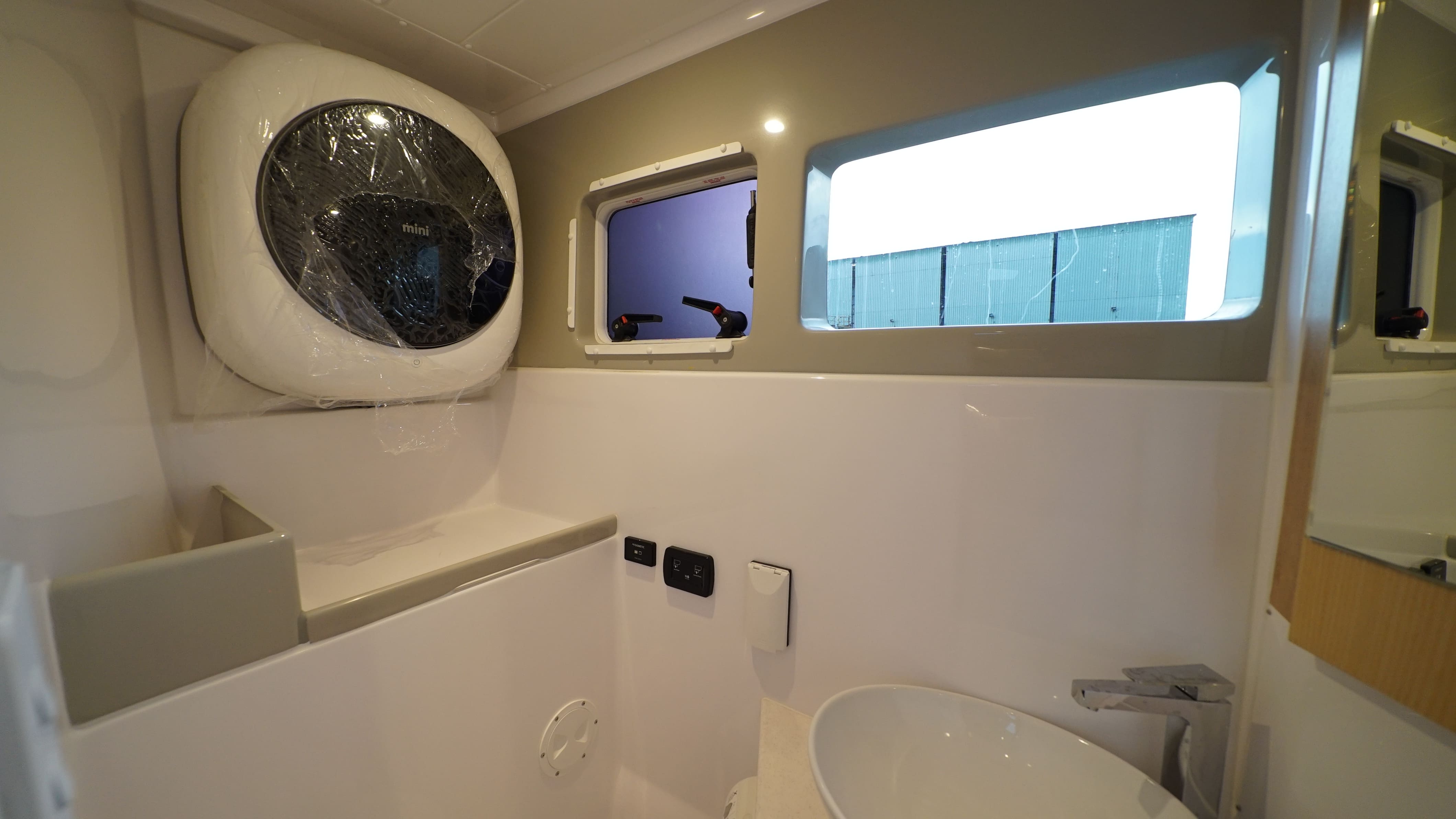

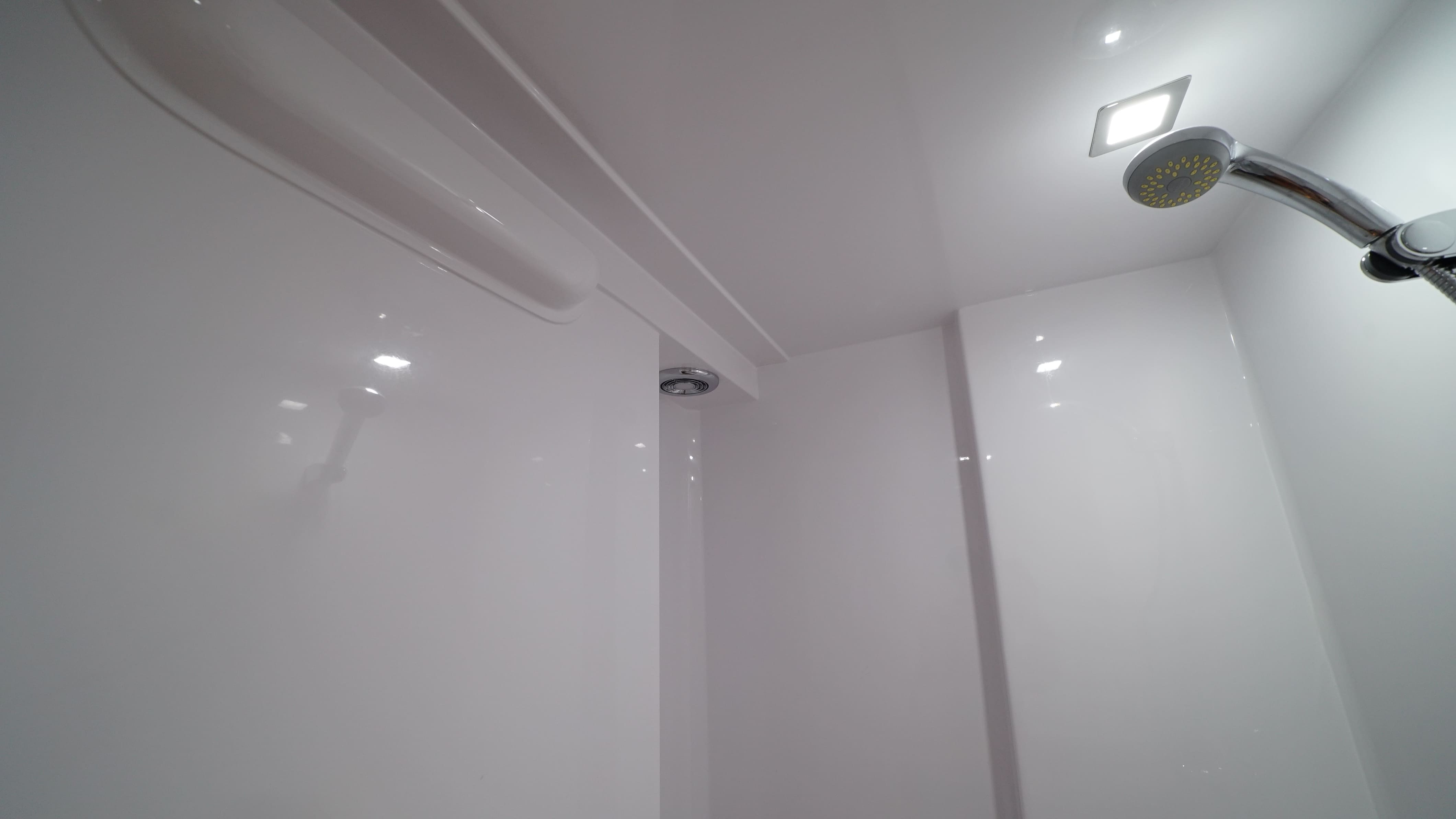

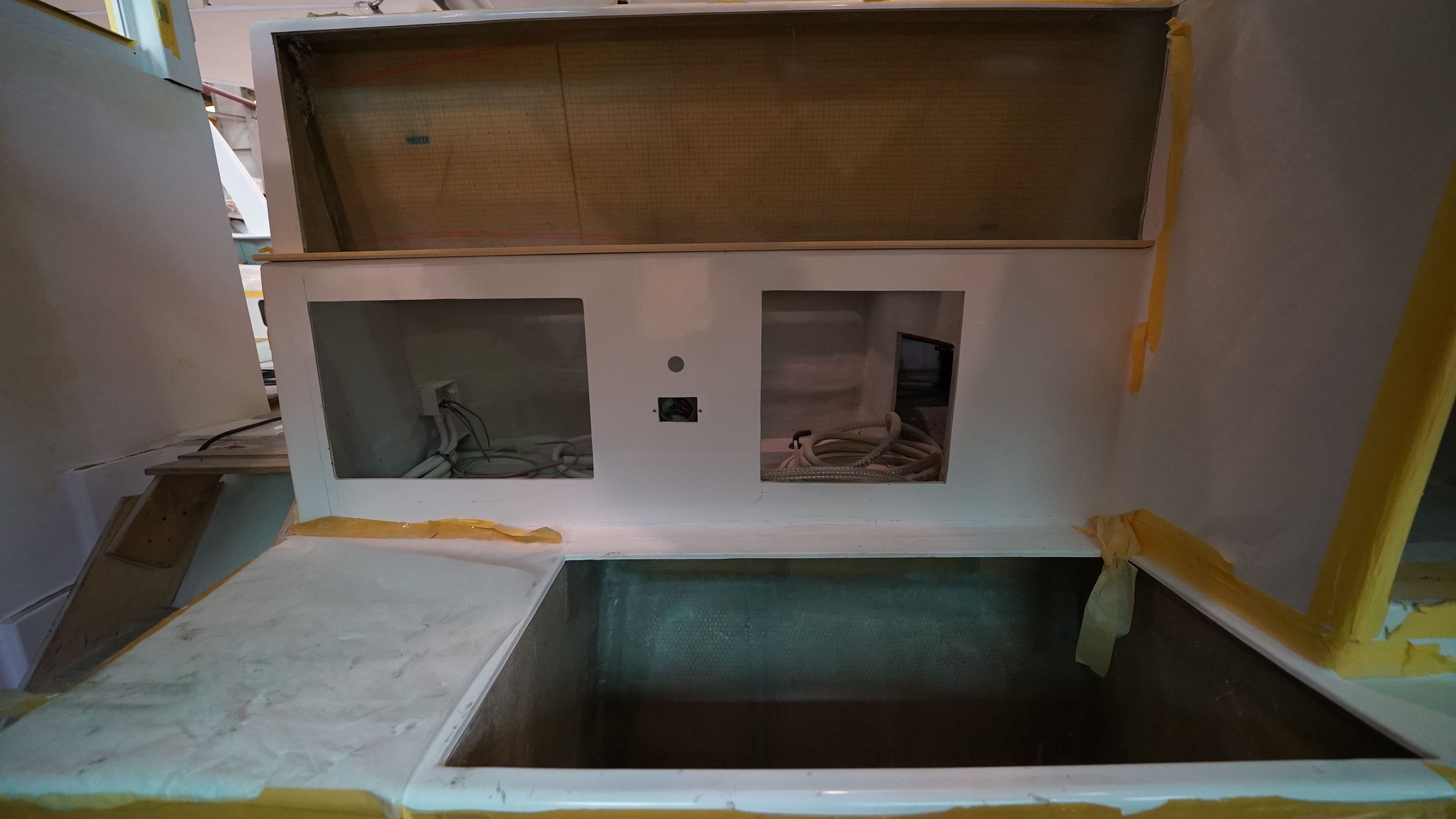

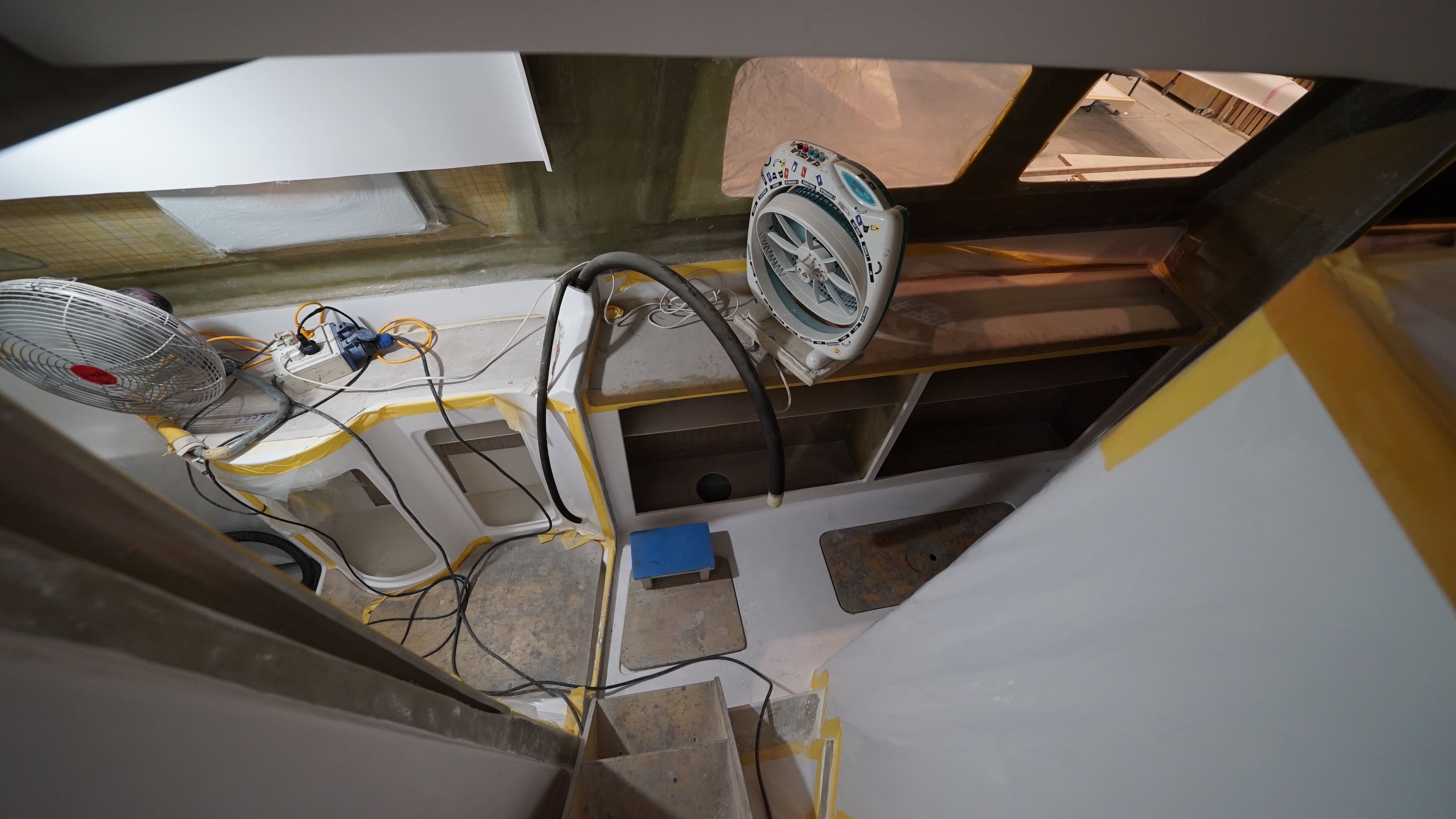

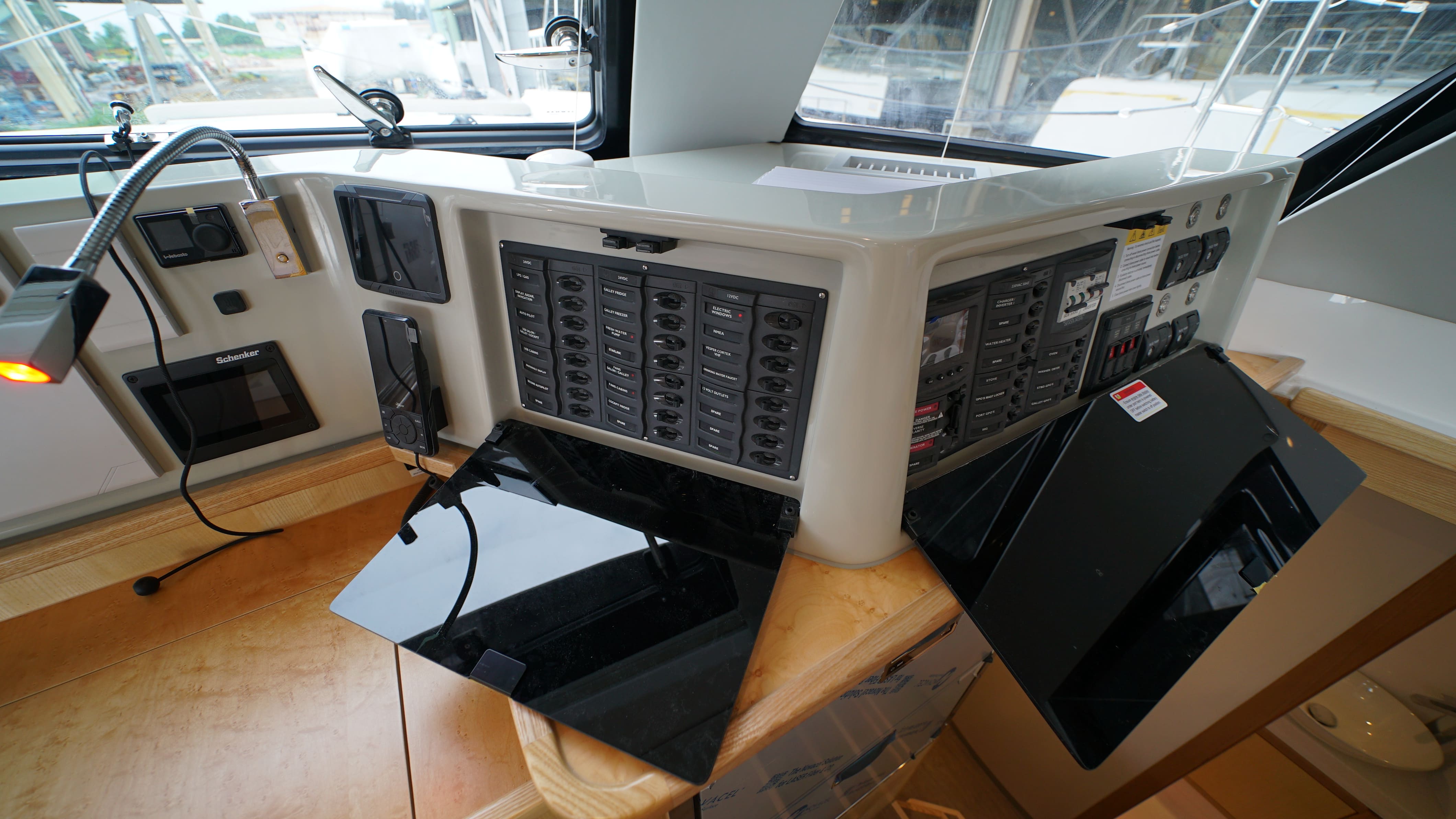

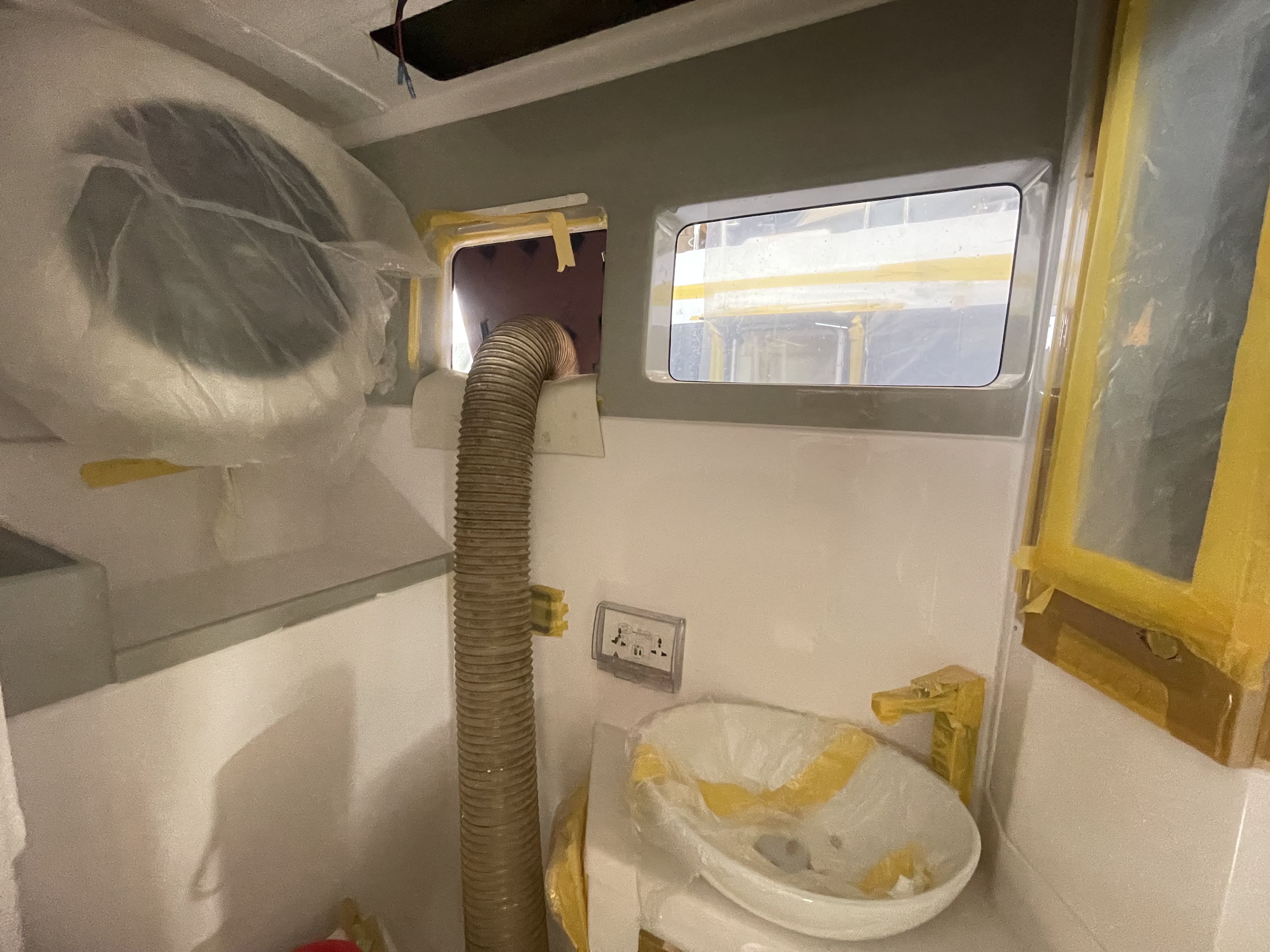

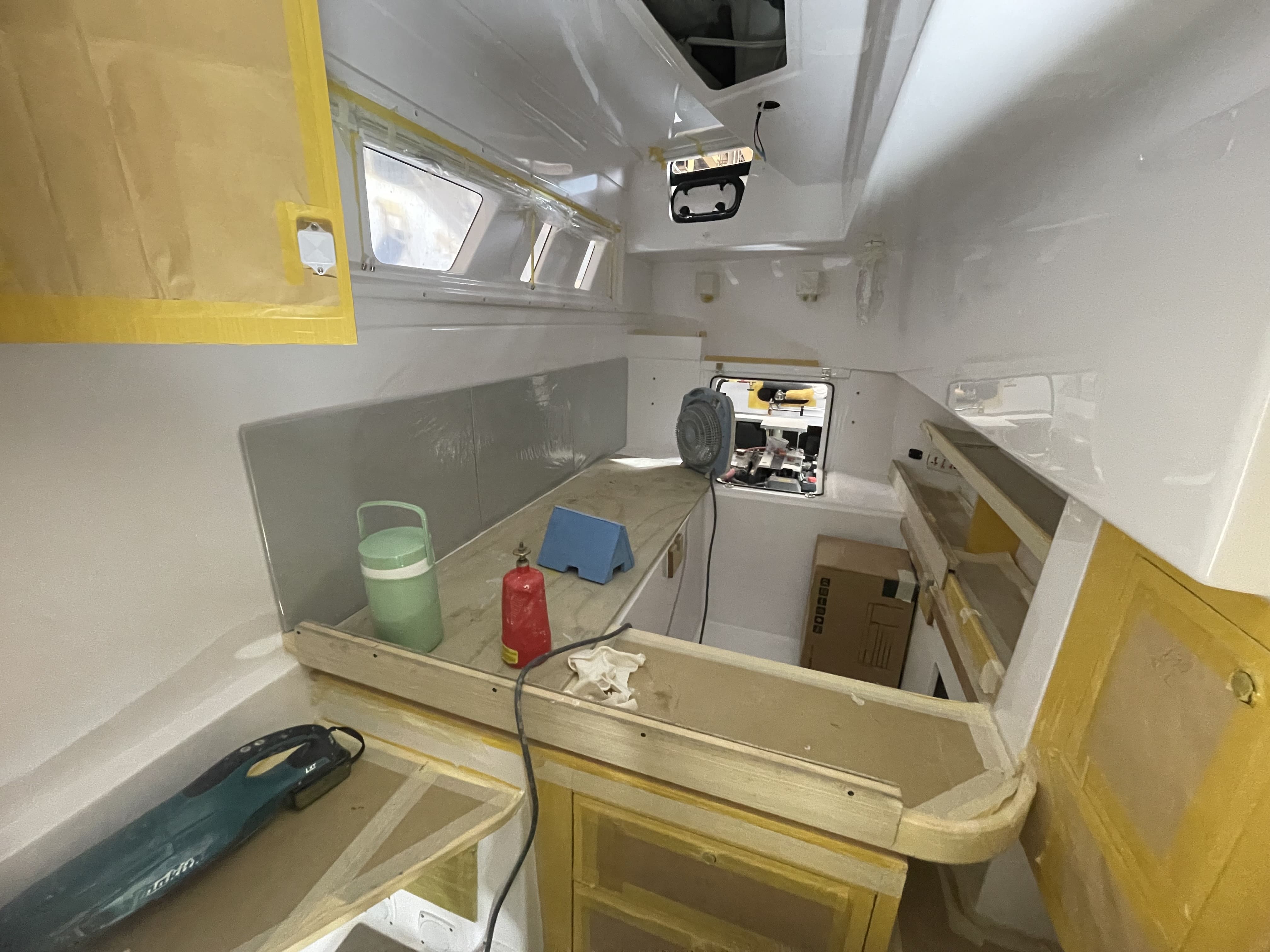

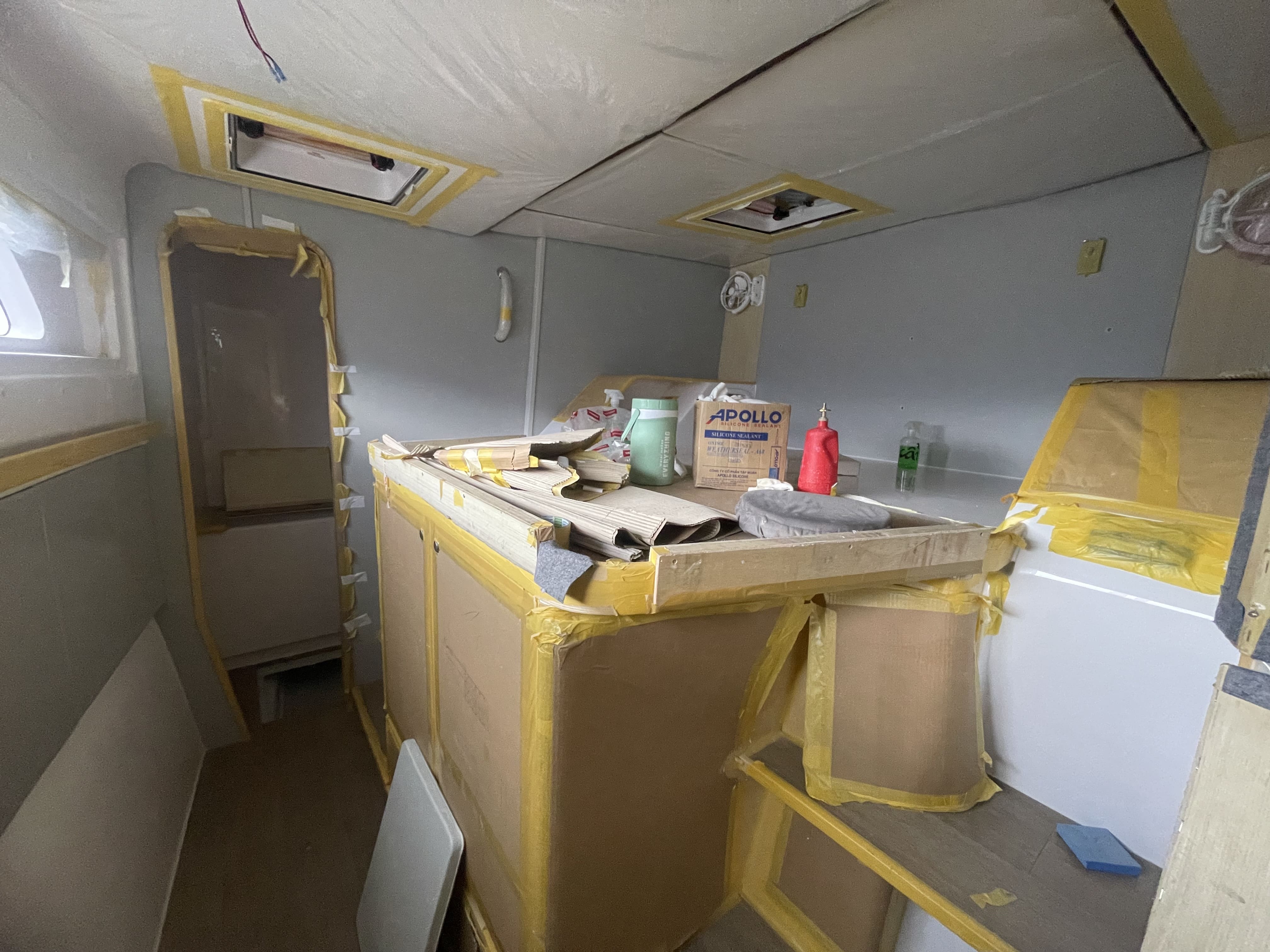

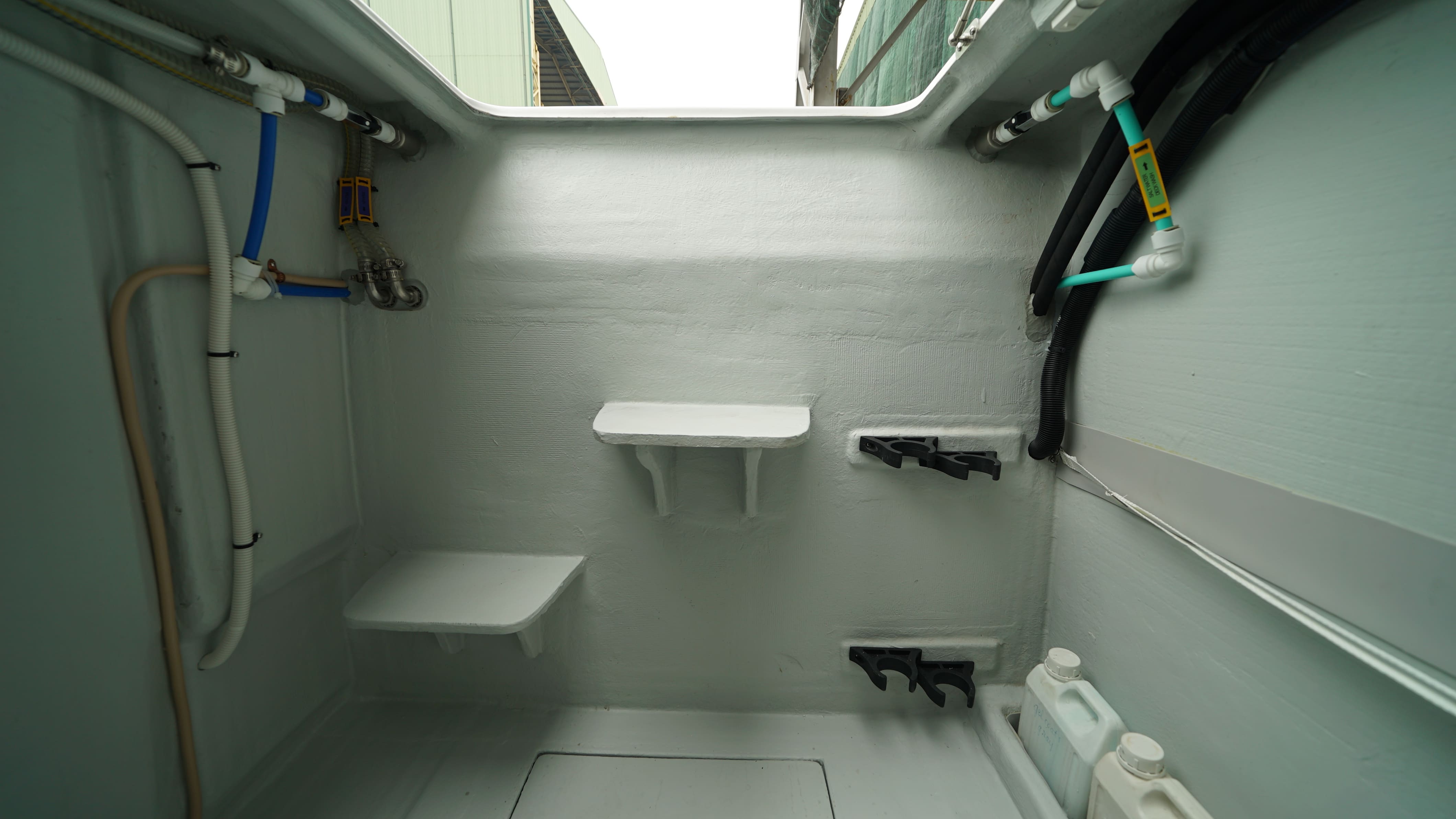

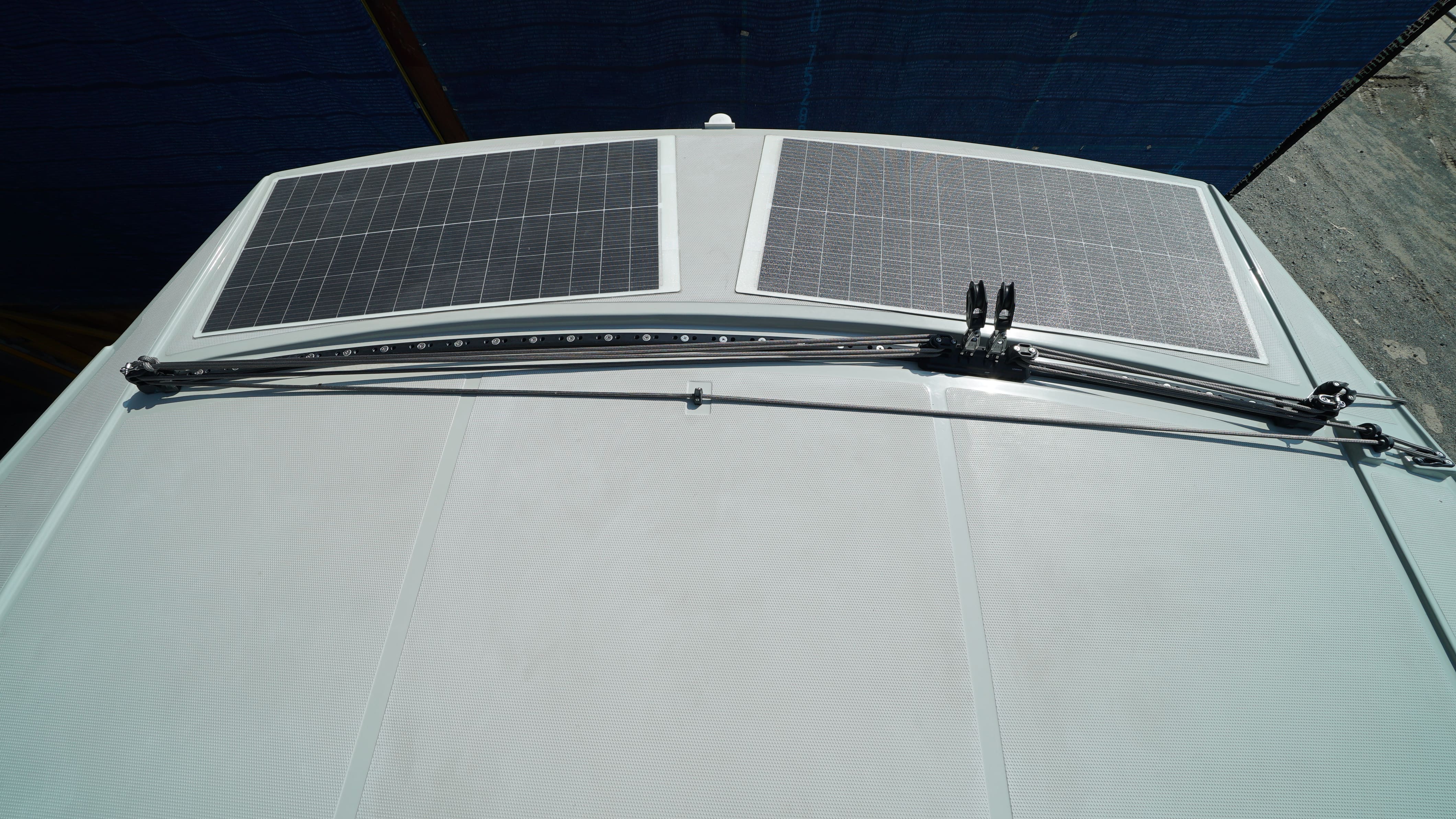

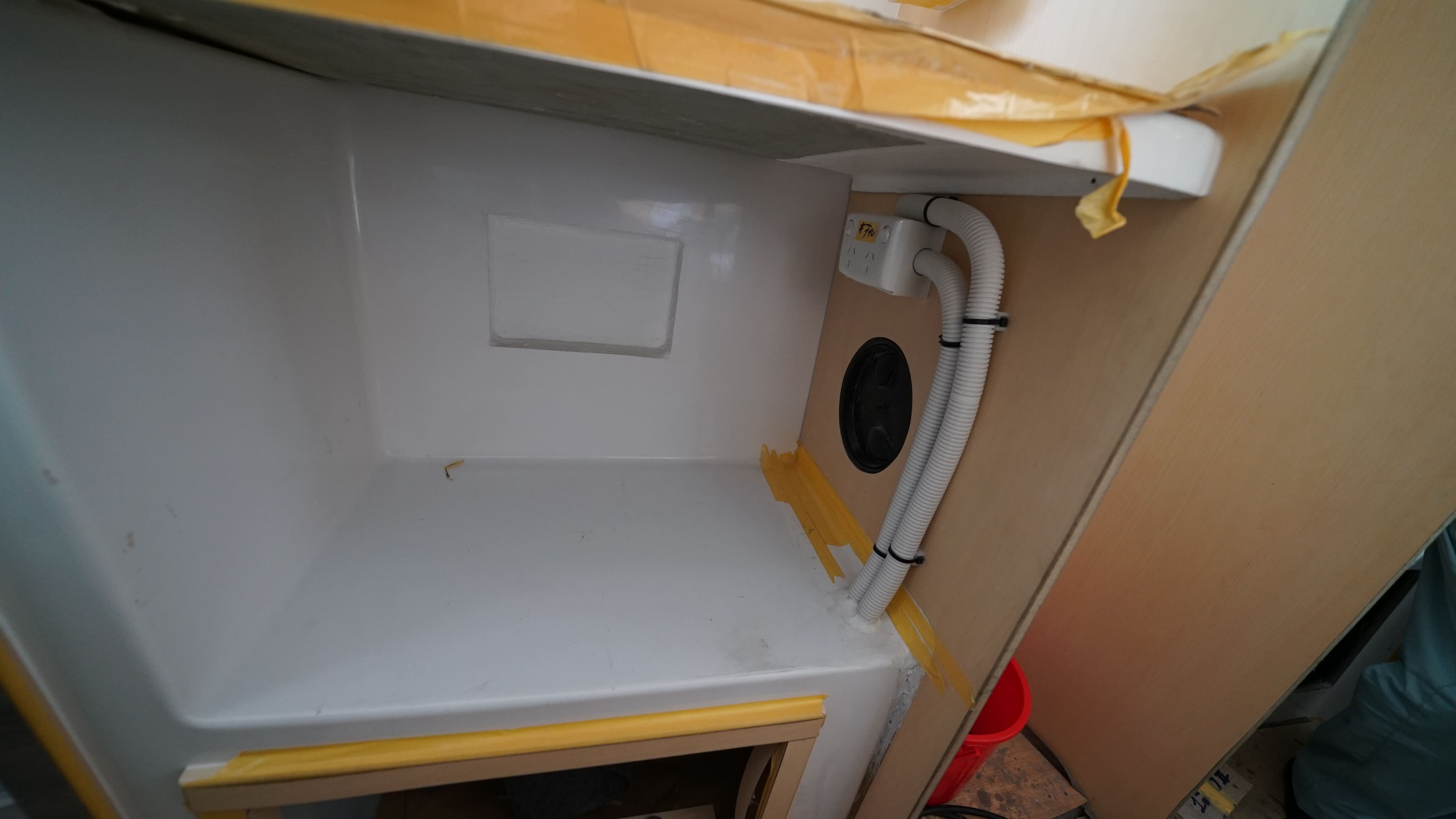

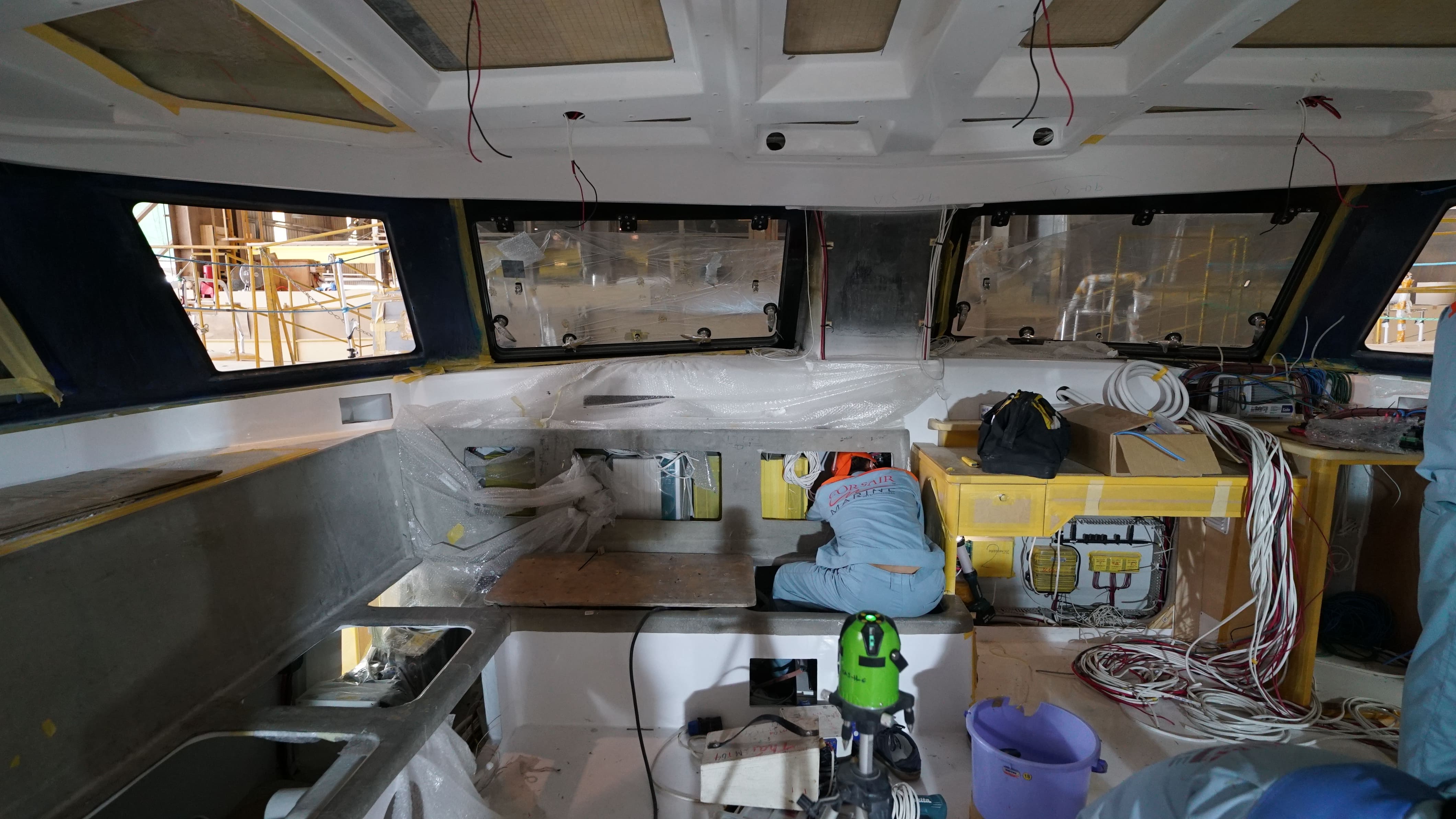

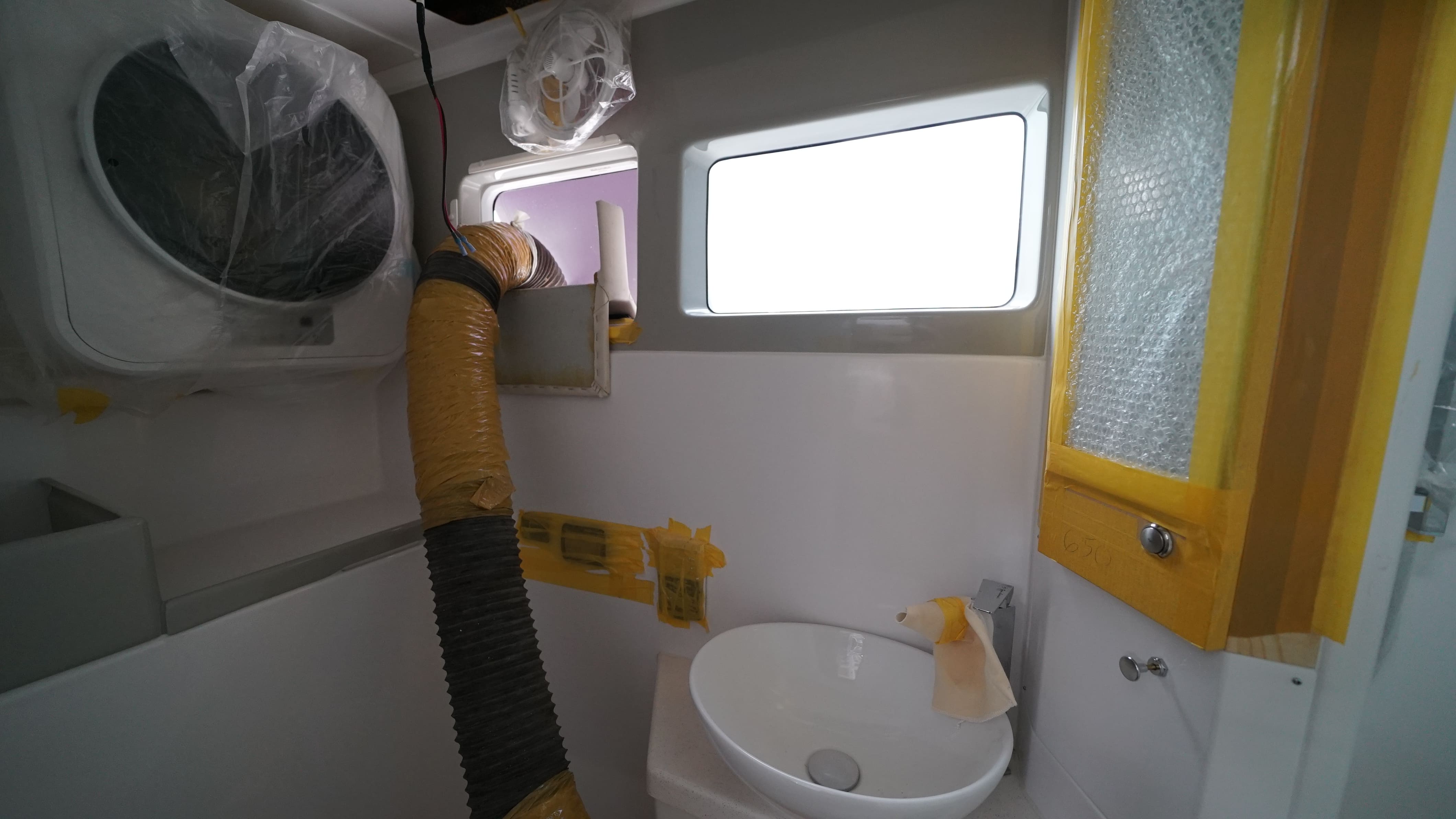

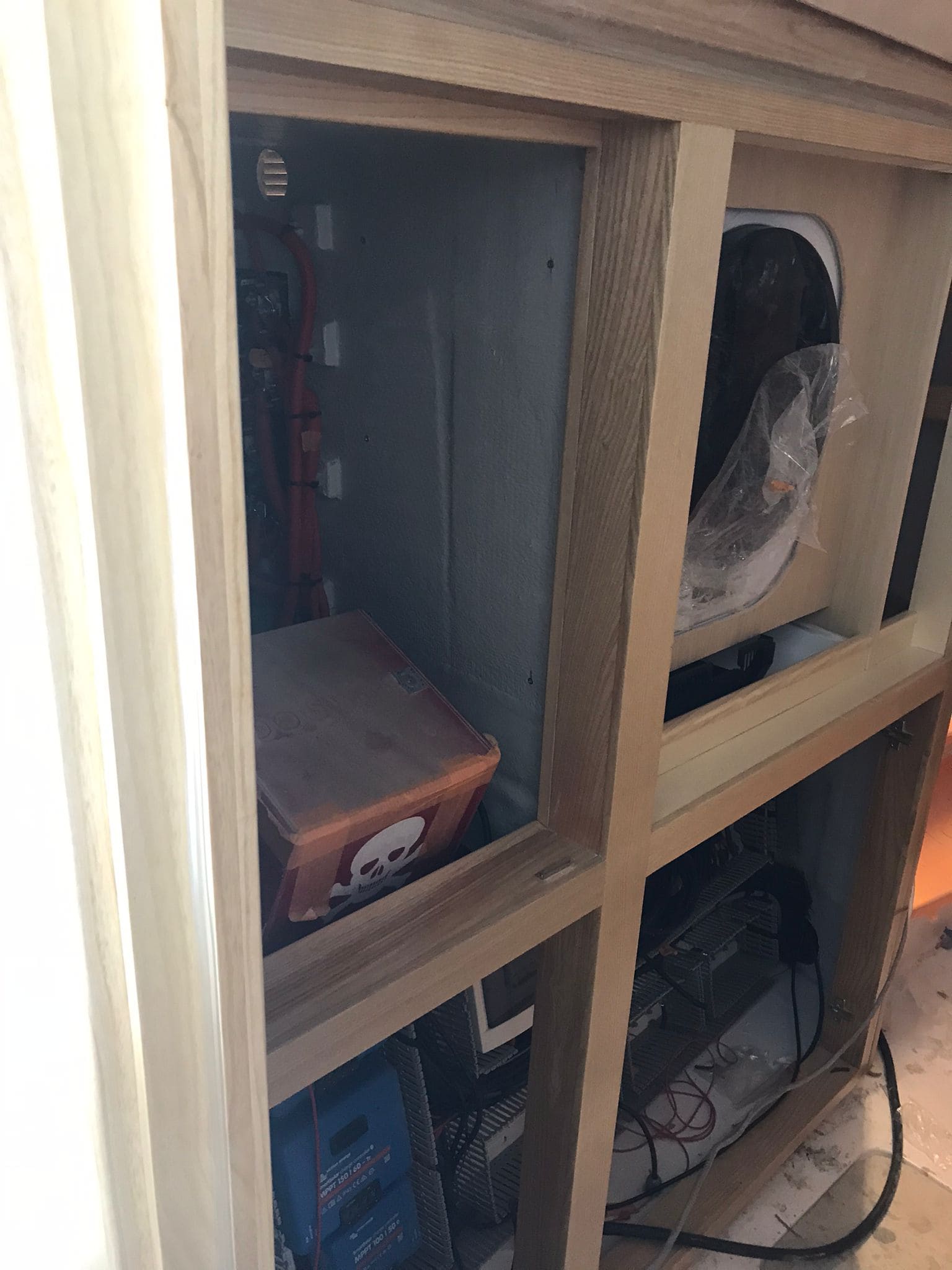

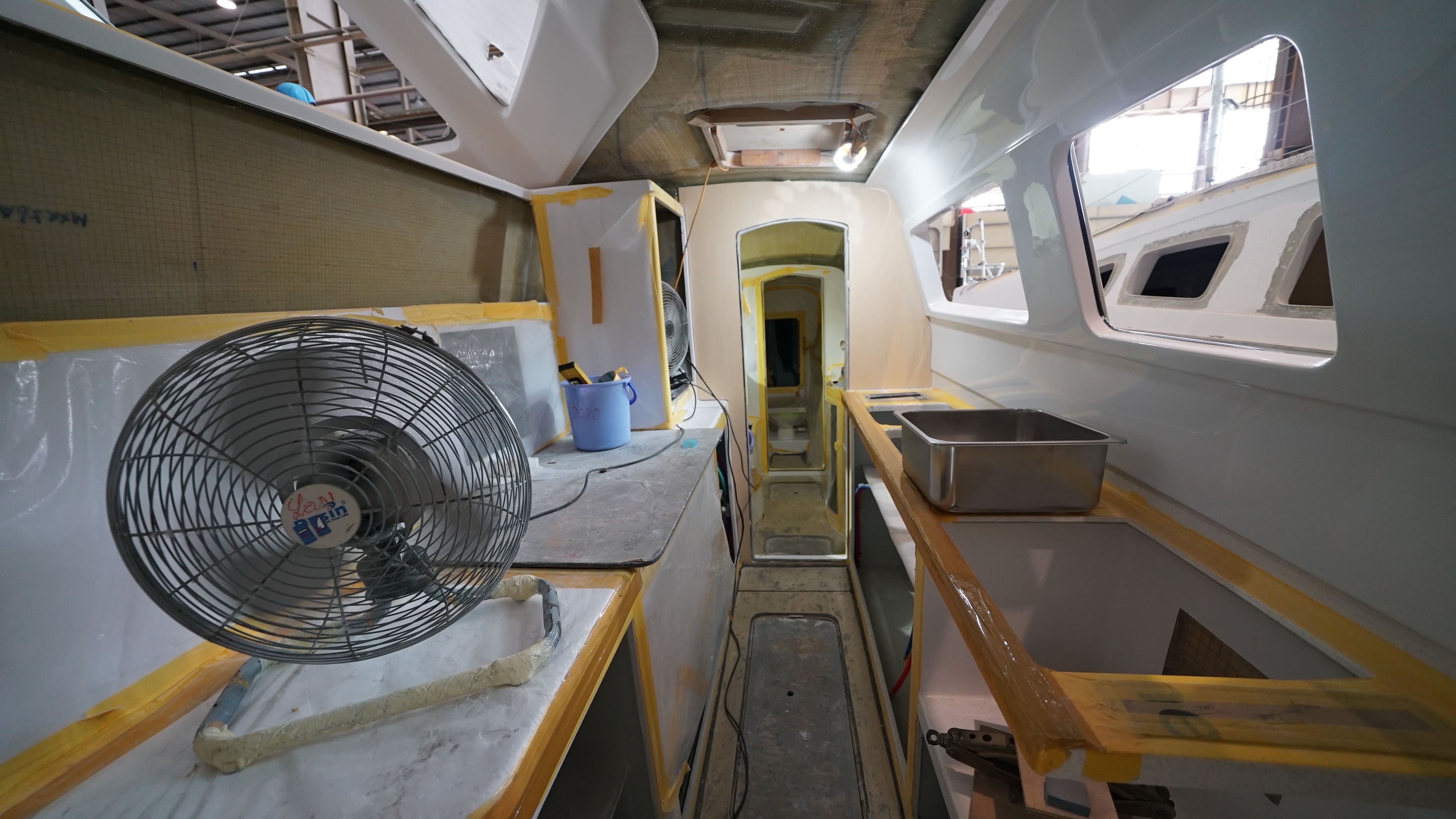

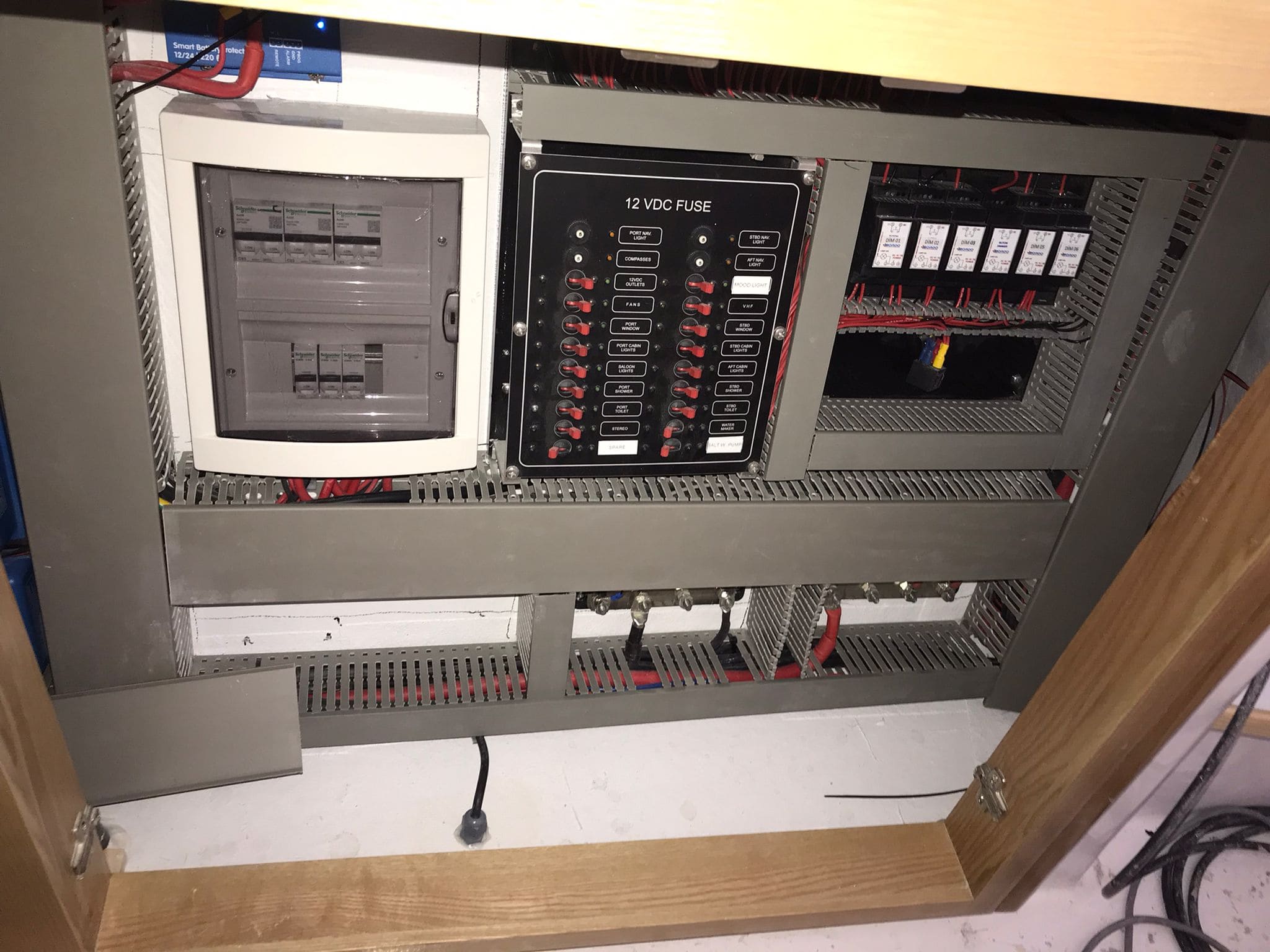

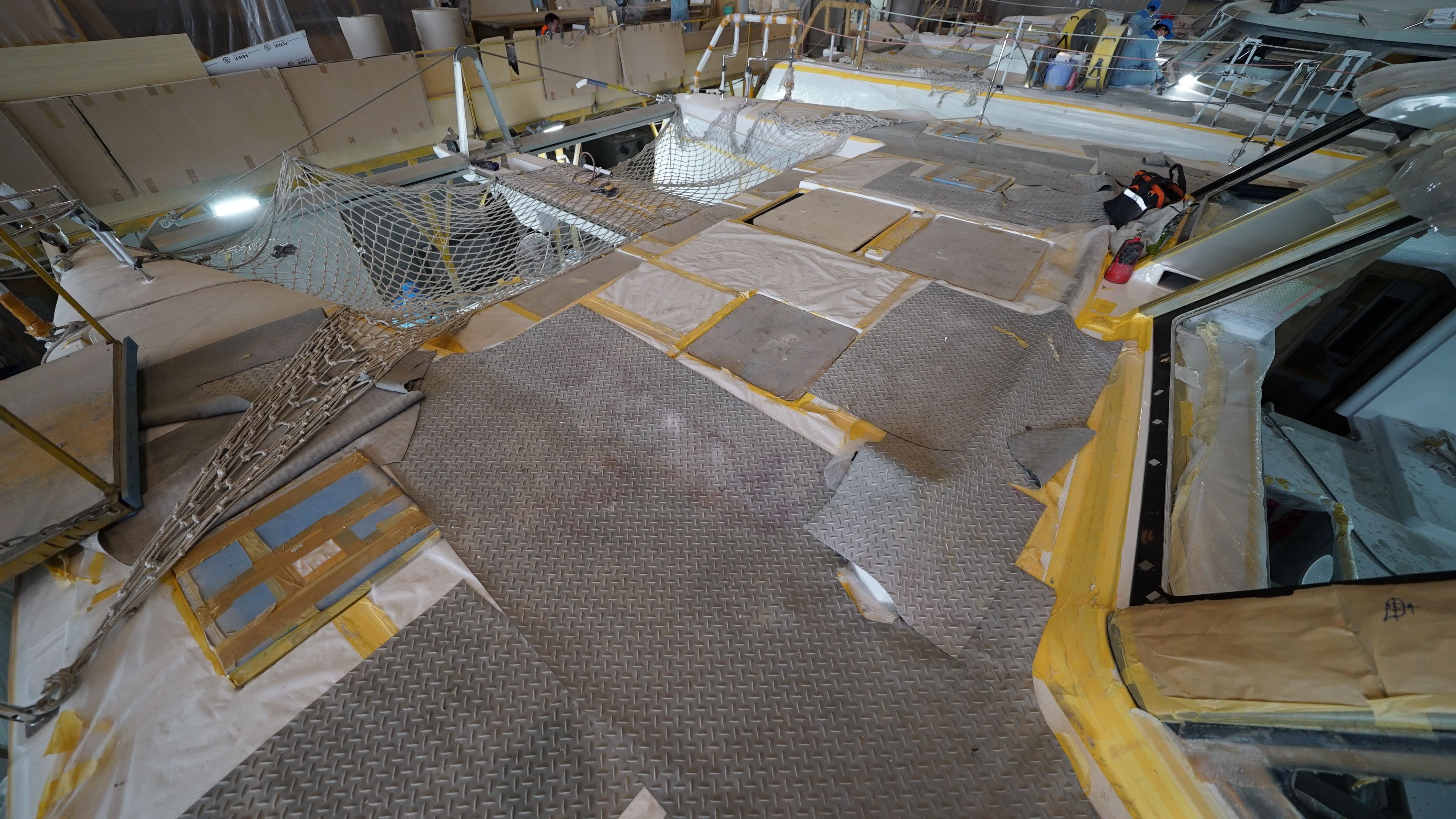

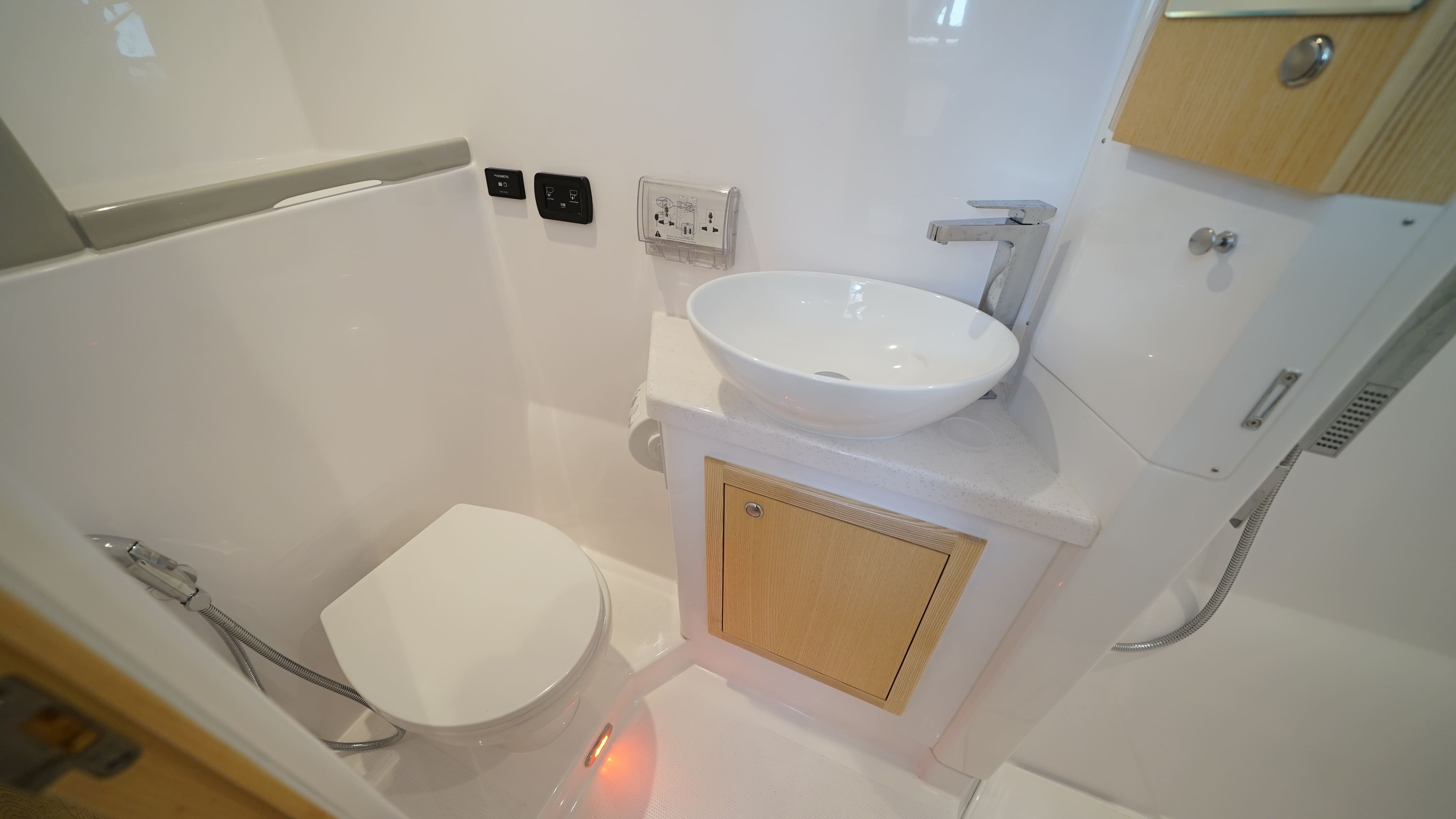

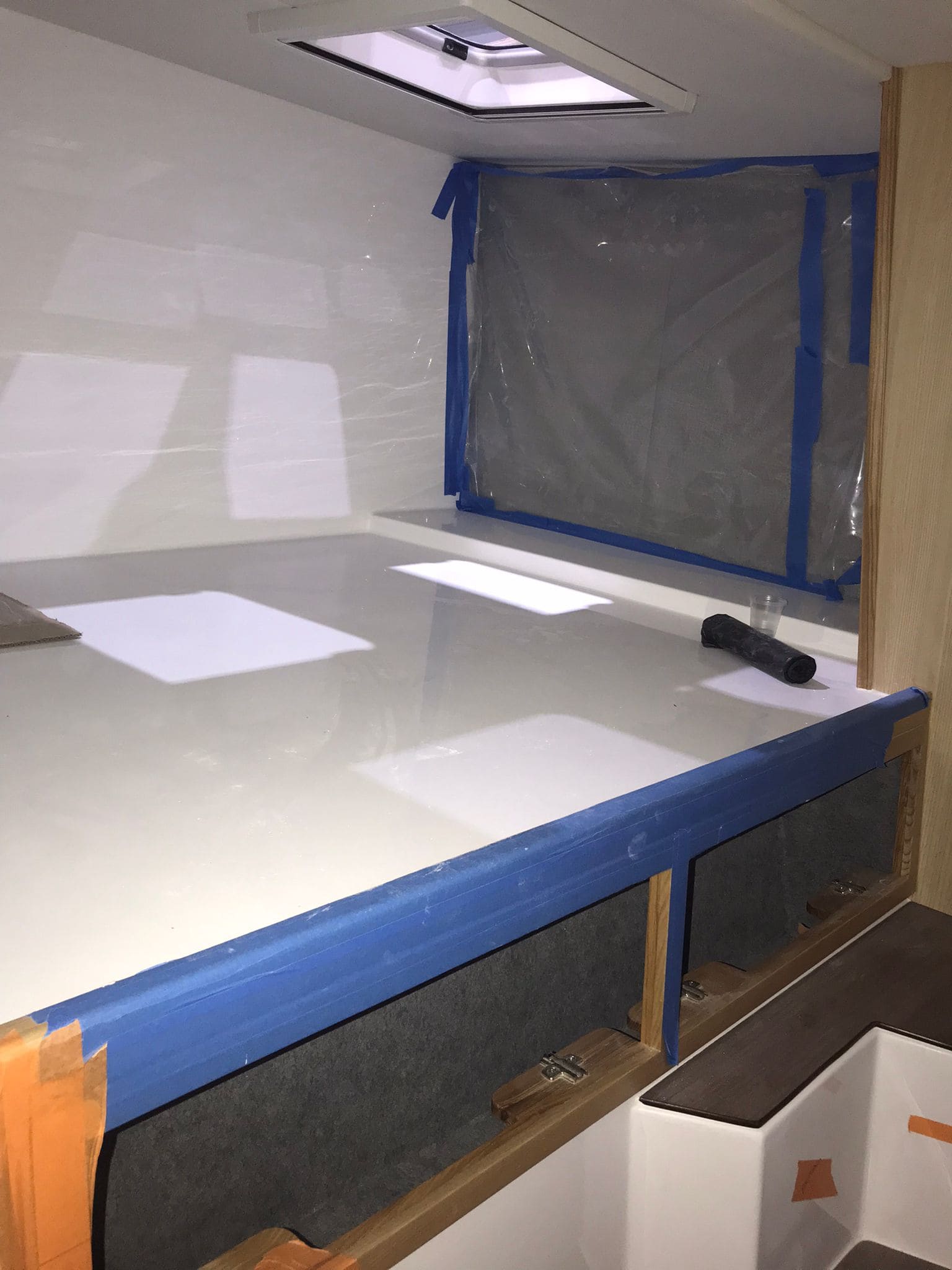

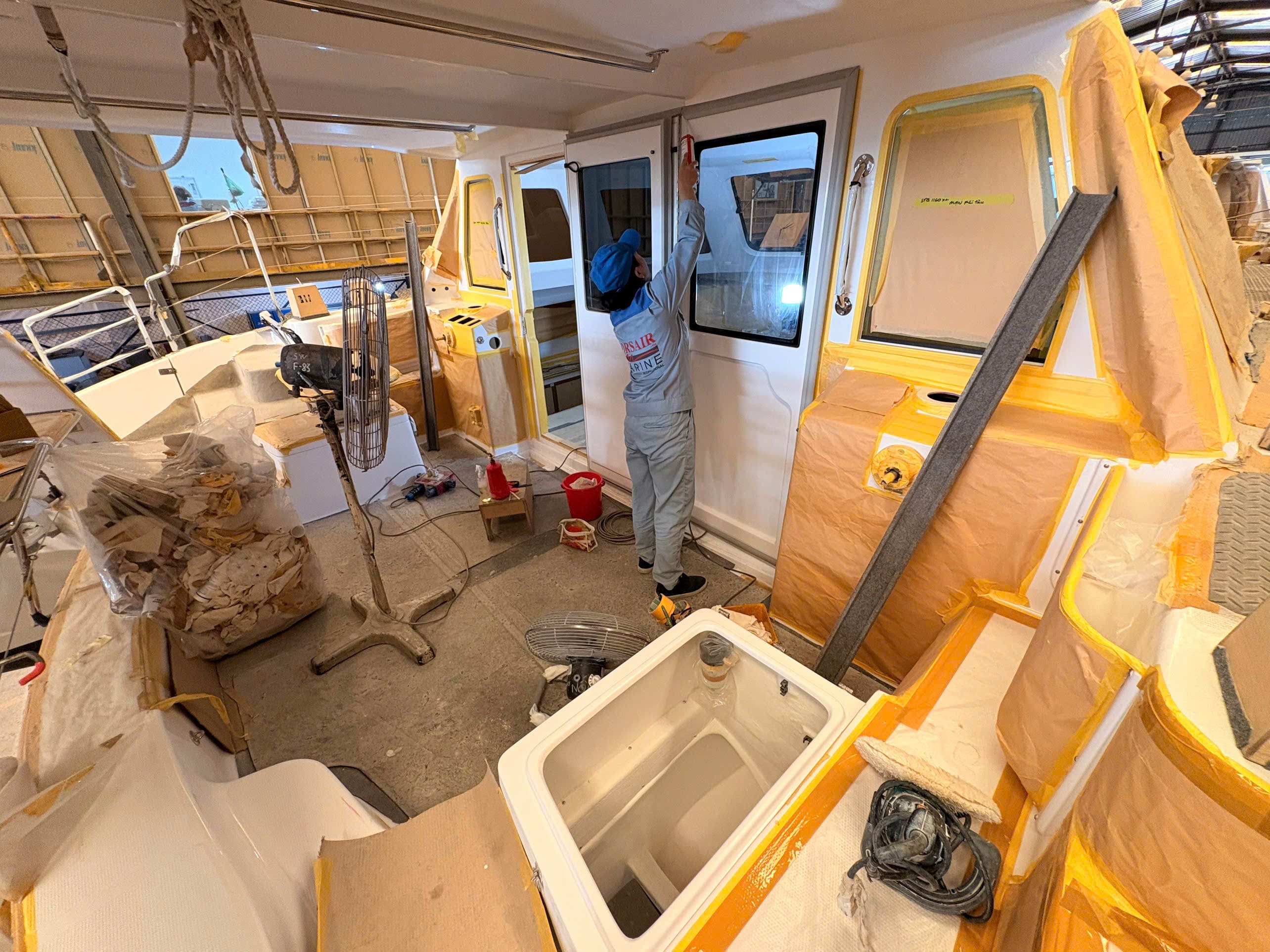

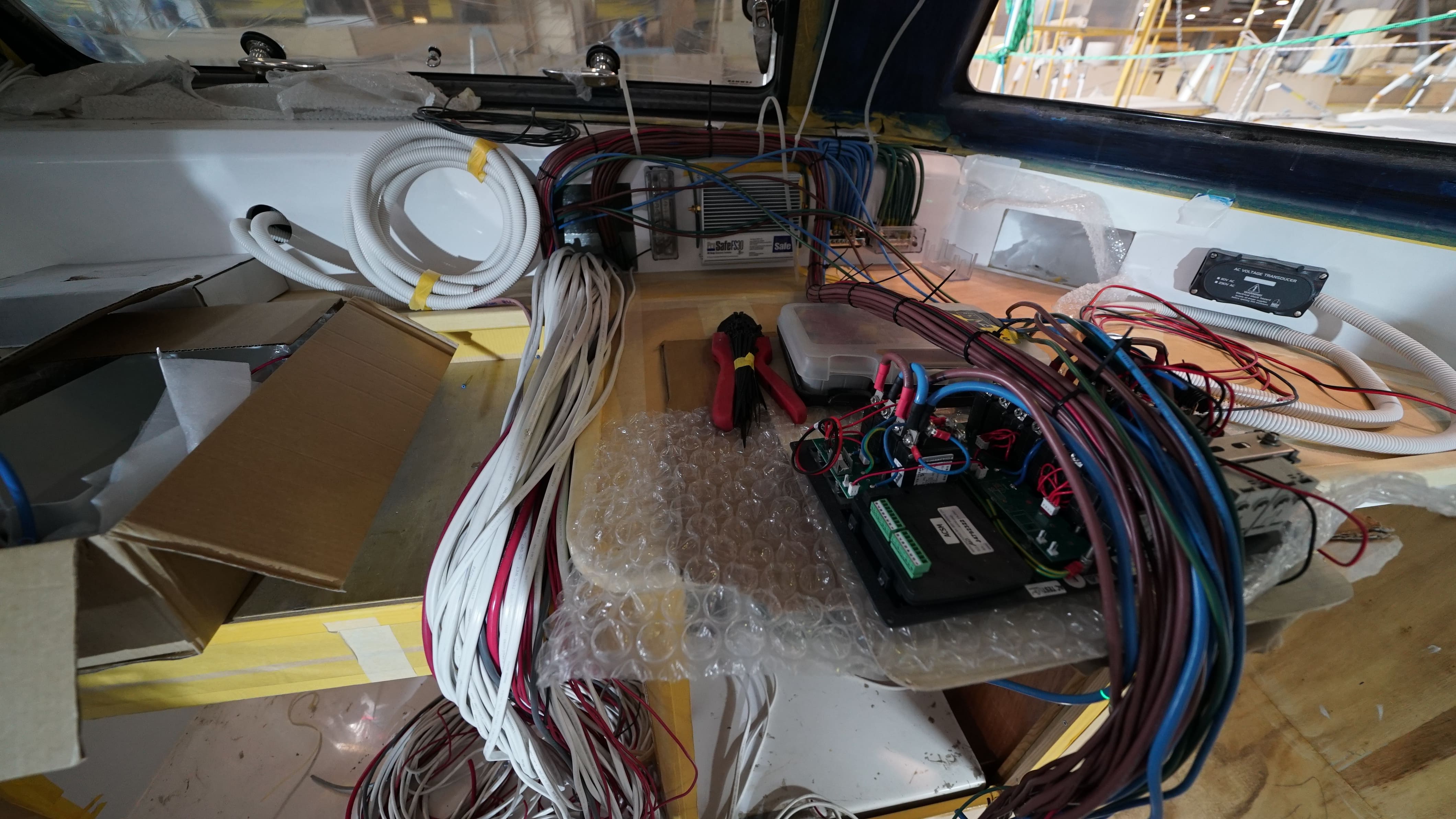

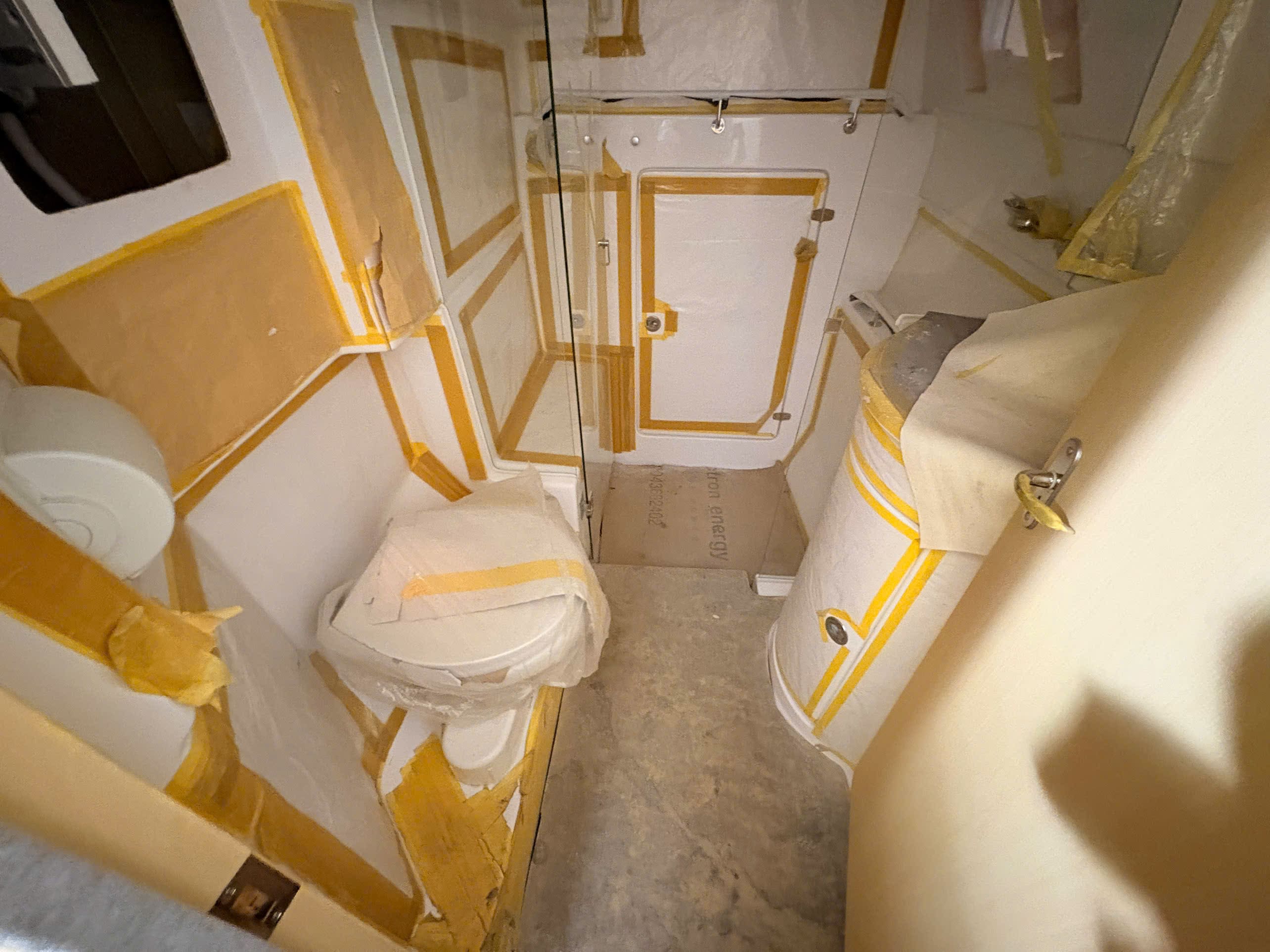

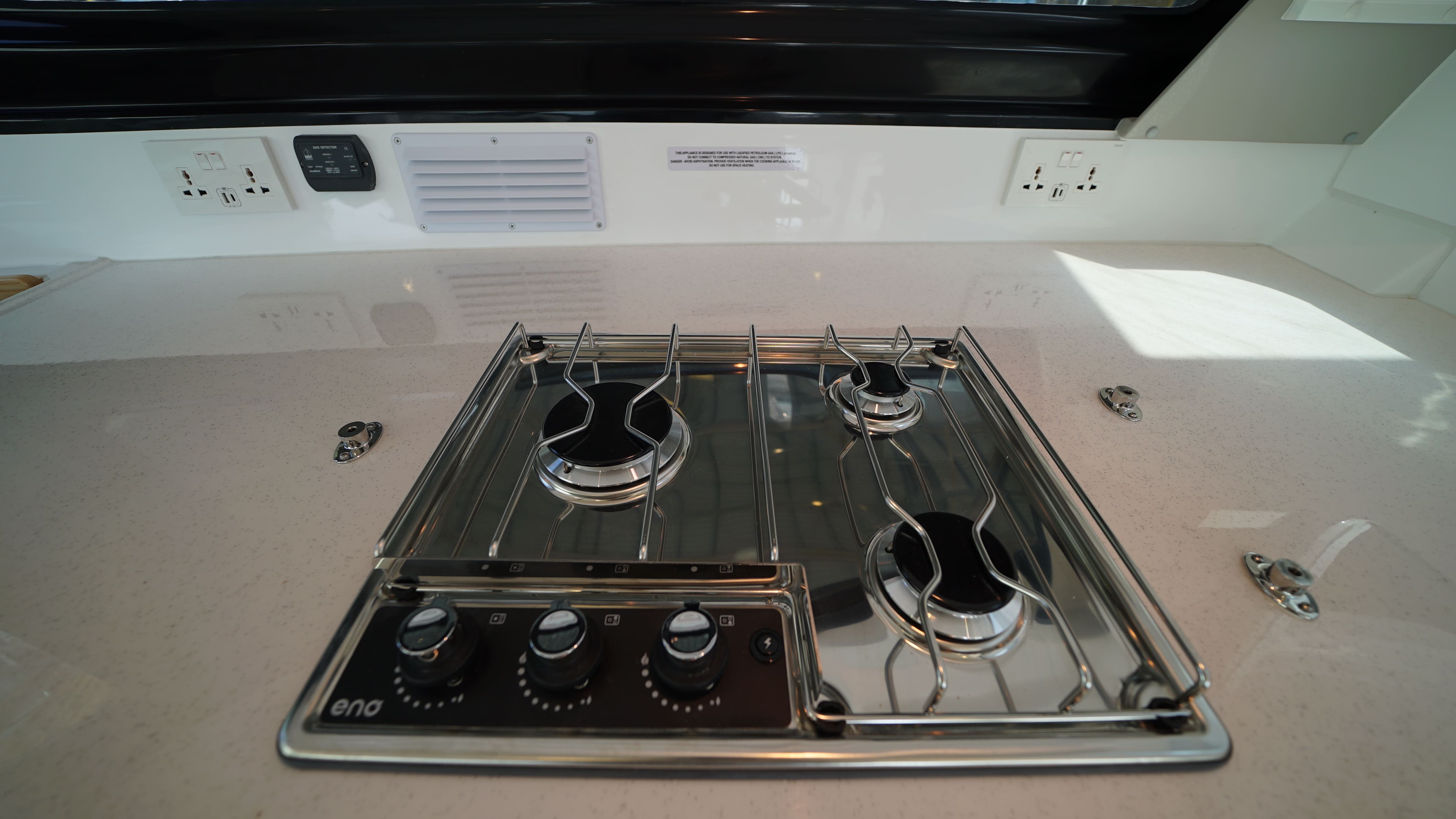

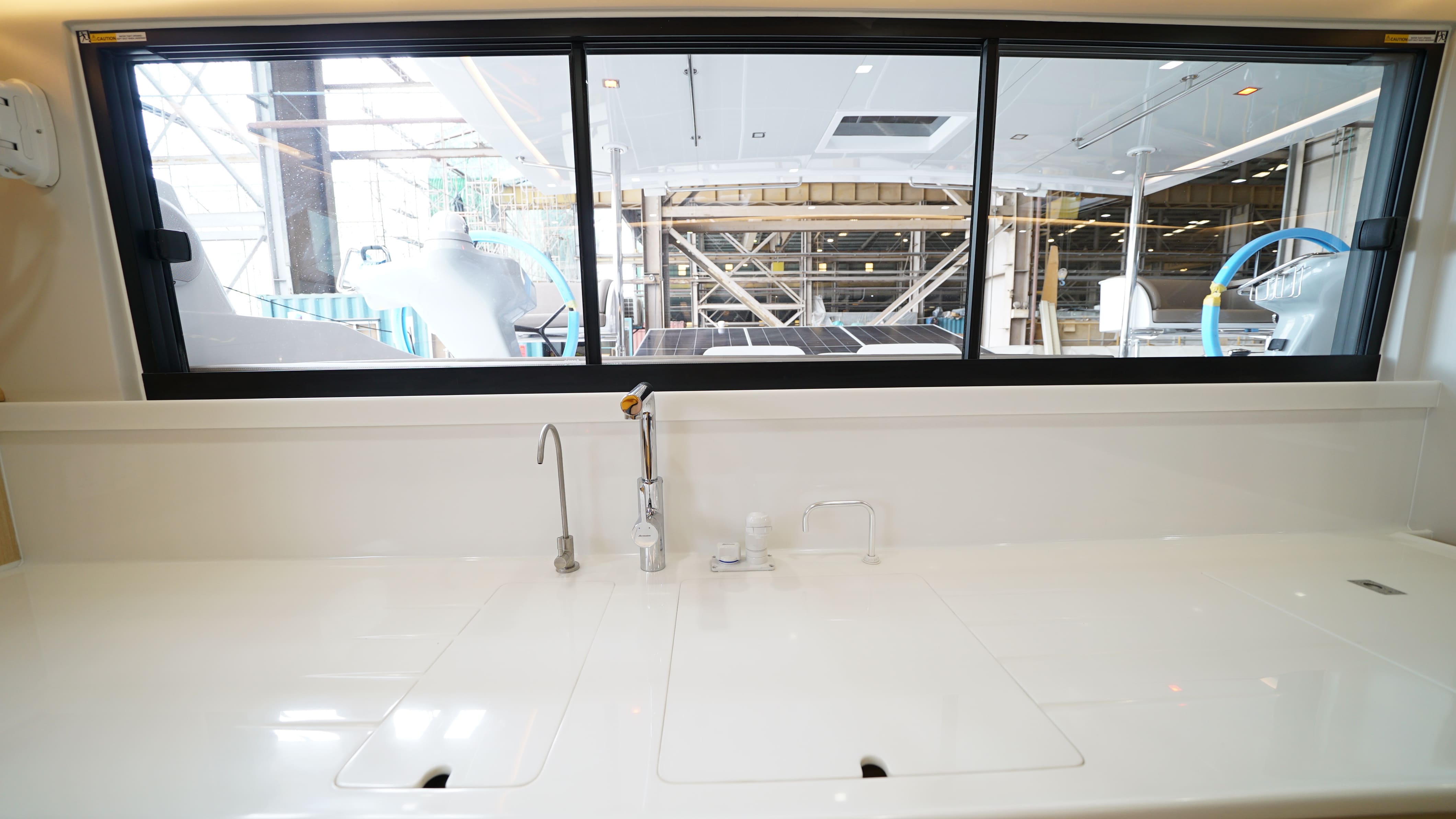

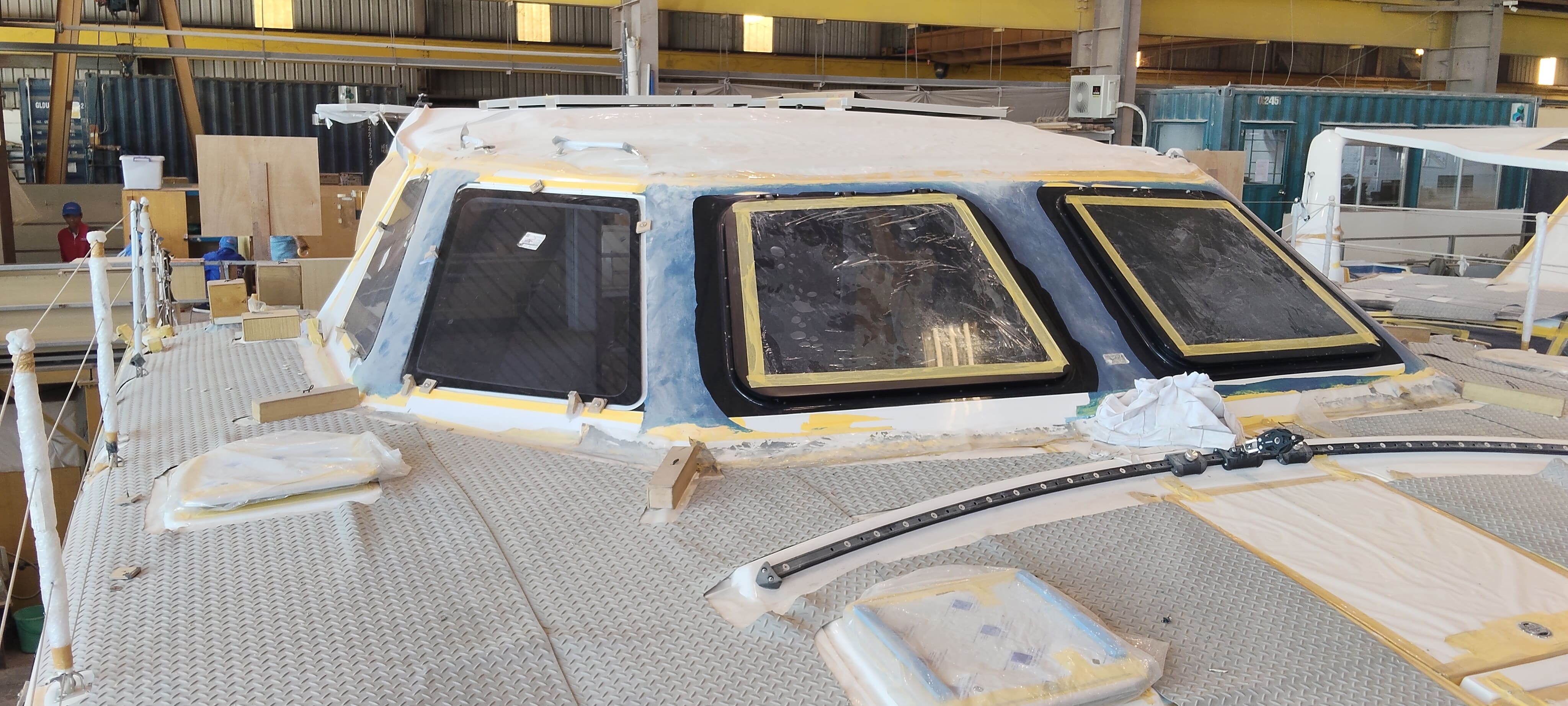

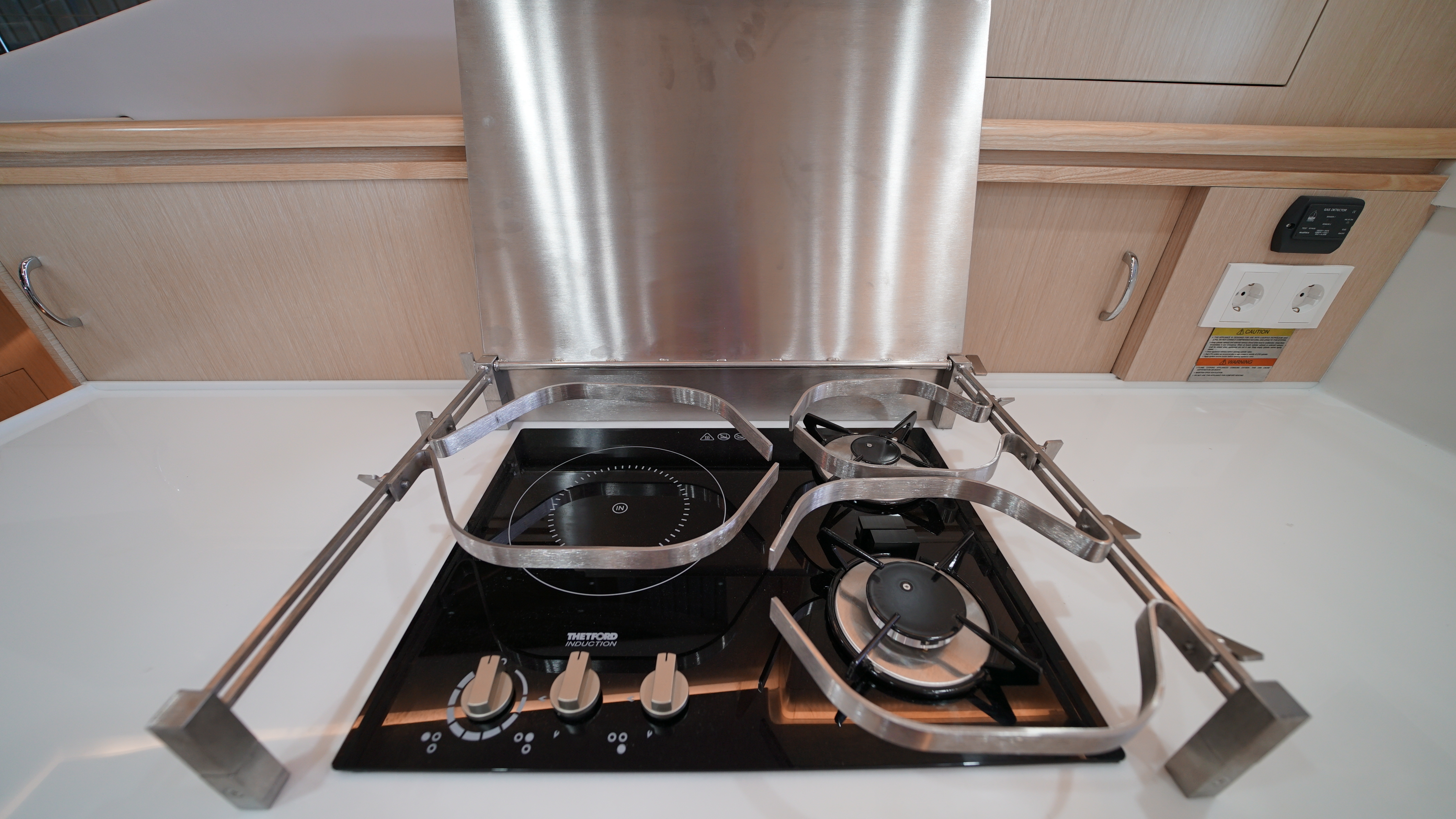

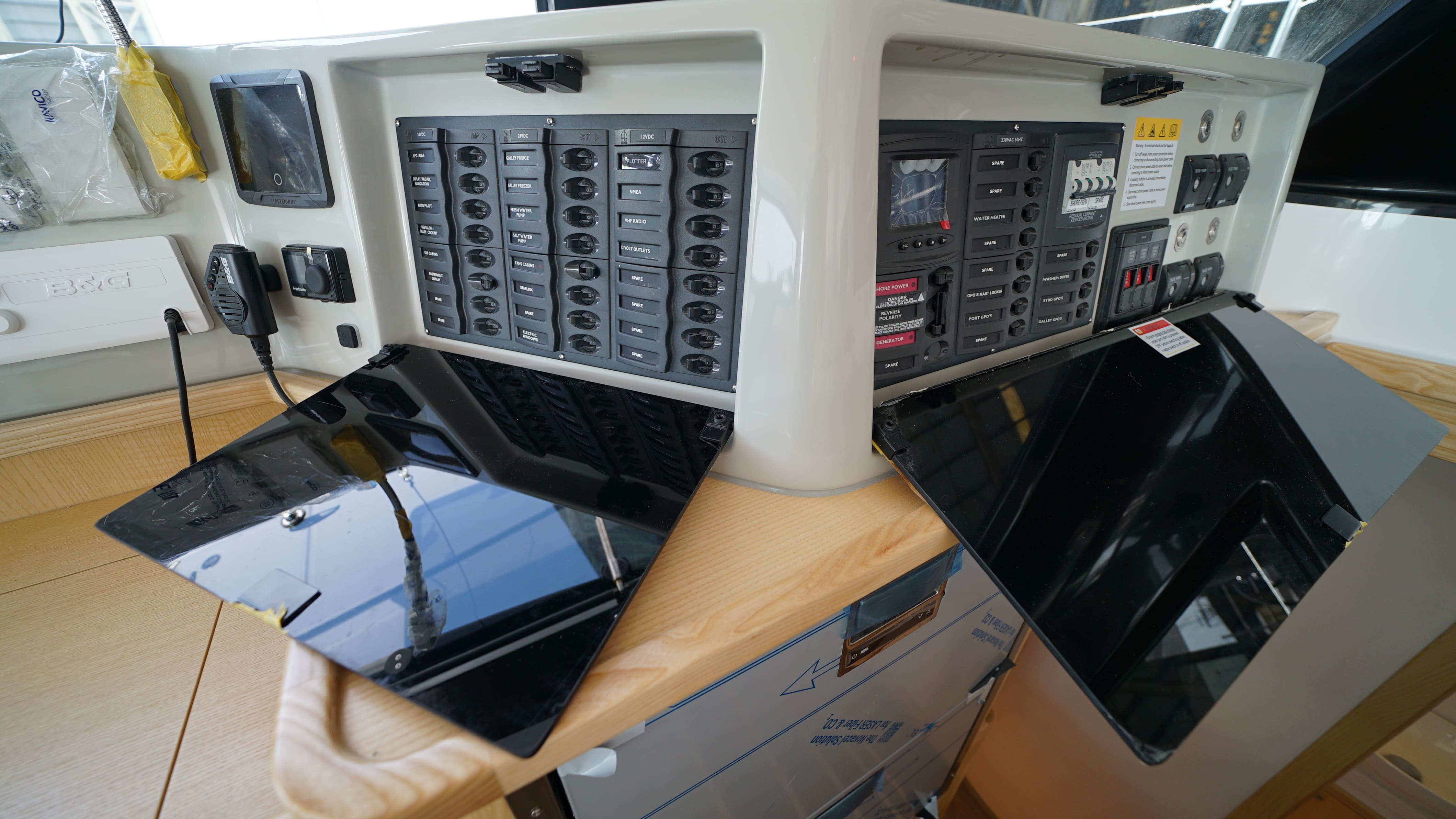

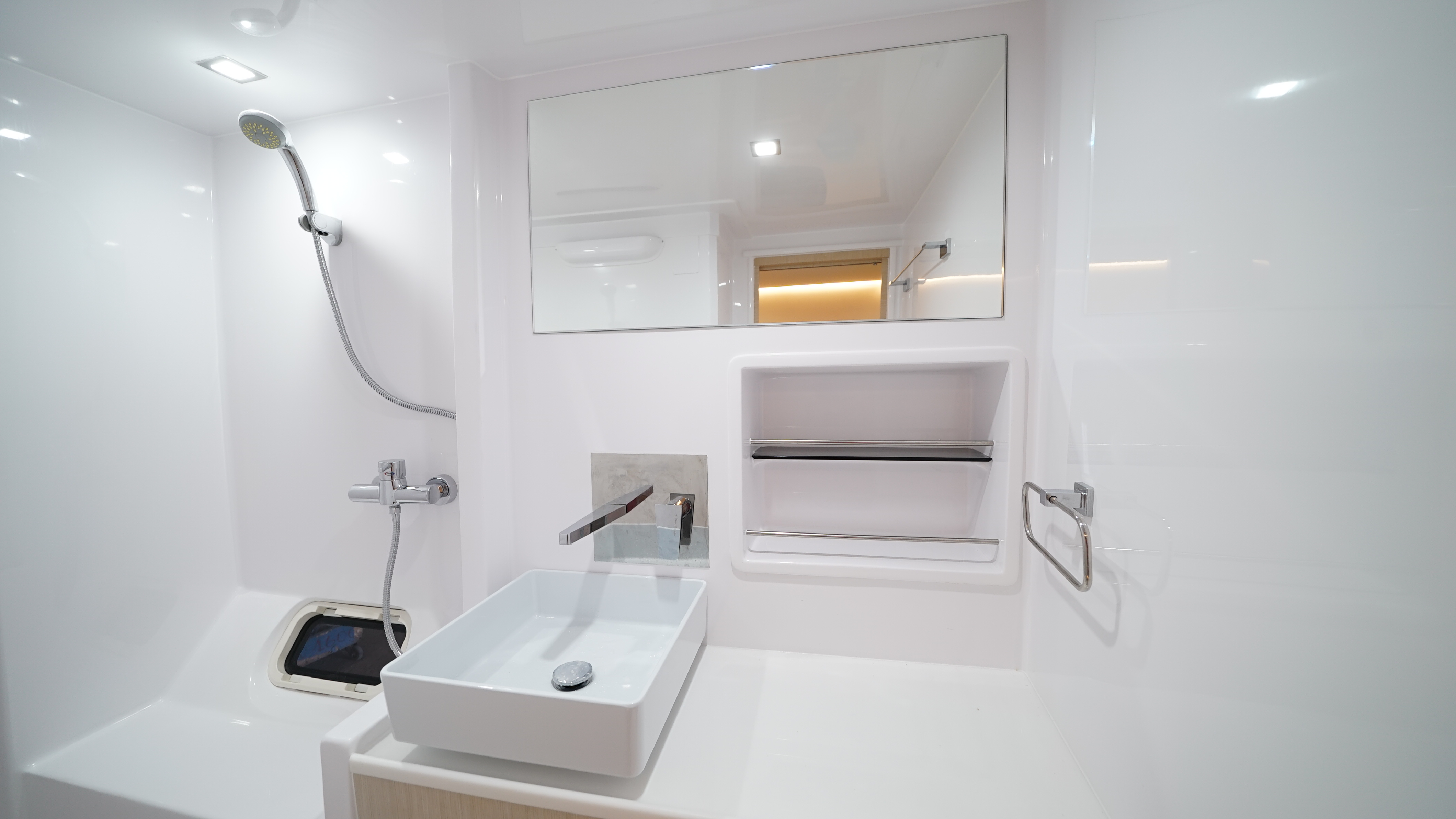

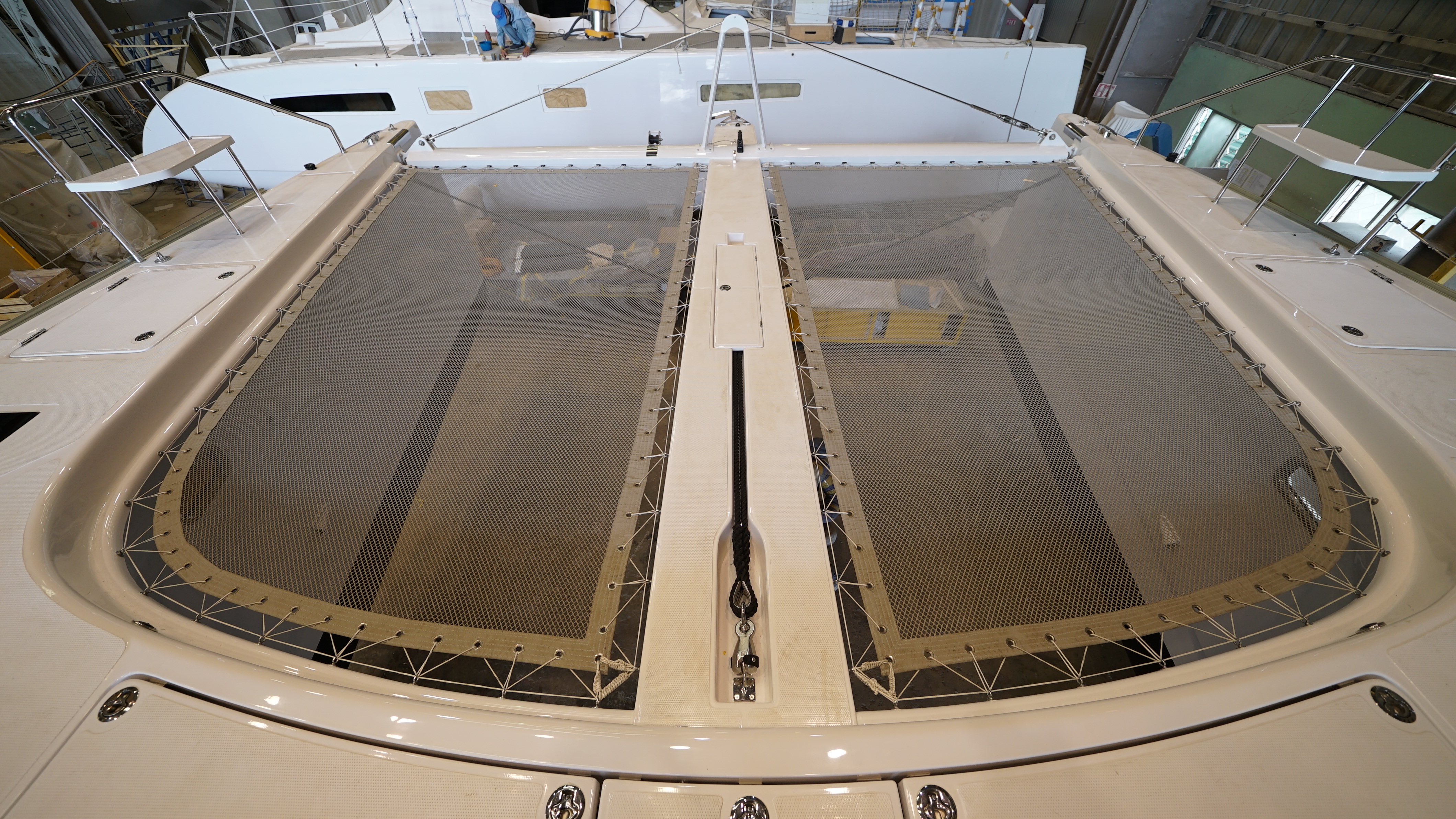

Our Production team is currently working on: windows installation, electrical items (25%), plumbing (50%), and steering system (50%).

Production Update – Fit out

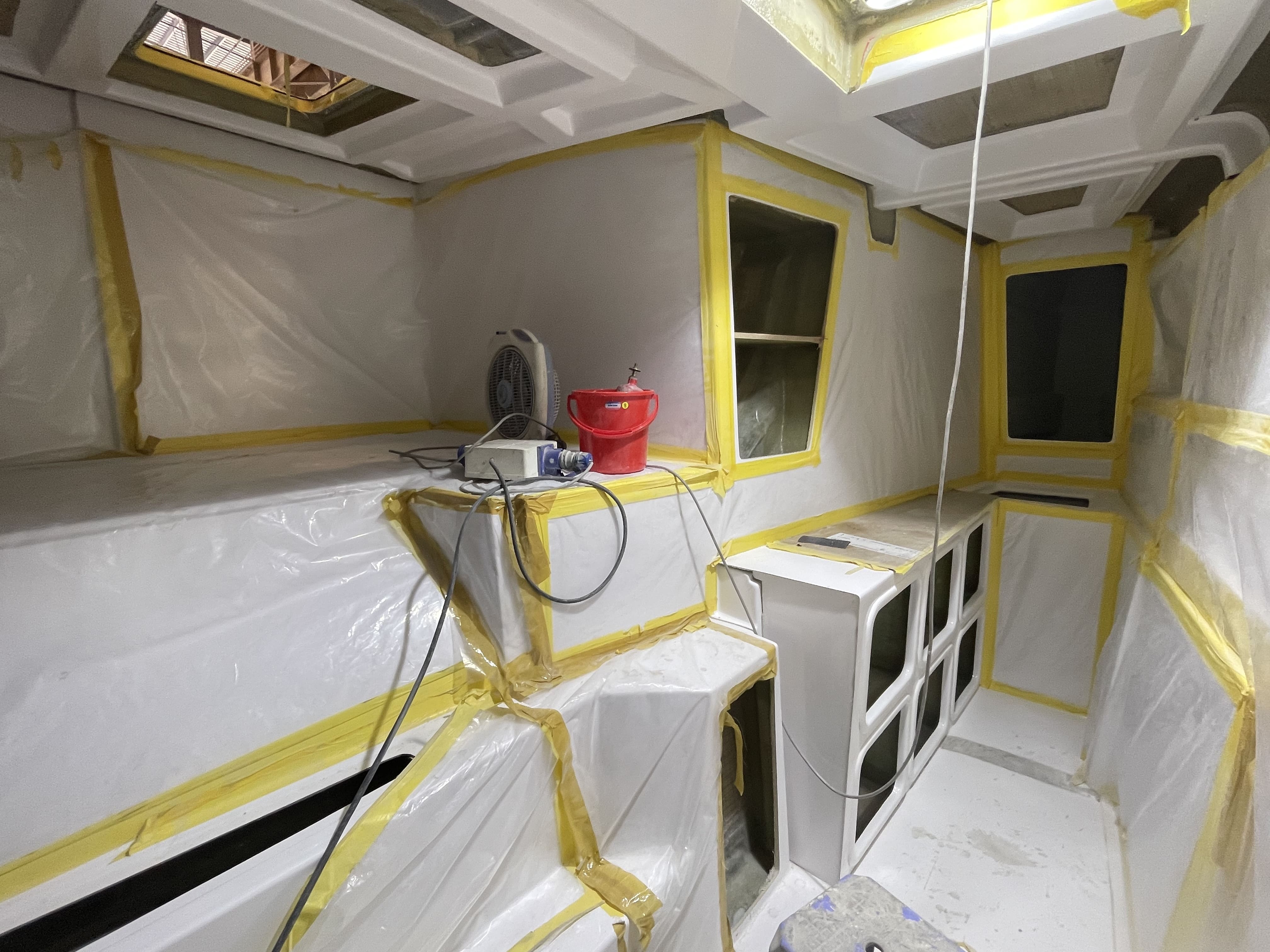

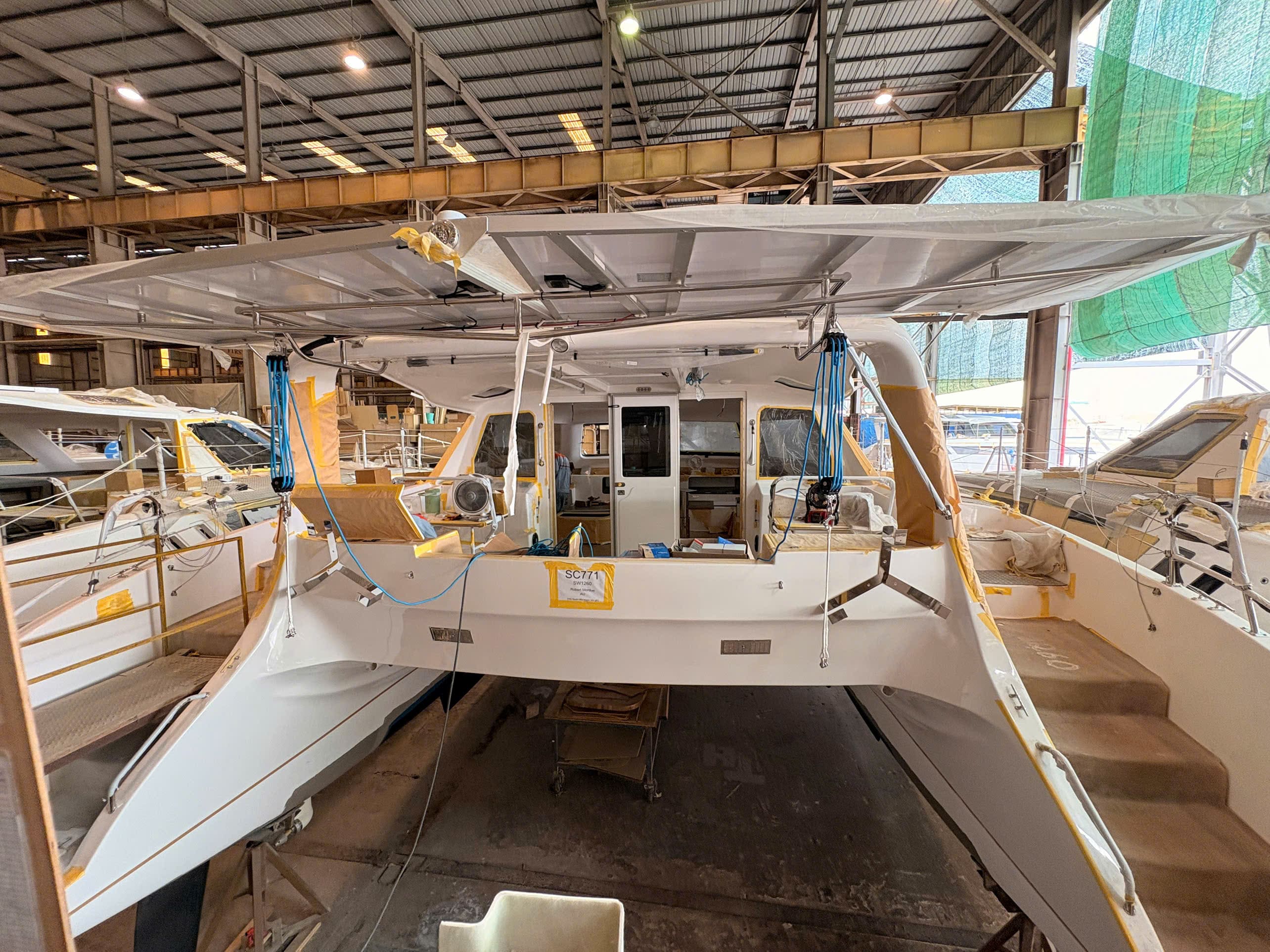

Your boat is progressing well in the Fit out stage.

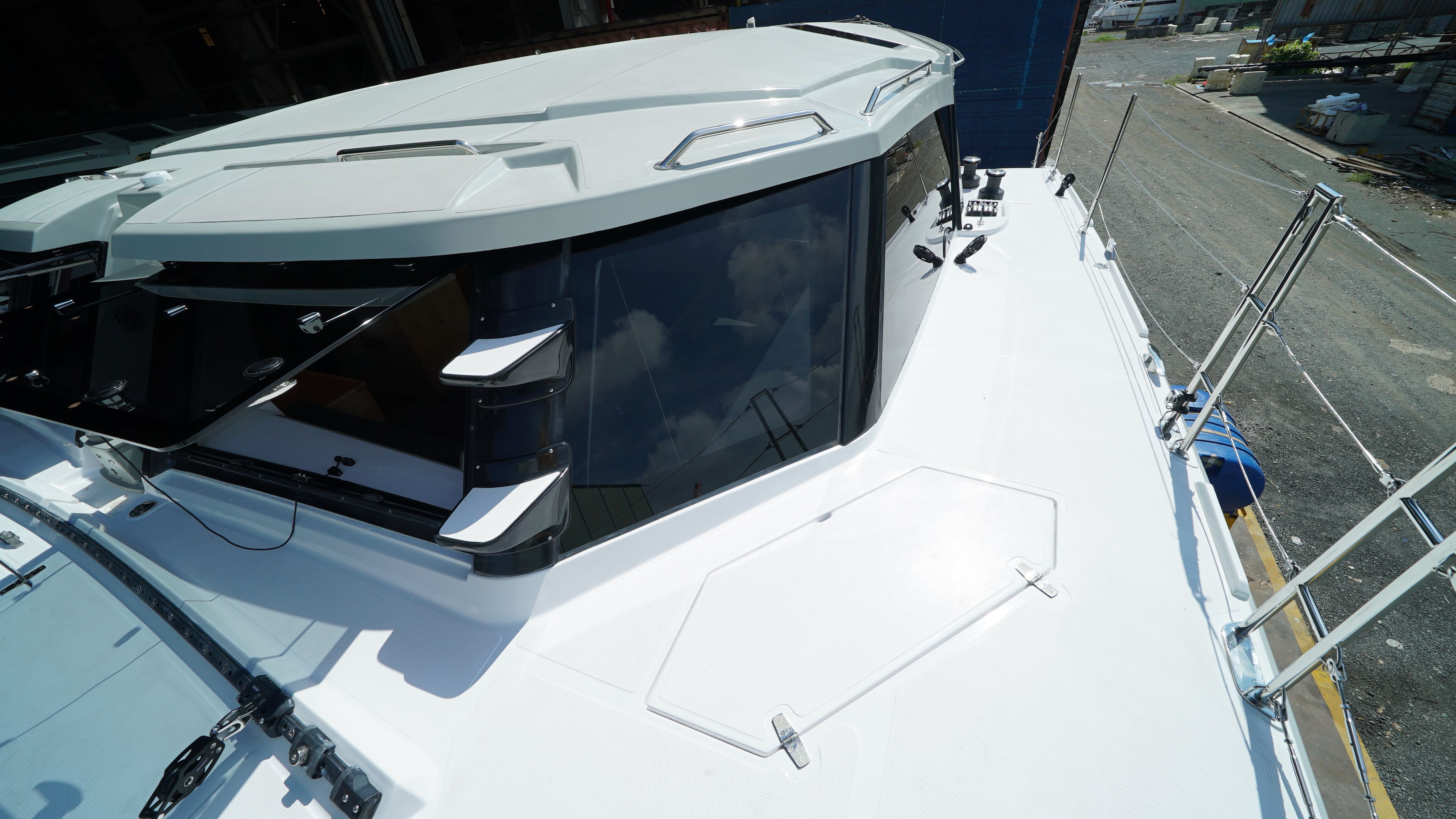

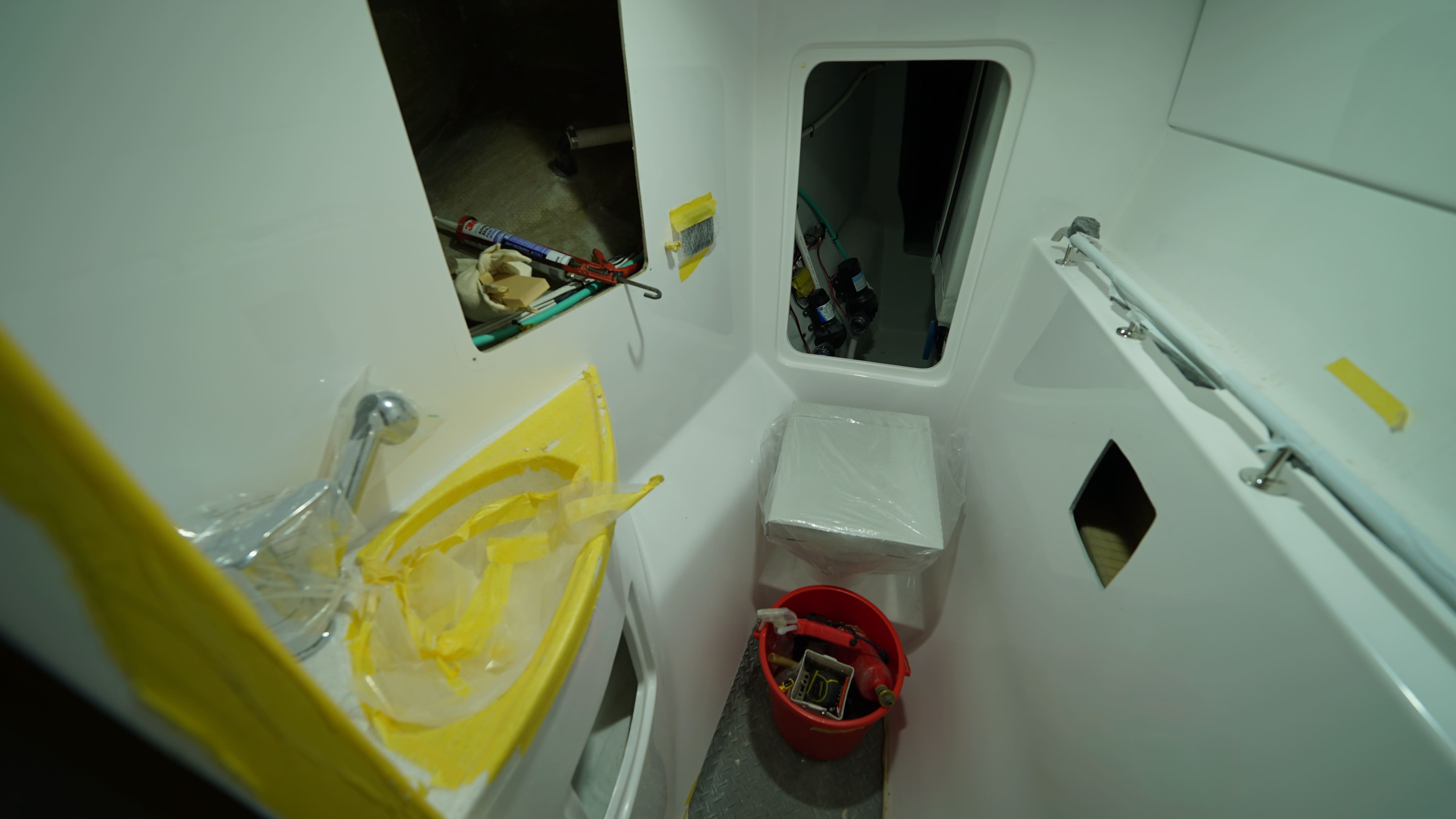

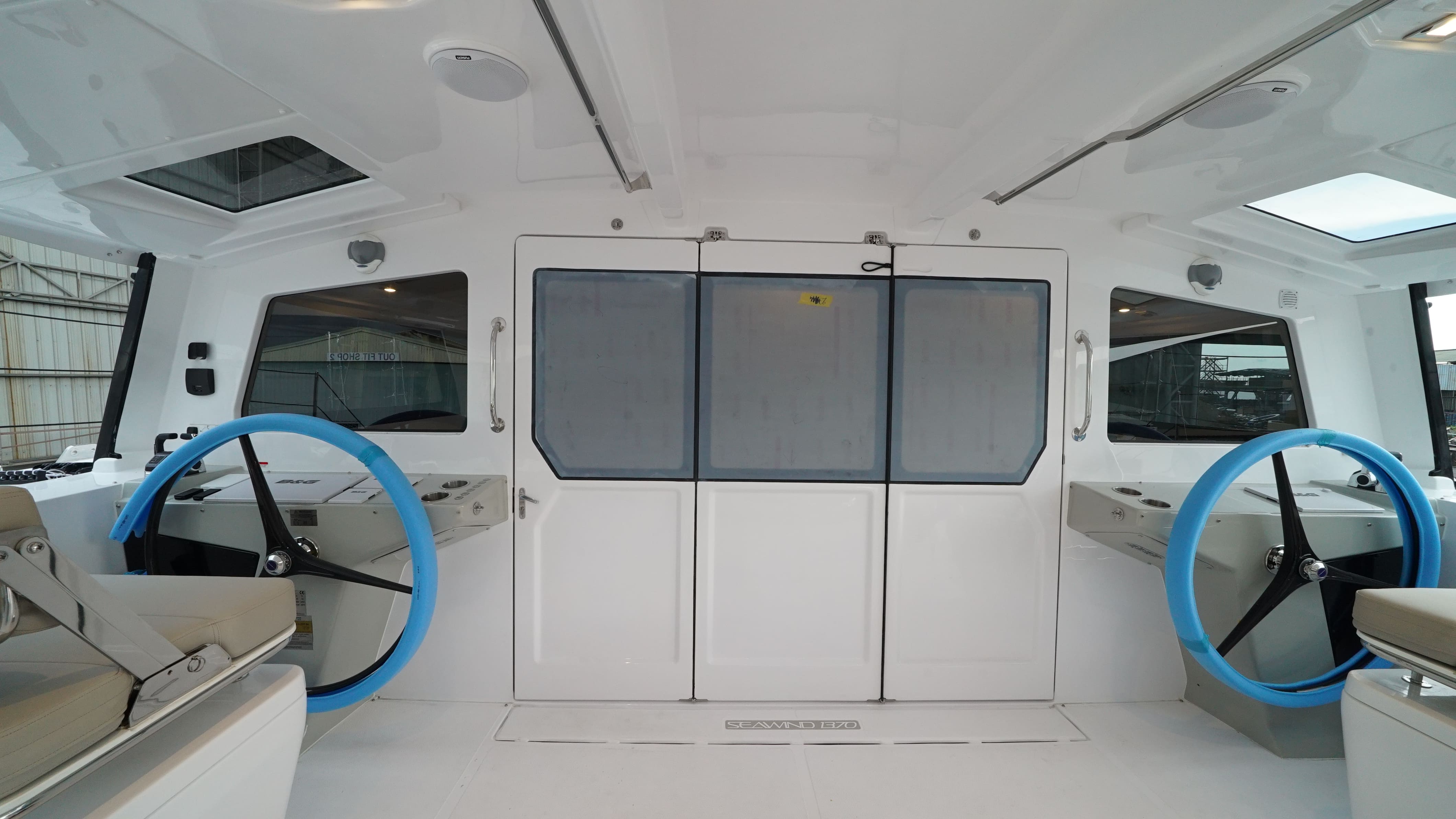

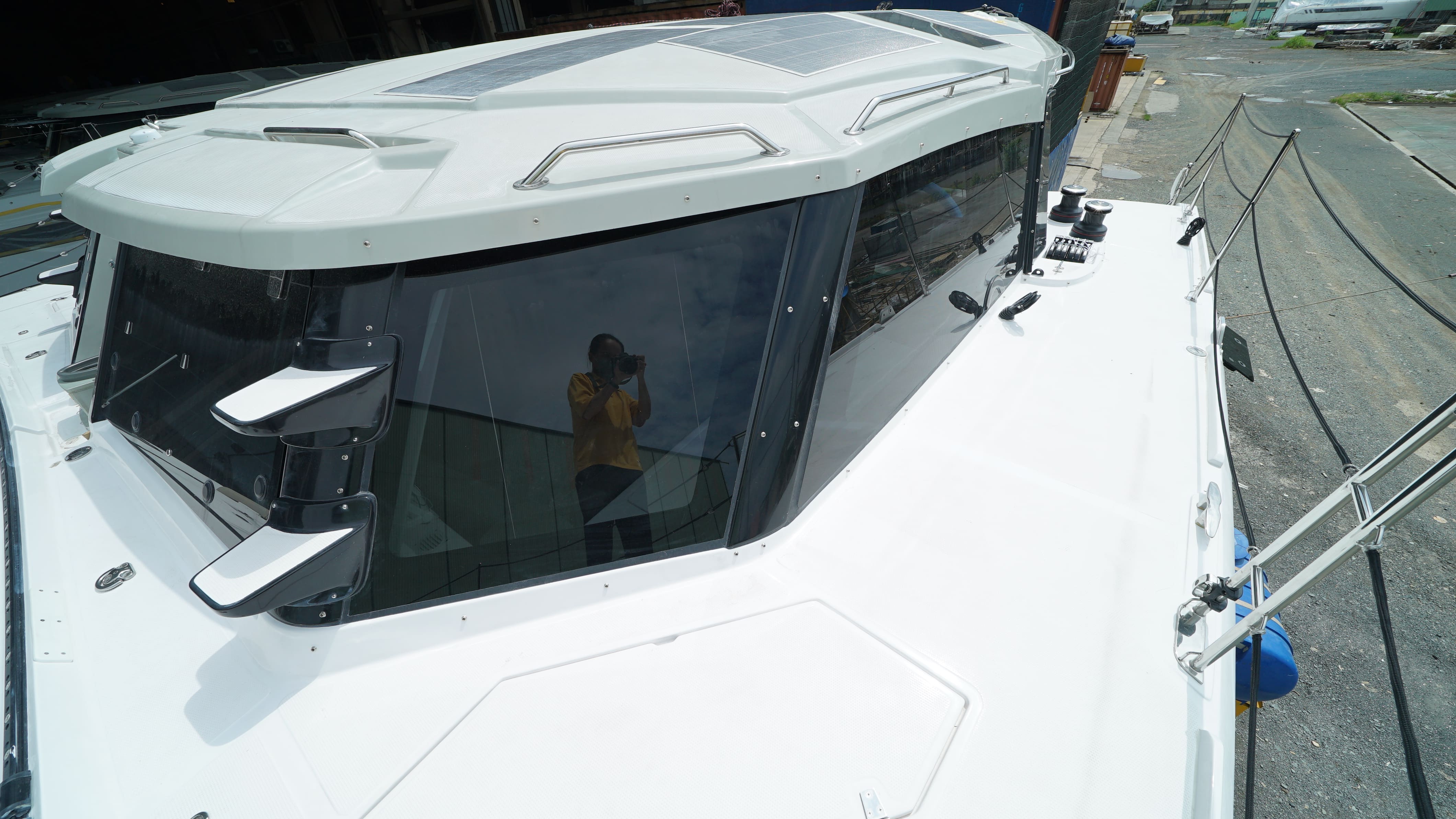

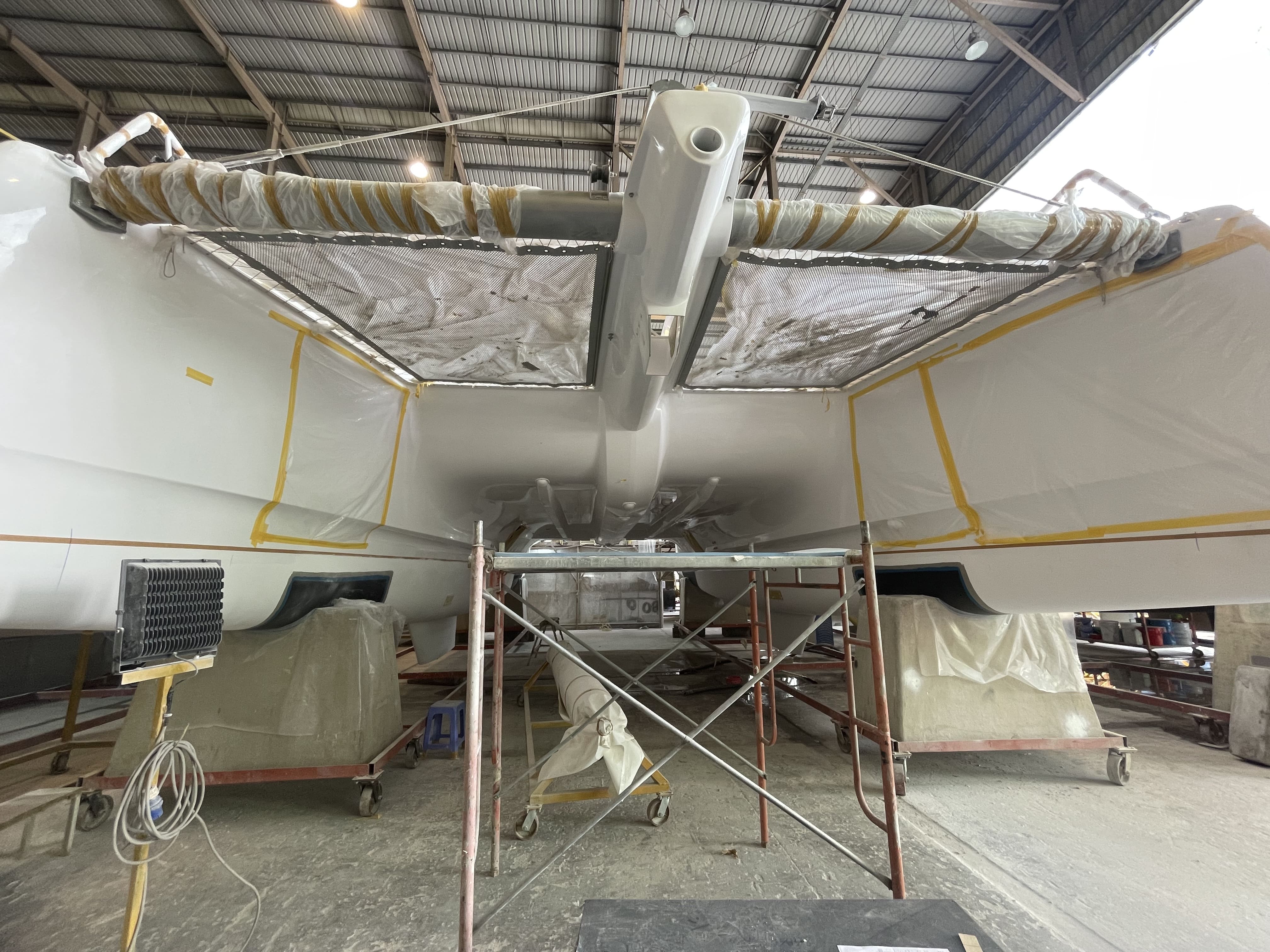

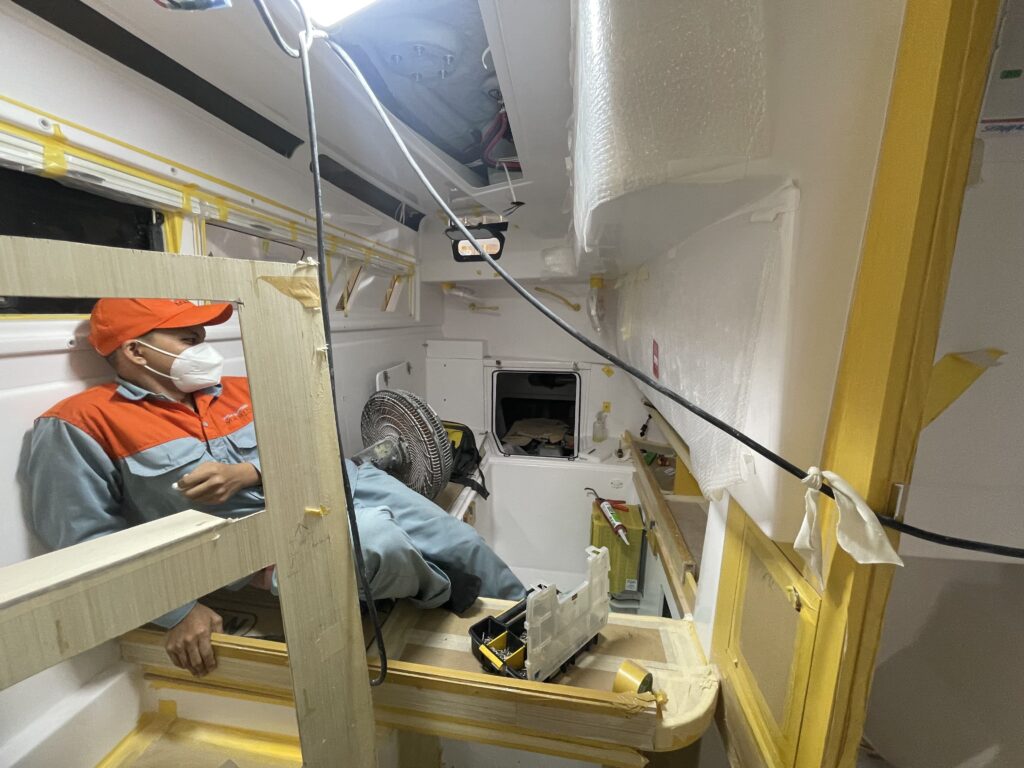

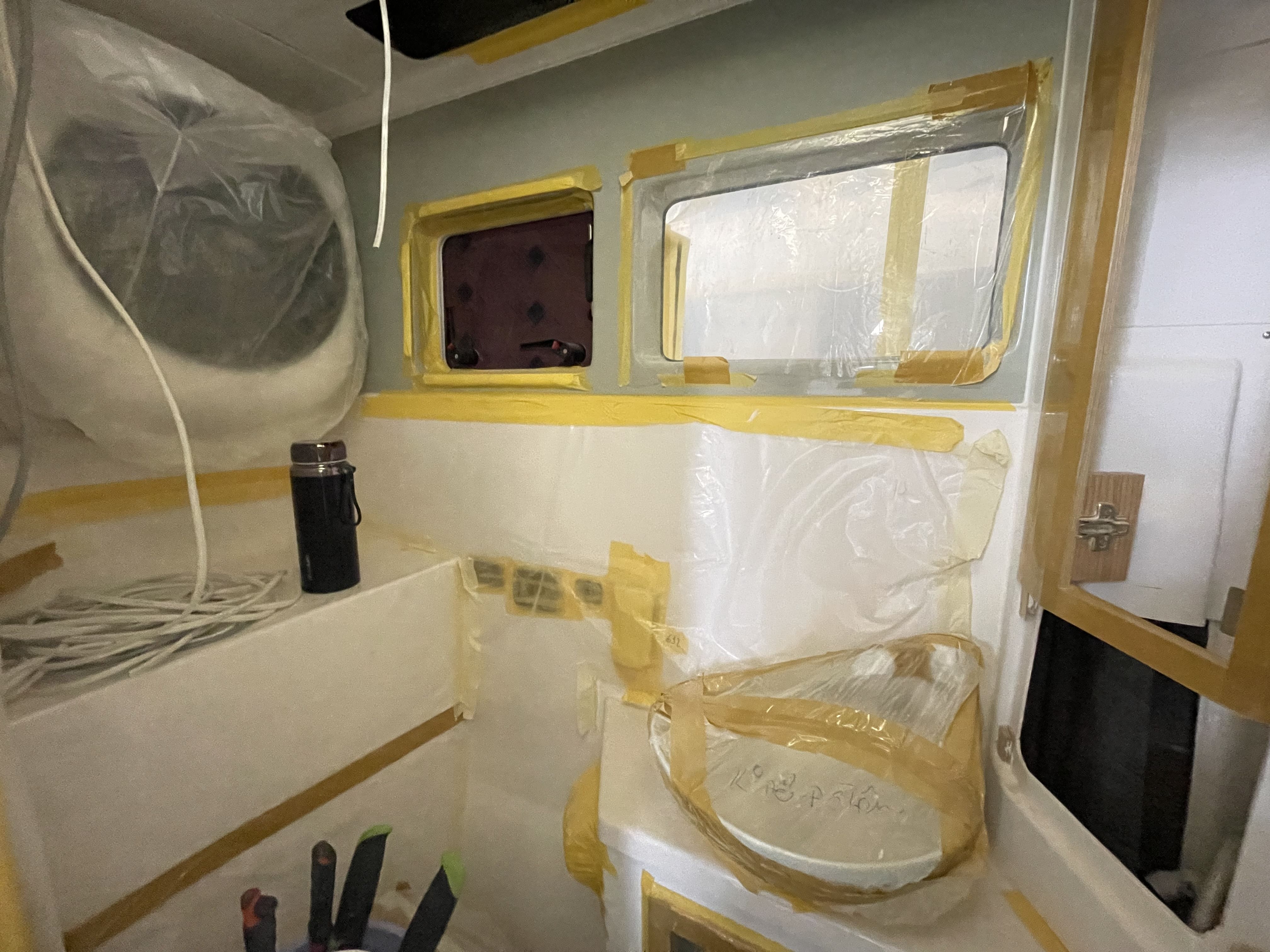

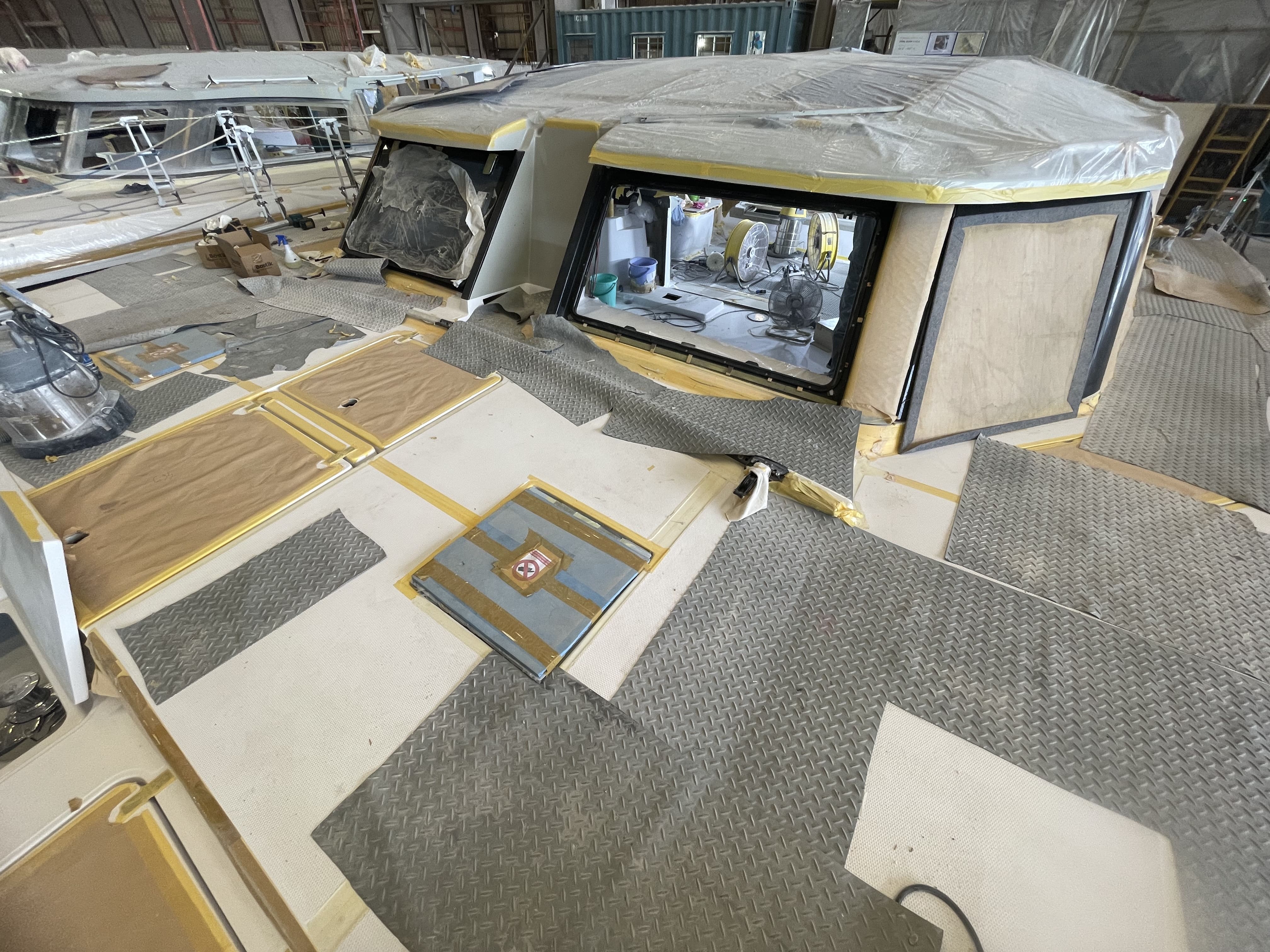

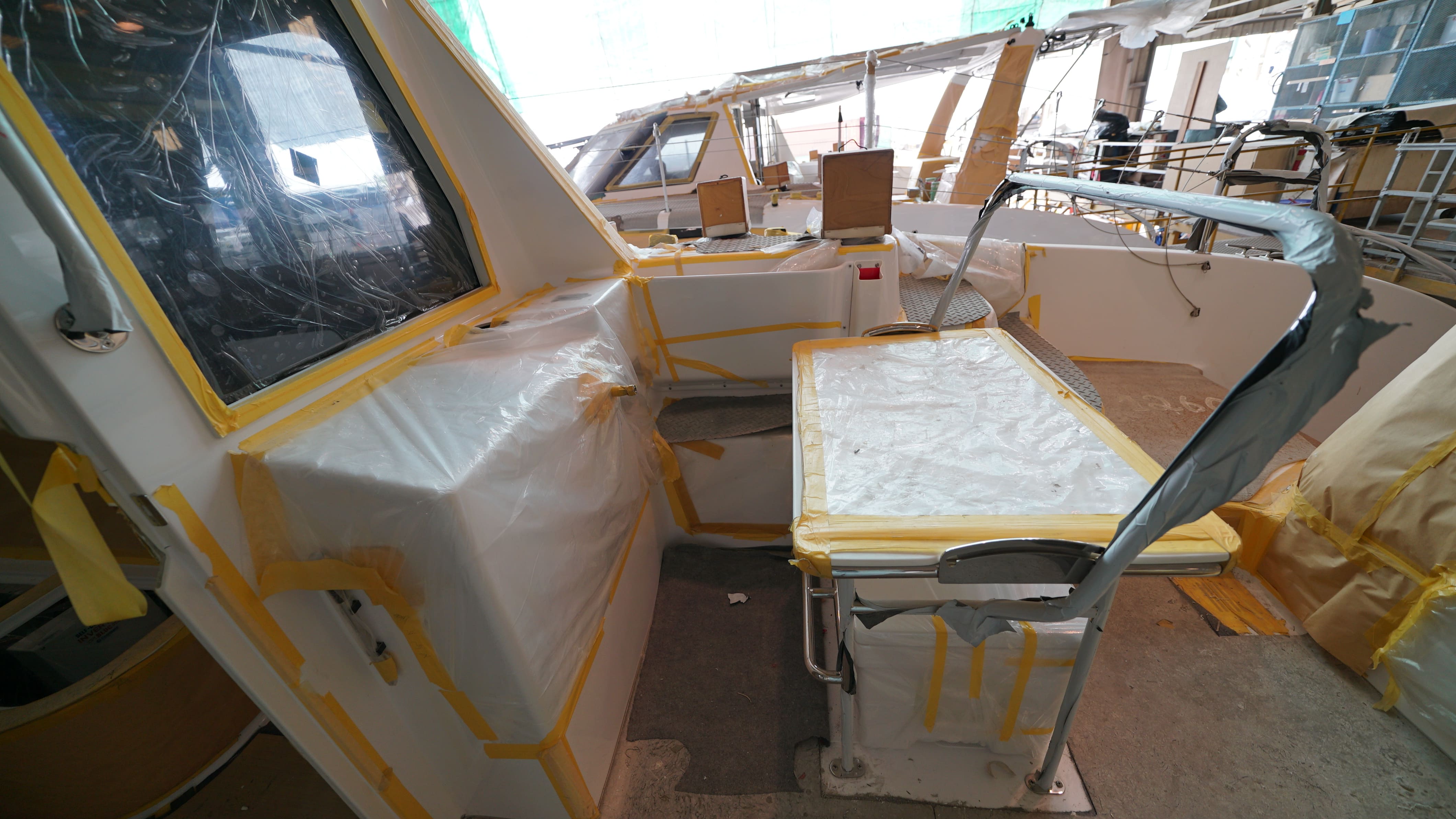

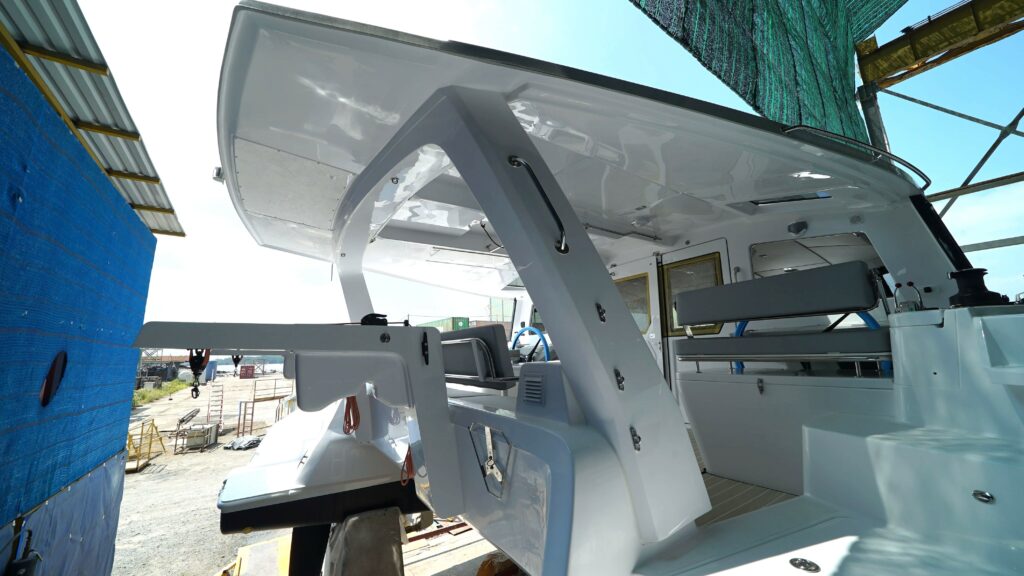

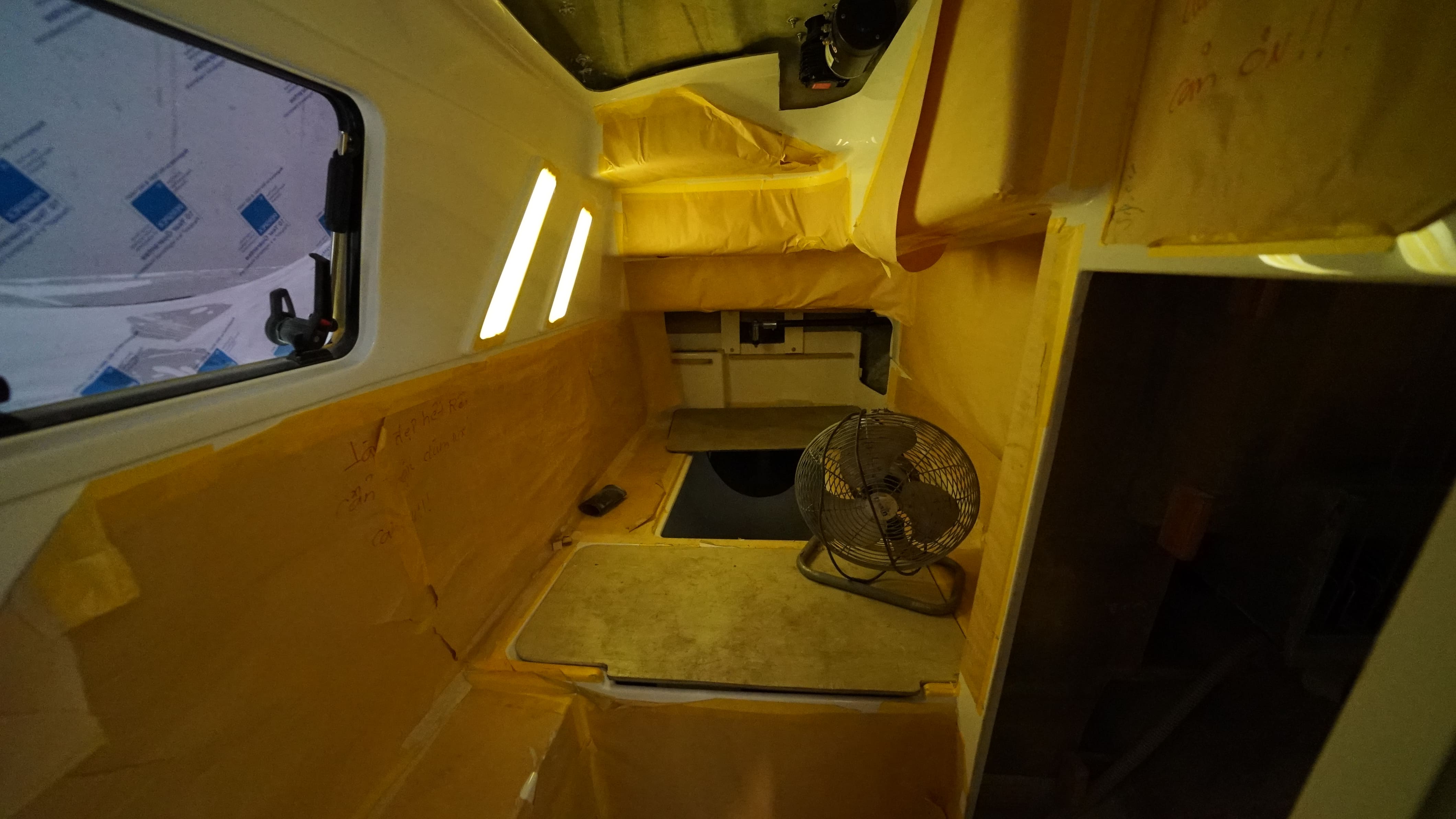

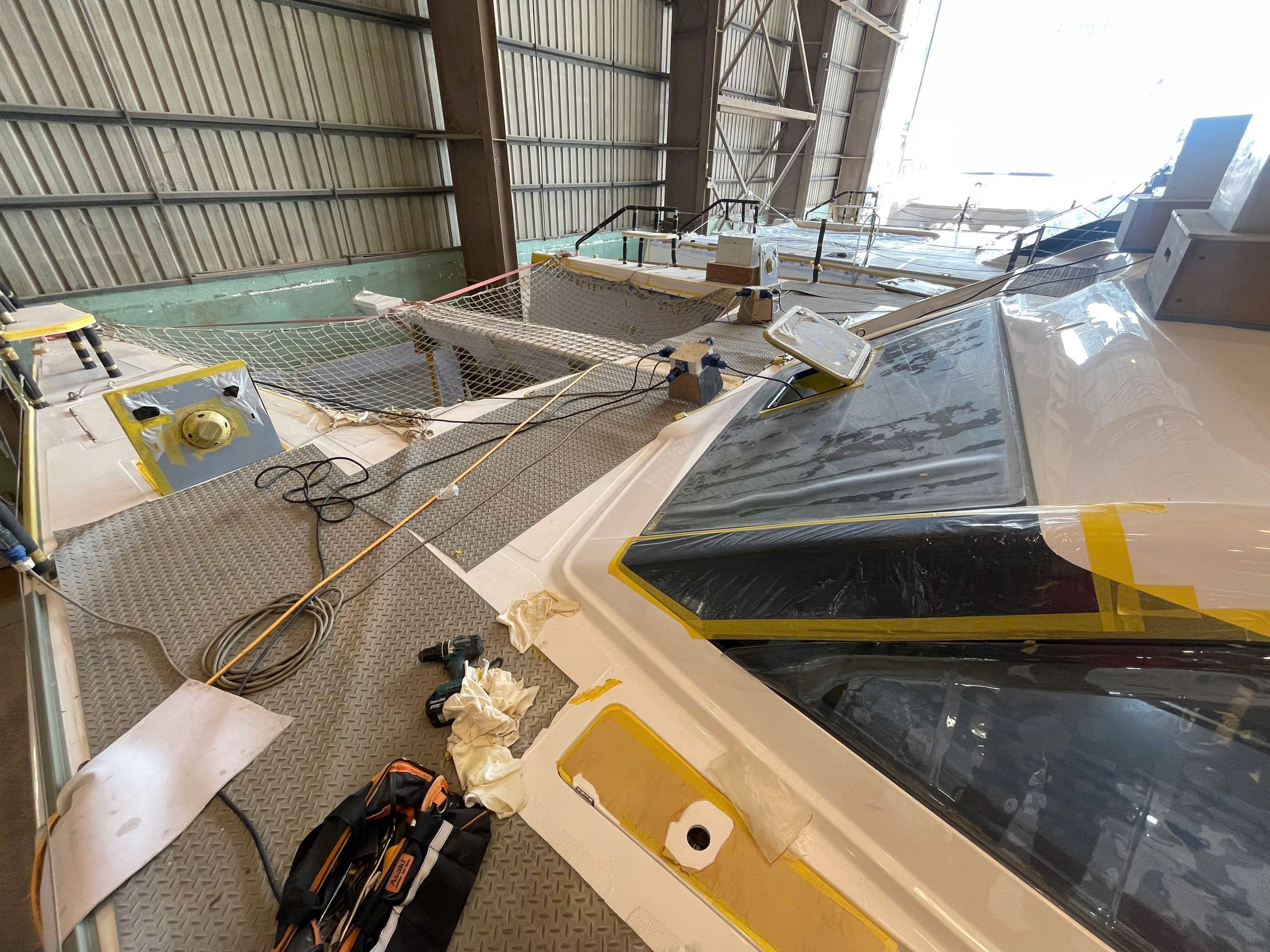

We have finished the installation of windows & dech hatches, forward beam, A-frame & A frame wire, and engines.

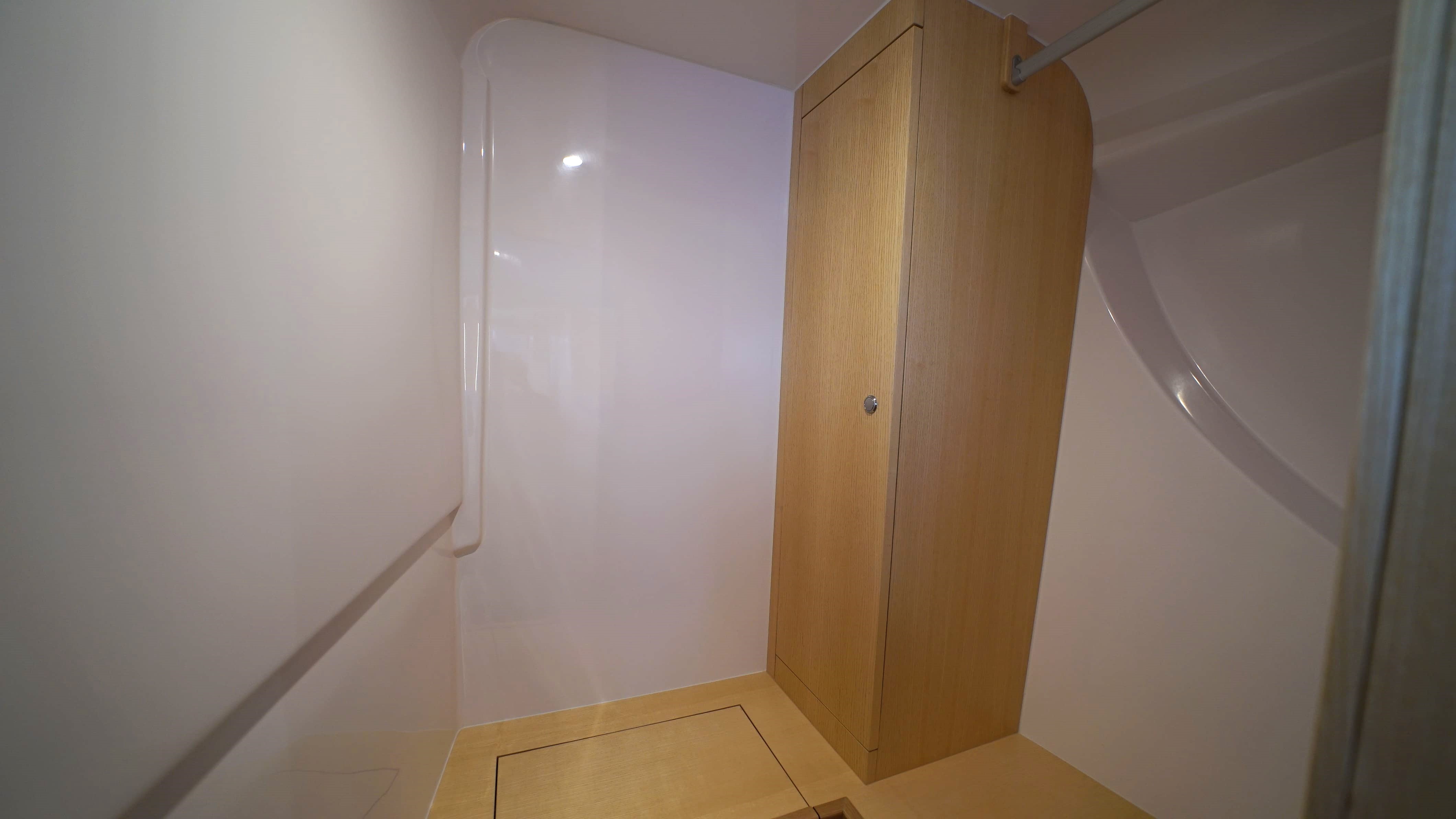

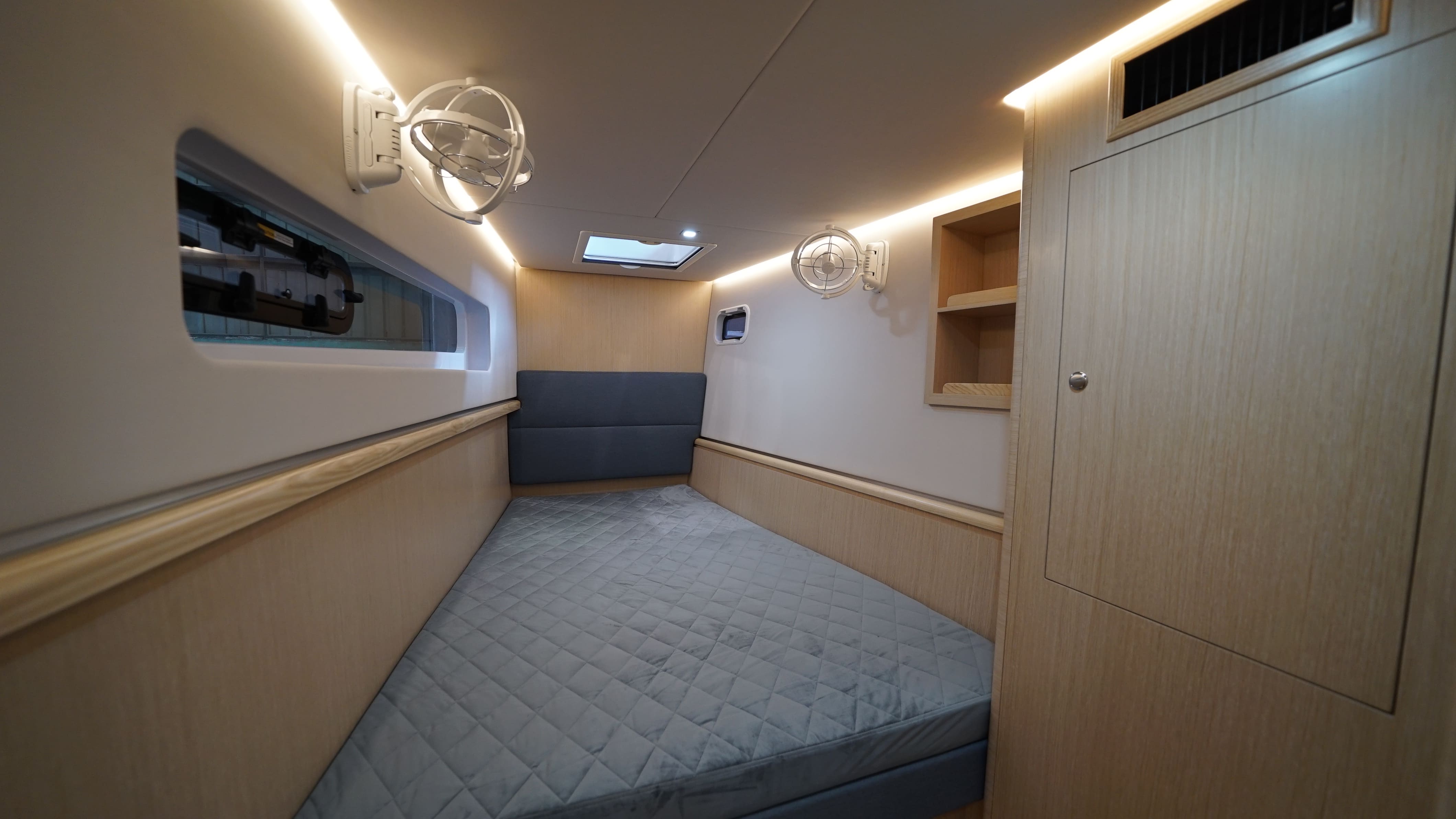

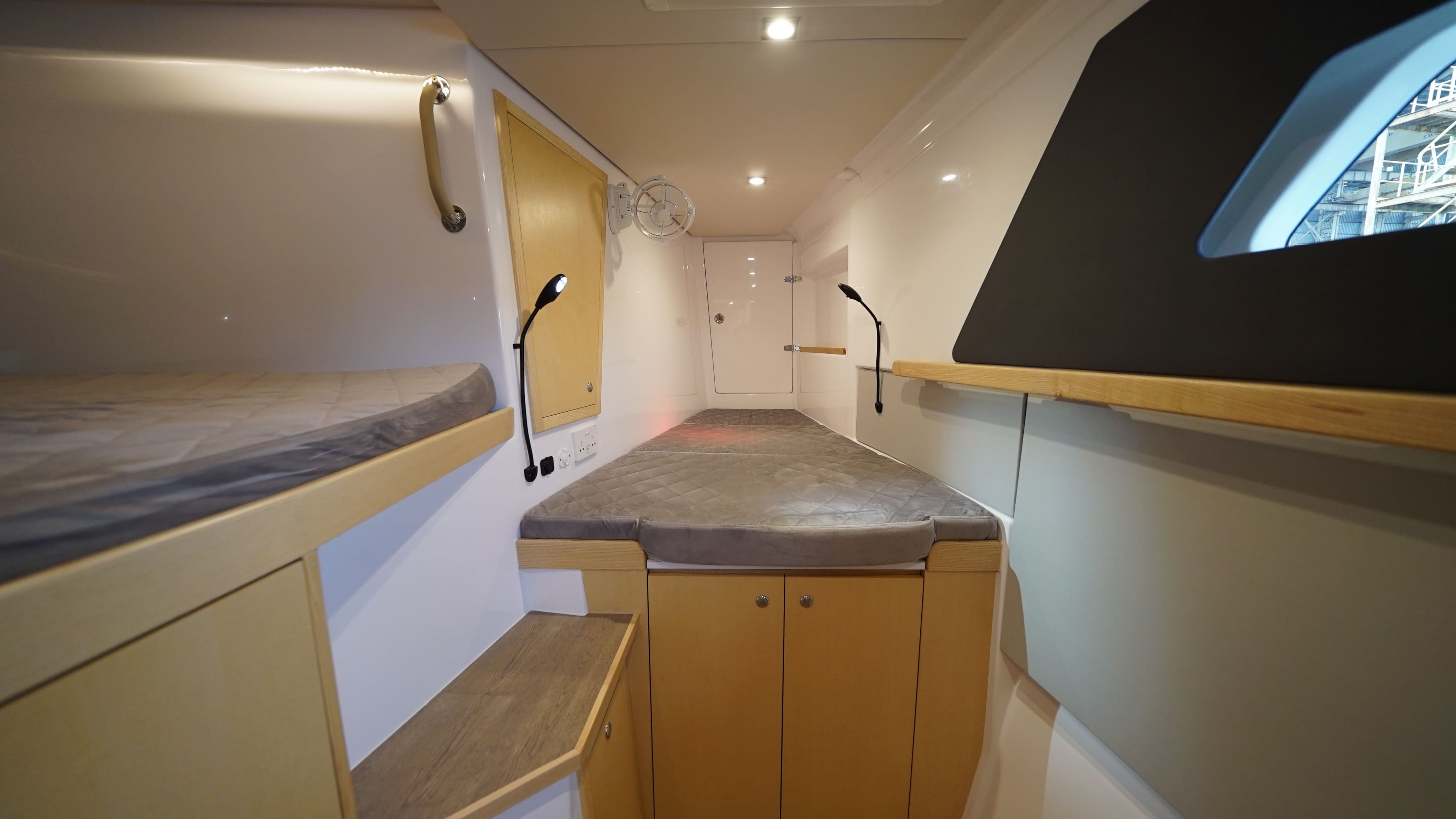

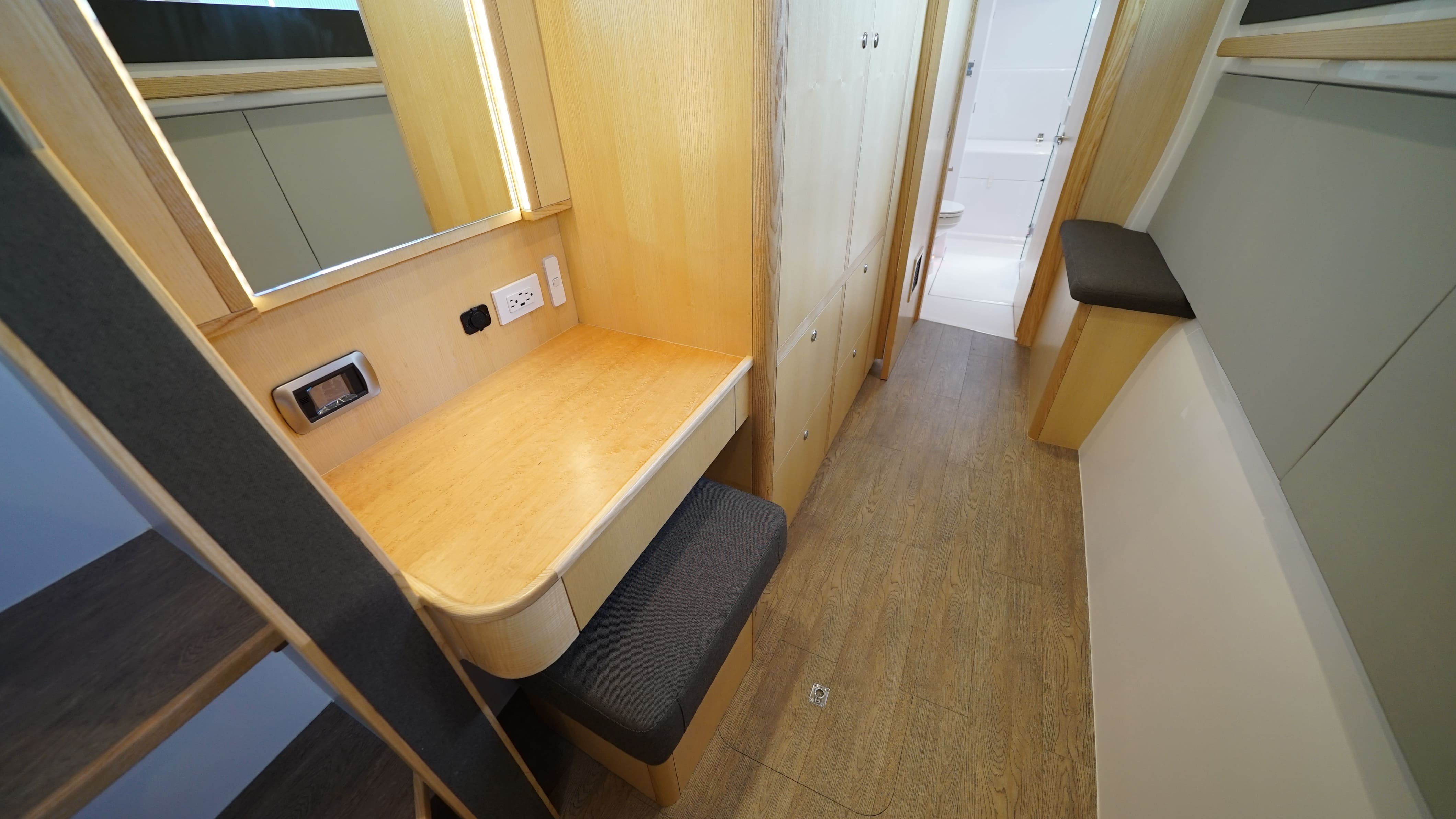

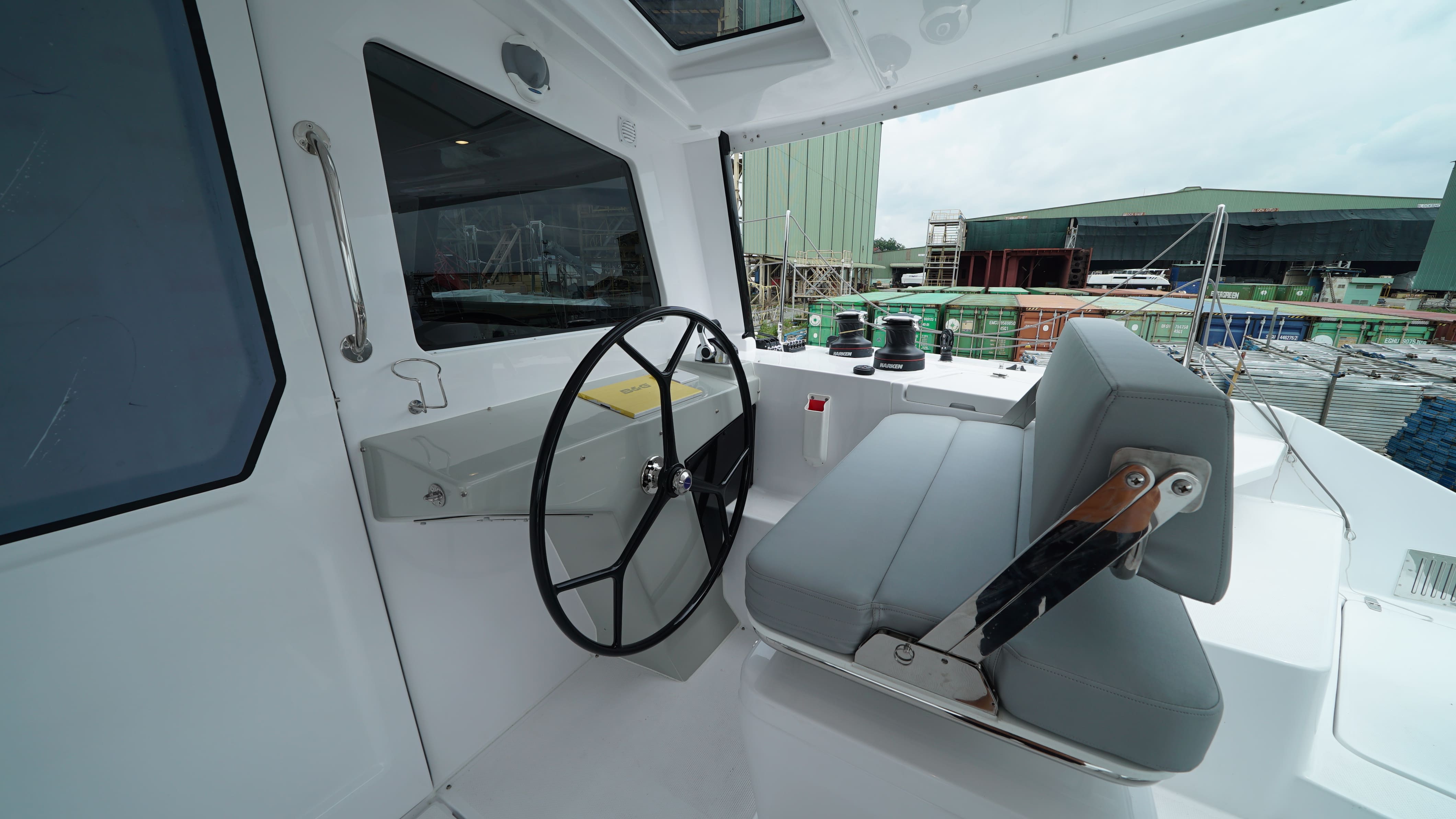

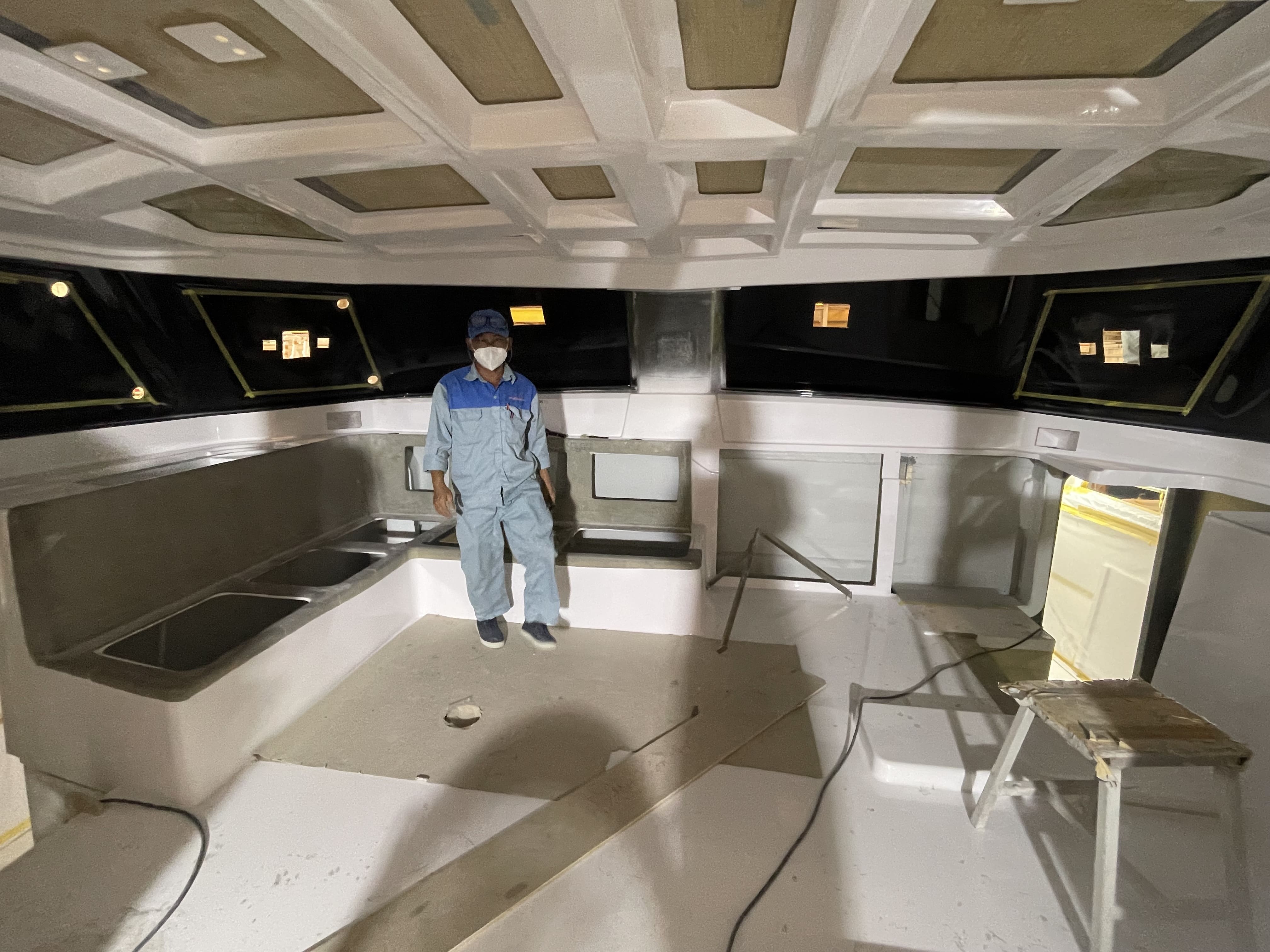

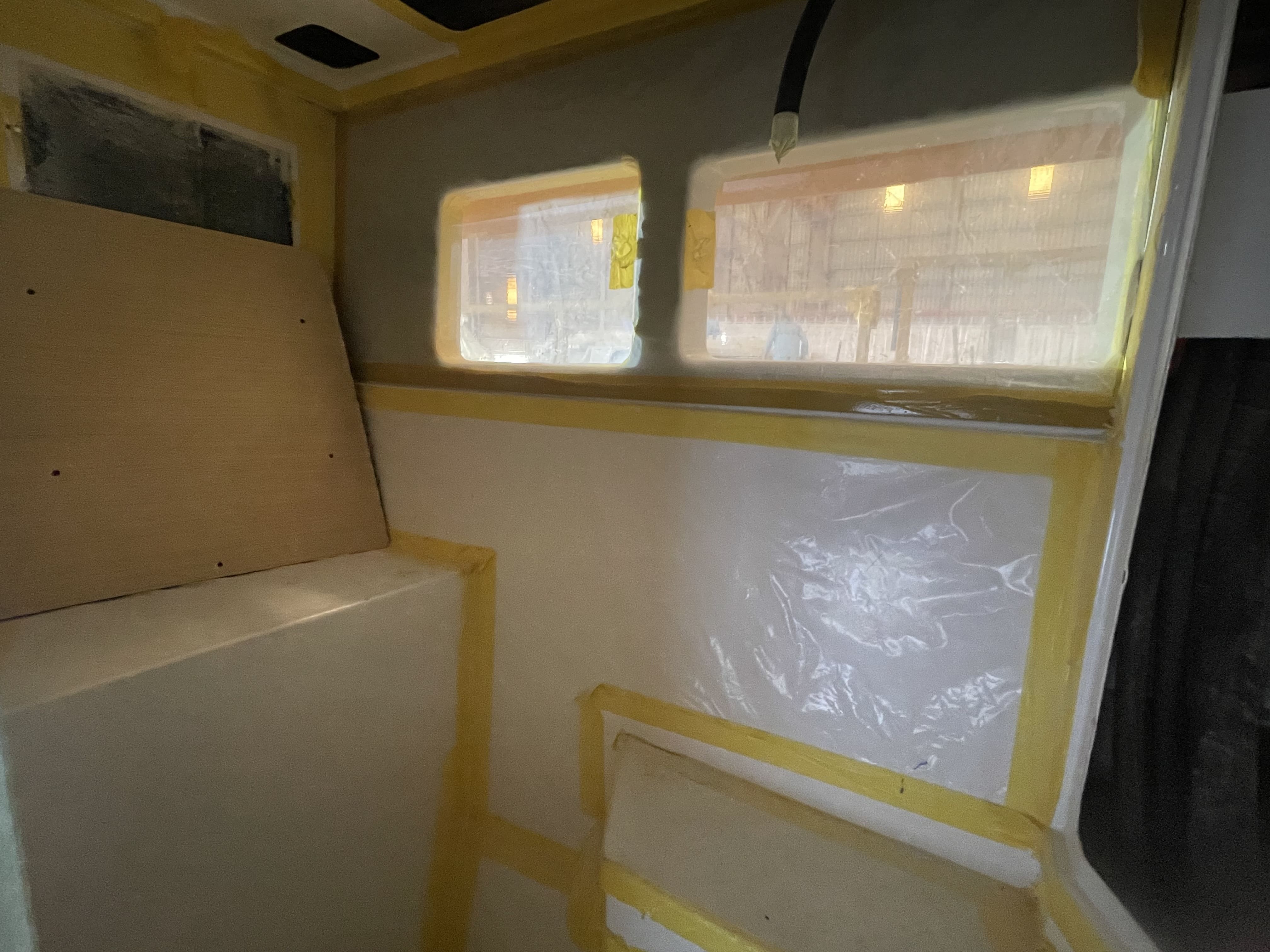

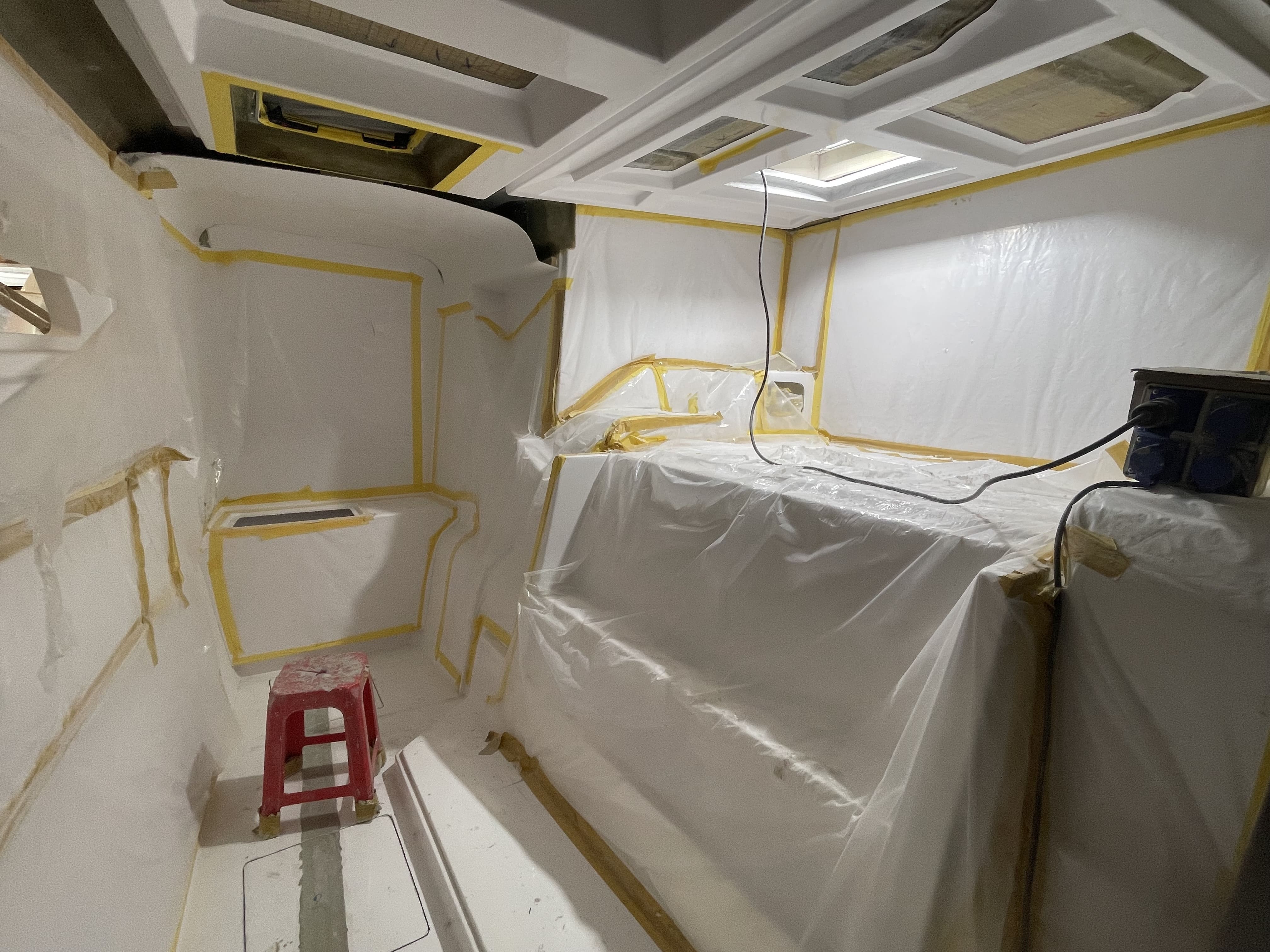

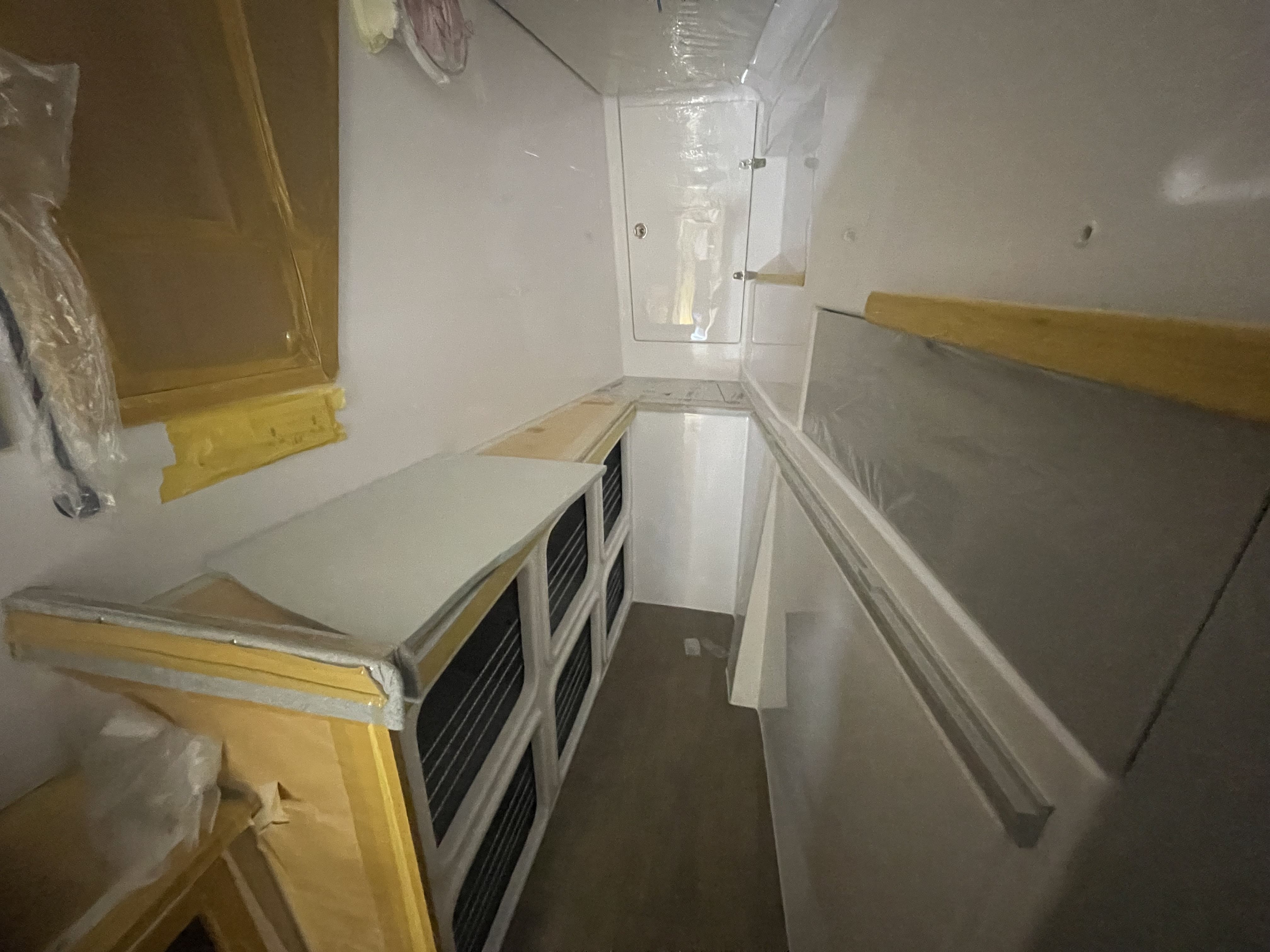

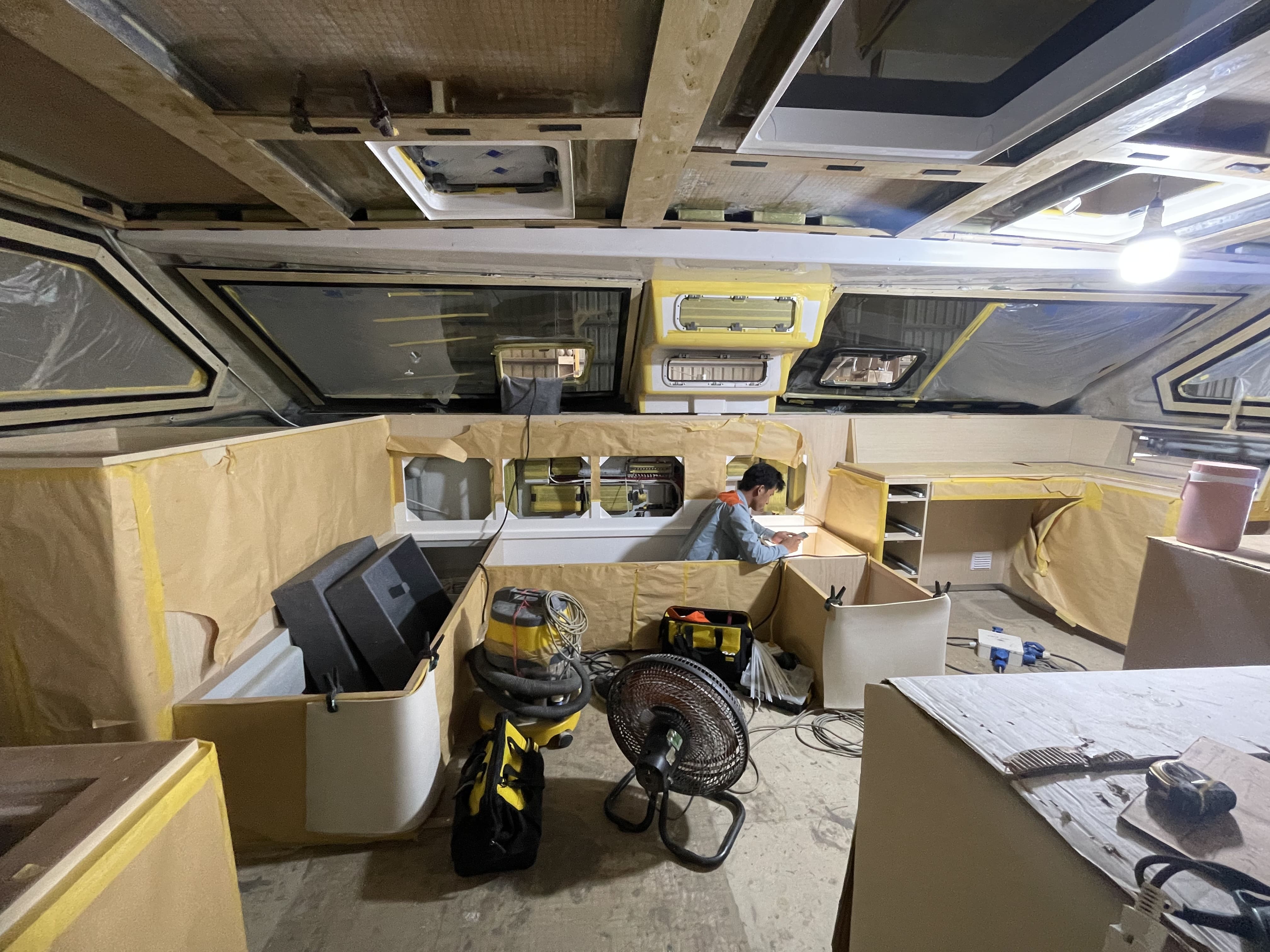

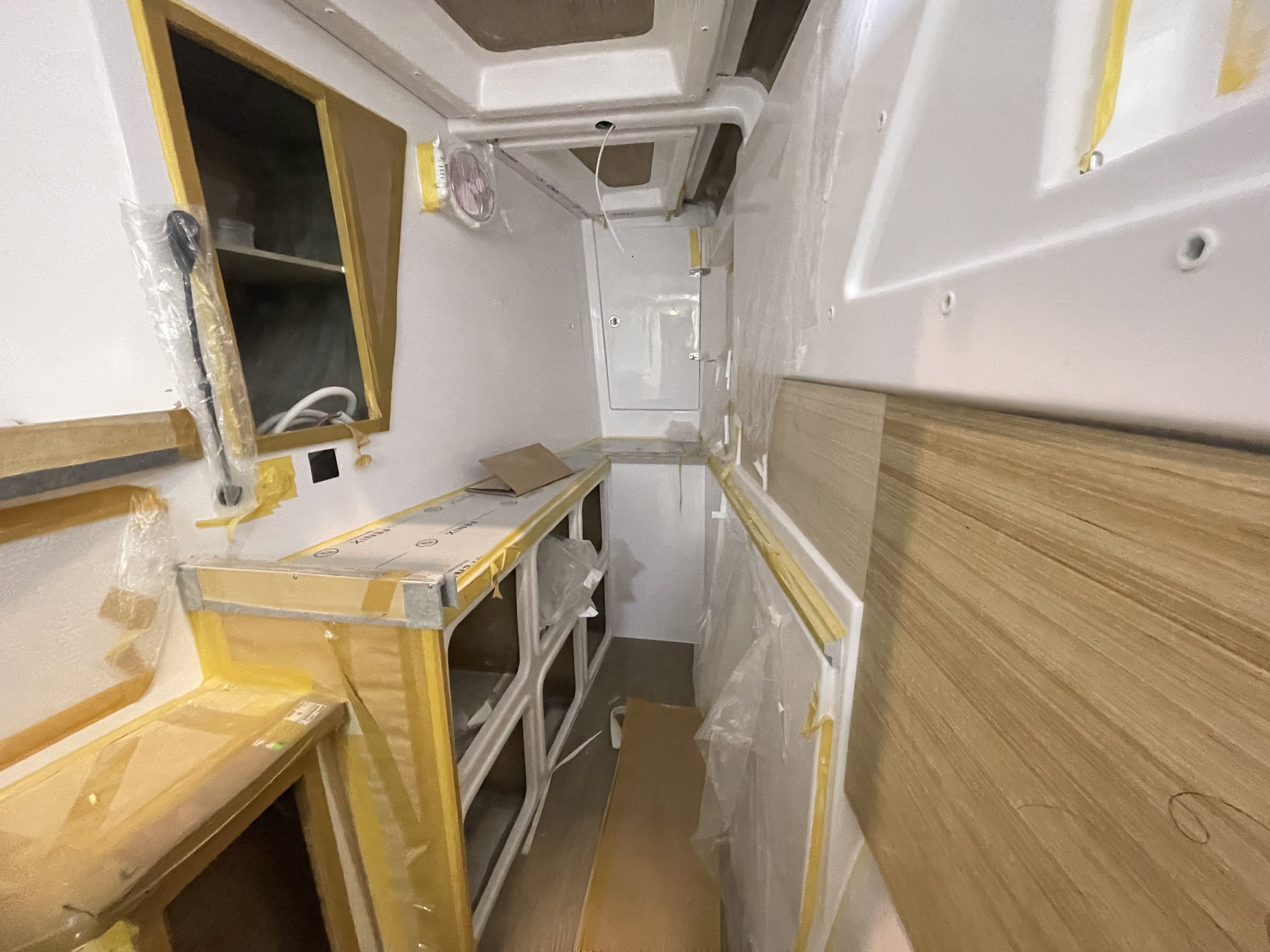

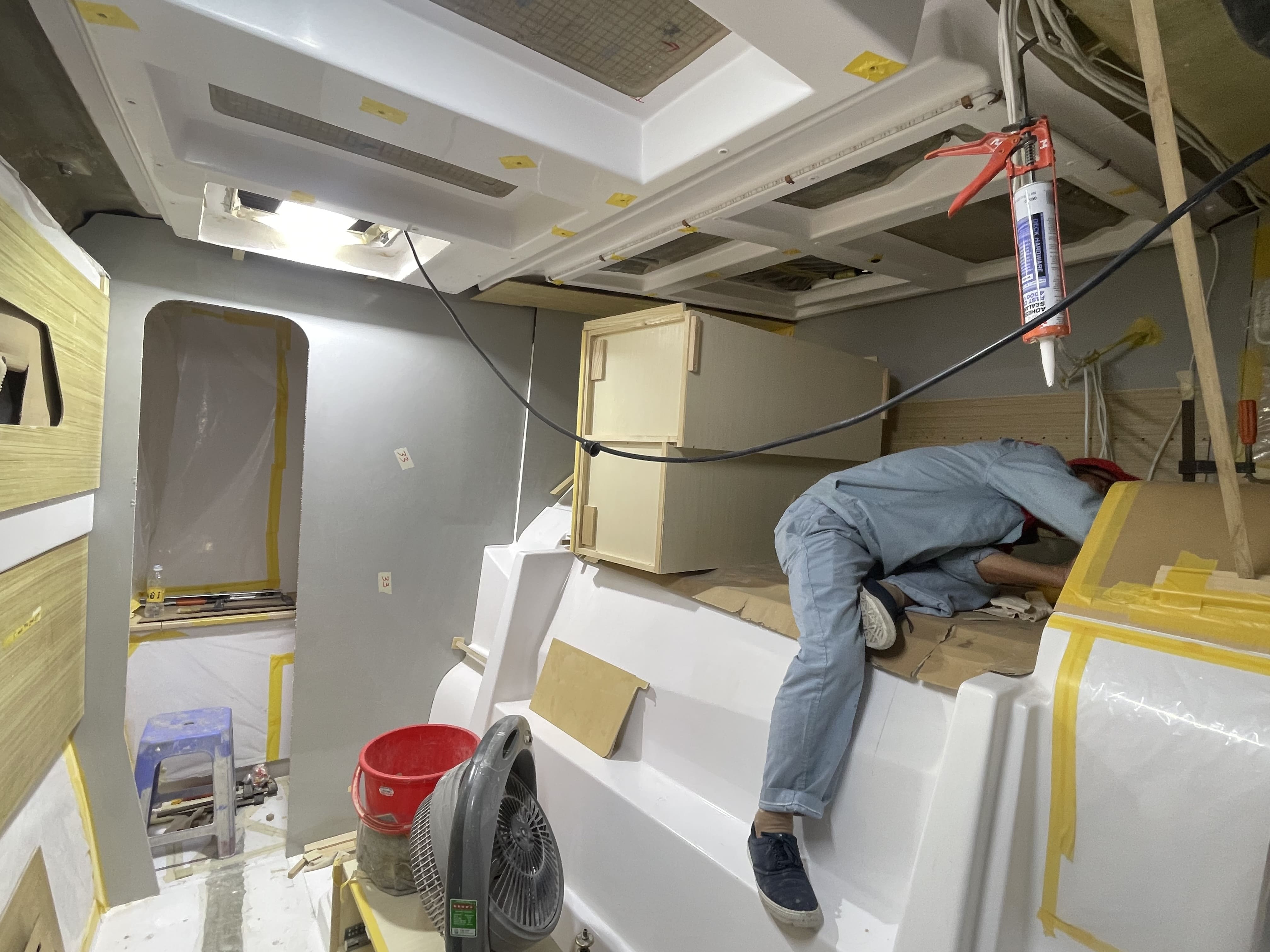

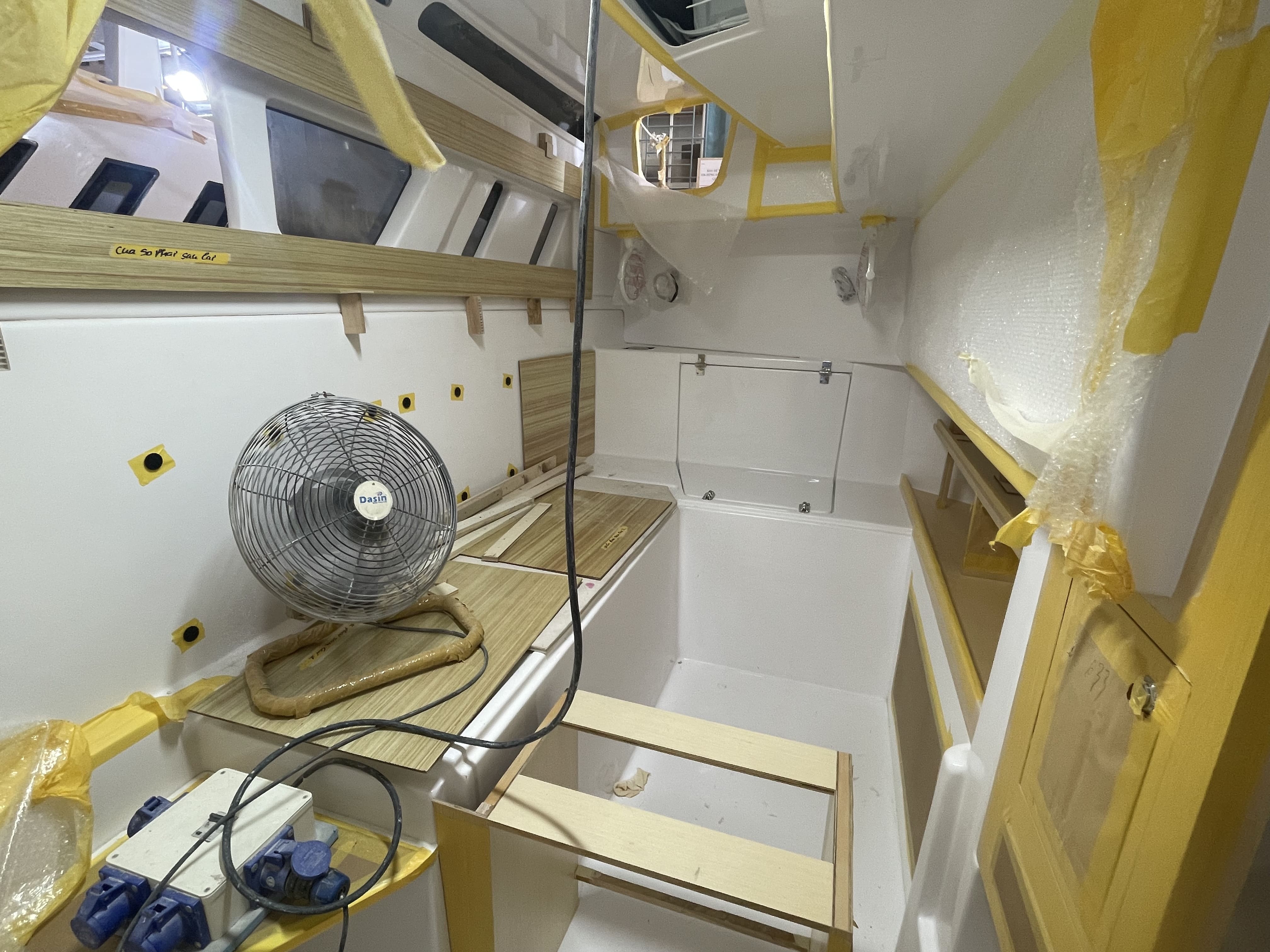

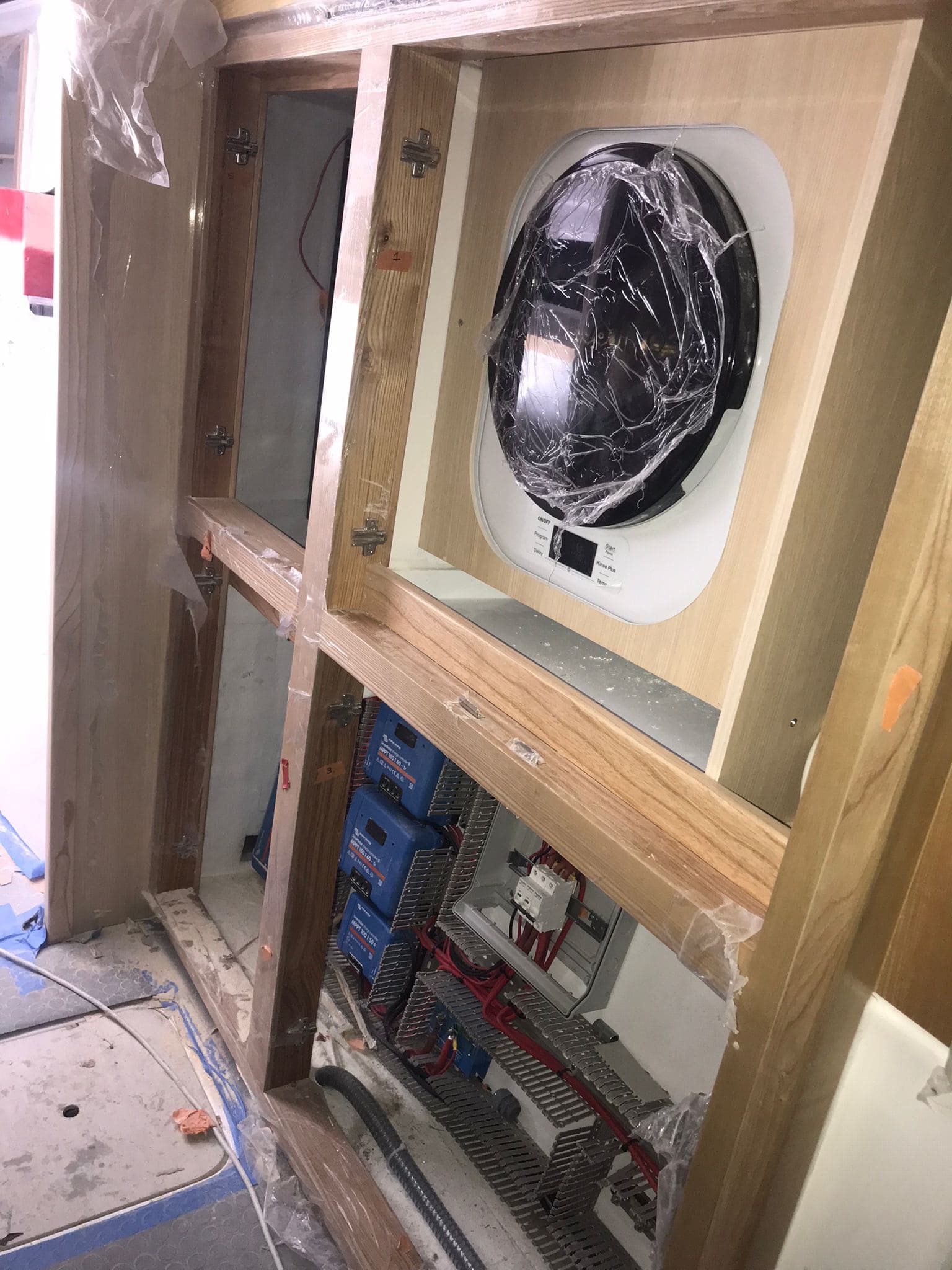

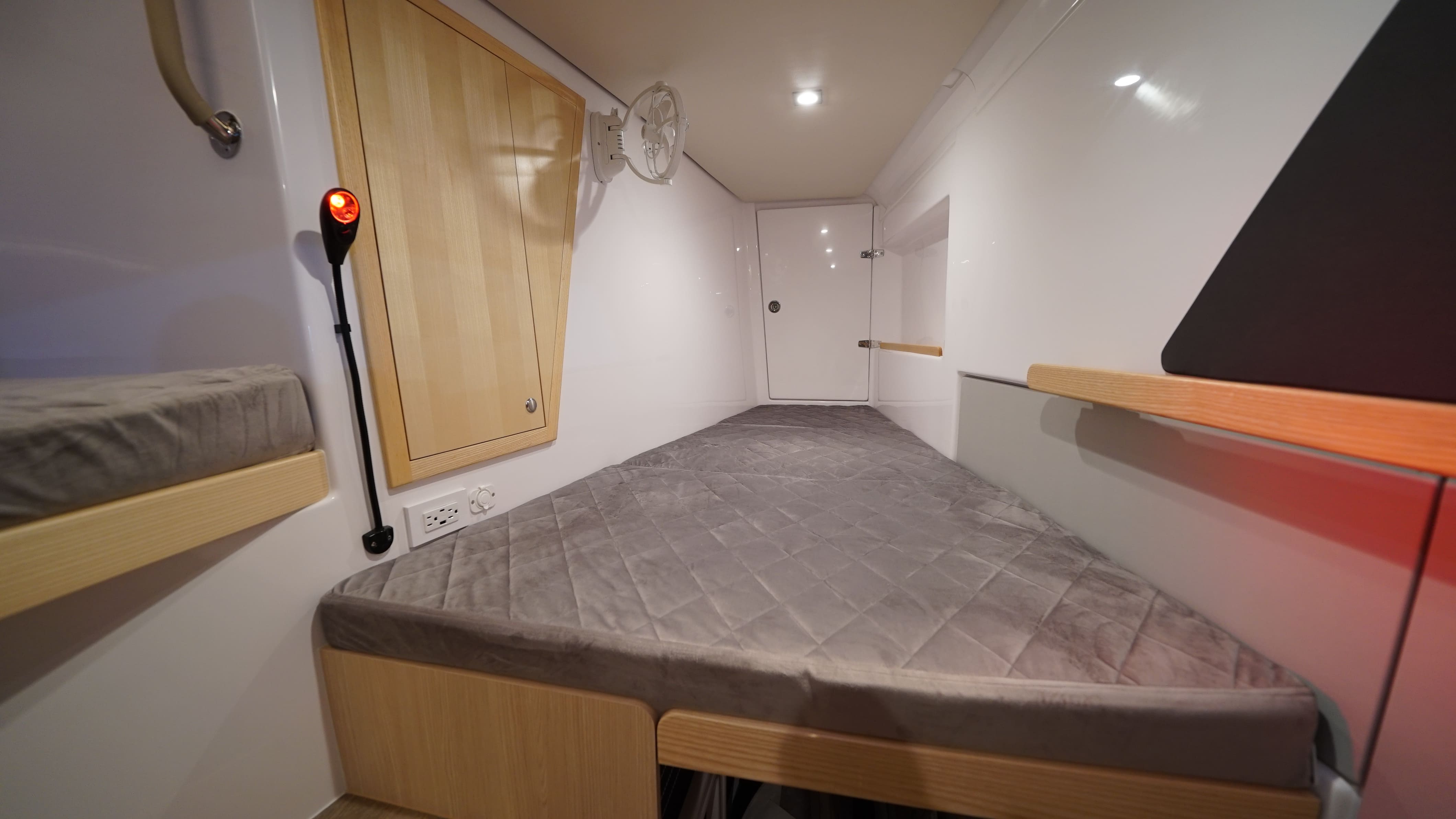

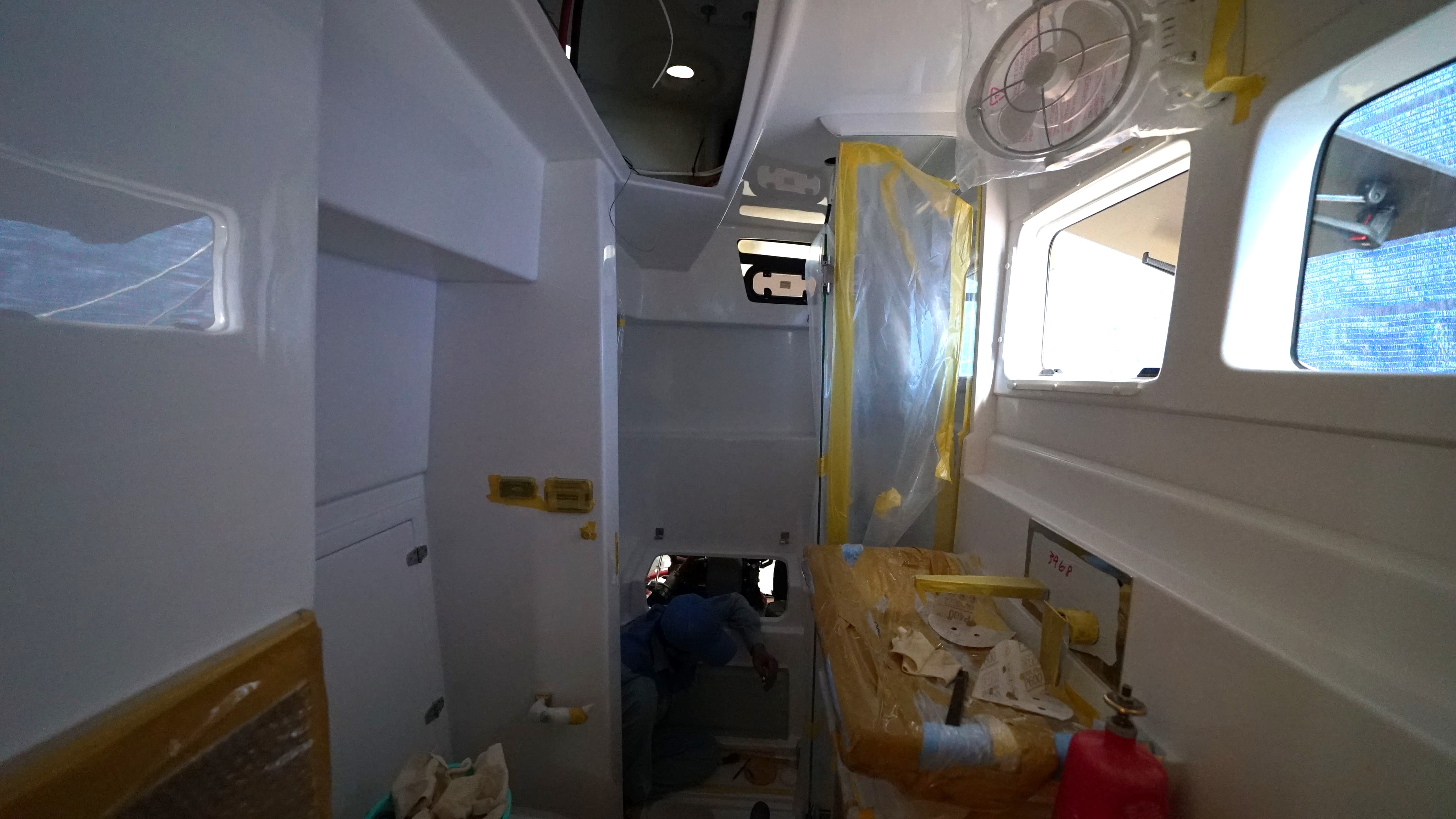

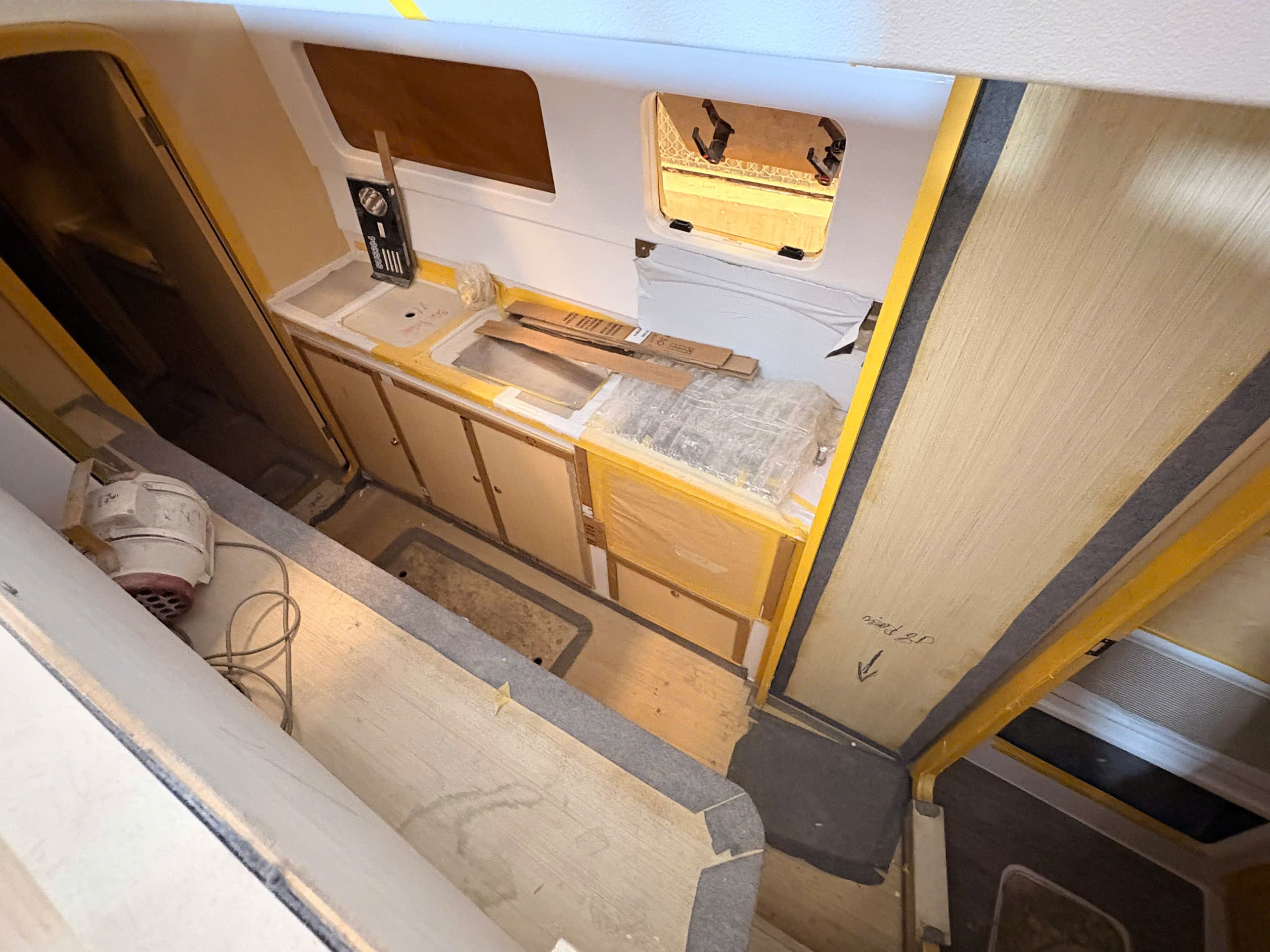

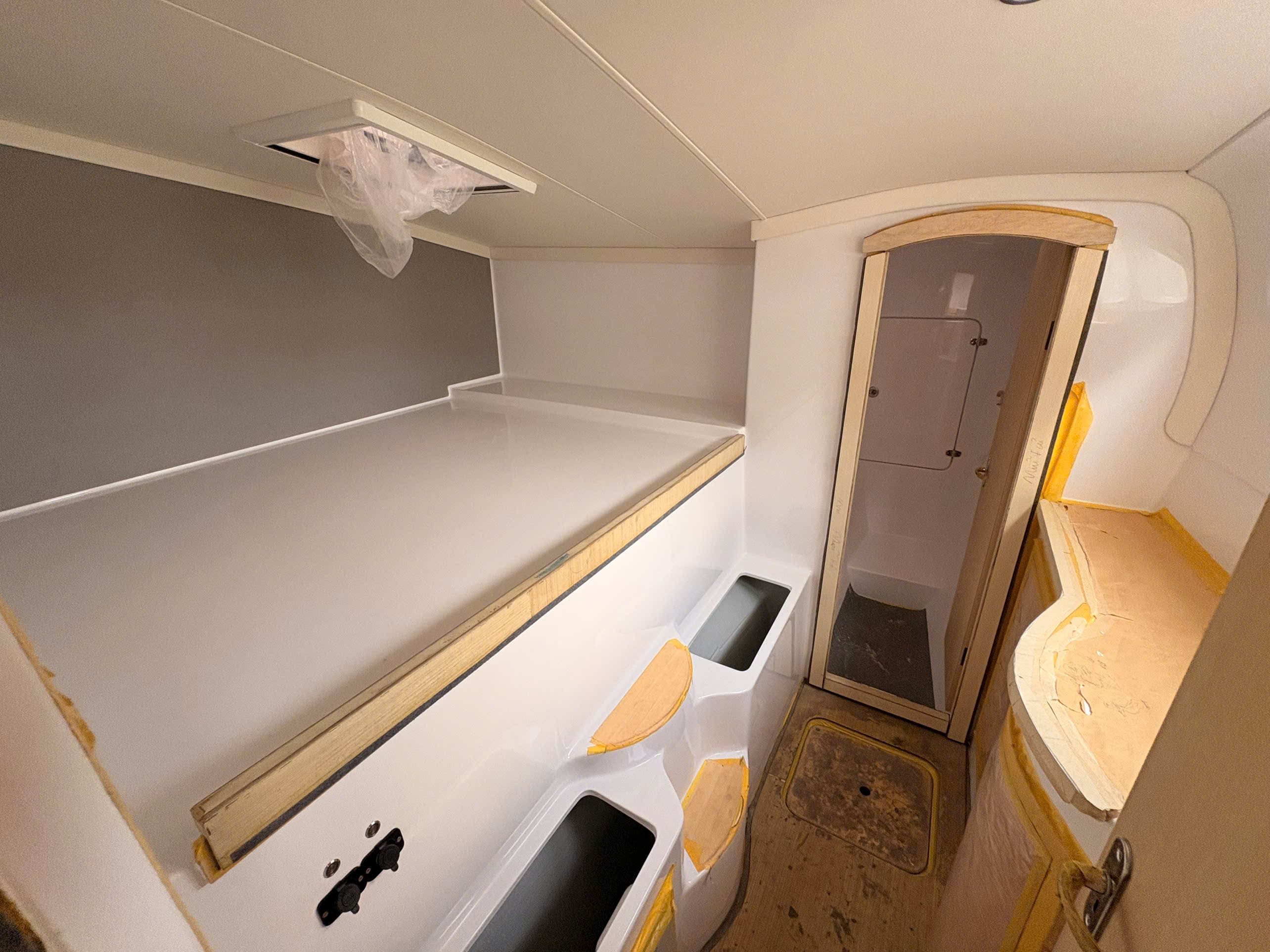

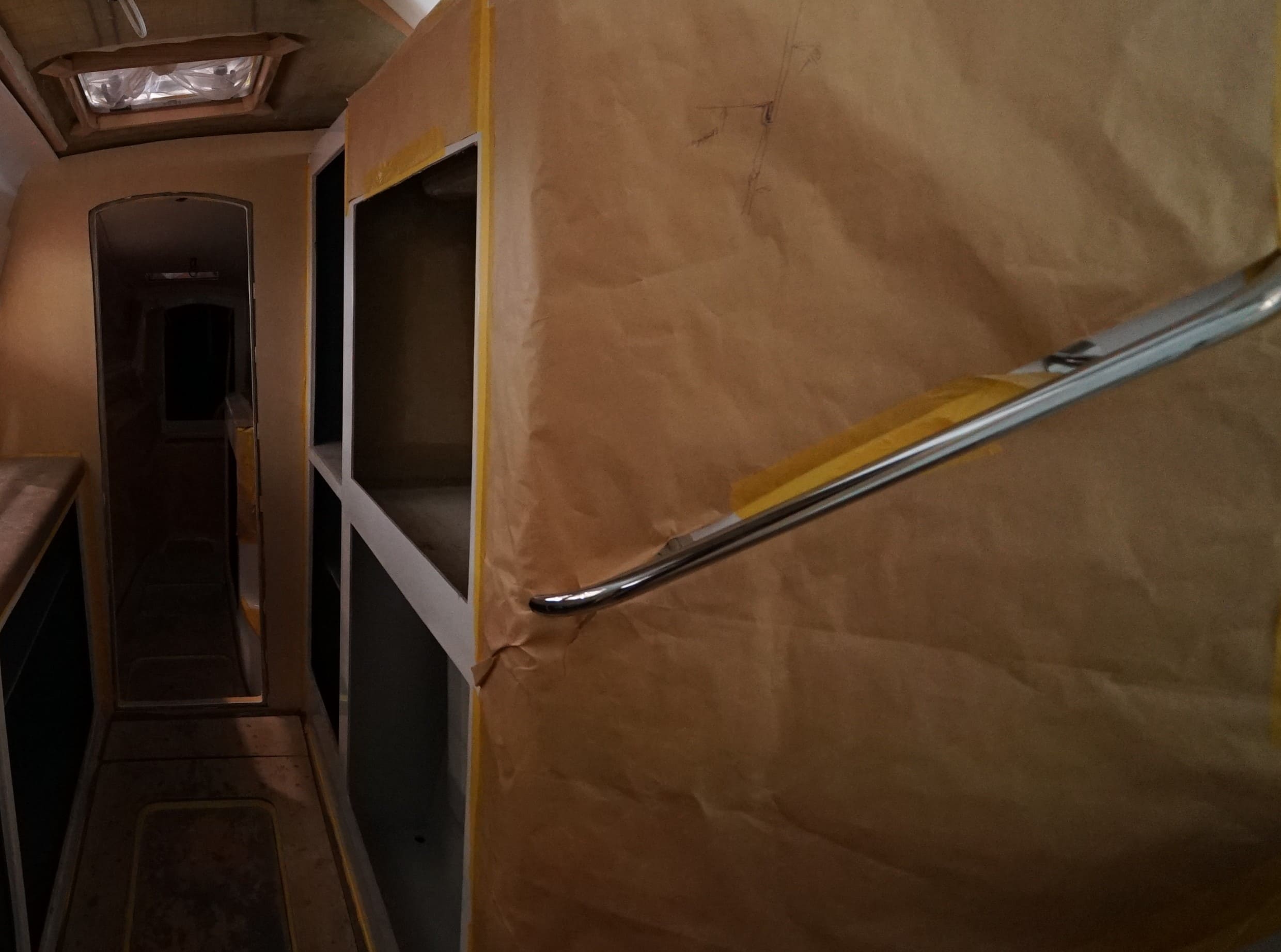

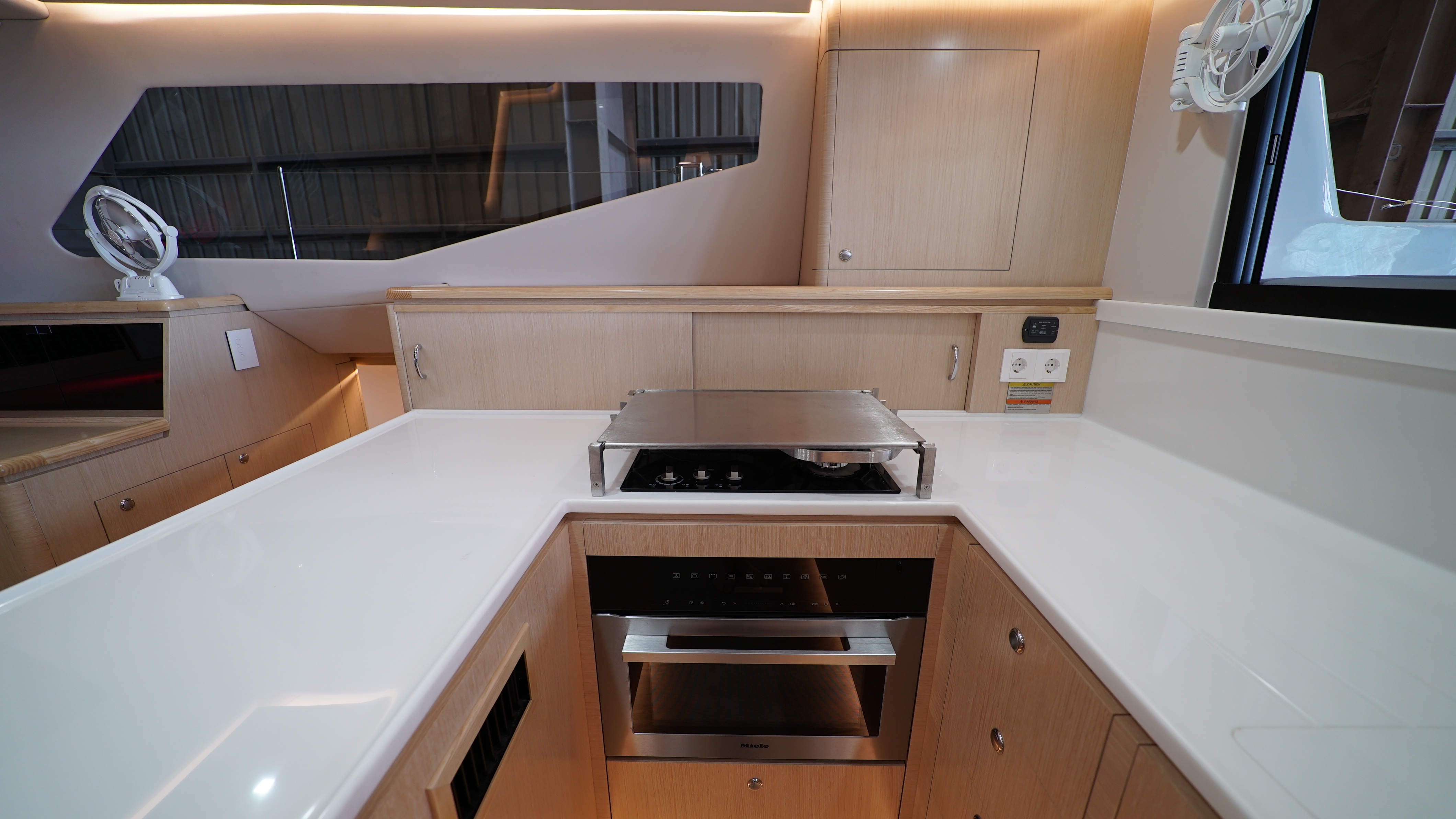

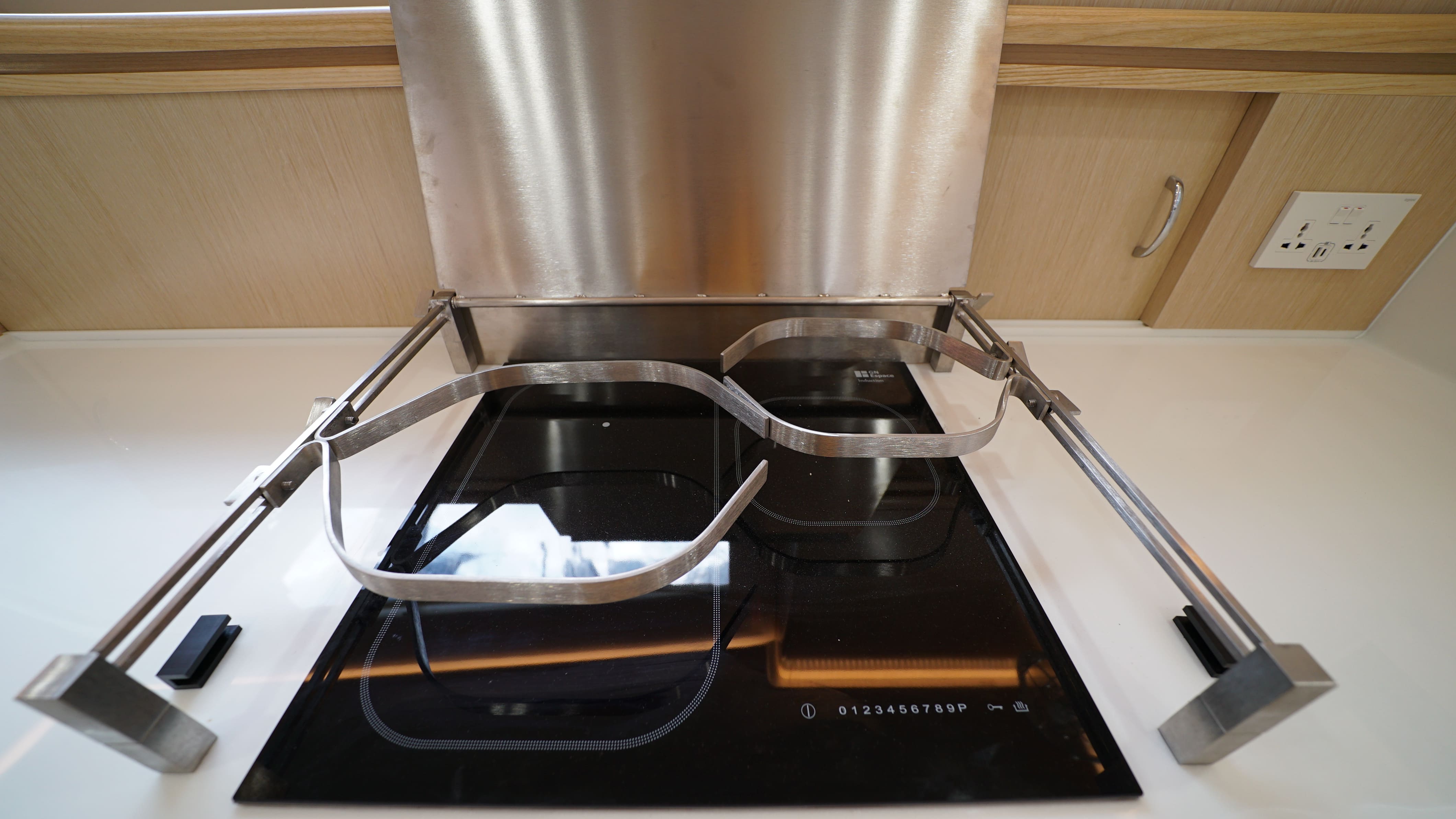

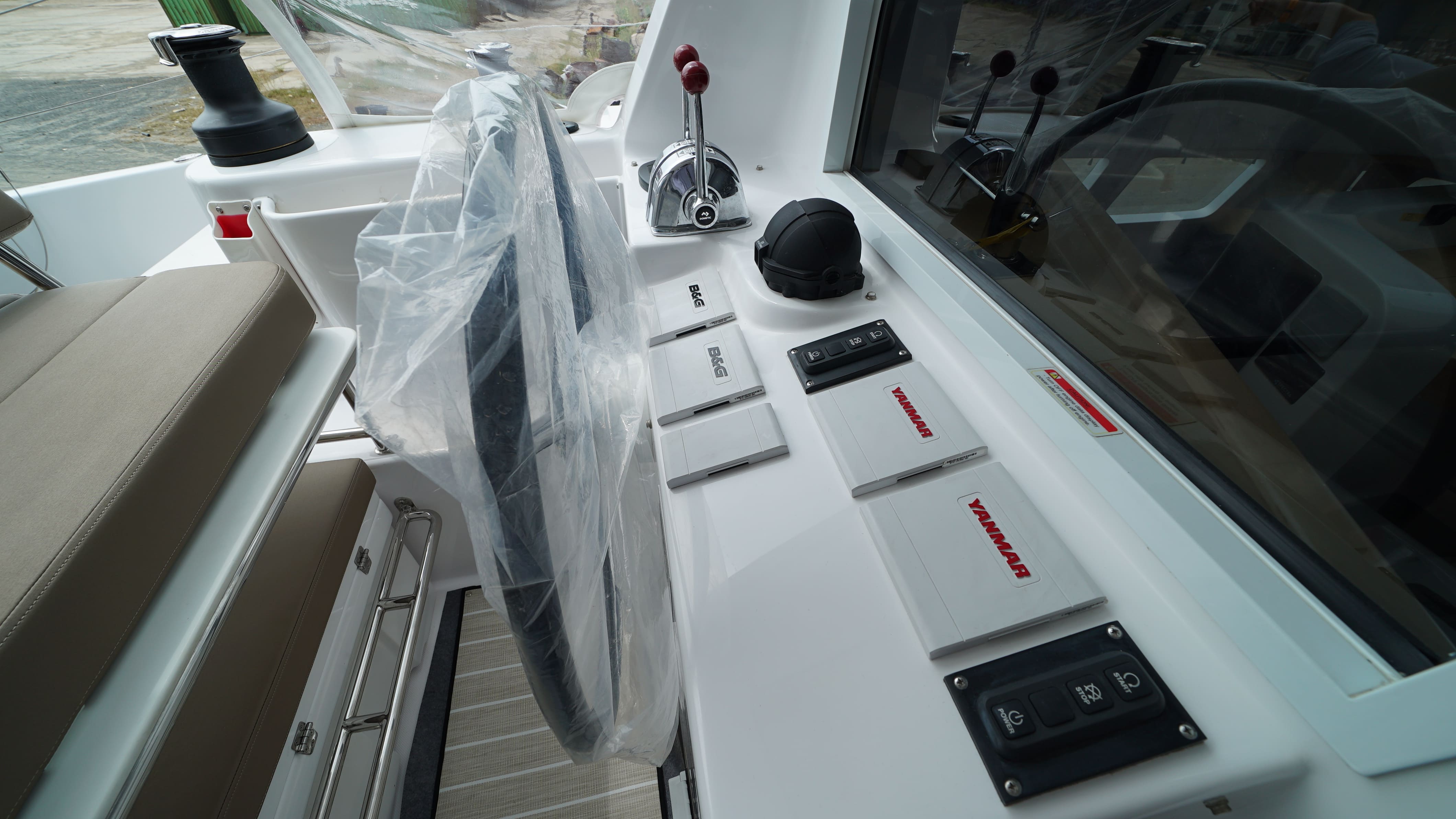

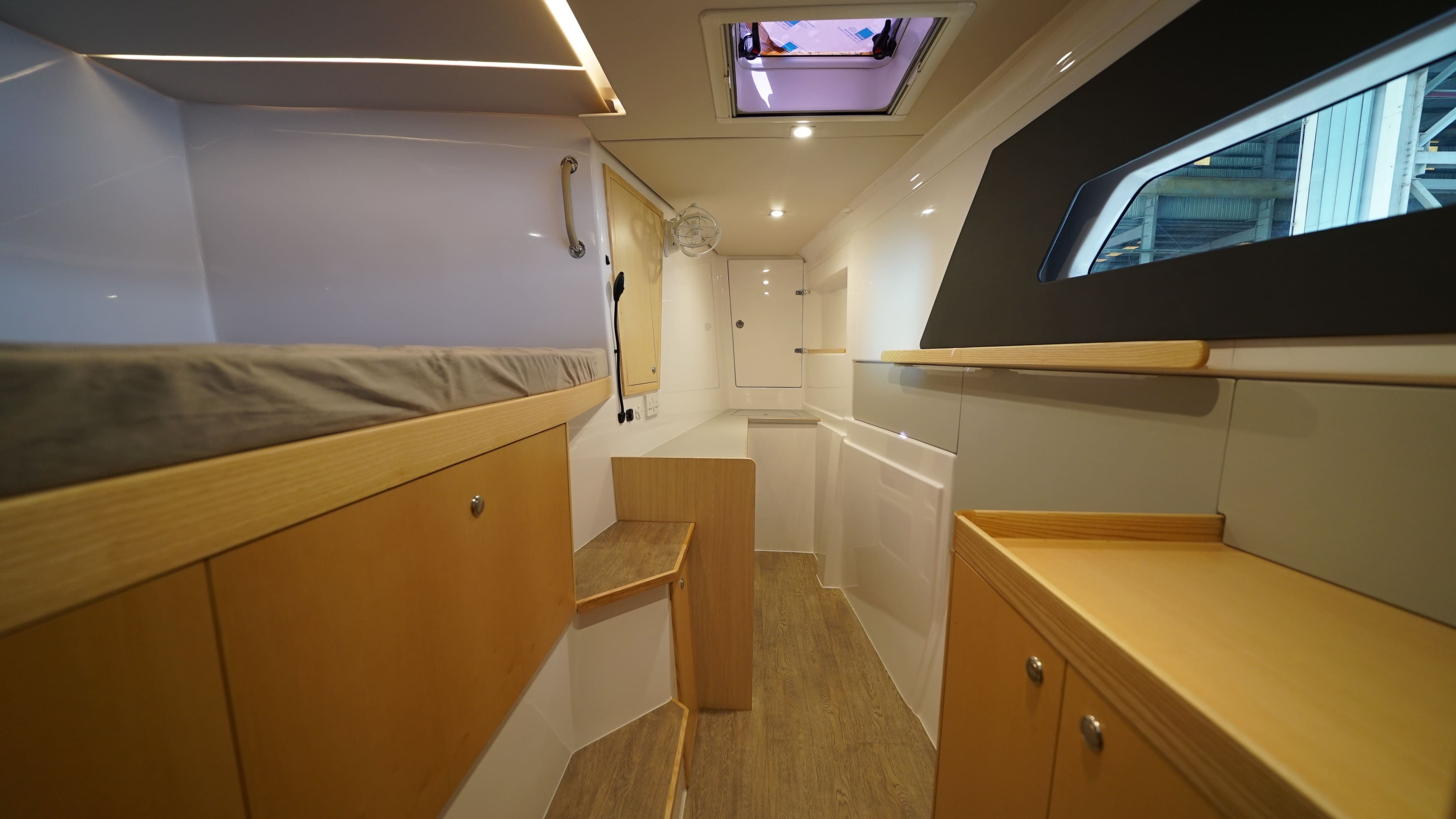

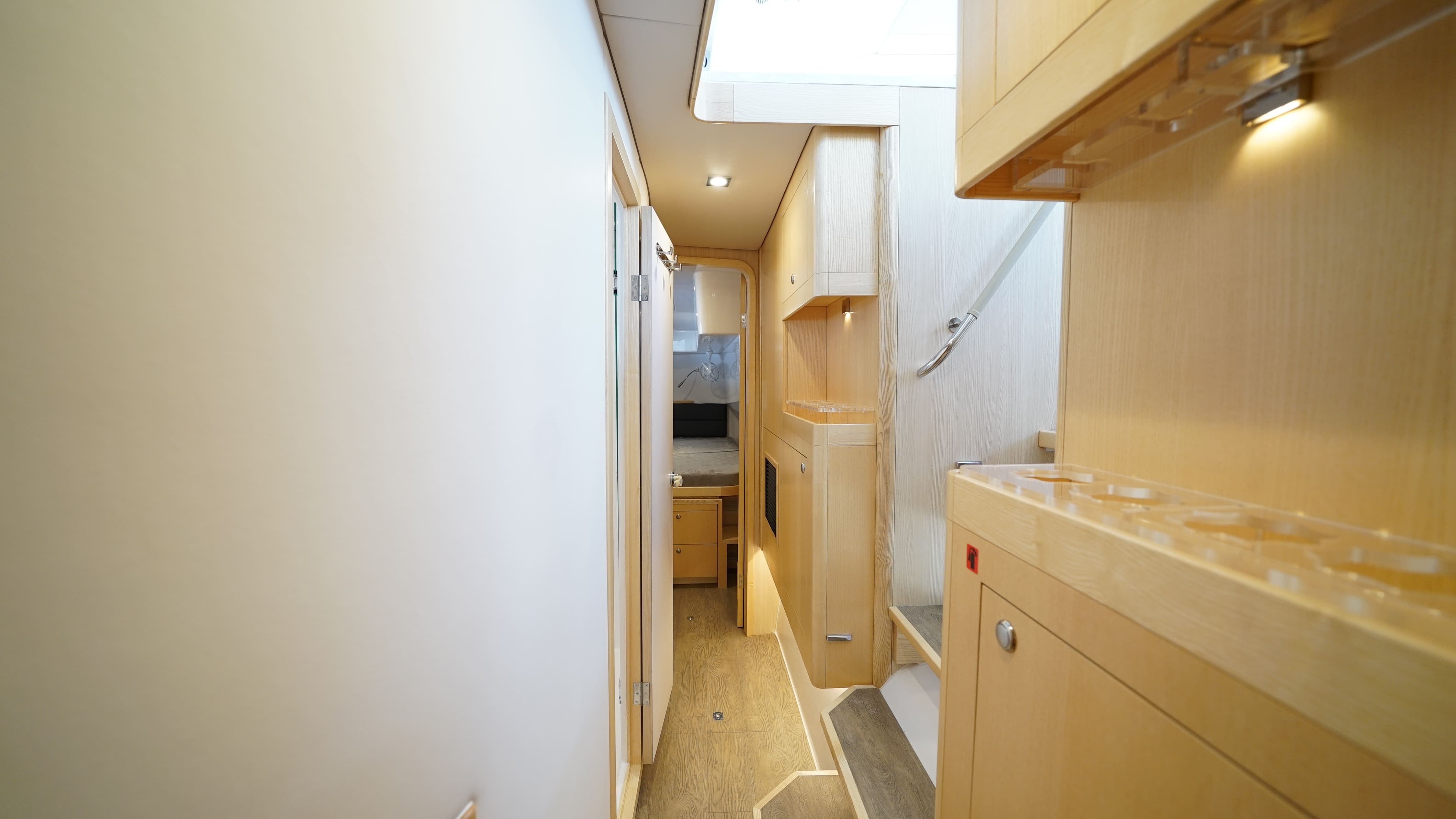

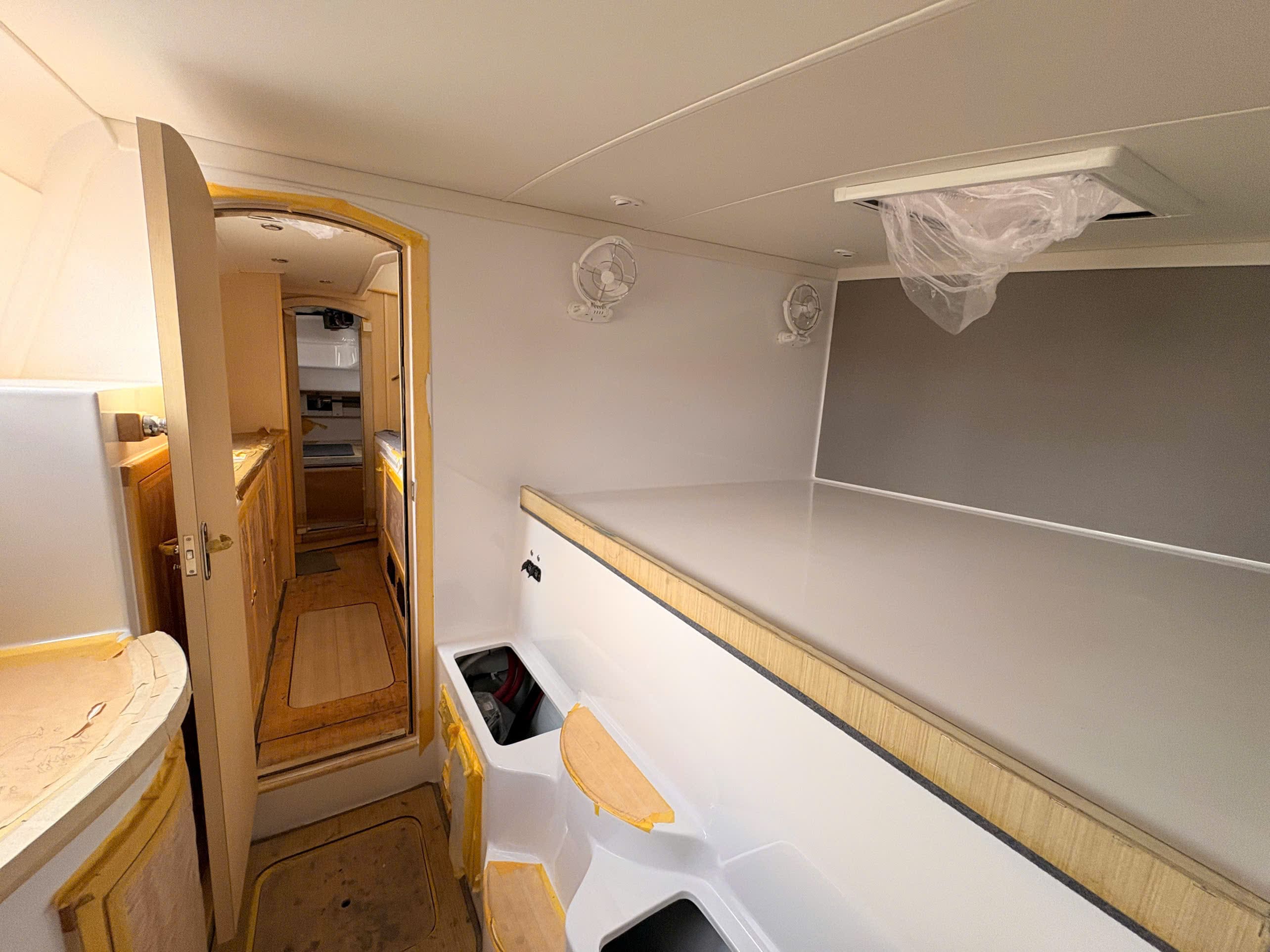

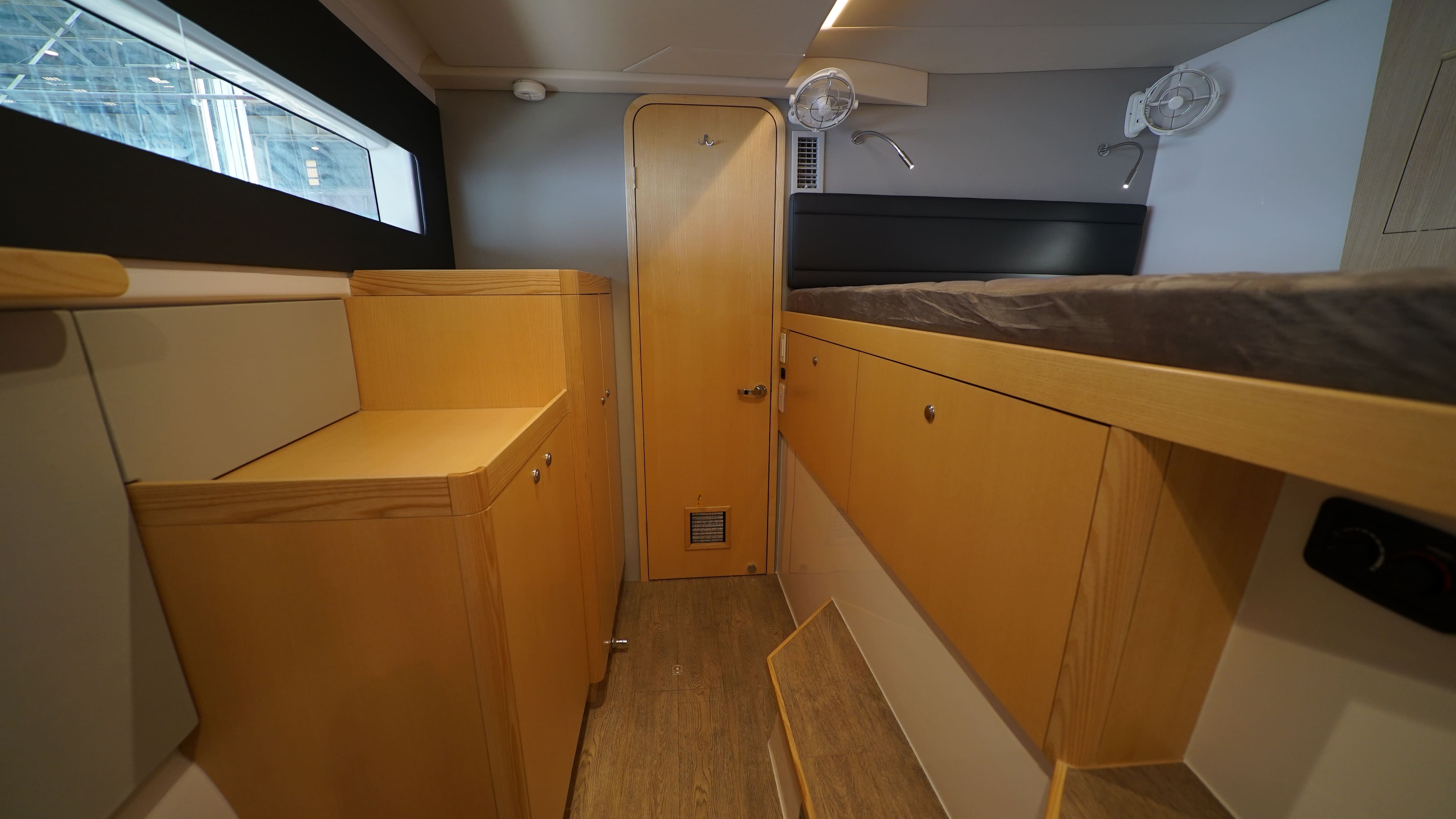

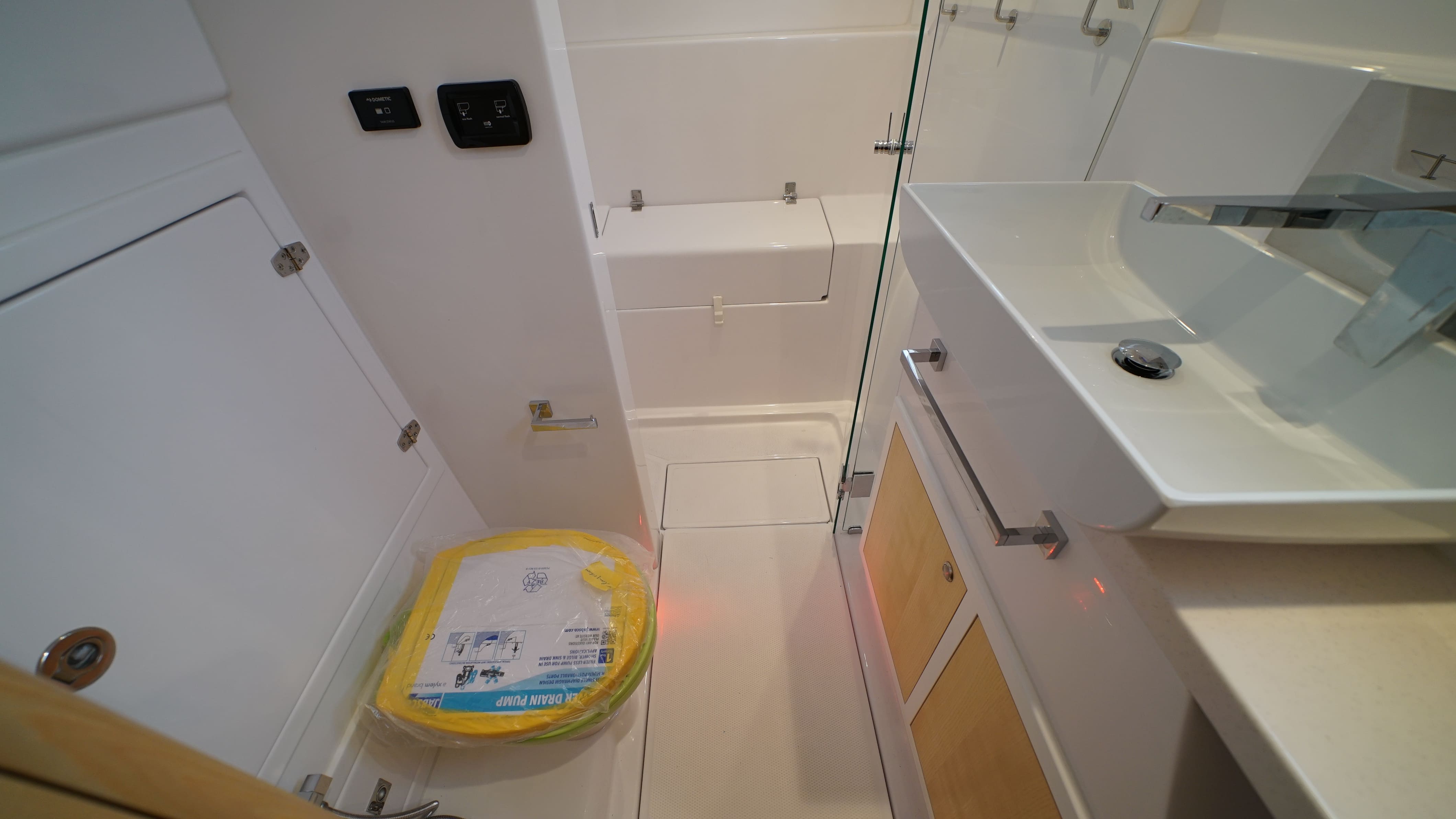

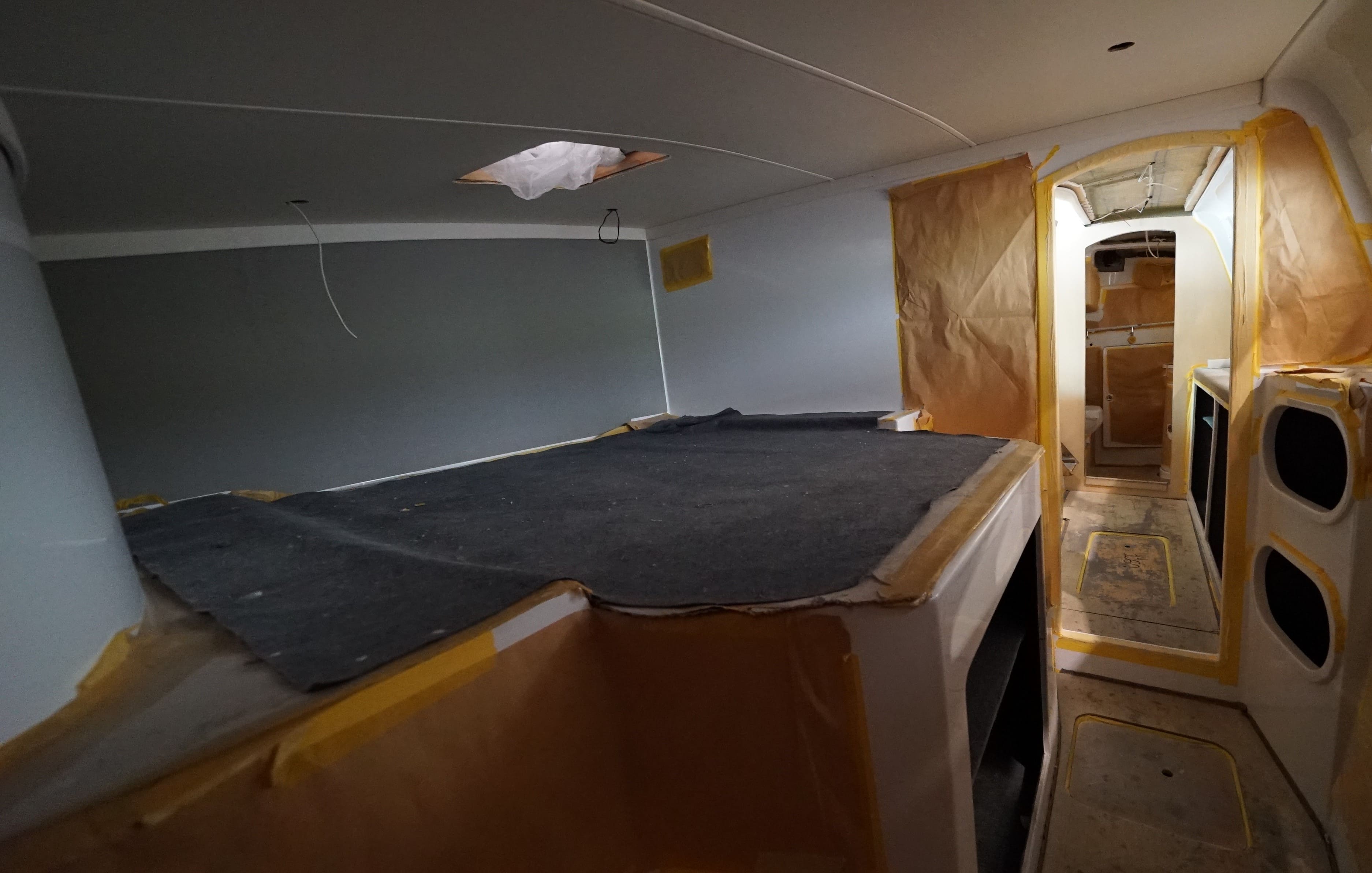

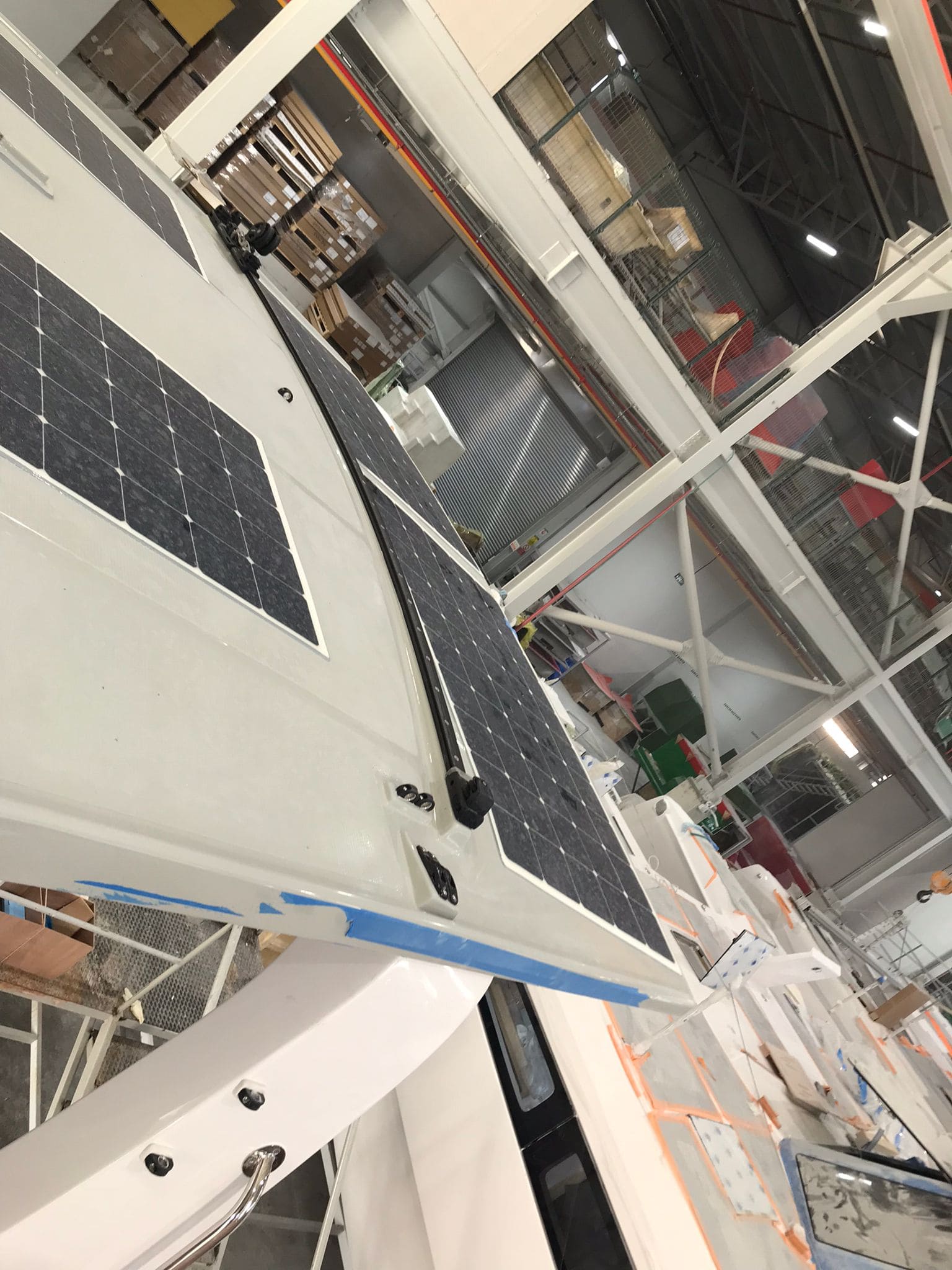

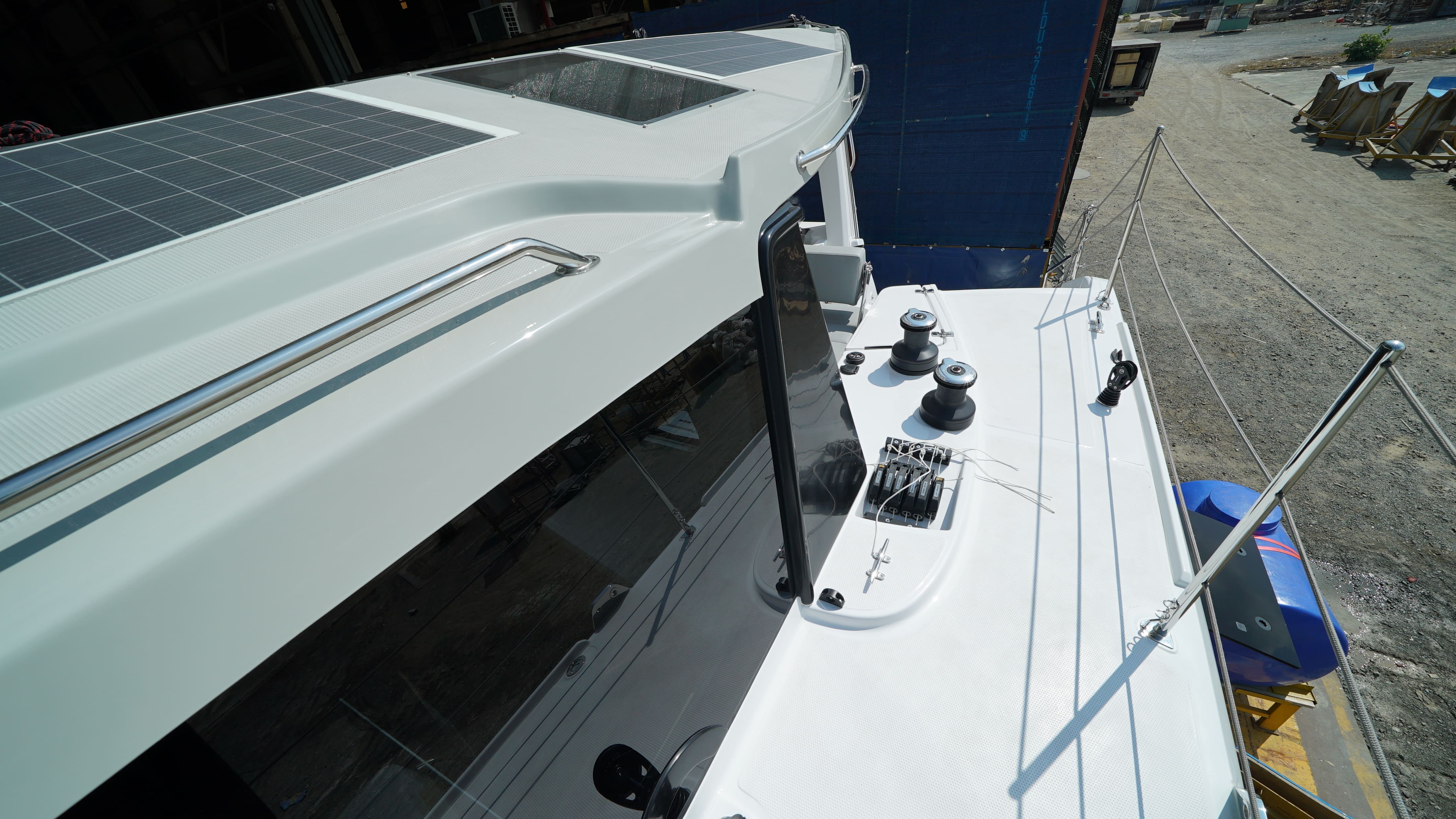

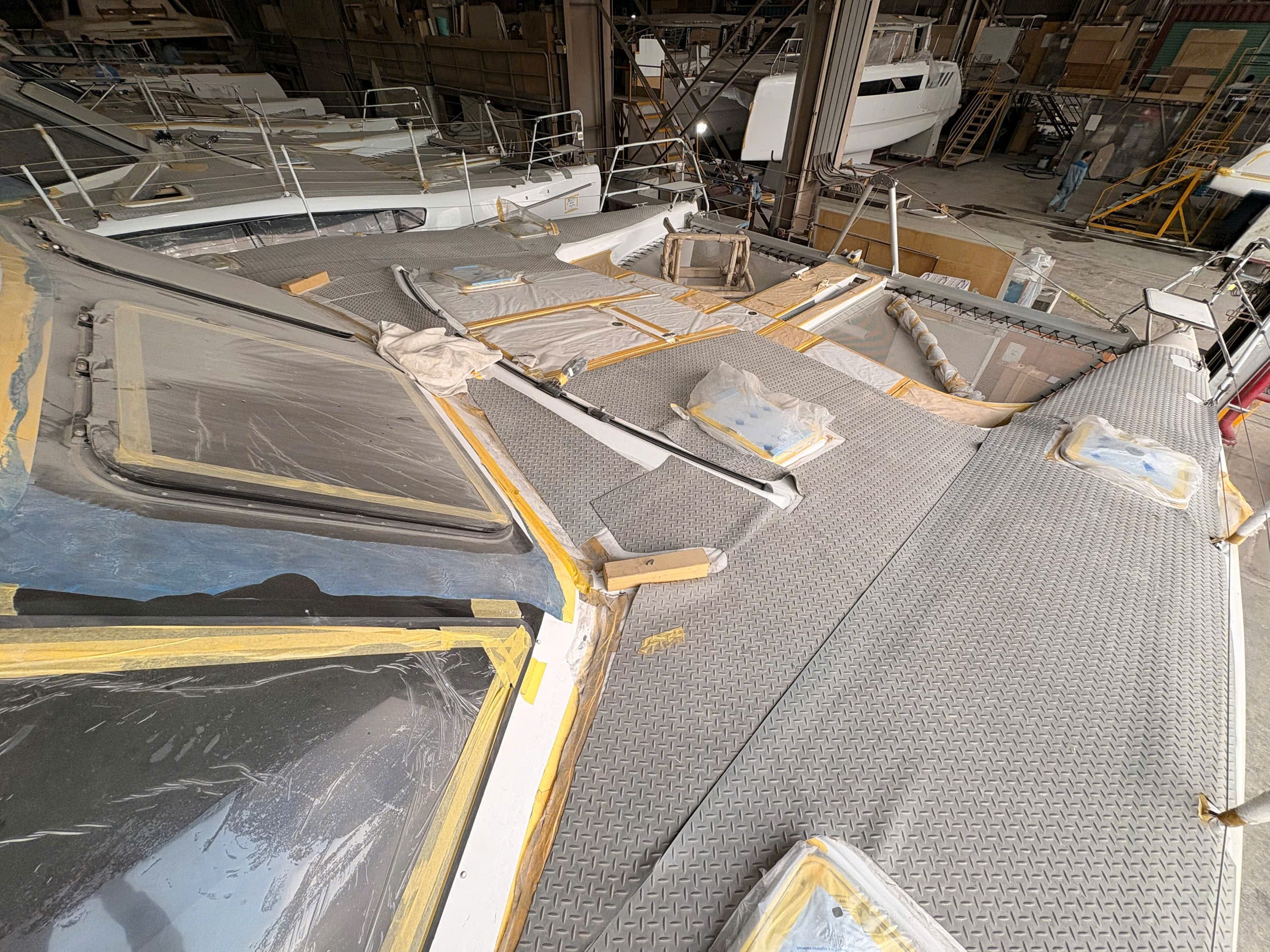

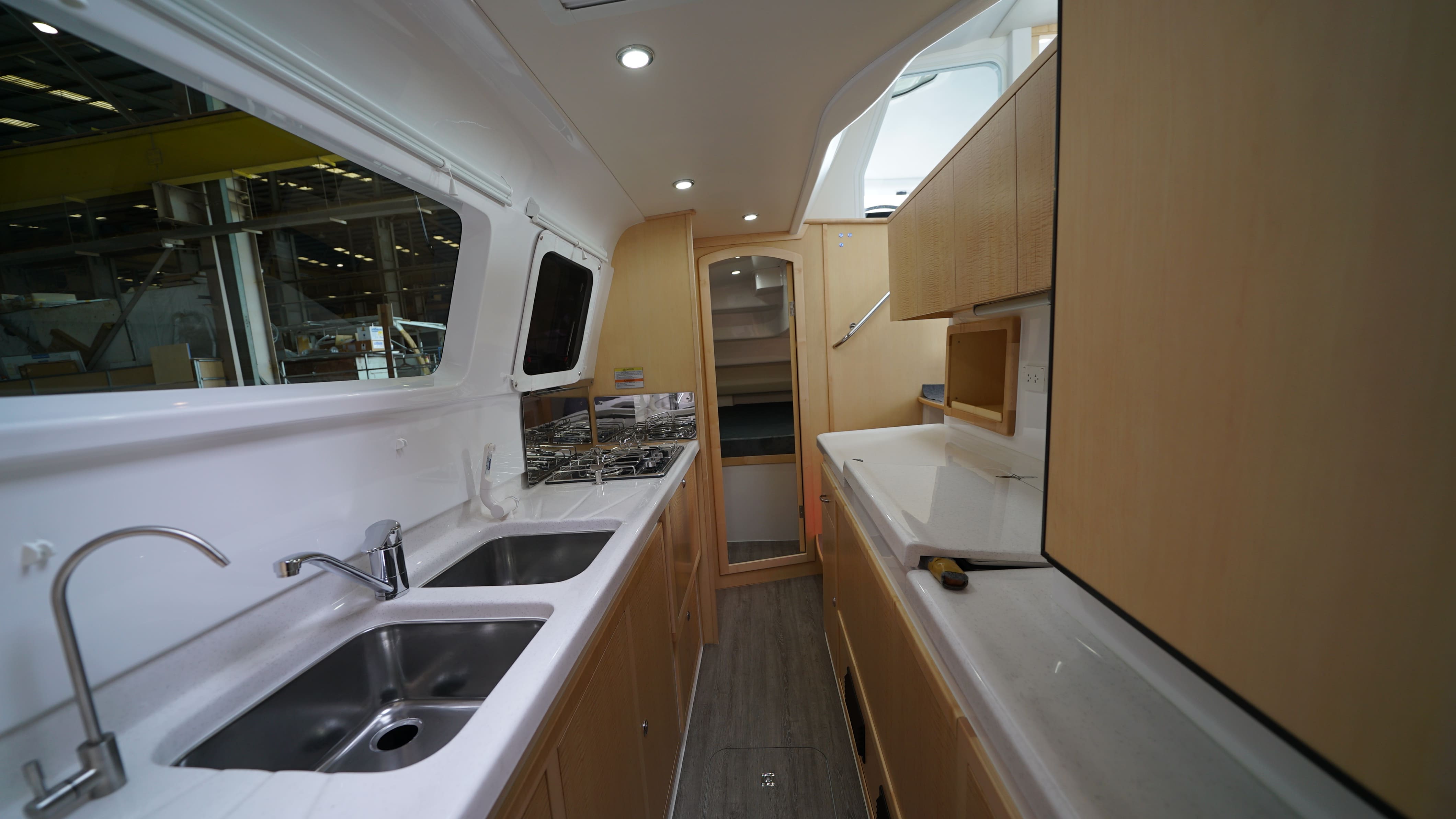

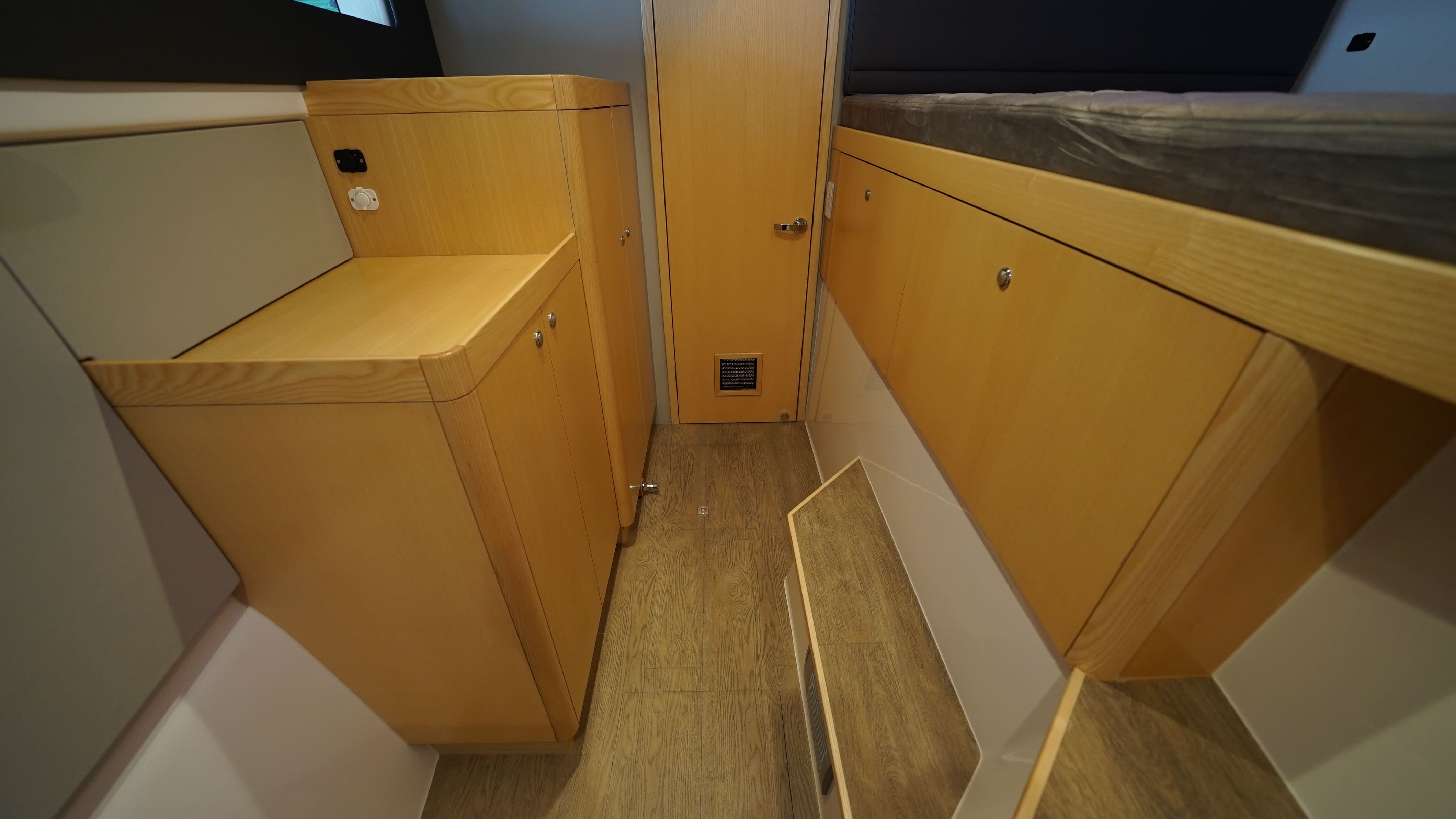

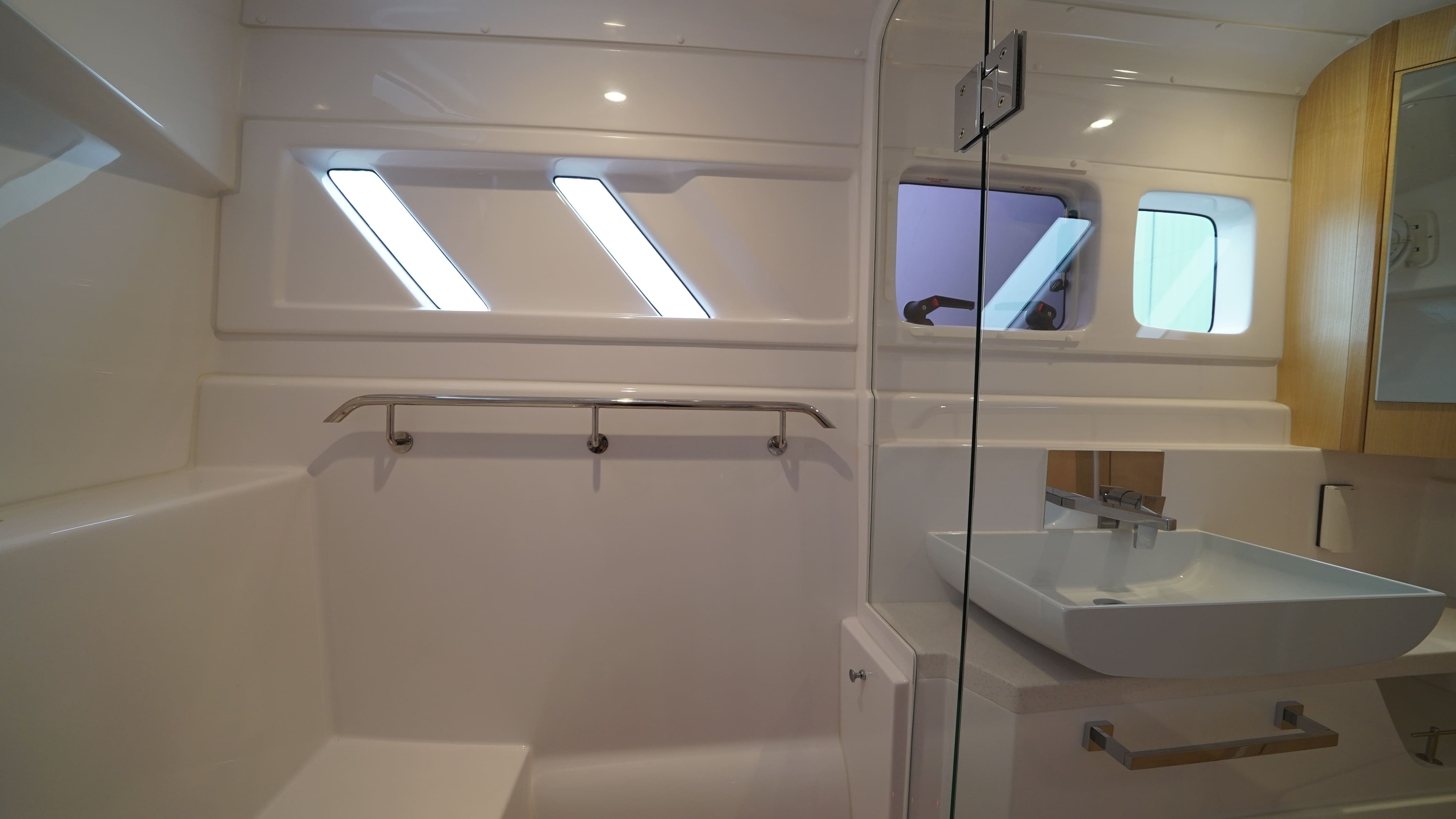

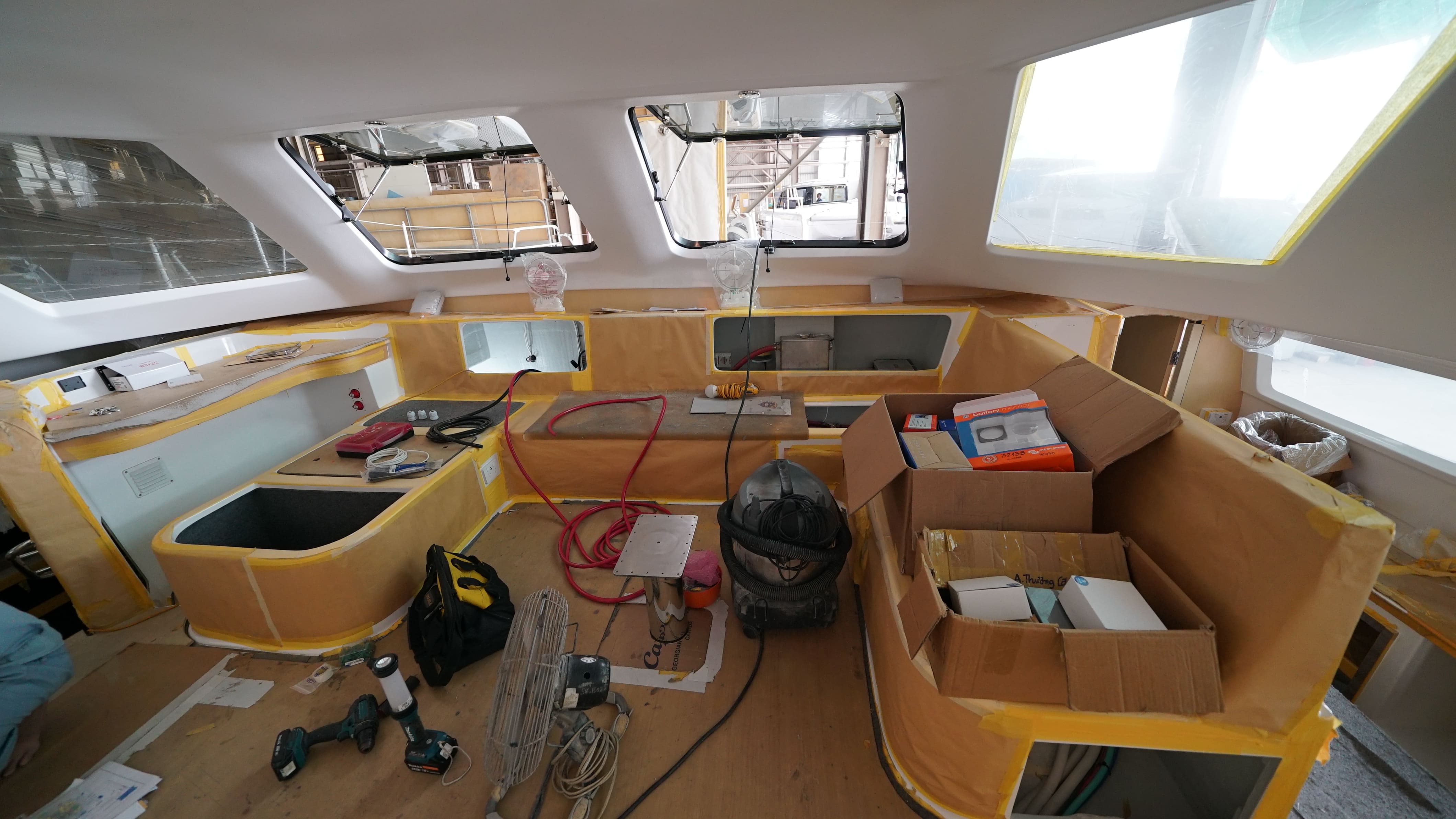

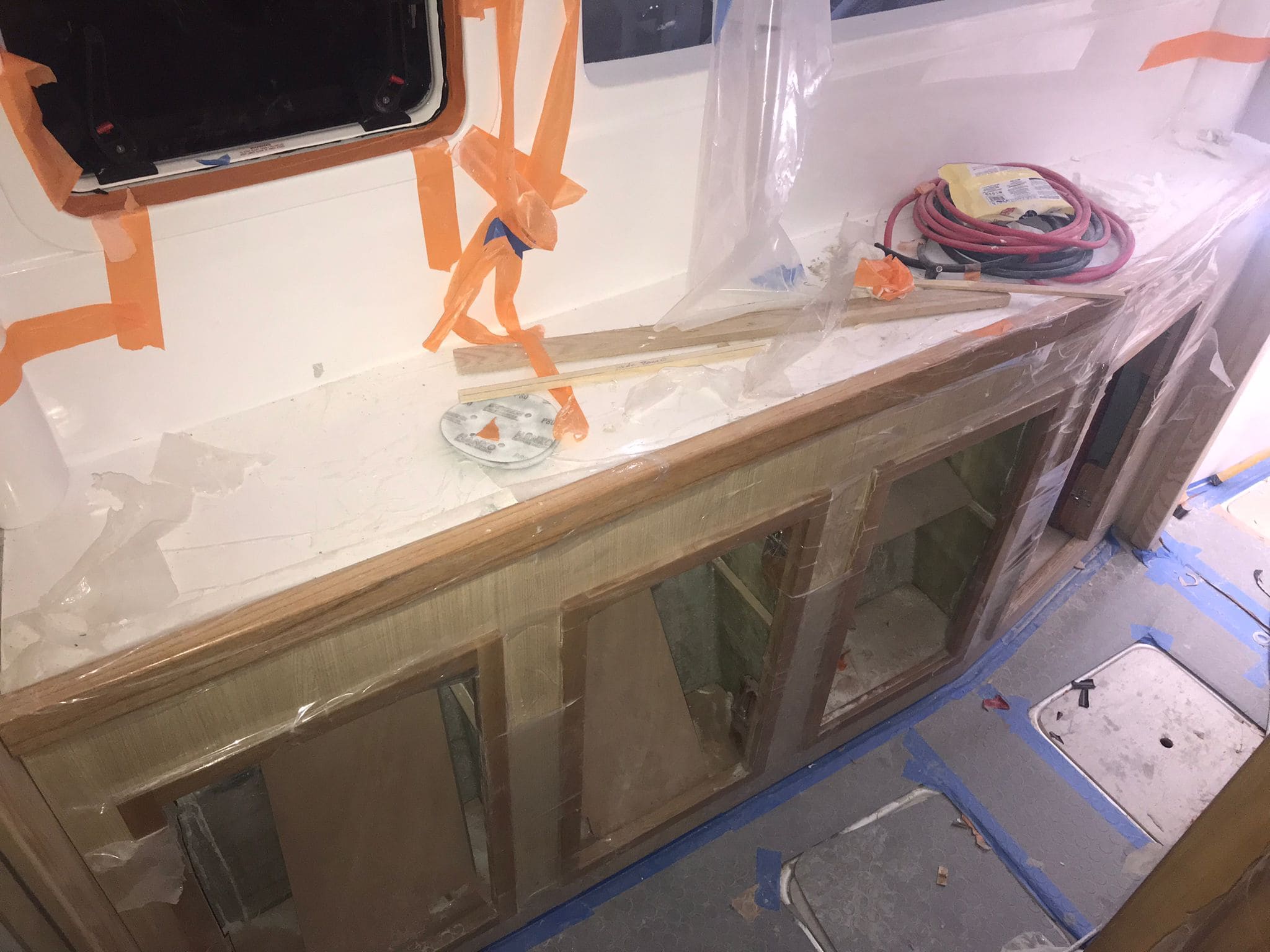

Our Production team is currently working on deck hardware (80%), plumbing (70%), steering (70%), electric (50%), and timber fitout (30%).

Production Update – Fit out

Your boat is progressing well in the Fit out stage.

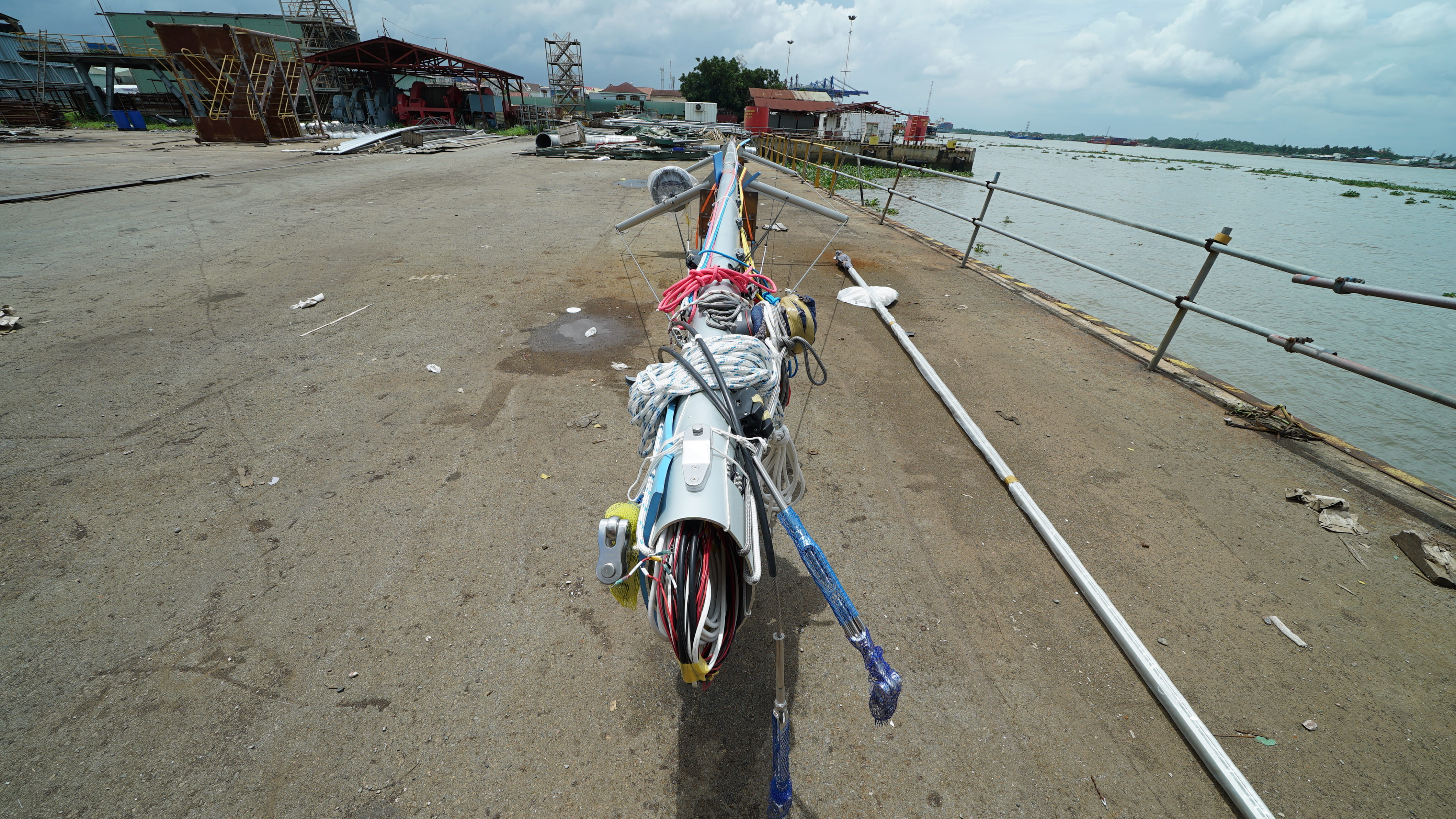

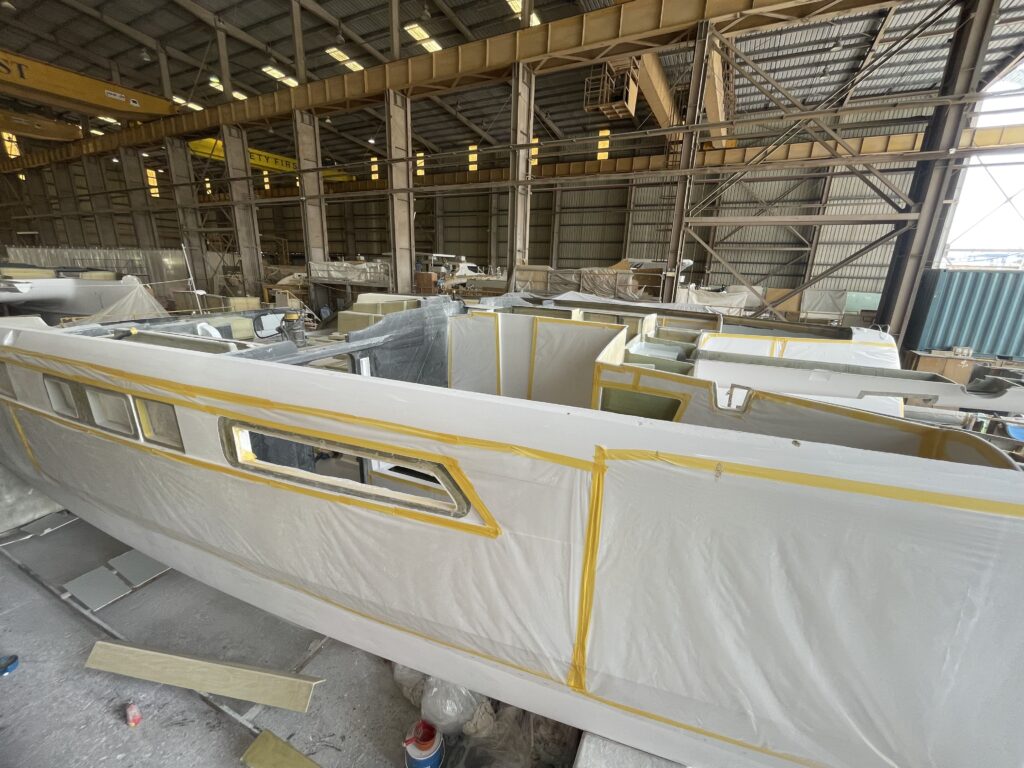

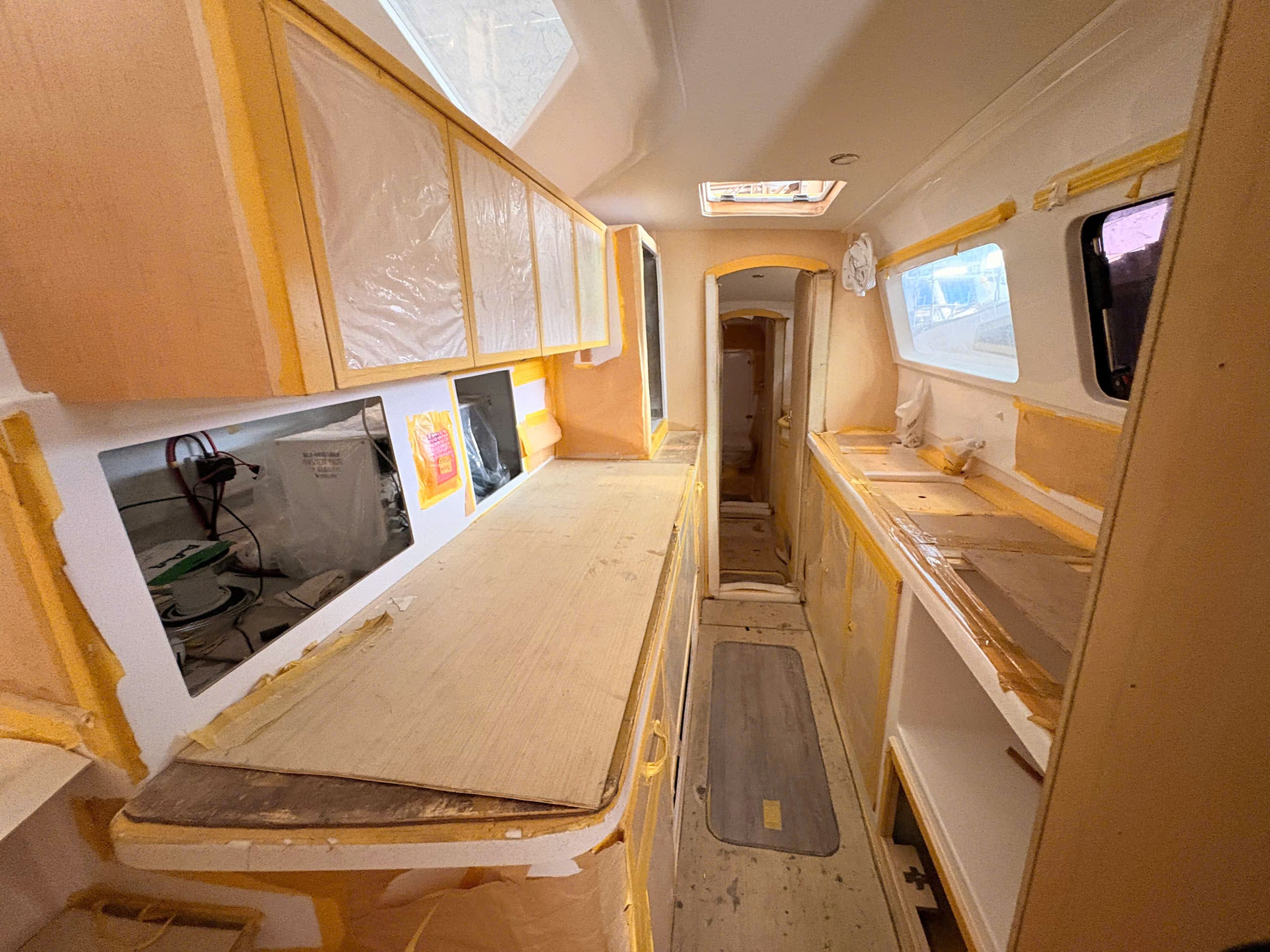

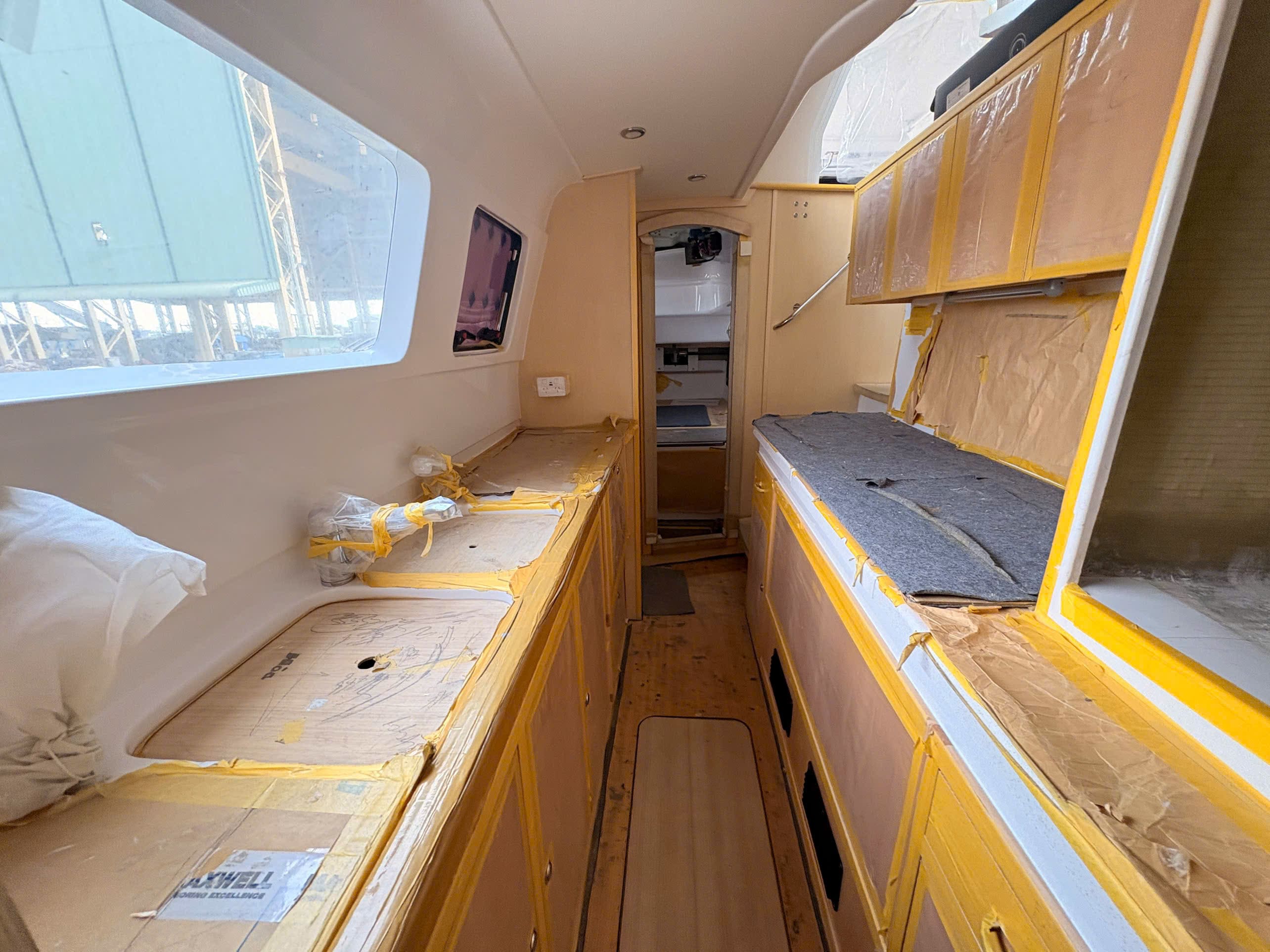

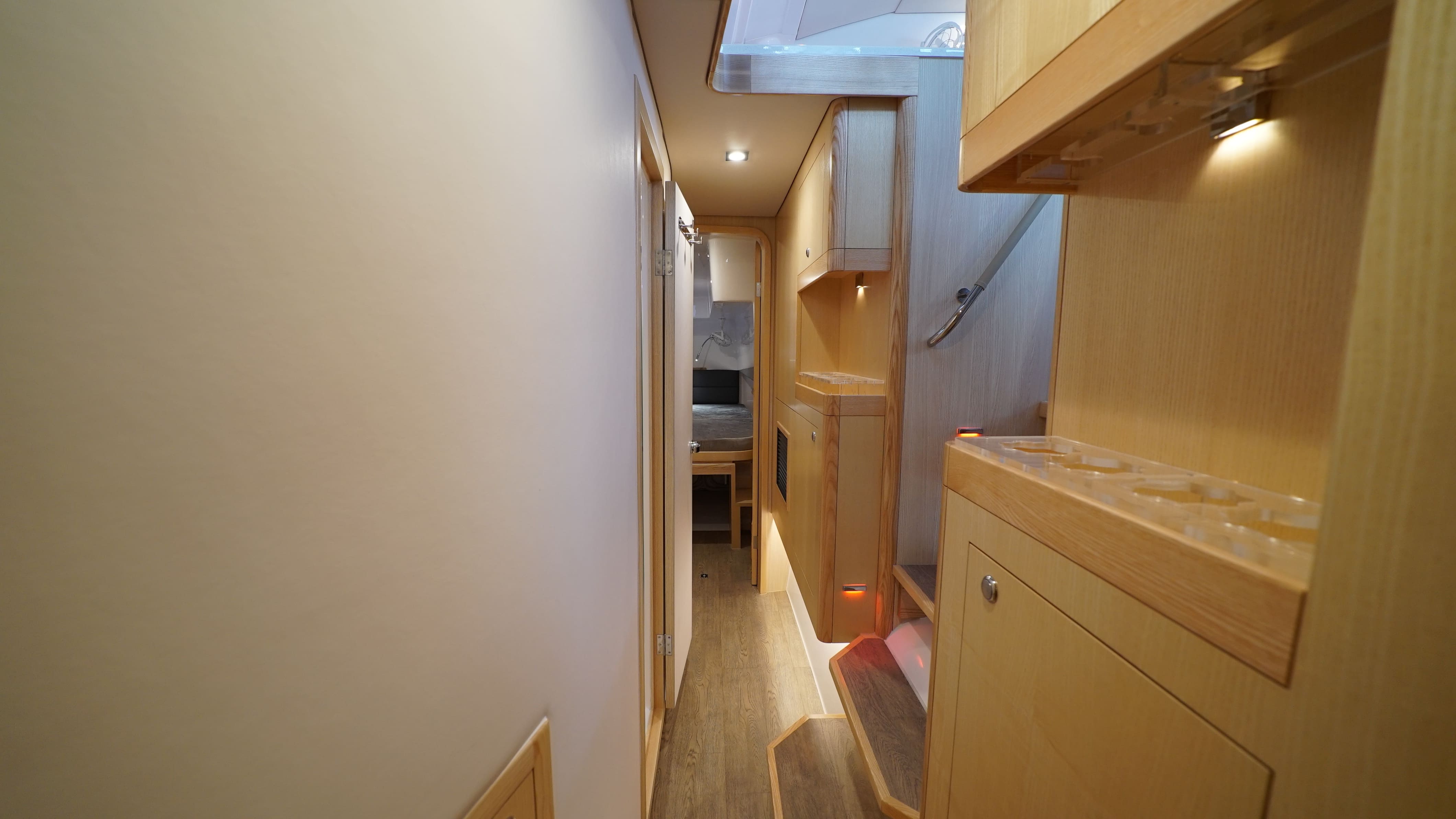

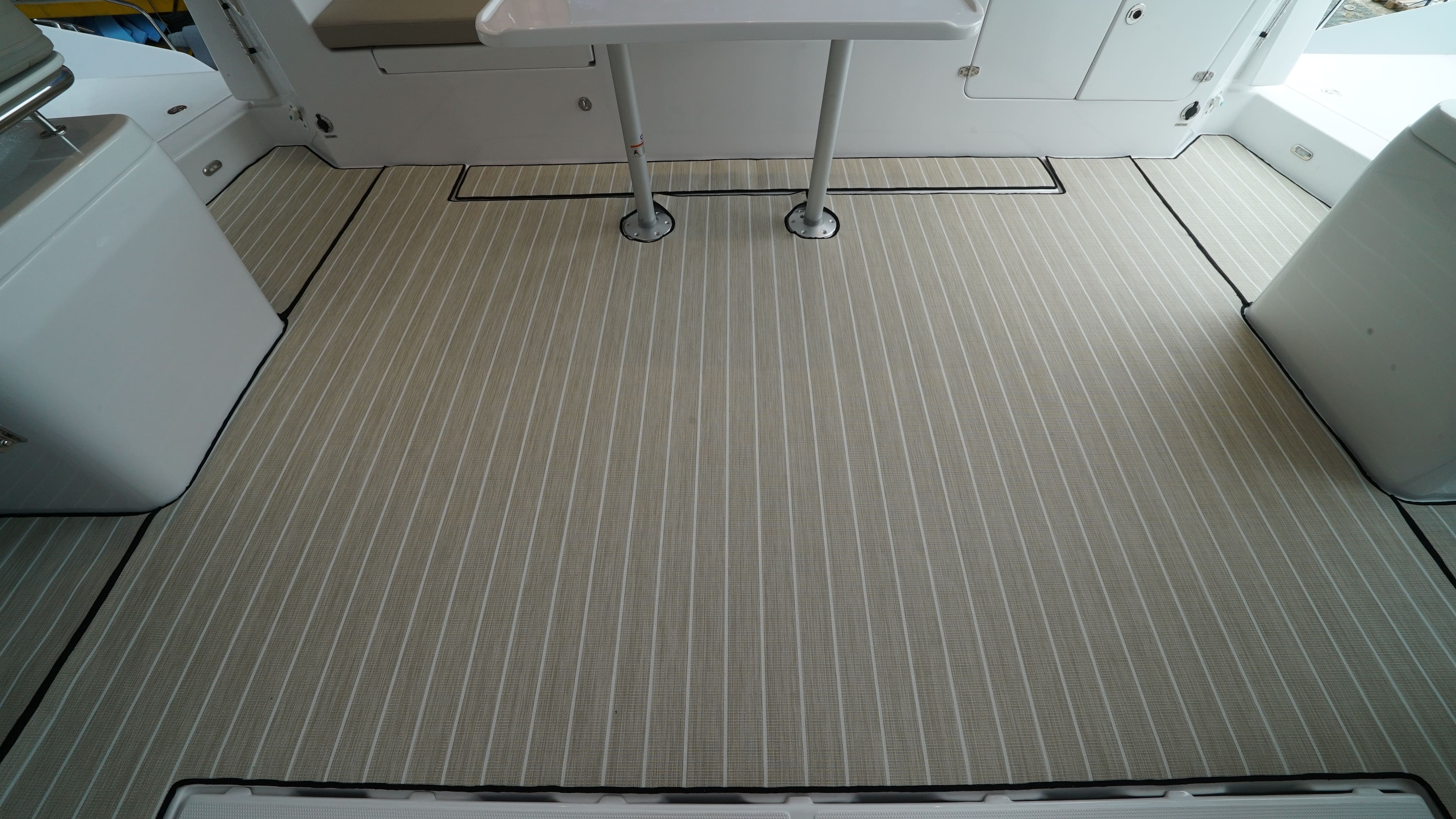

We finished the installation of stanchions, forward beam, A-frame, A-frame wire, all windows, and the deck hatches. Our Production team is currently working on deck hardware (80%), plumbing (80%), steering (70%), timber fitout (70%) and electrical items (70%).

Production Update – Fit out

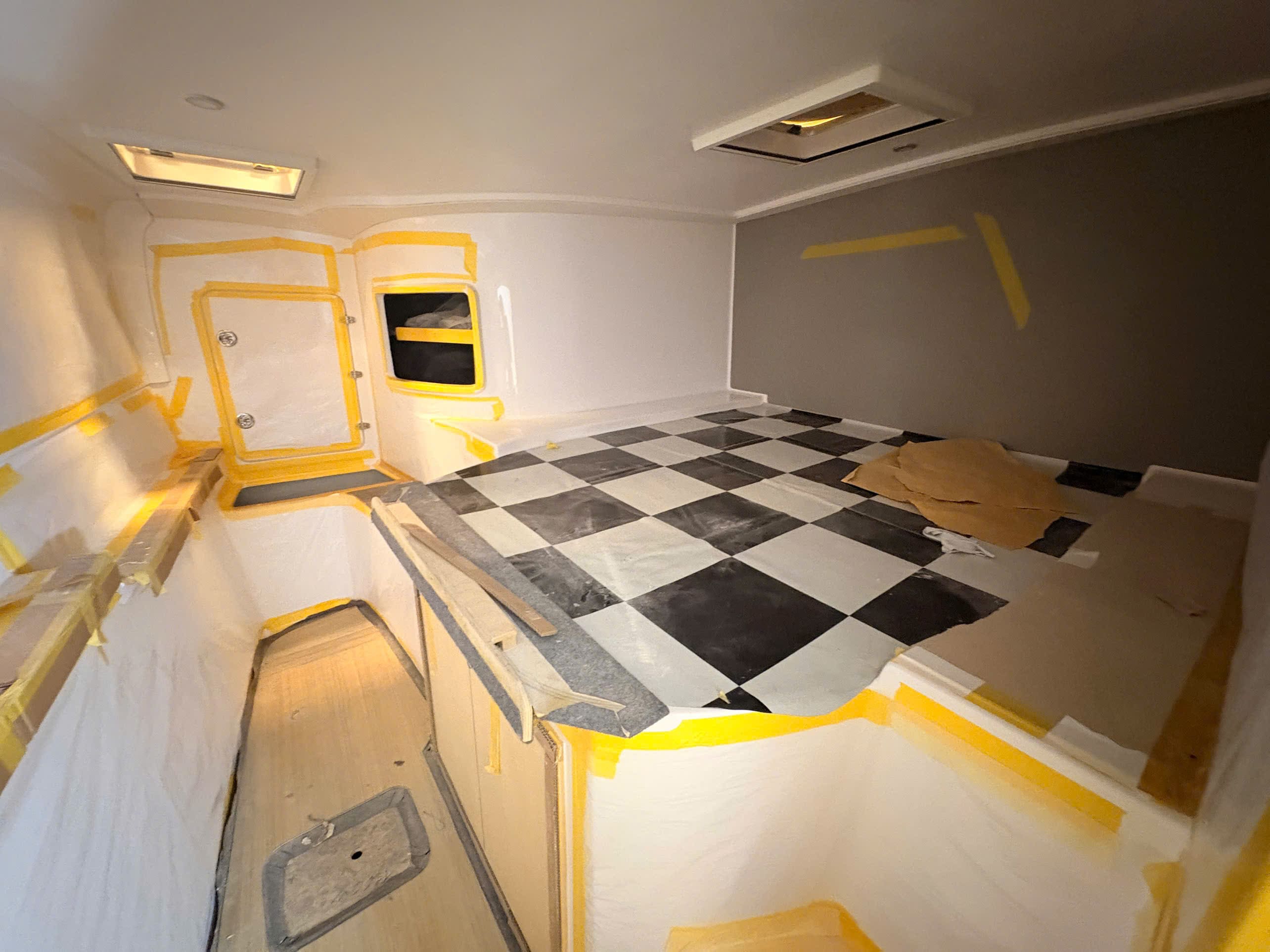

Your boat is progressing well in the last phase of Fit out stage.

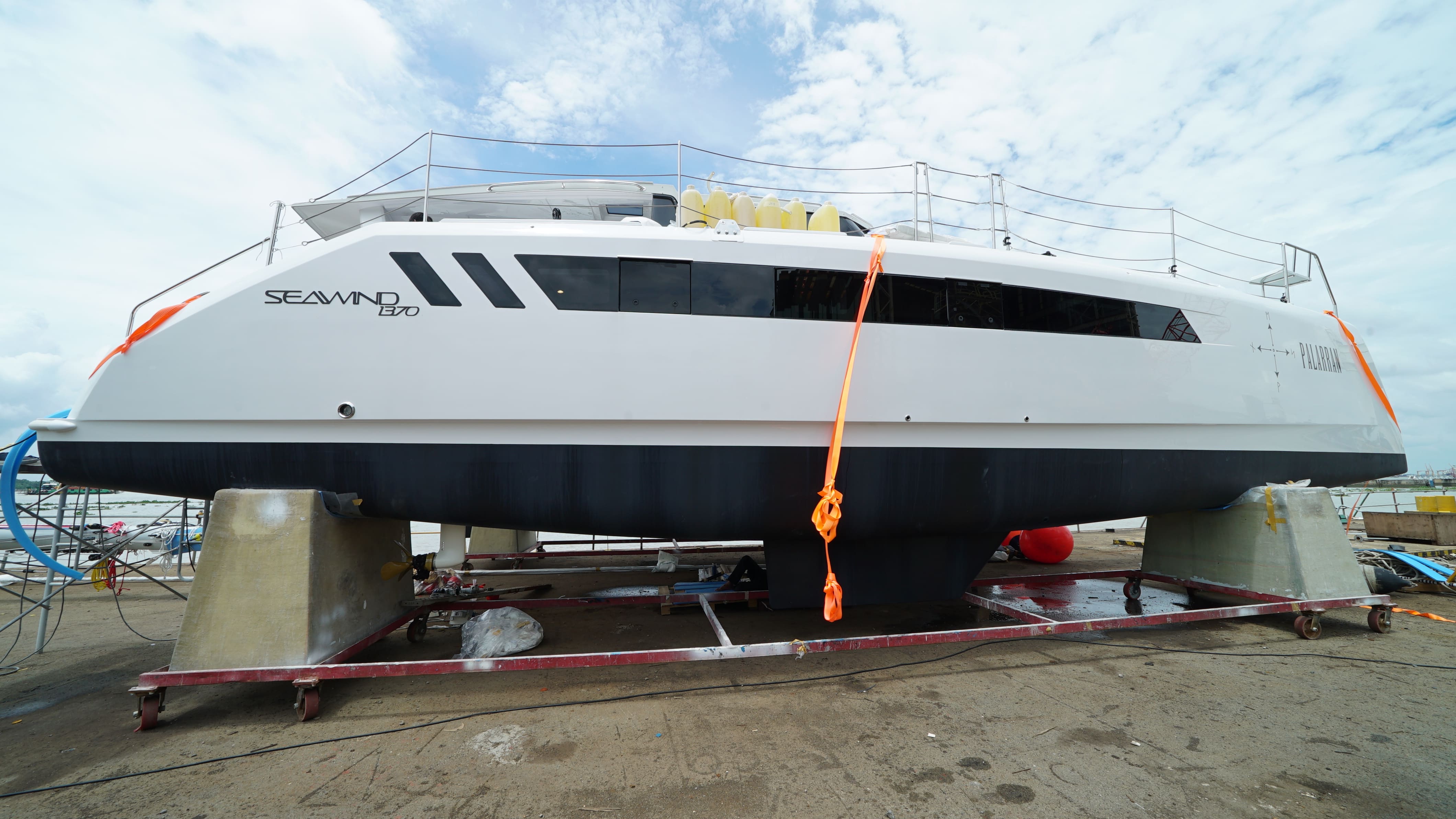

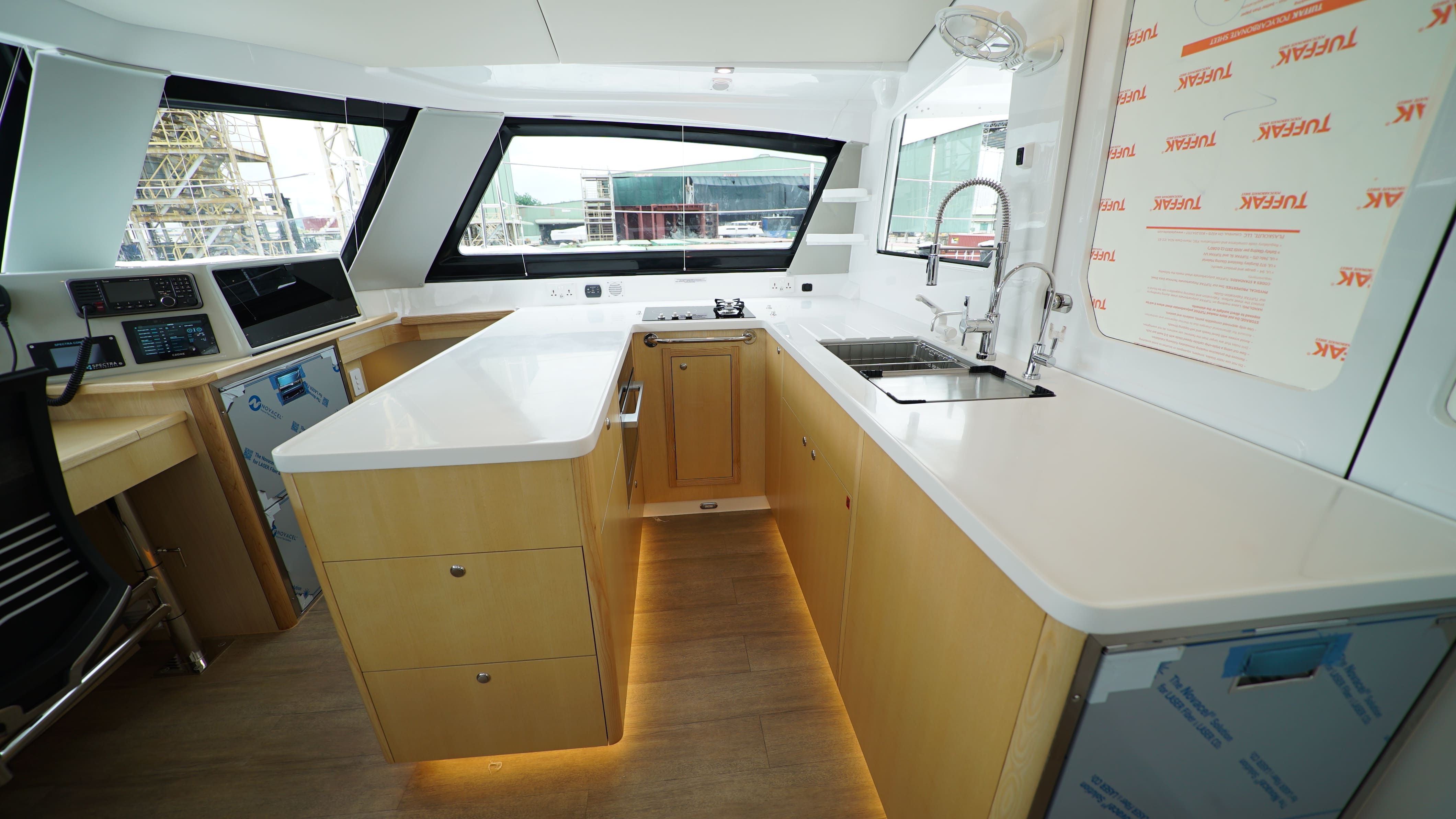

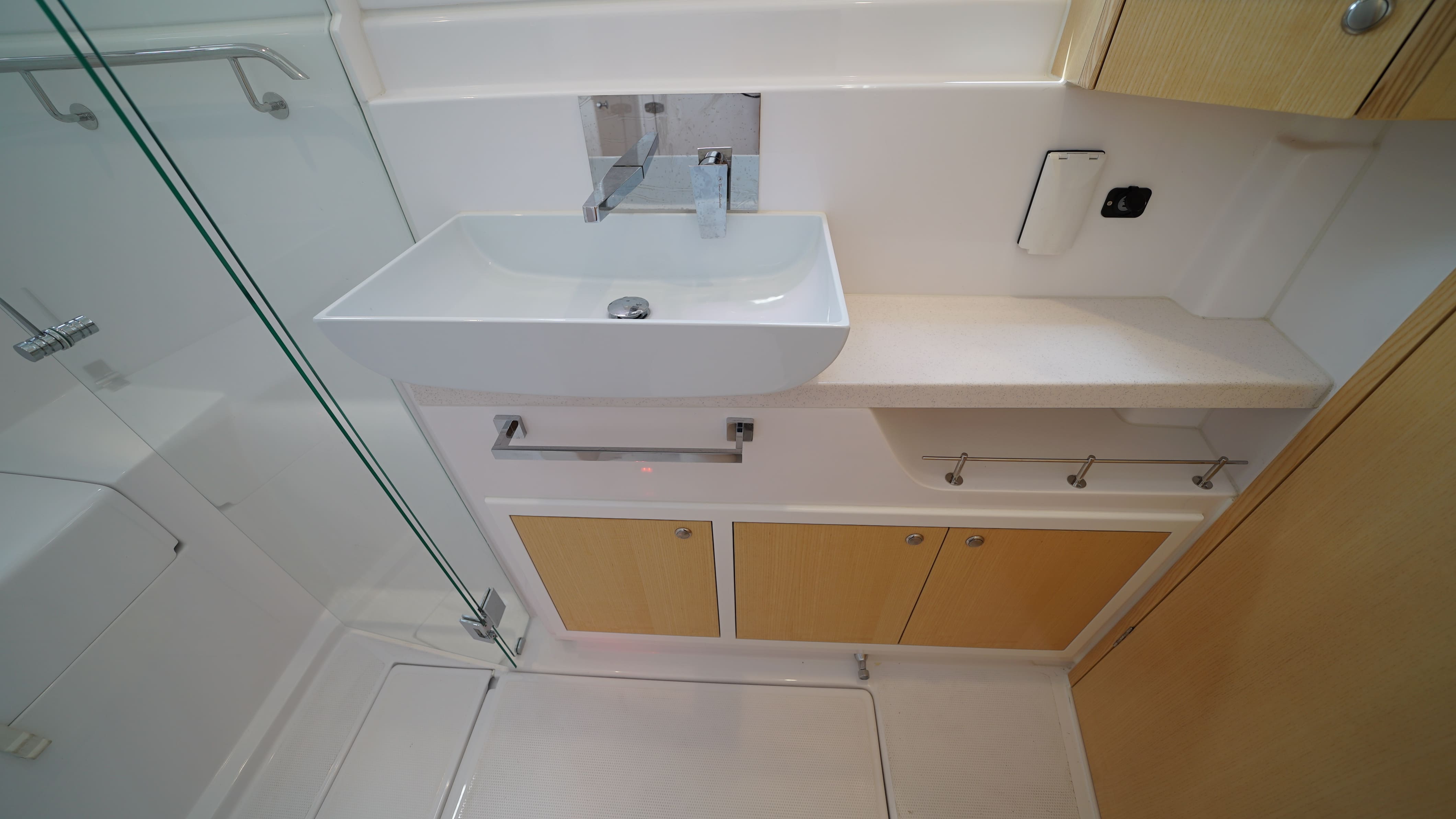

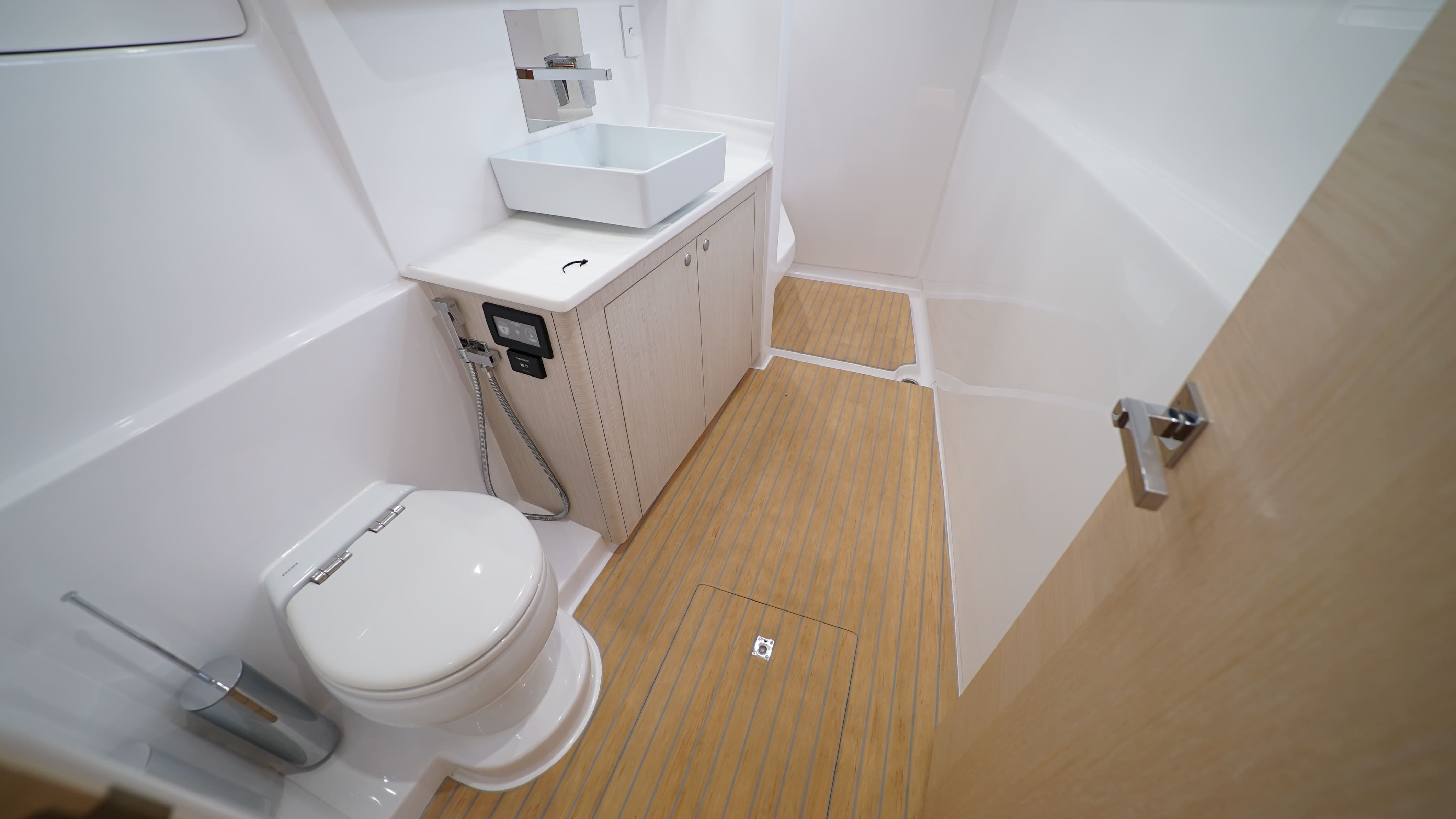

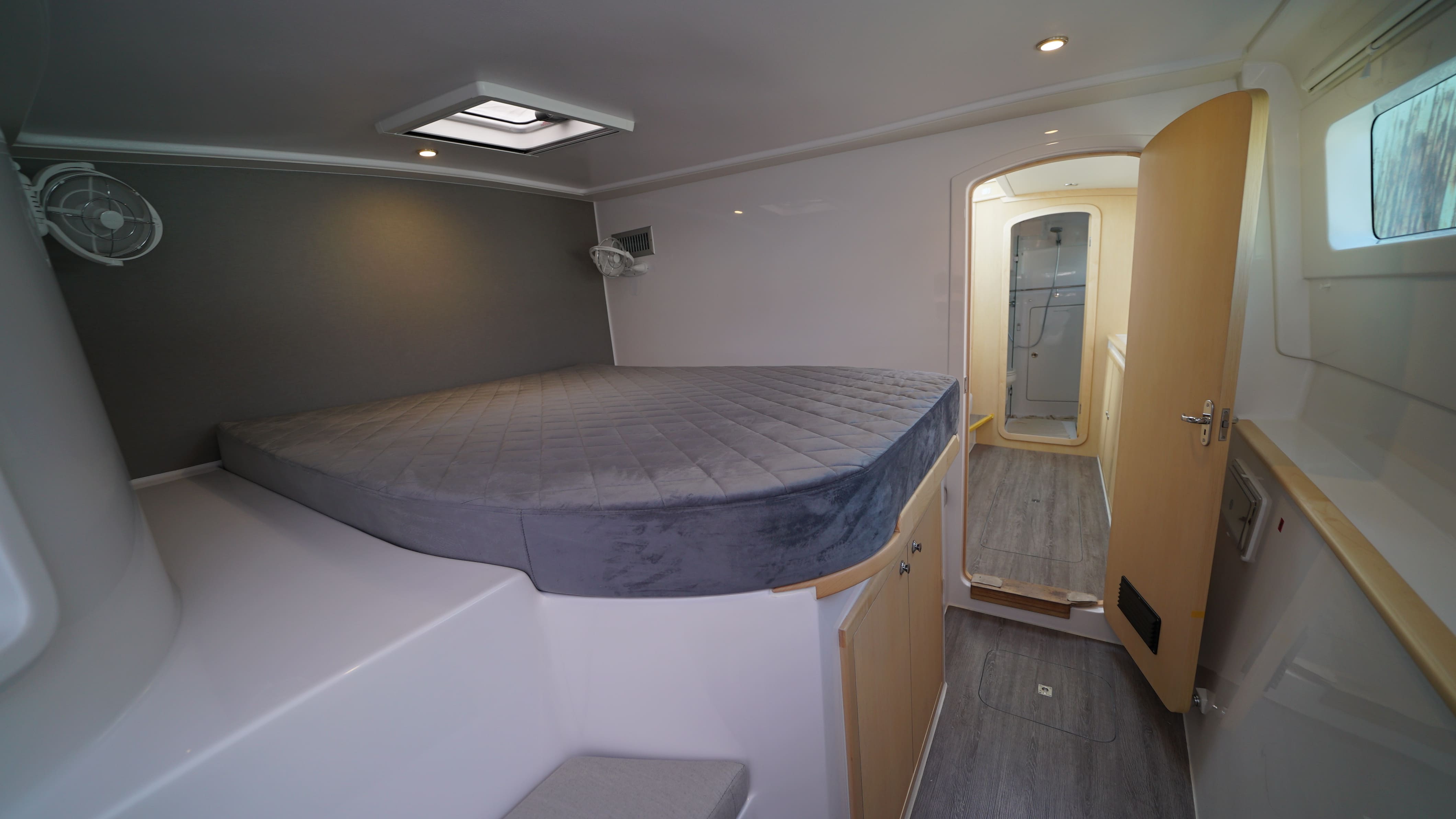

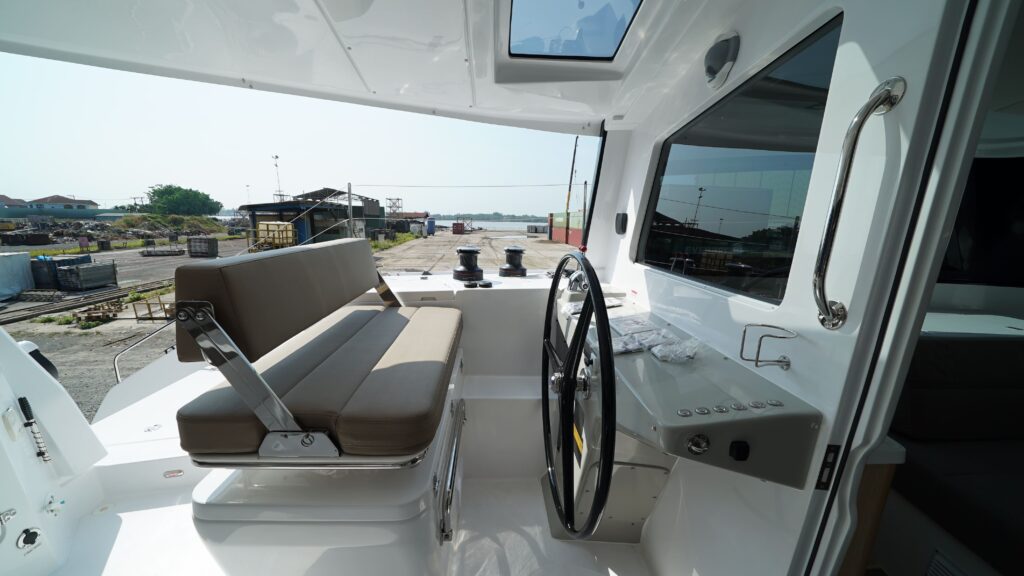

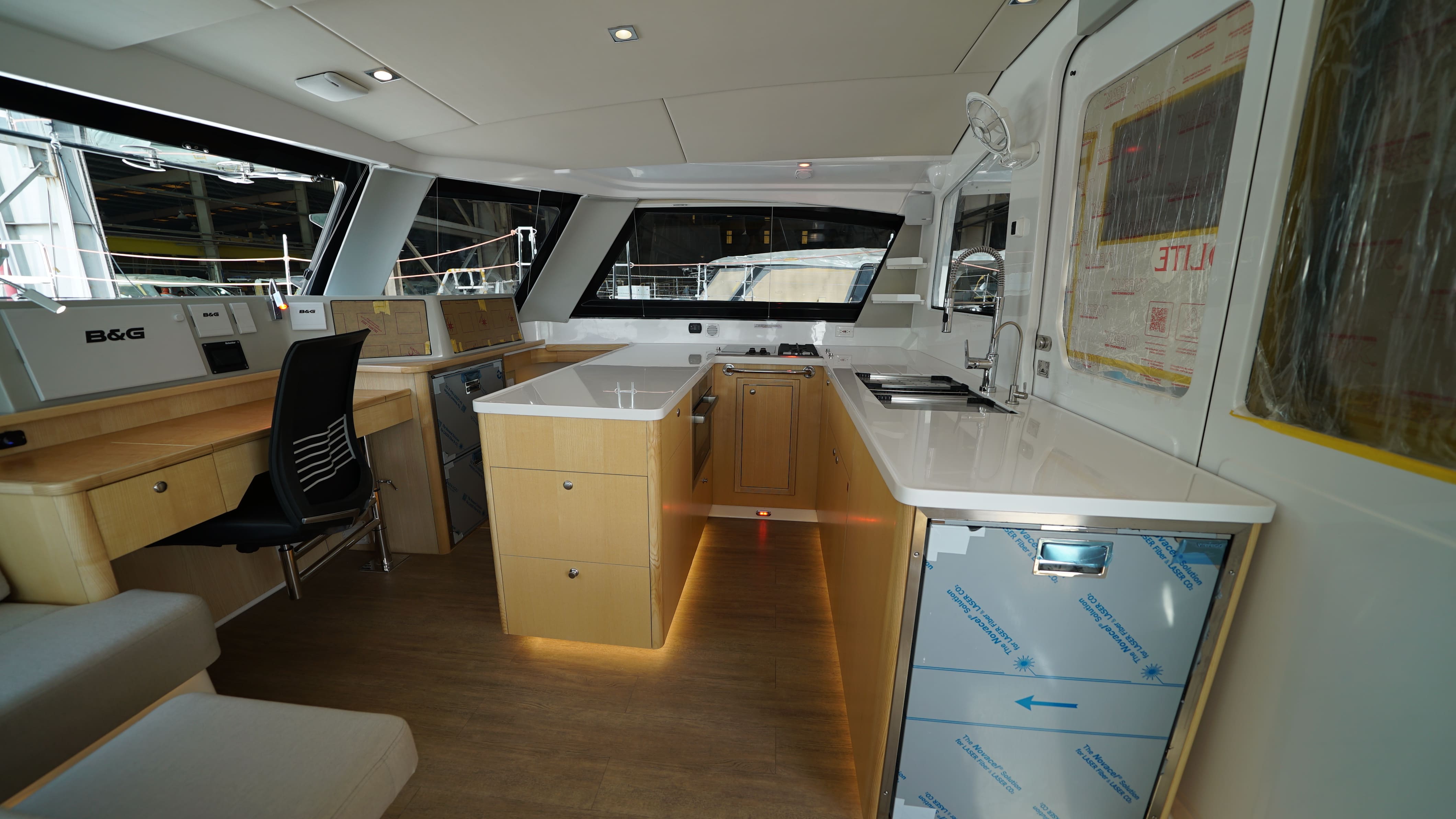

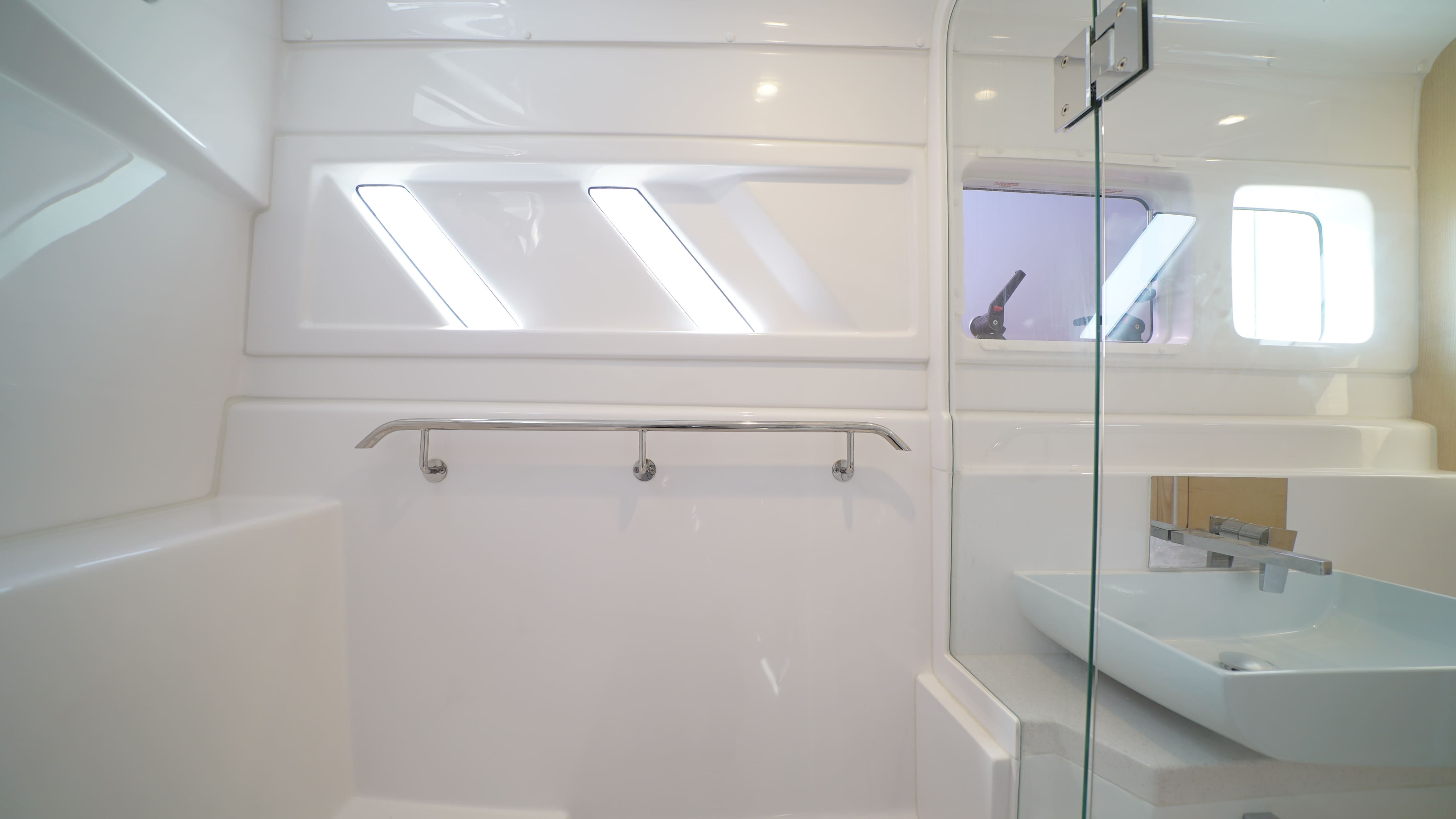

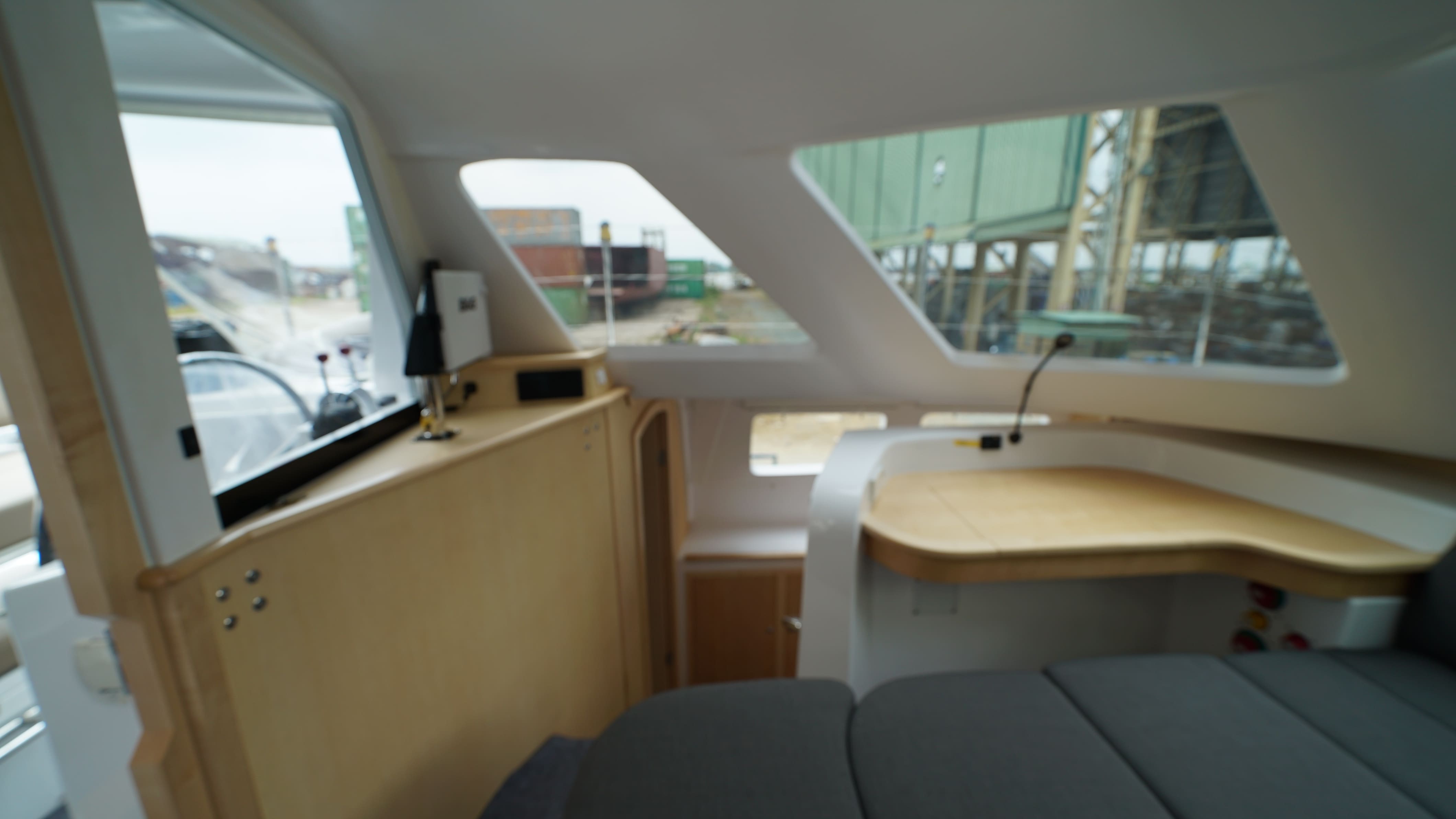

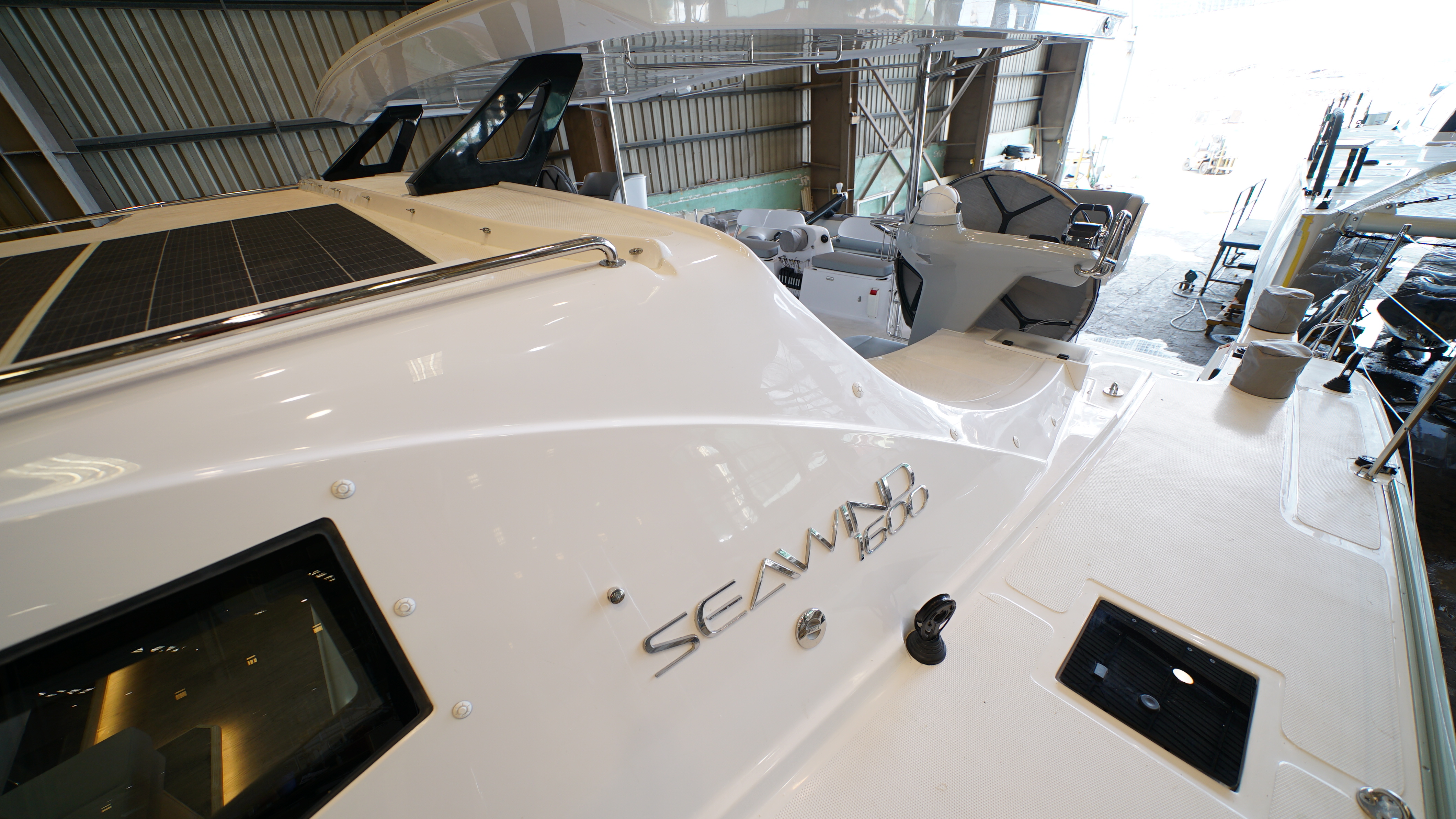

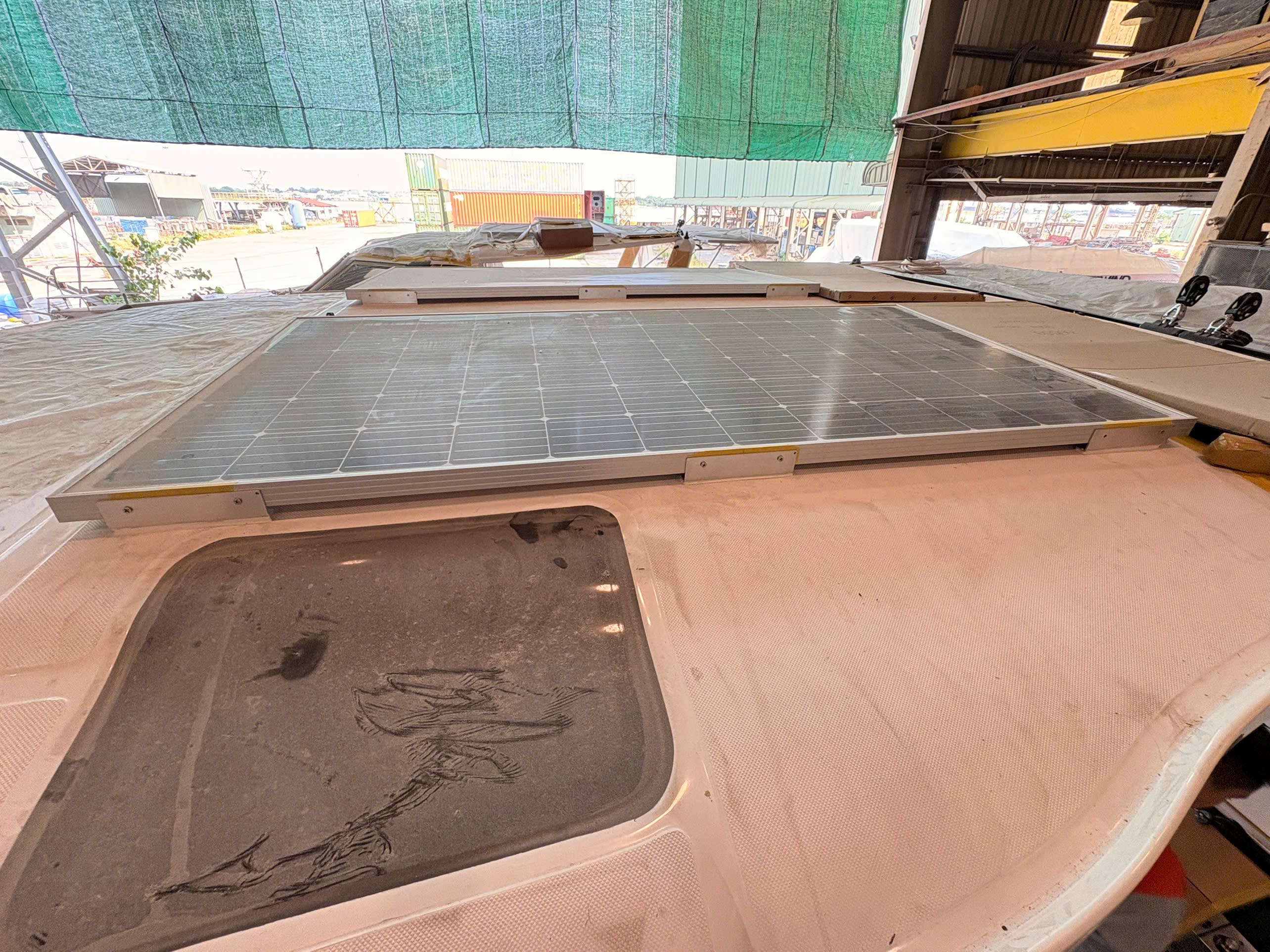

The boat is currently at 85% of completion progress. Electrical system, plumbing system, engines, deck hardware & navigation instrument have been installed successfully & tested. Timber fitout & upholstery are on on track. With this progress, the boat will be finished on time for shipping as planned.

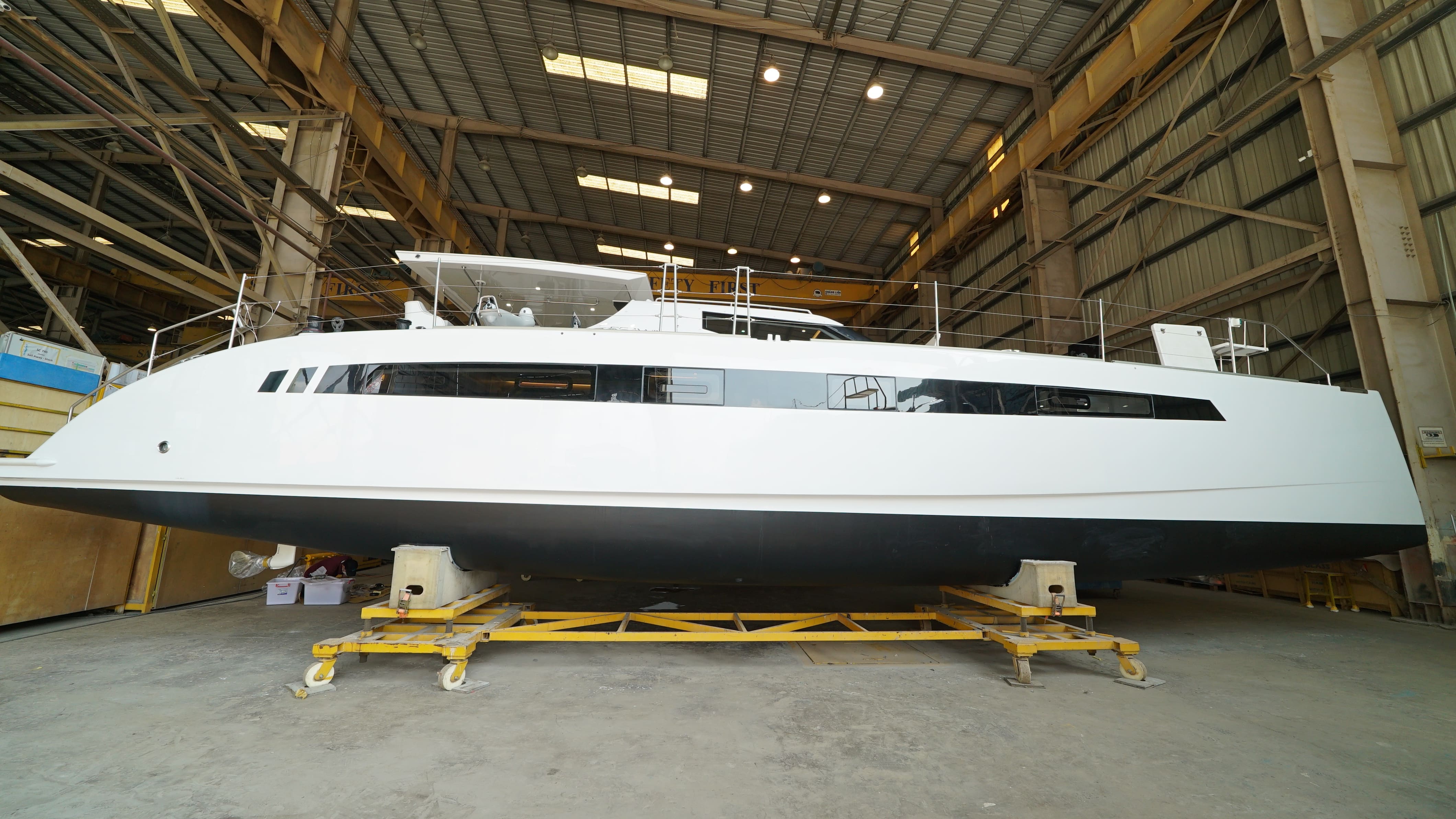

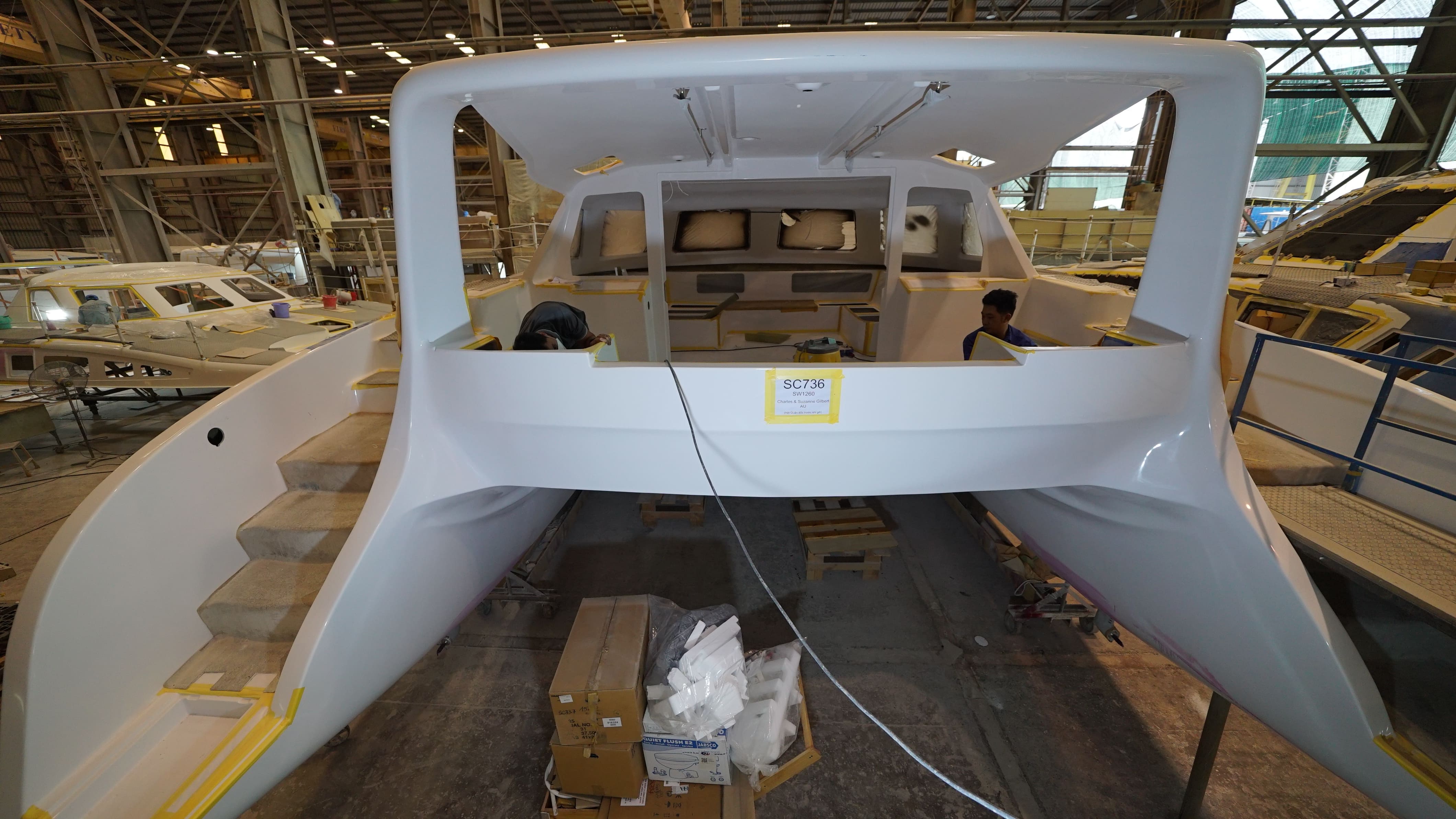

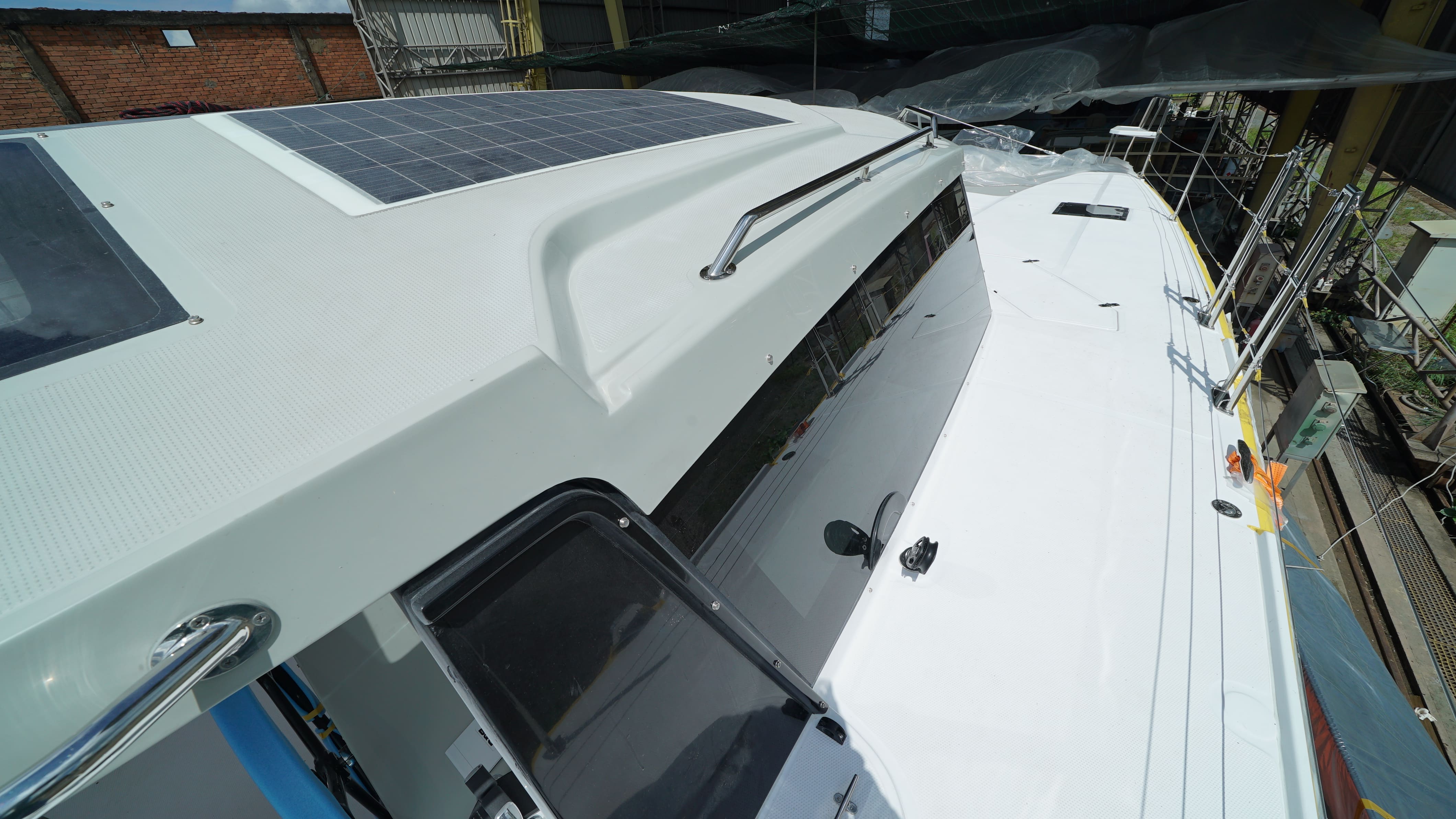

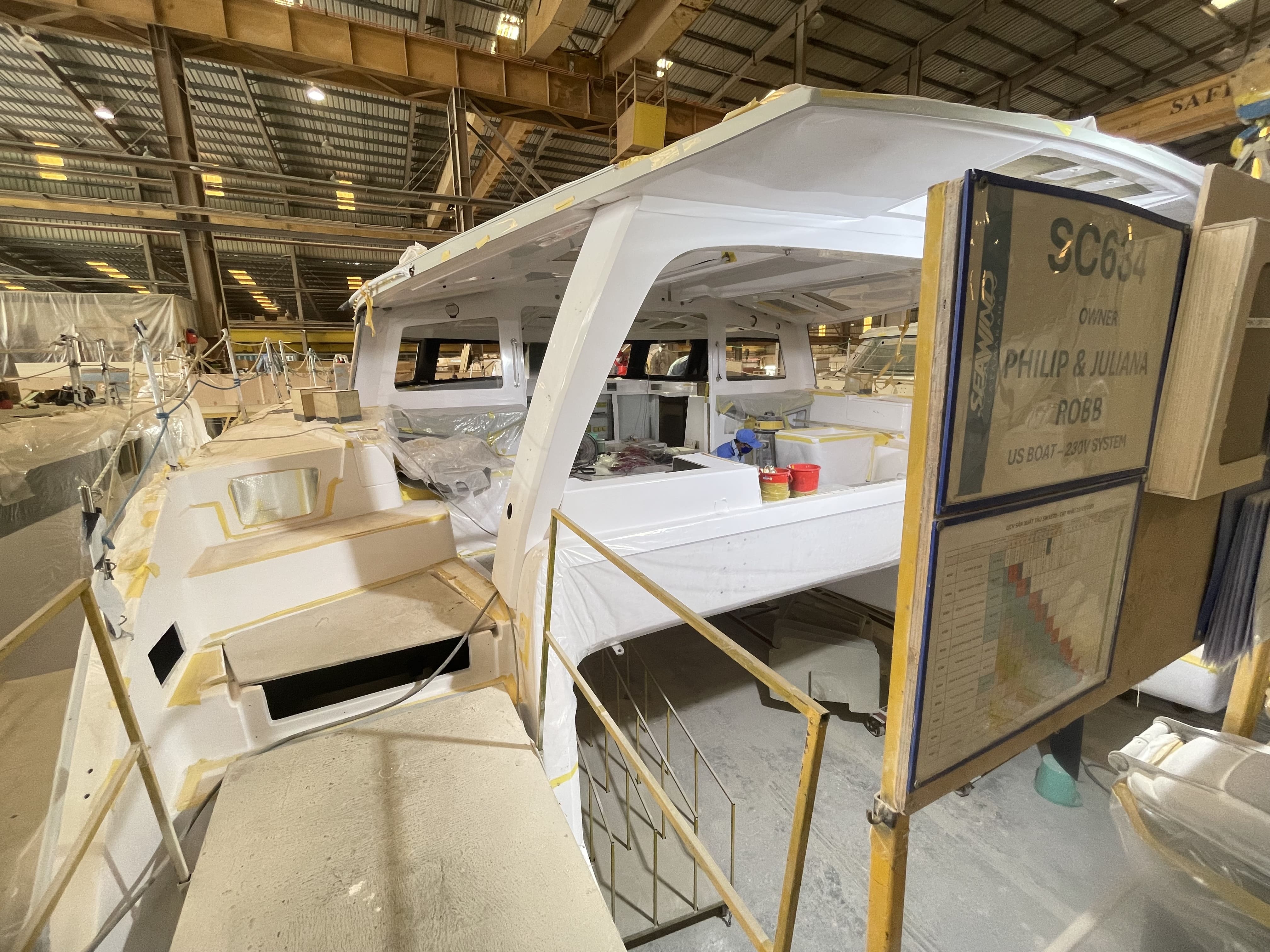

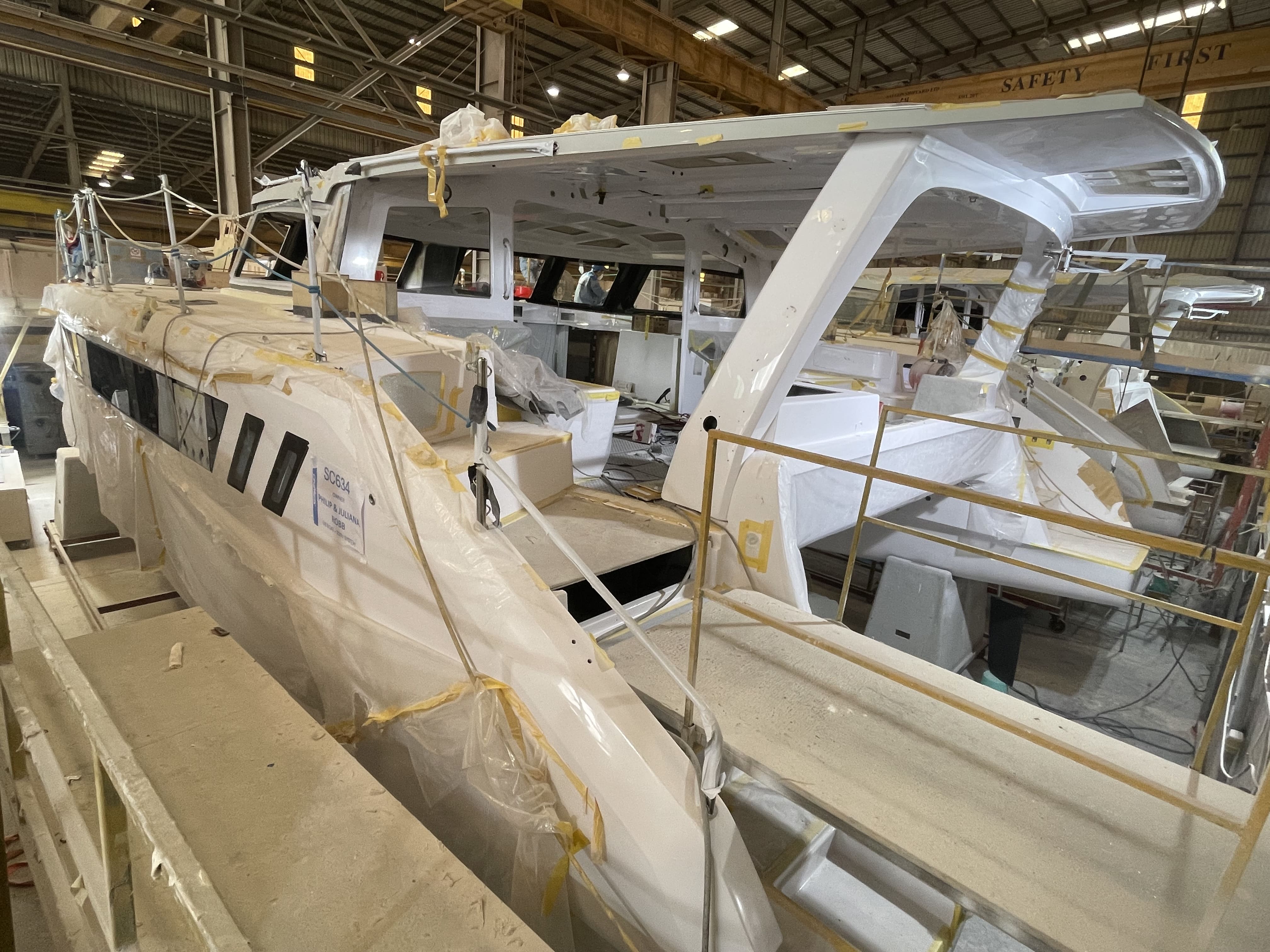

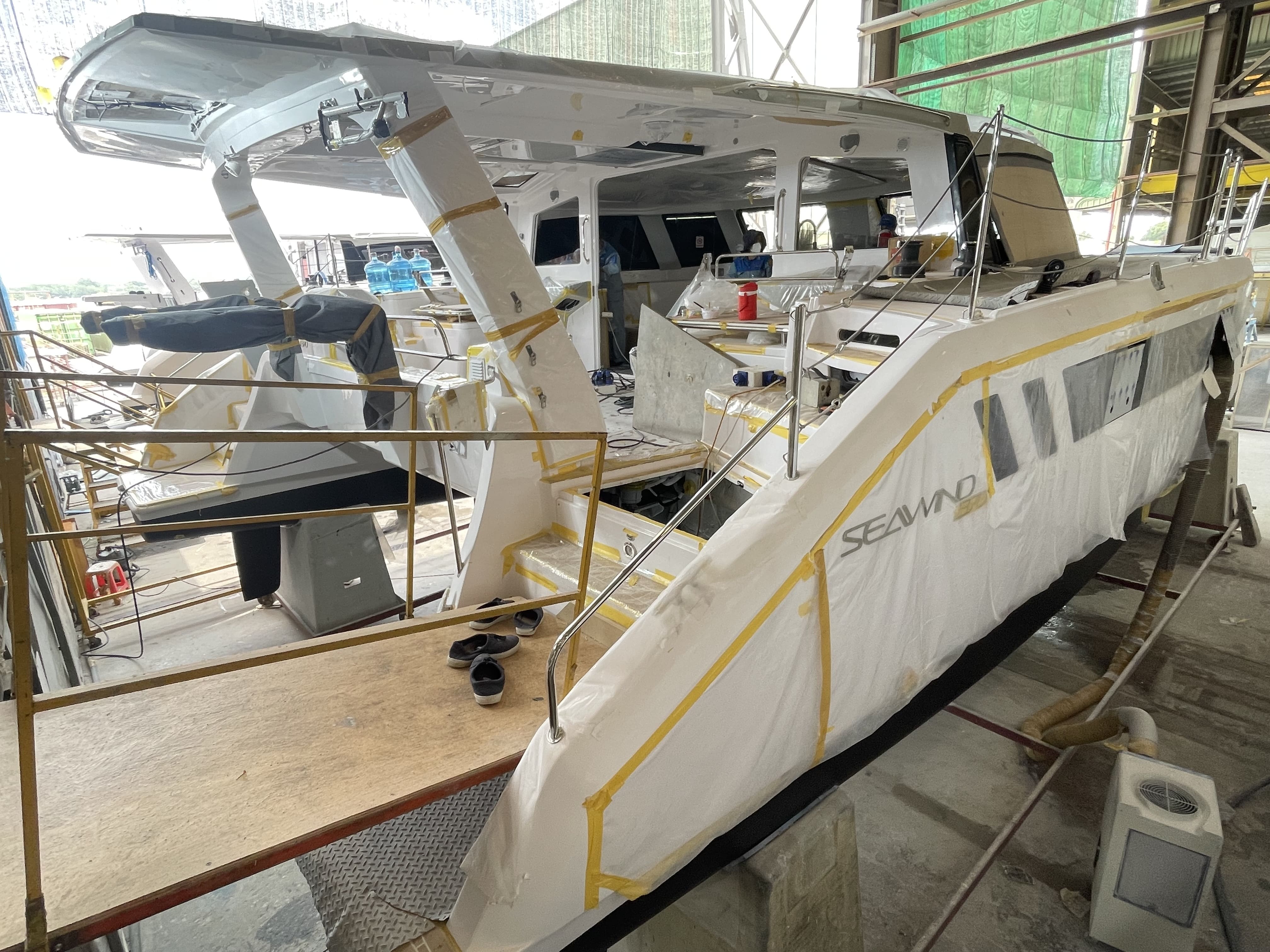

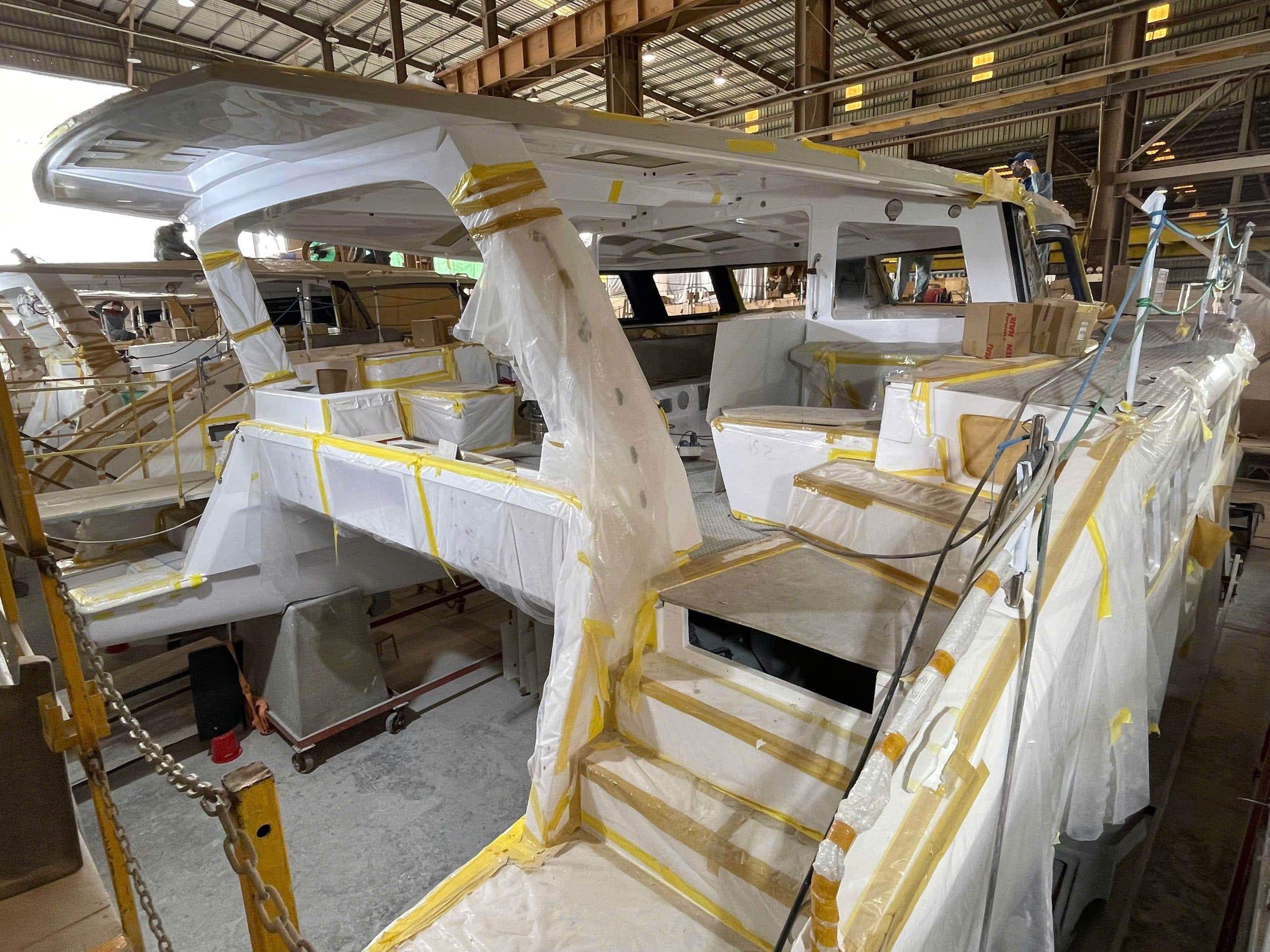

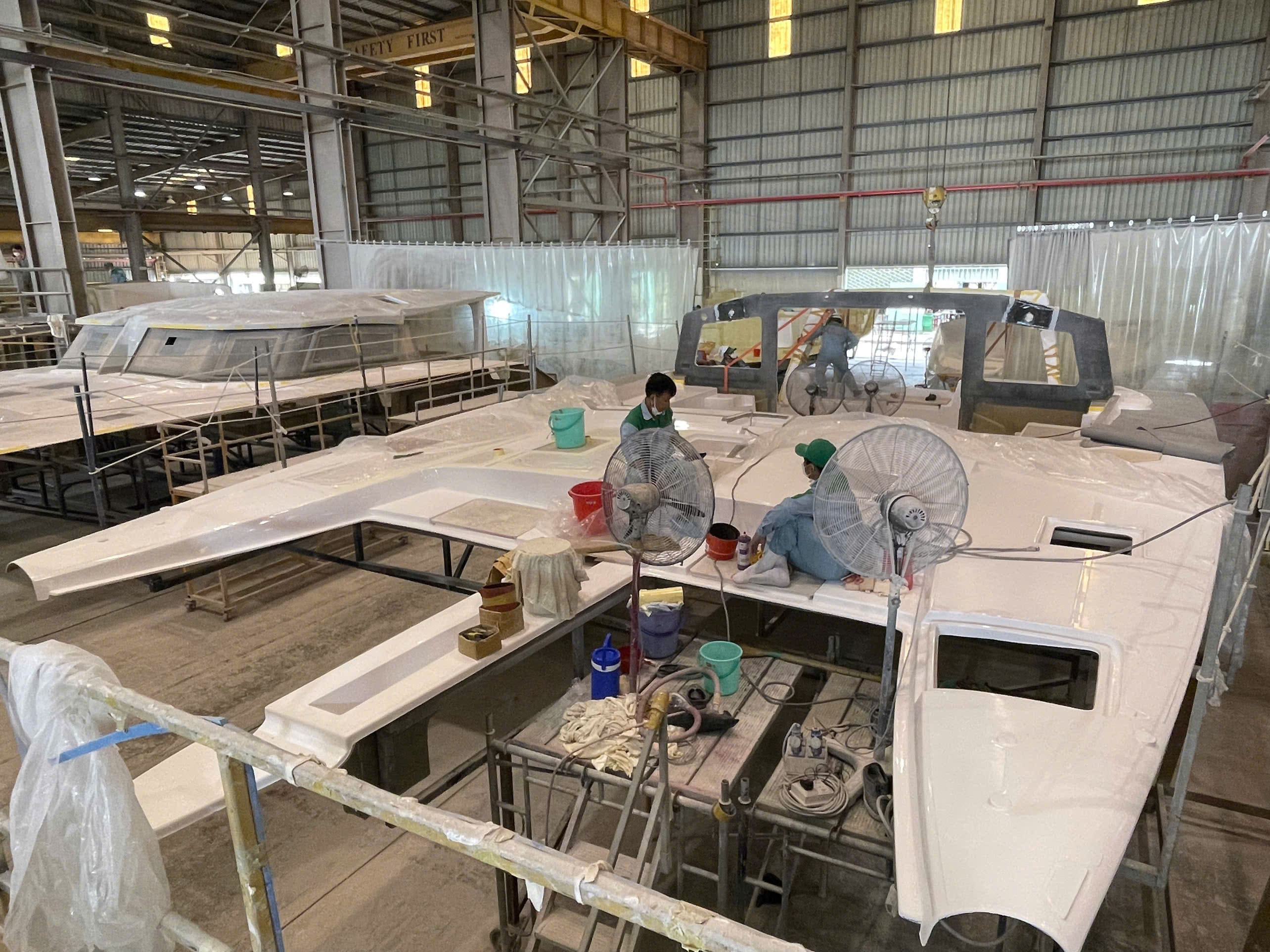

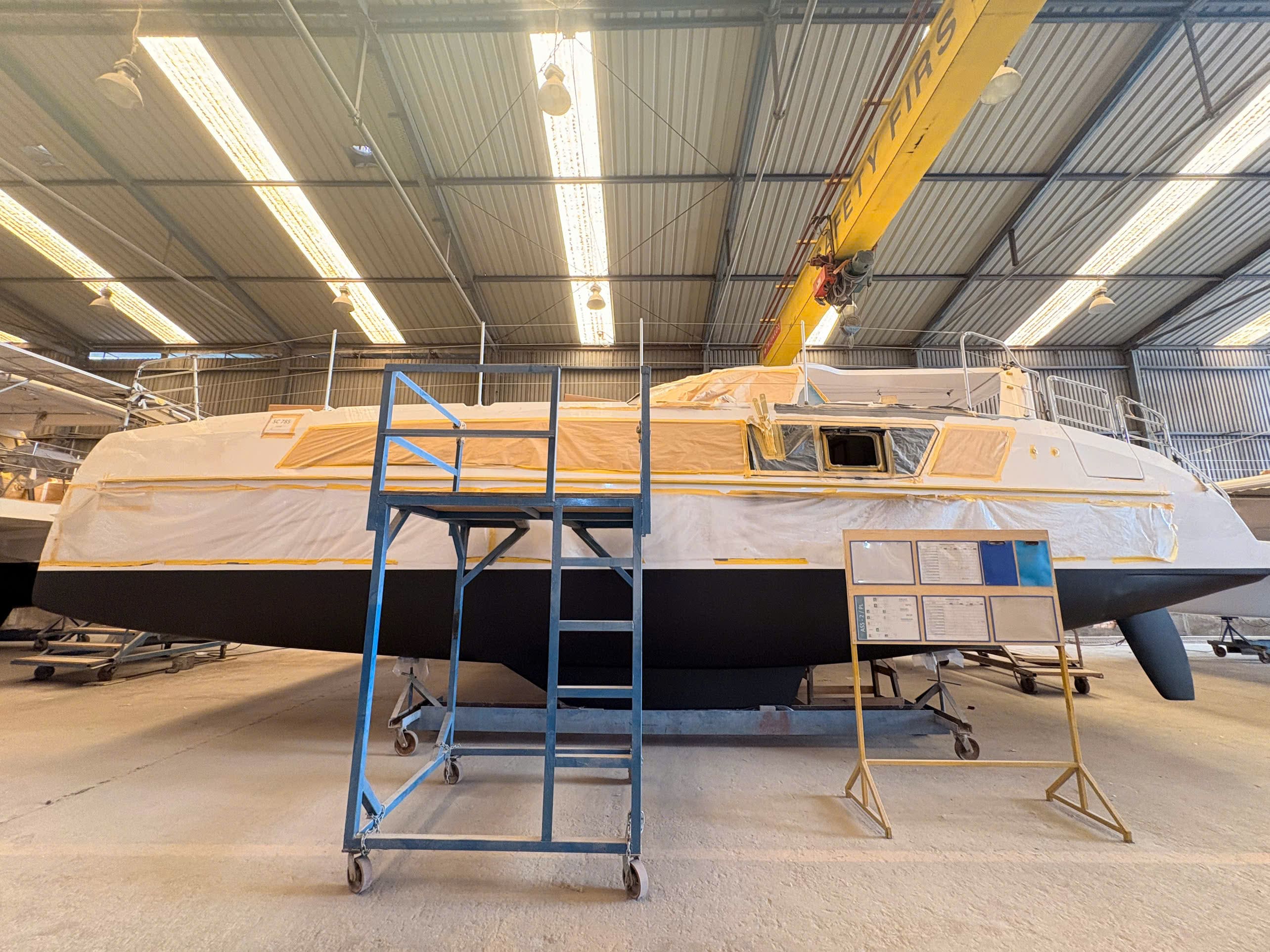

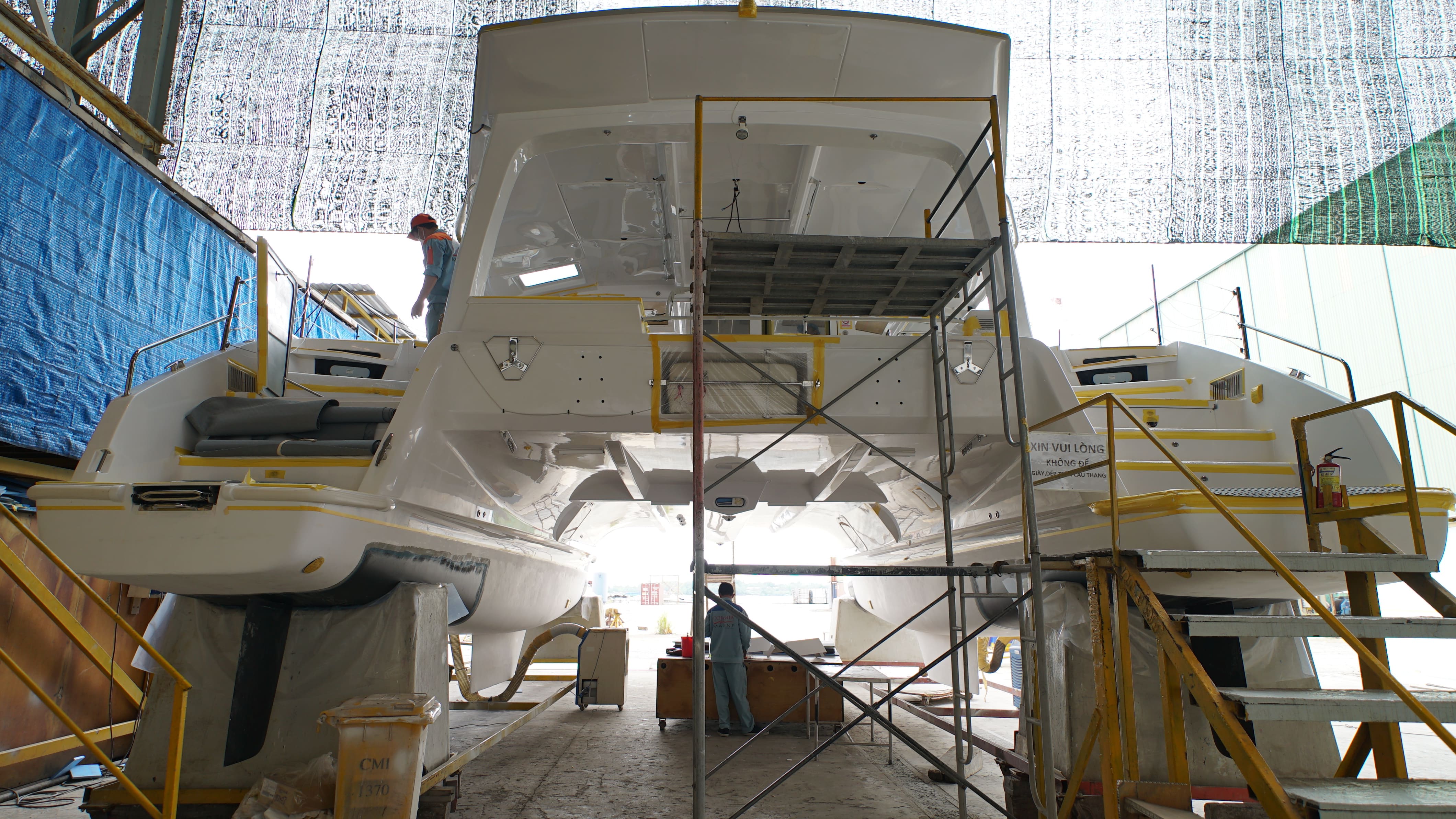

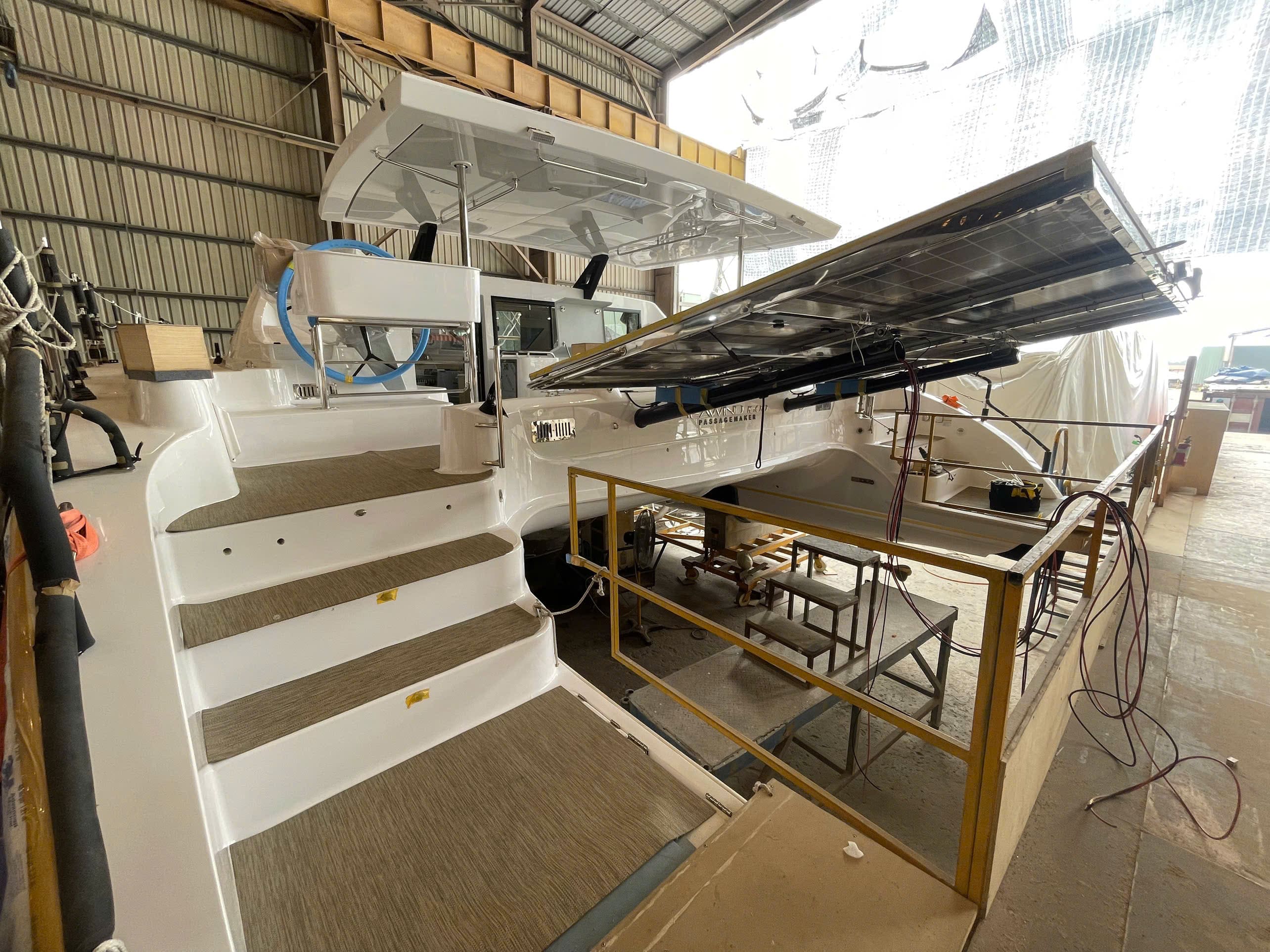

Production Update – Assembly

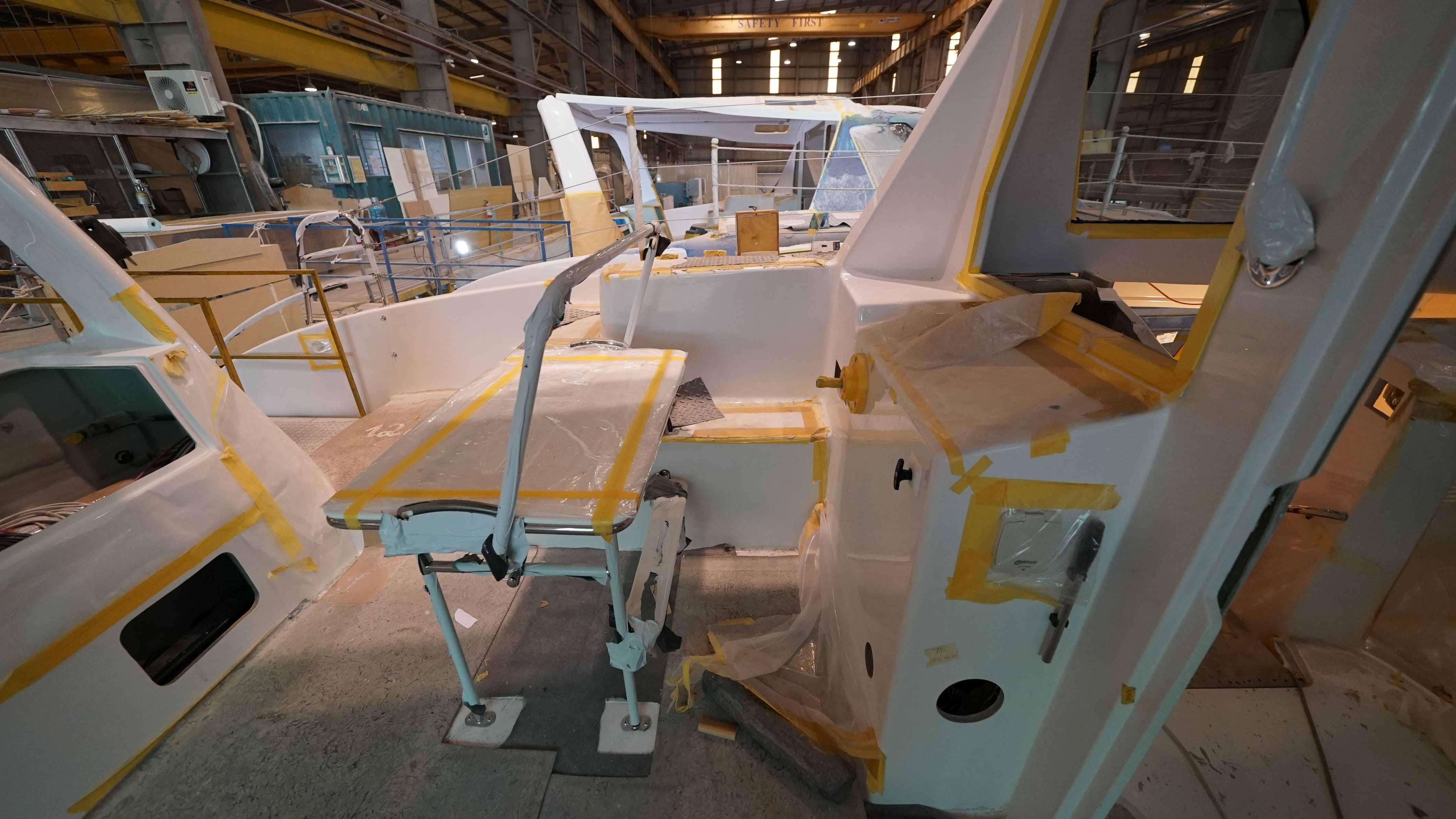

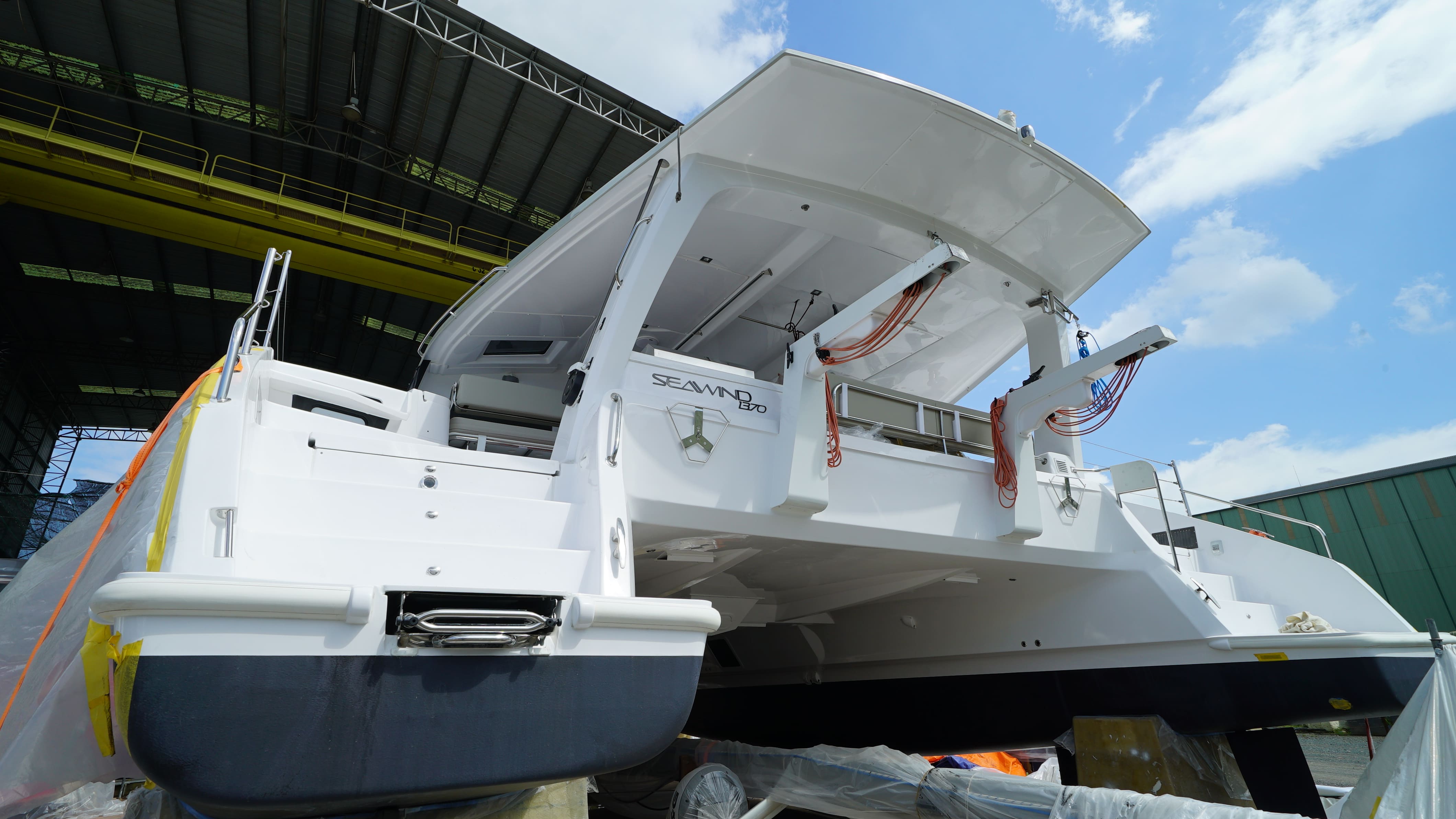

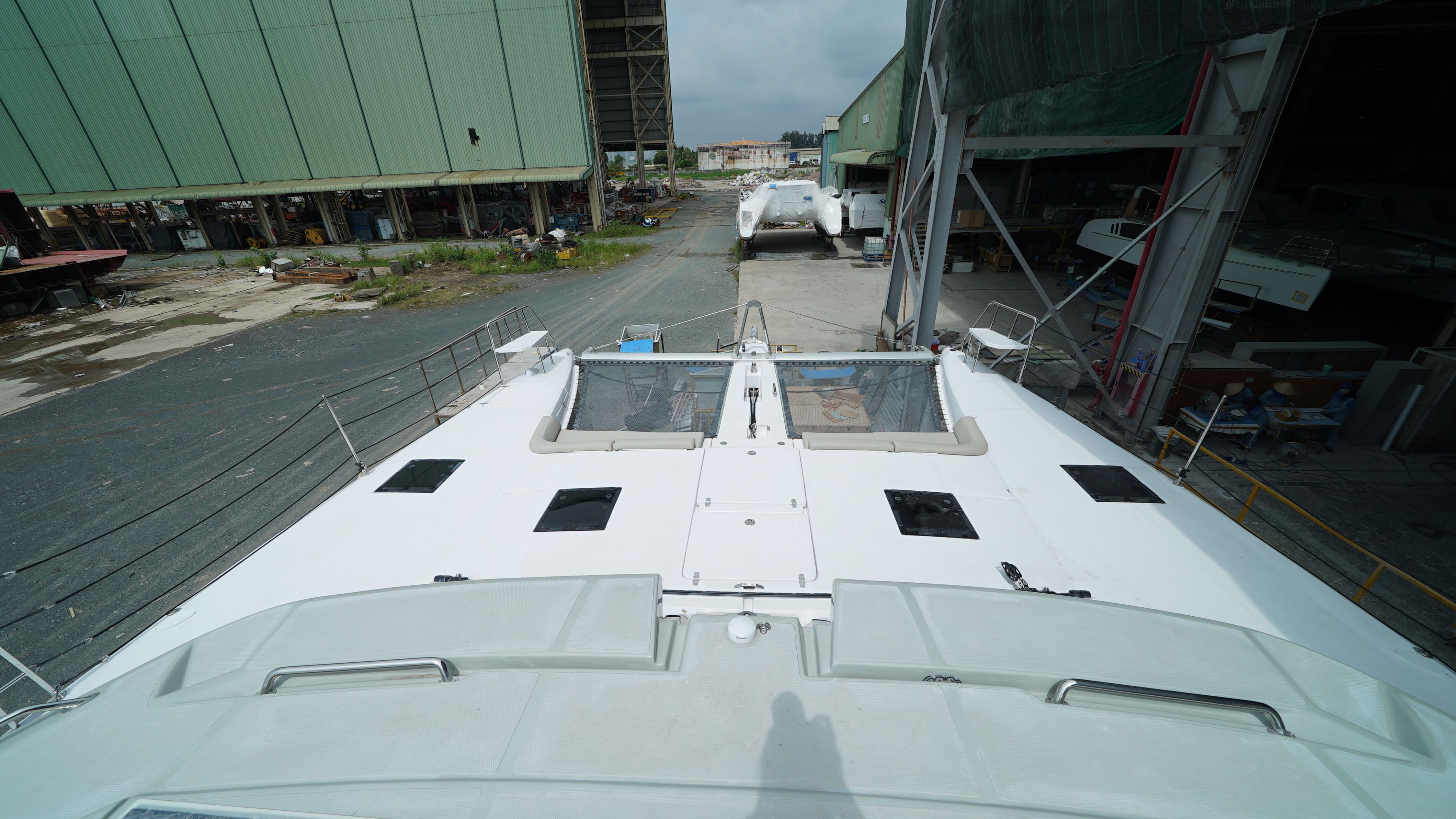

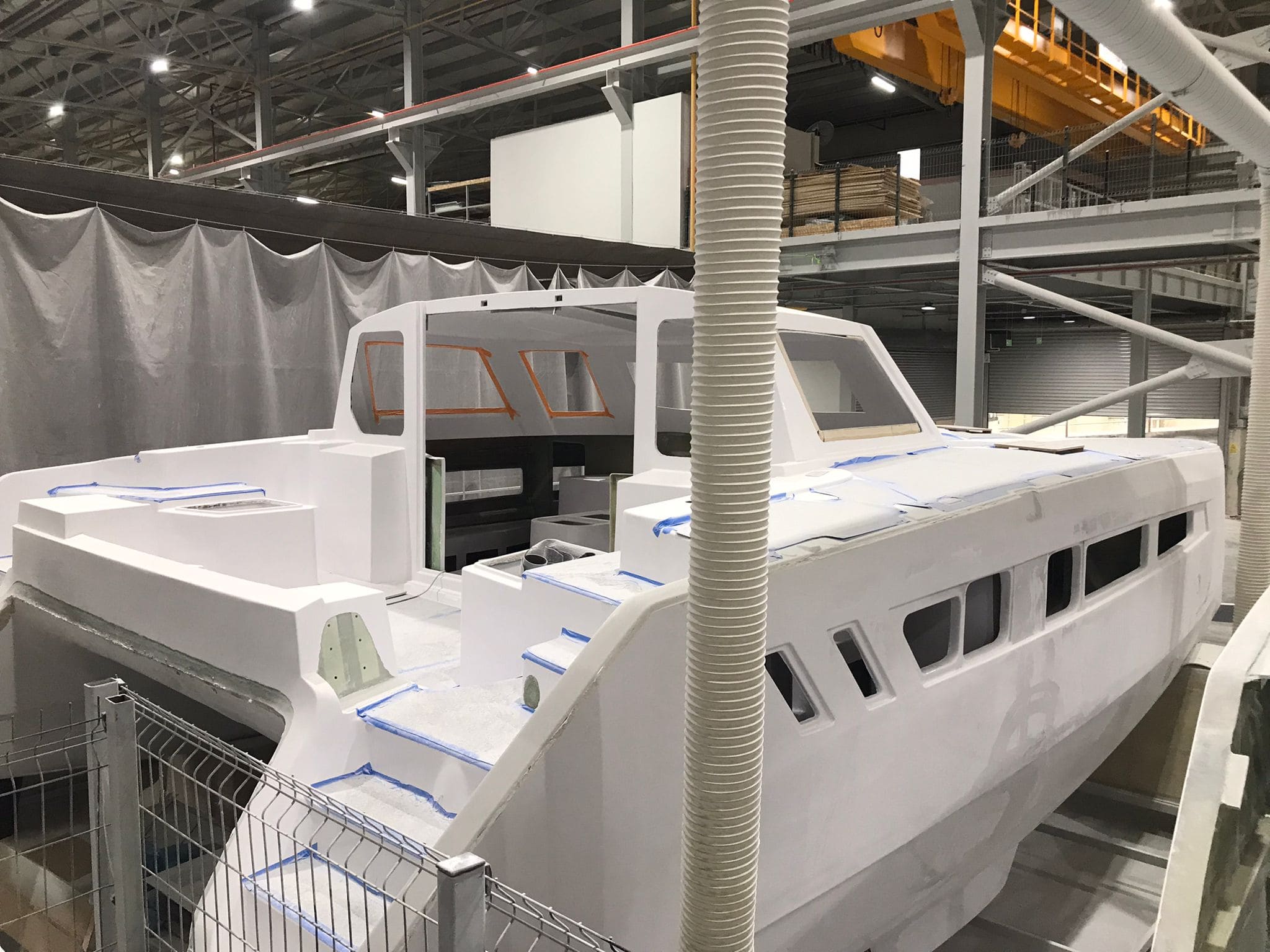

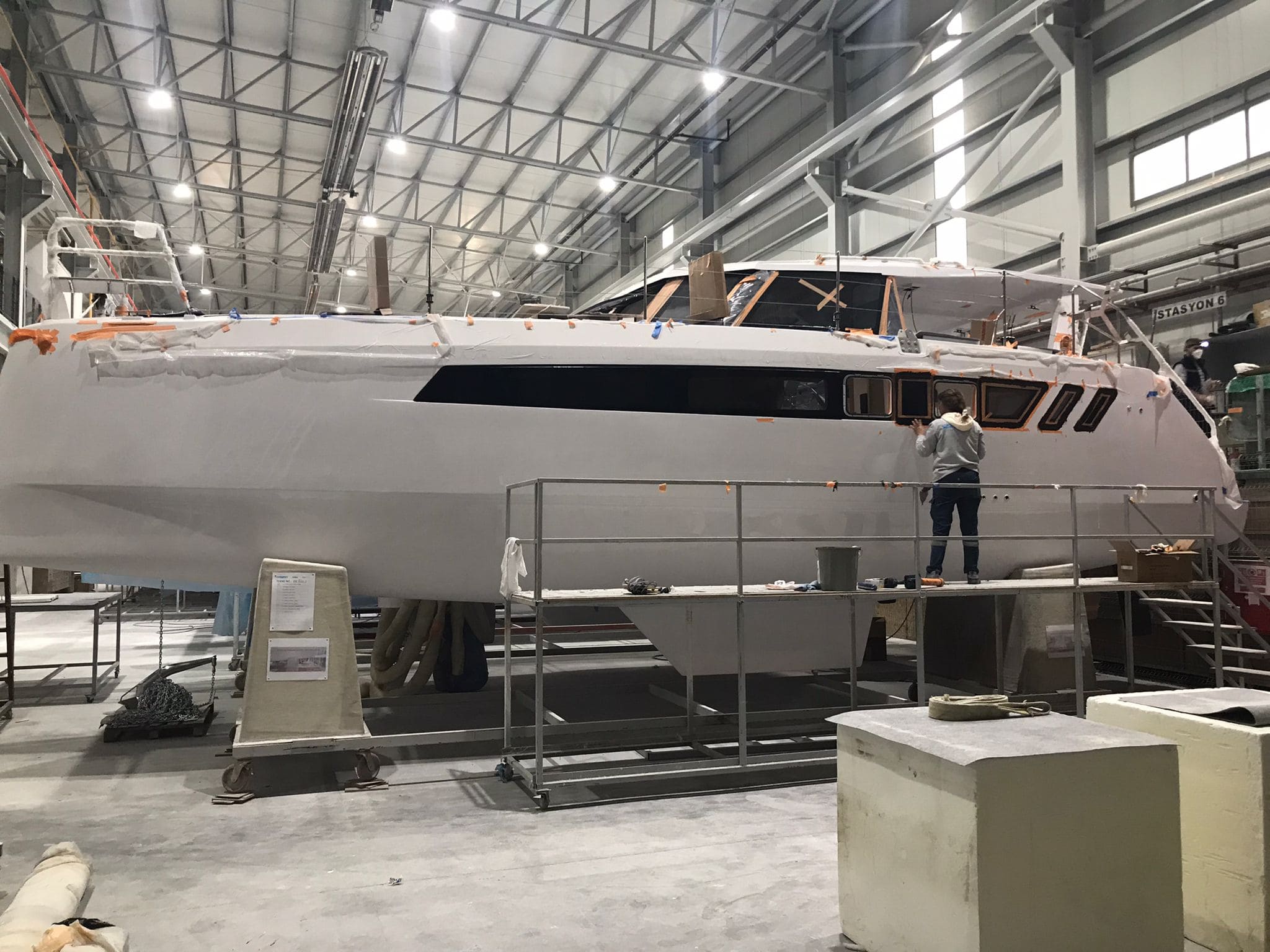

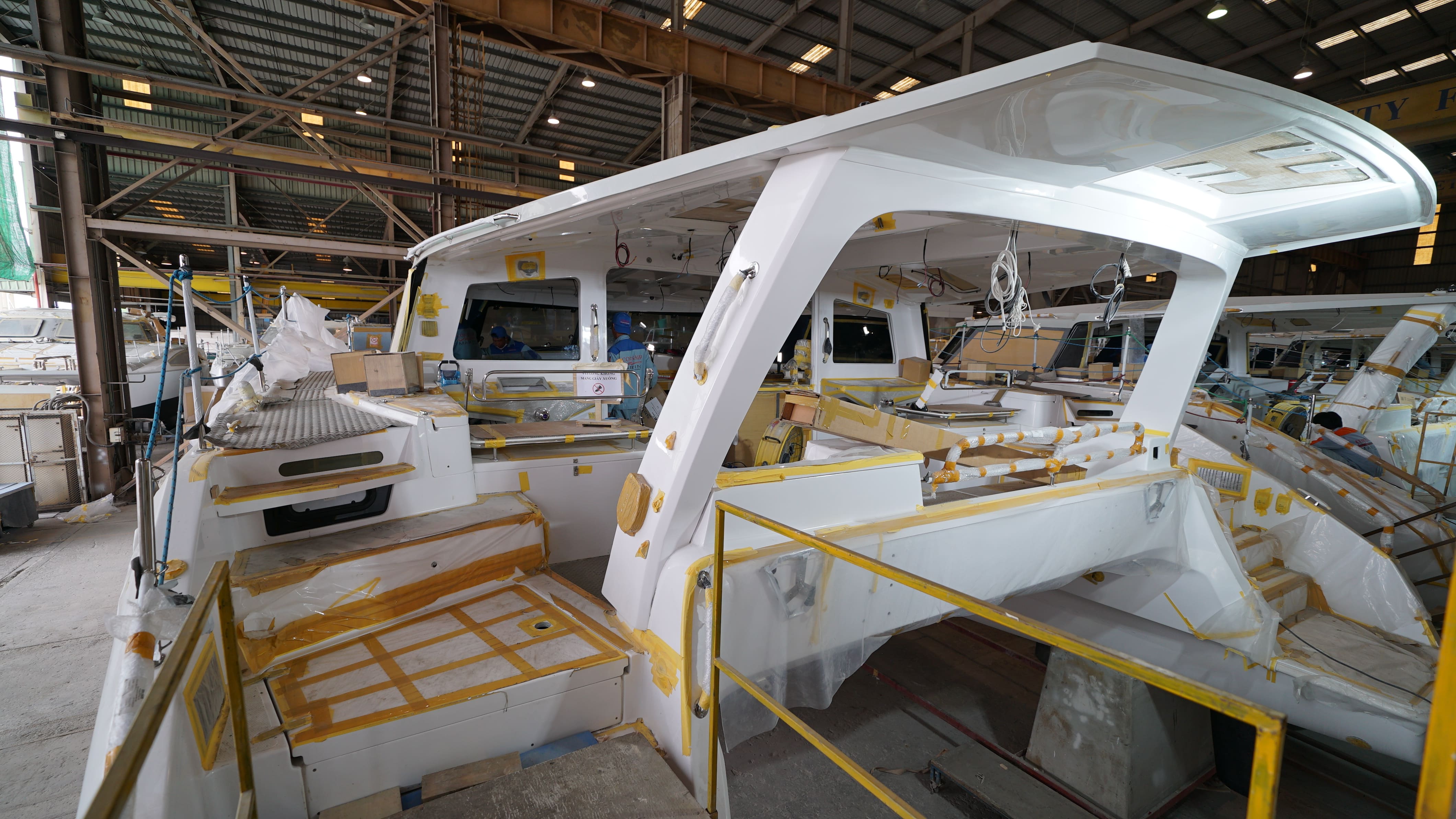

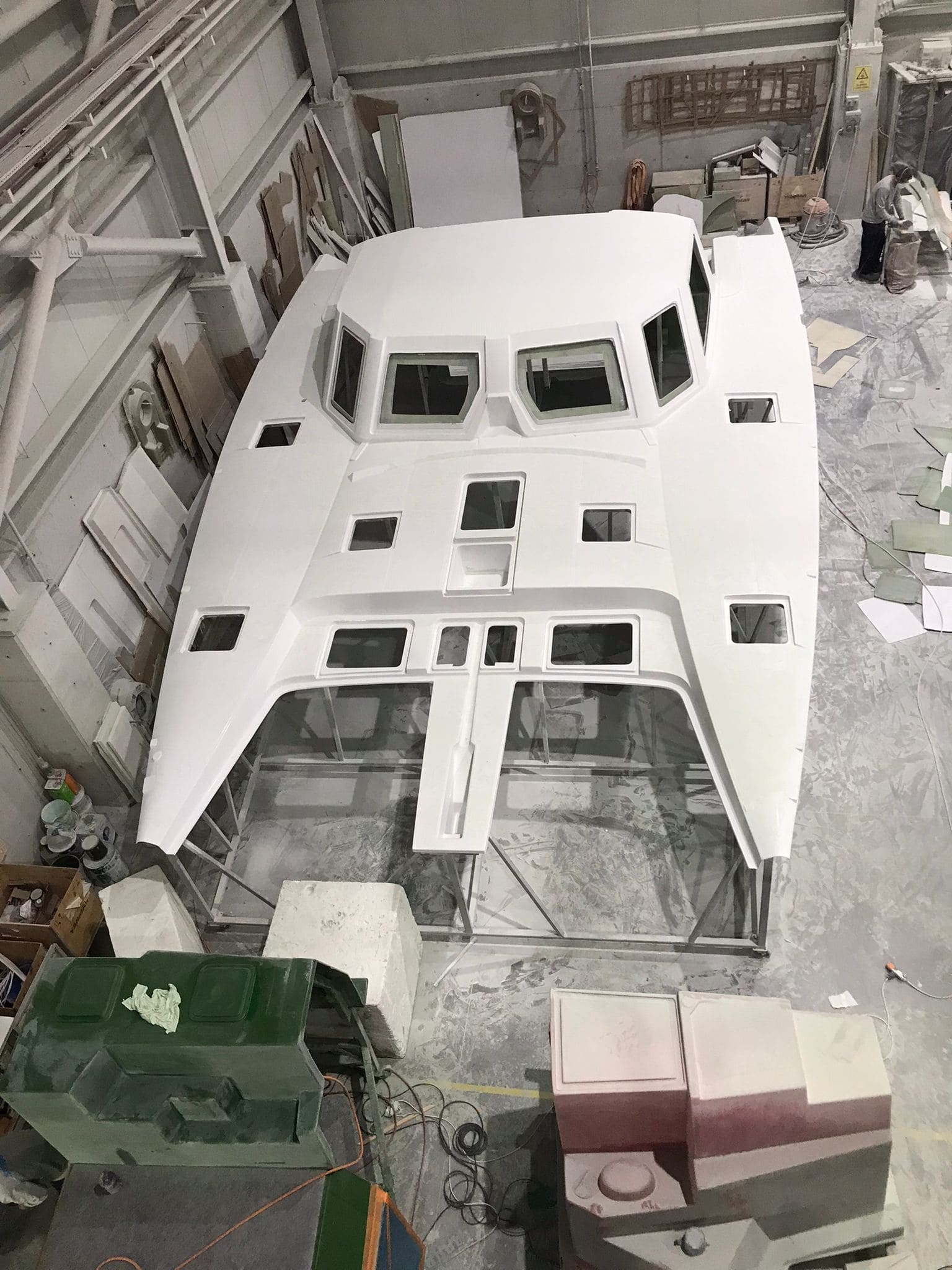

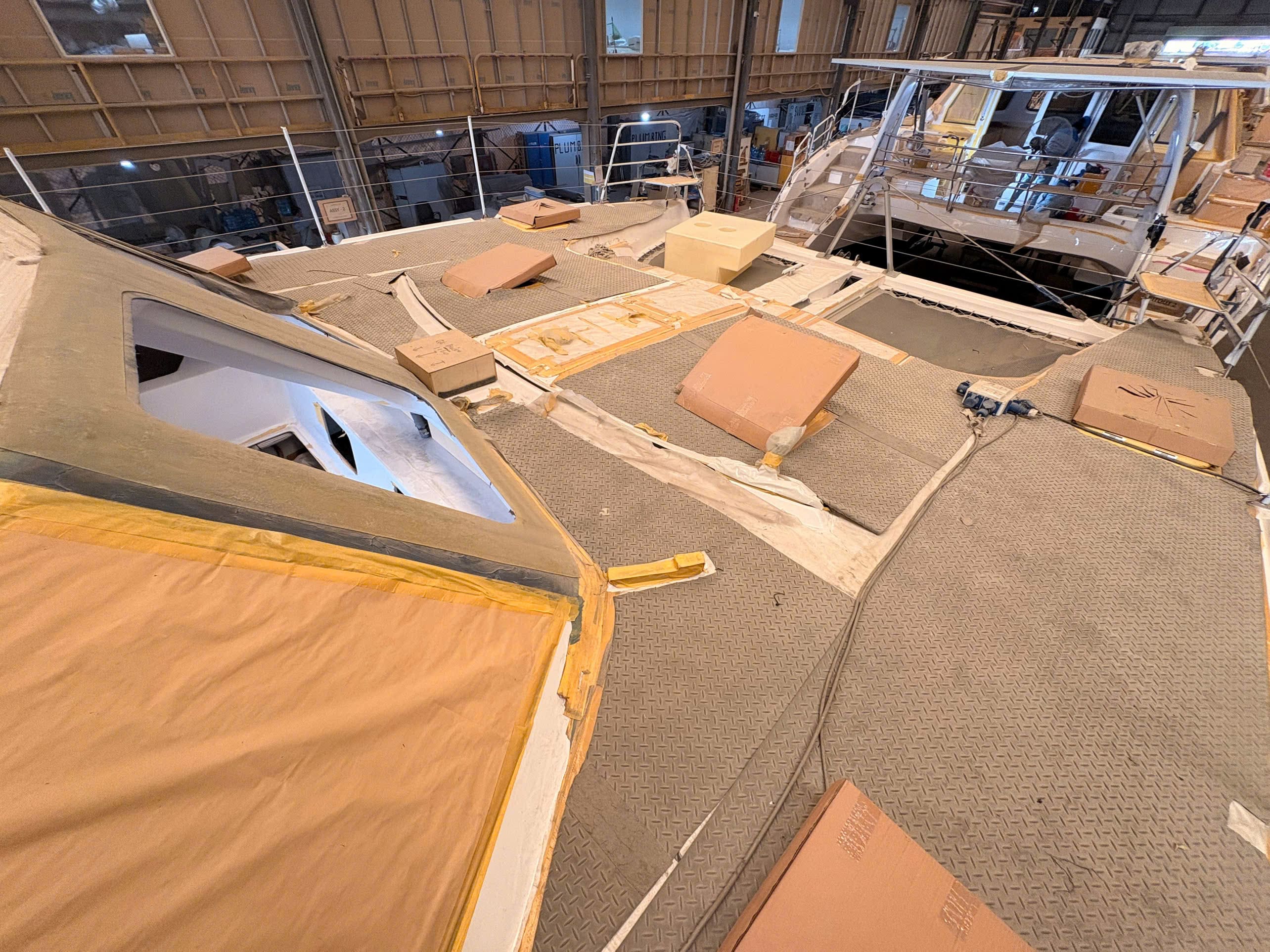

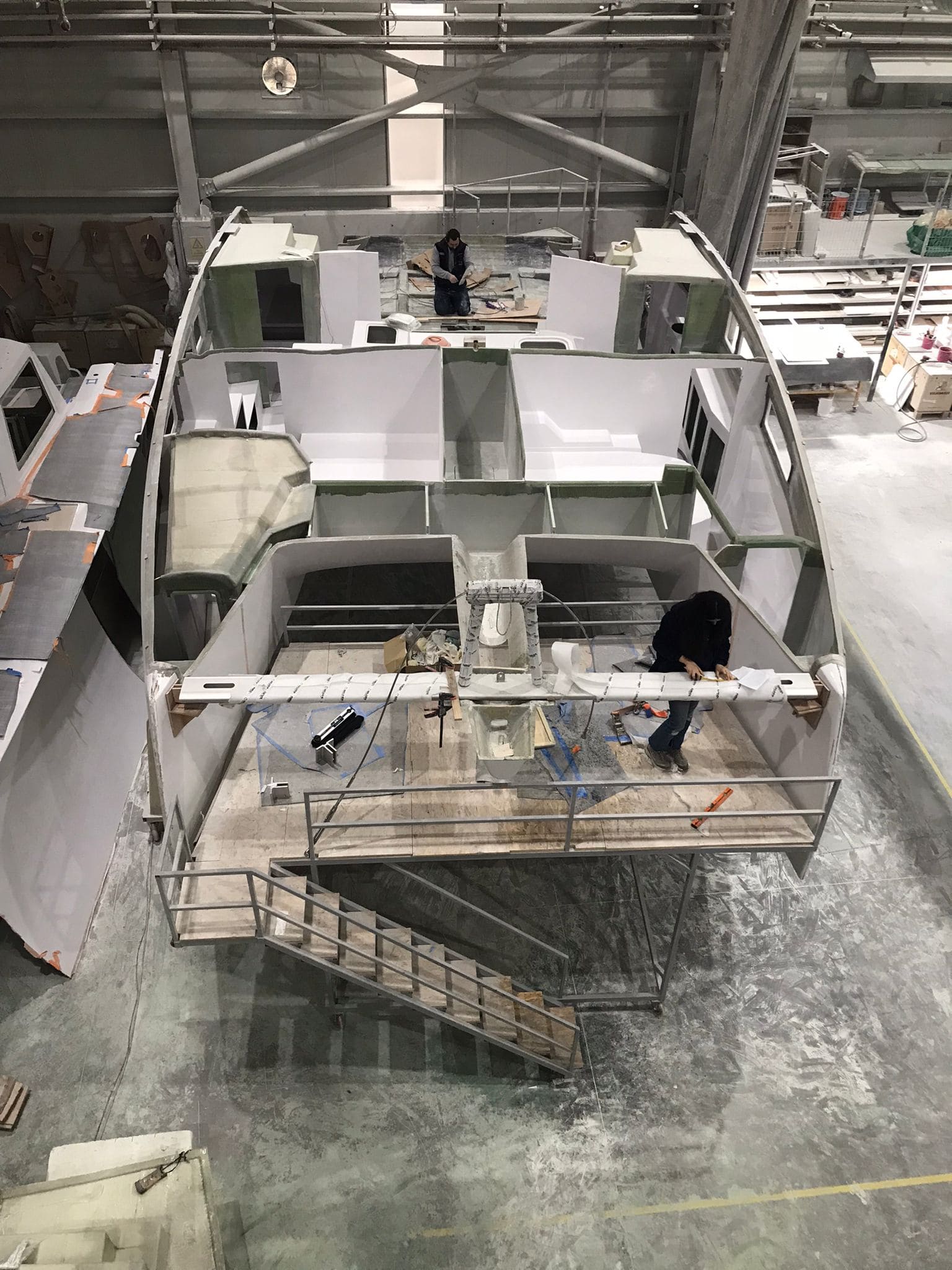

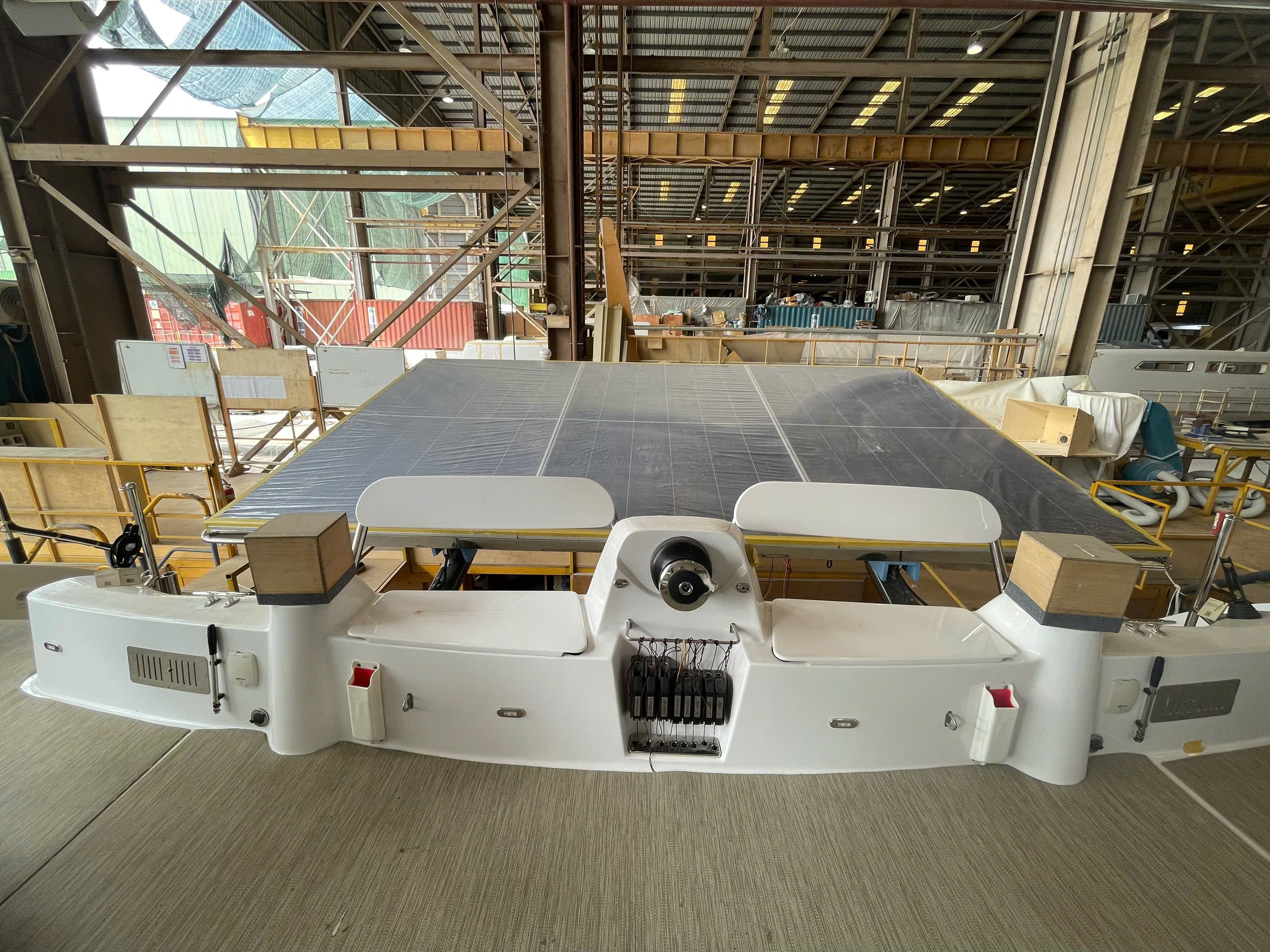

Your boat is progressing well in the Assembly stage.

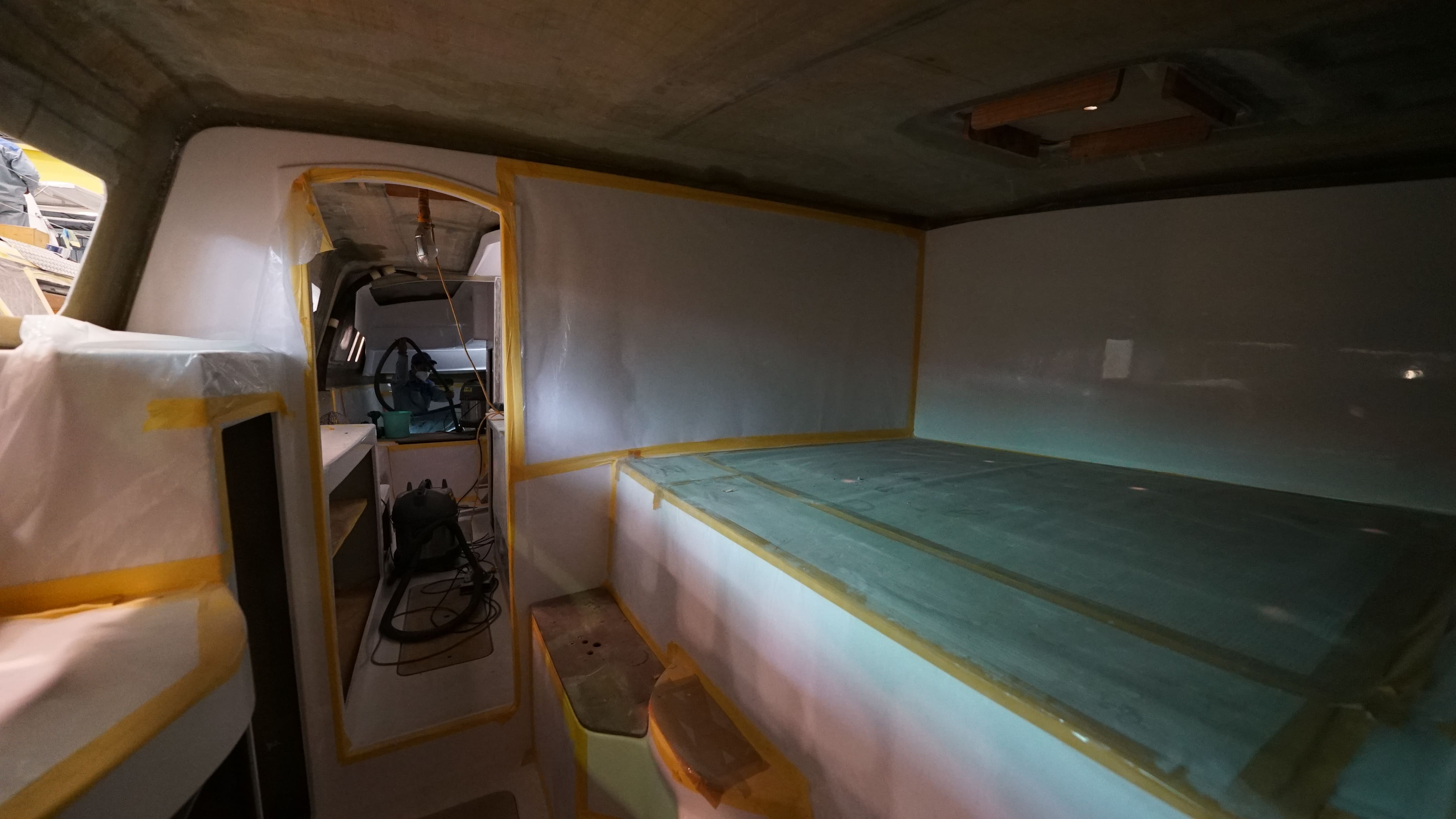

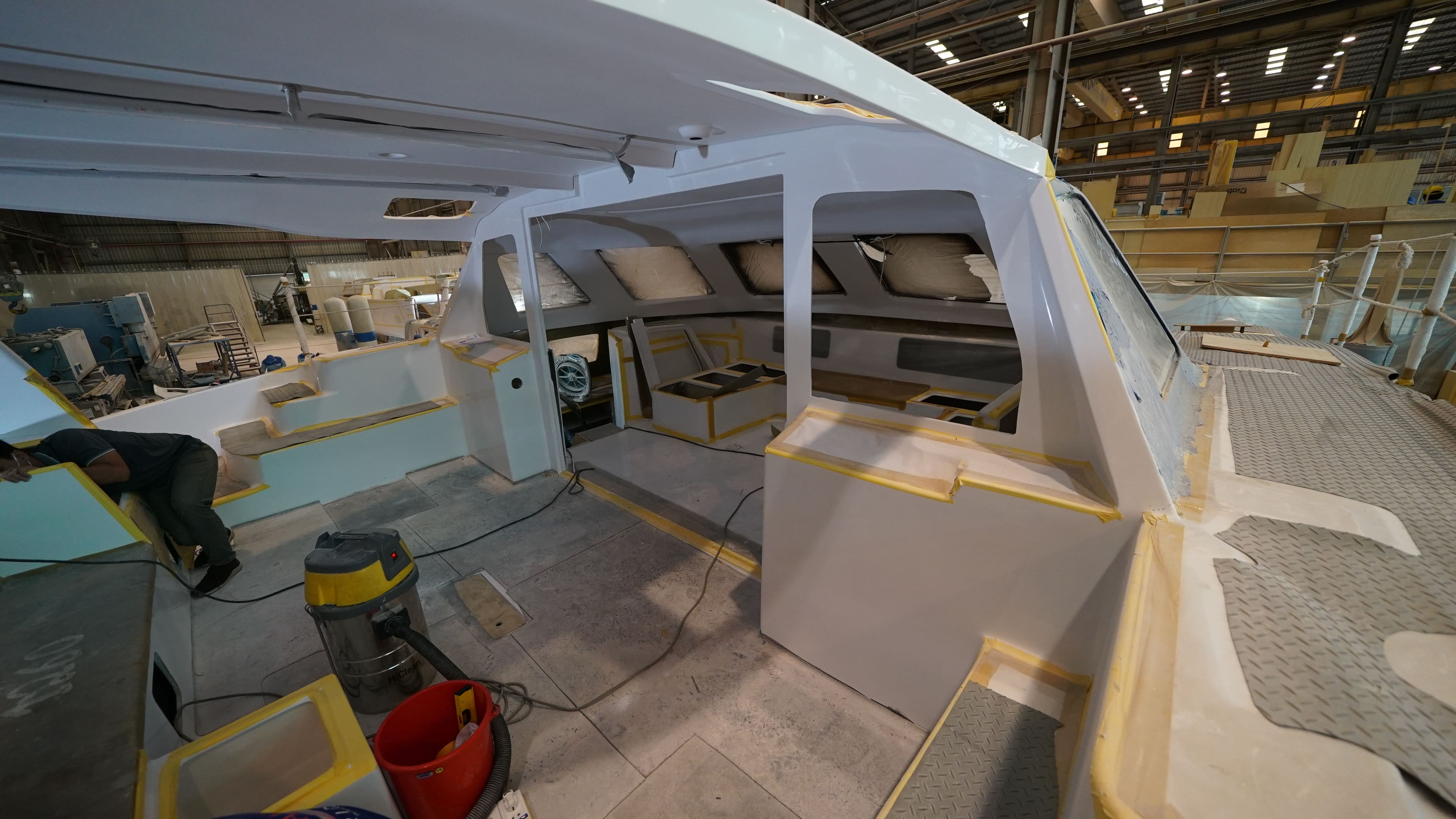

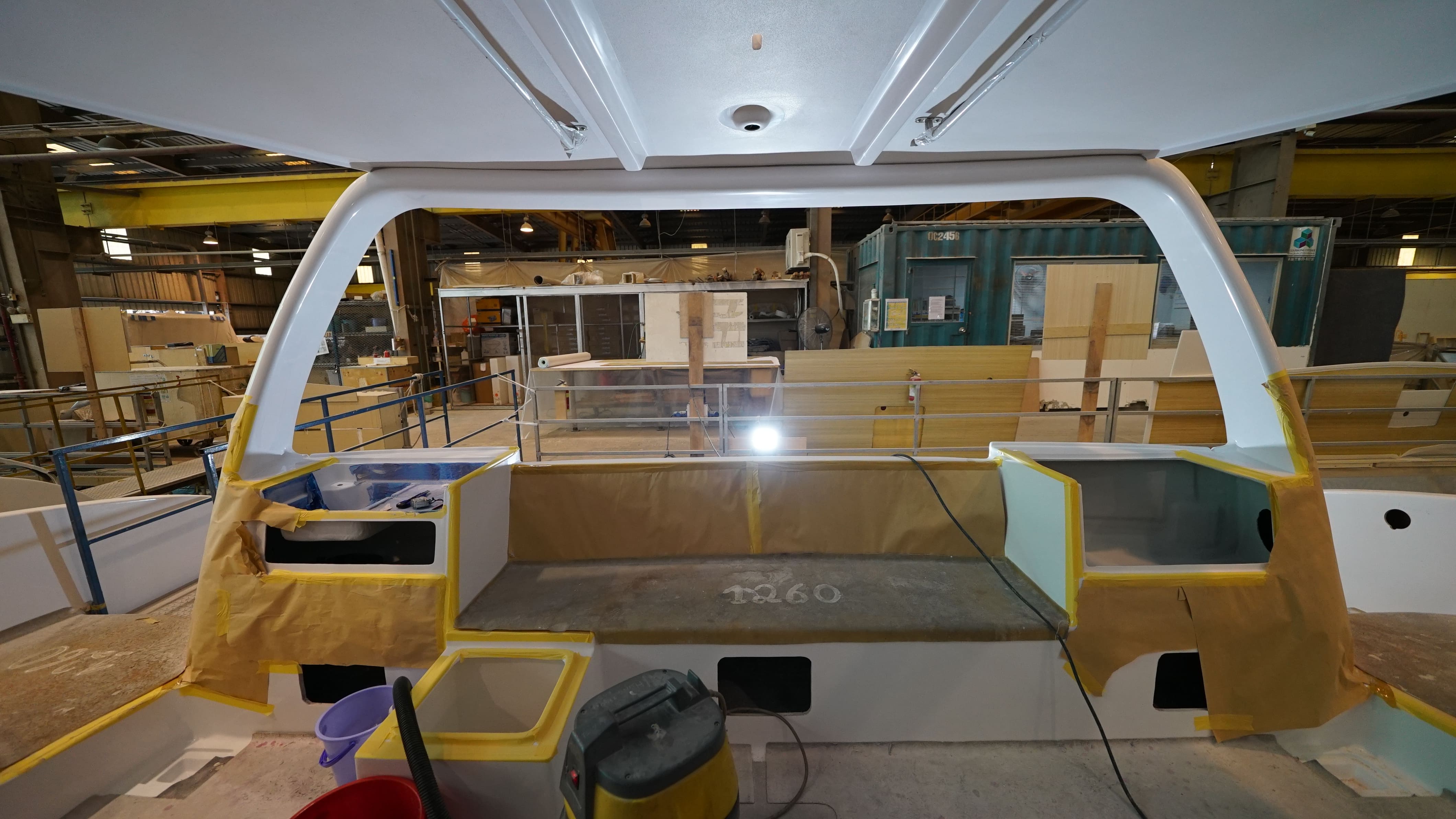

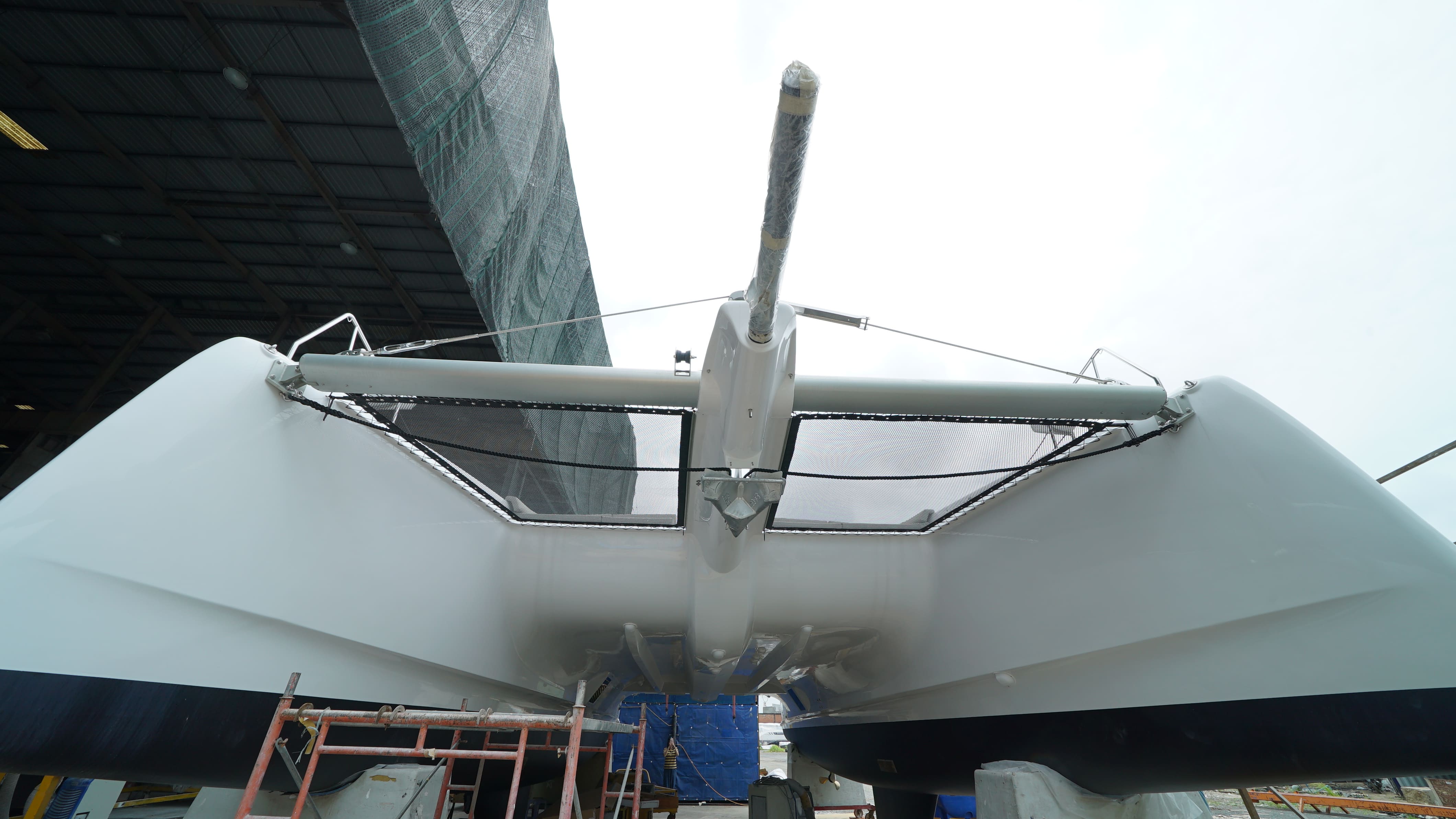

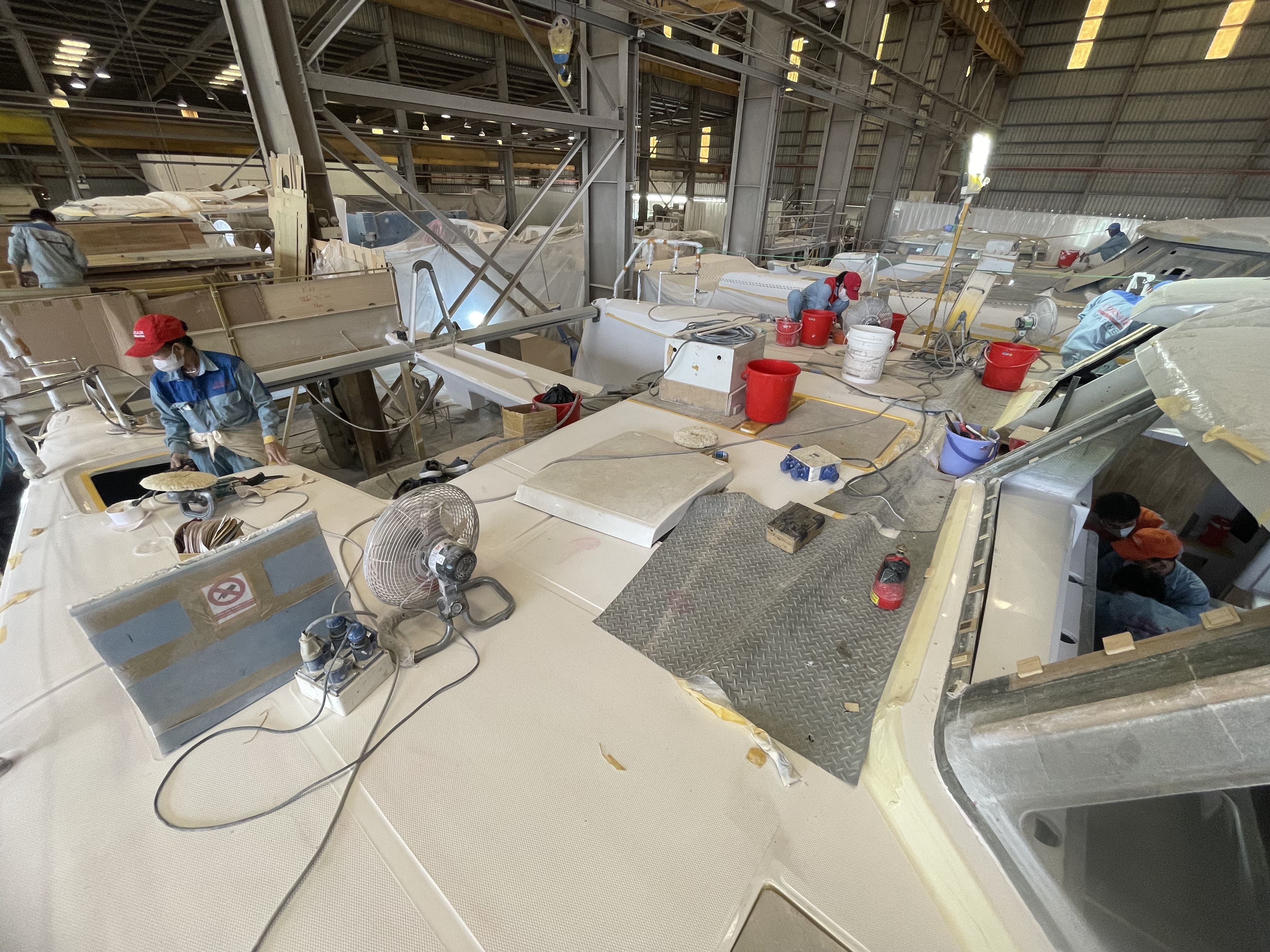

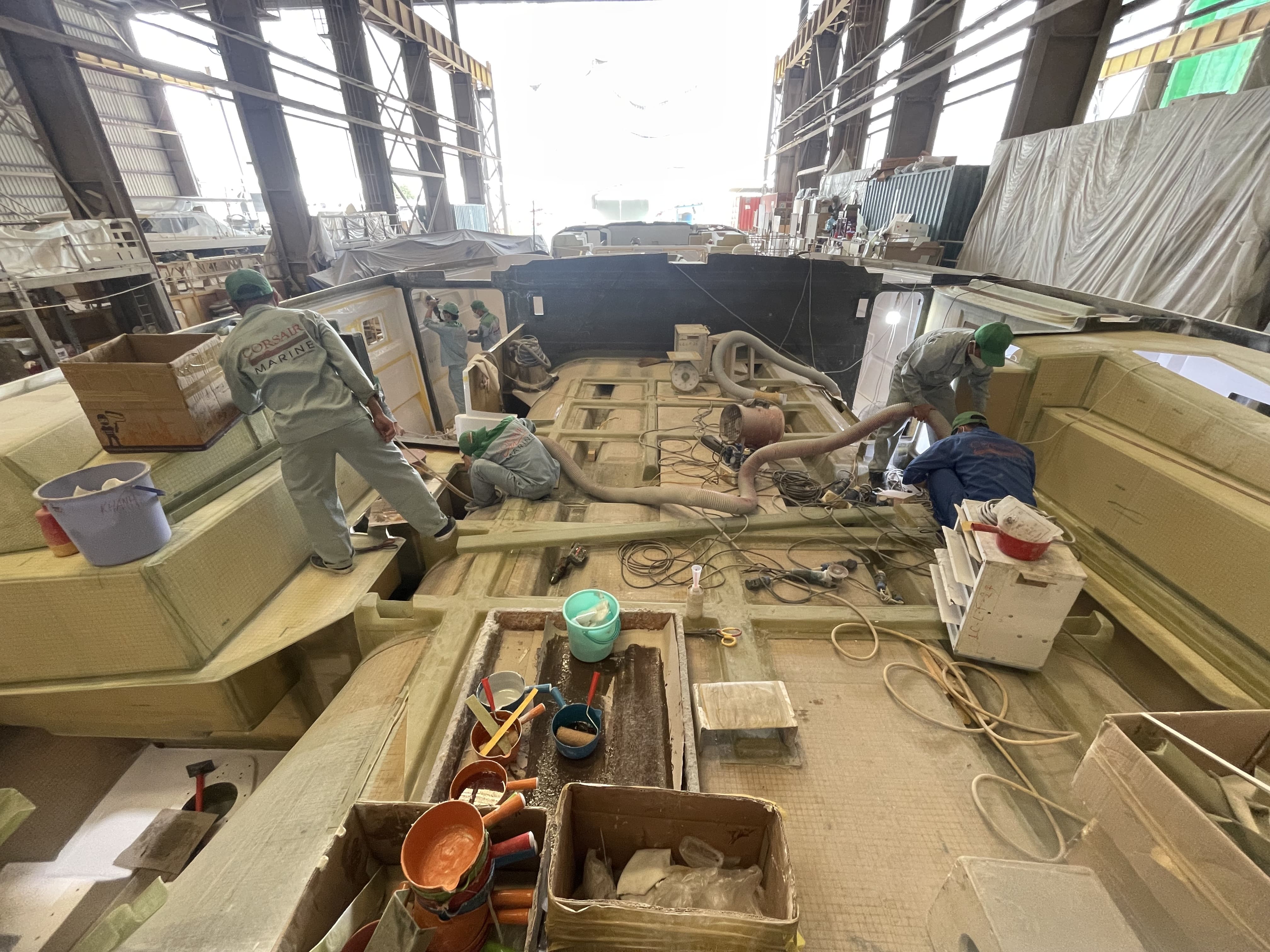

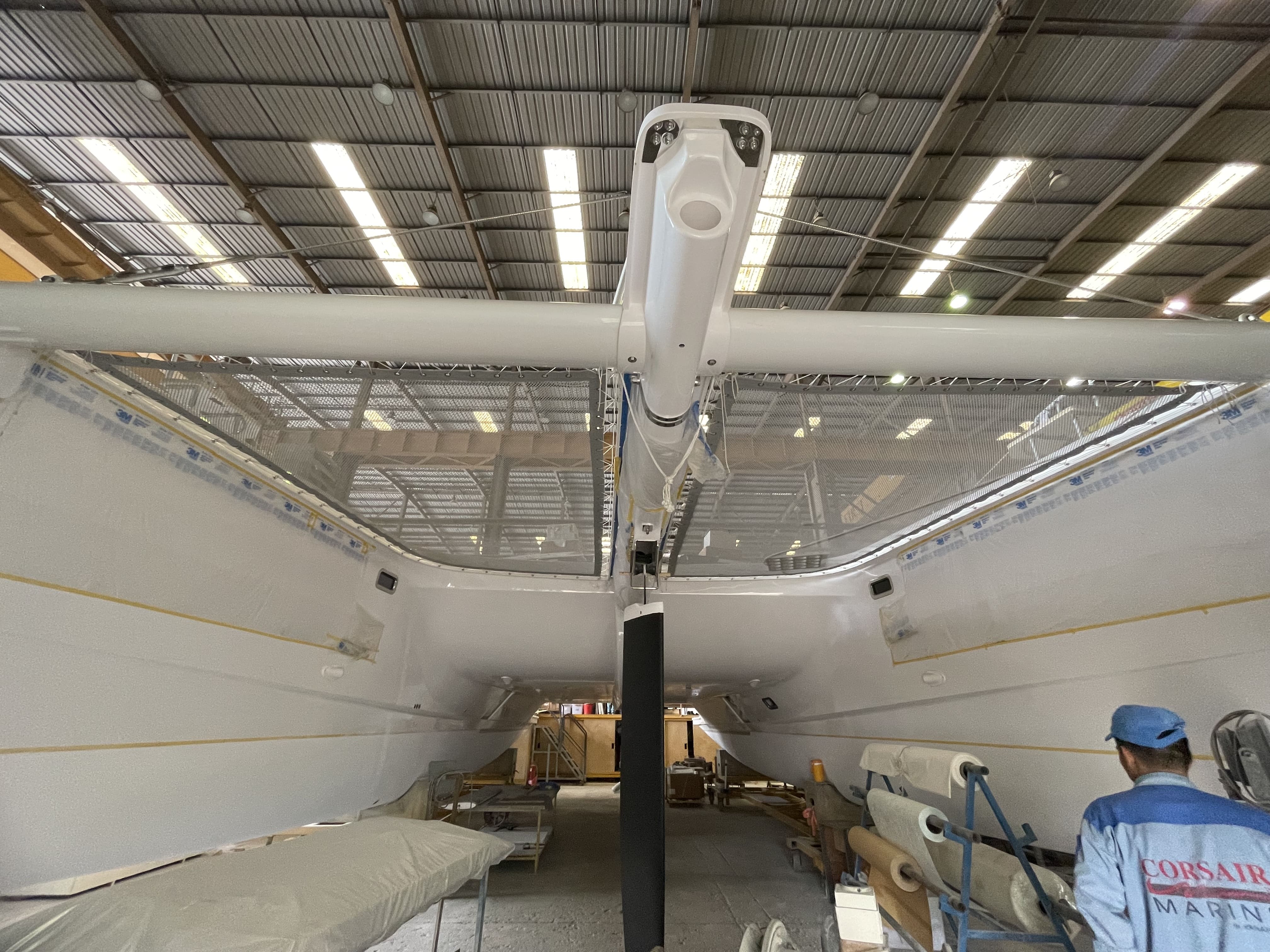

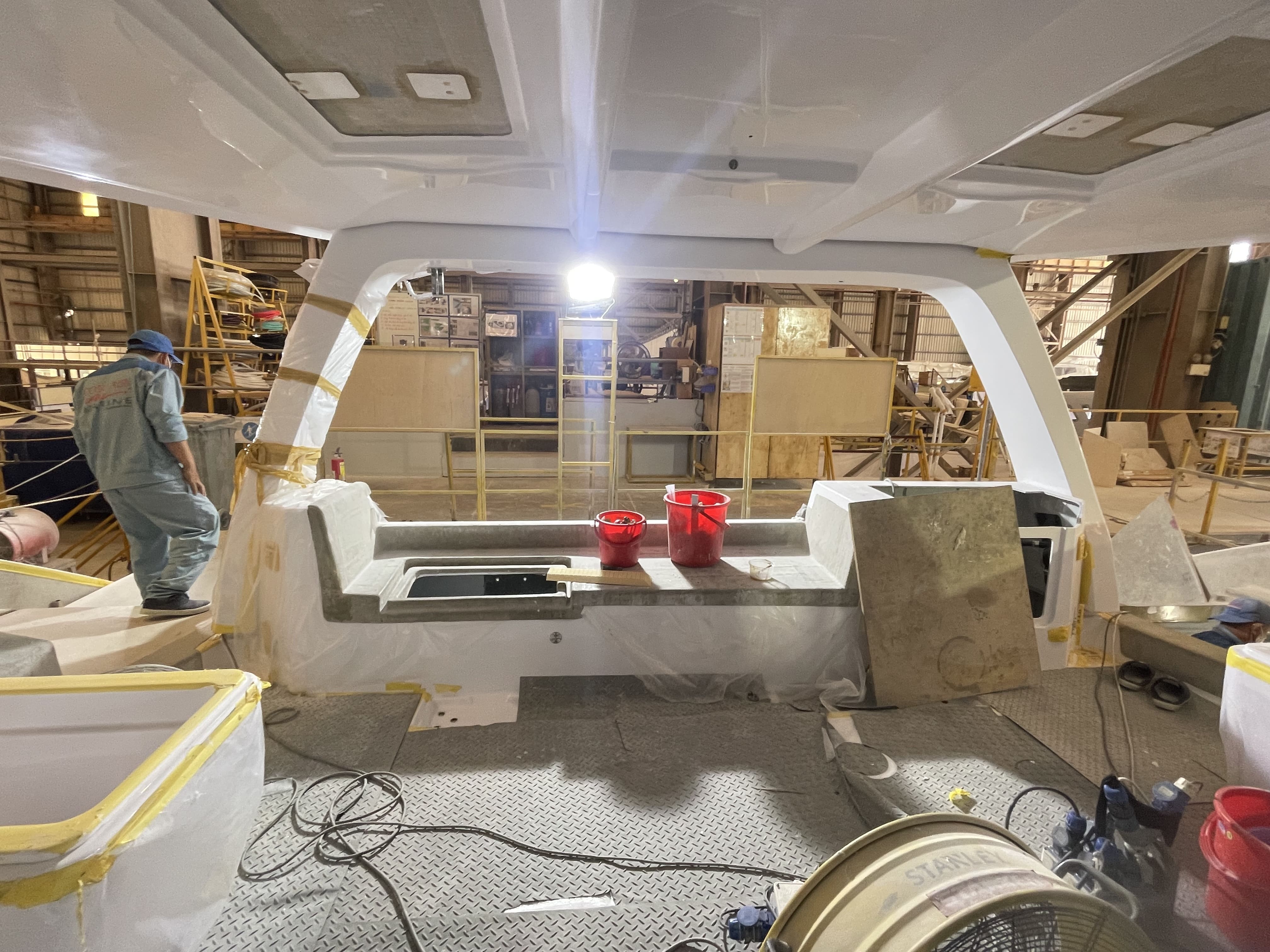

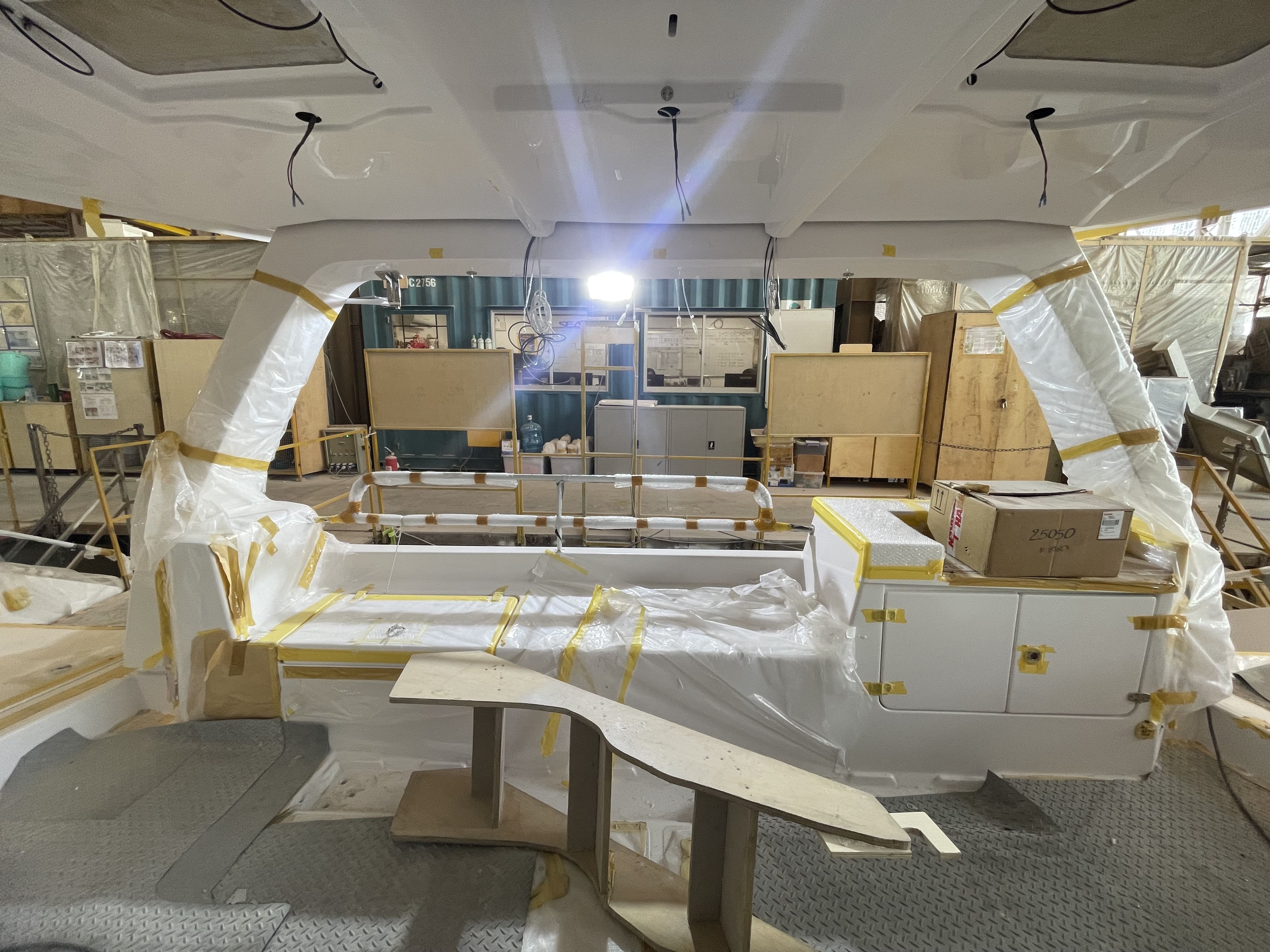

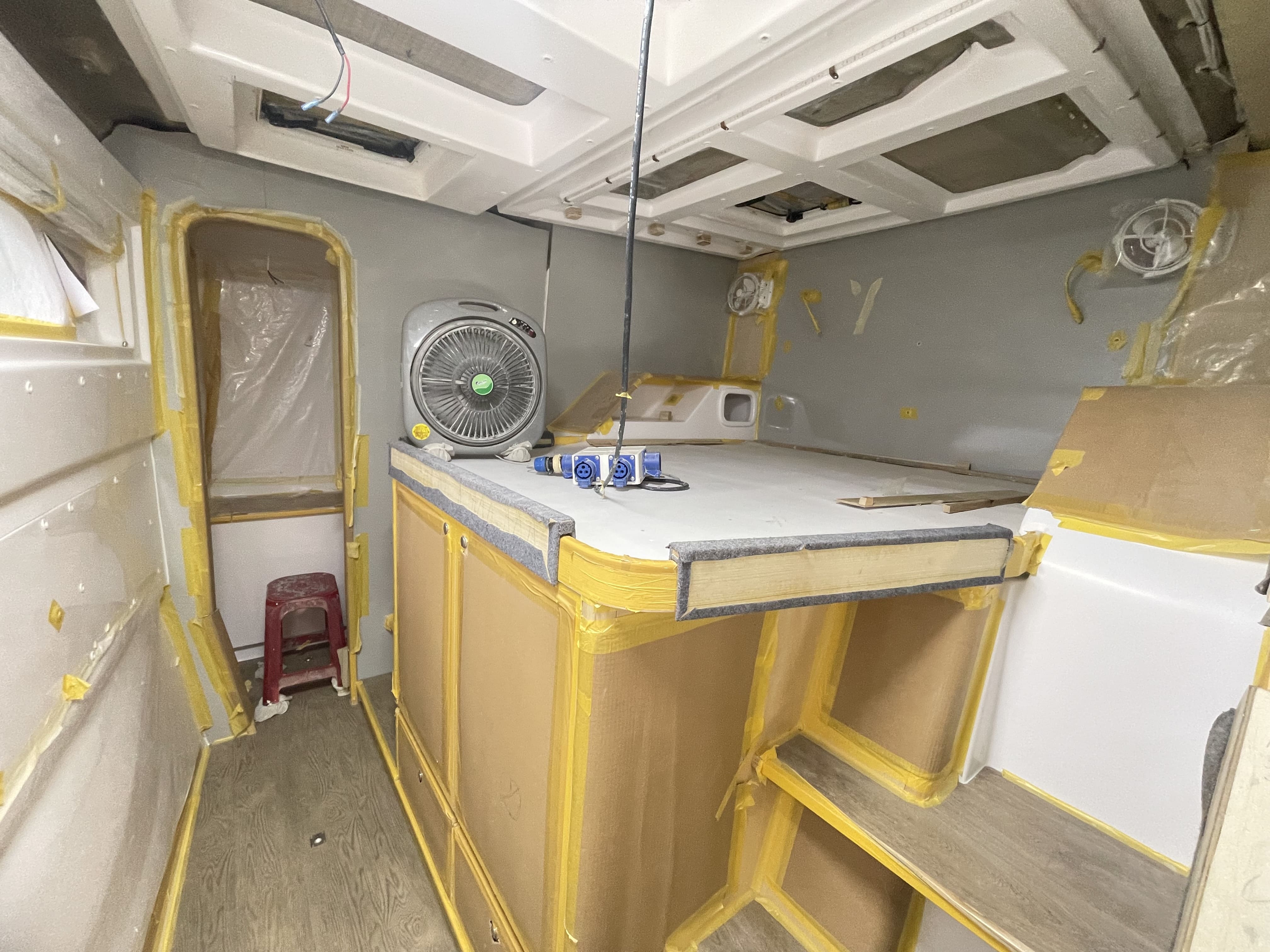

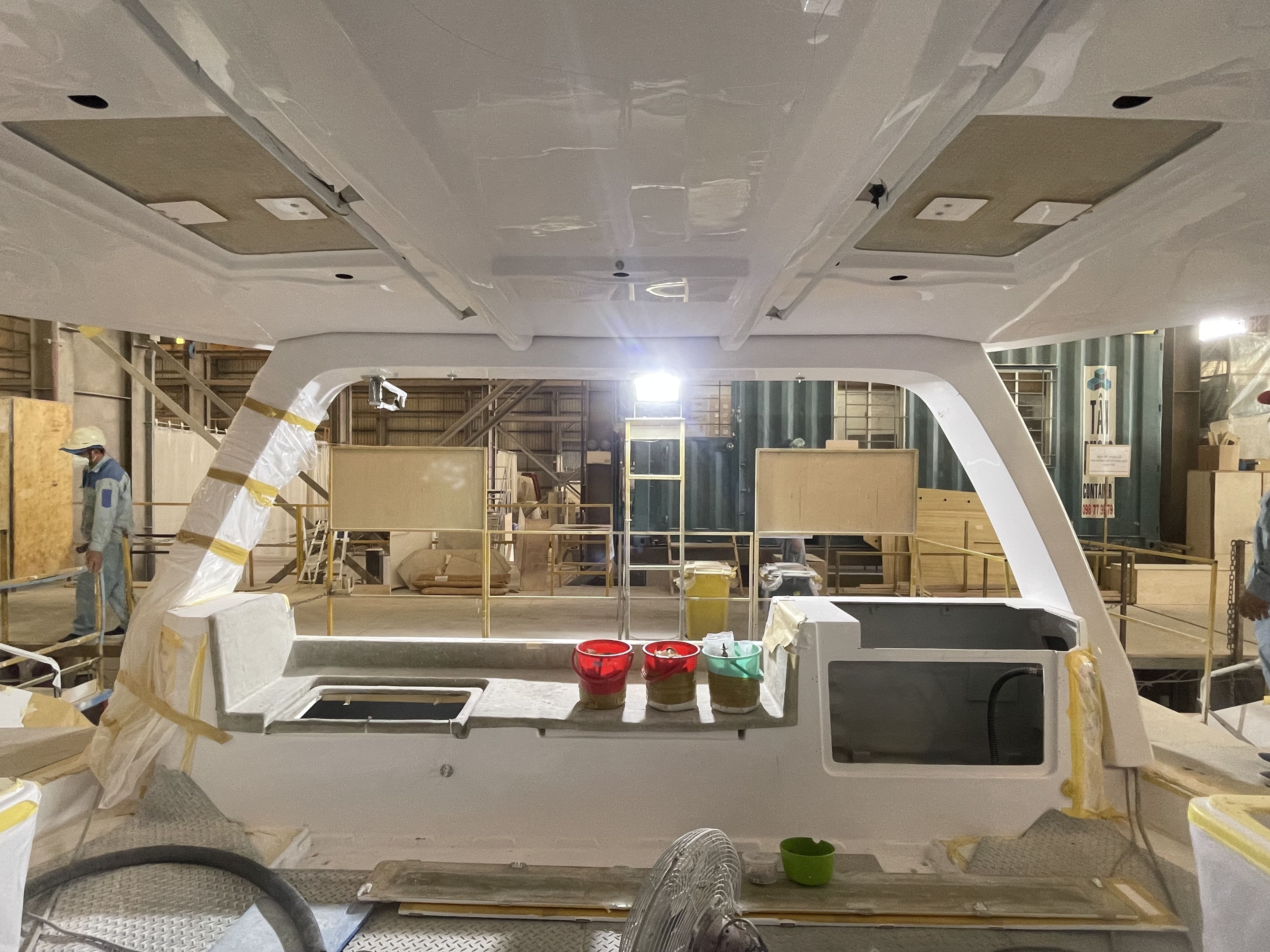

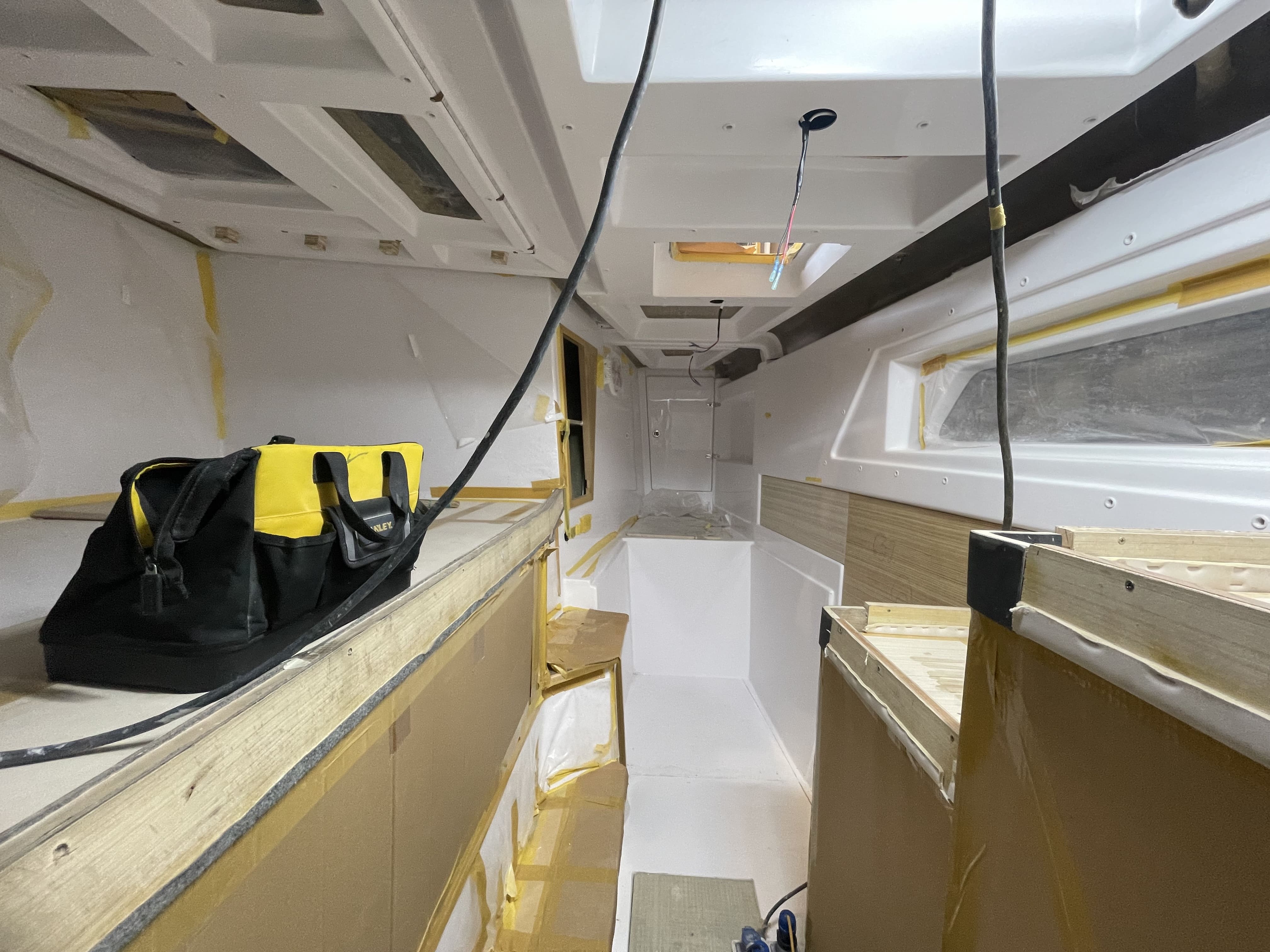

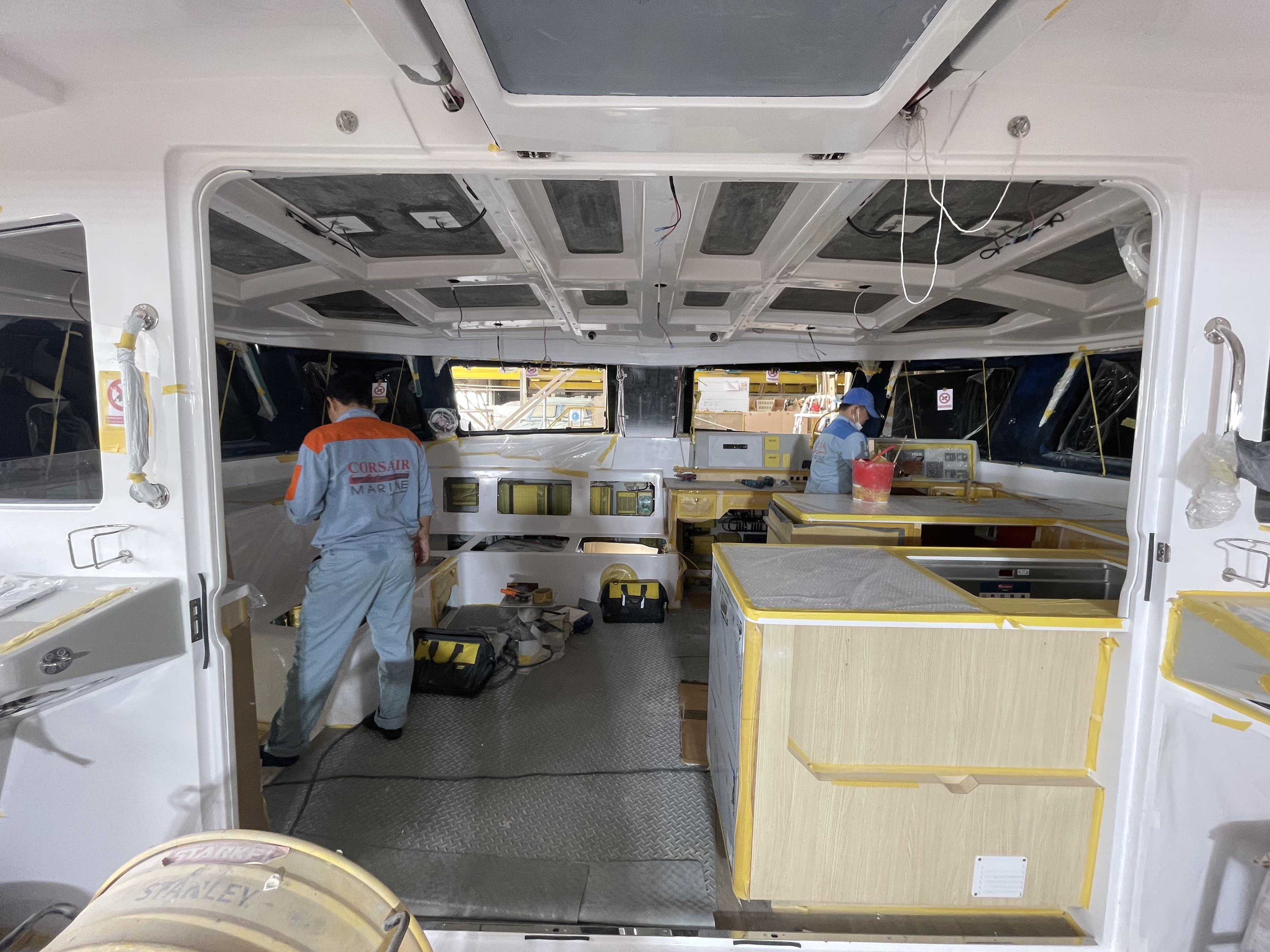

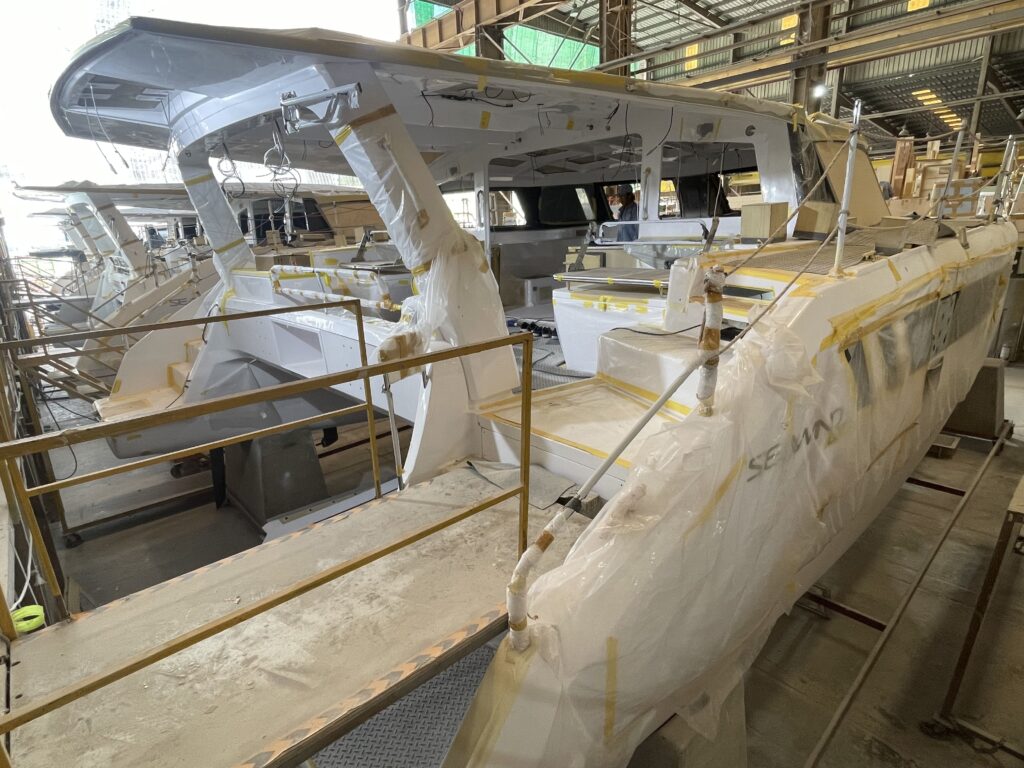

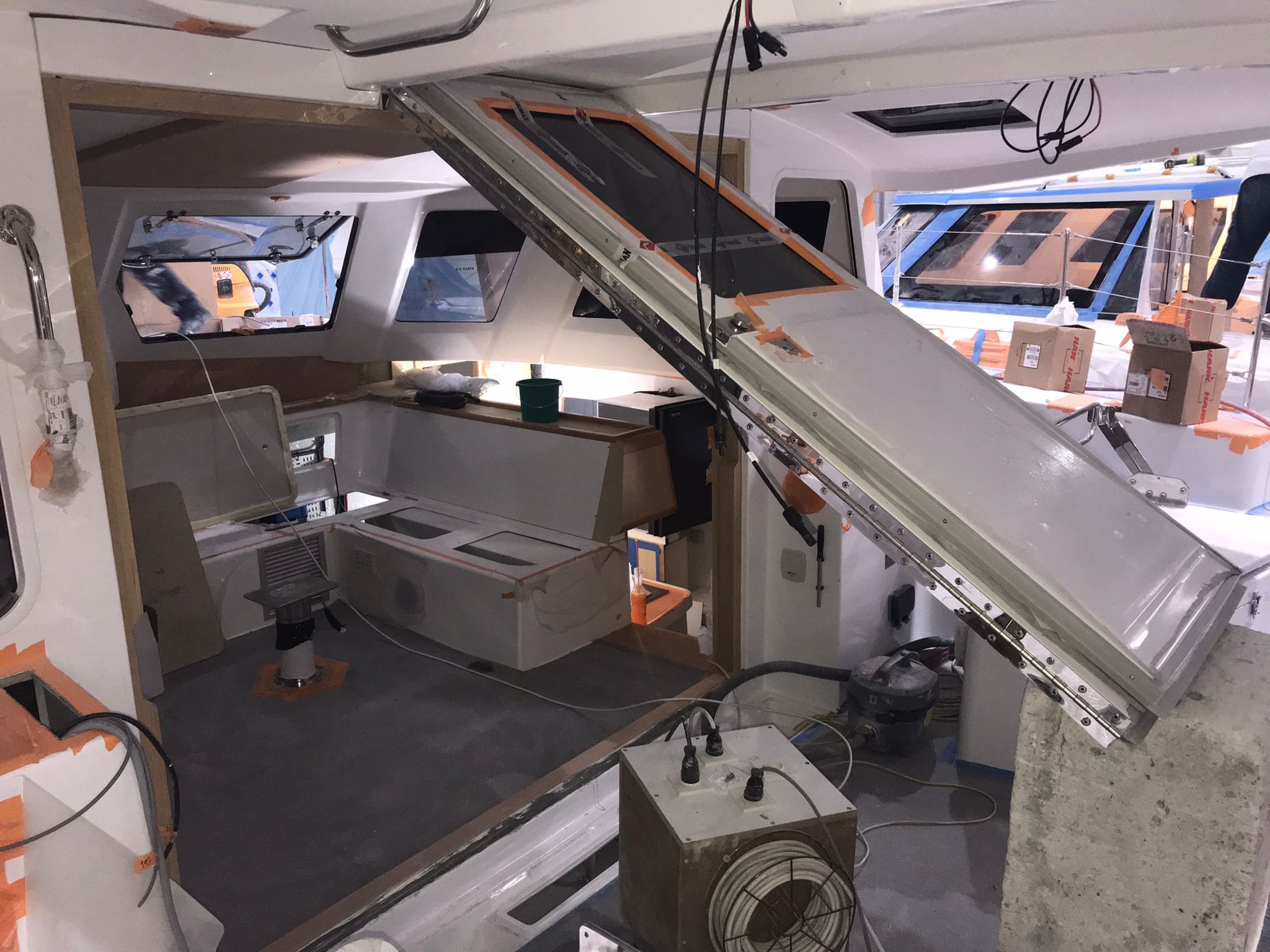

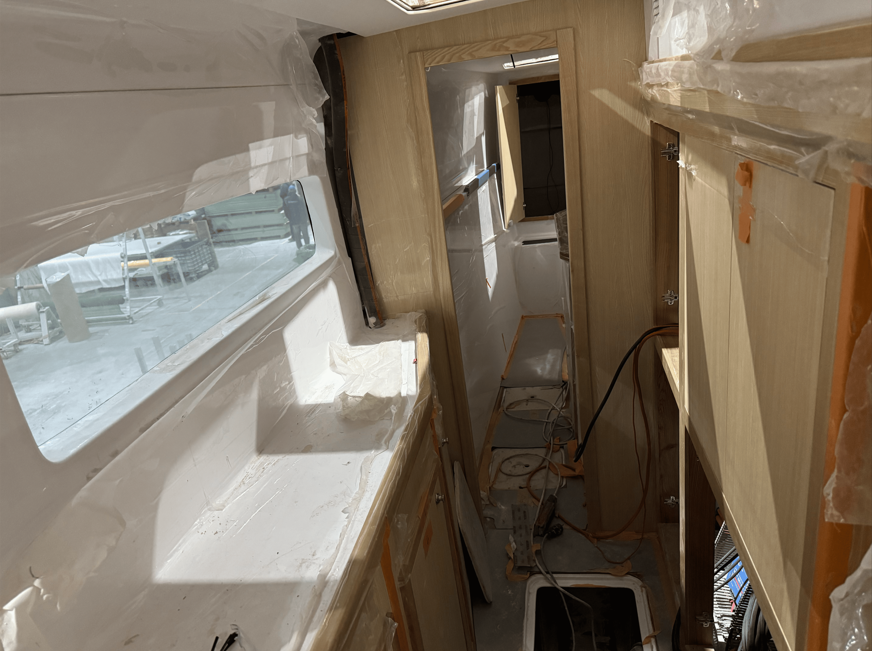

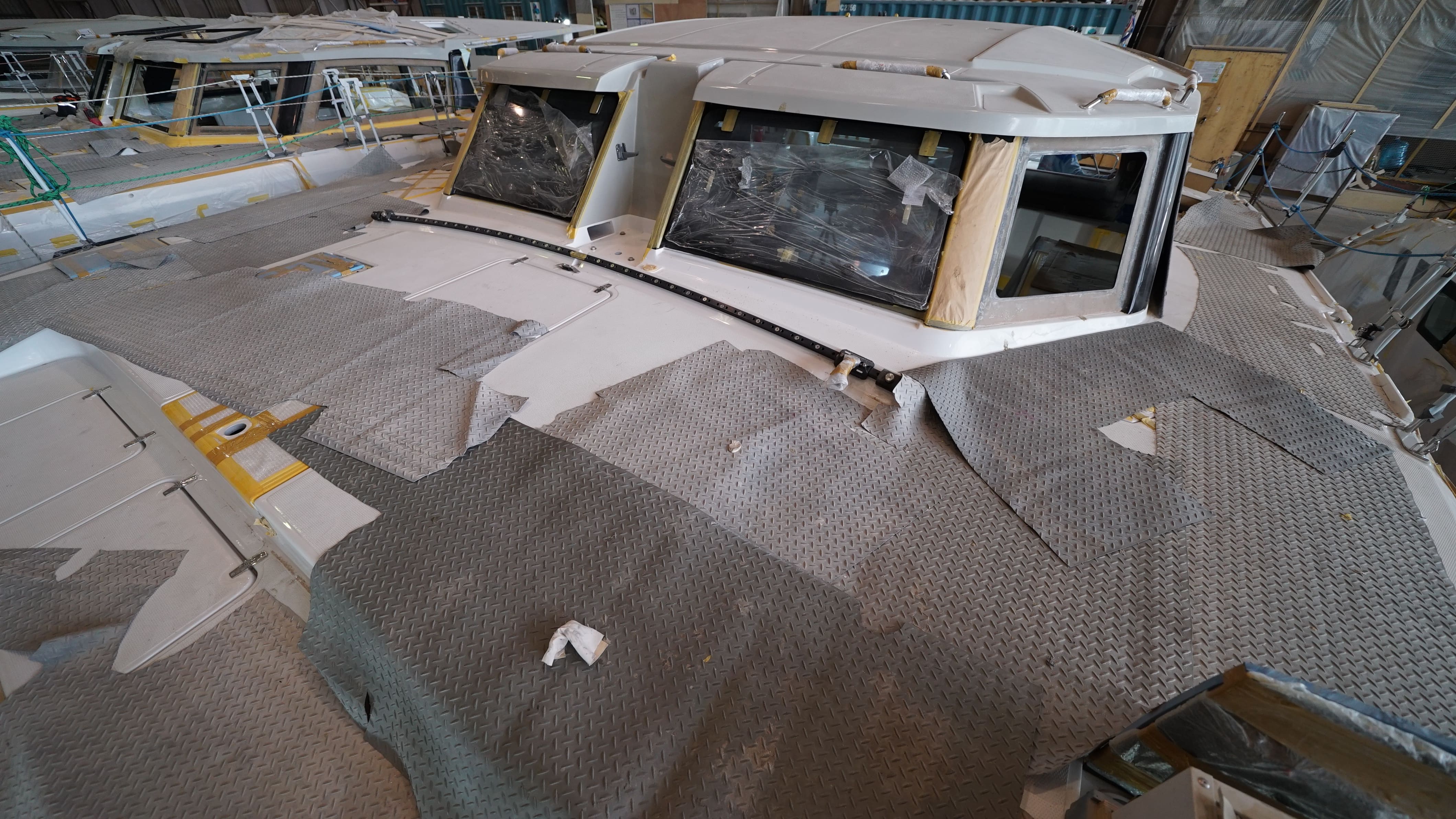

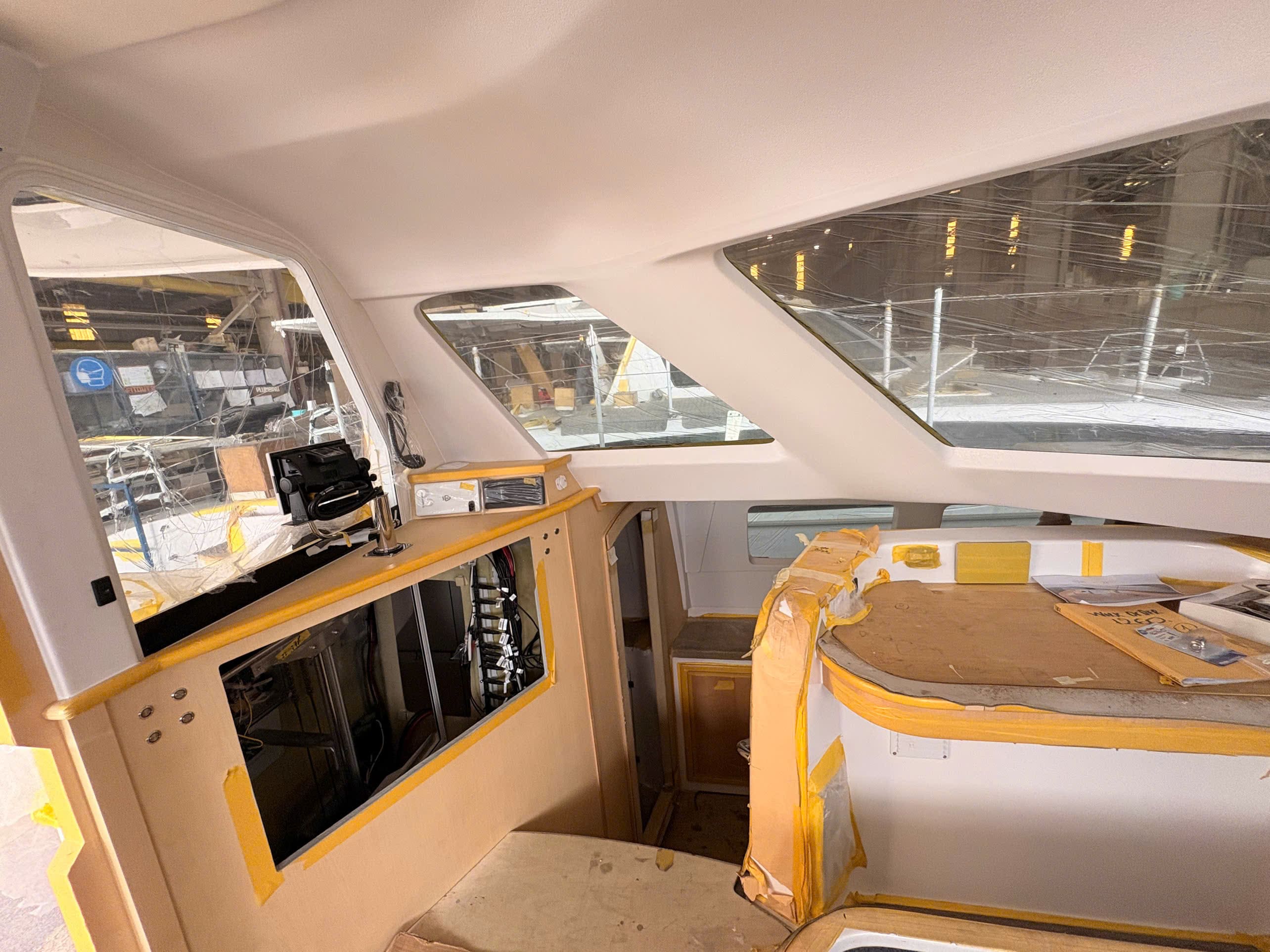

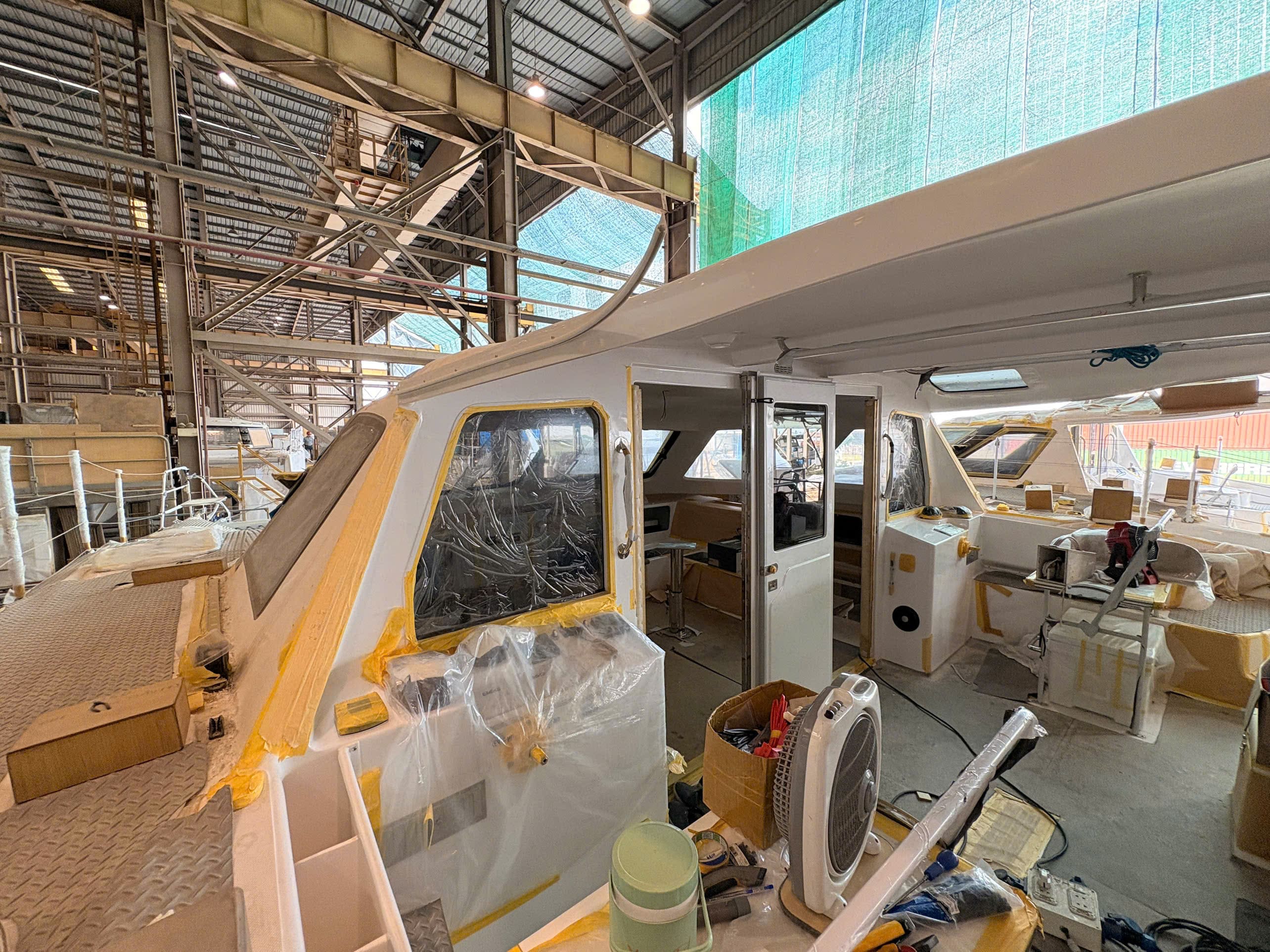

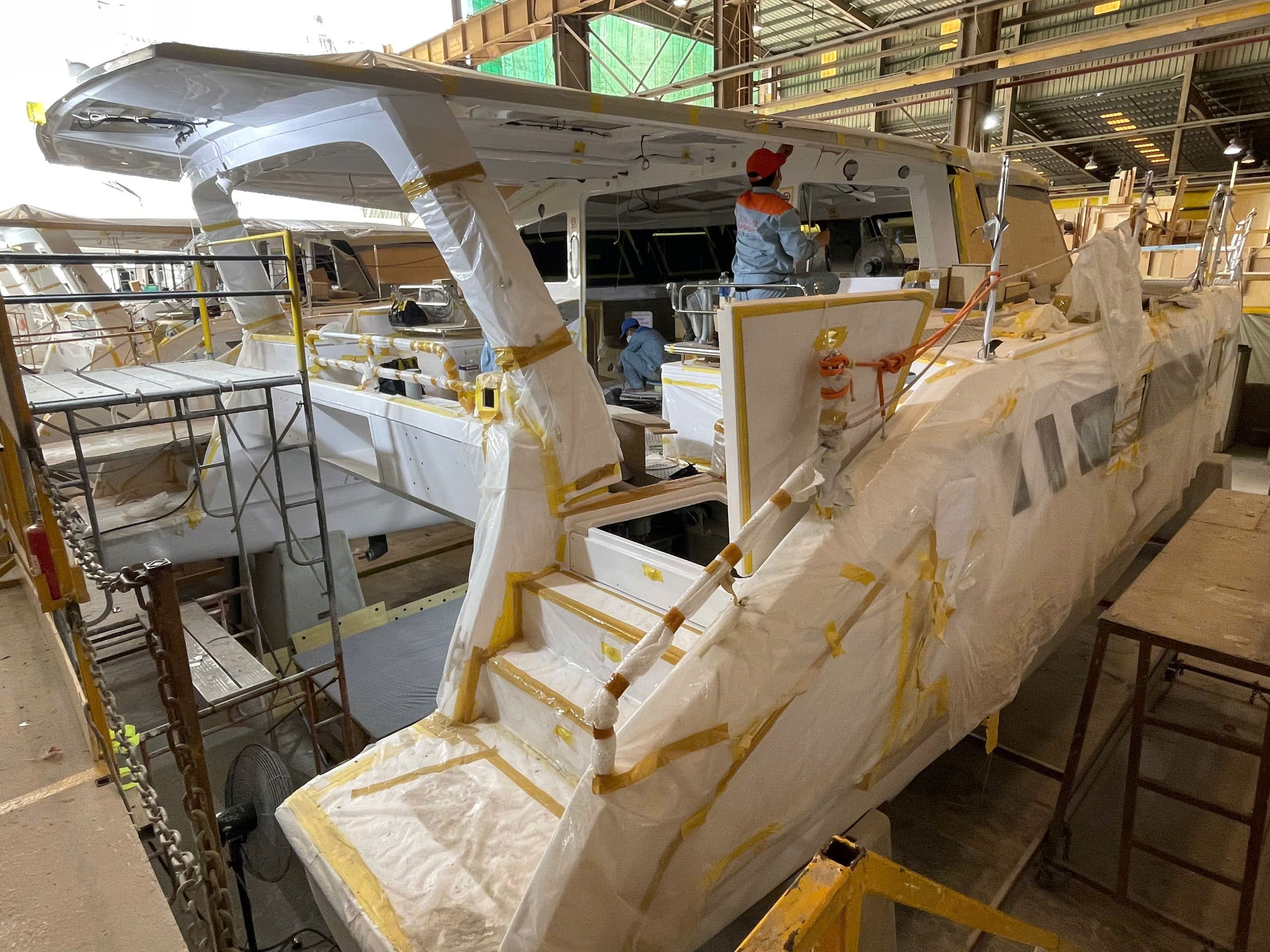

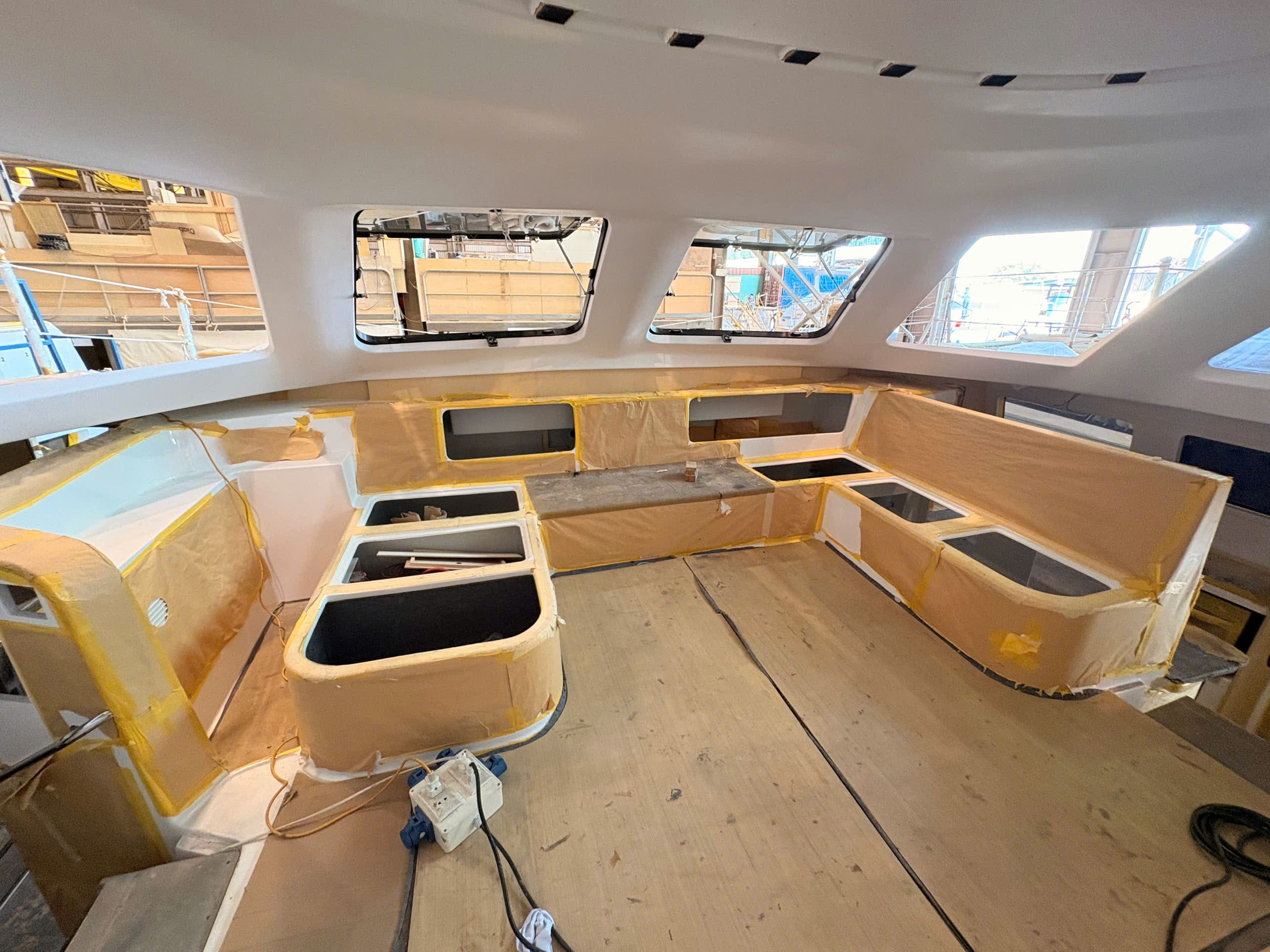

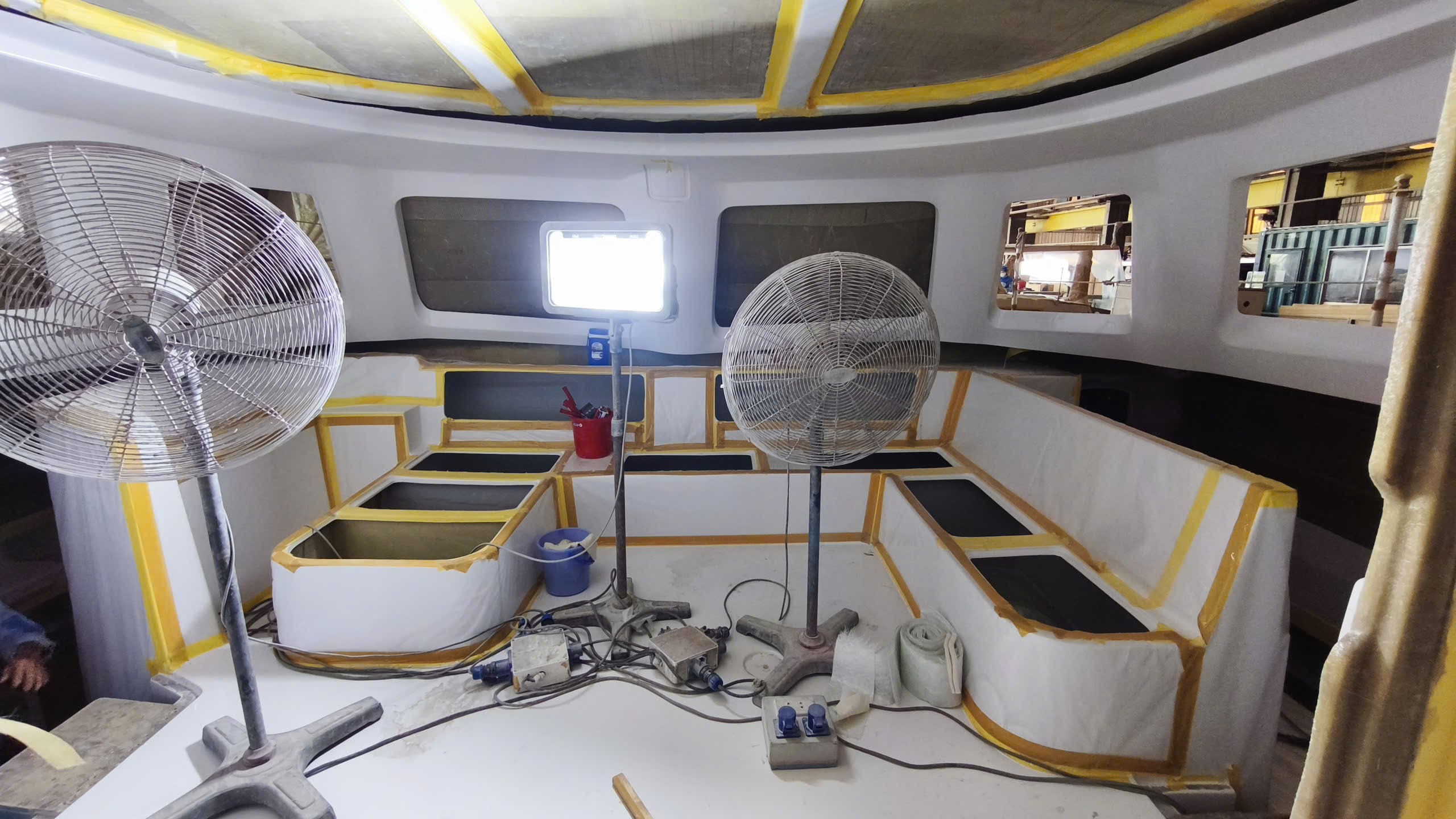

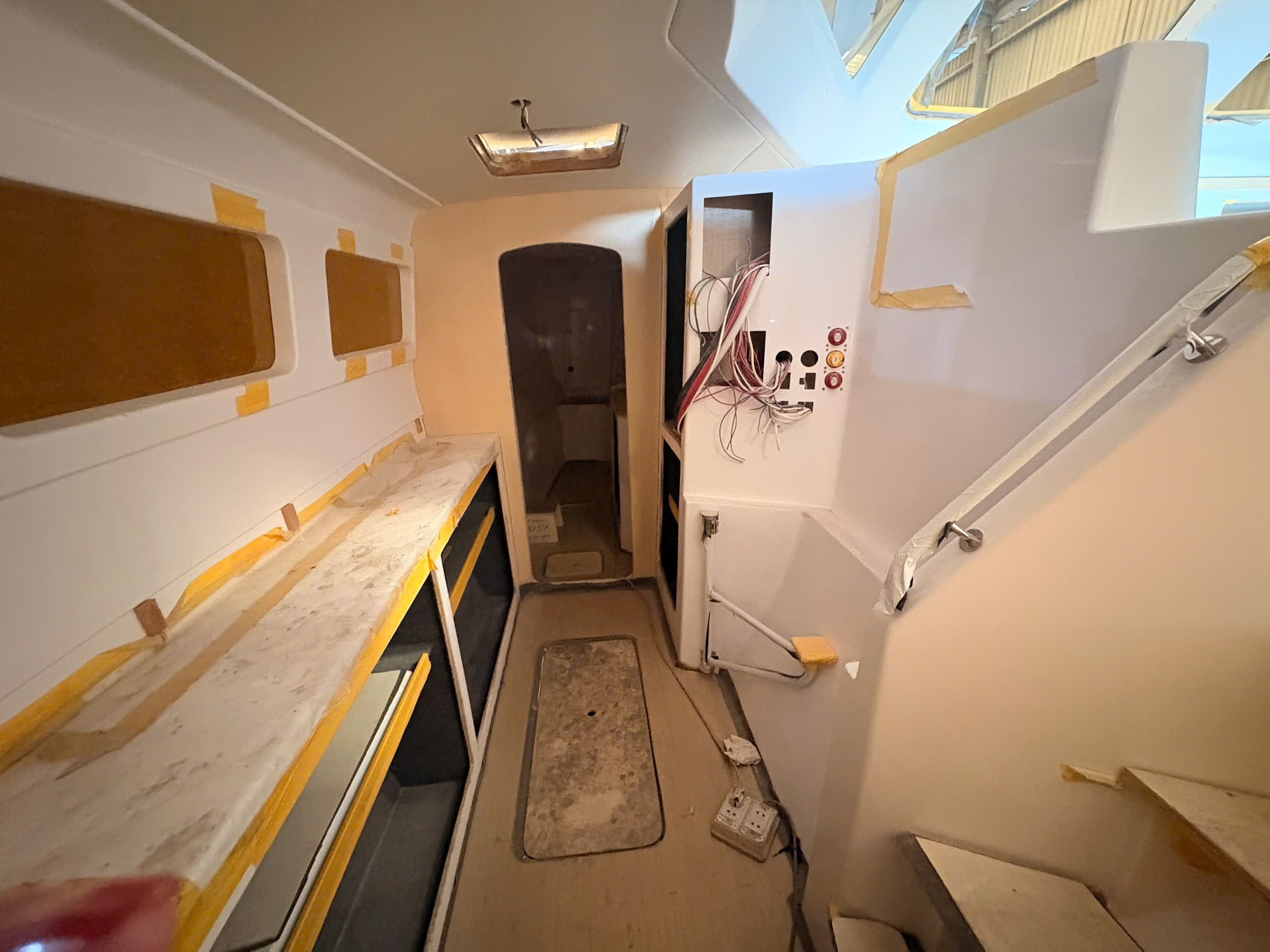

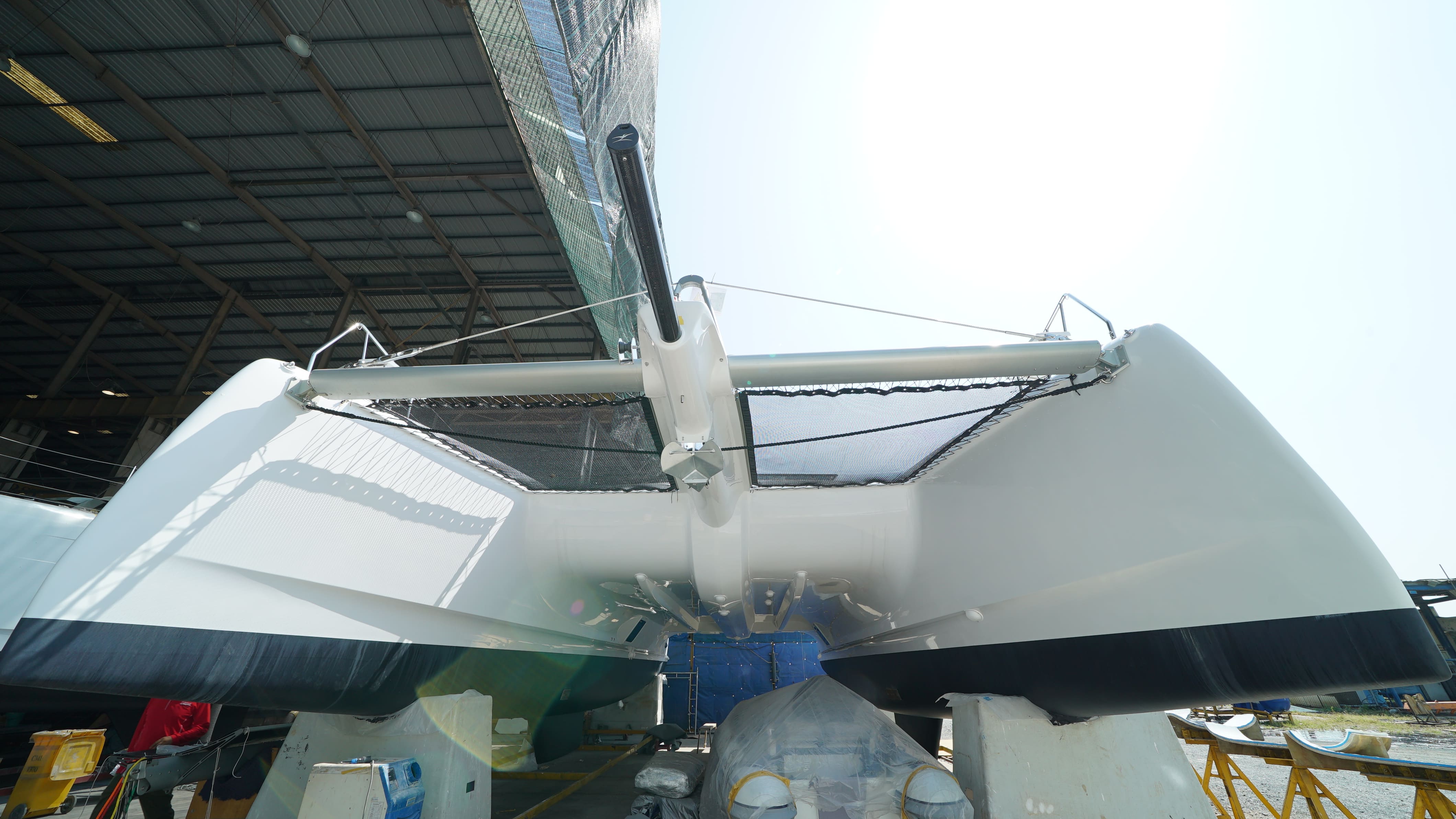

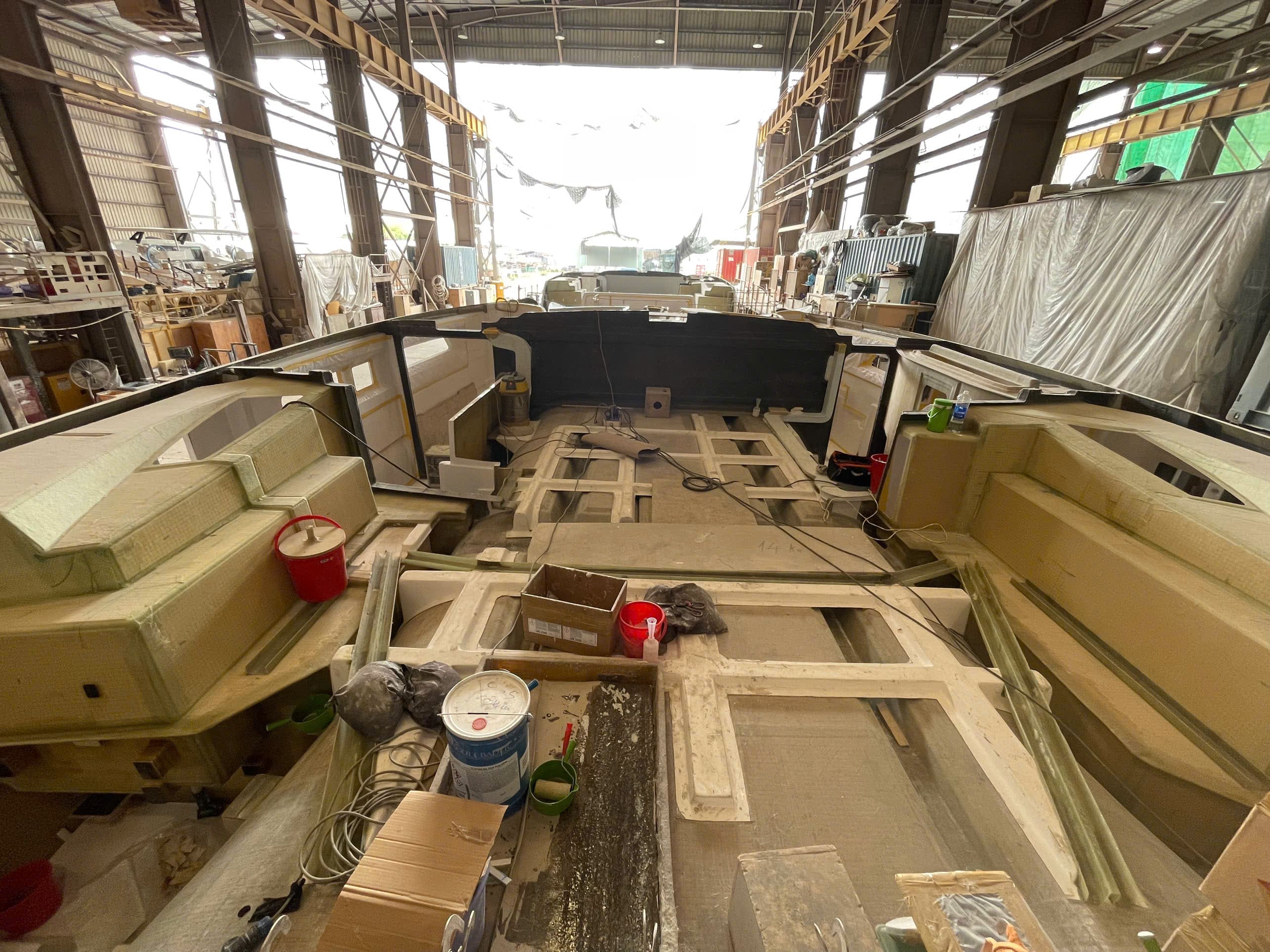

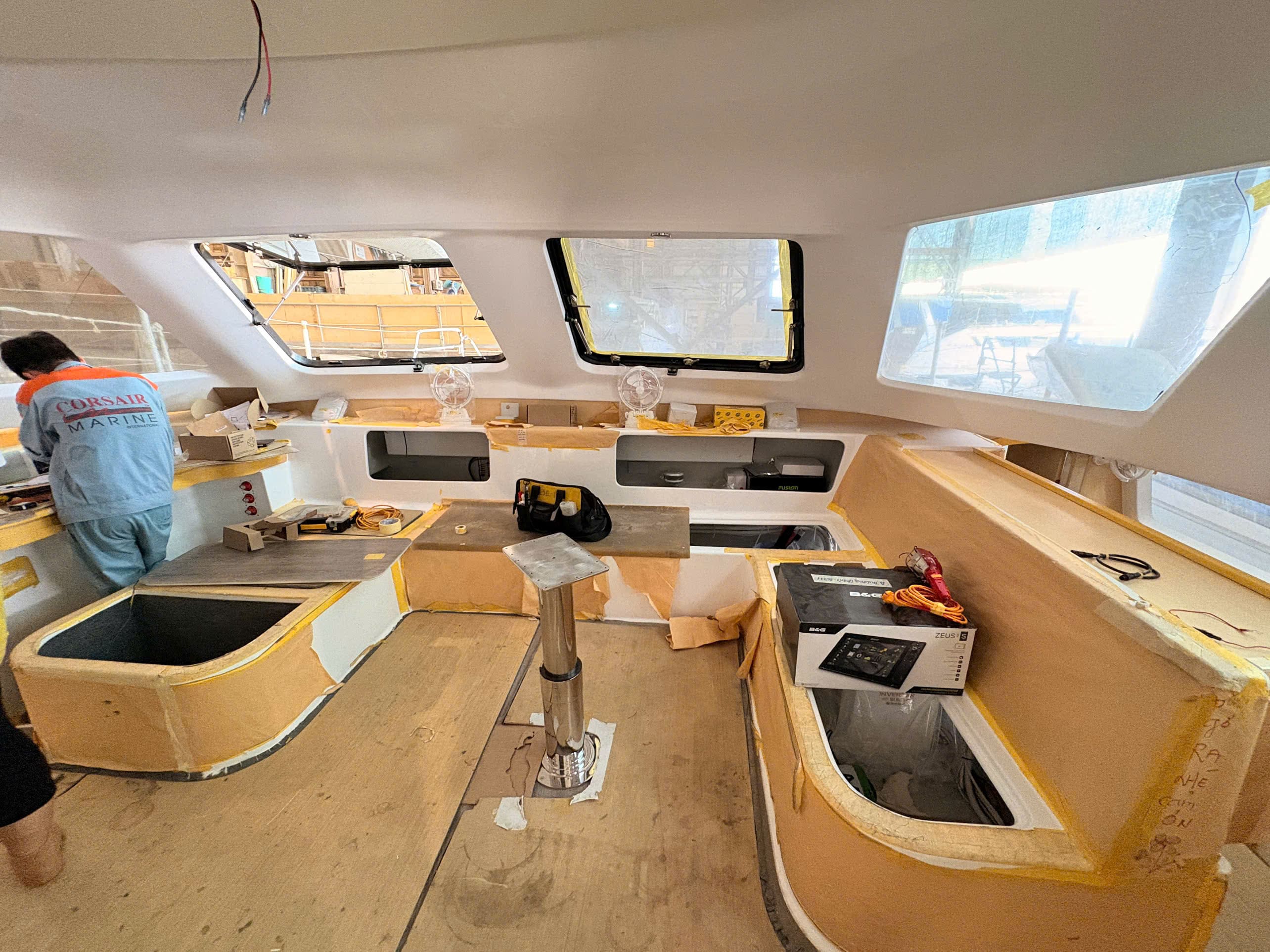

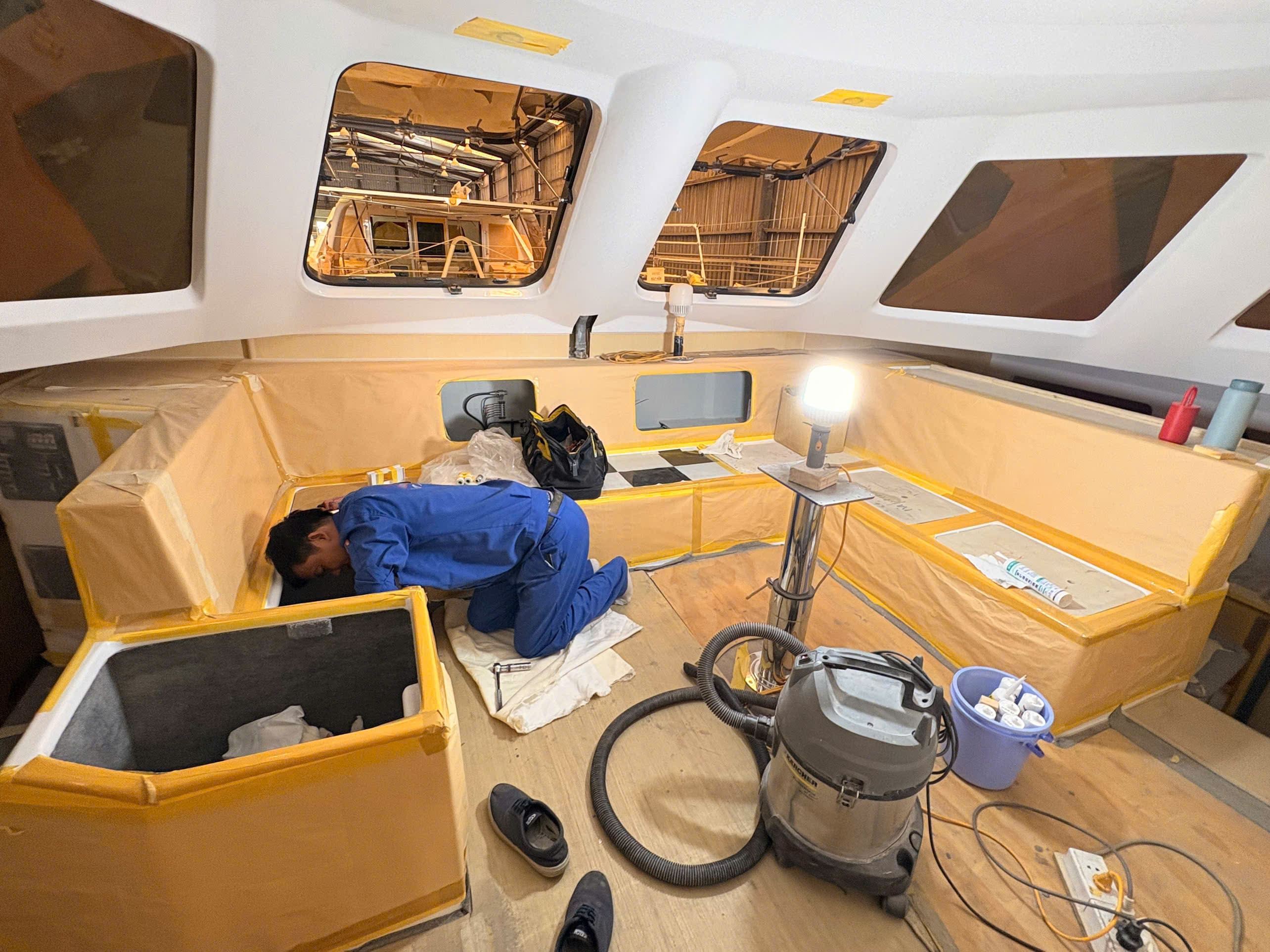

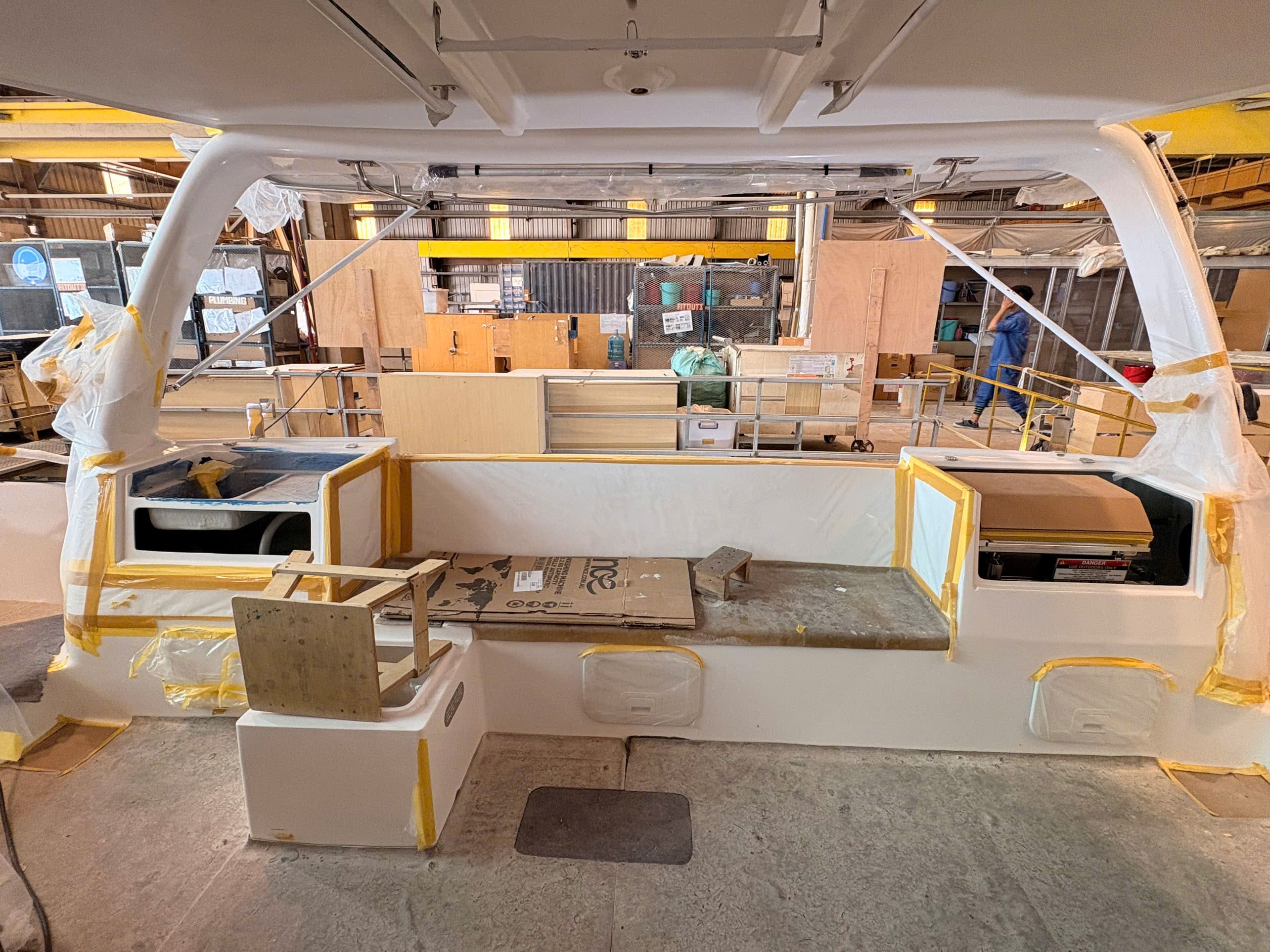

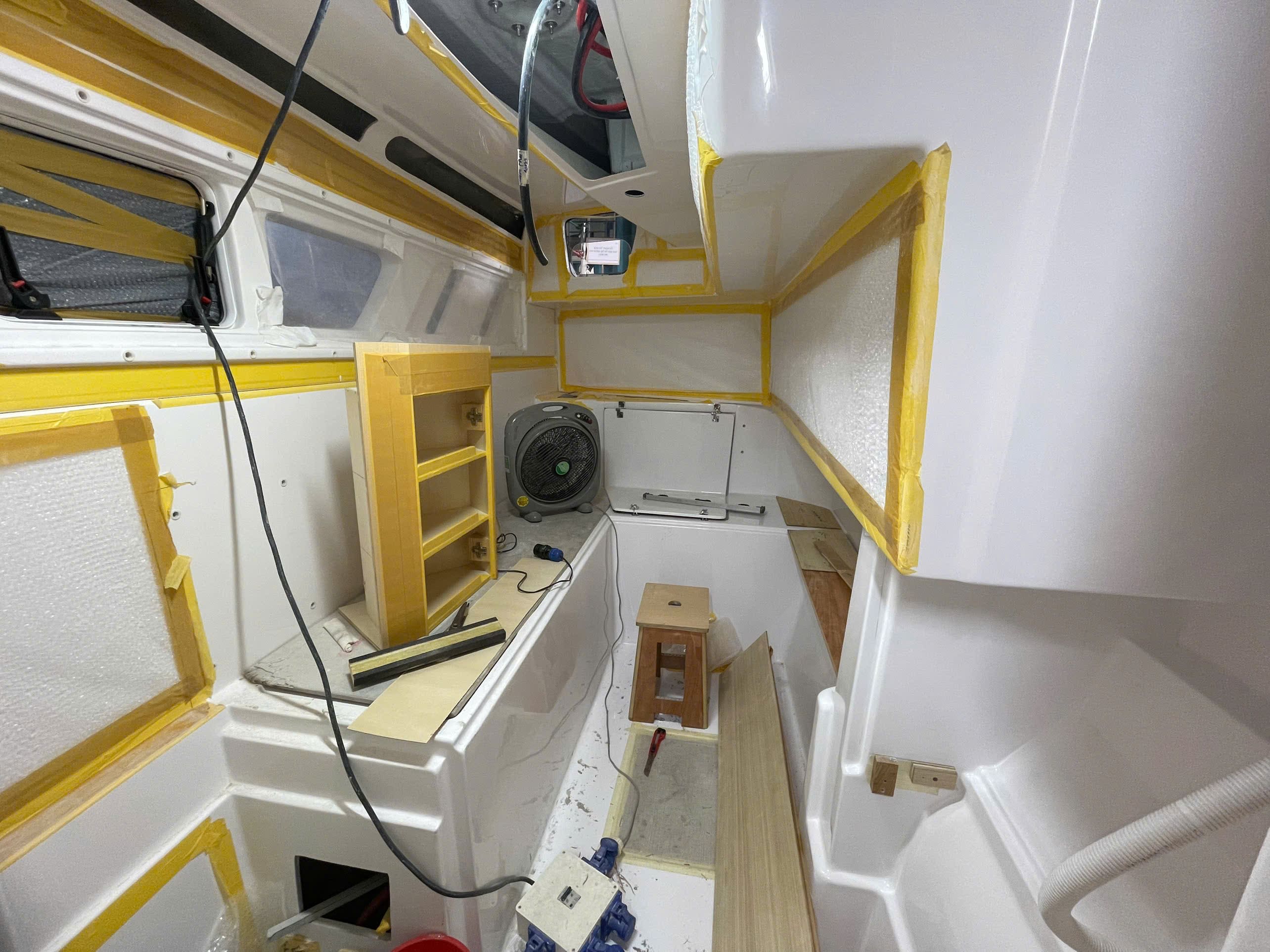

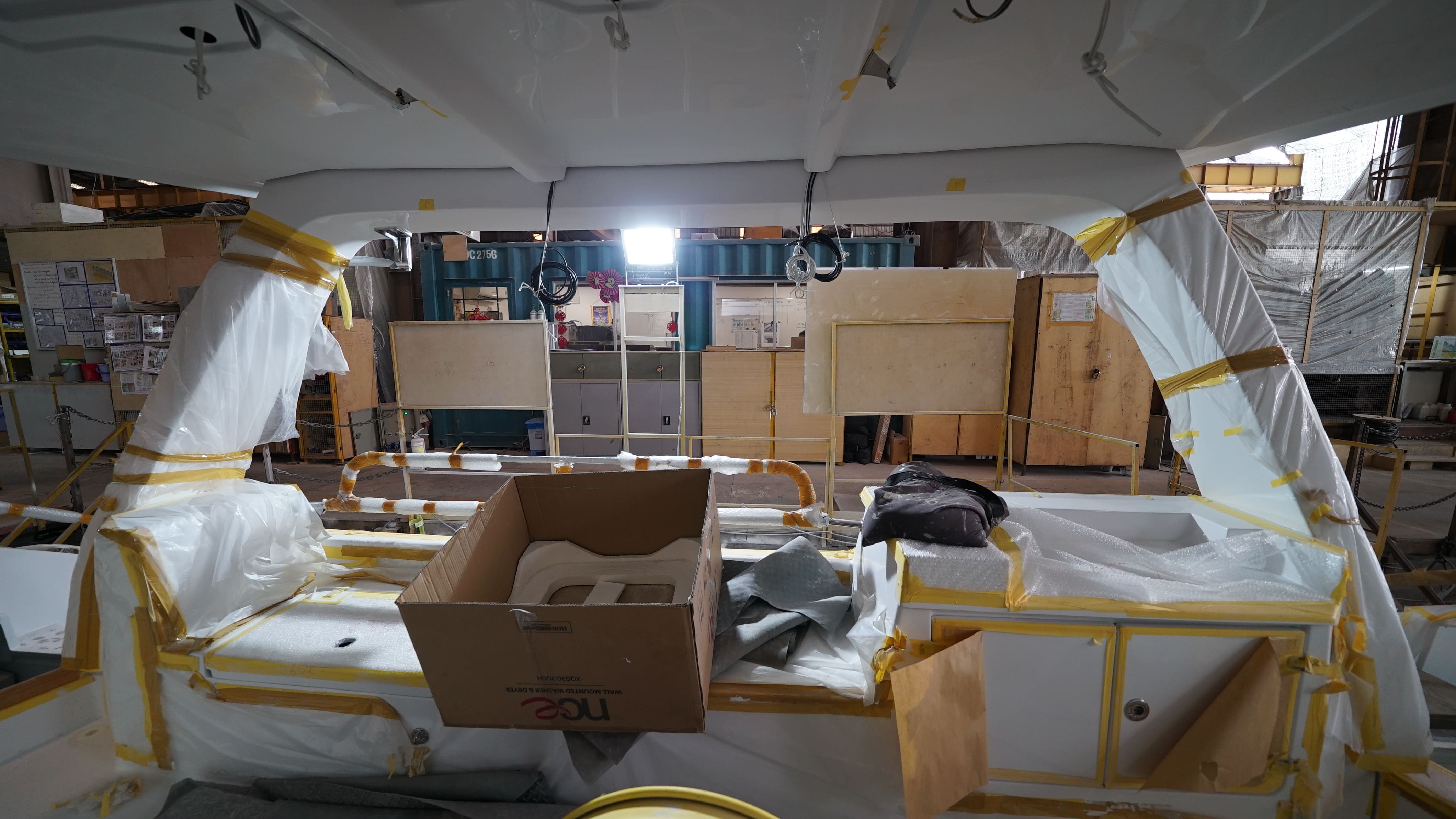

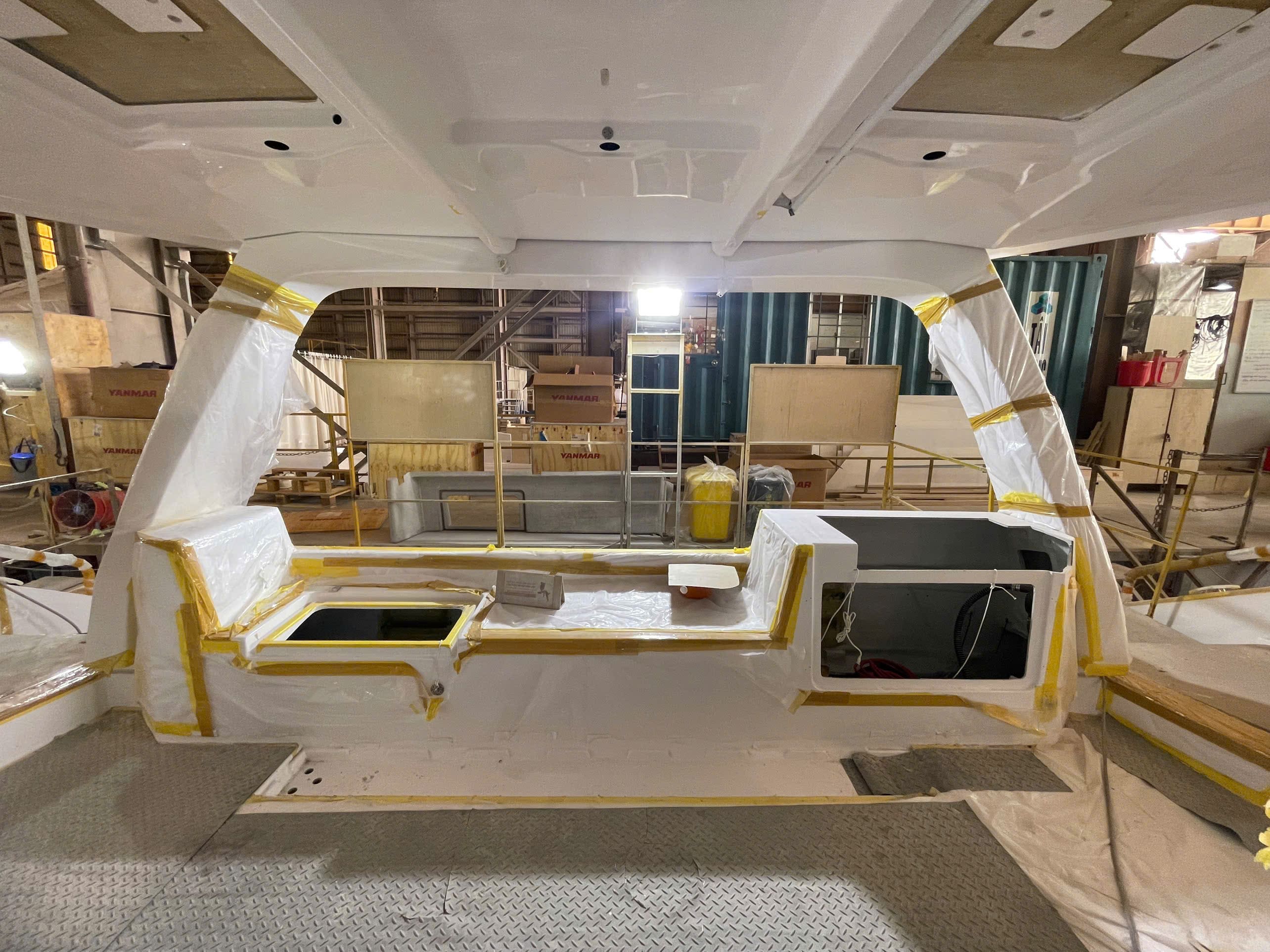

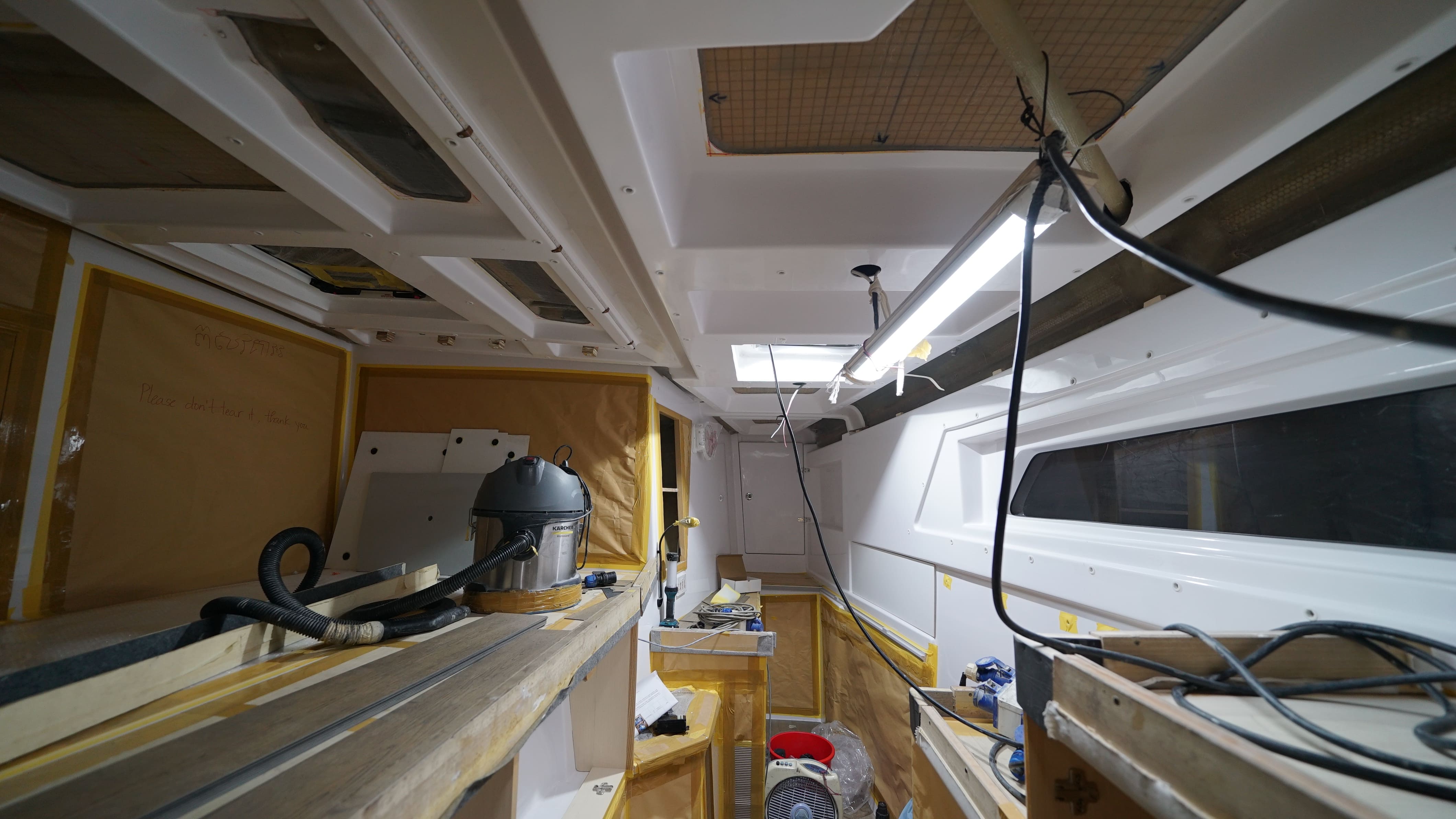

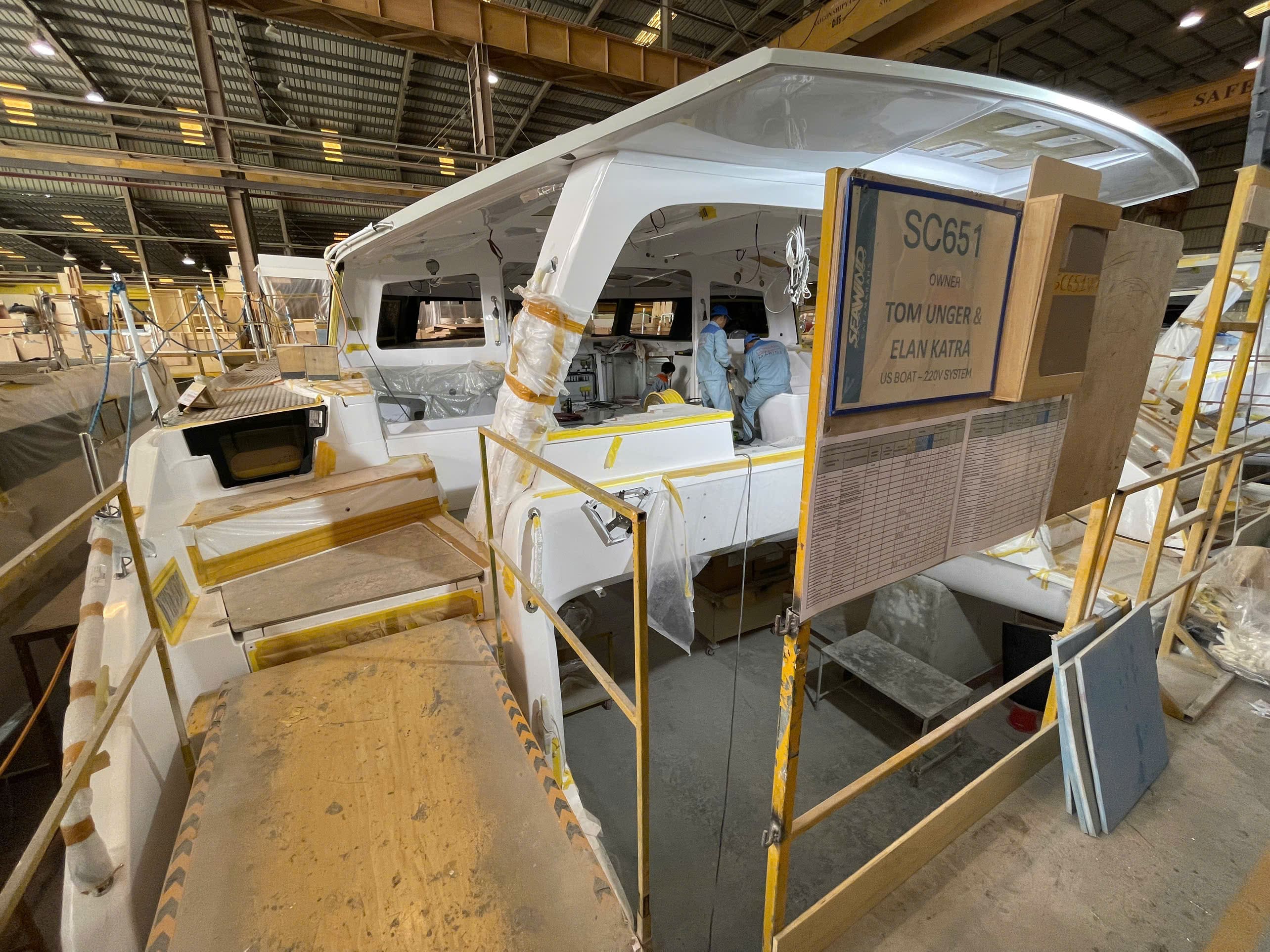

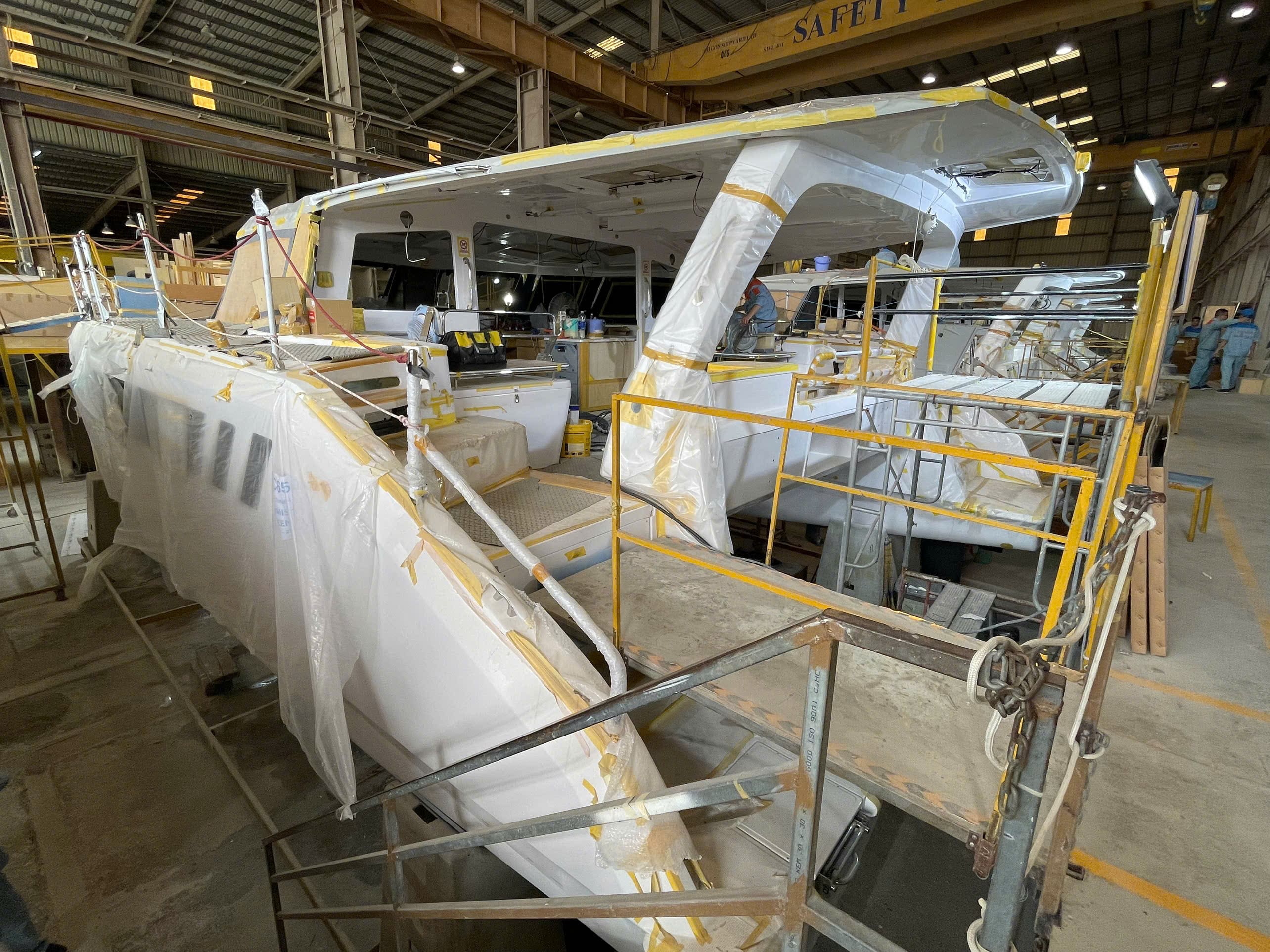

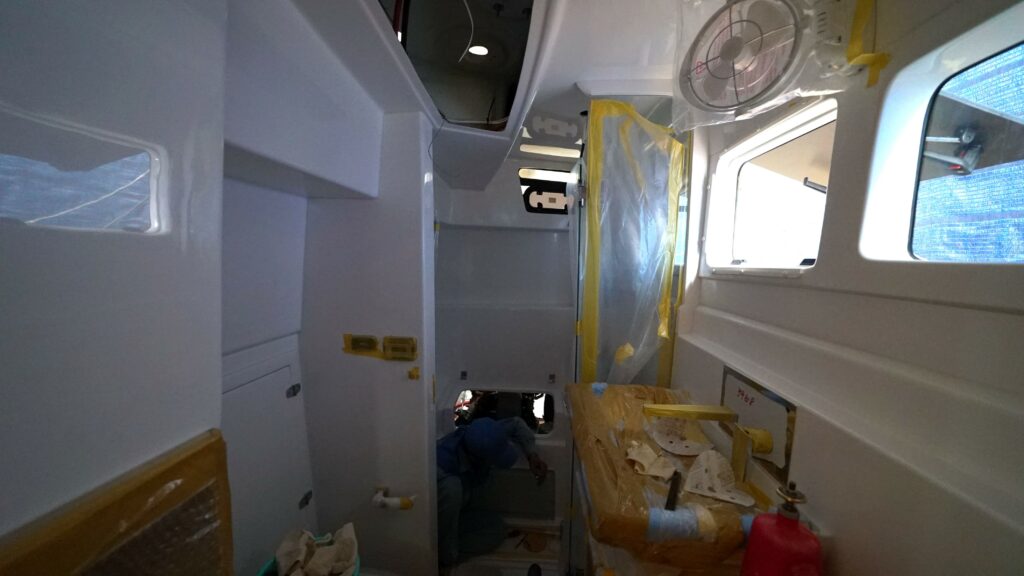

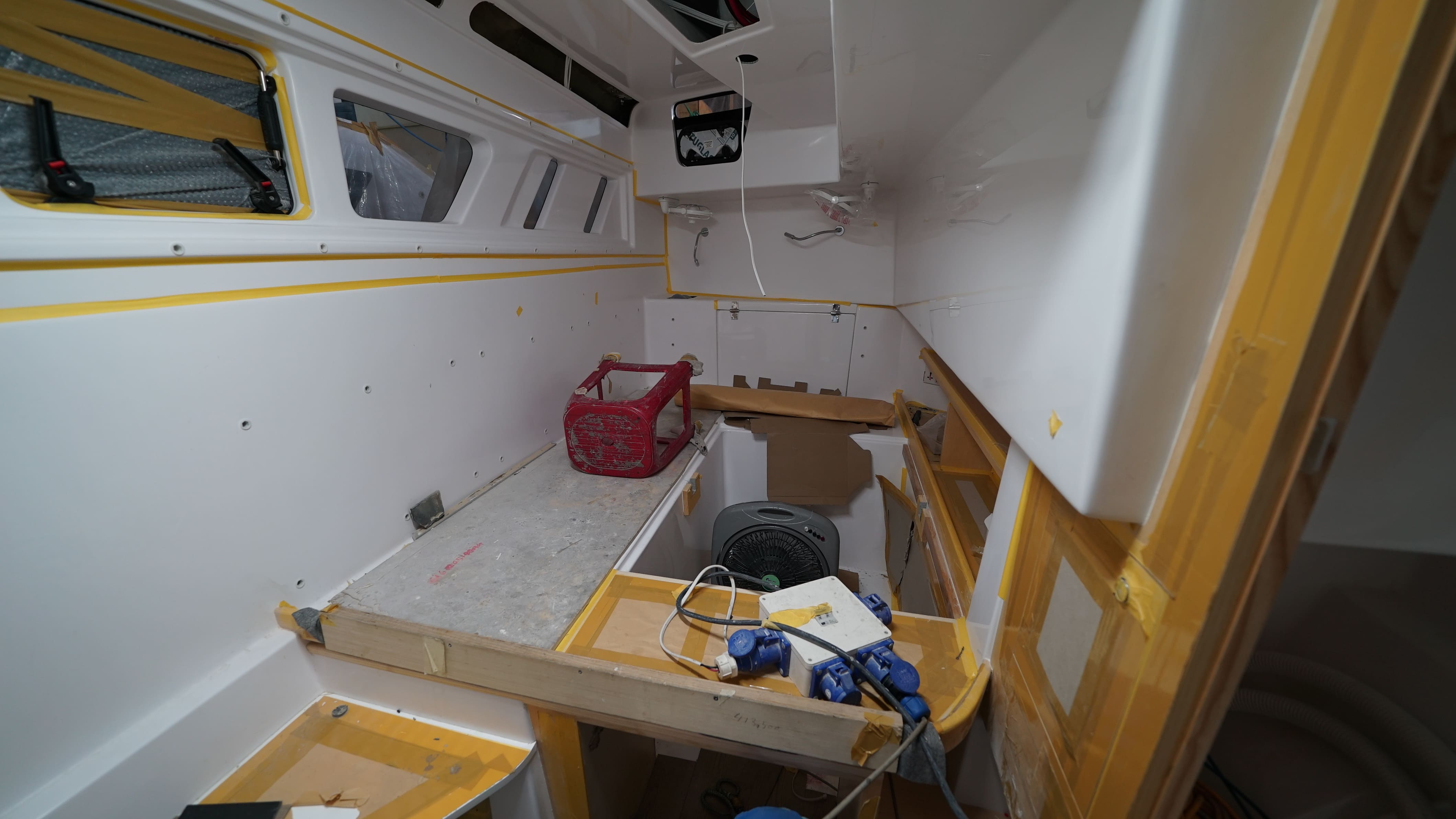

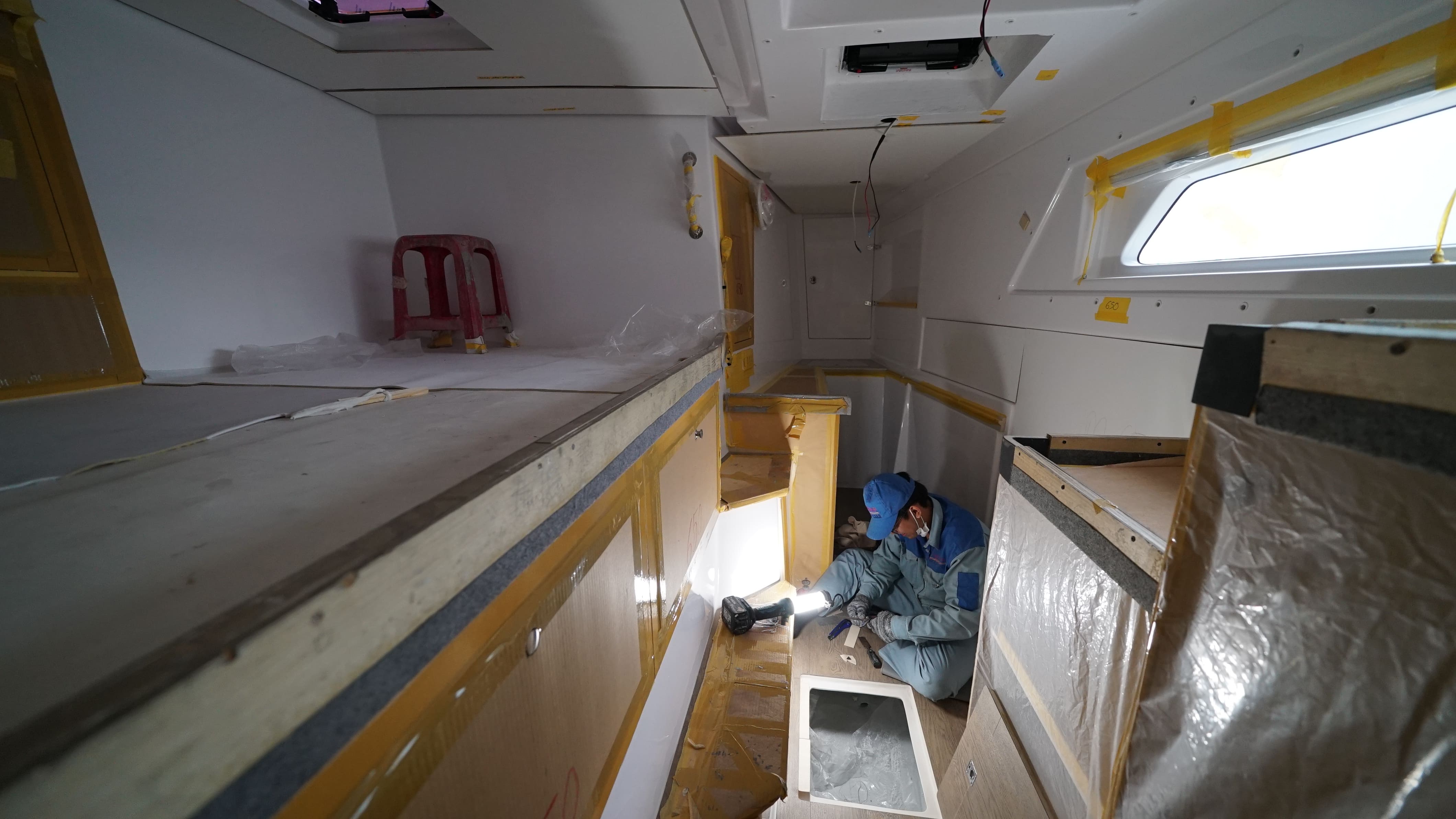

The targa bar and door bulkhead are currently being installed on the deck. The coachroof will be installed once this work is complete. Meanwhile, our Assembly team is making good progress installing the interior furniture modules throughout the hull.

Production Update – Assembly

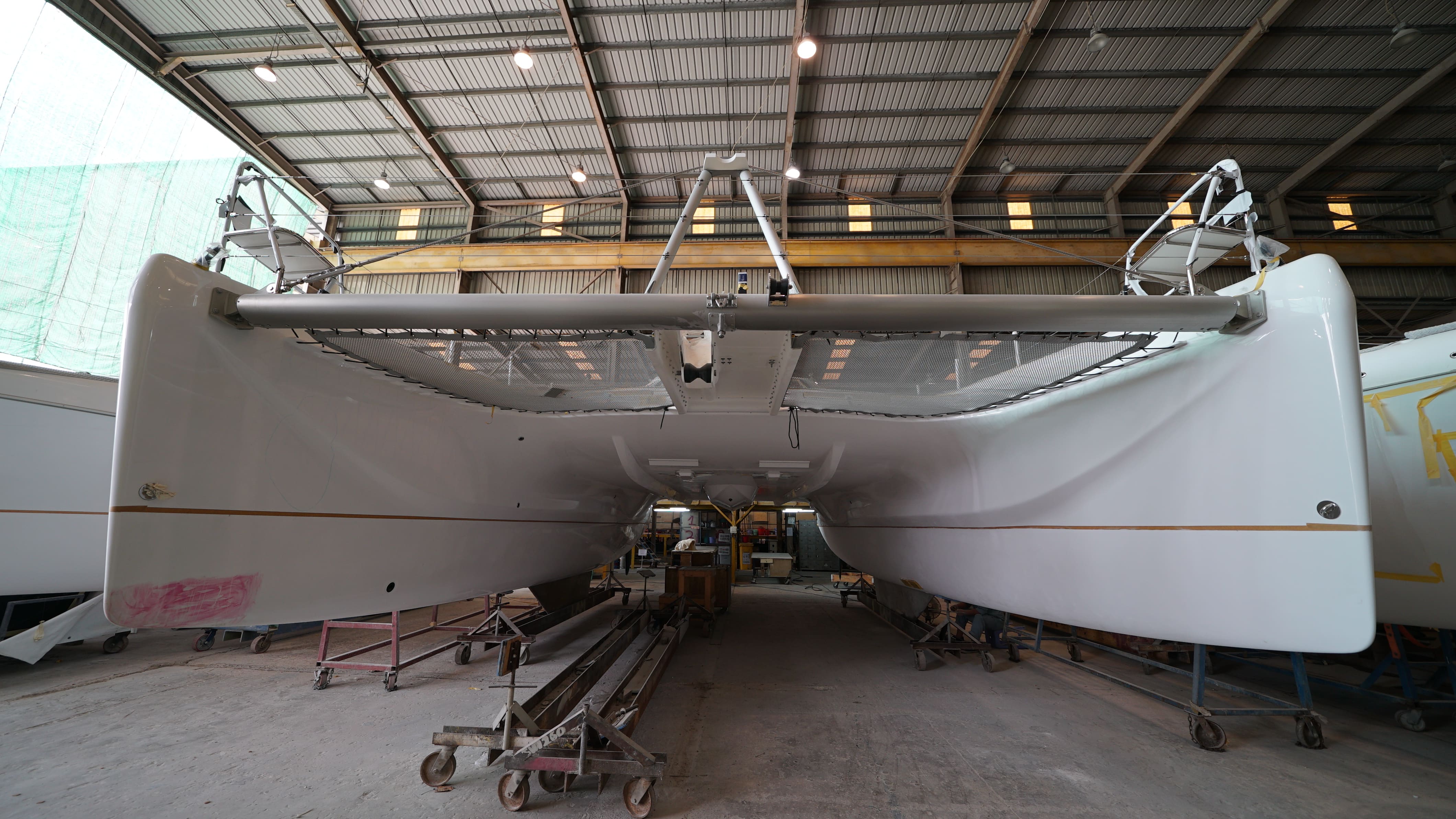

Your boat is progressing well in the Assembly stage.

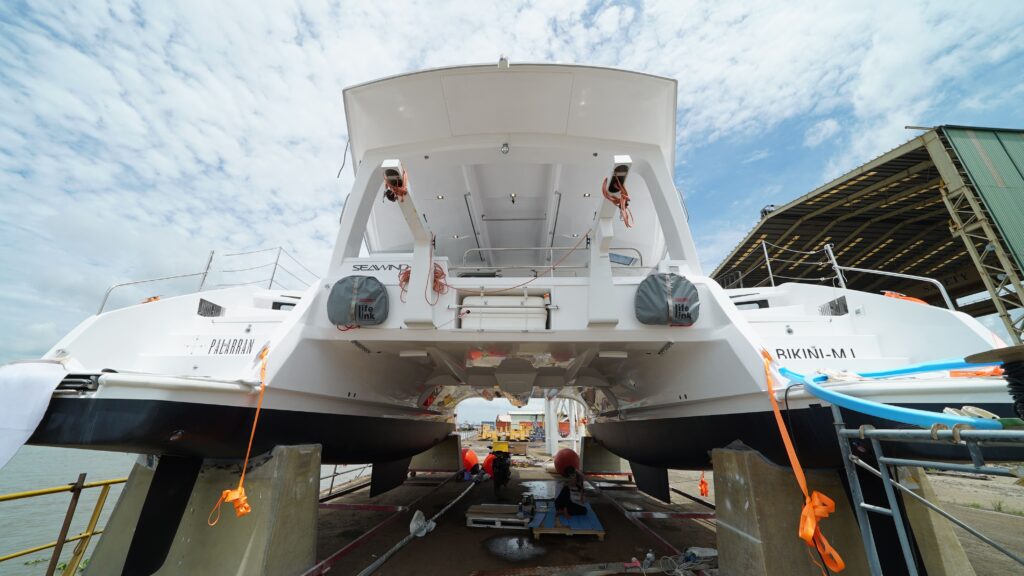

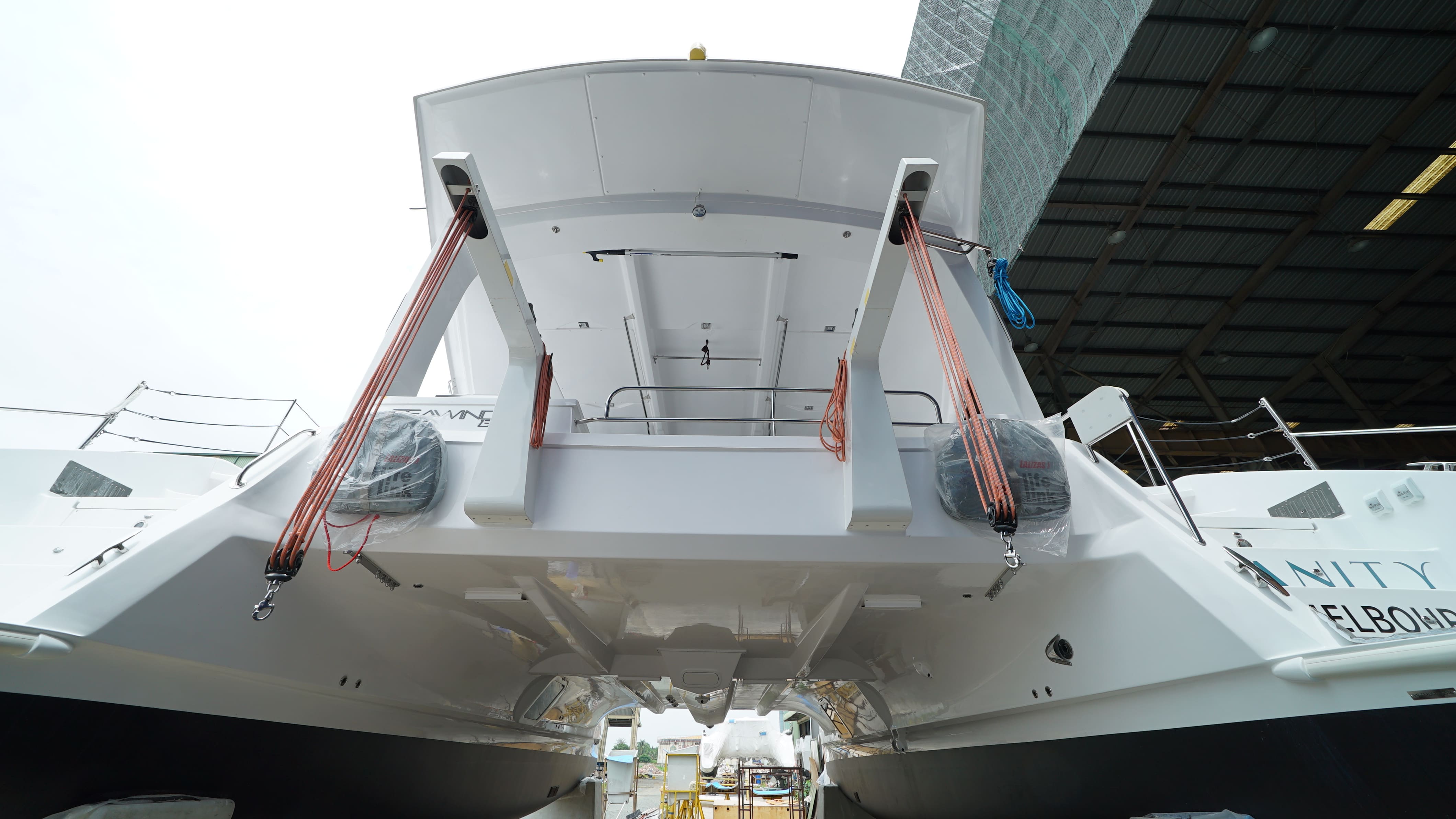

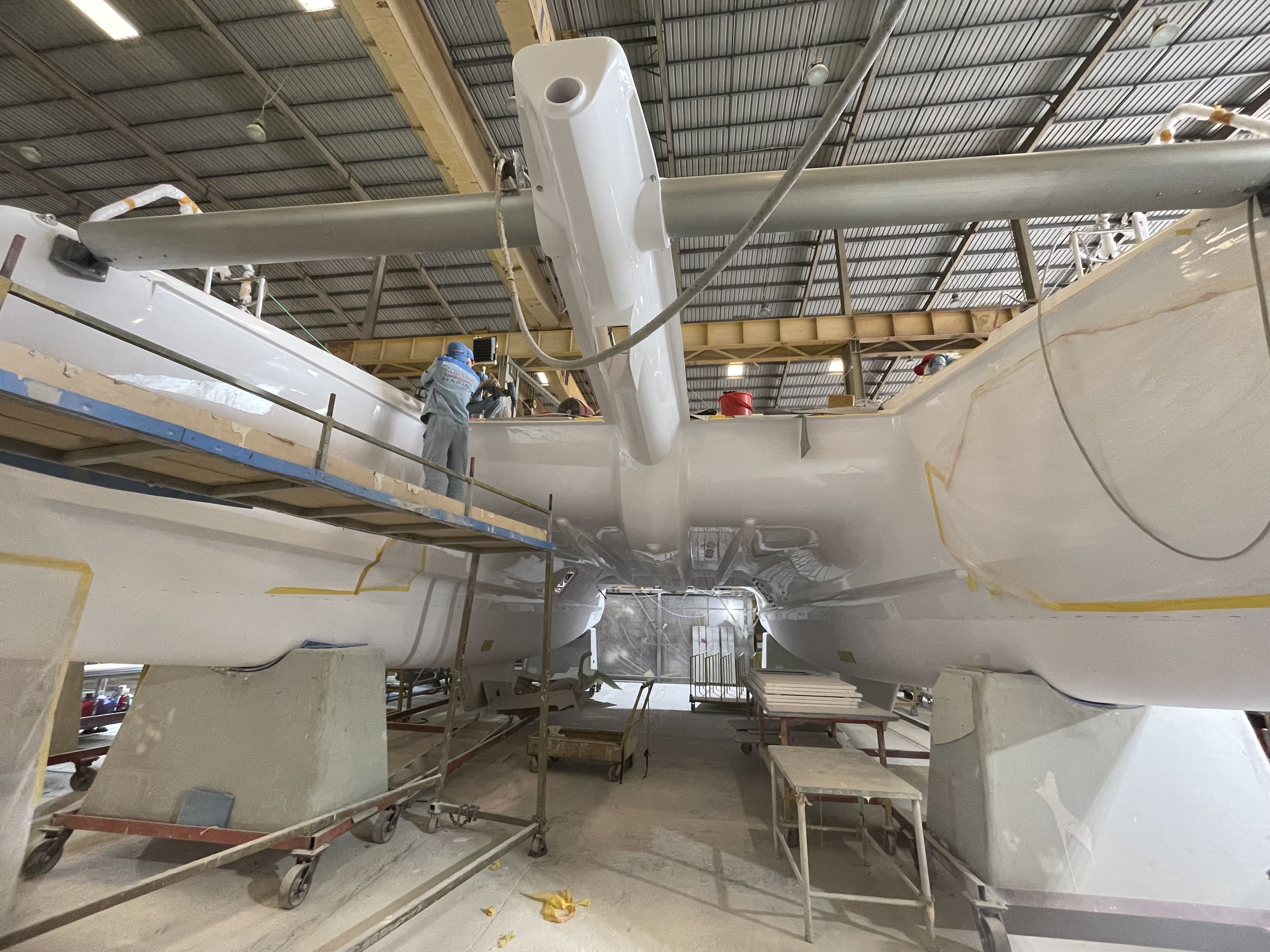

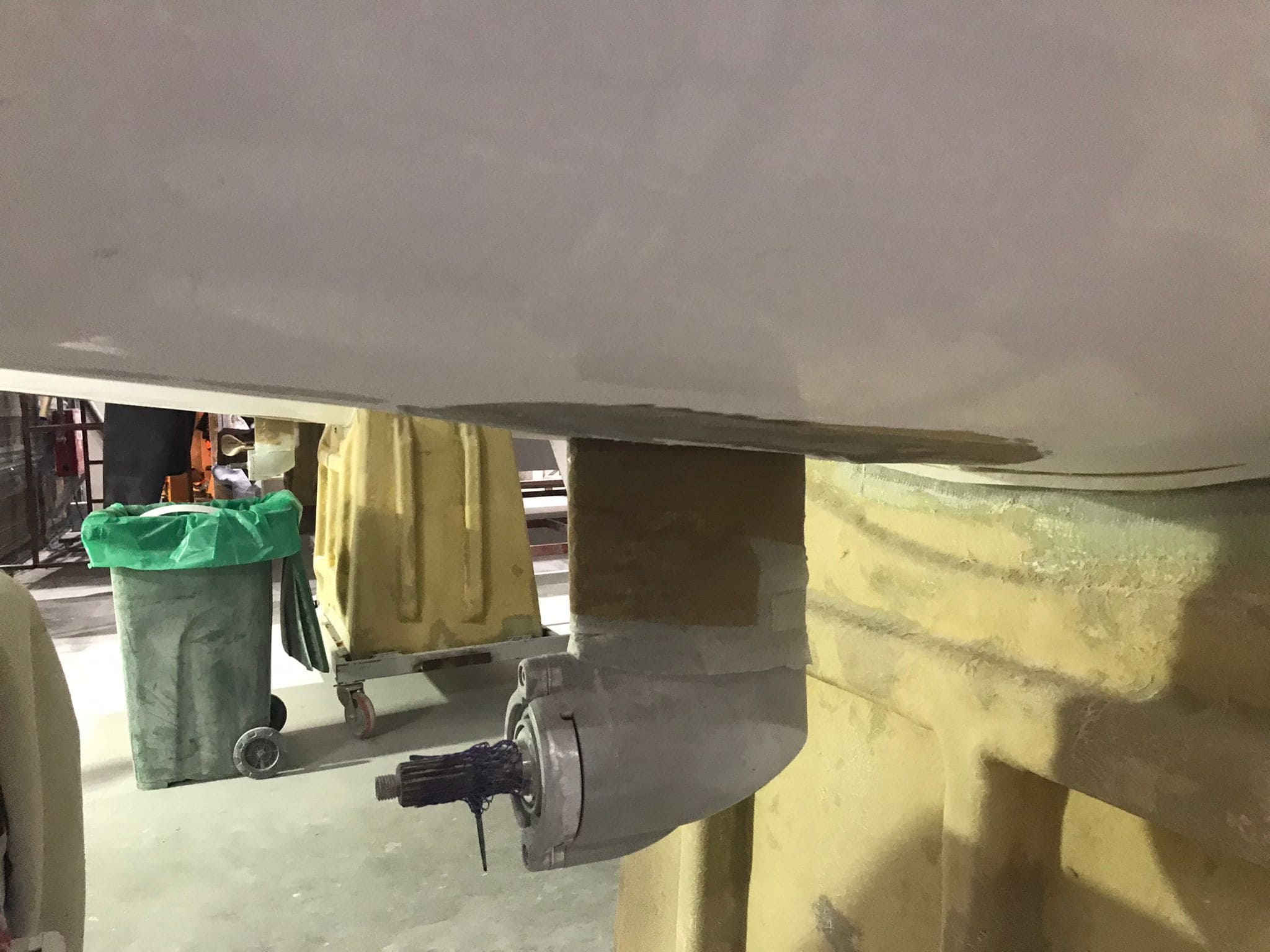

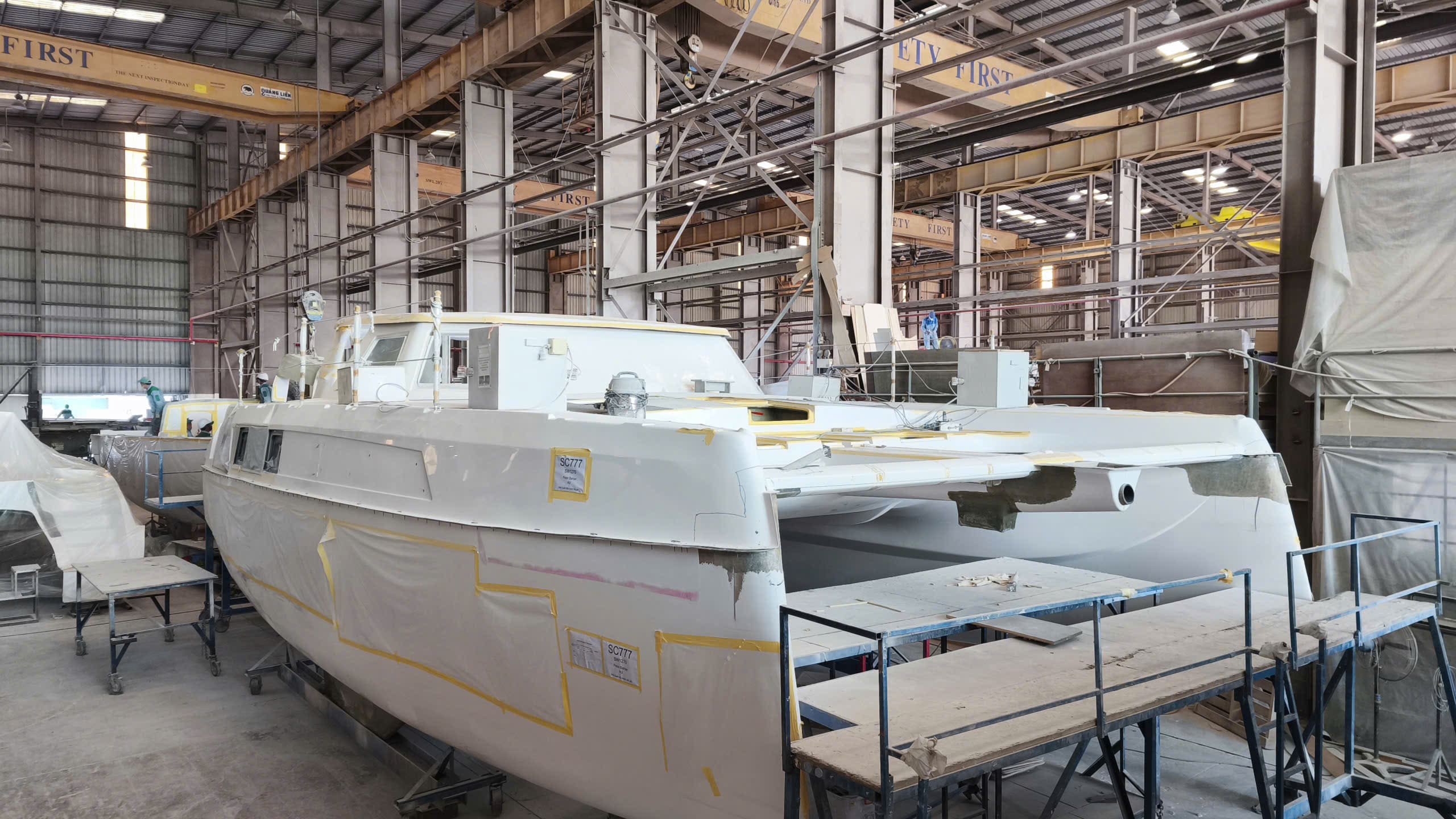

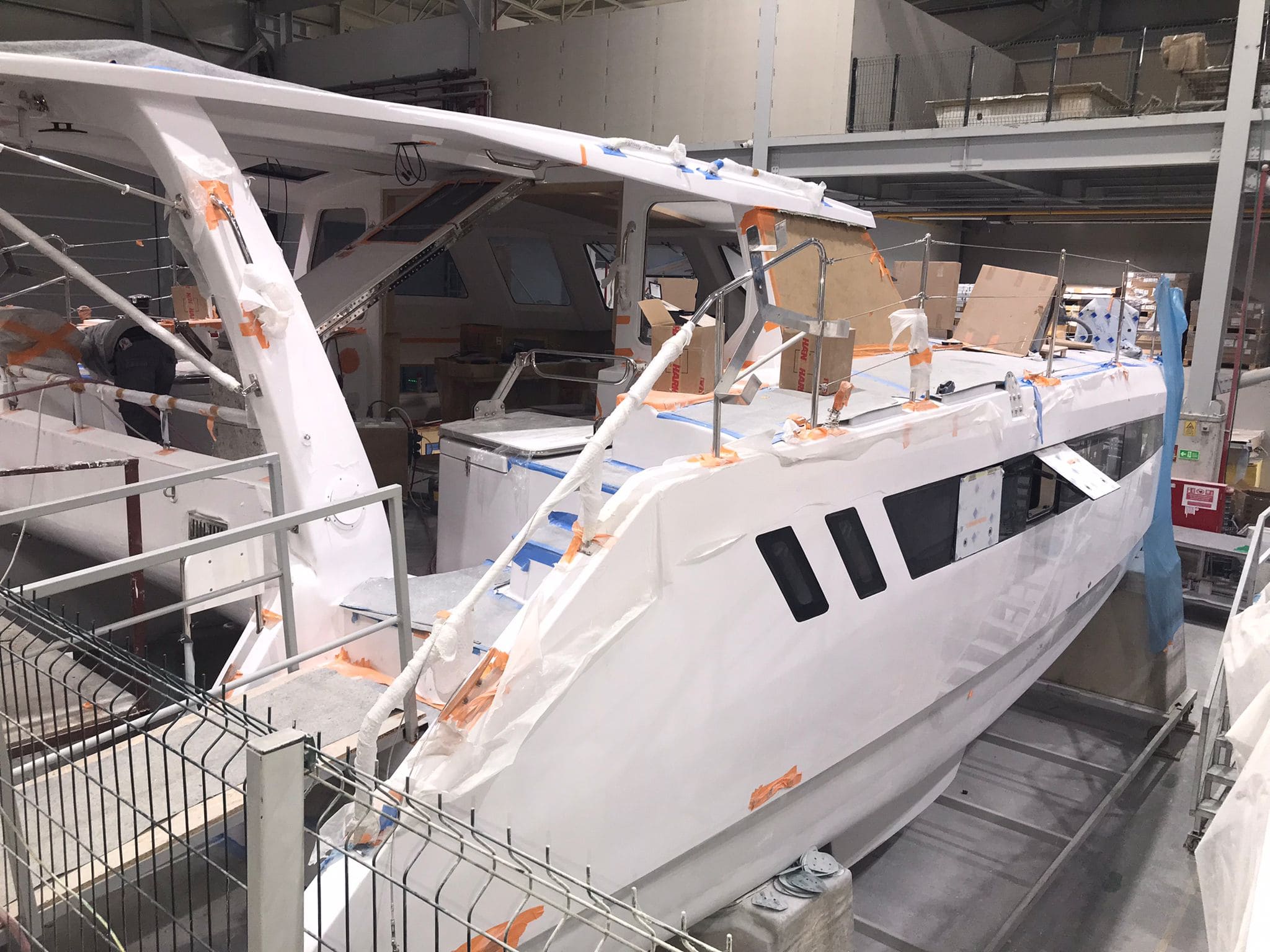

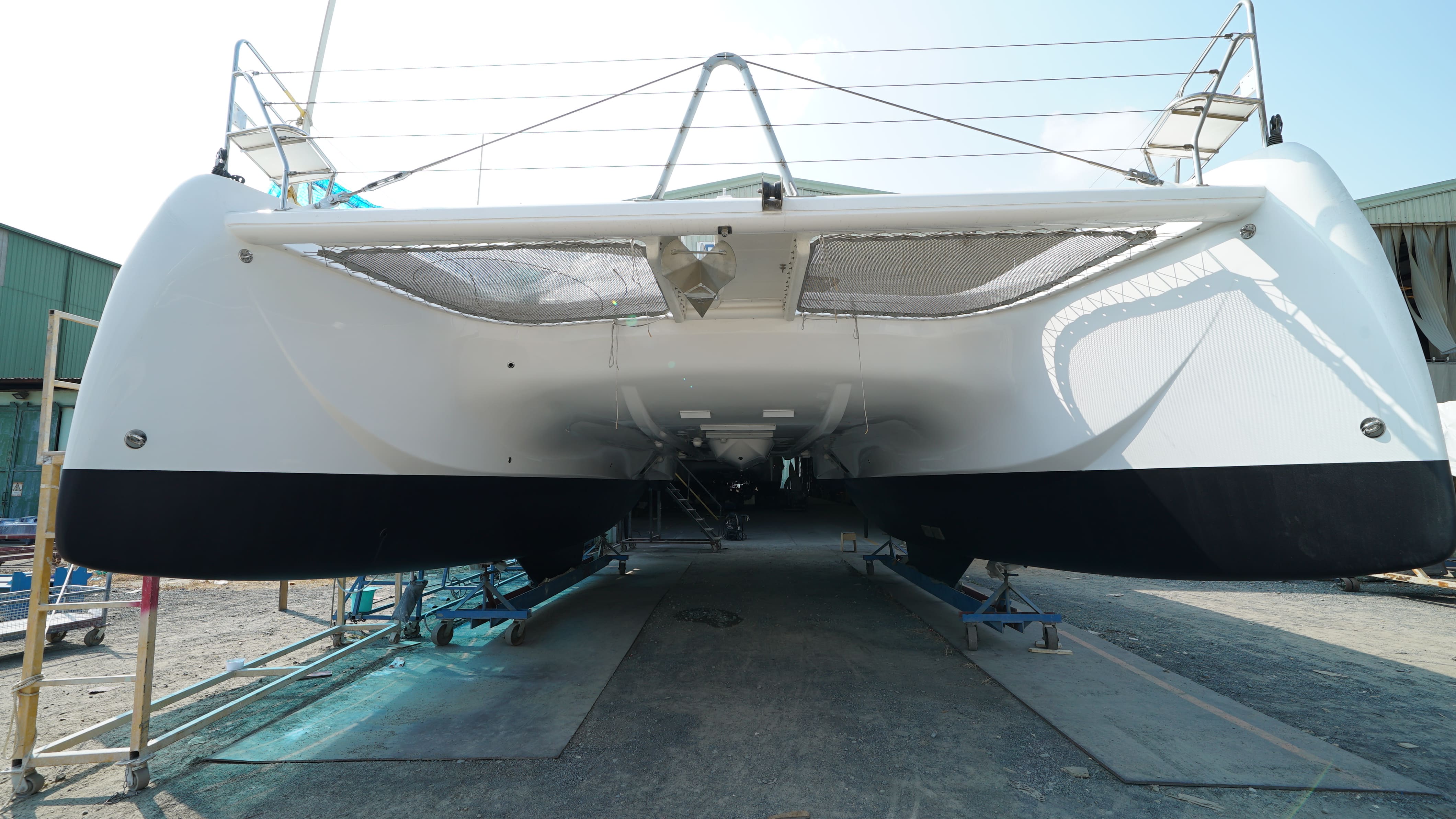

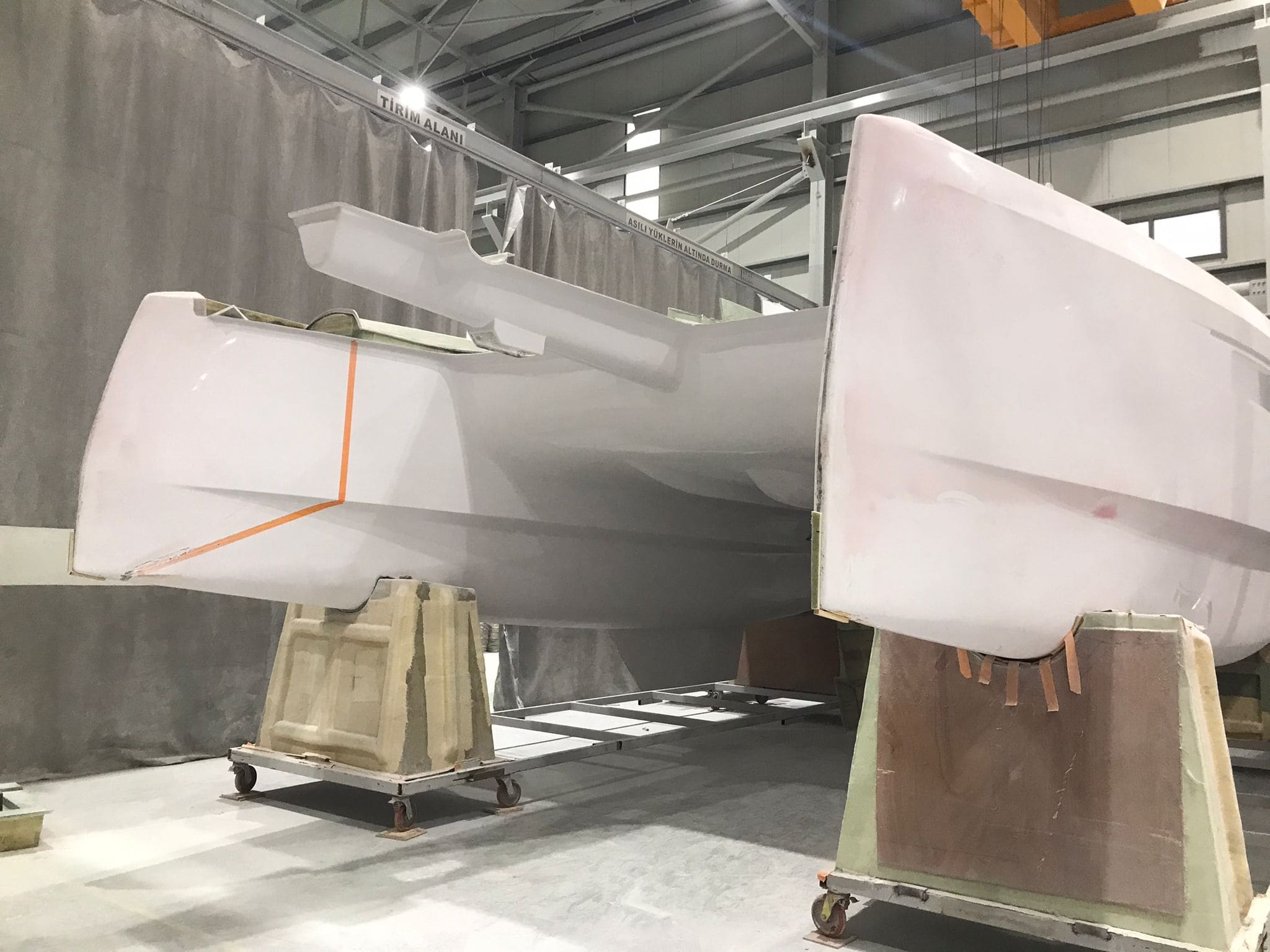

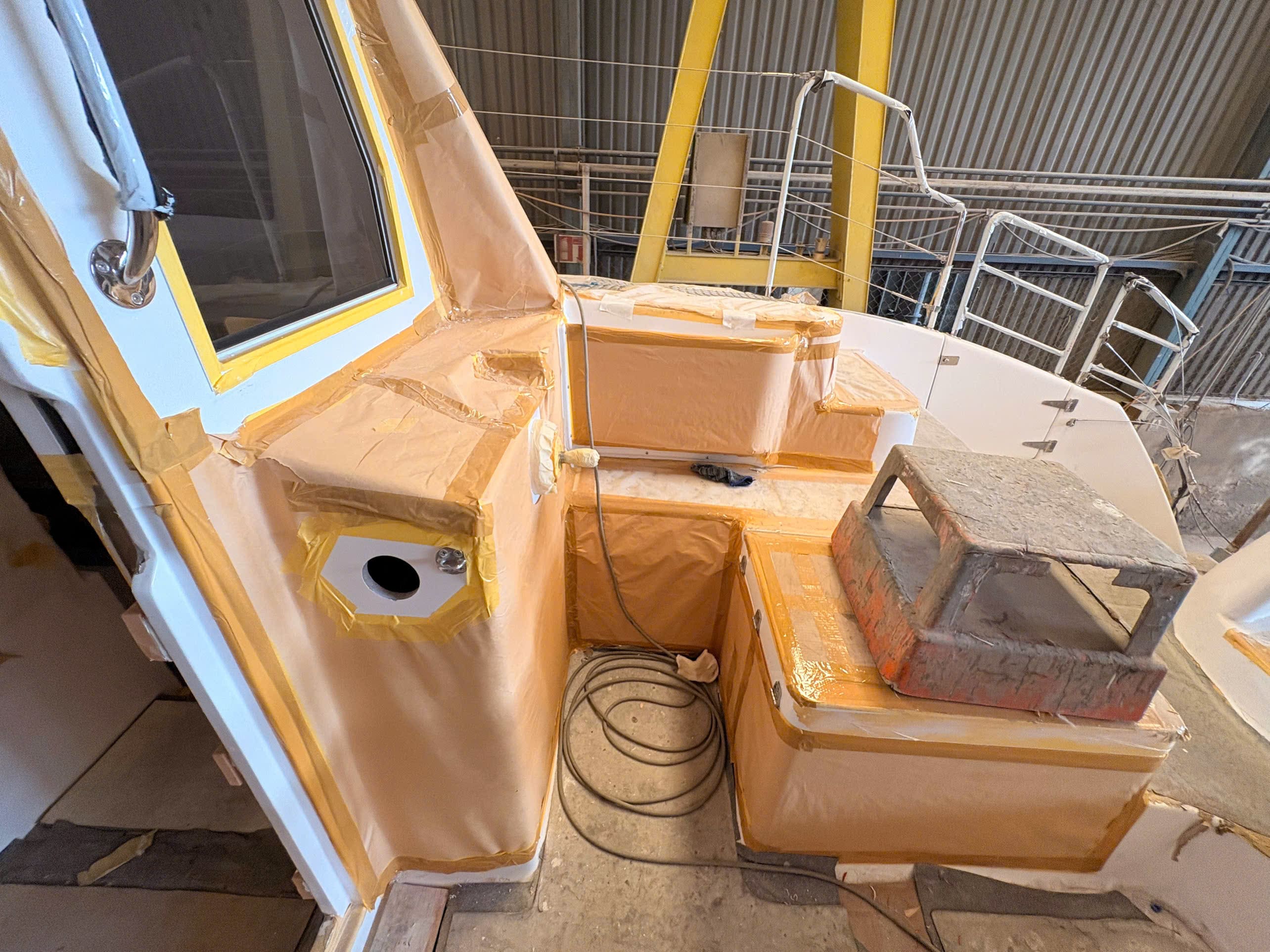

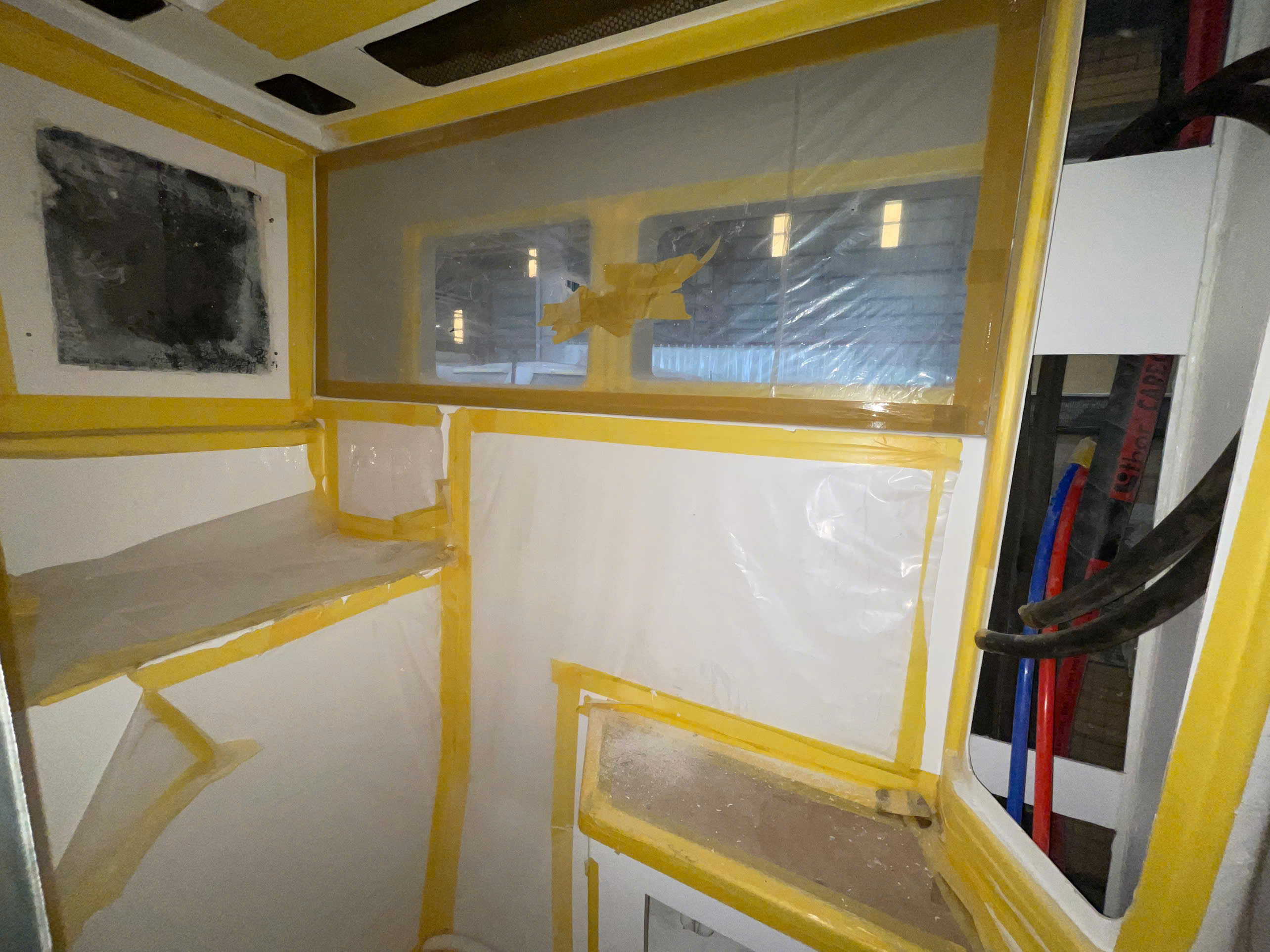

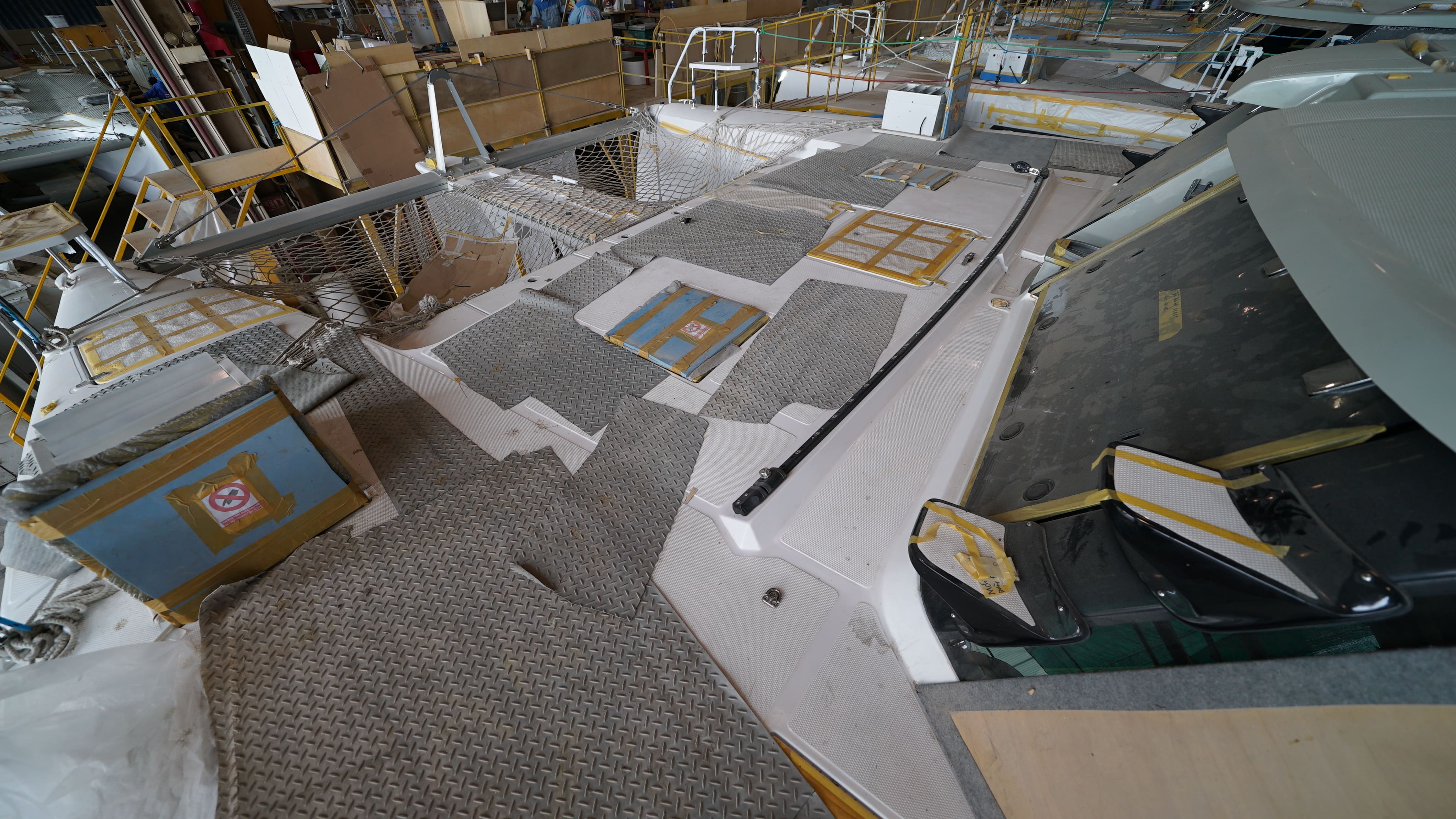

The hull and deck joining has been succesfully completed. Our Production team is currently working on gelcoat repair, preparation for engines & deck hardware installation.
