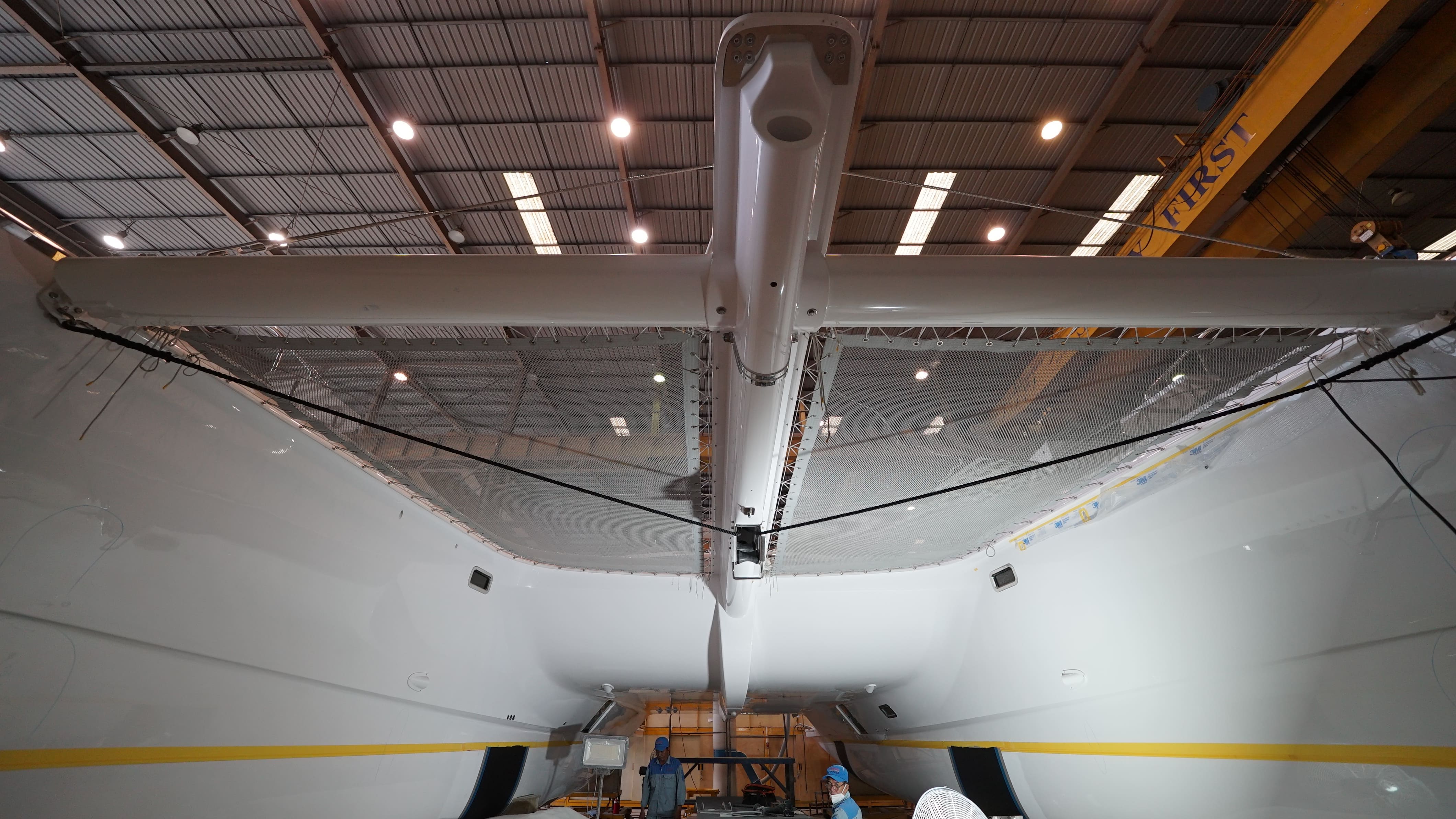

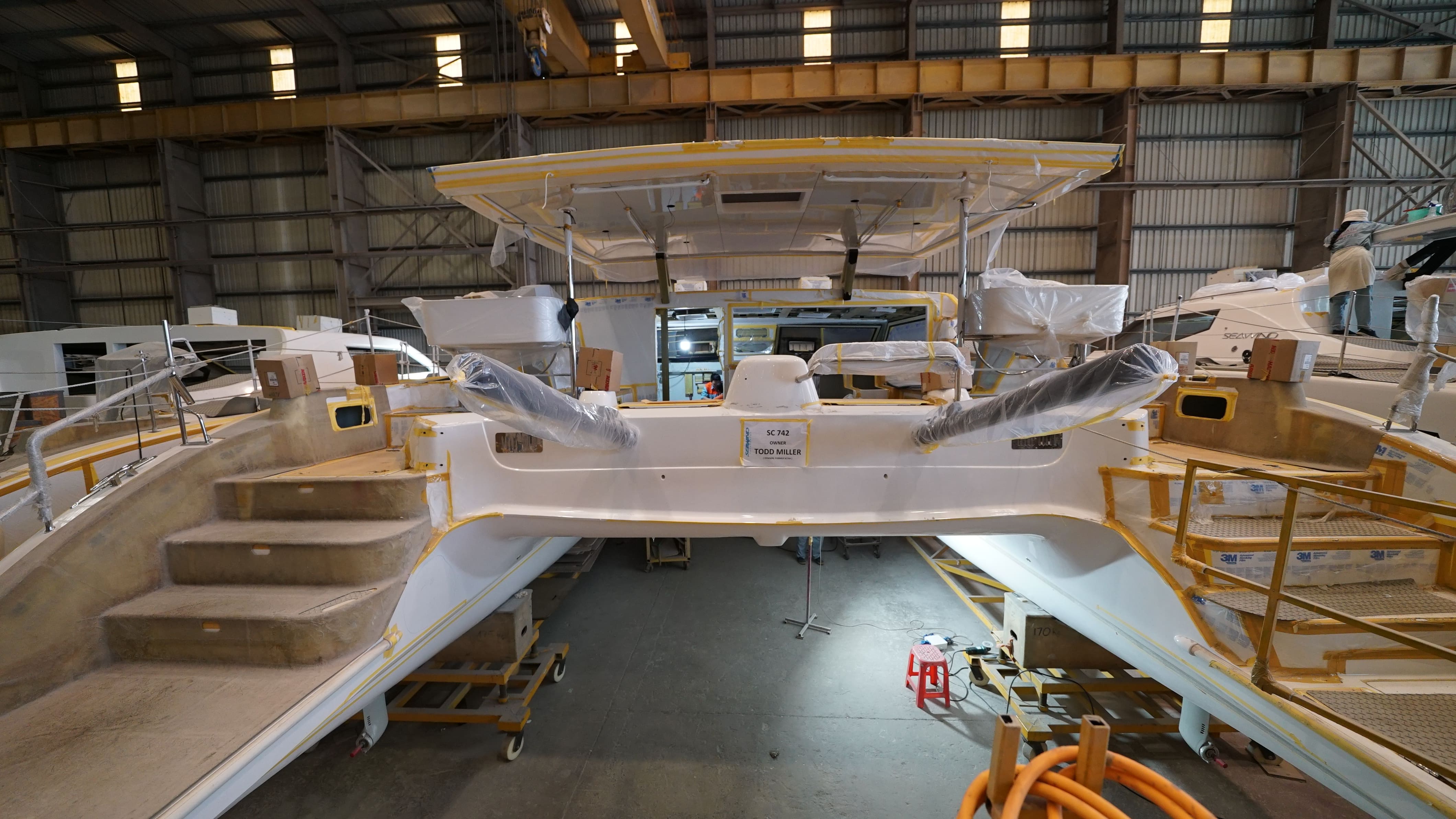

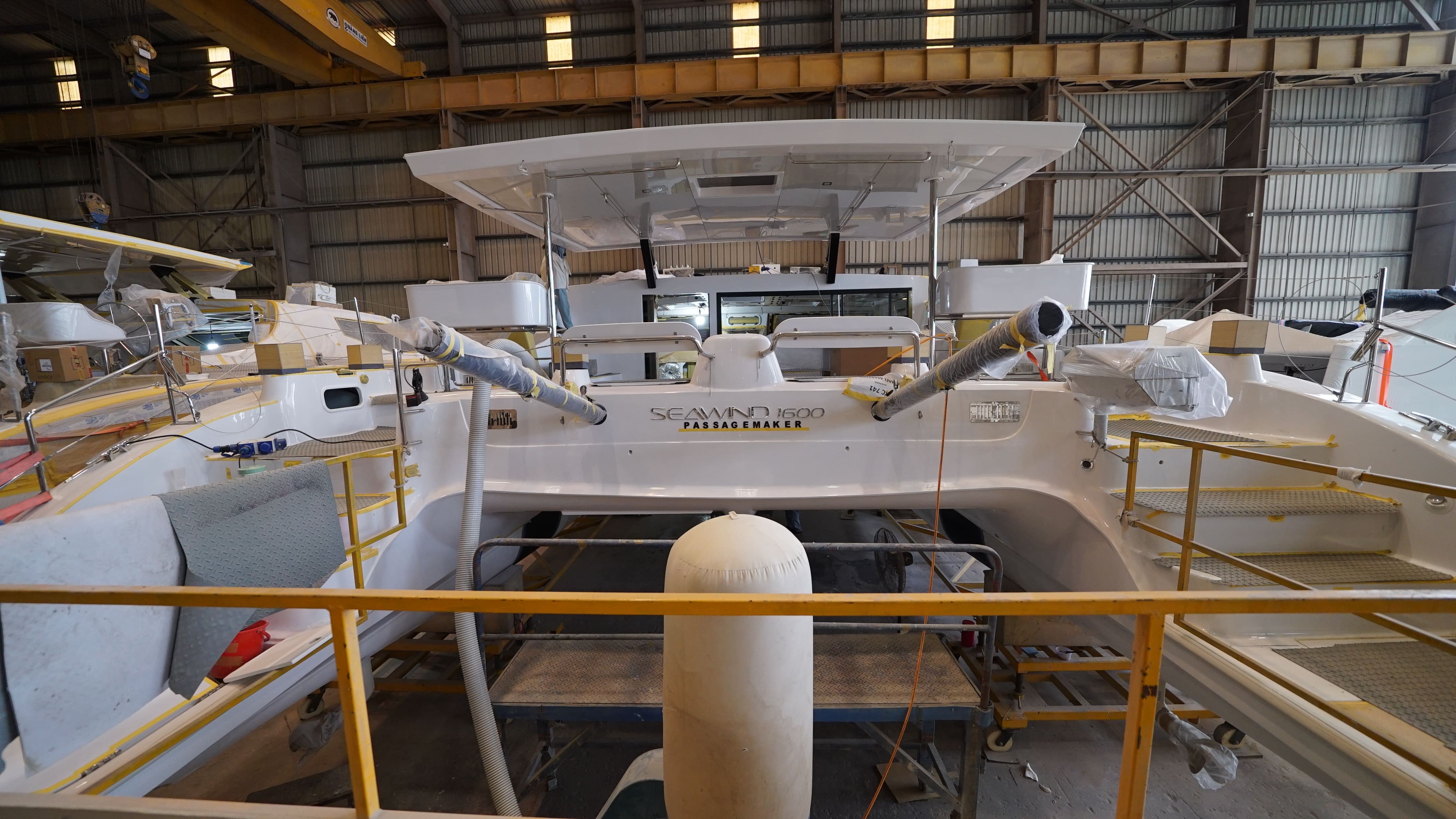

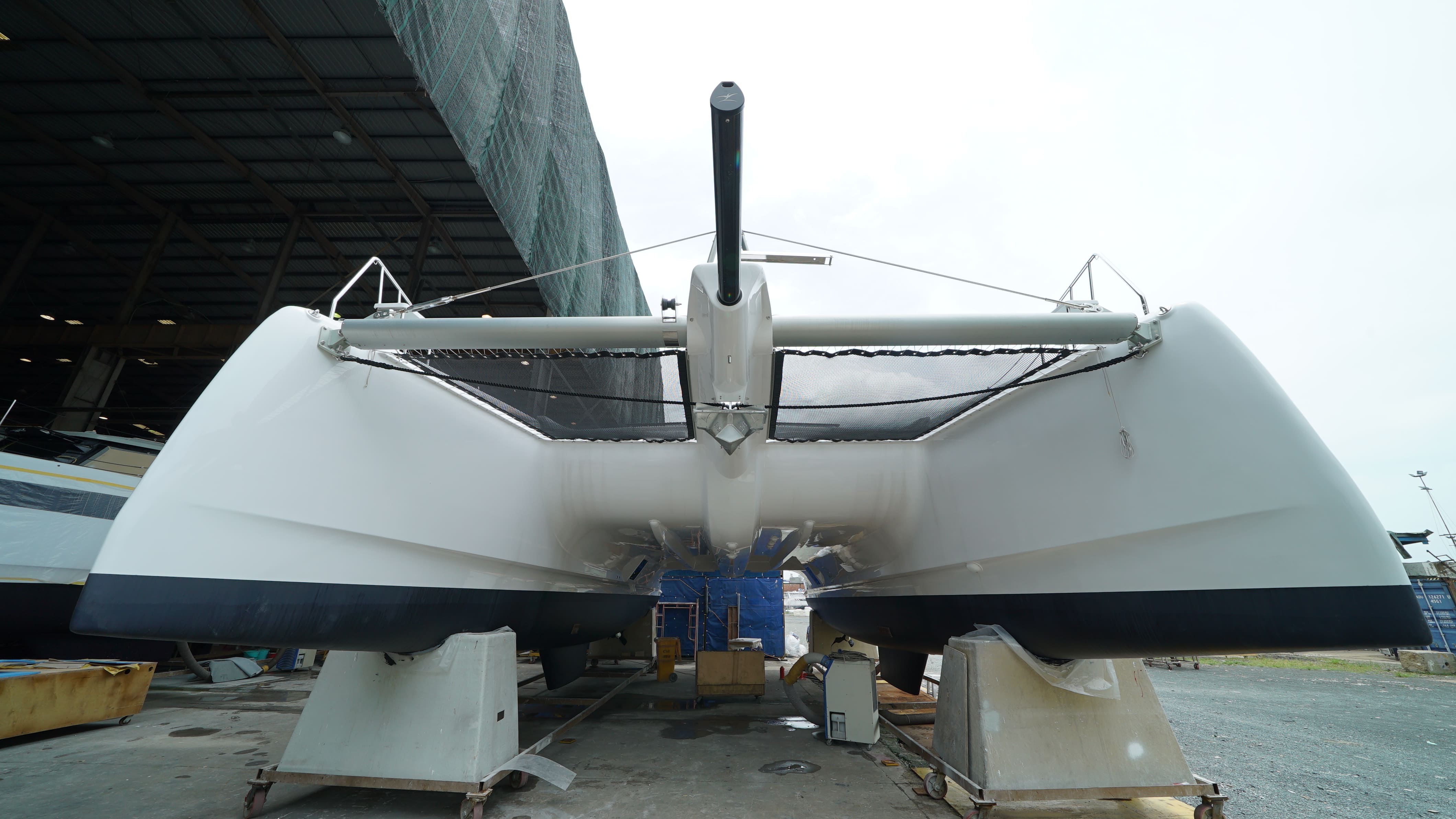

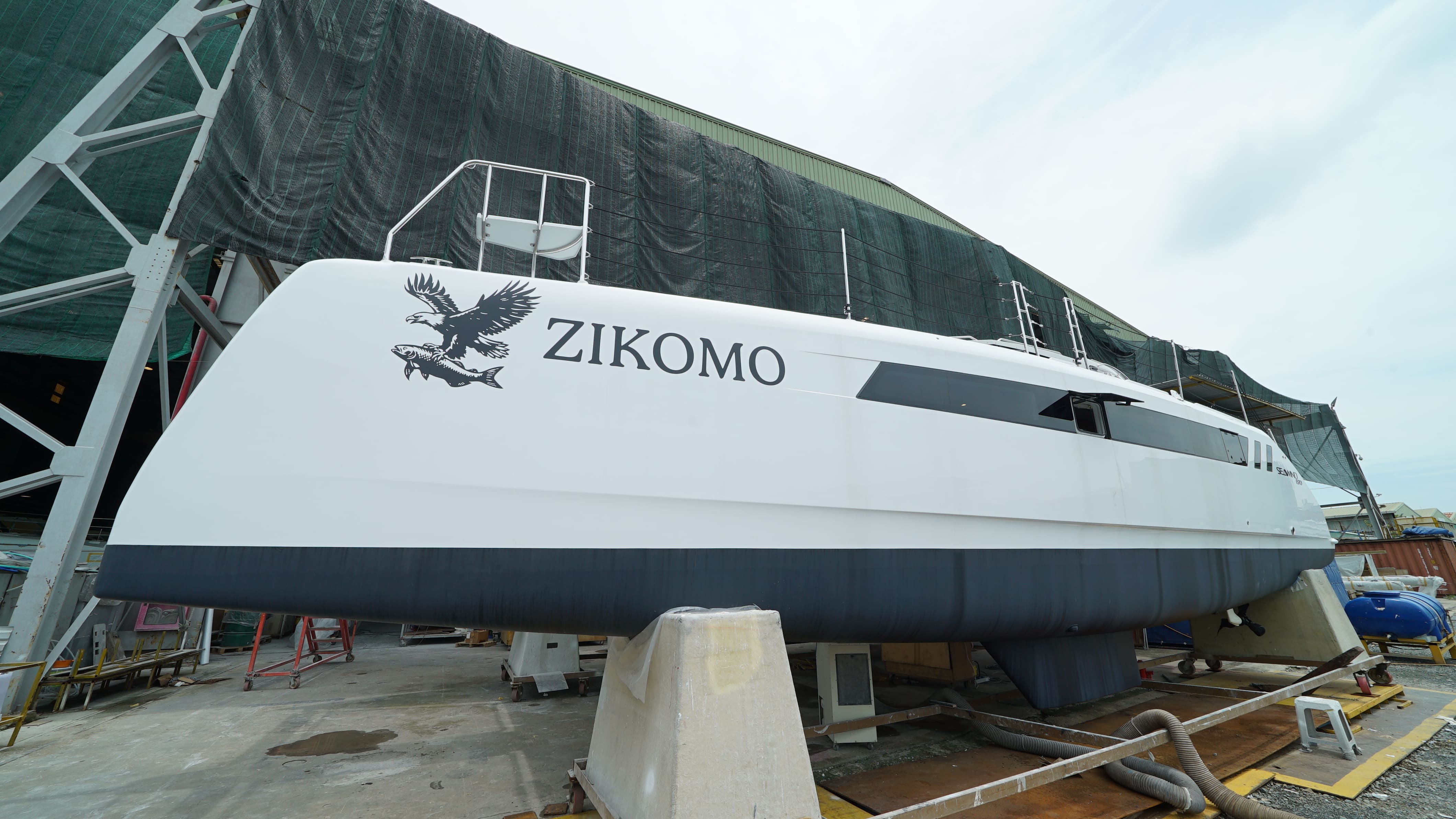

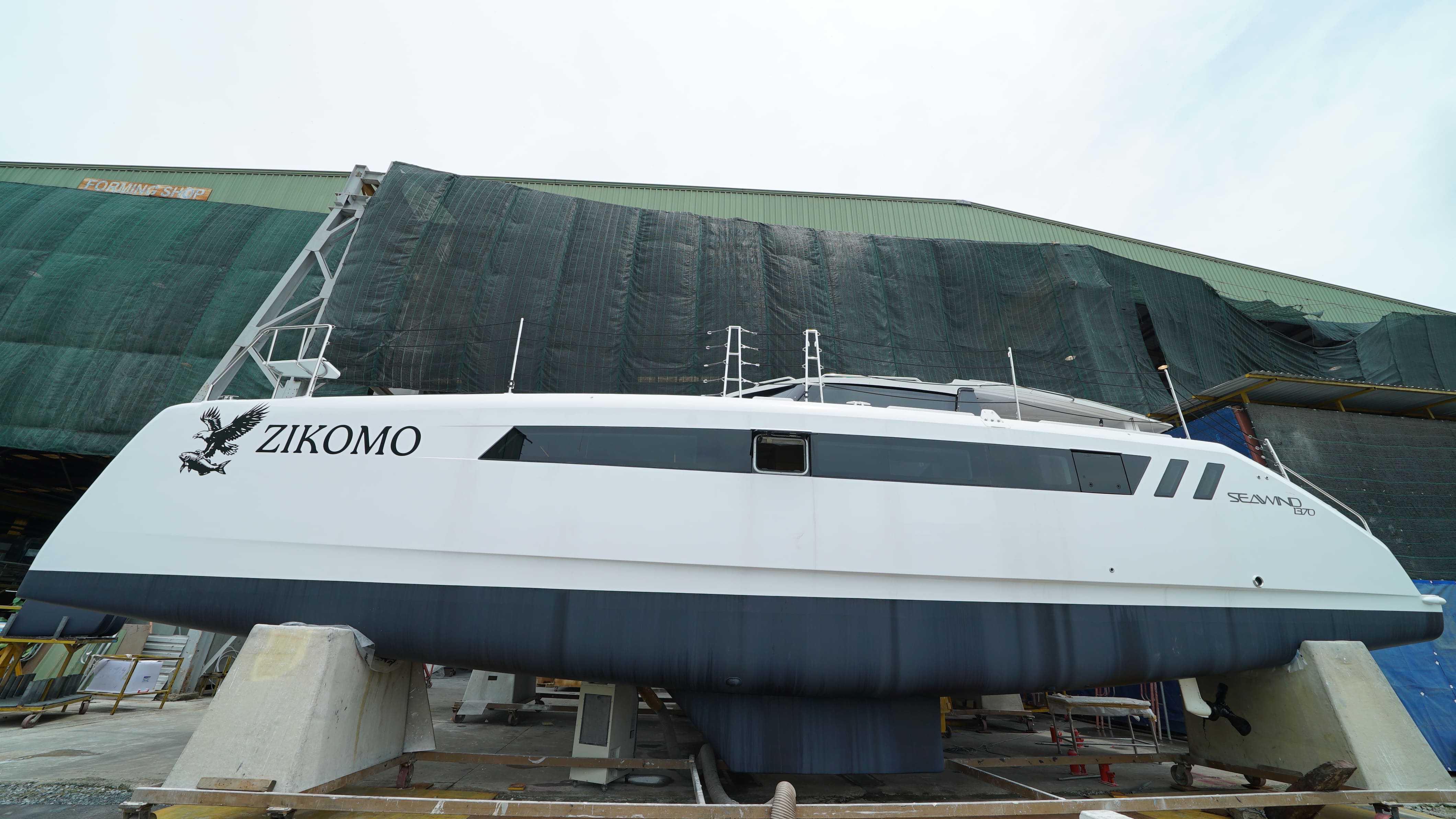

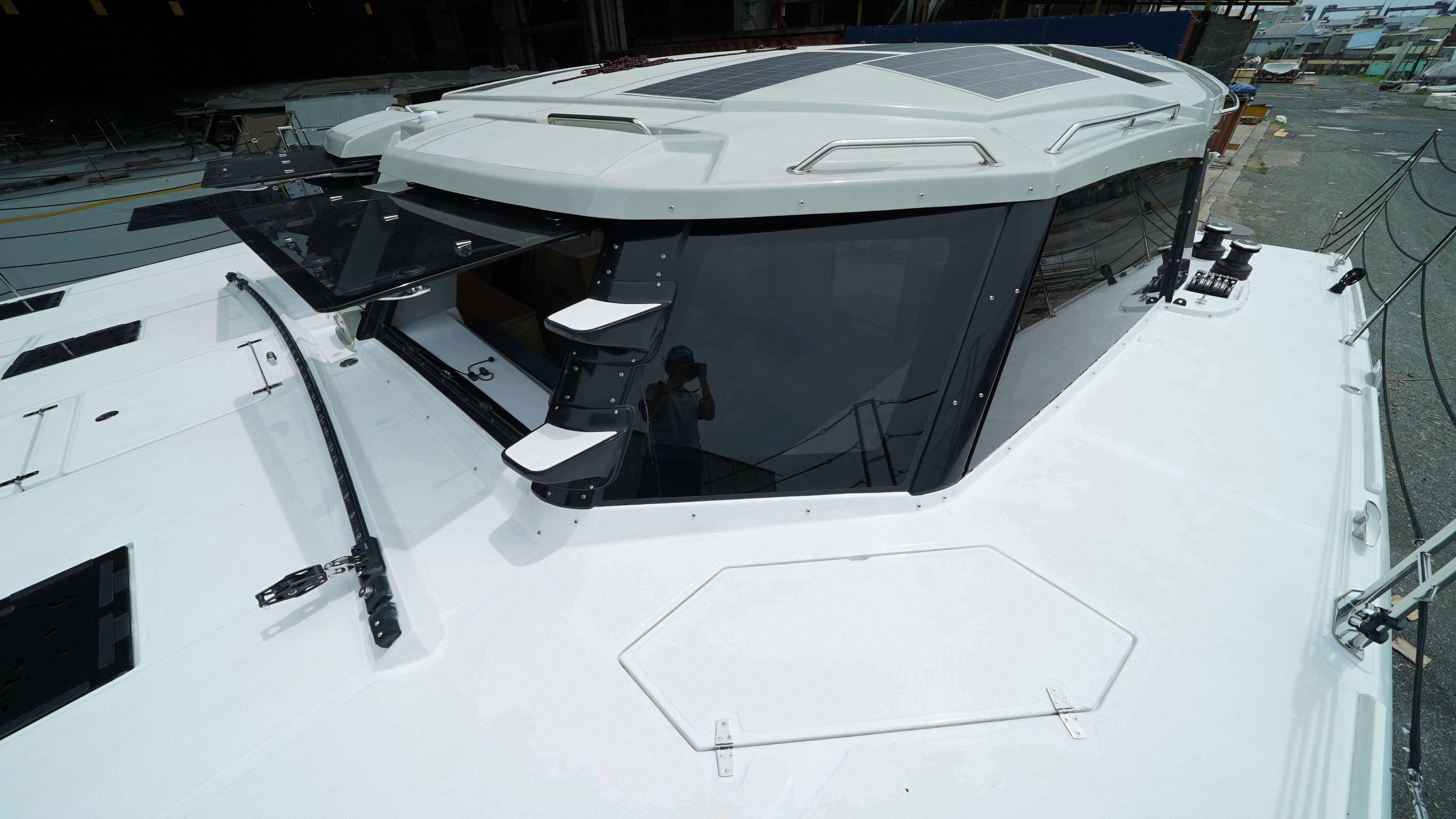

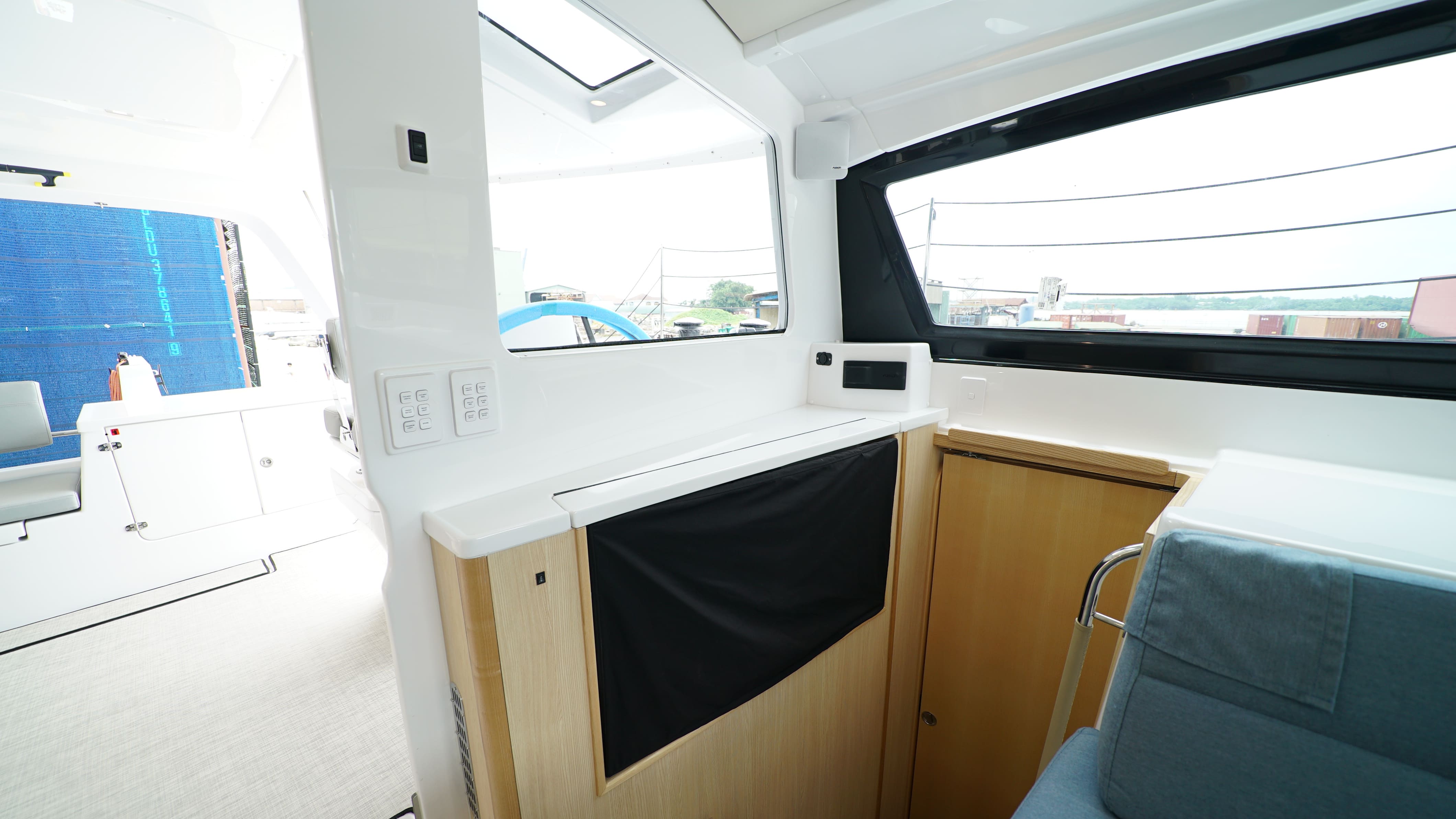

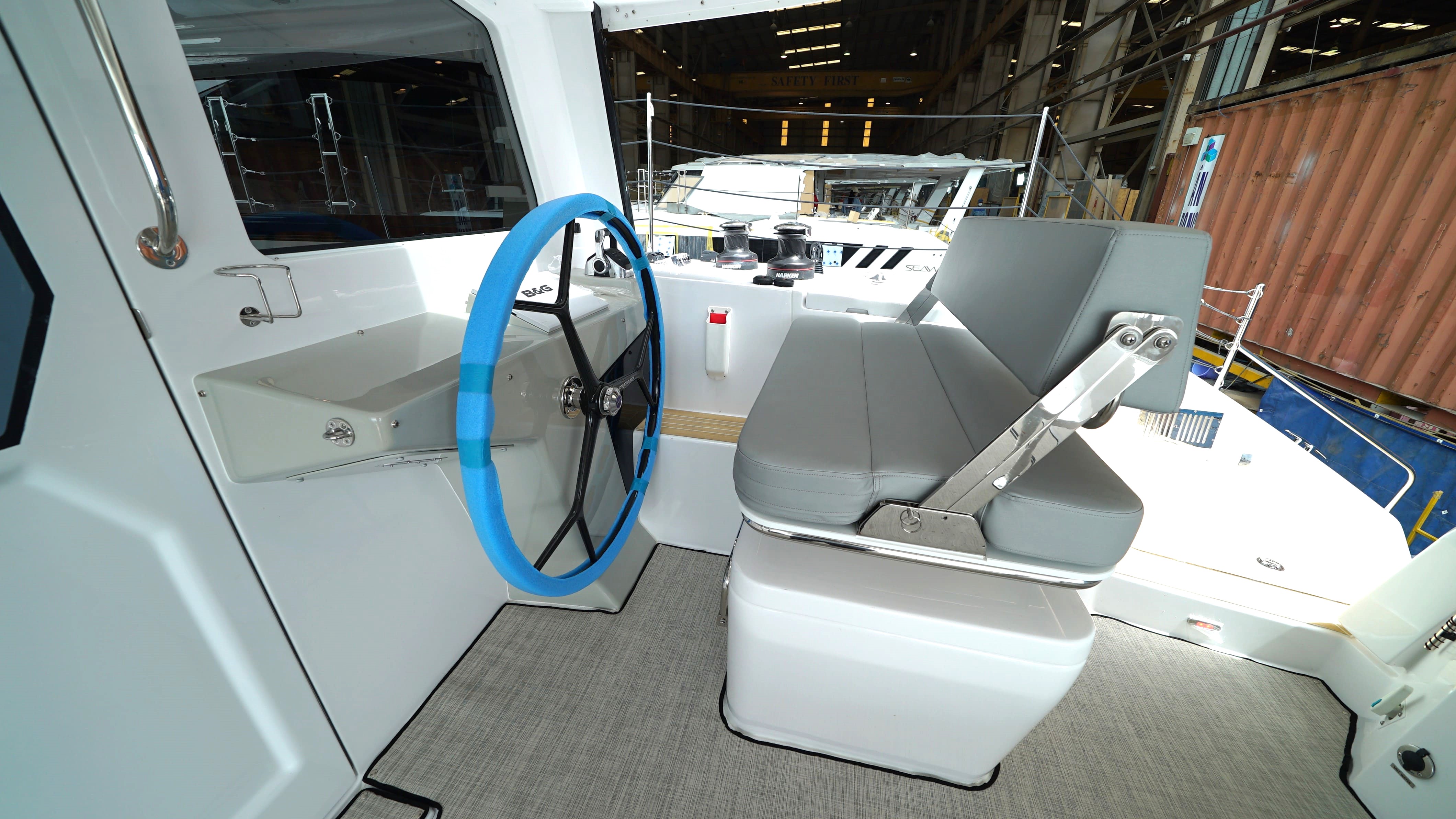

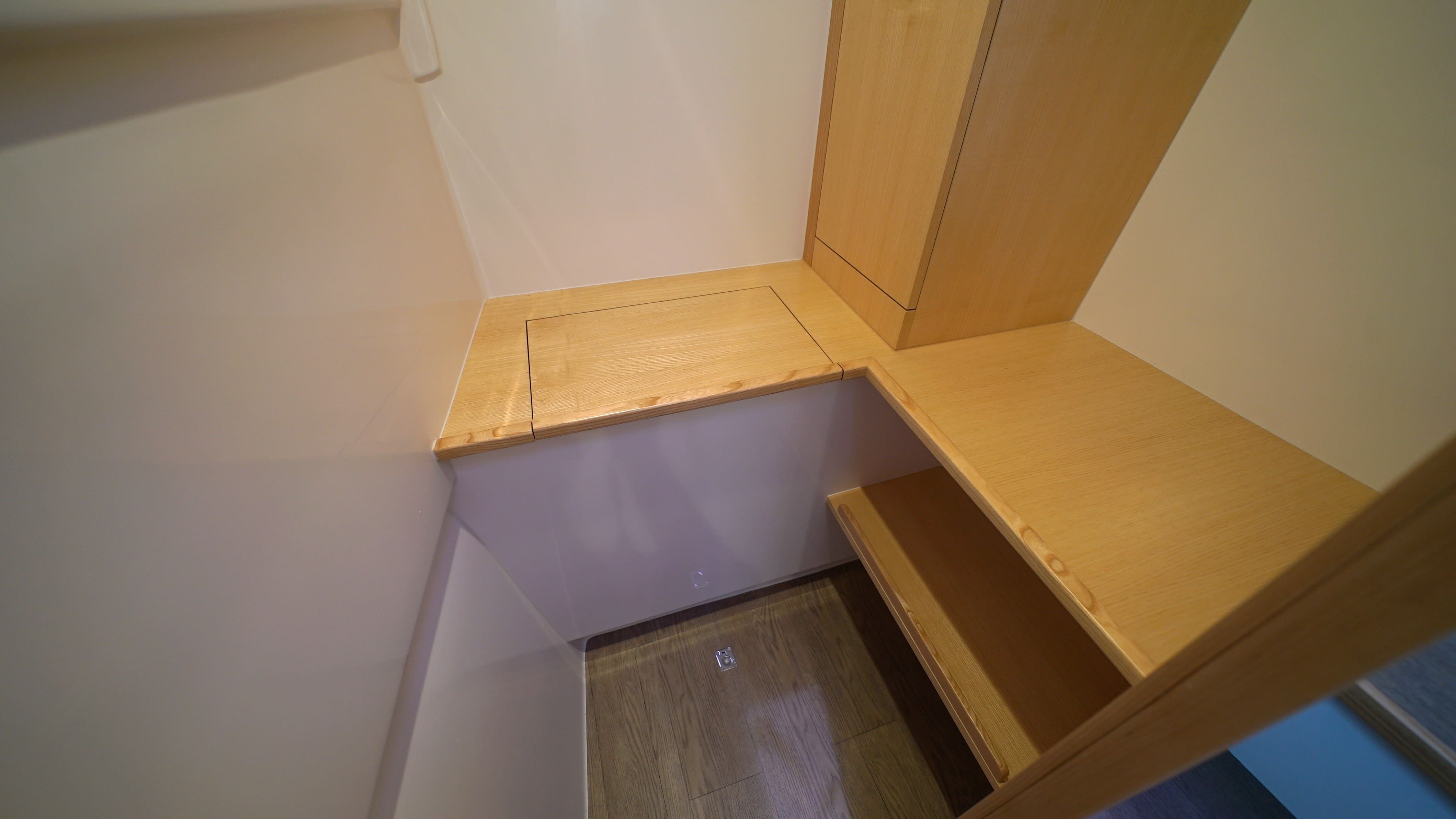

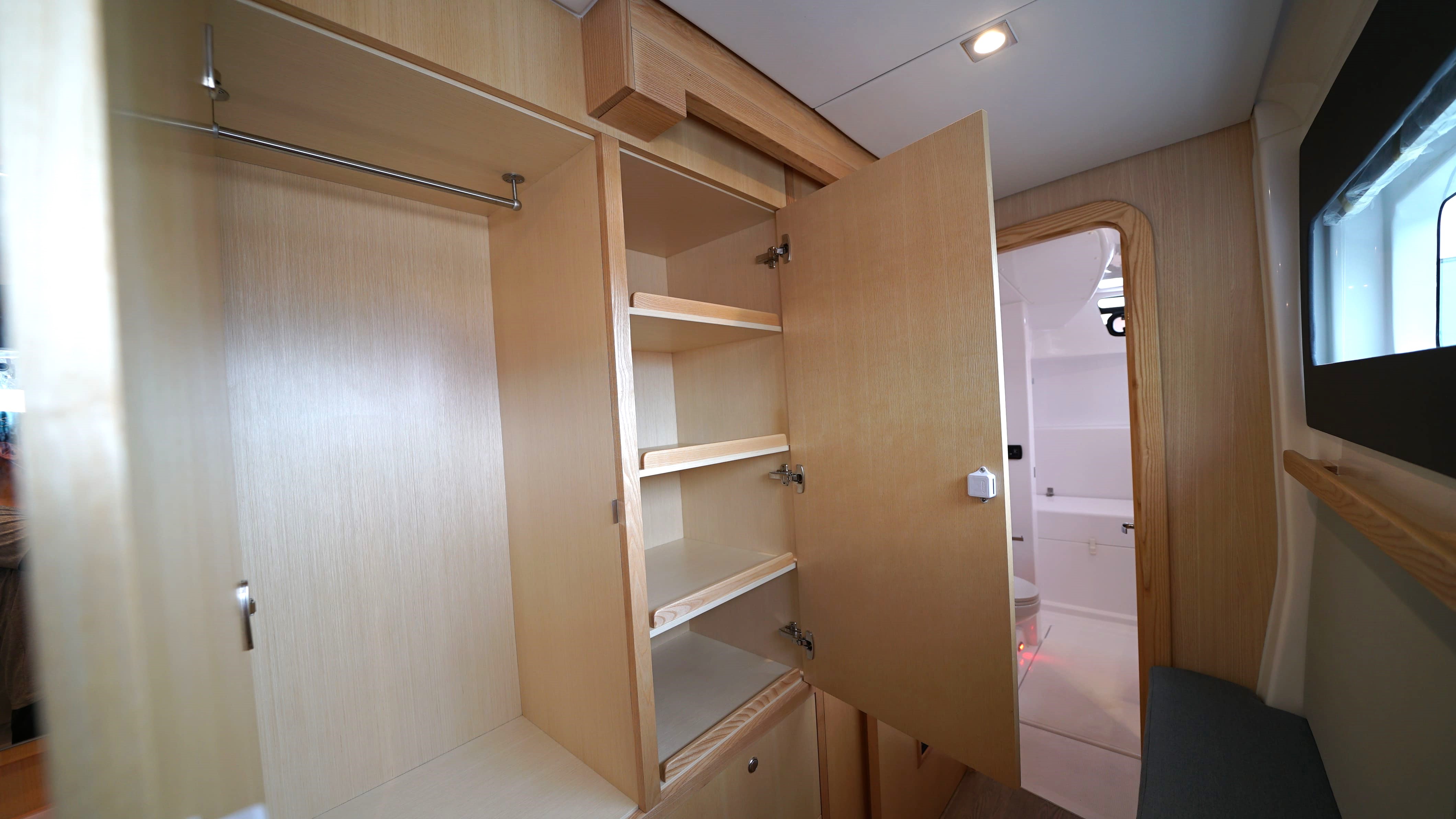

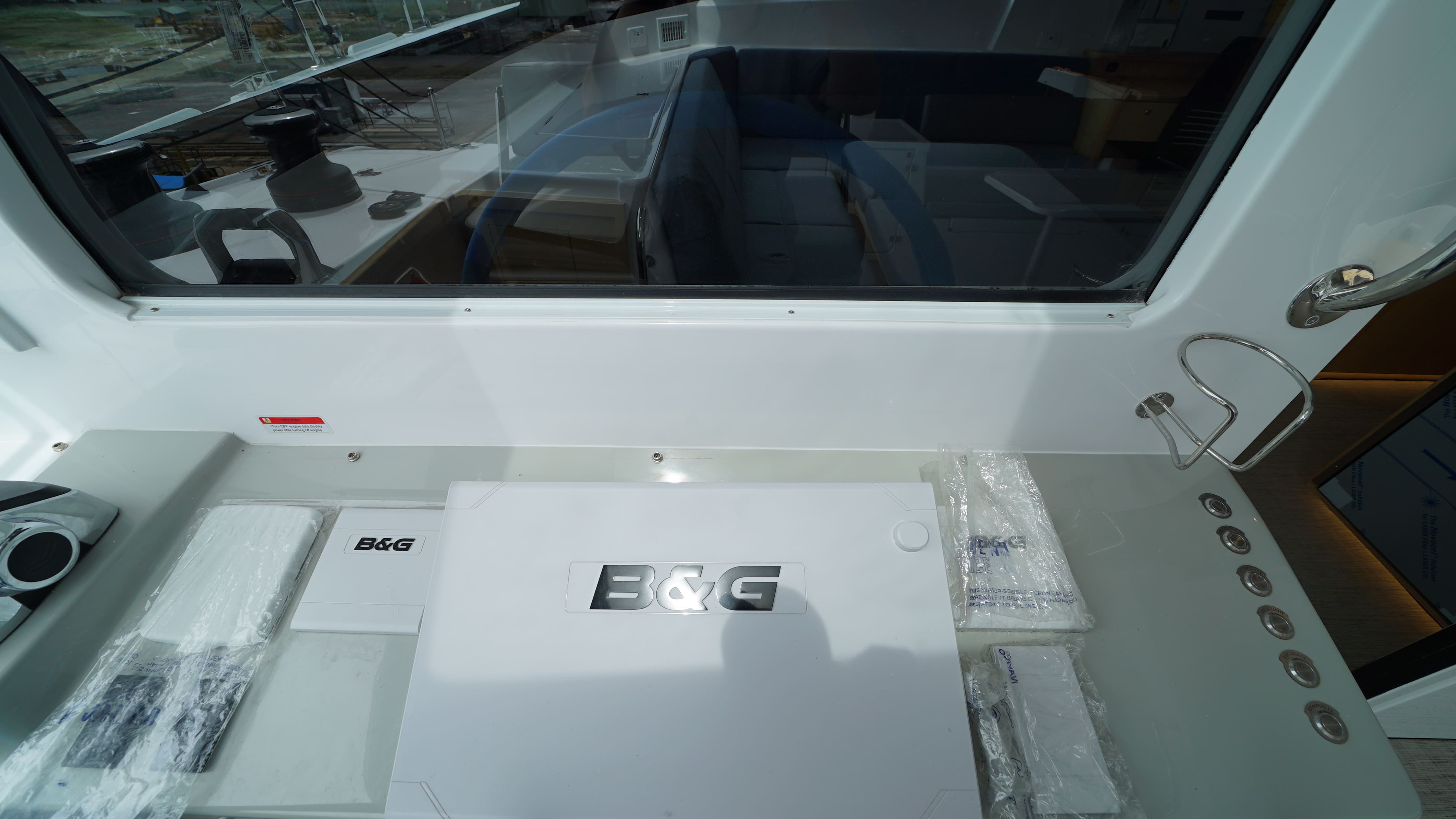

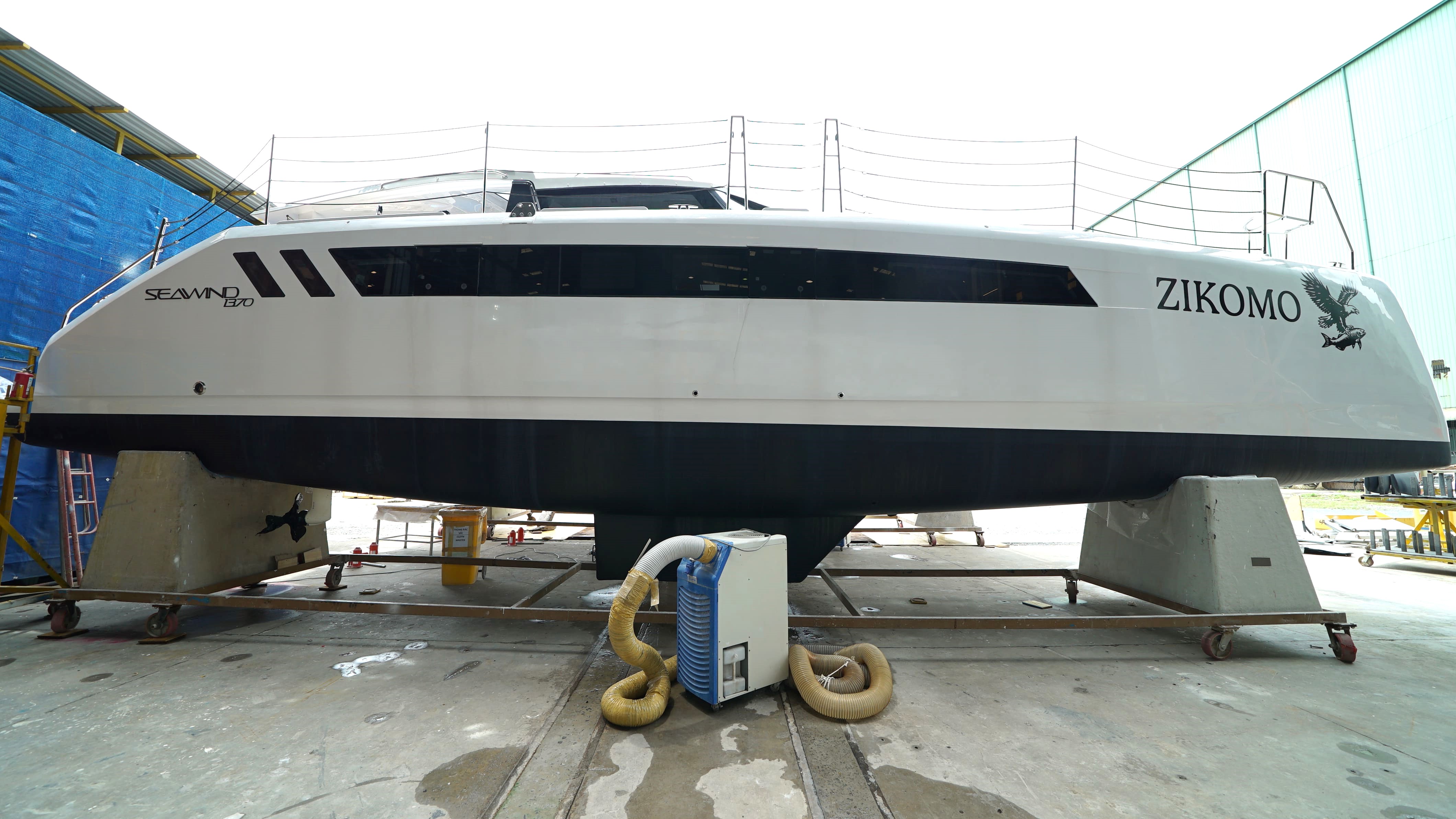

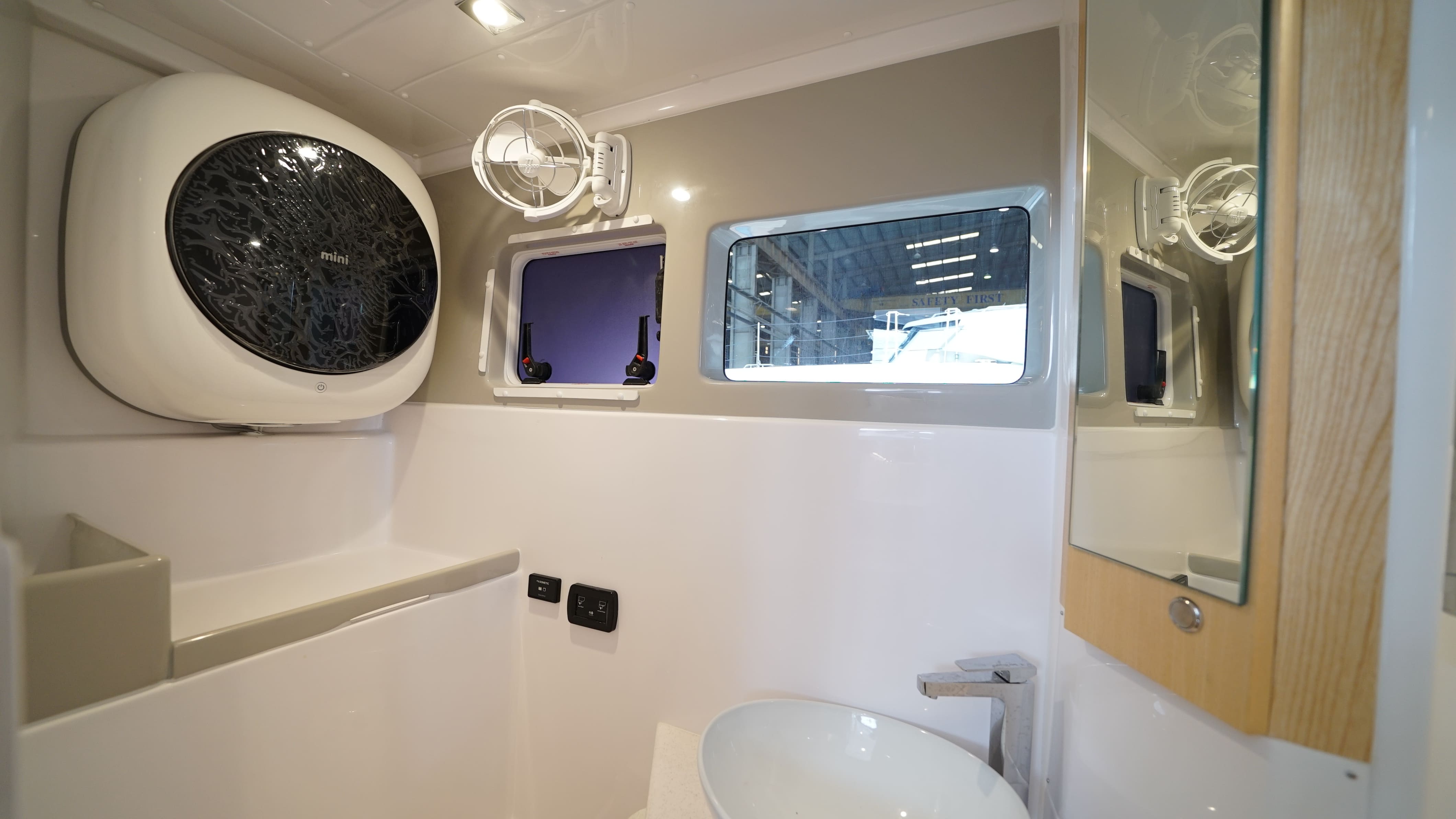

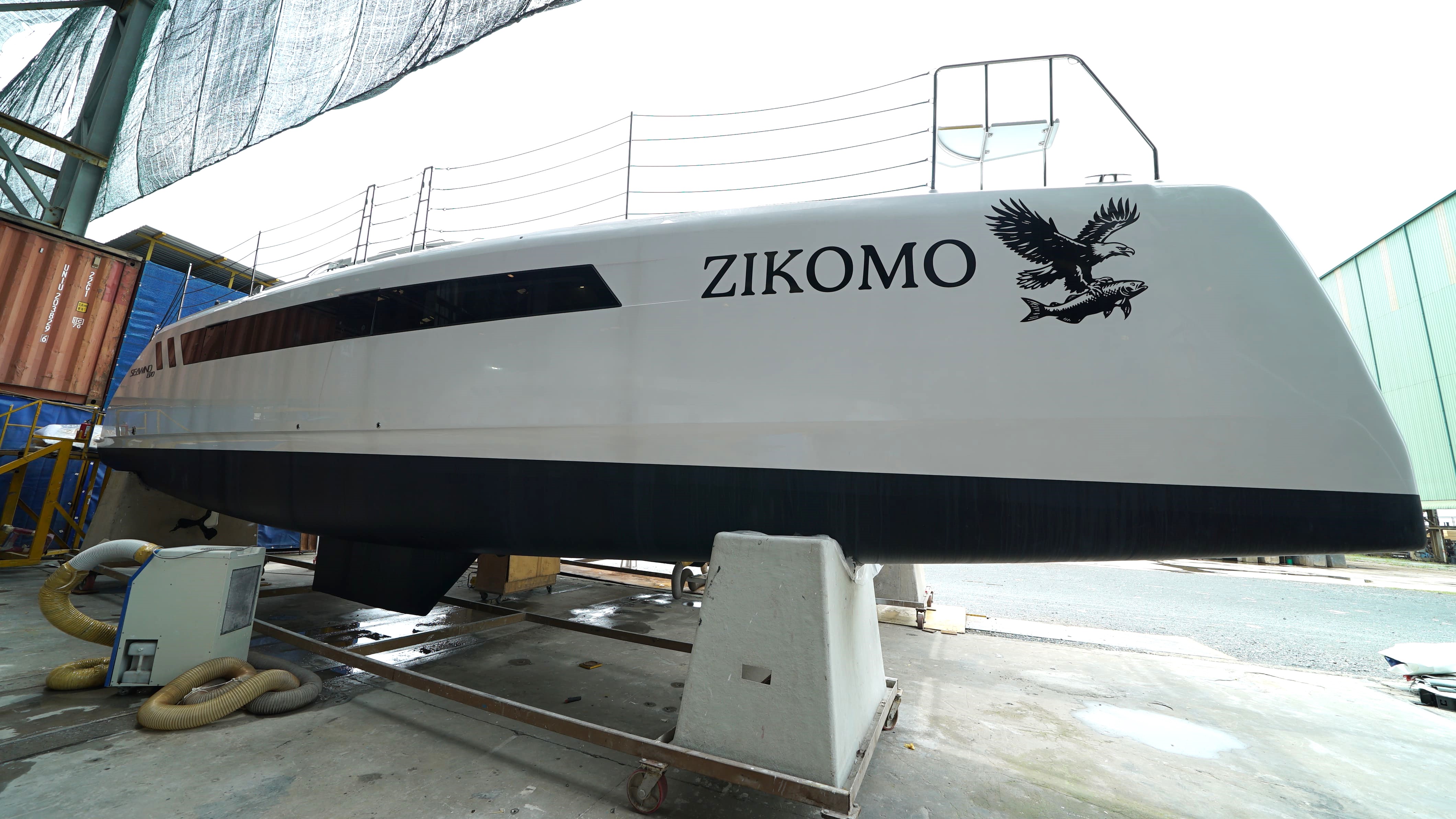

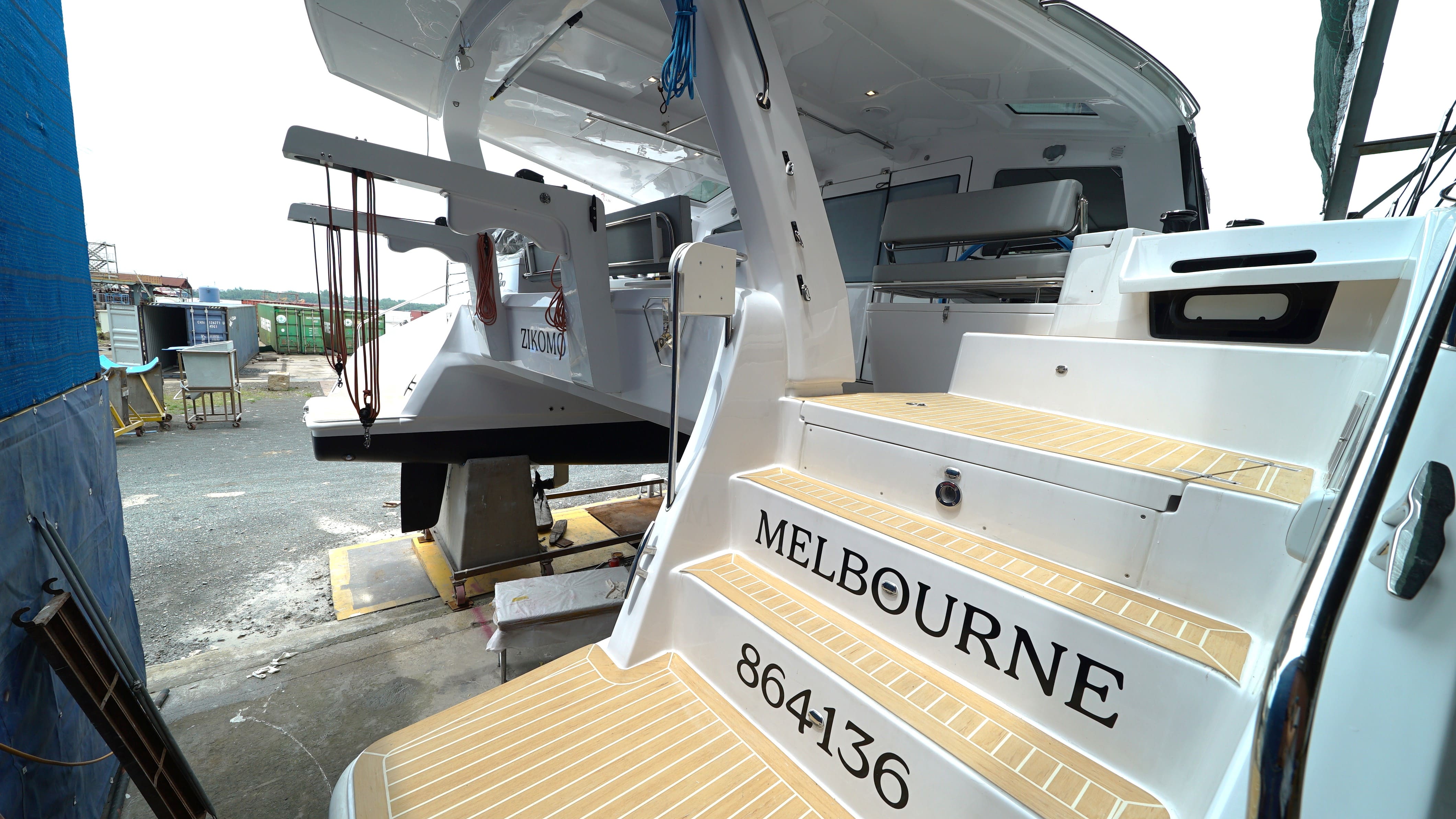

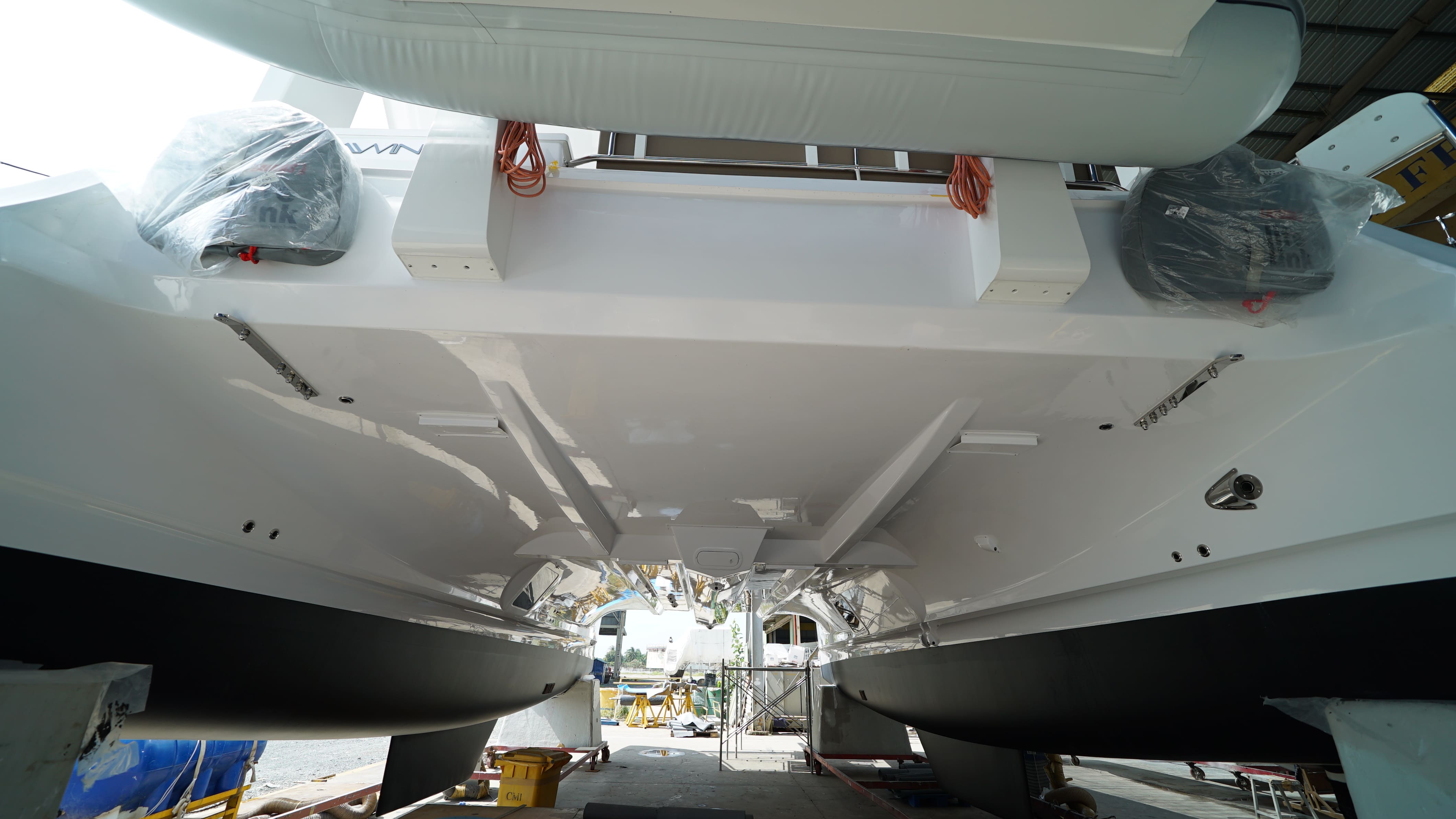

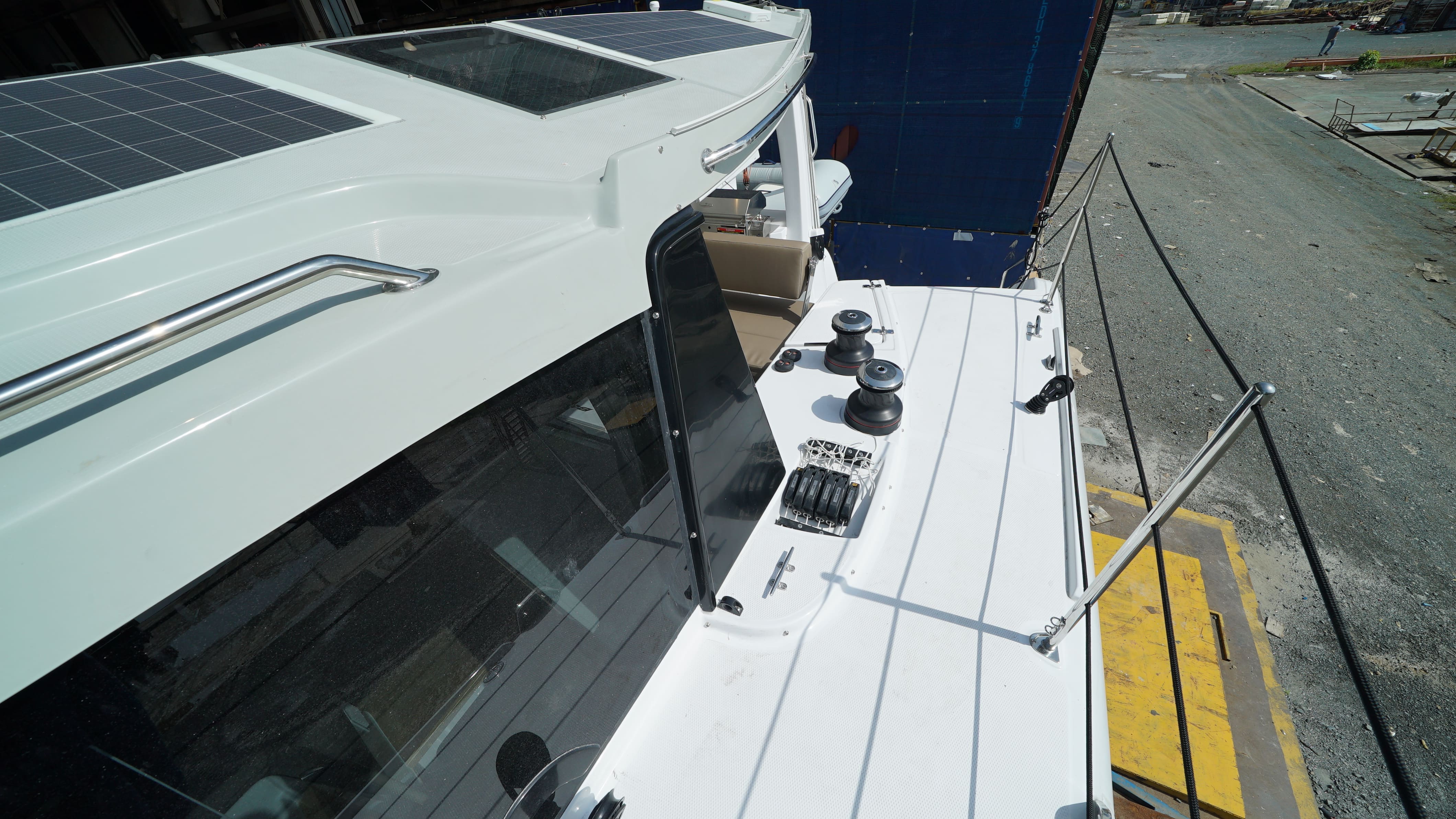

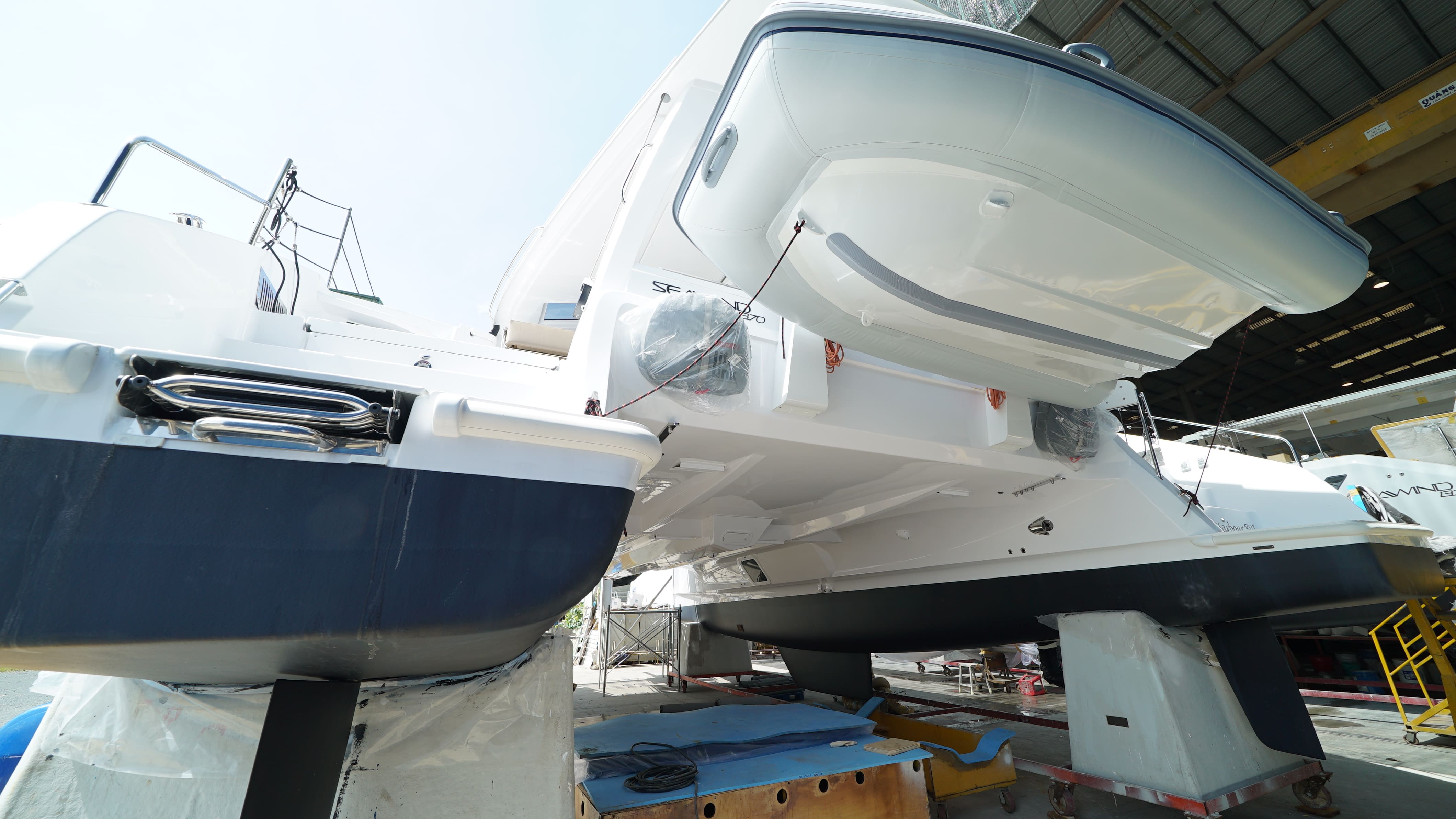

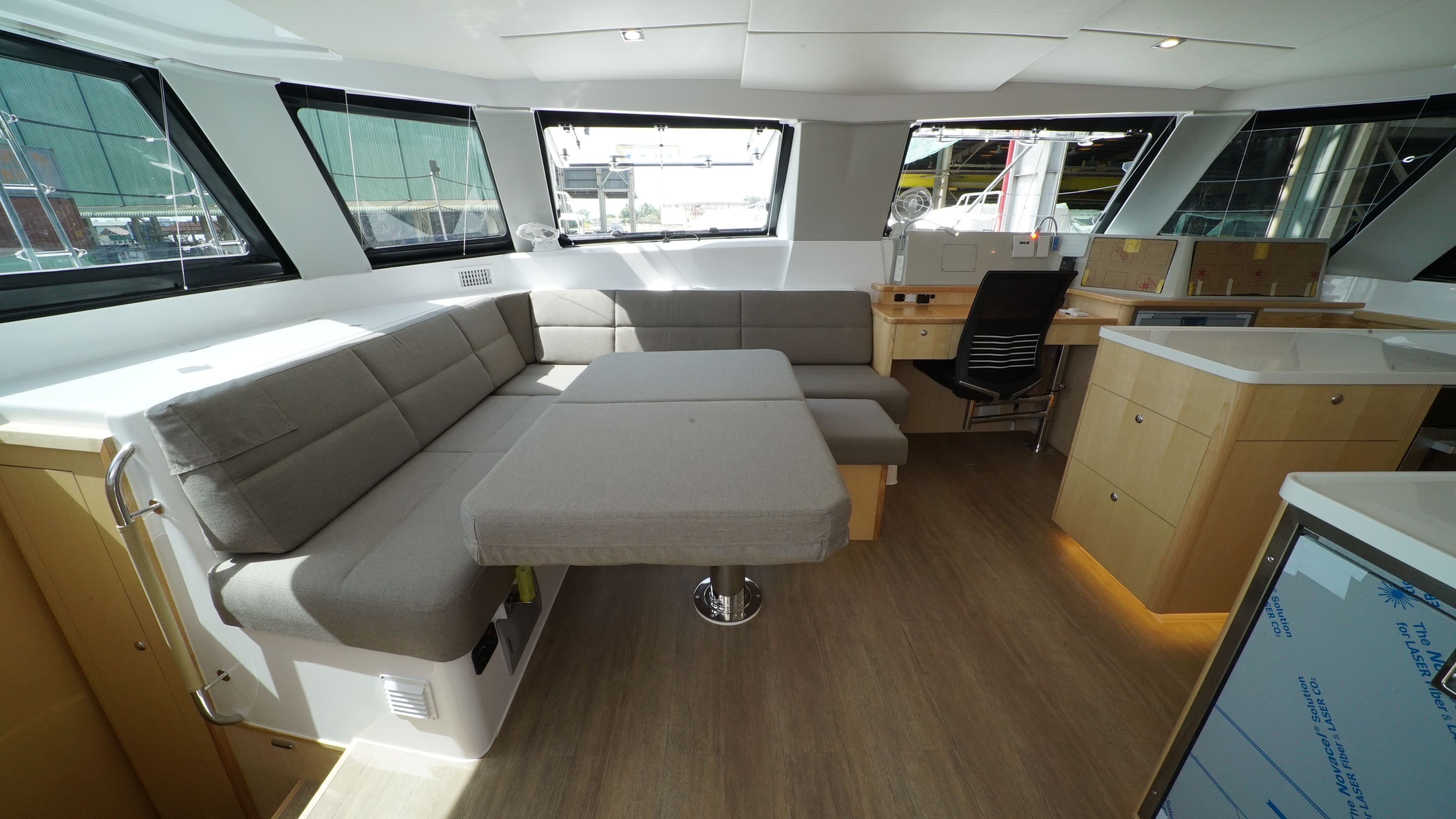

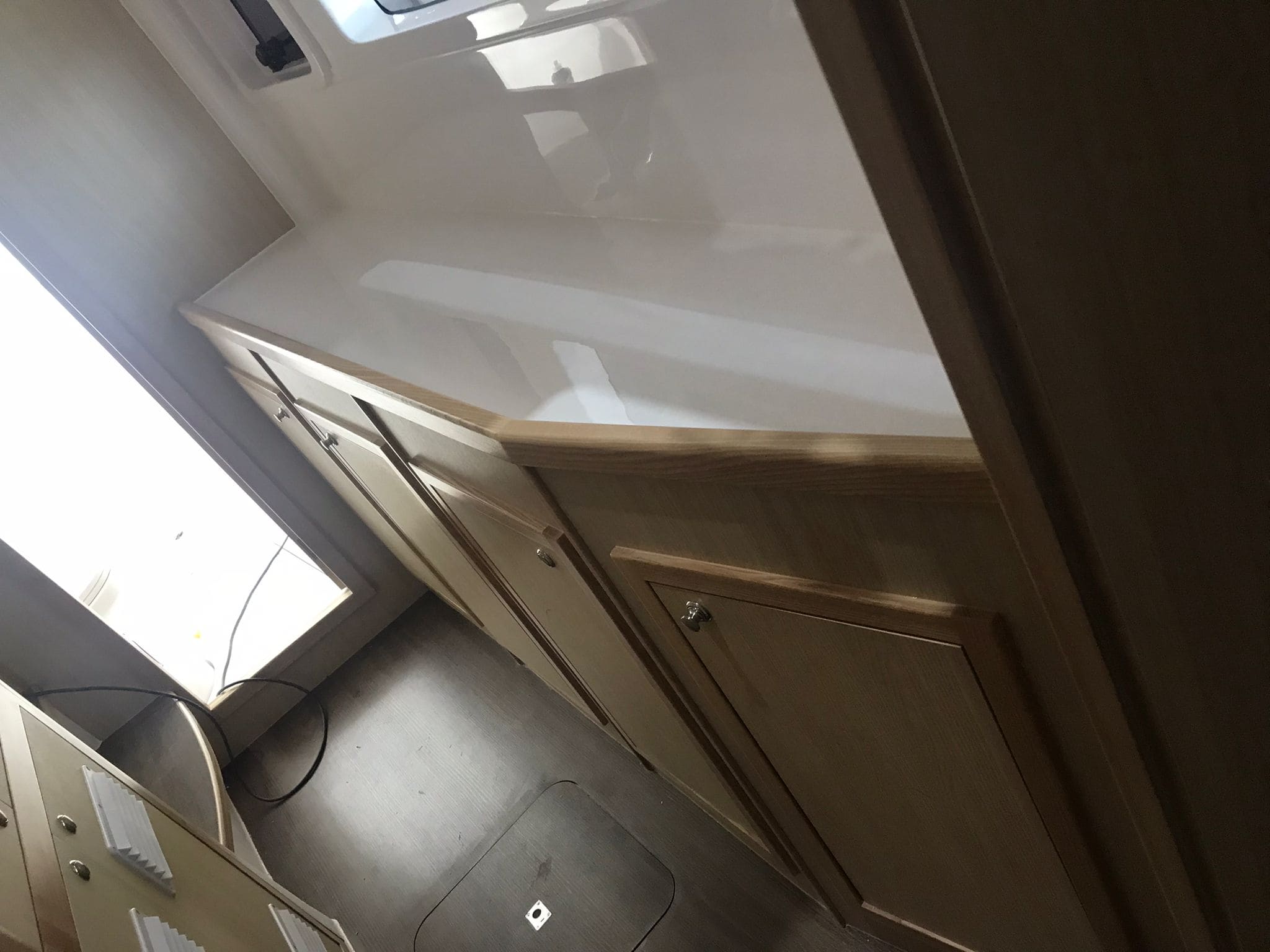

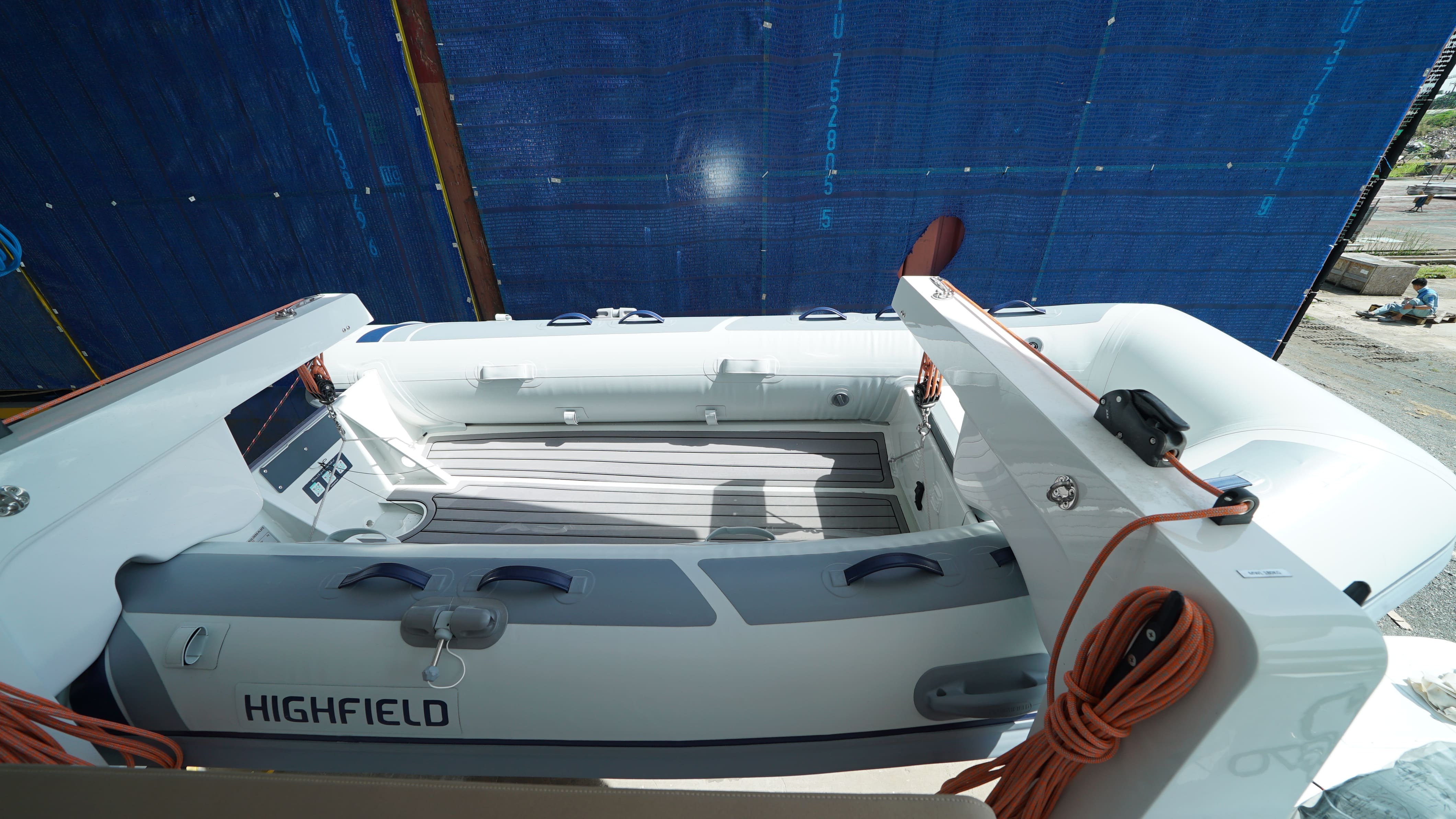

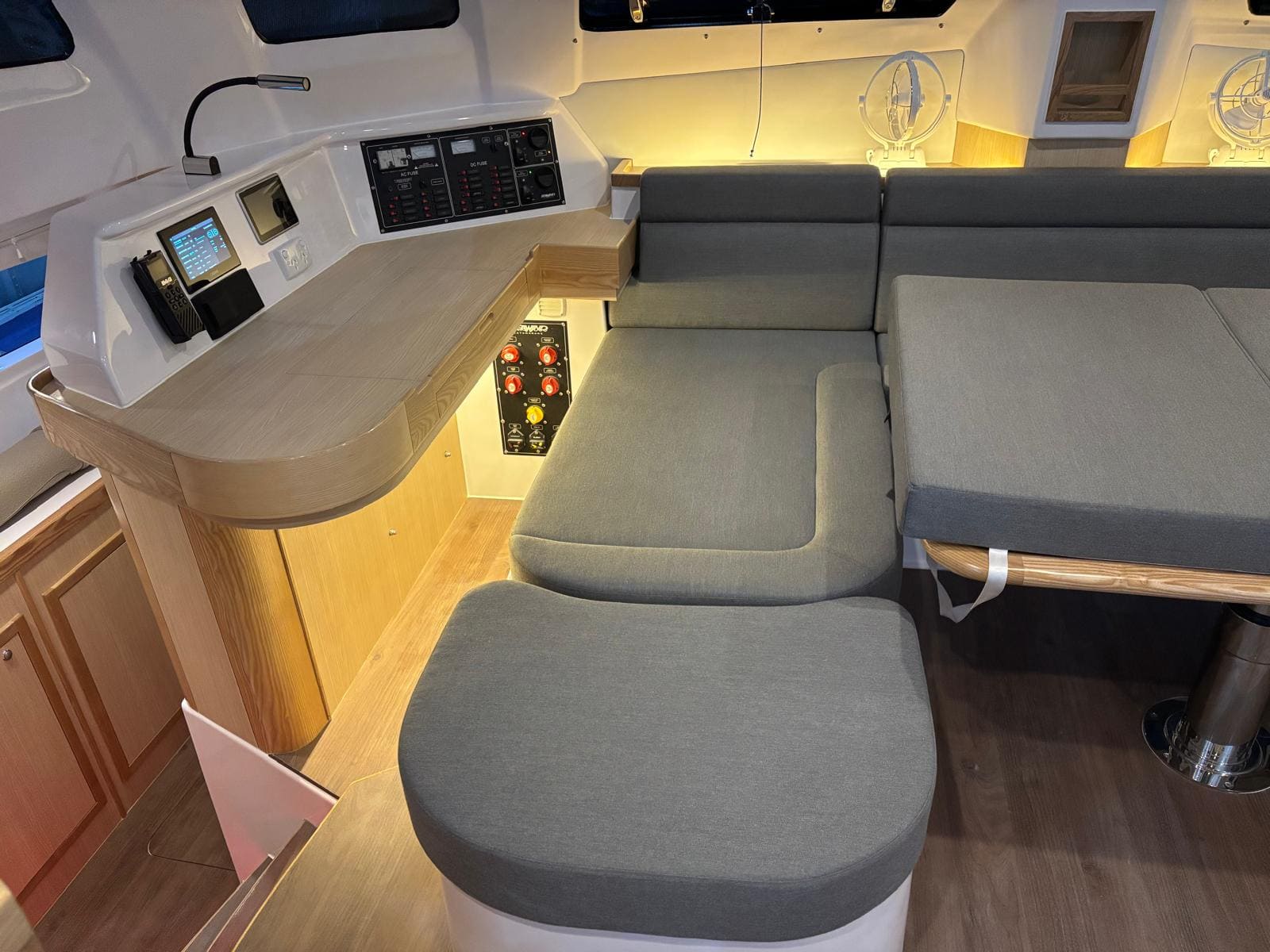

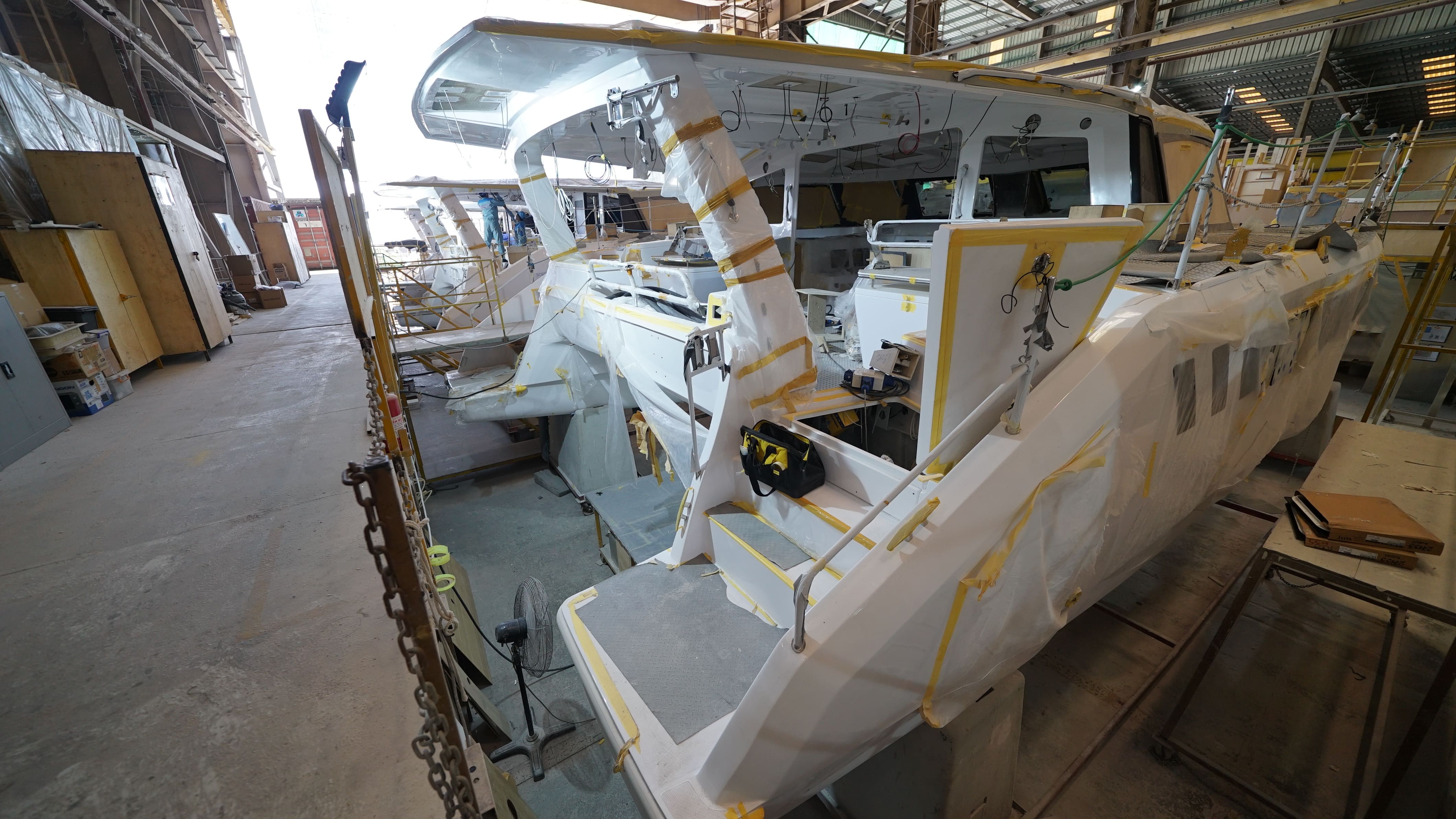

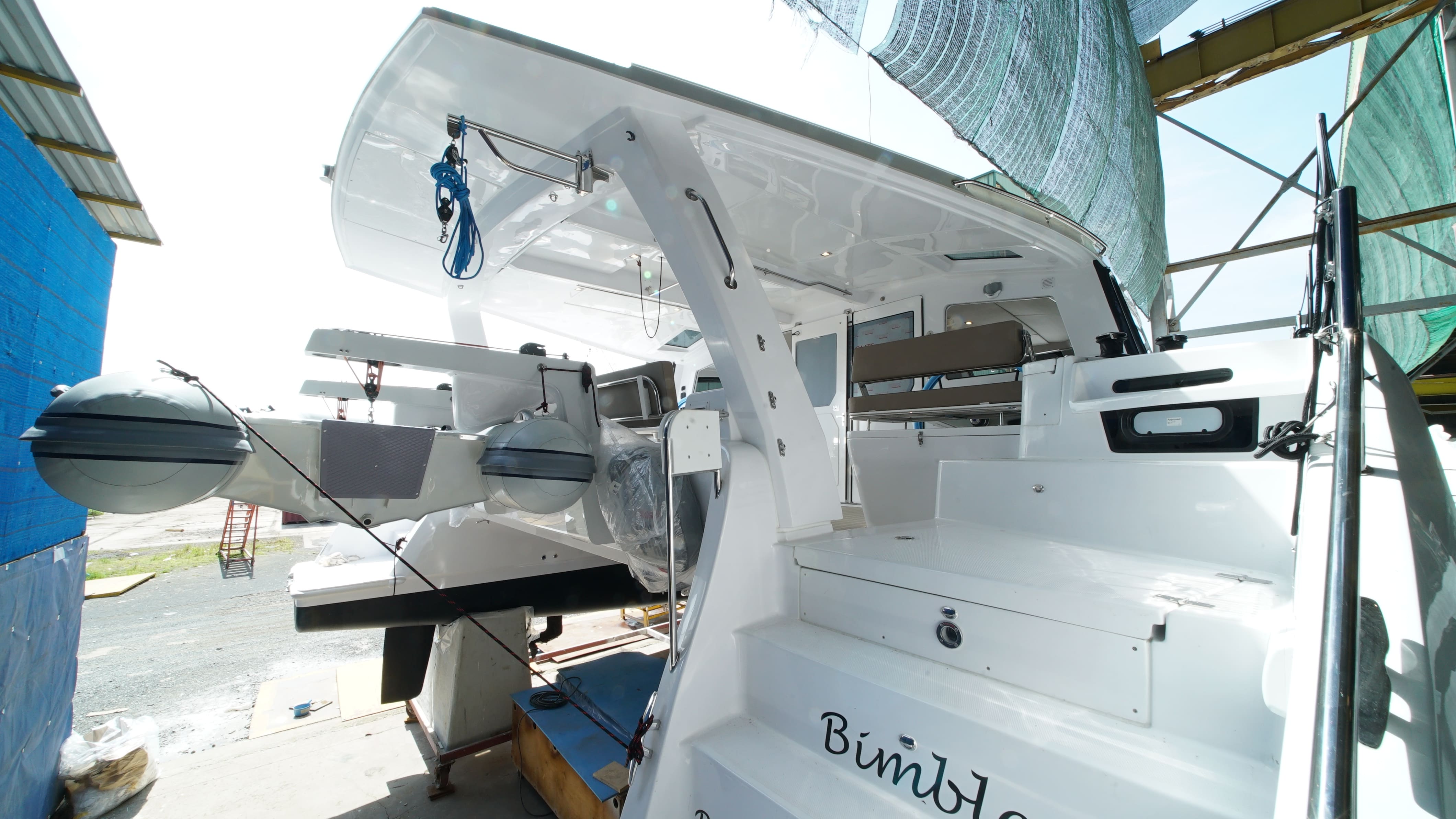

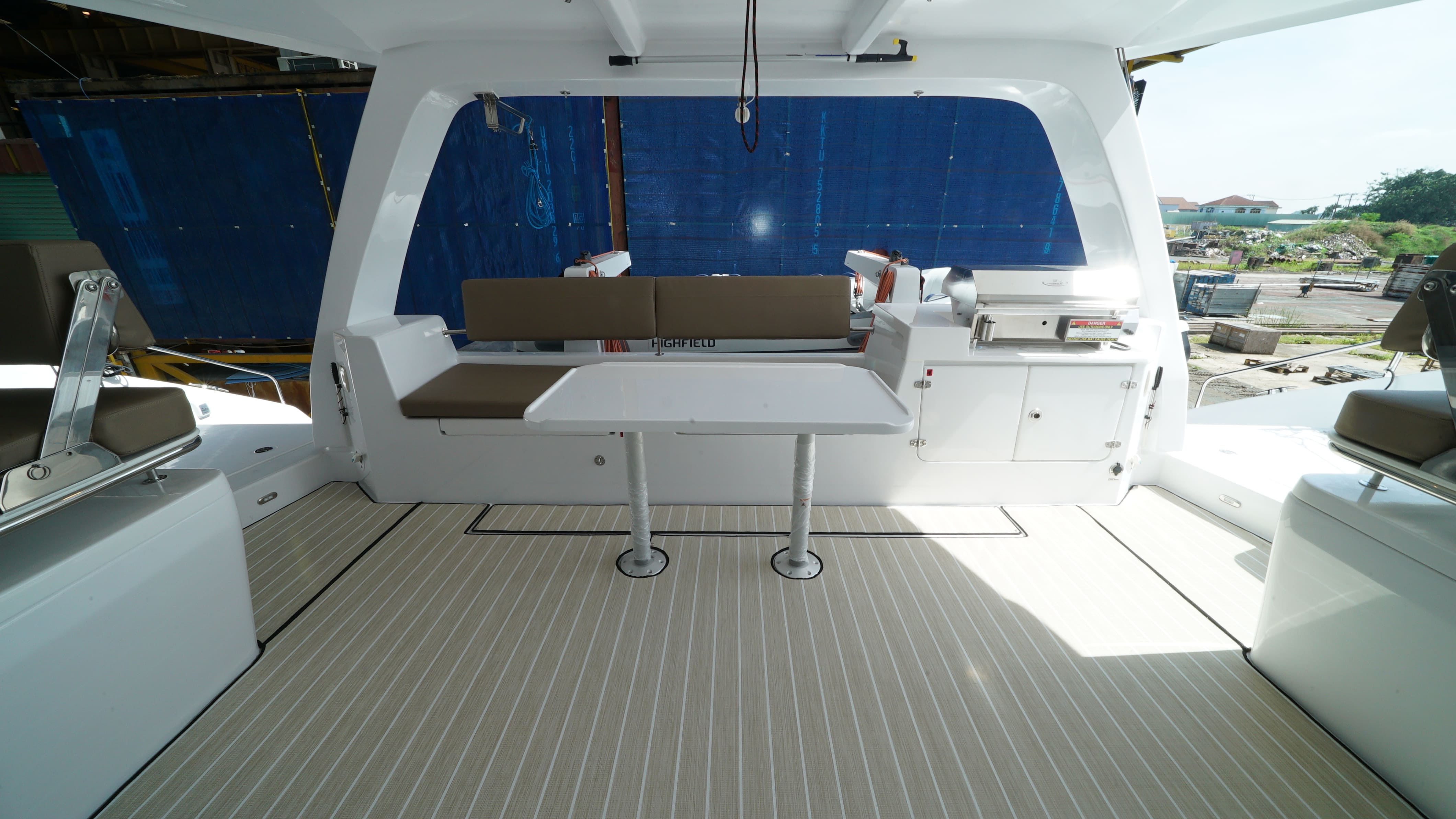

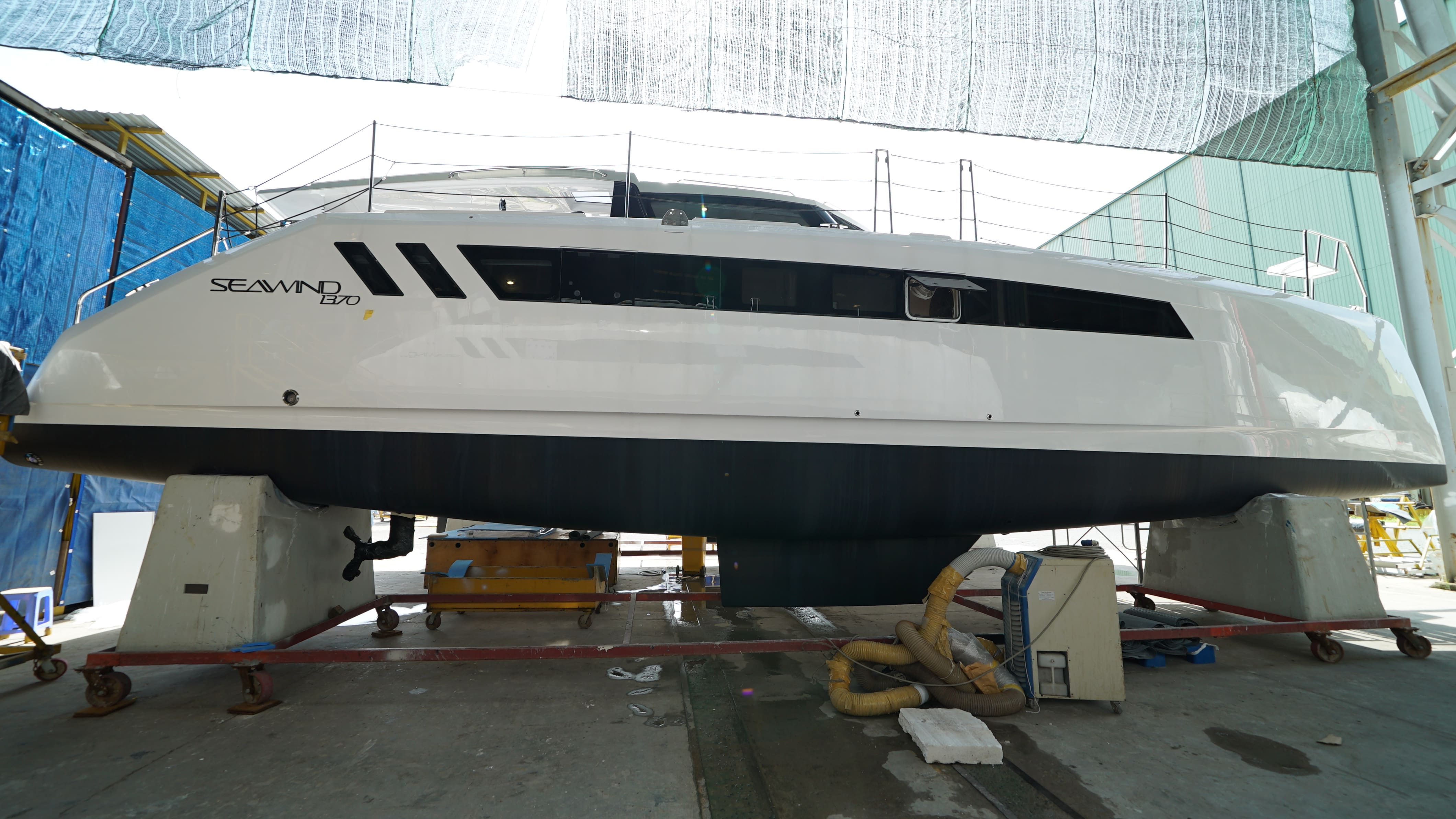

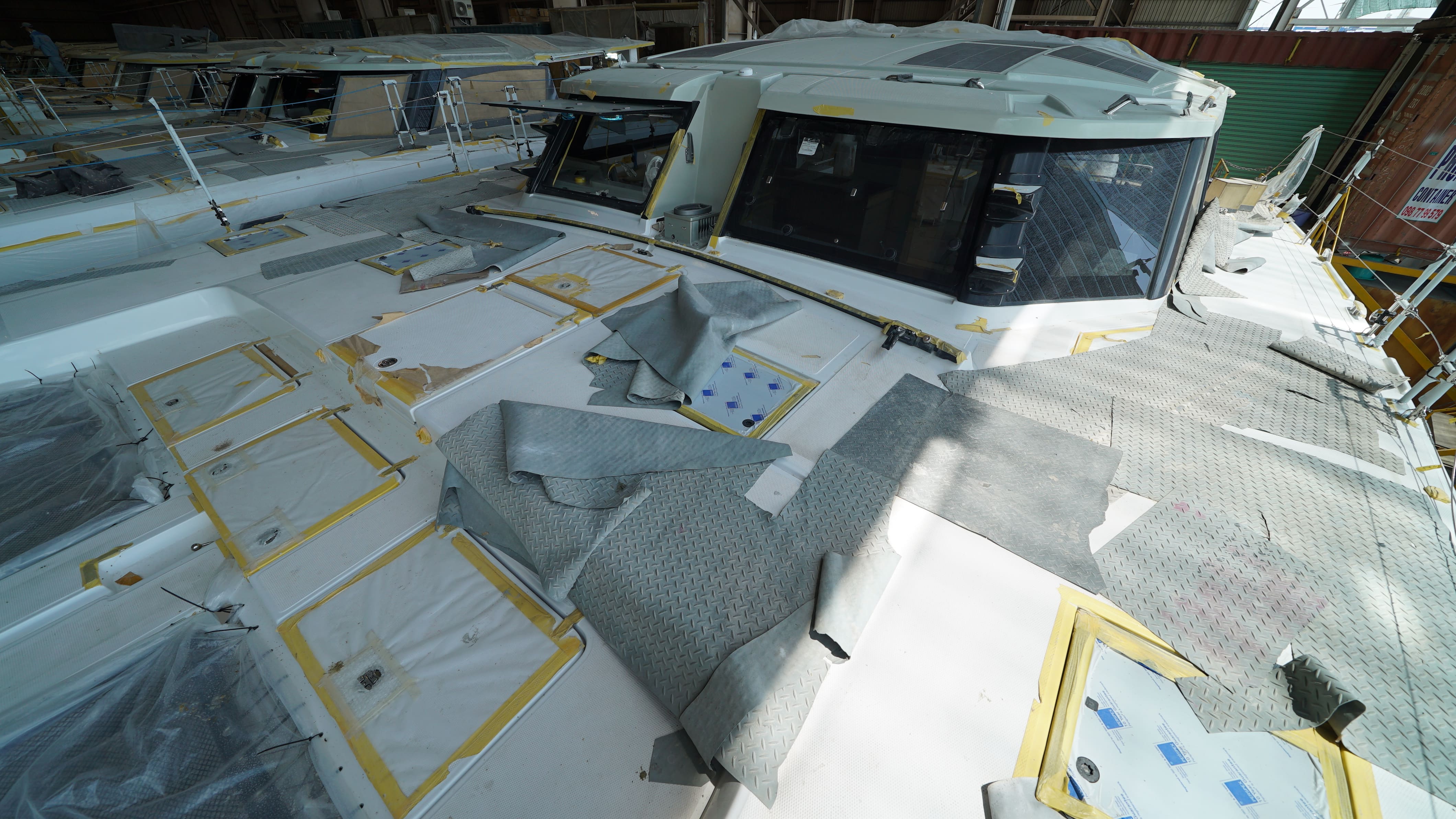

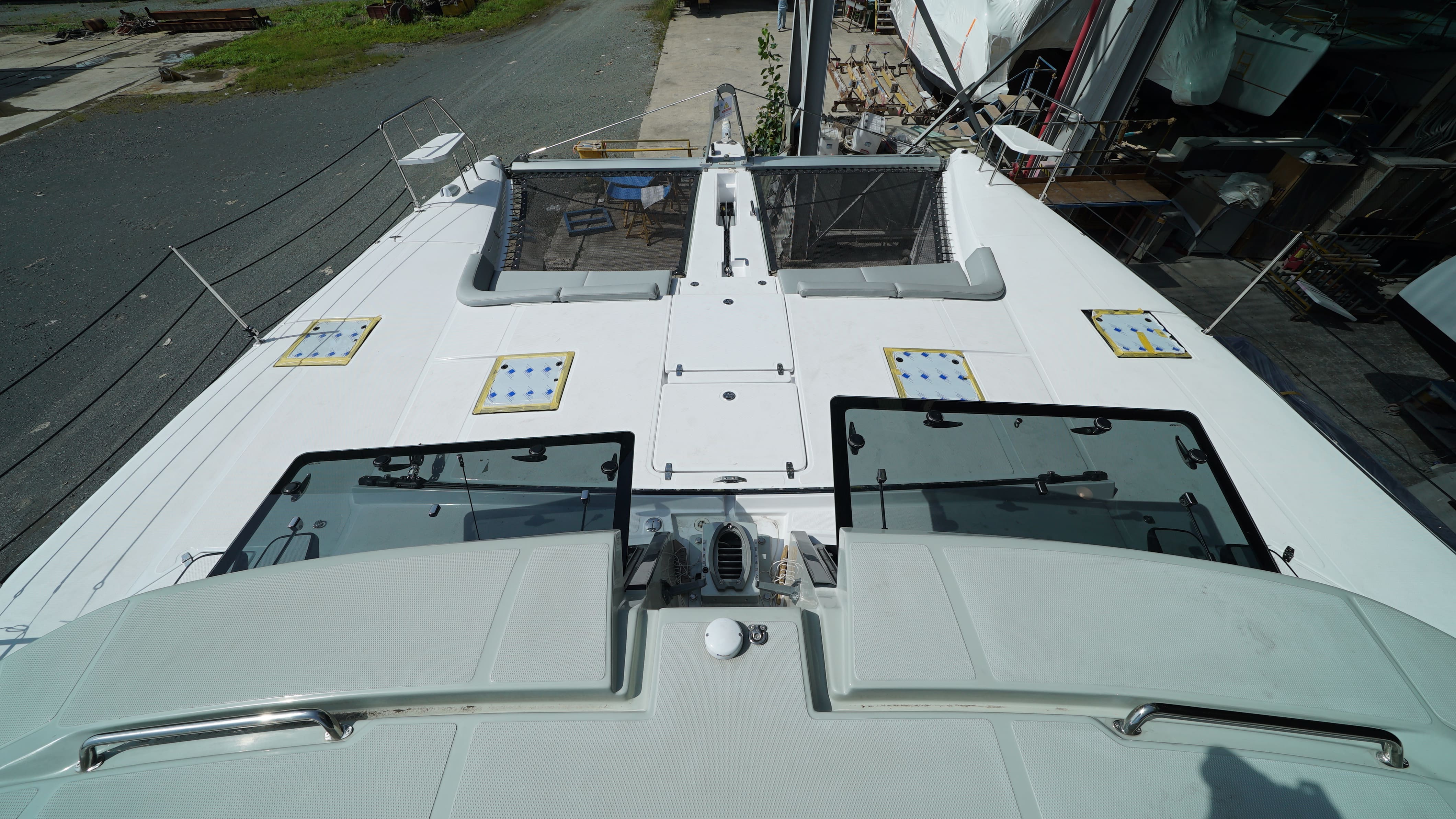

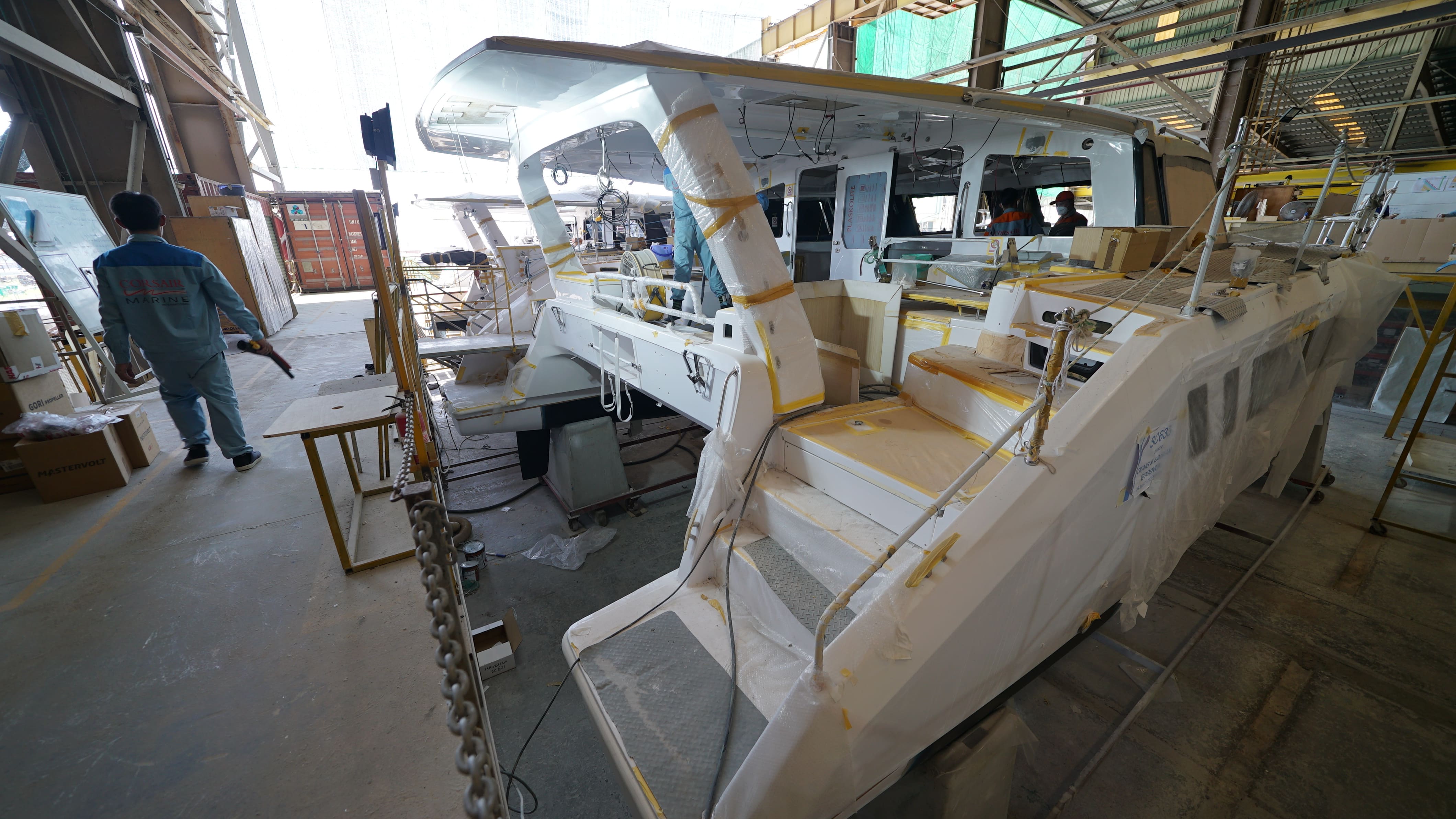

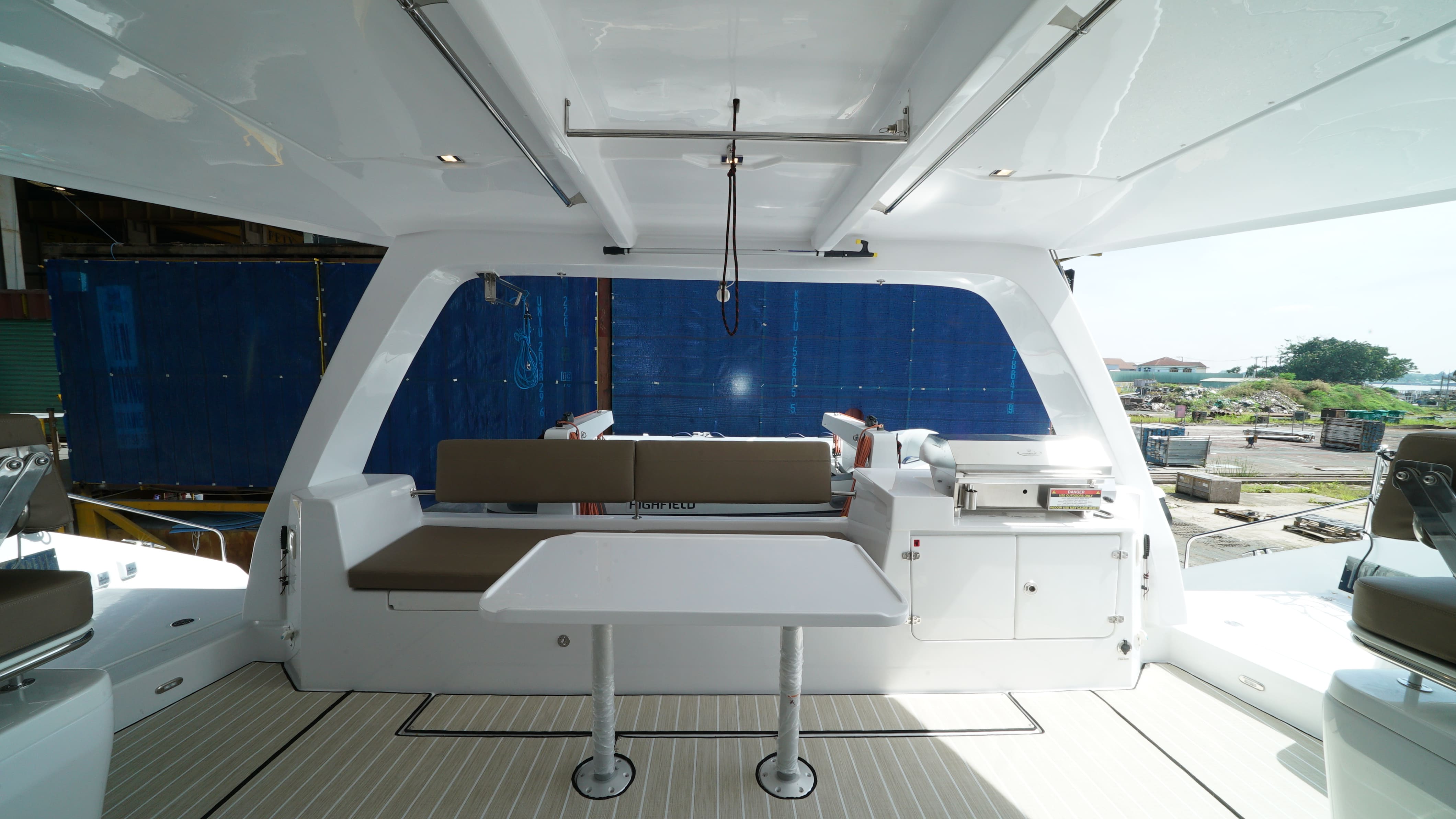

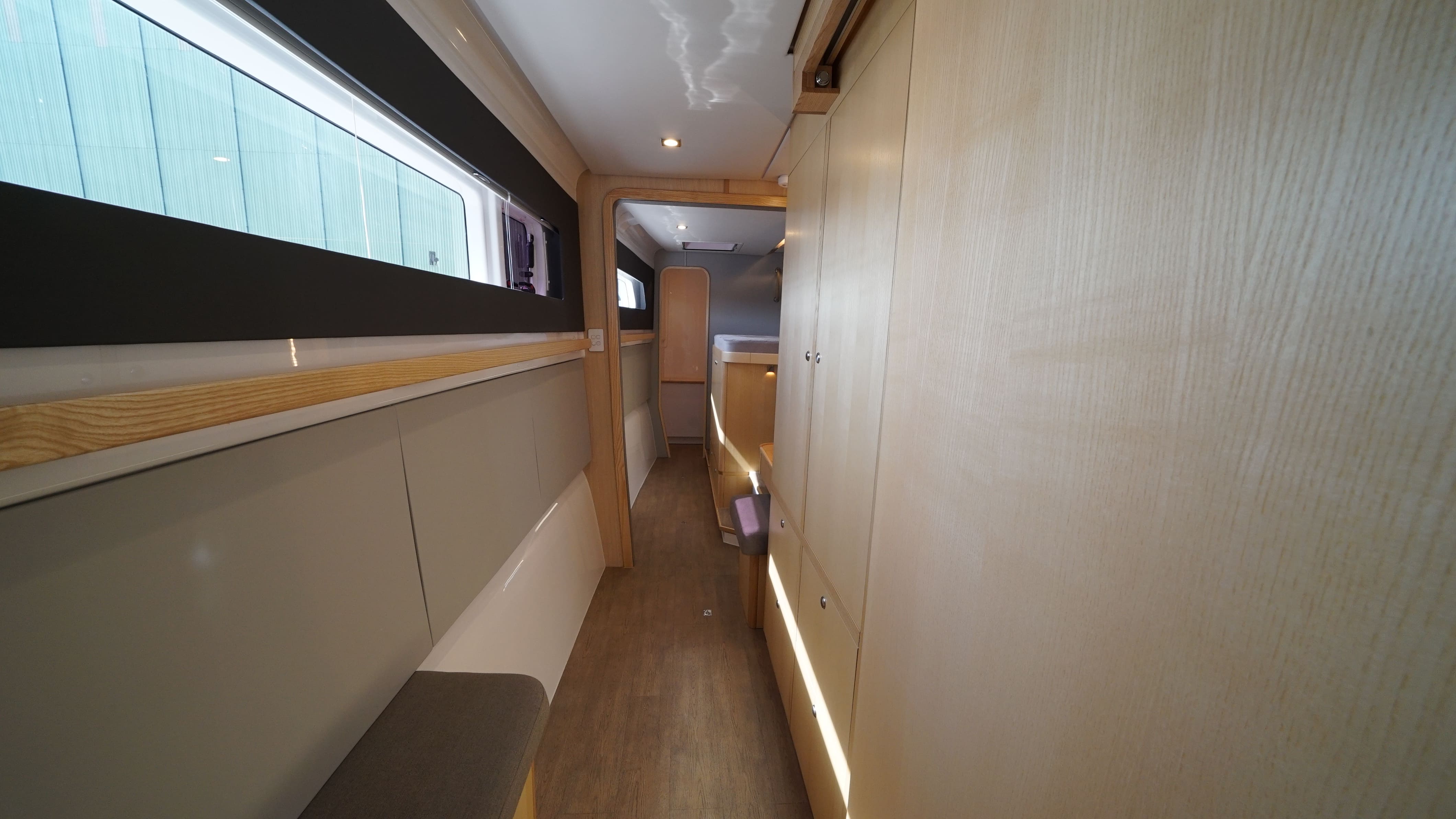

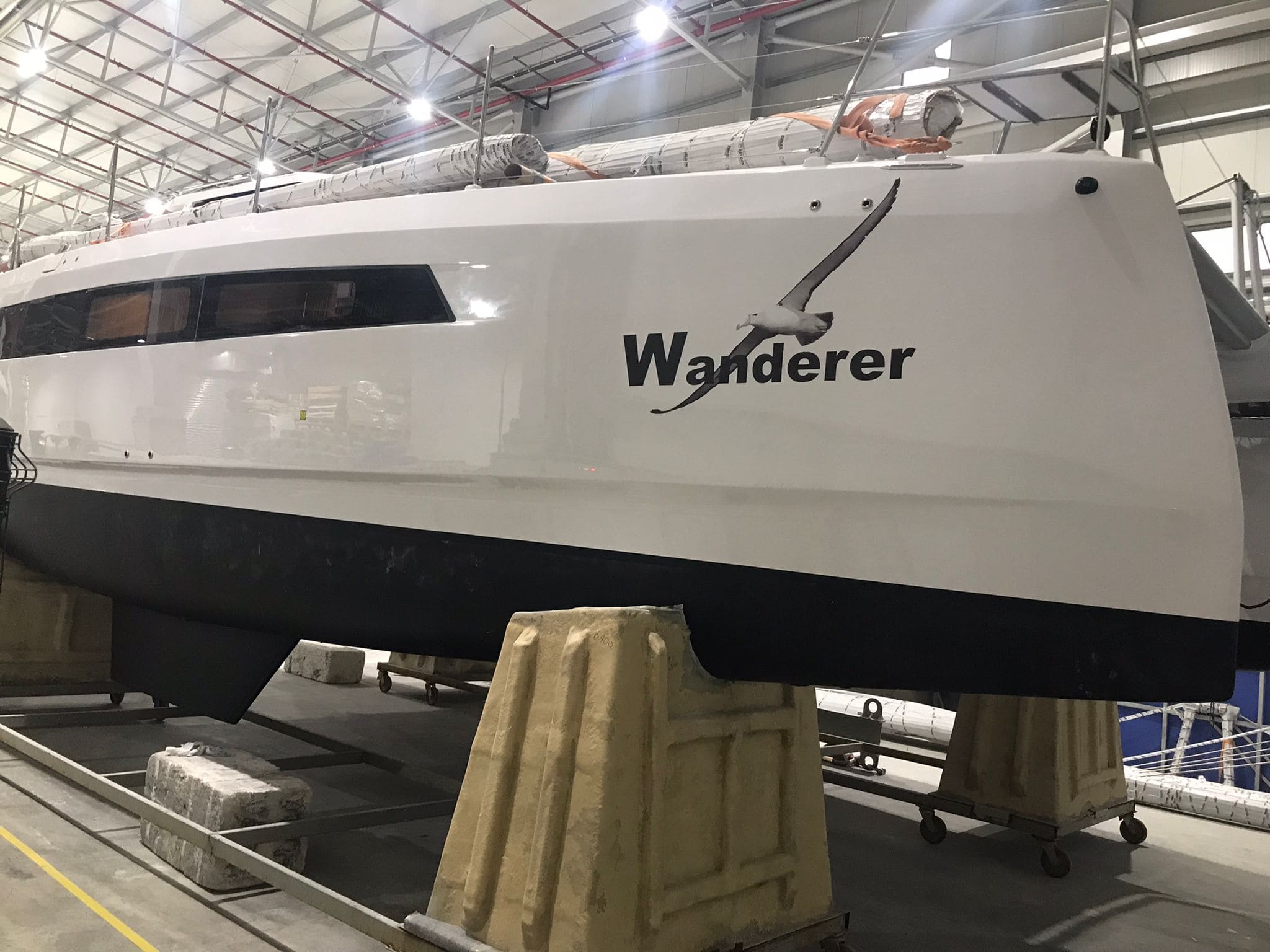

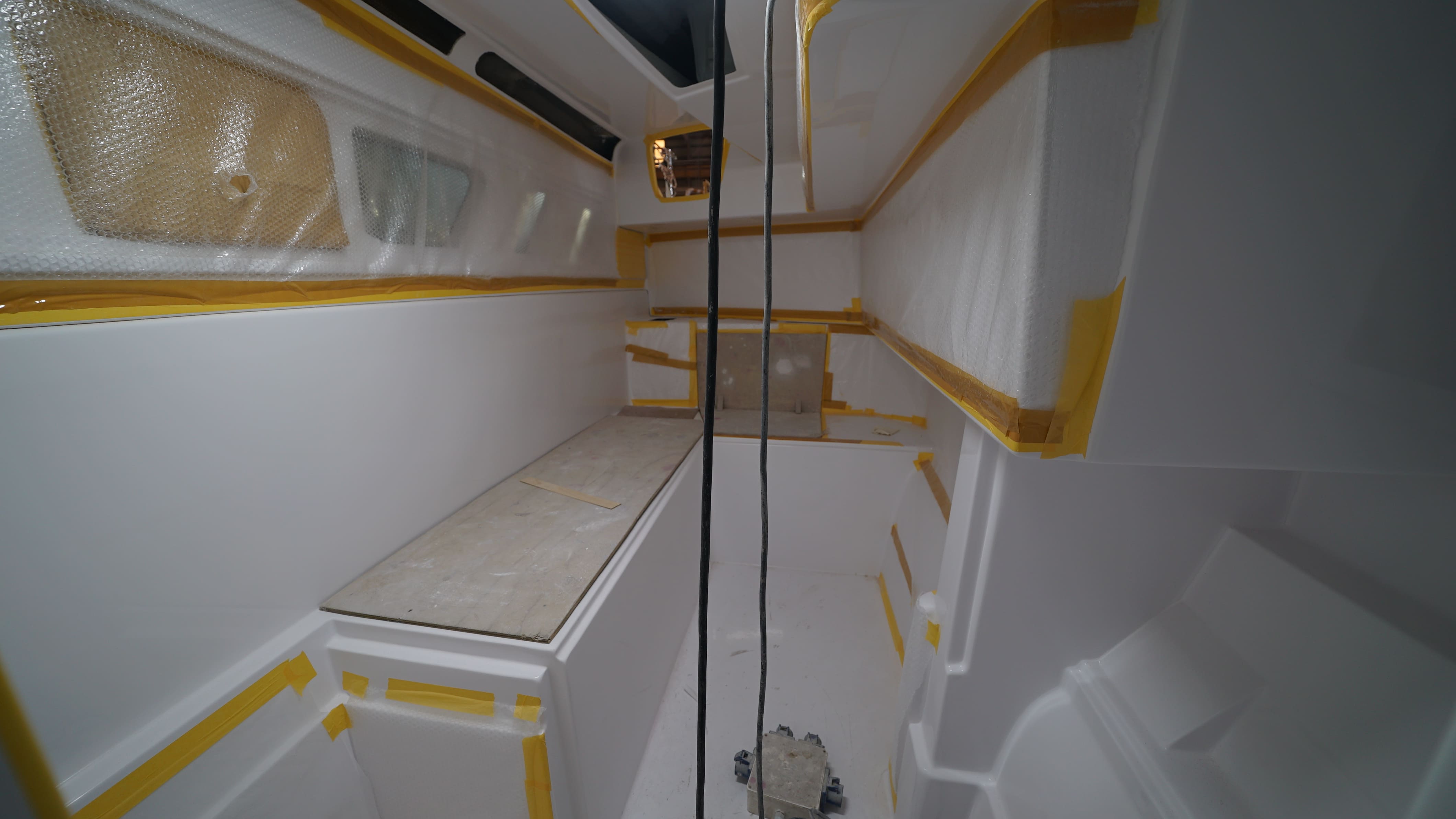

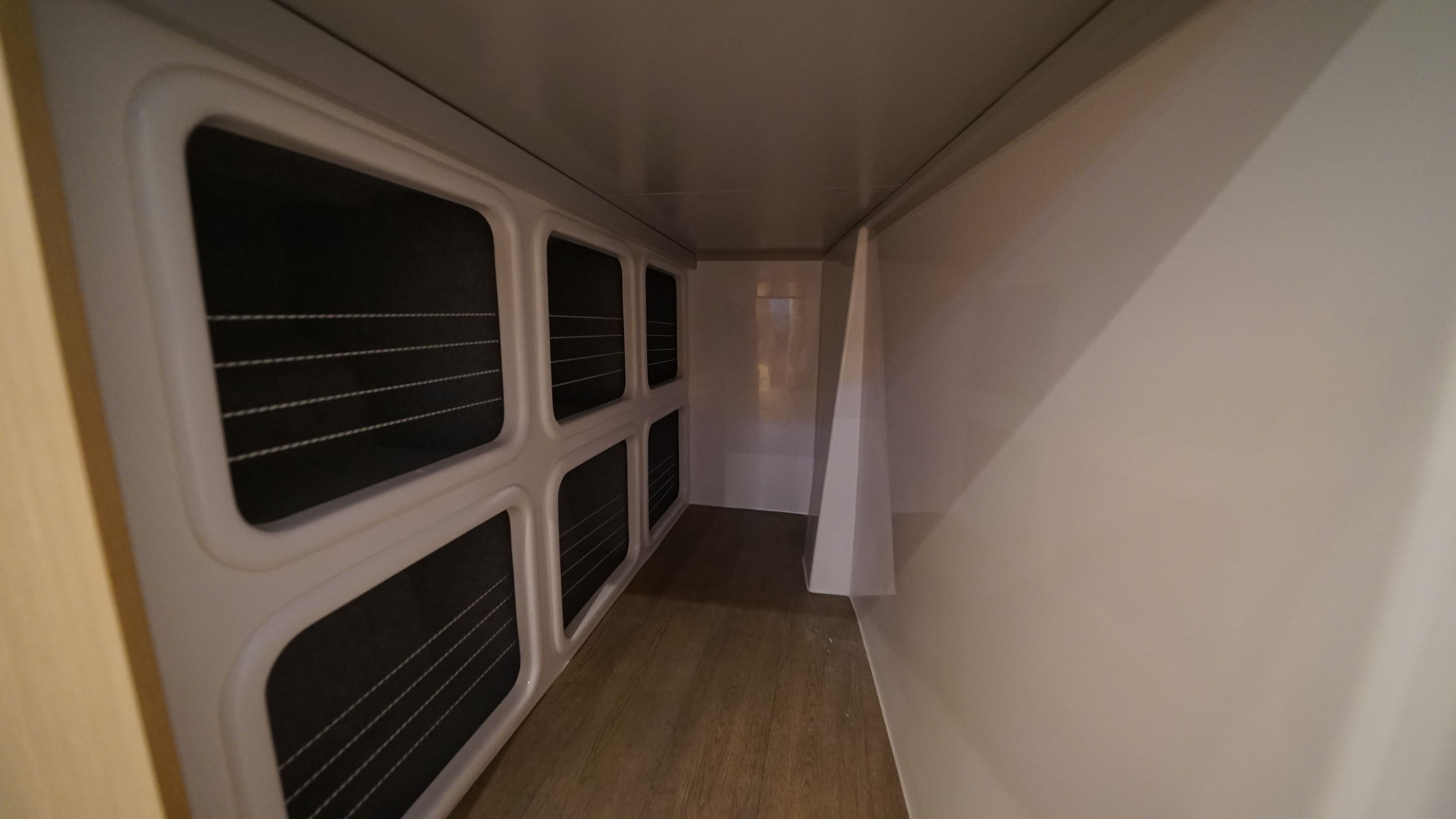

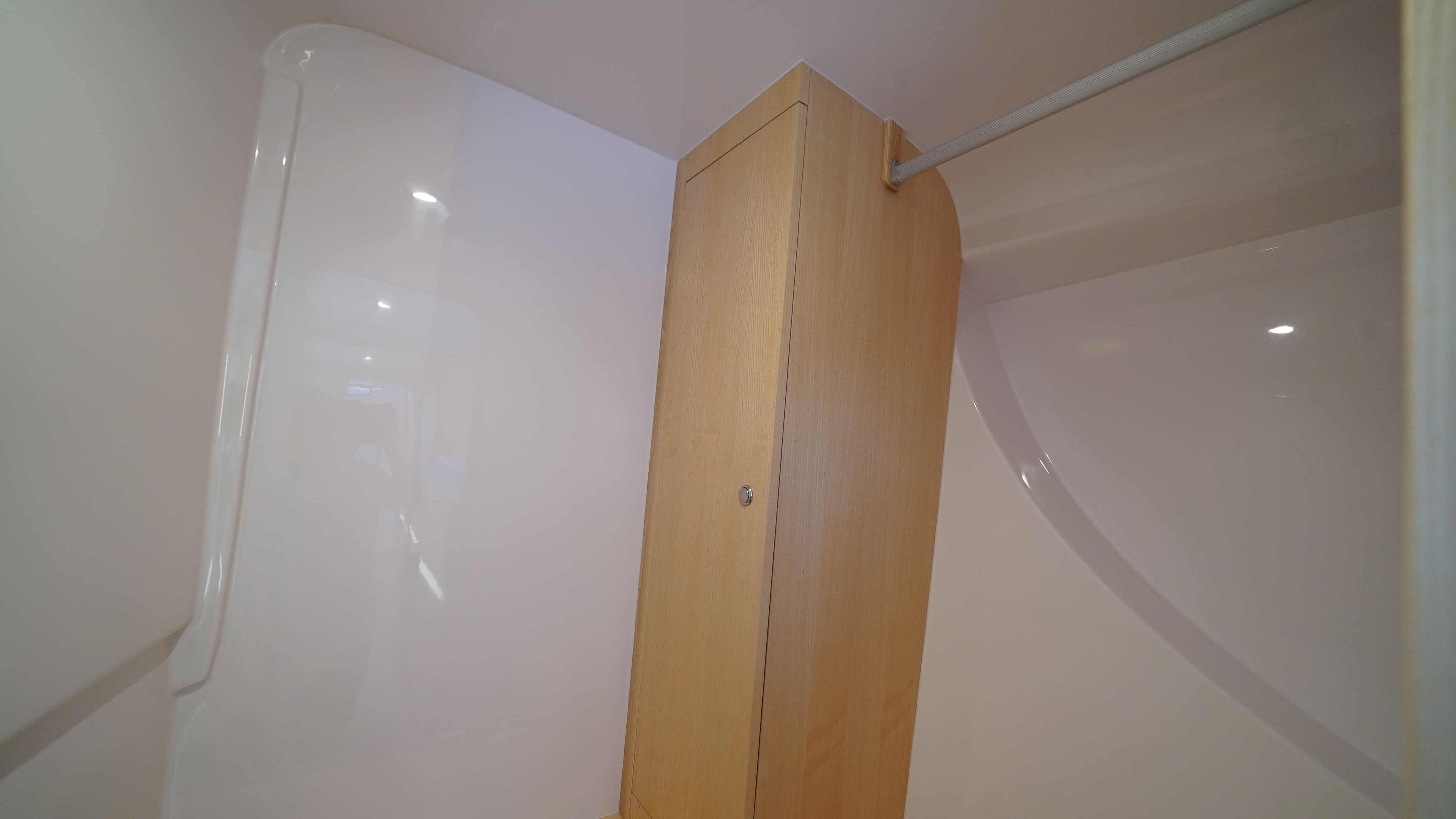

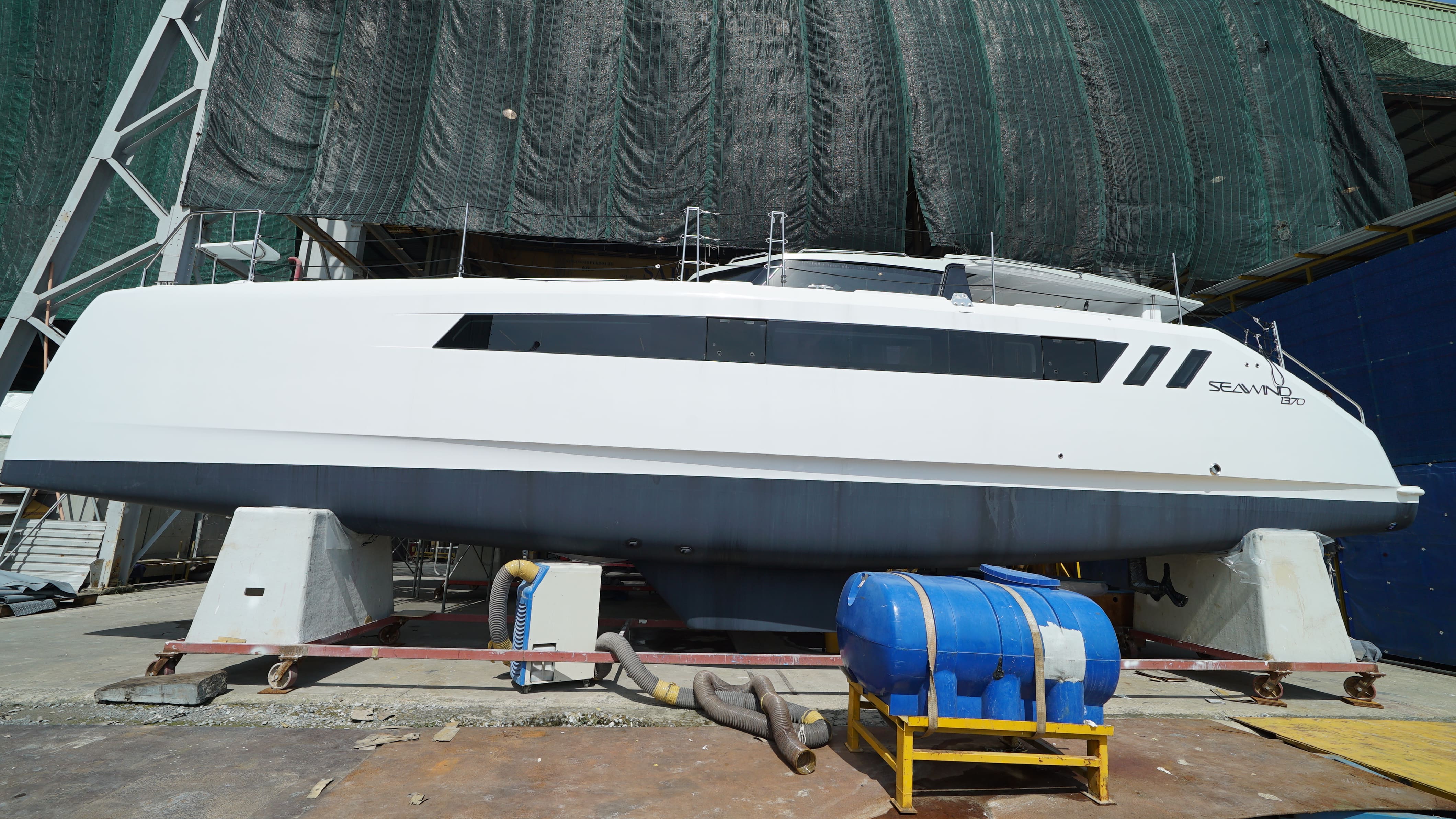

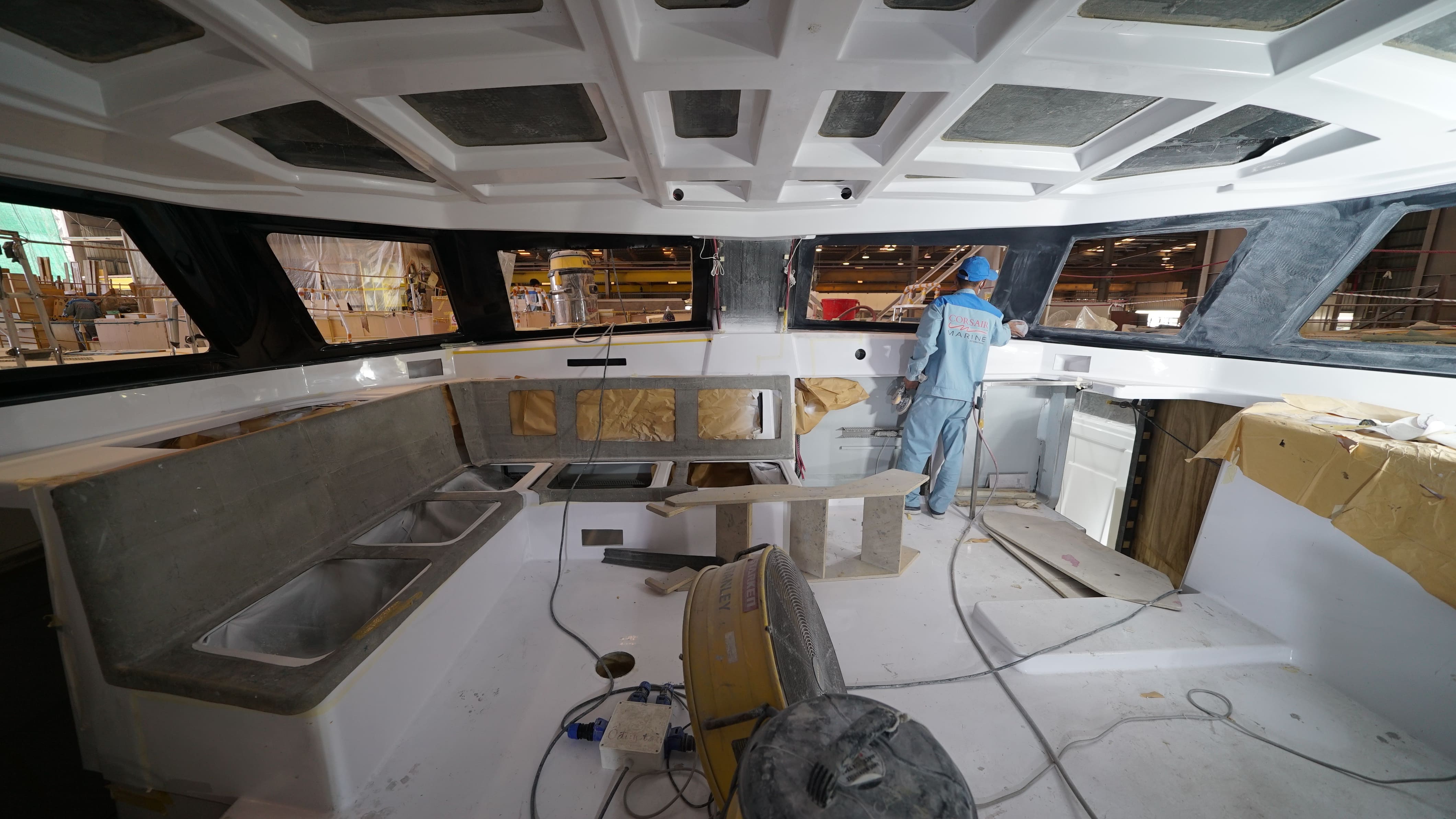

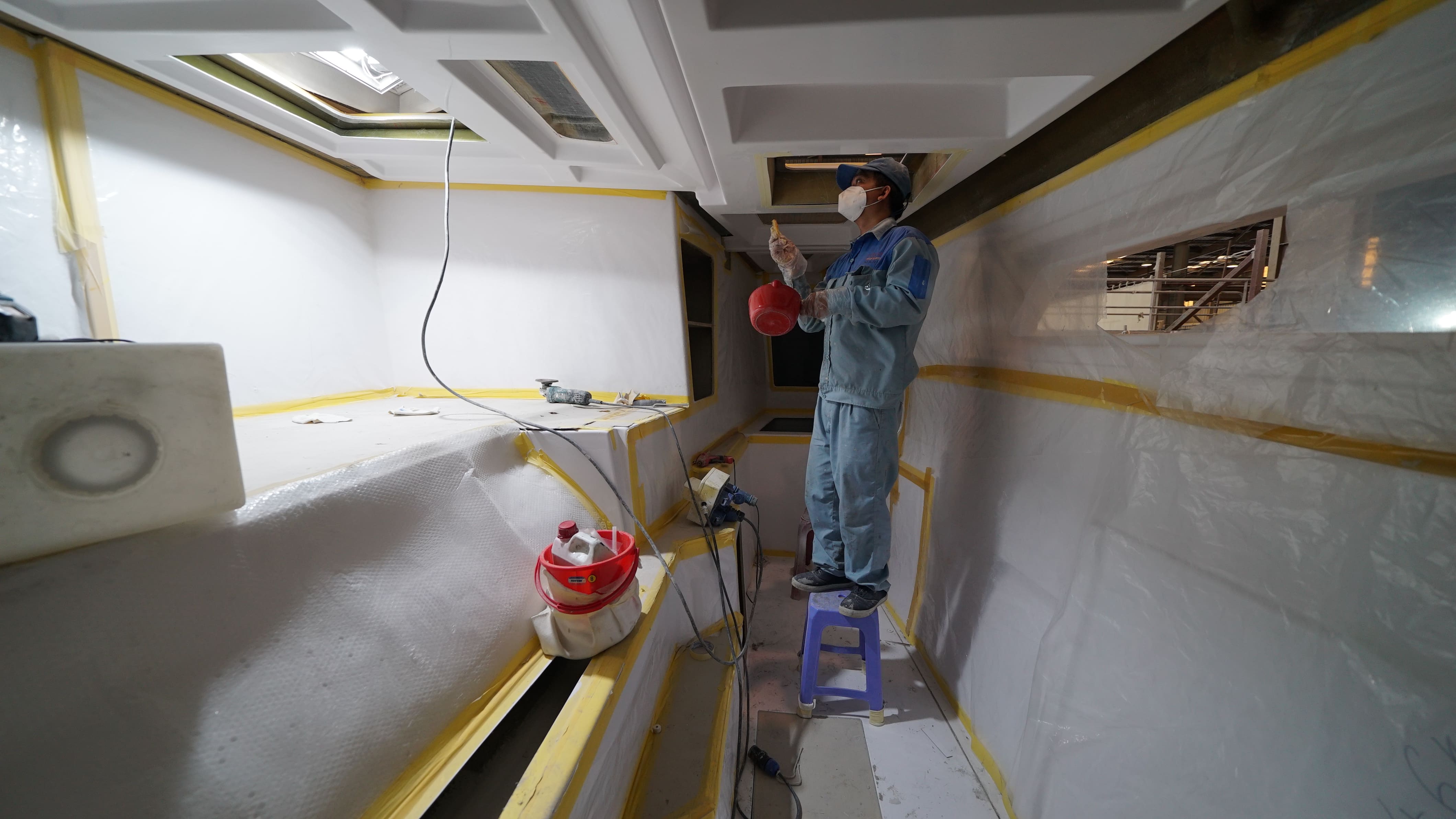

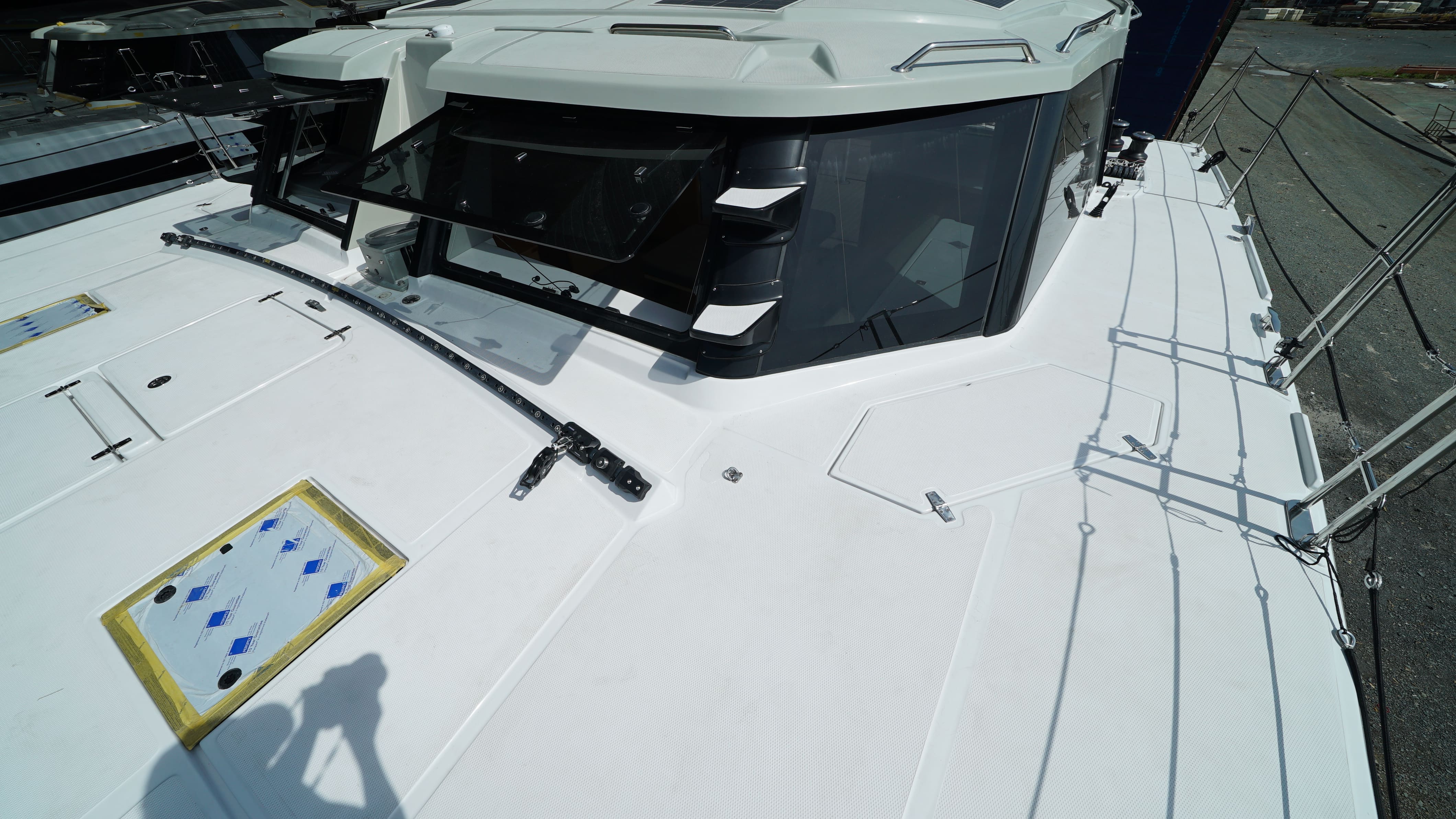

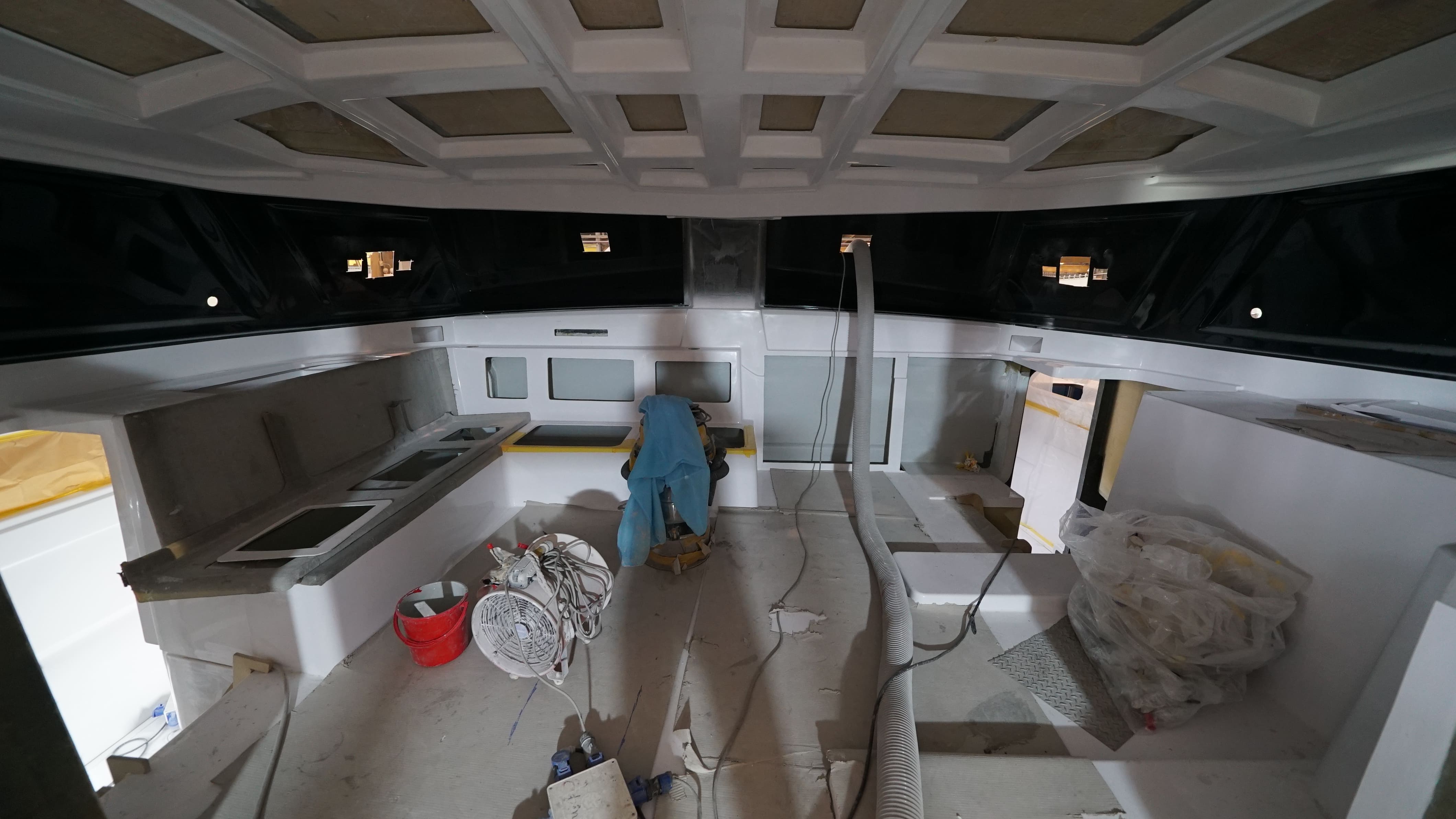

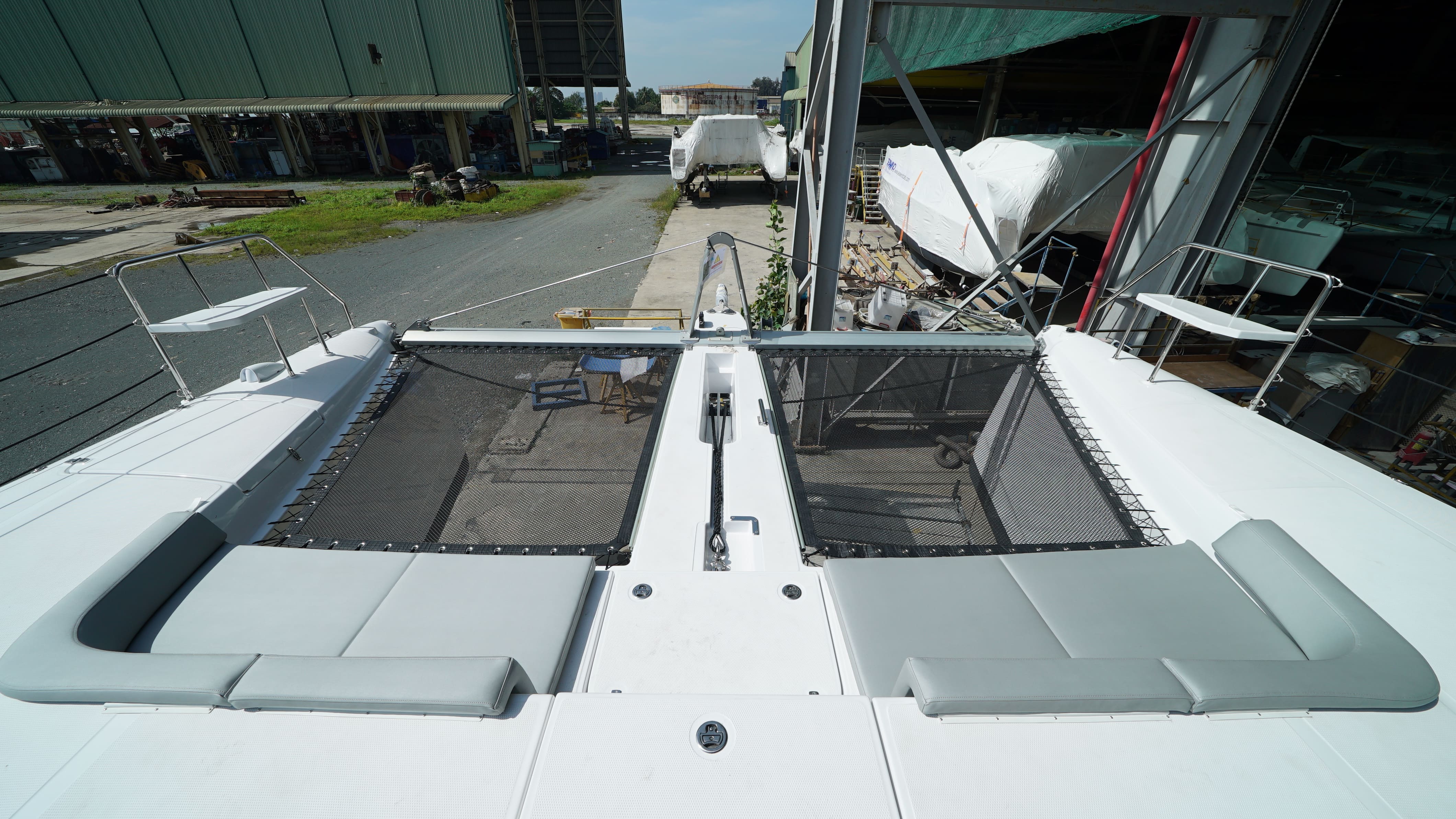

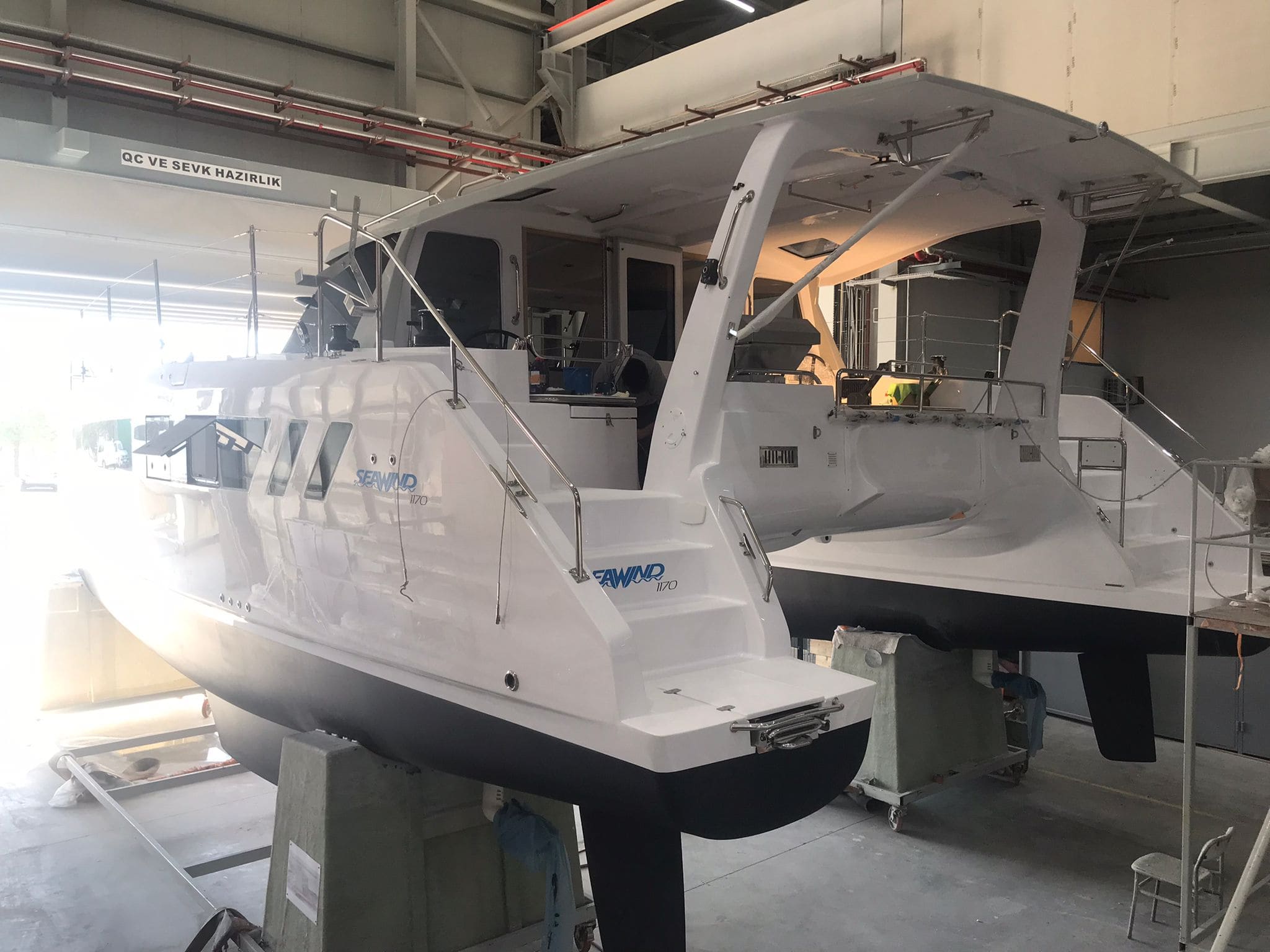

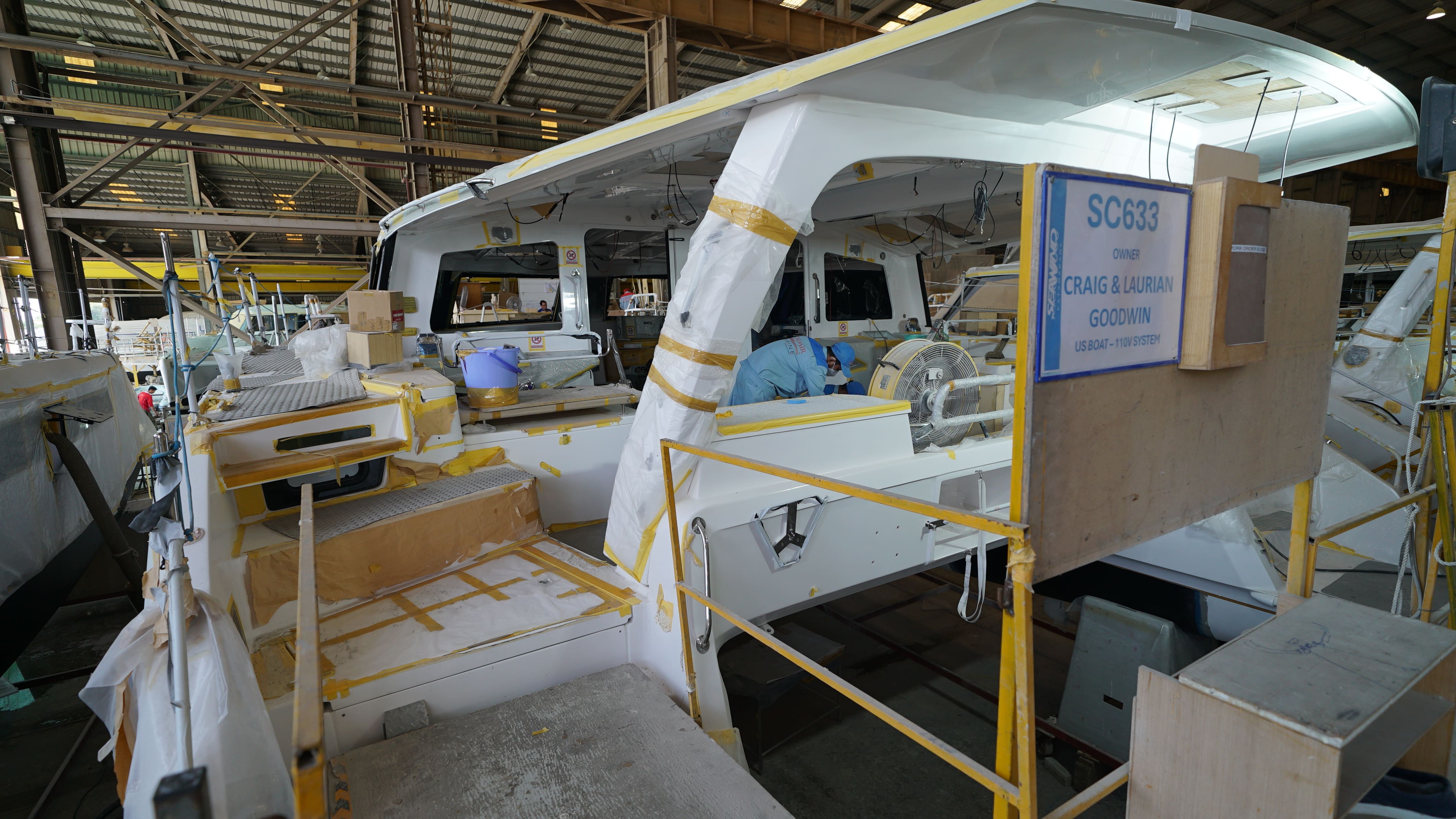

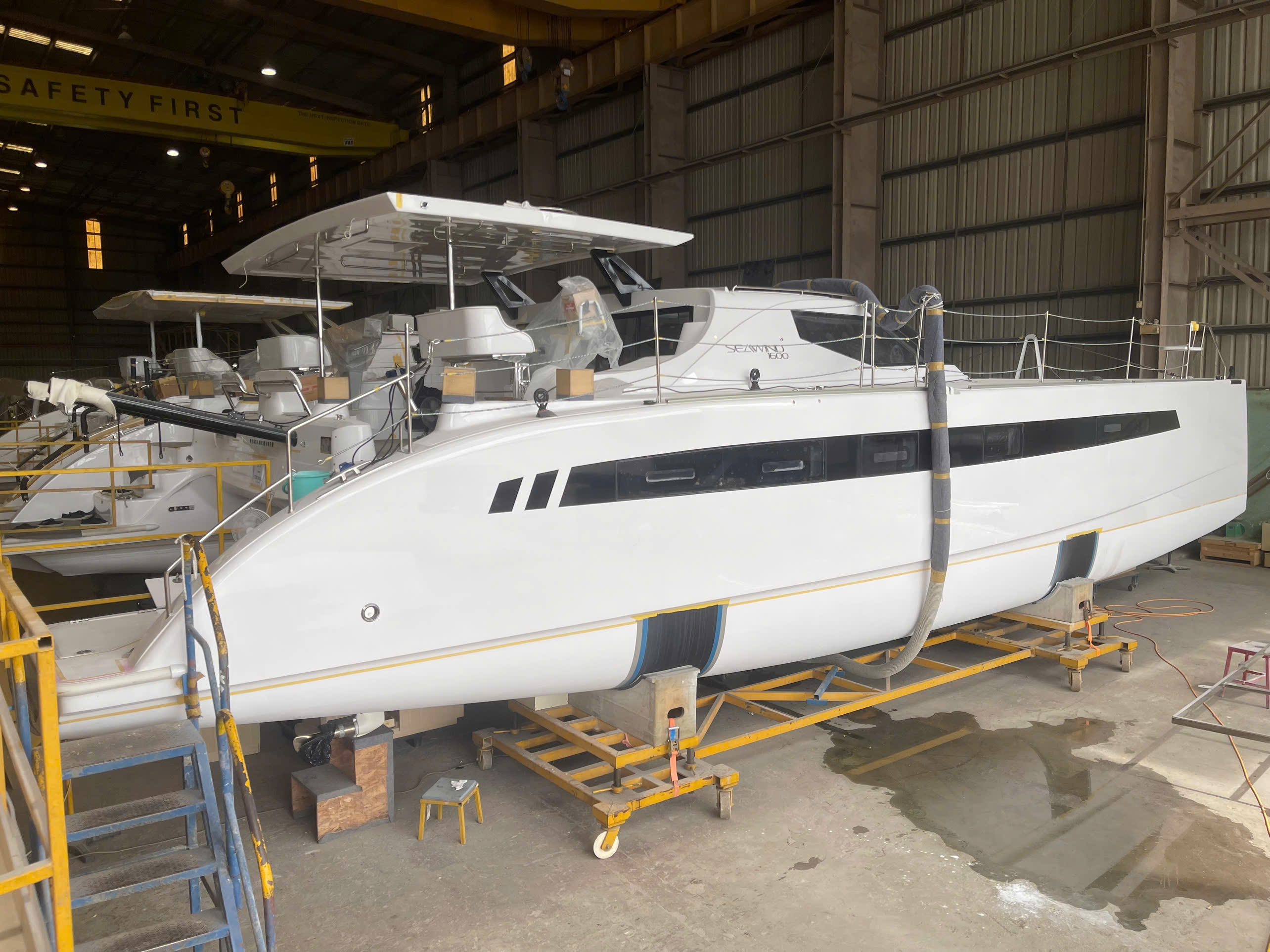

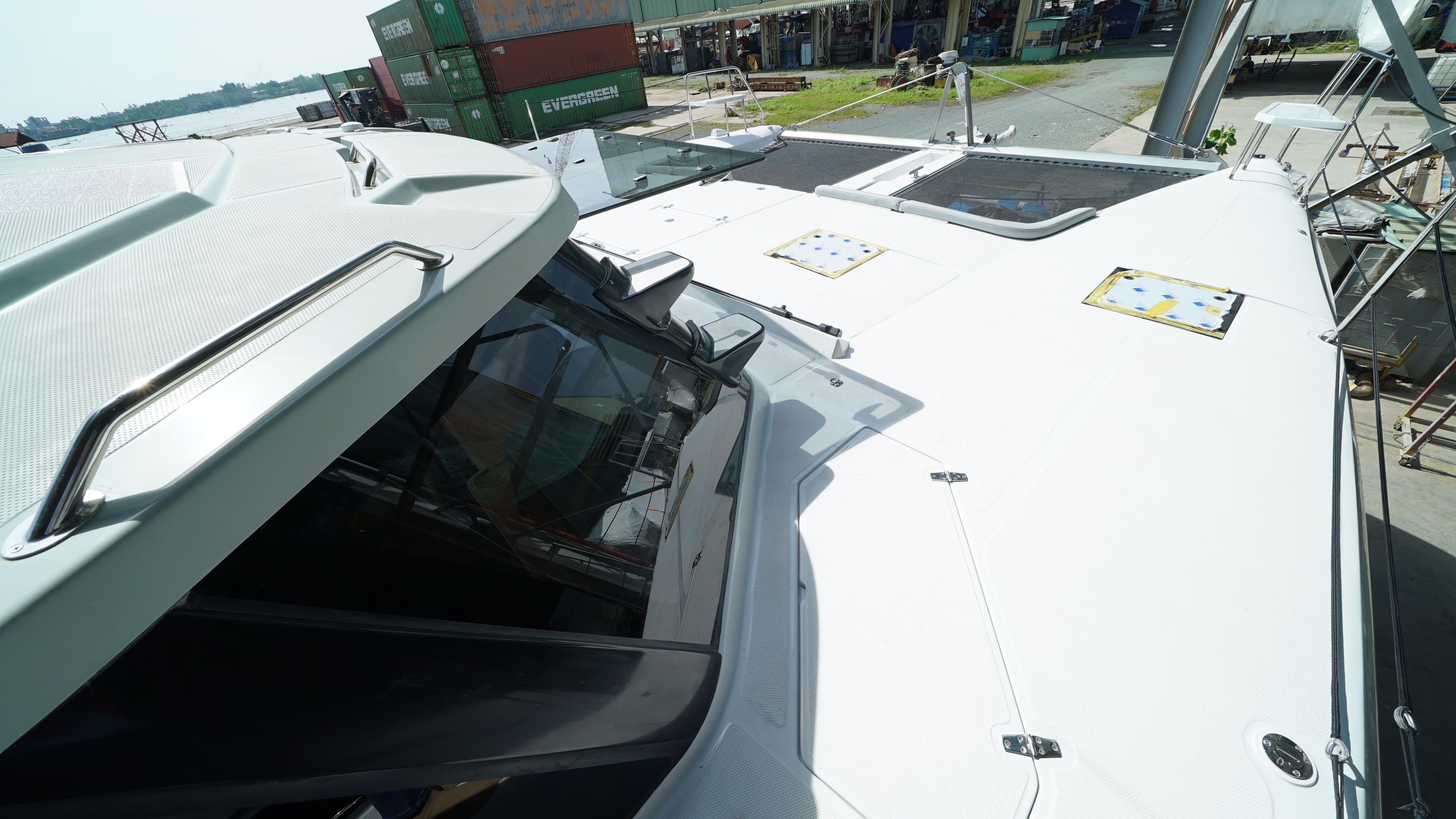

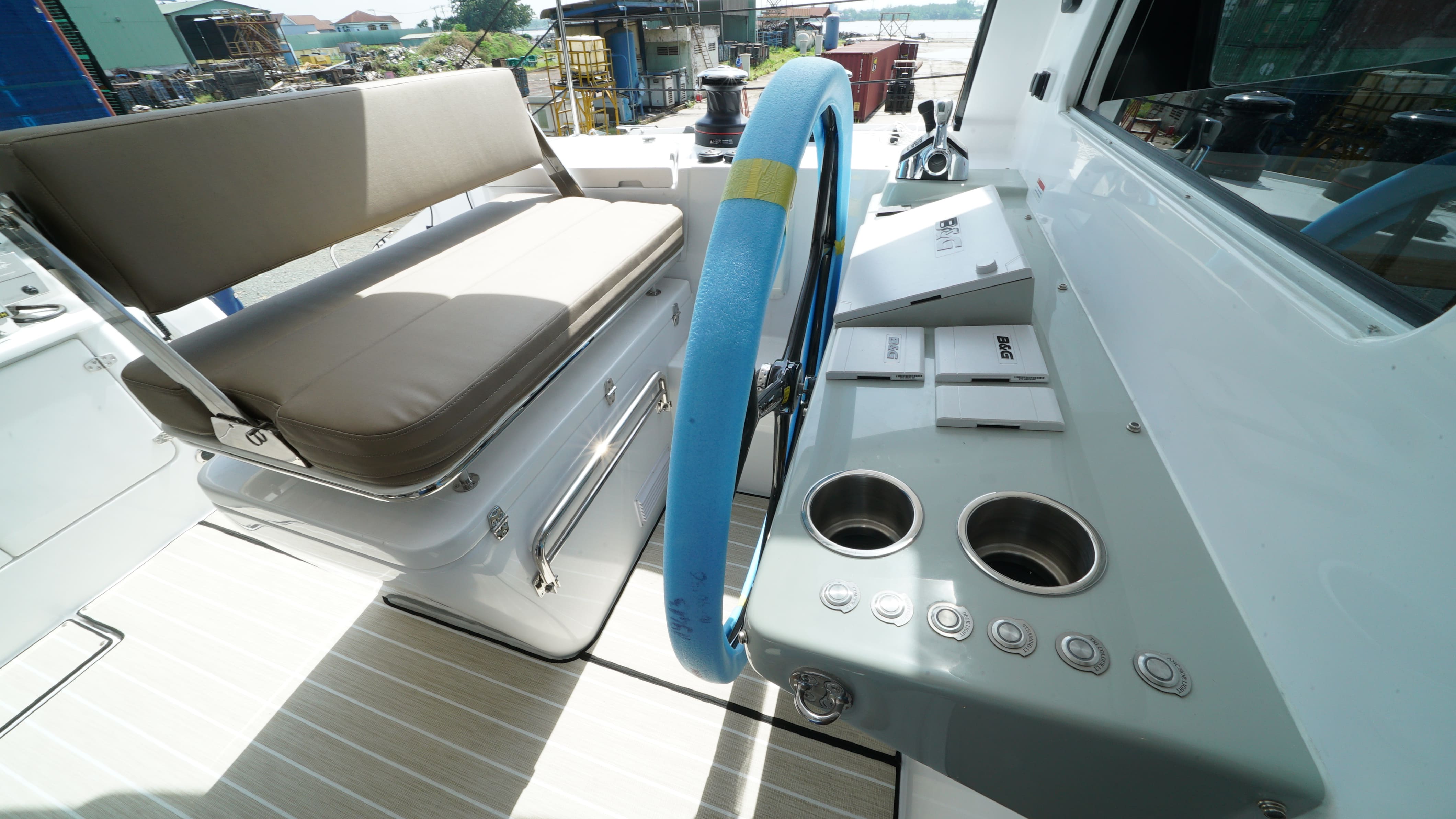

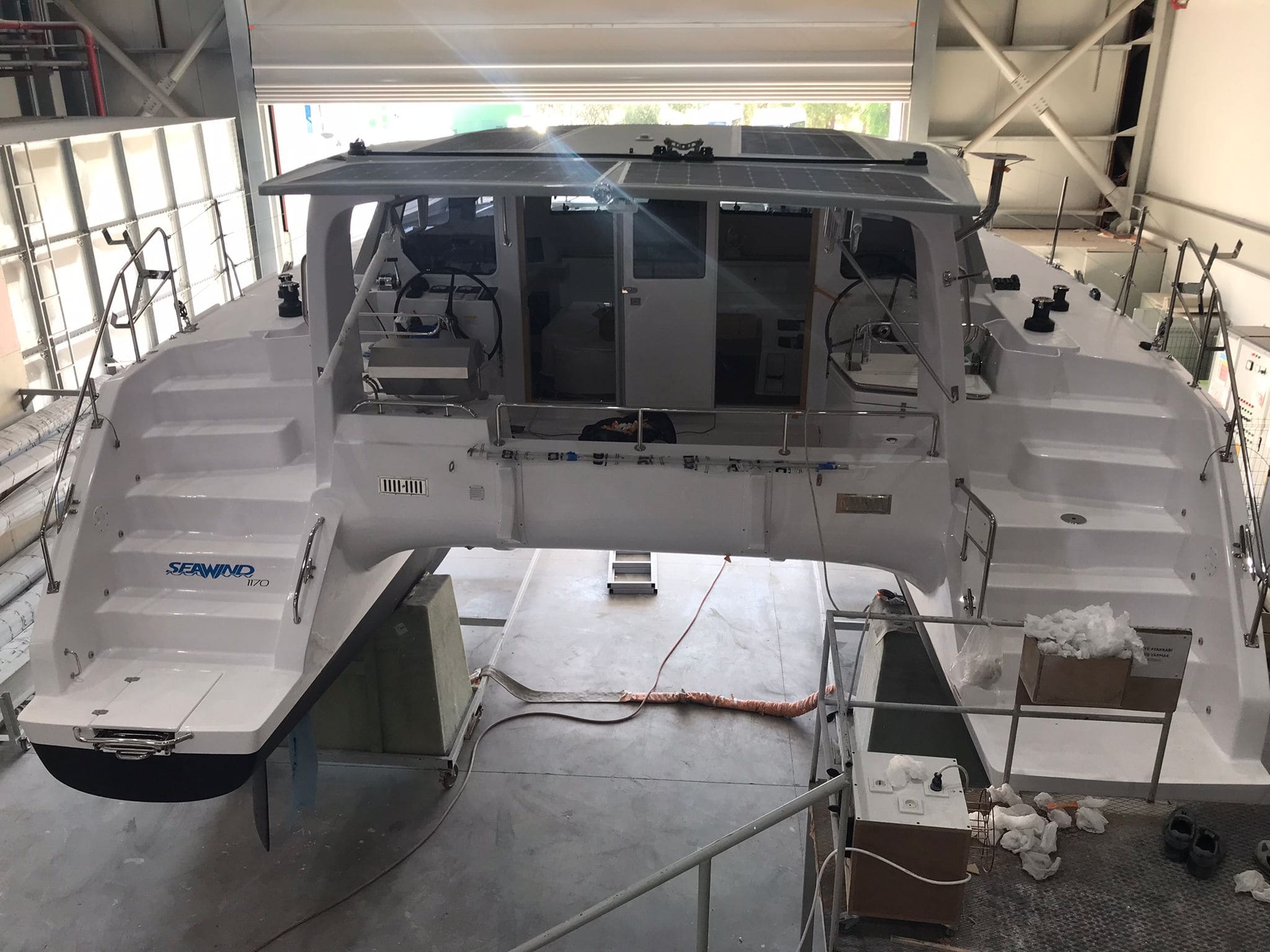

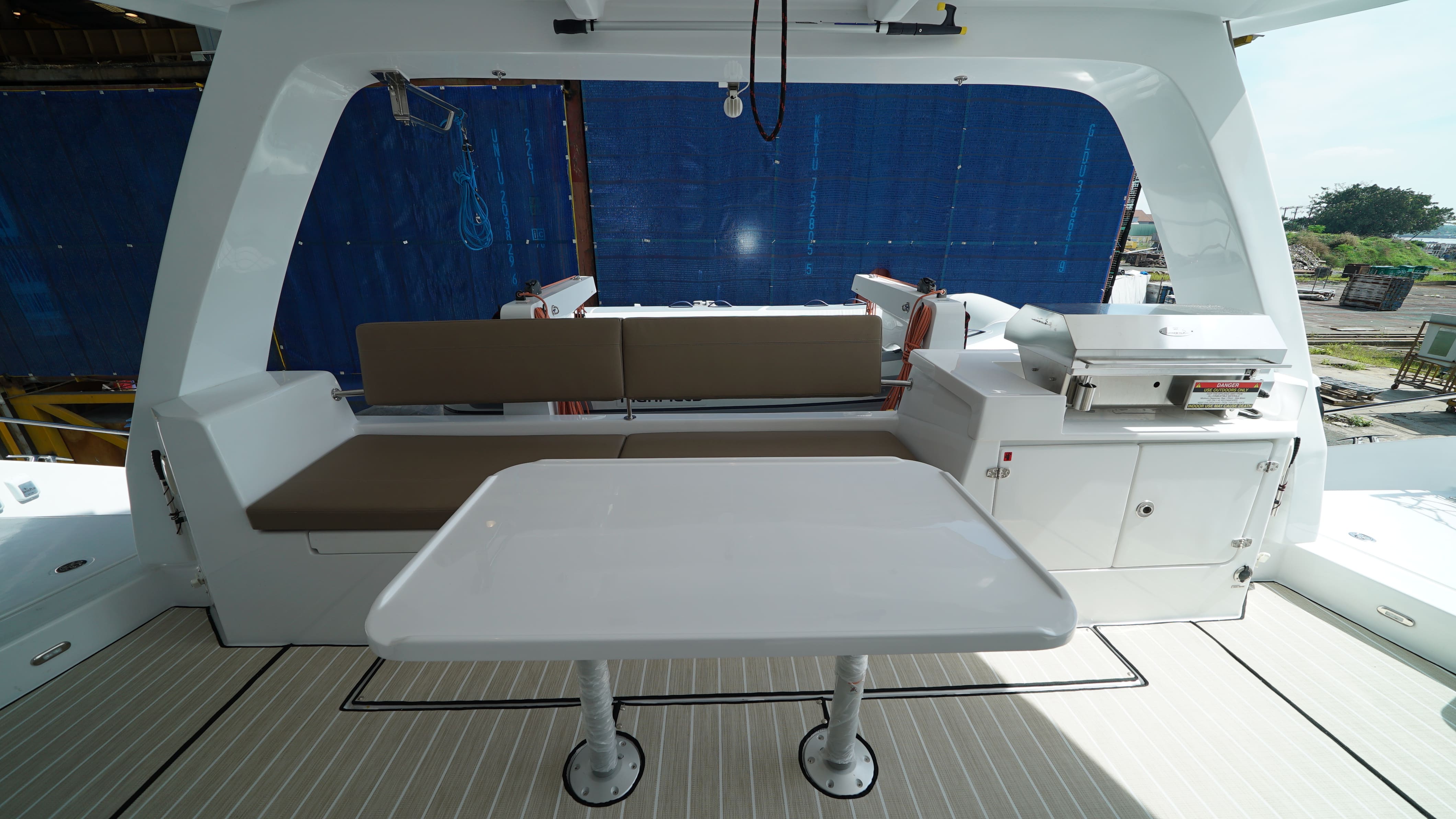

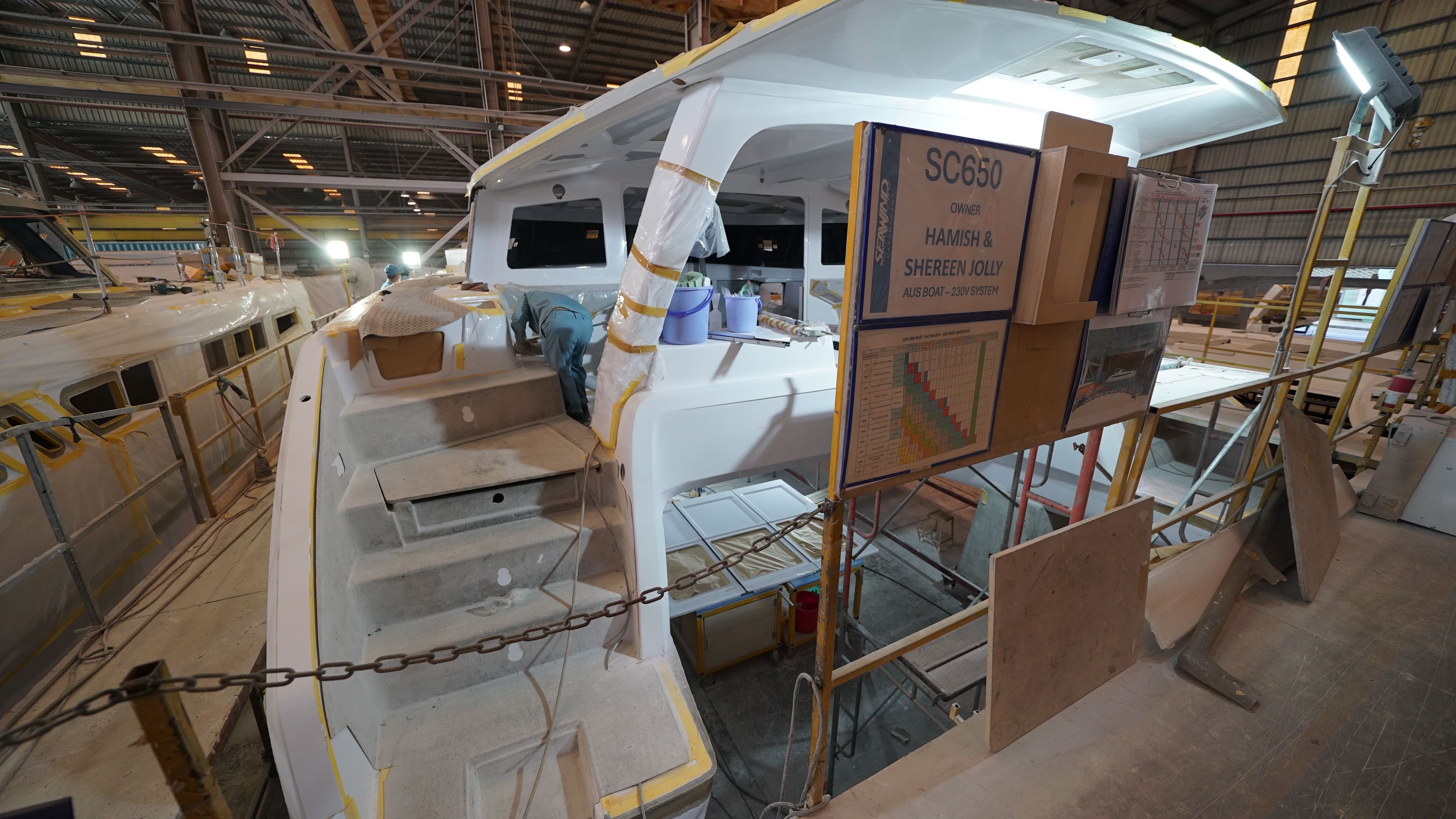

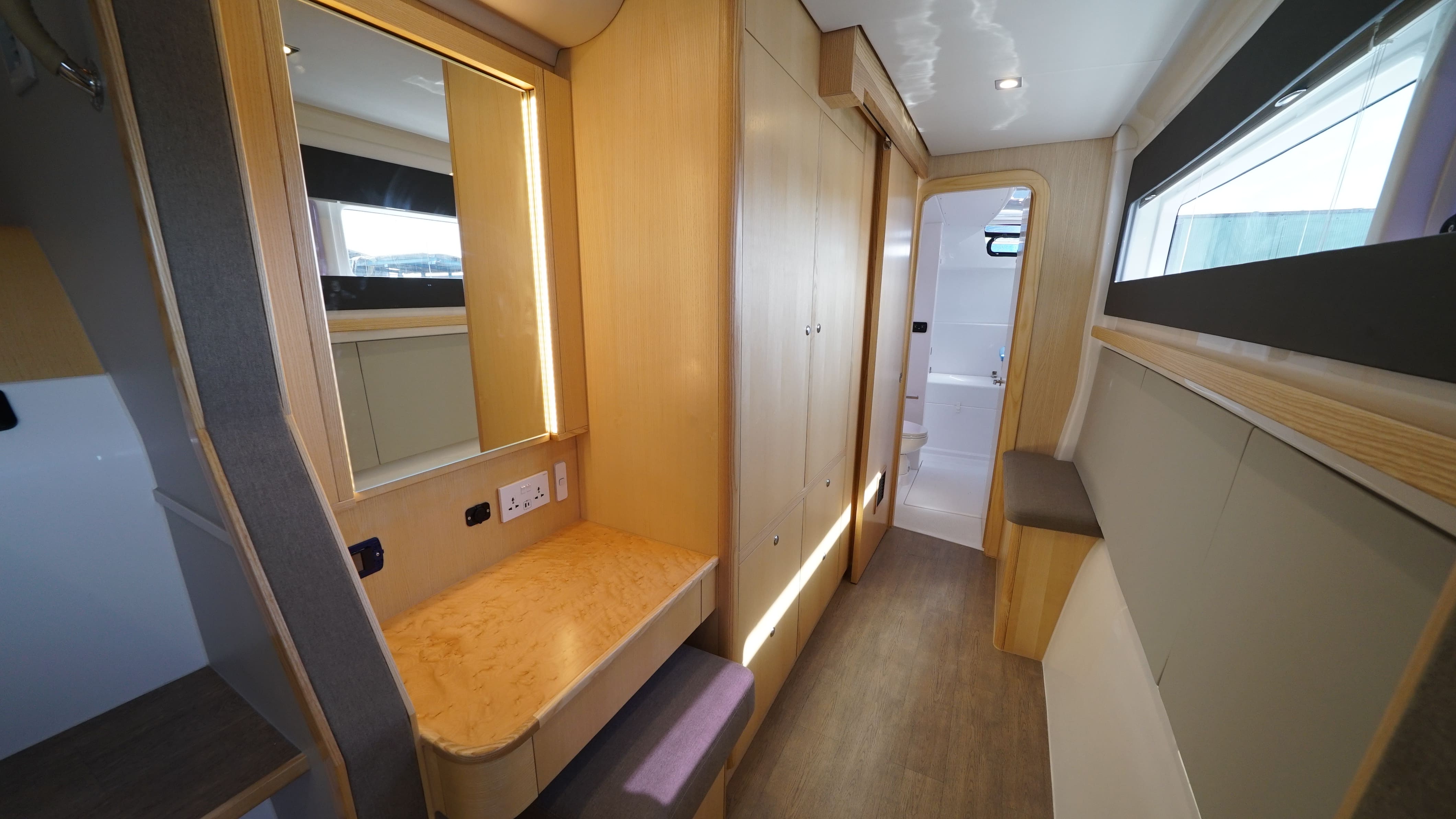

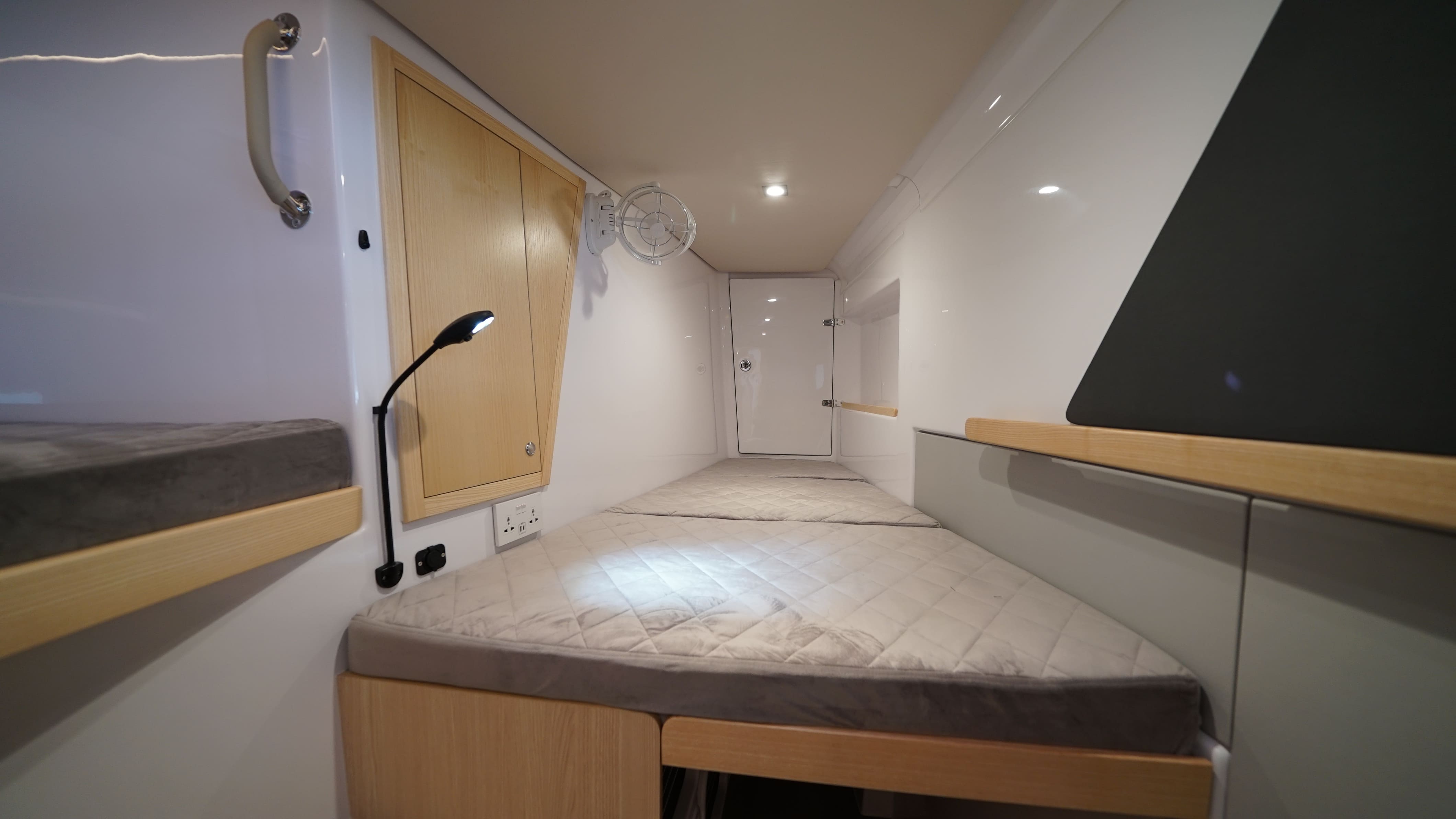

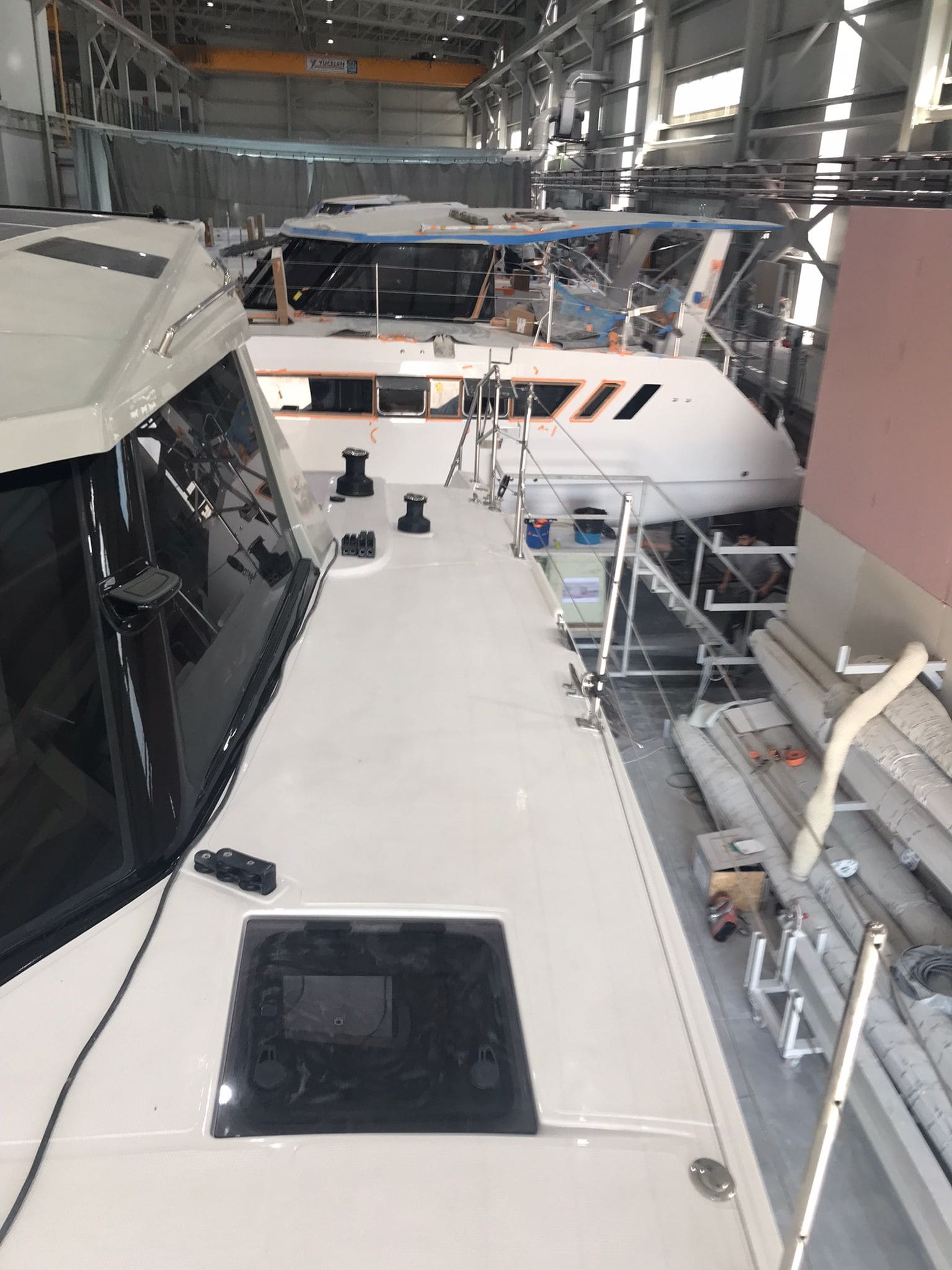

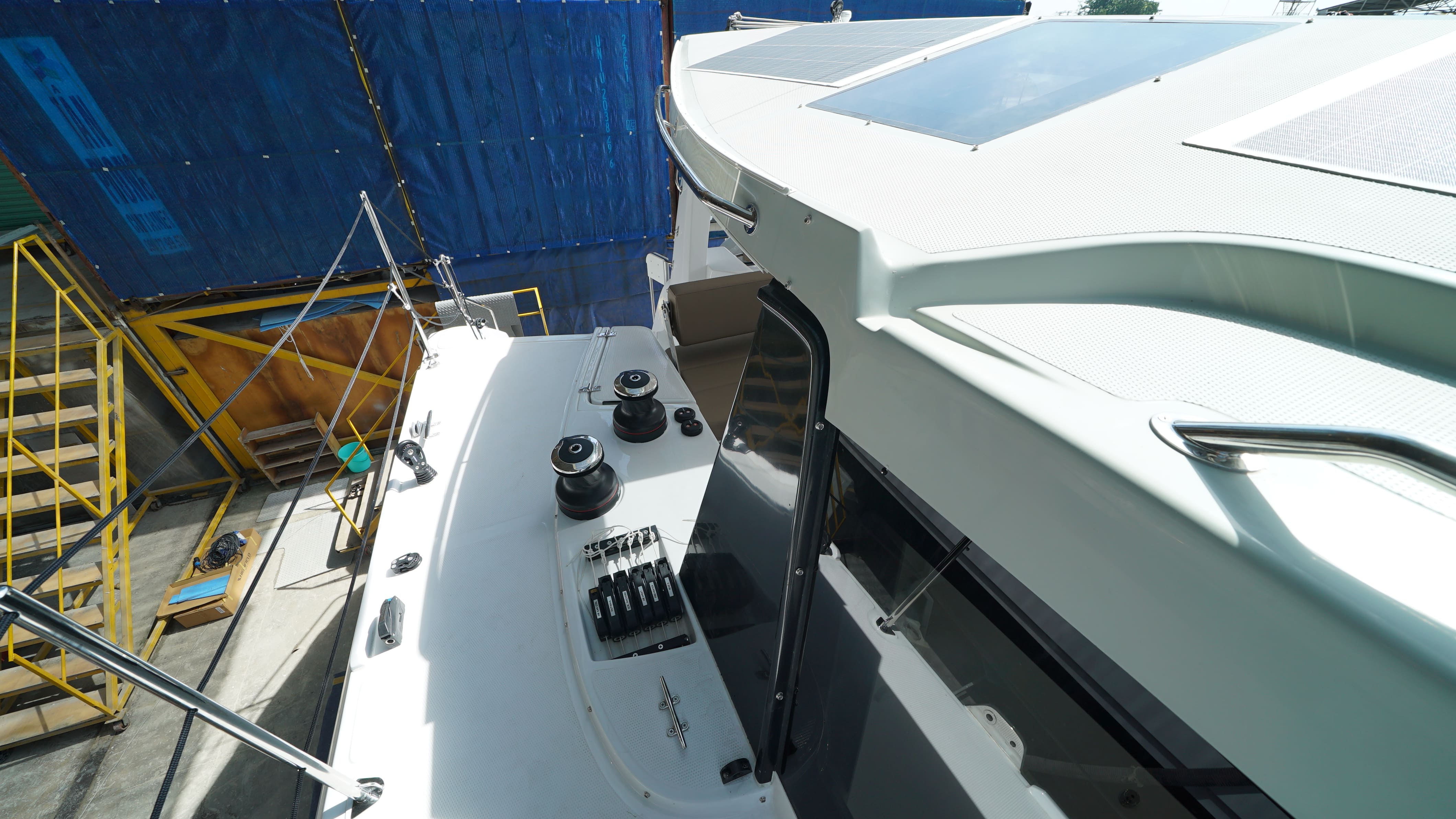

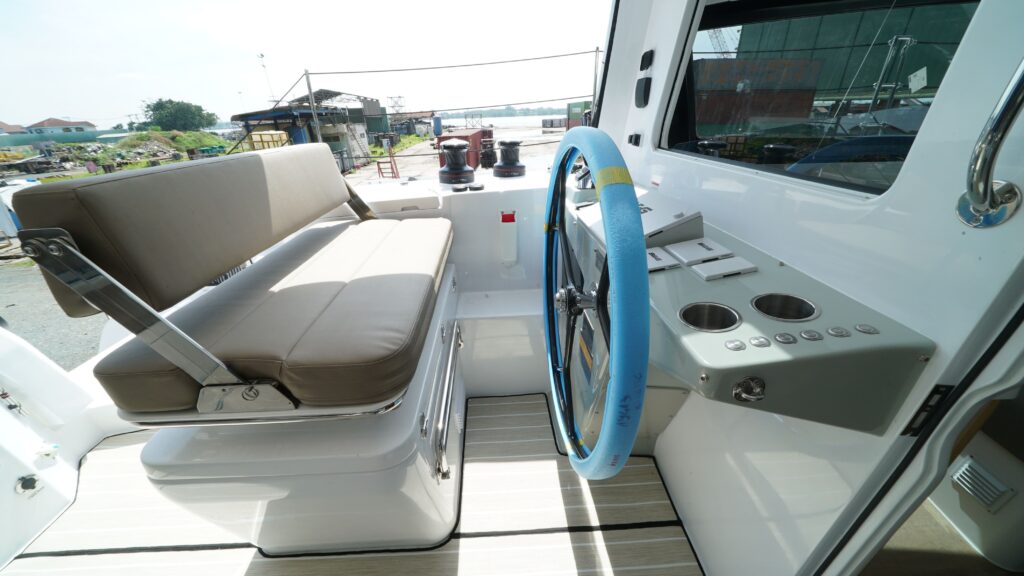

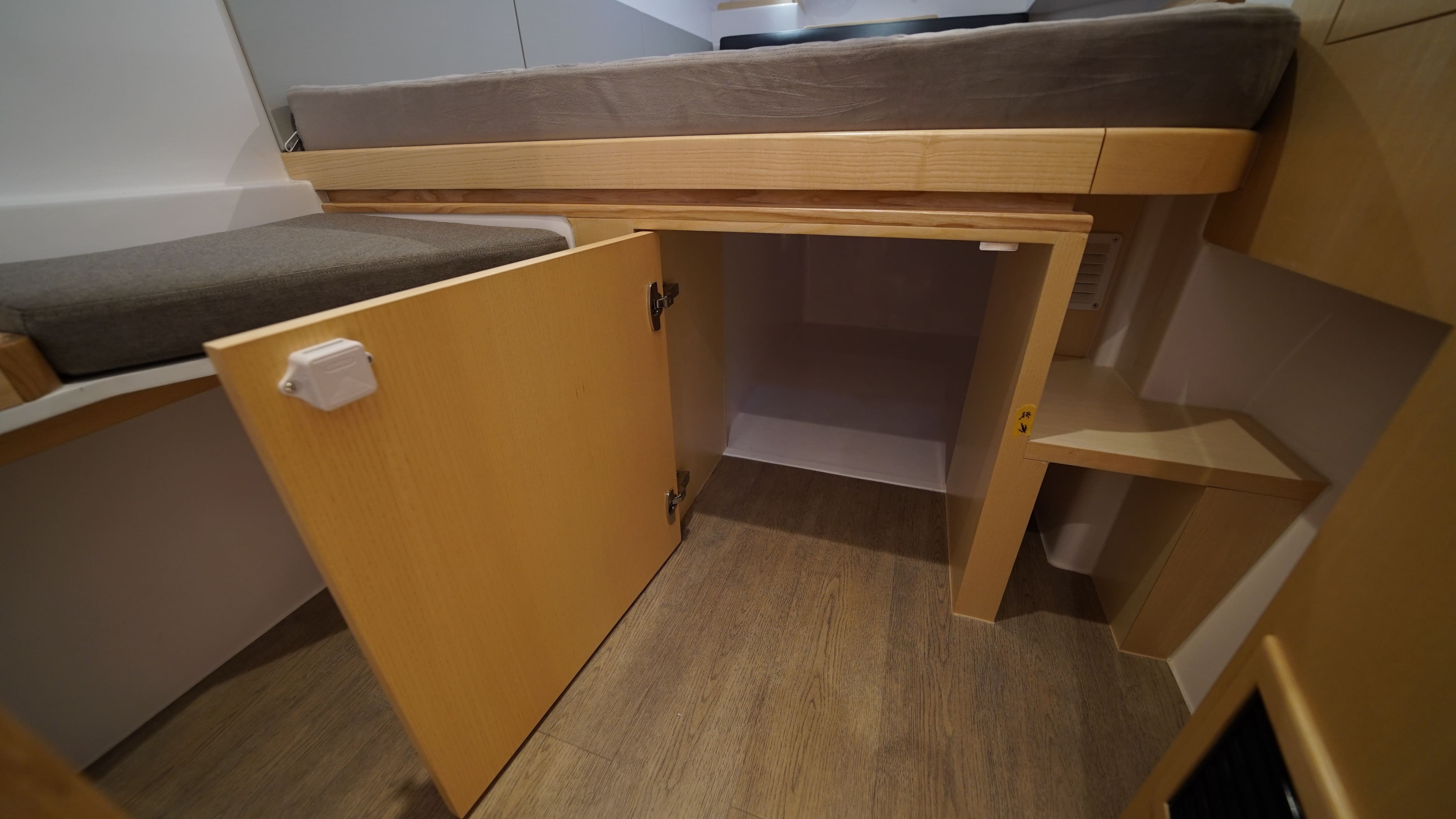

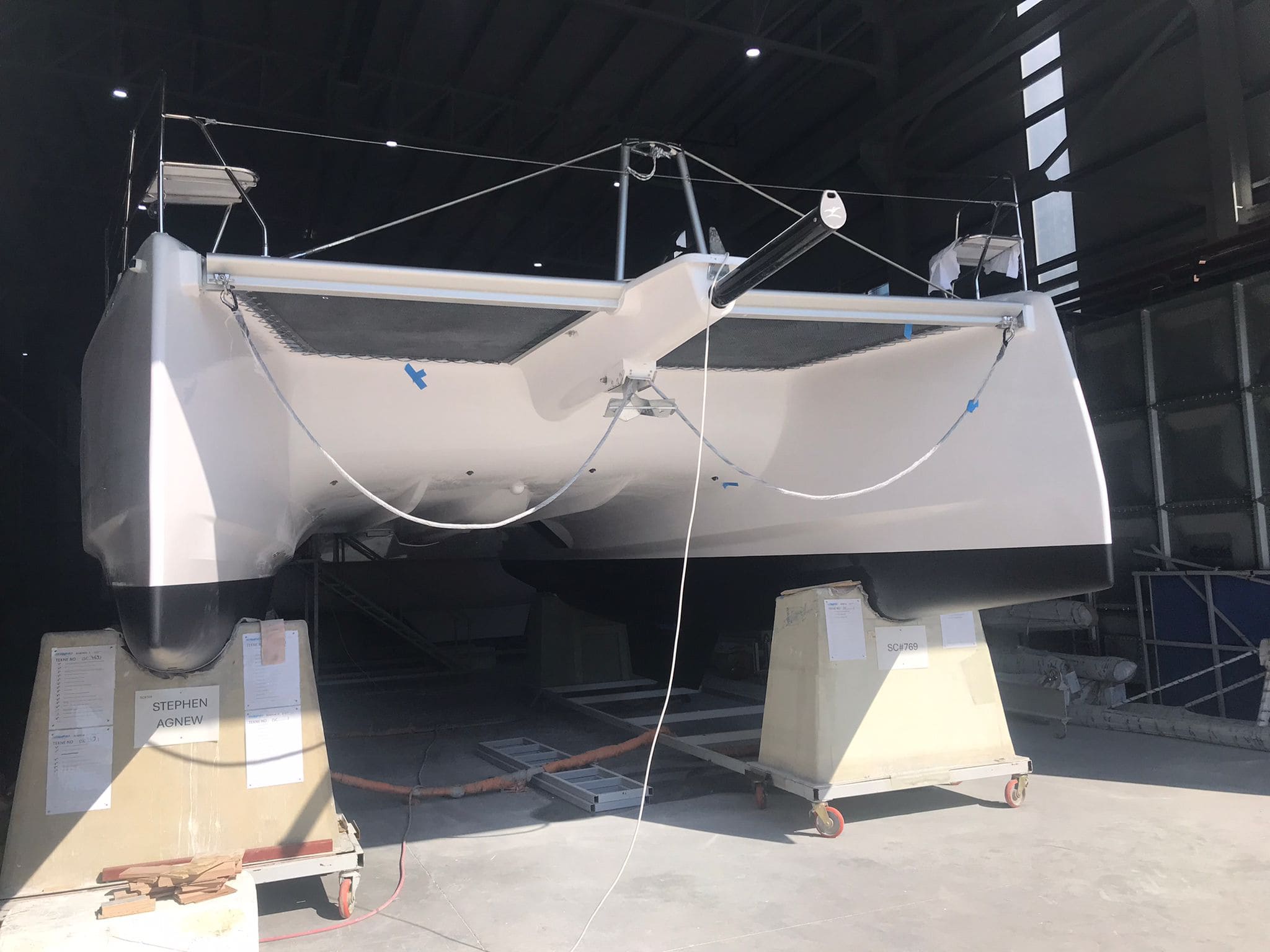

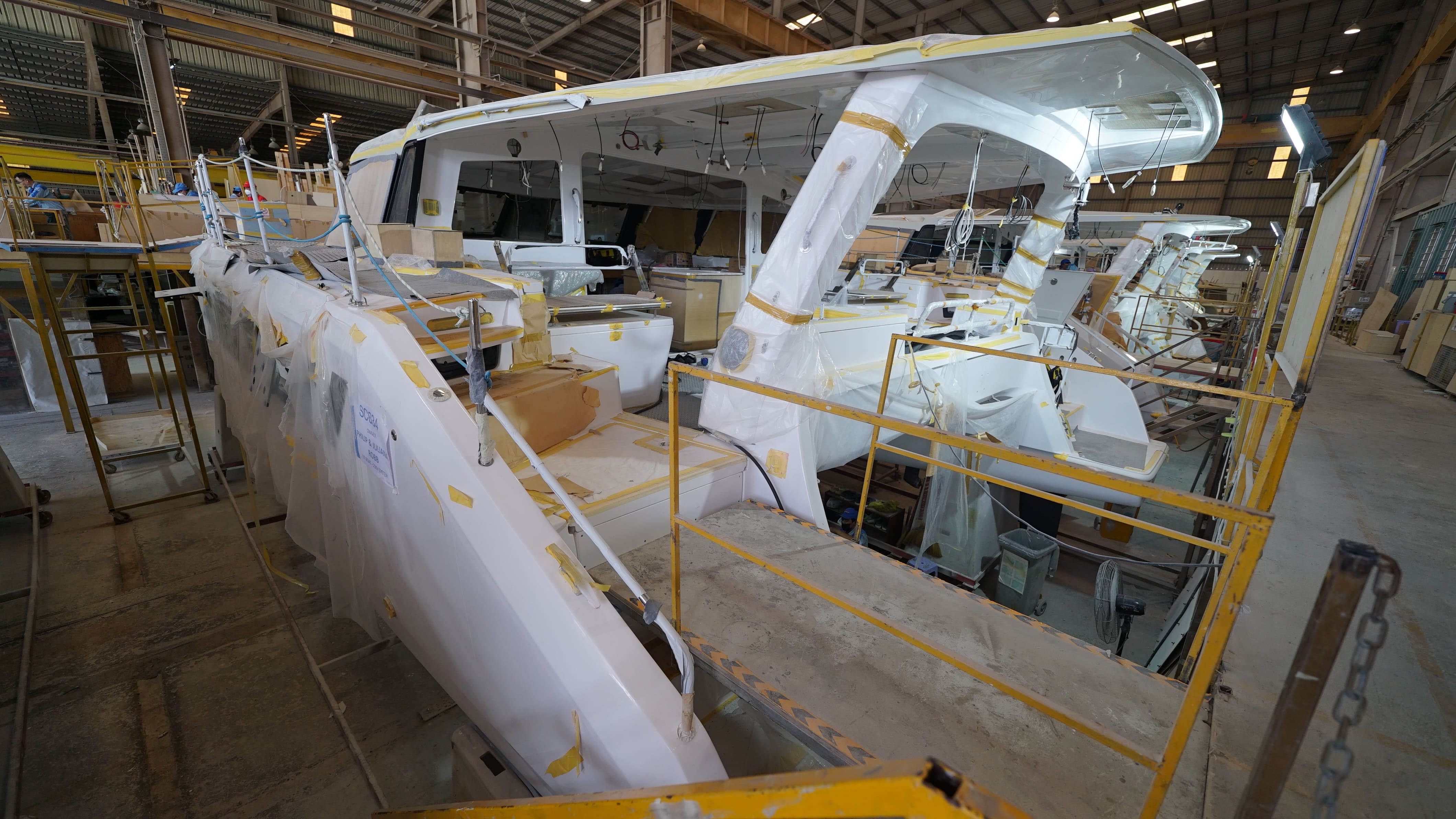

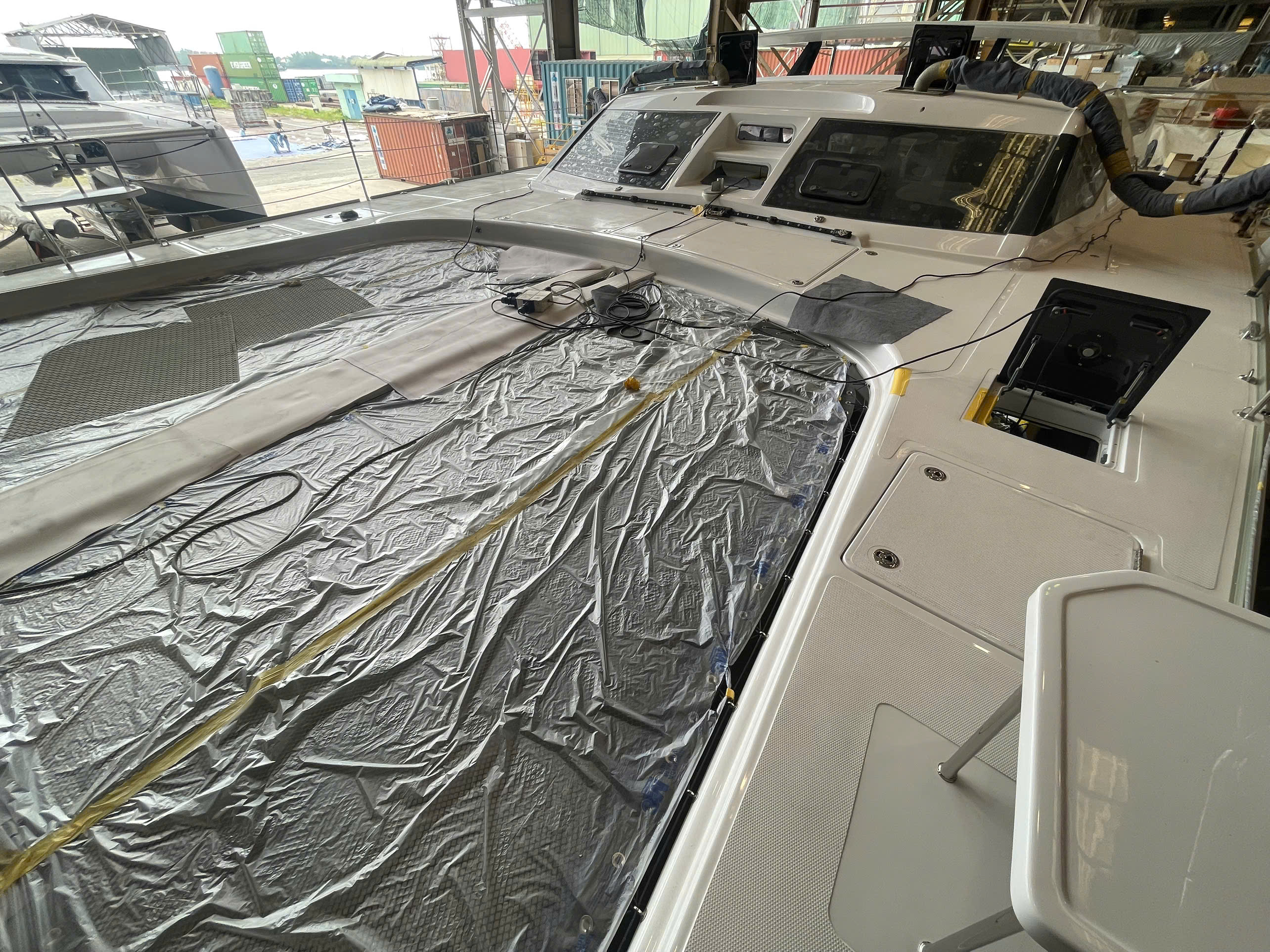

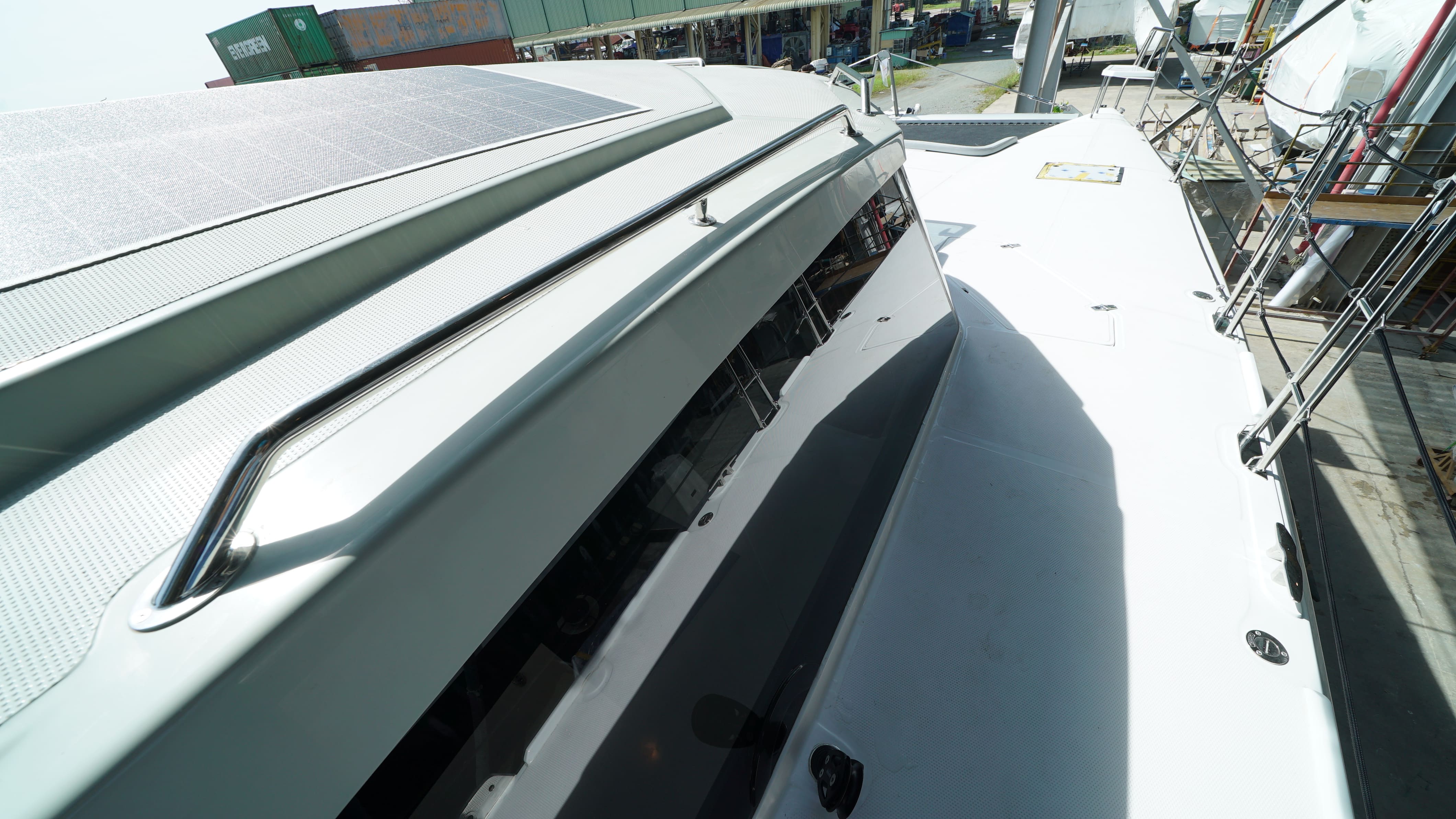

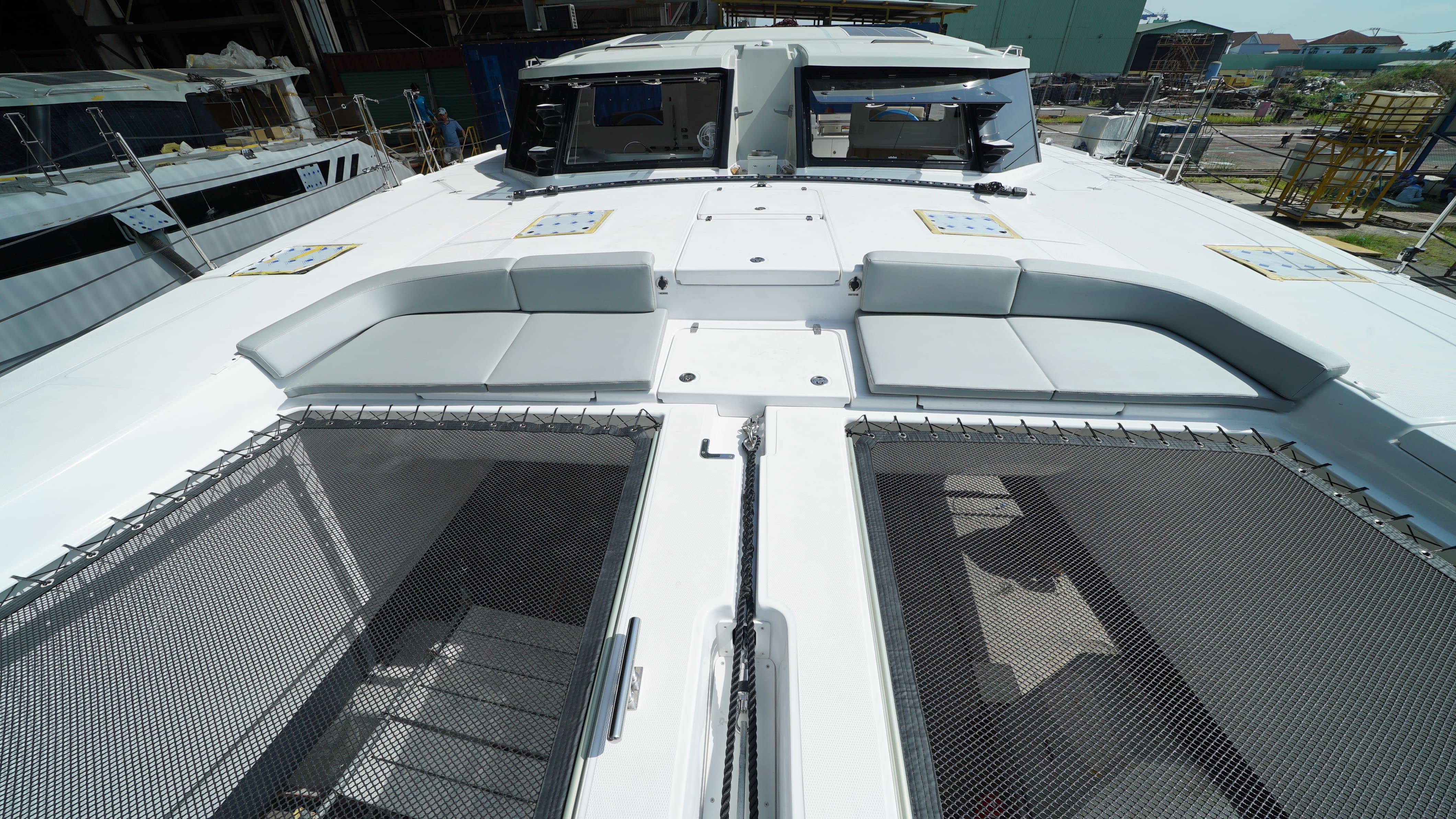

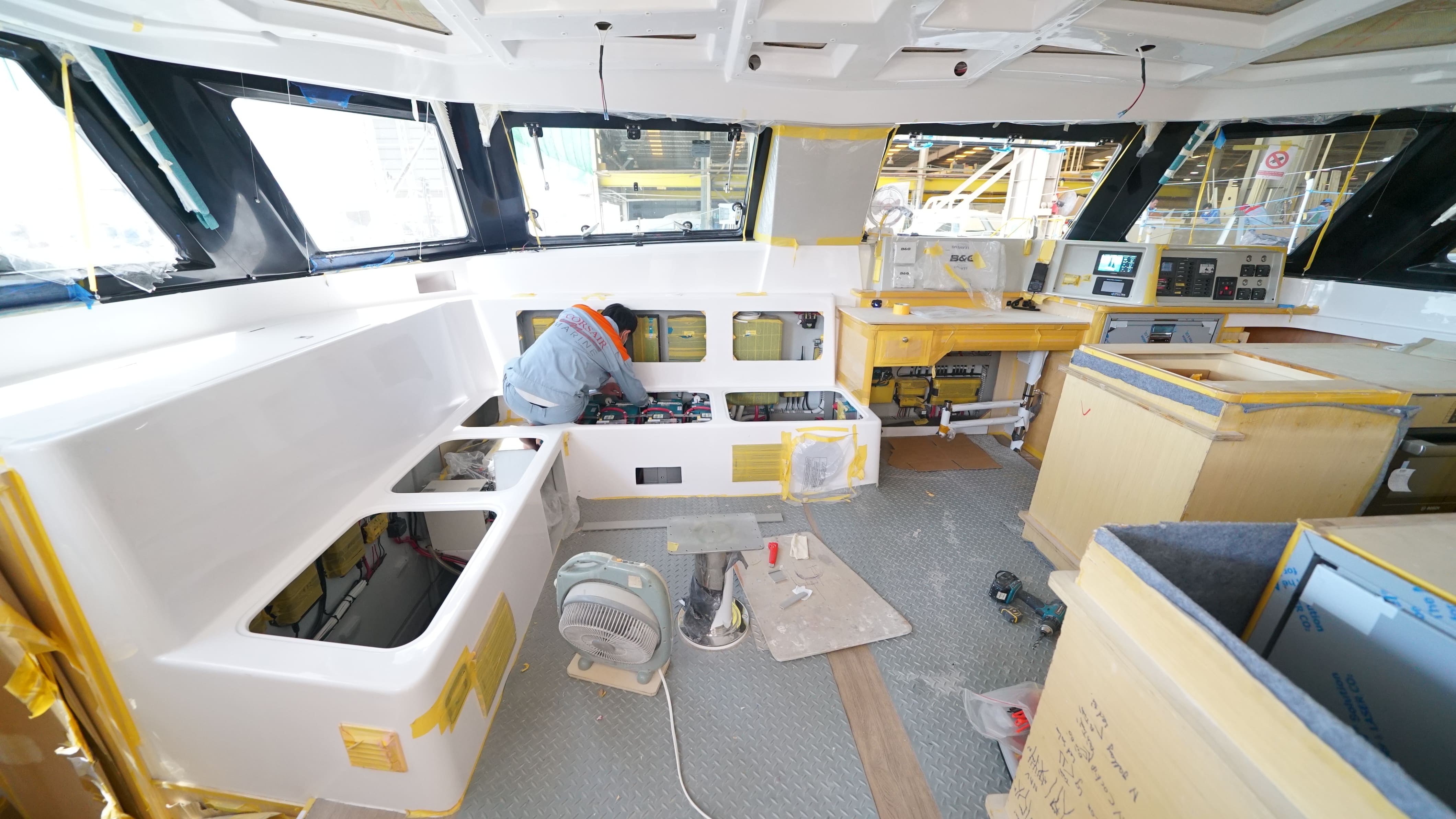

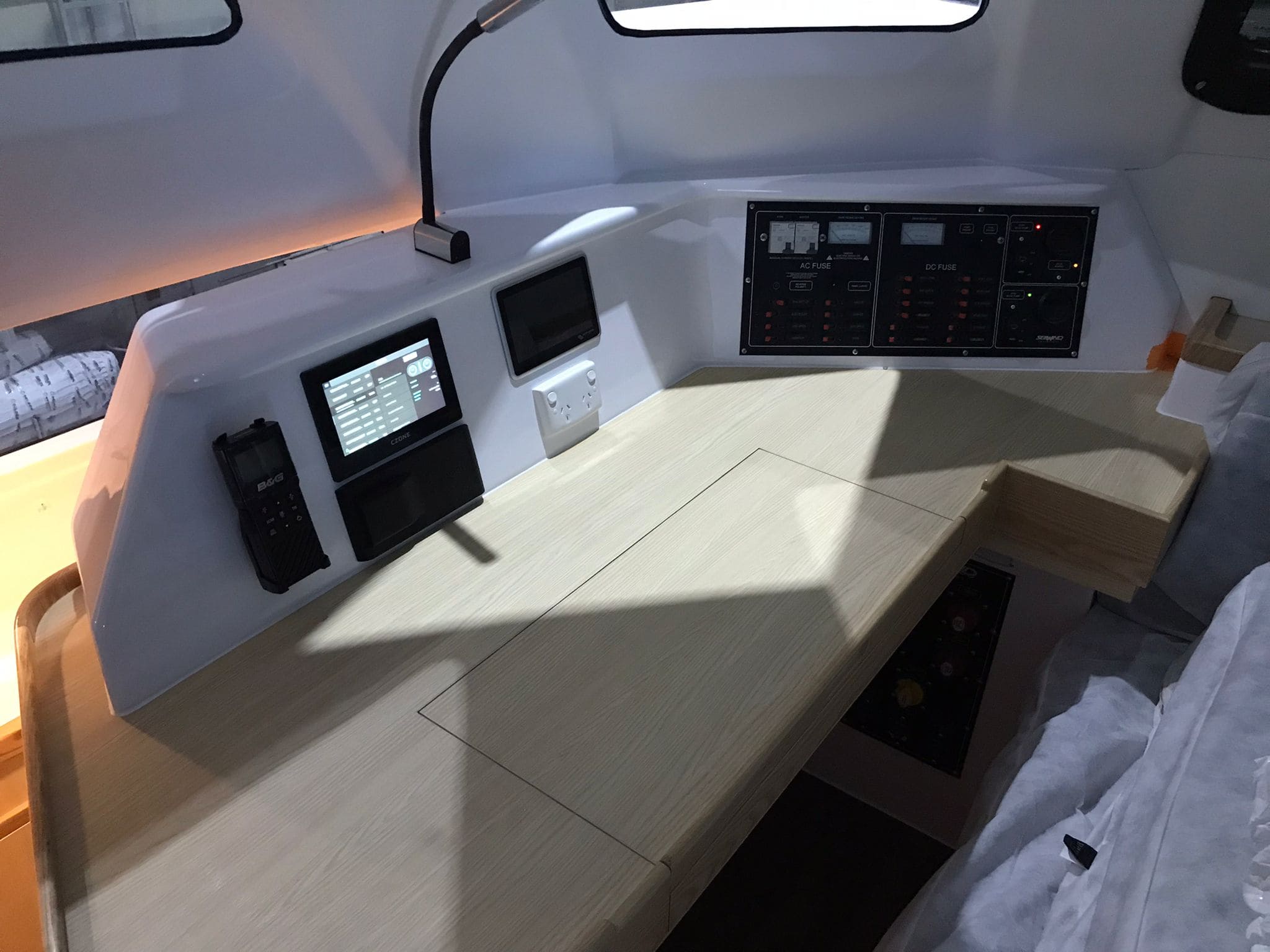

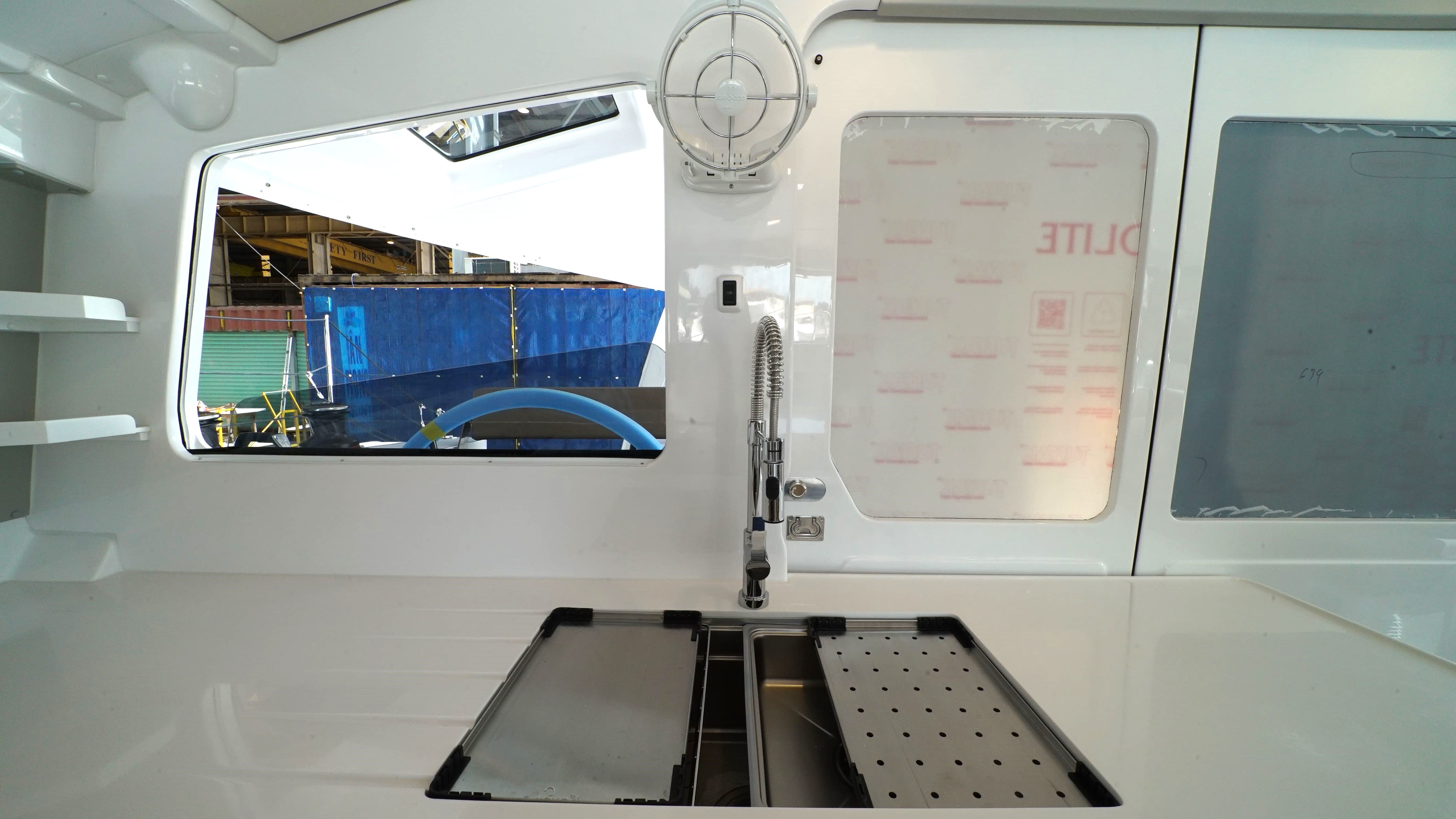

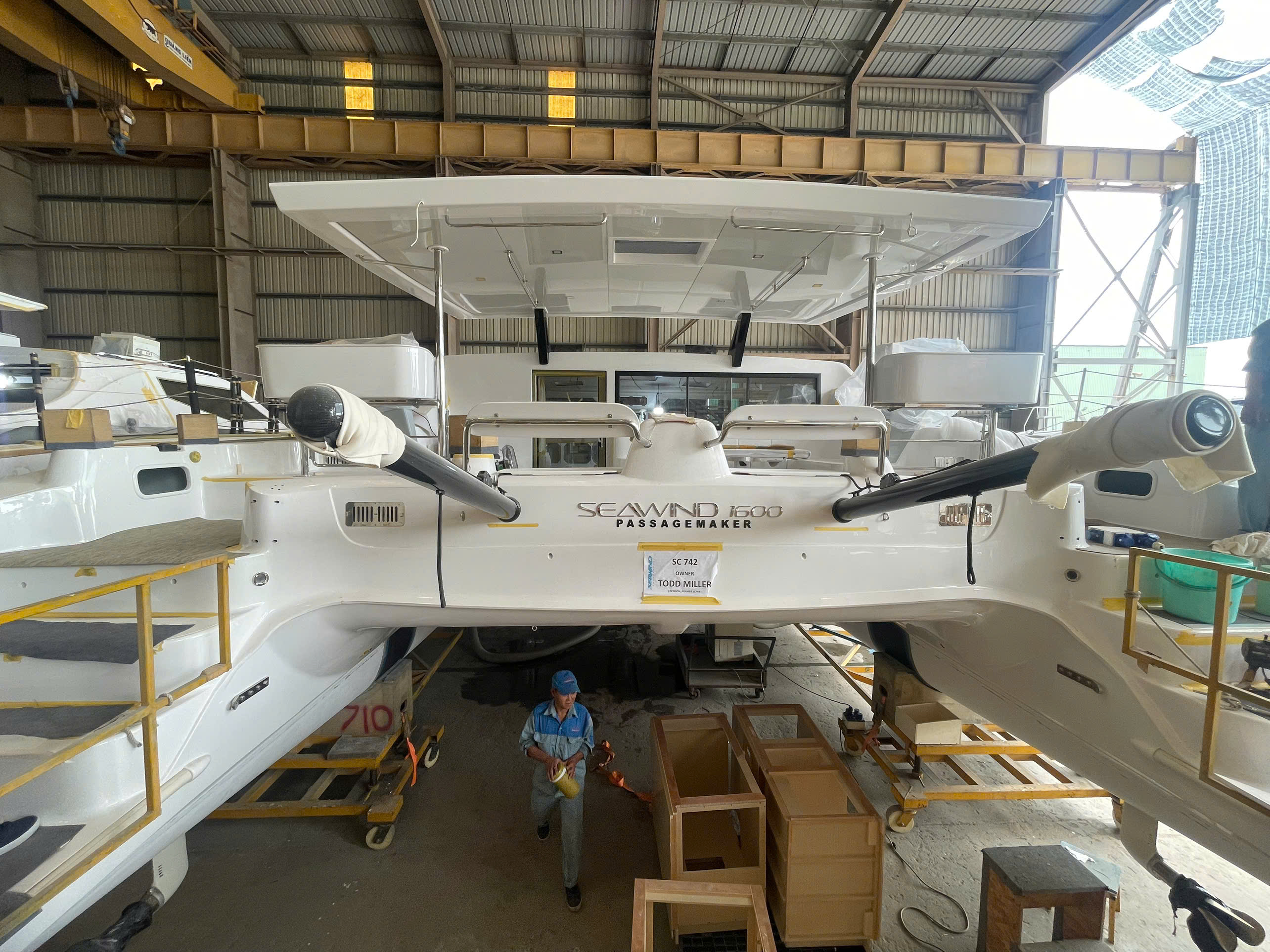

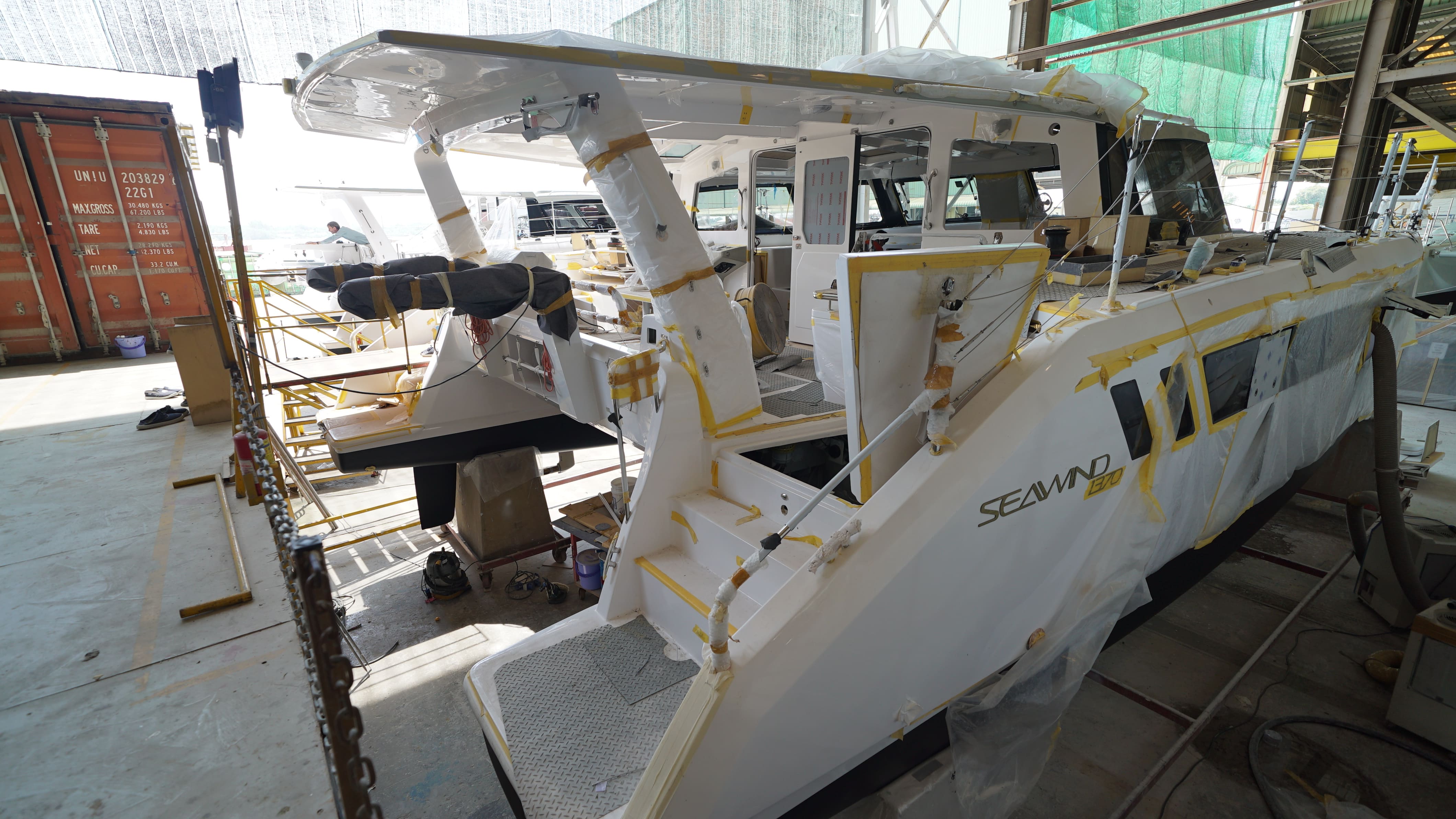

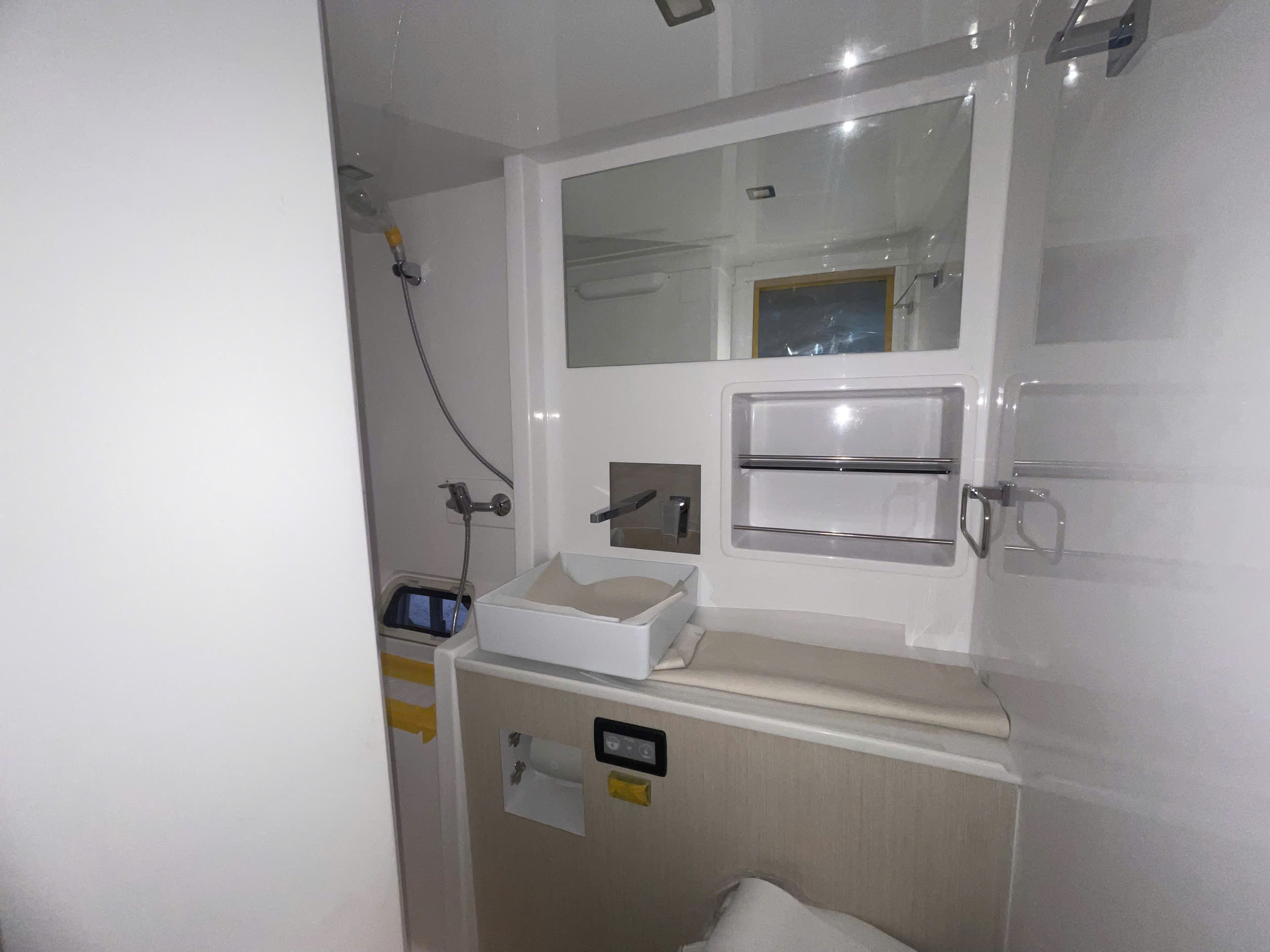

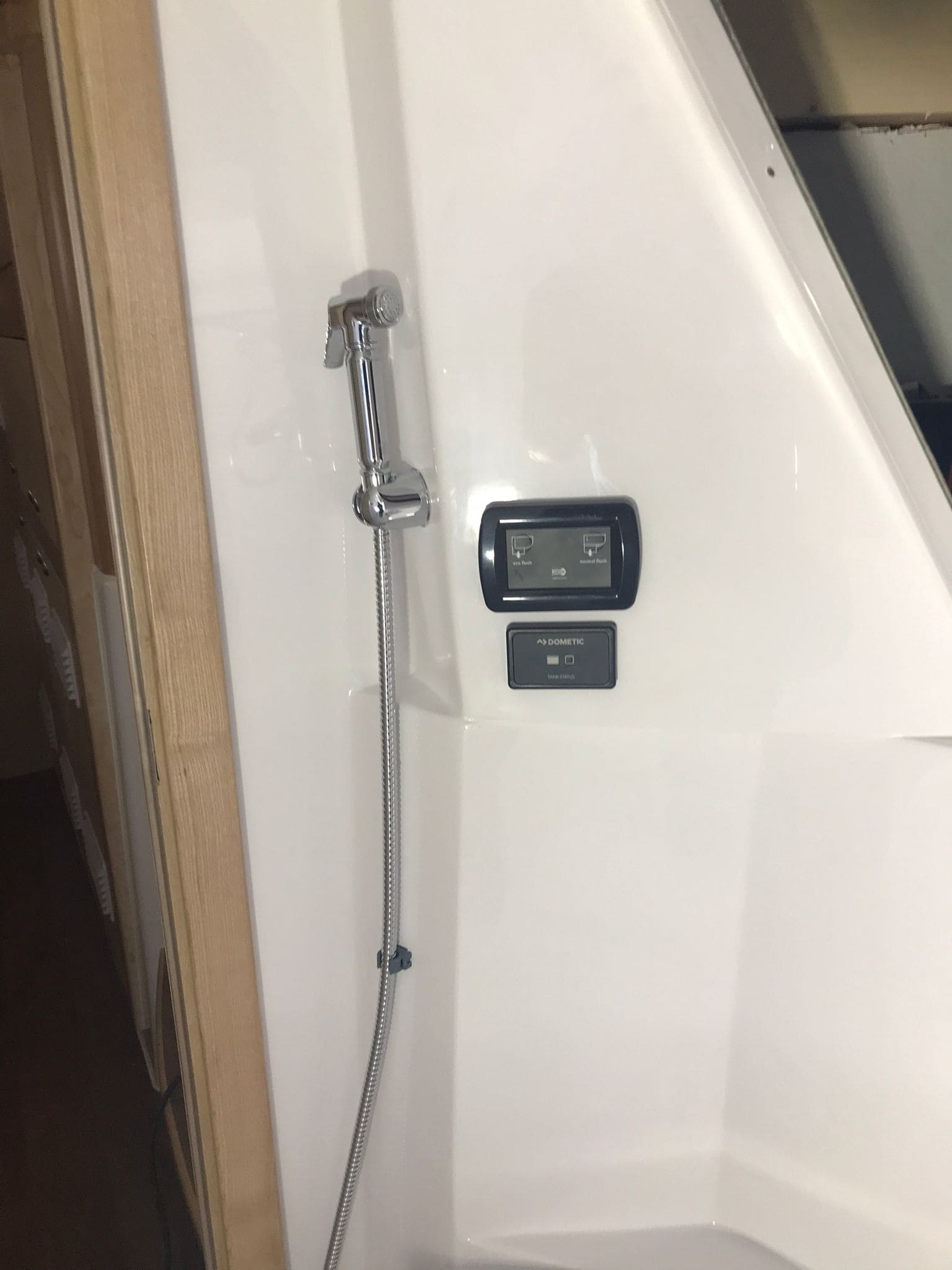

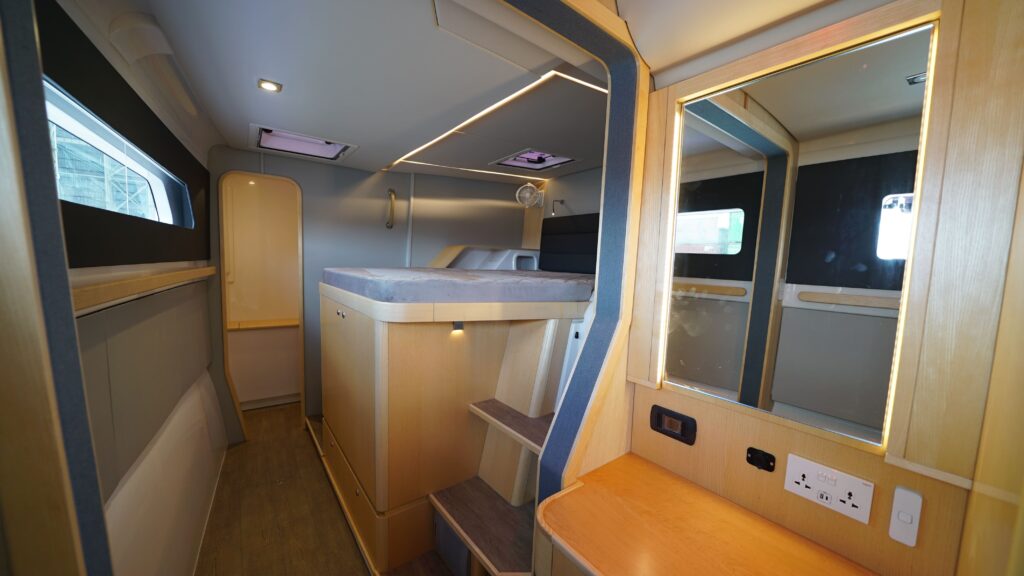

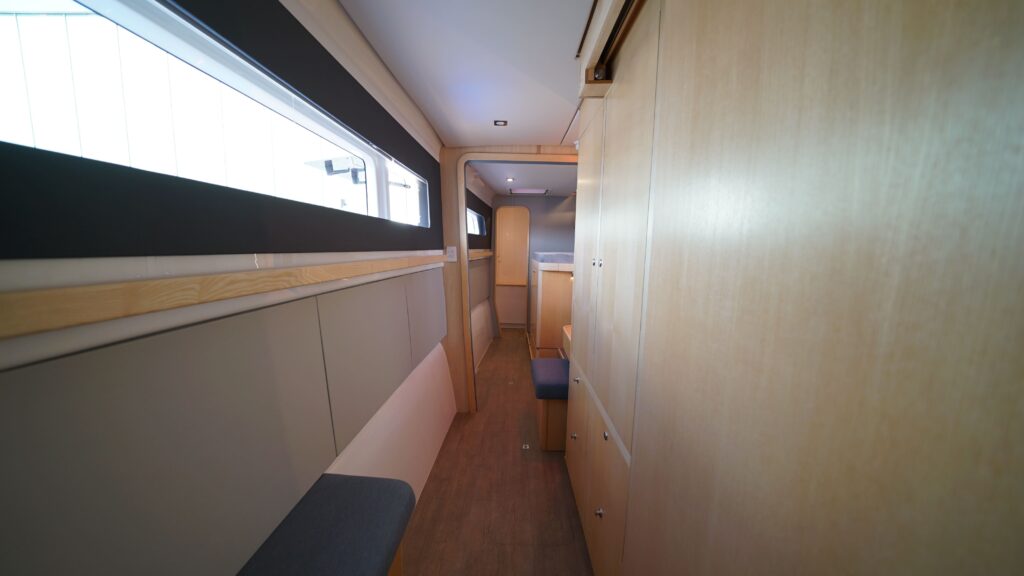

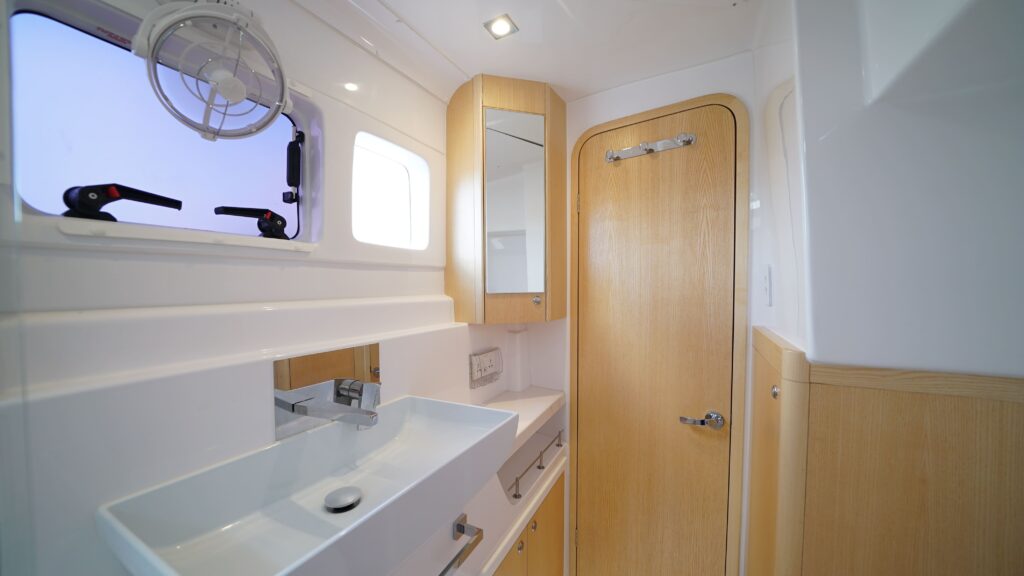

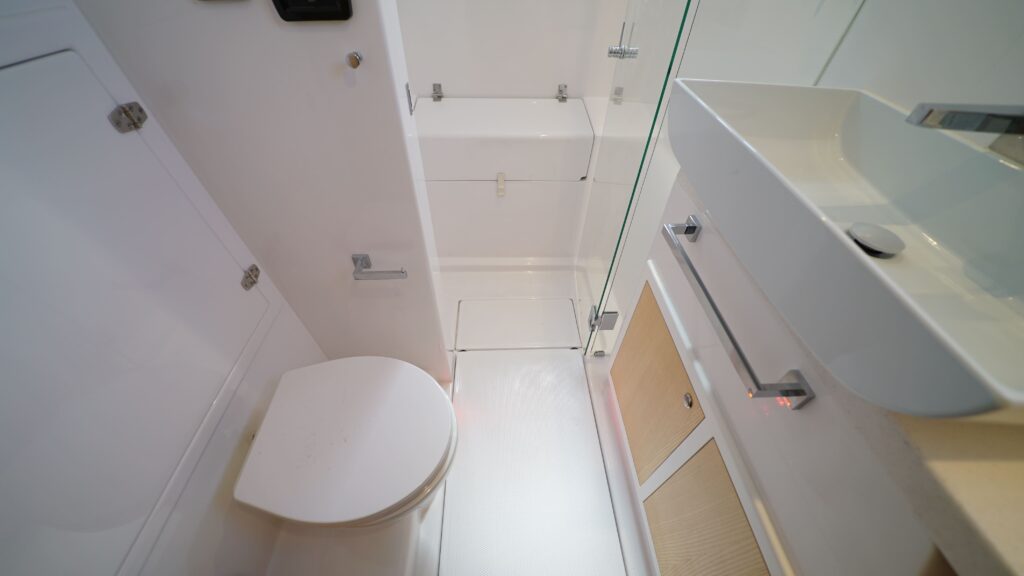

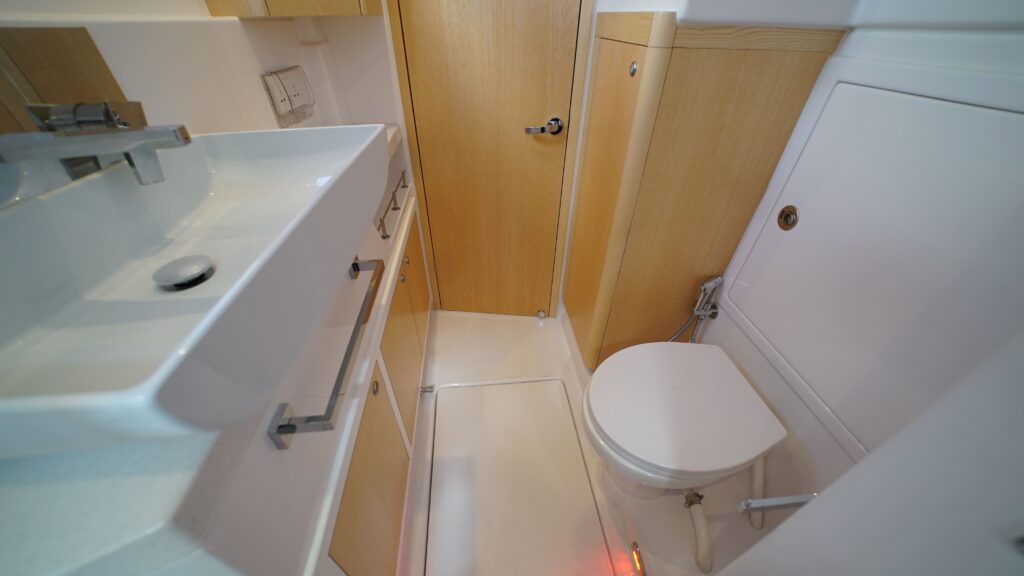

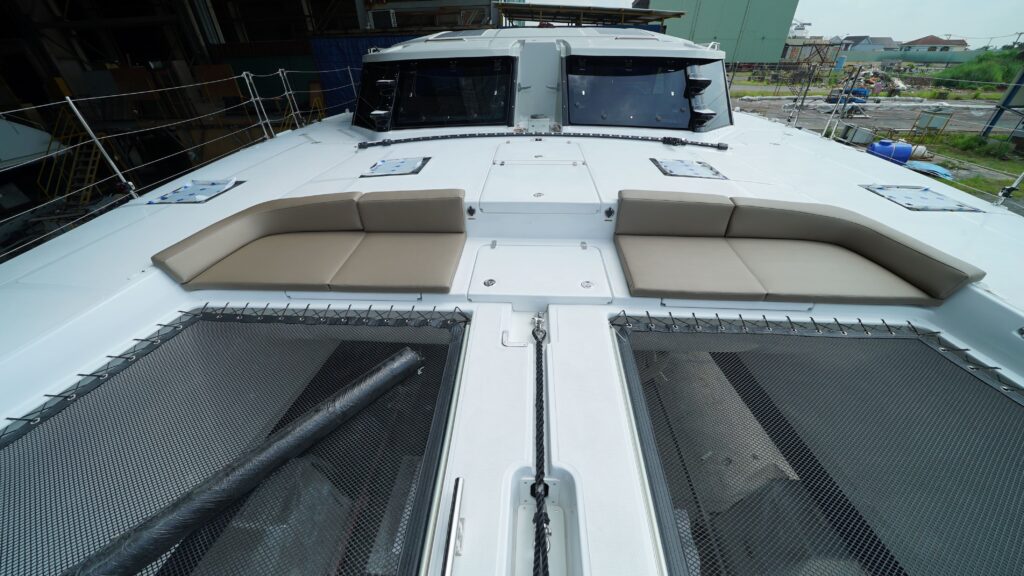

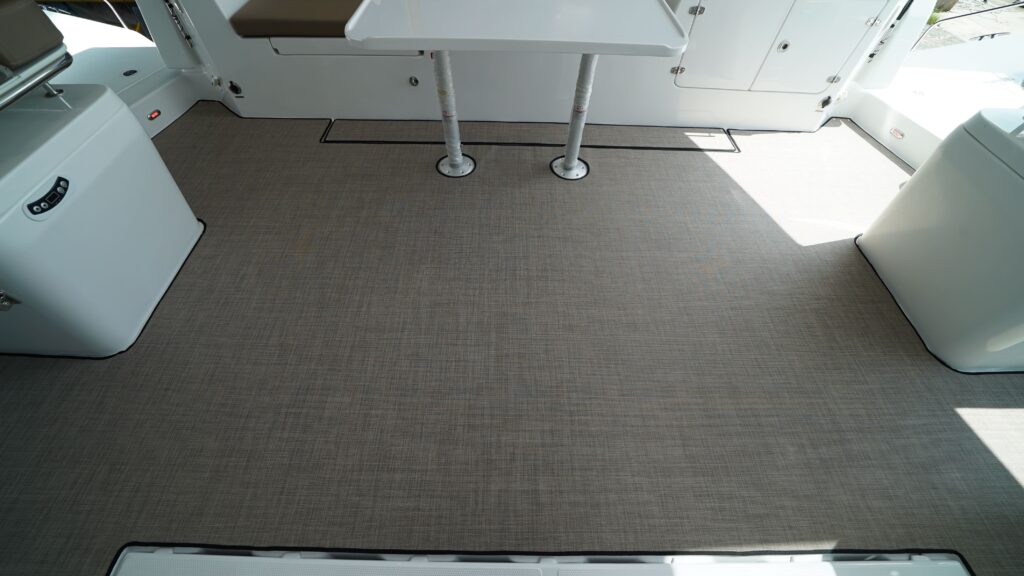

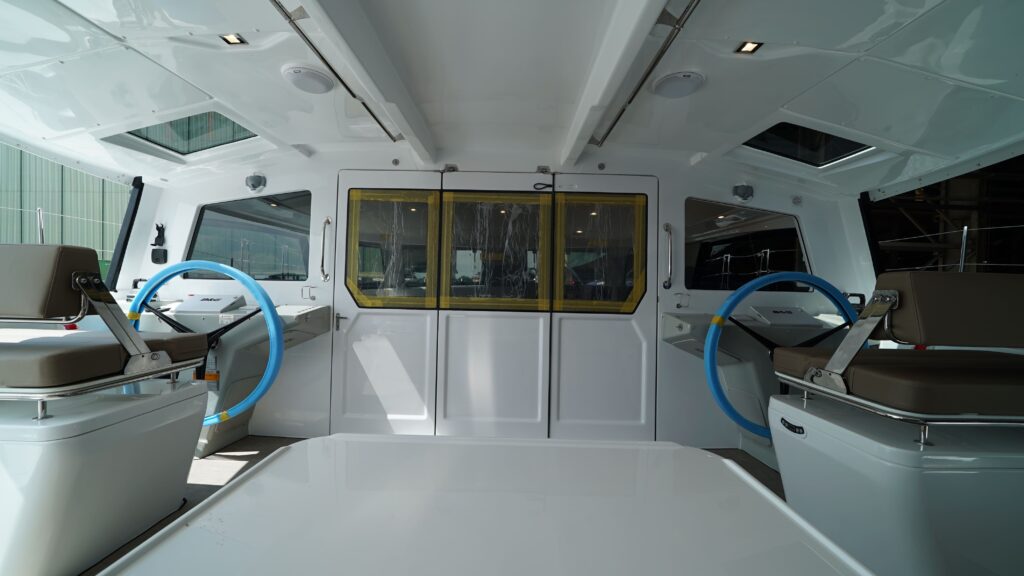

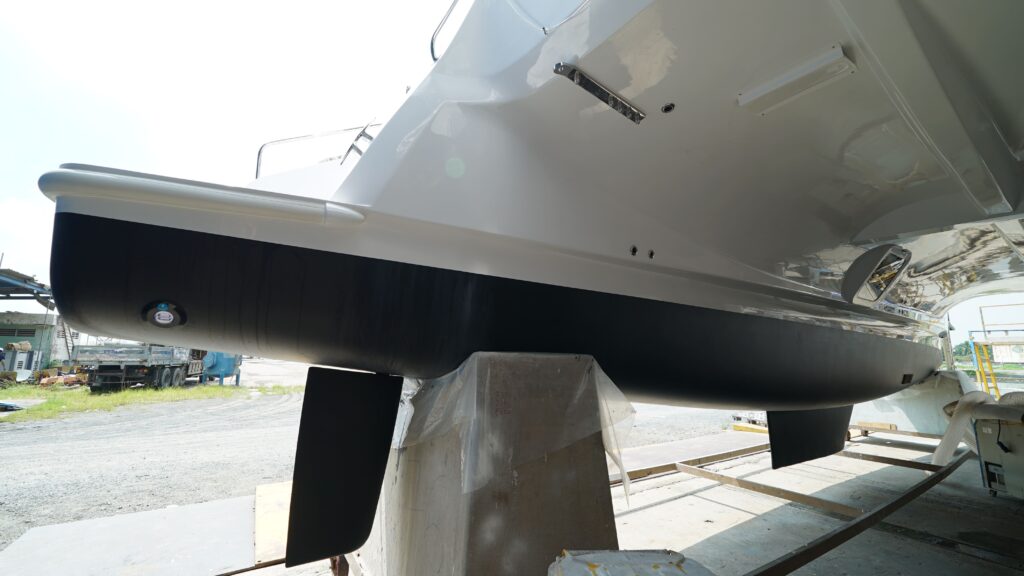

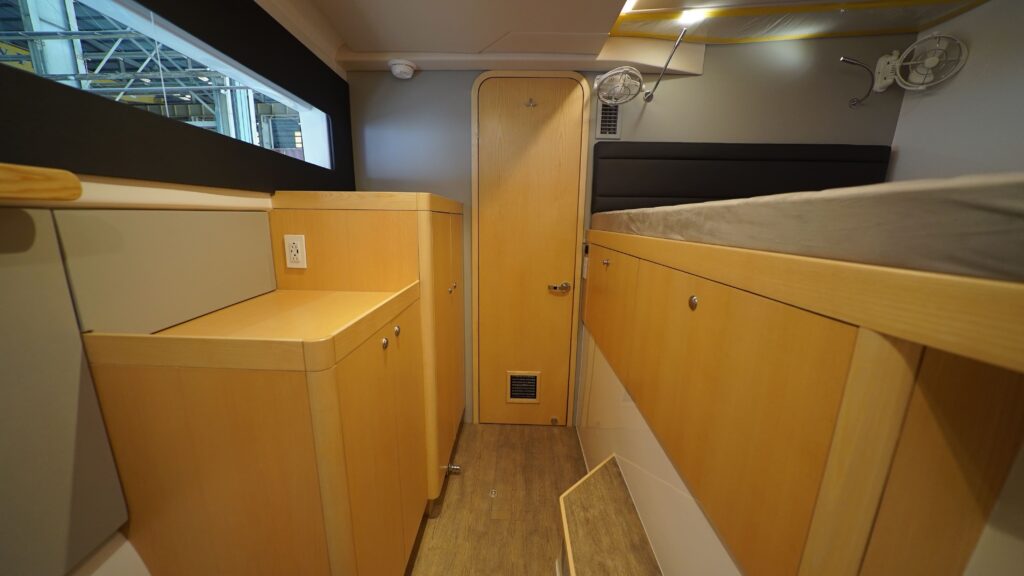

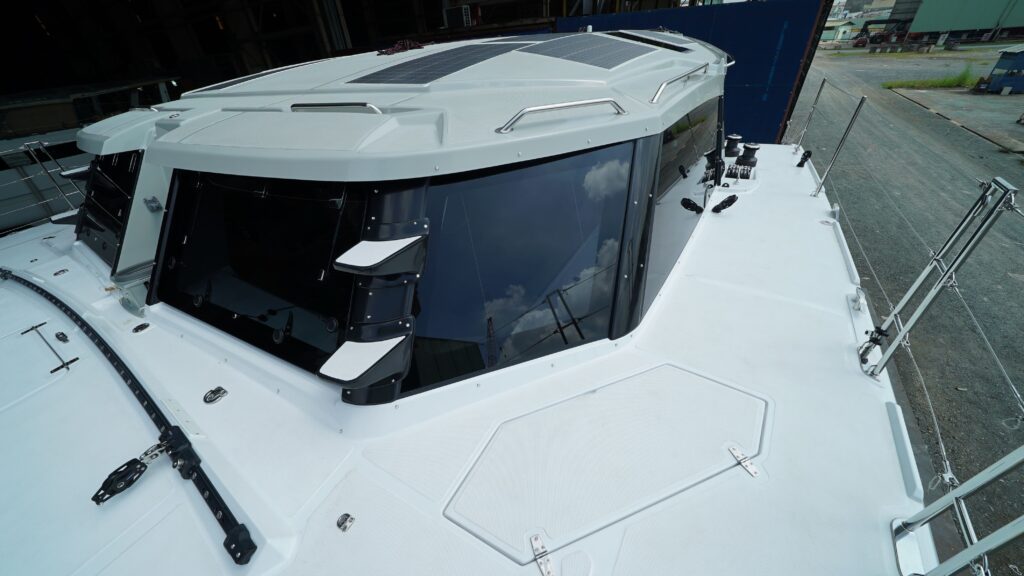

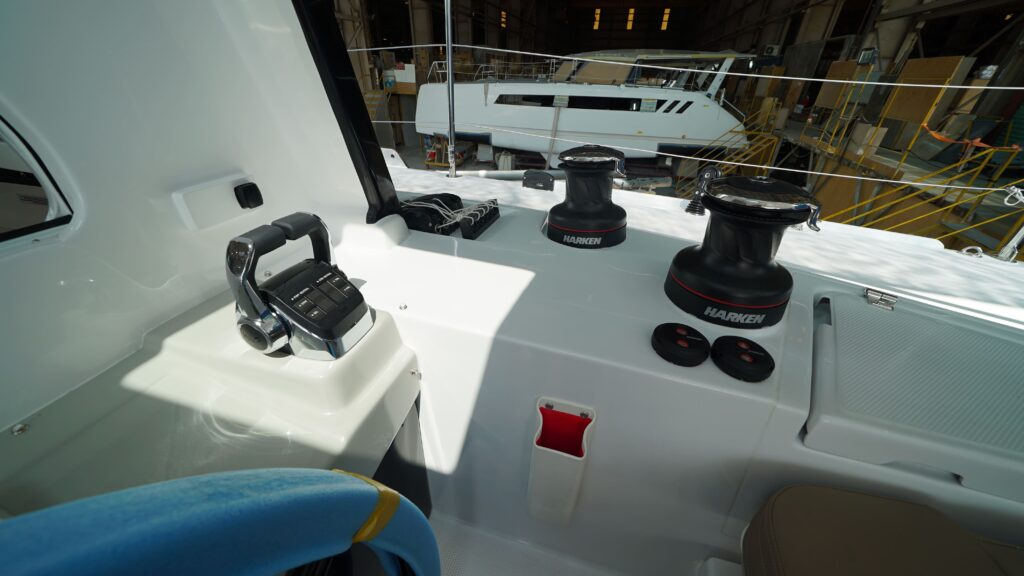

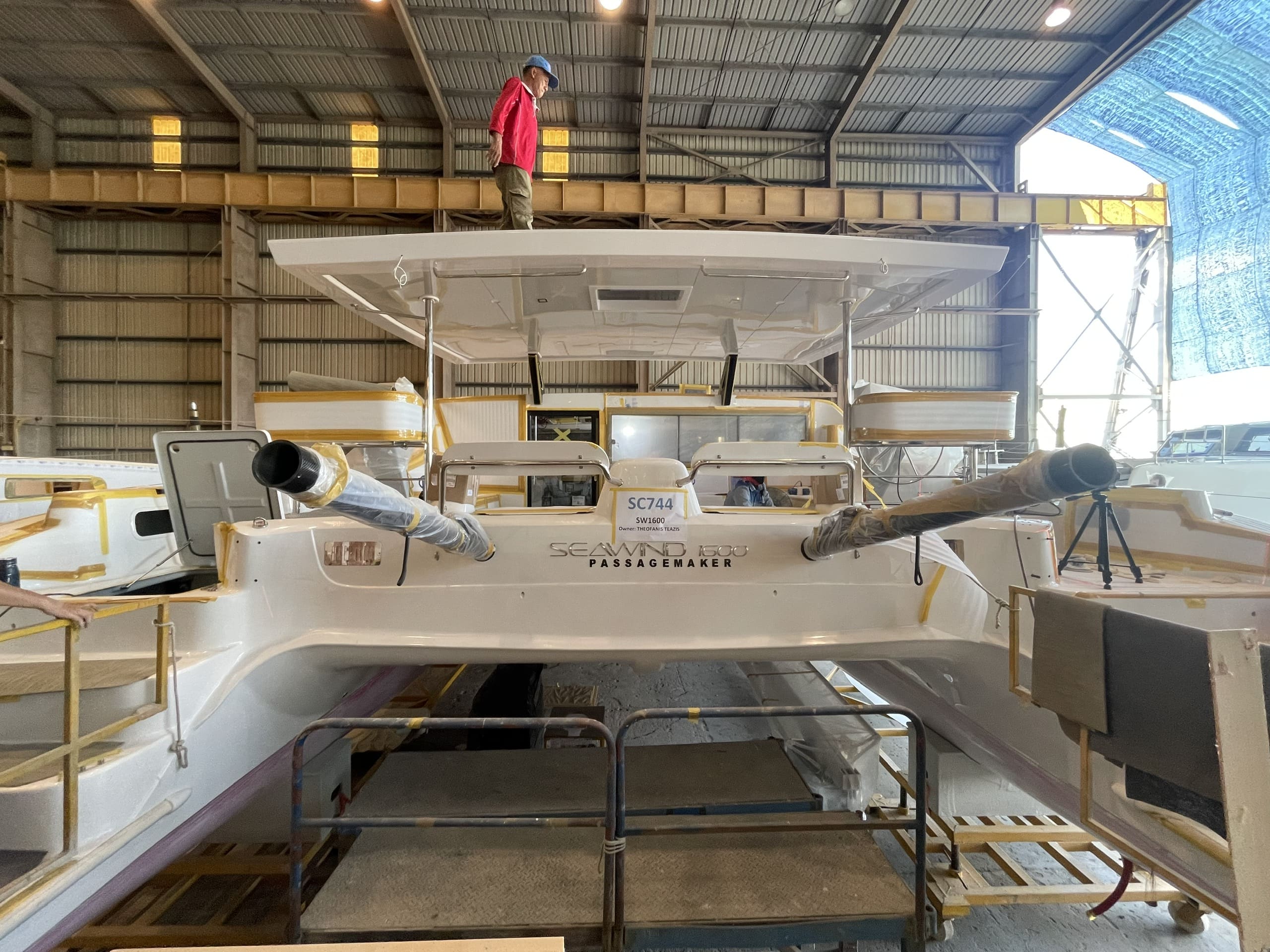

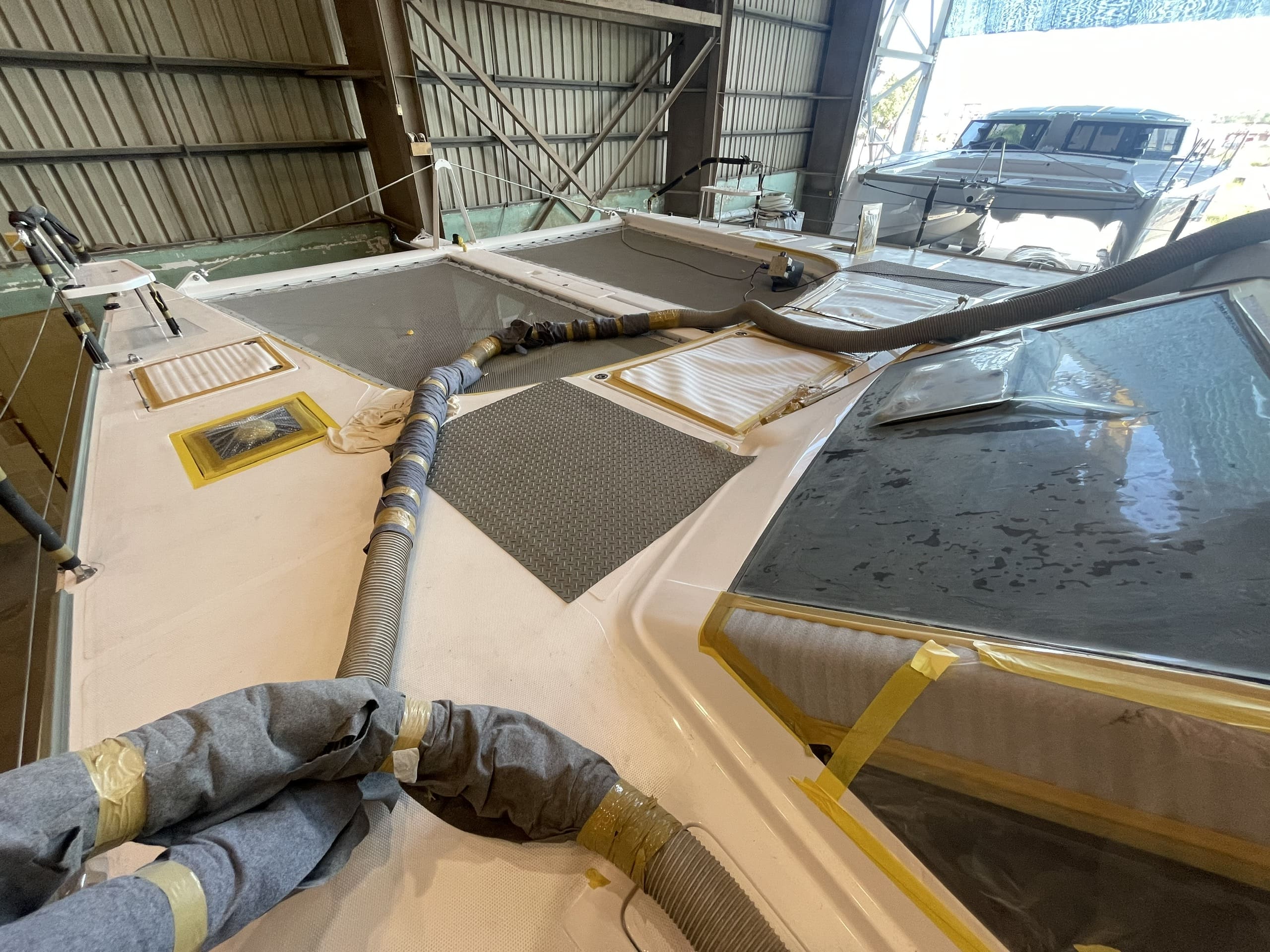

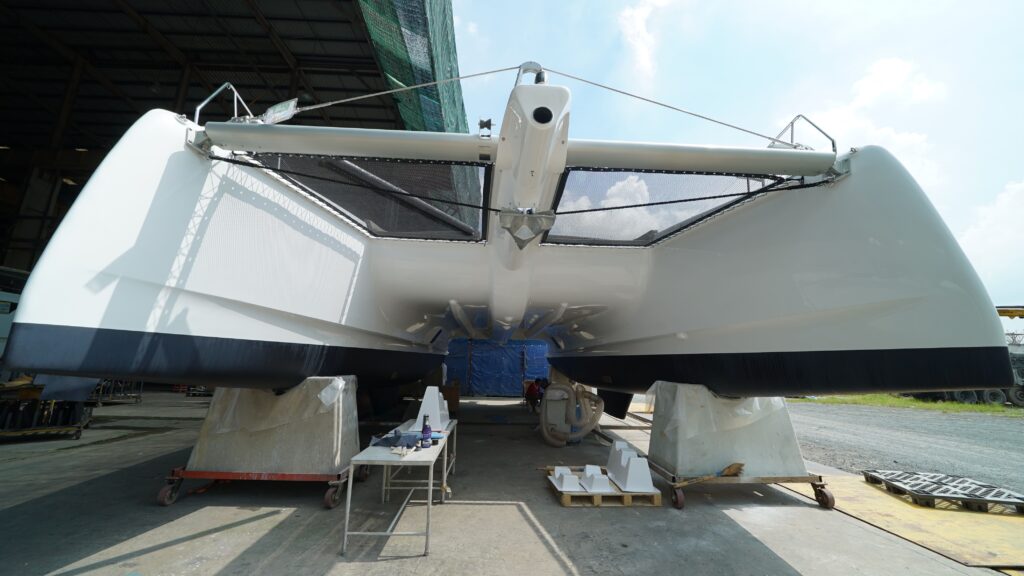

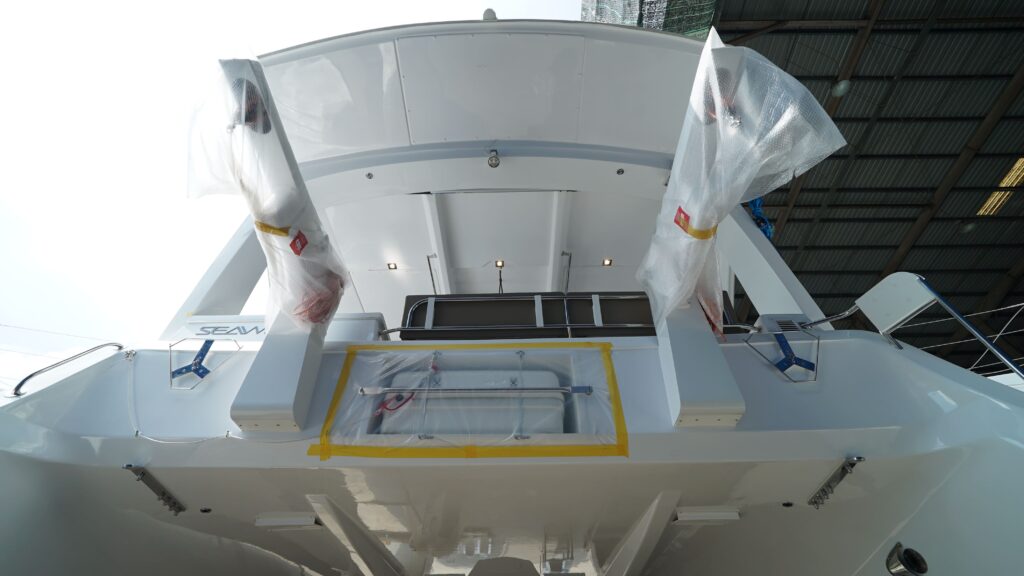

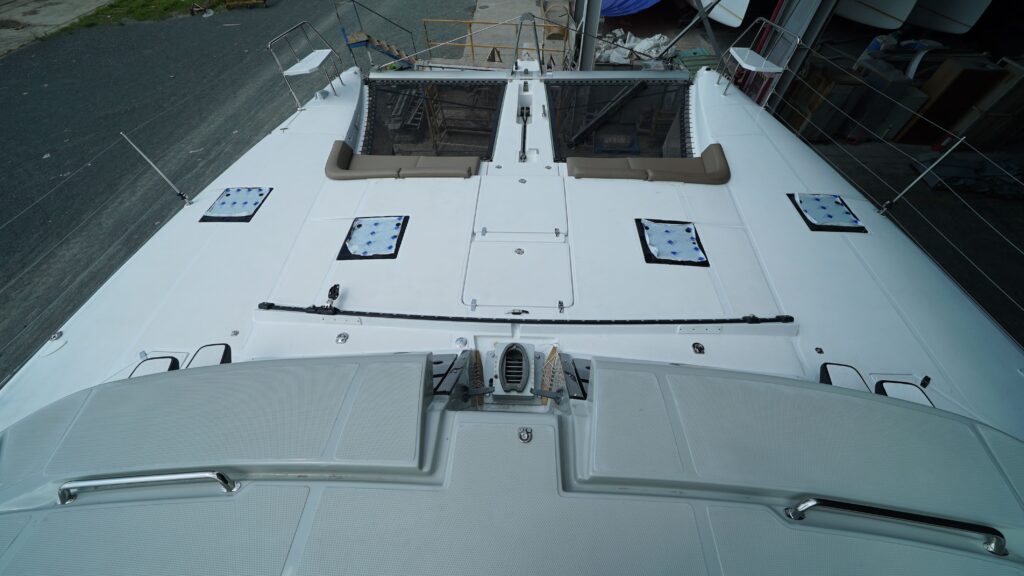

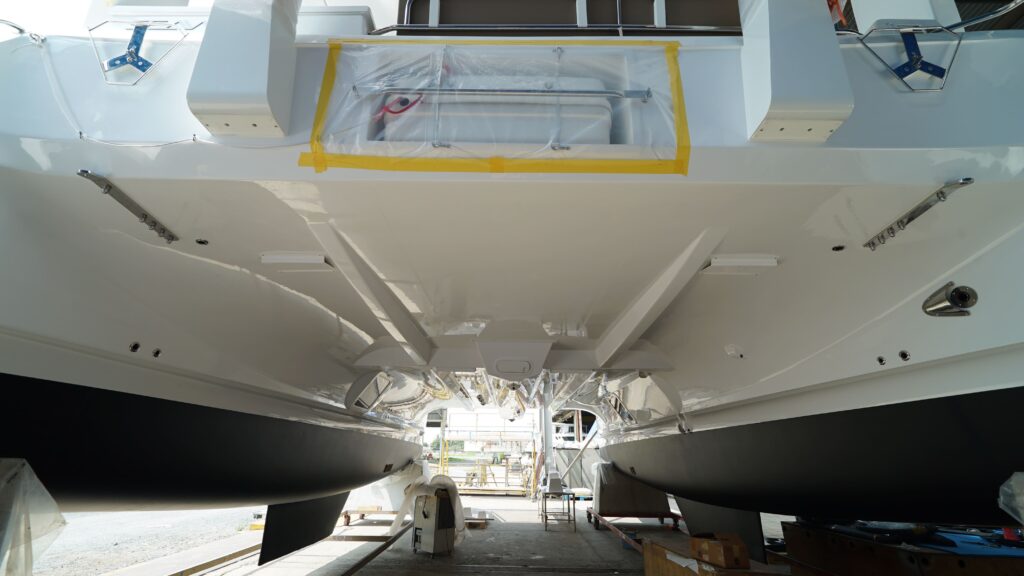

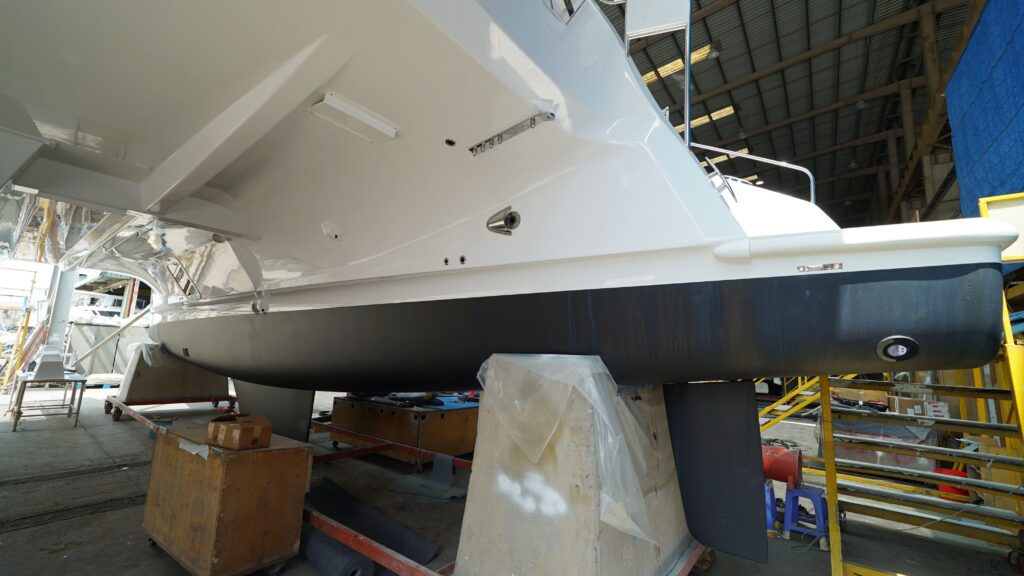

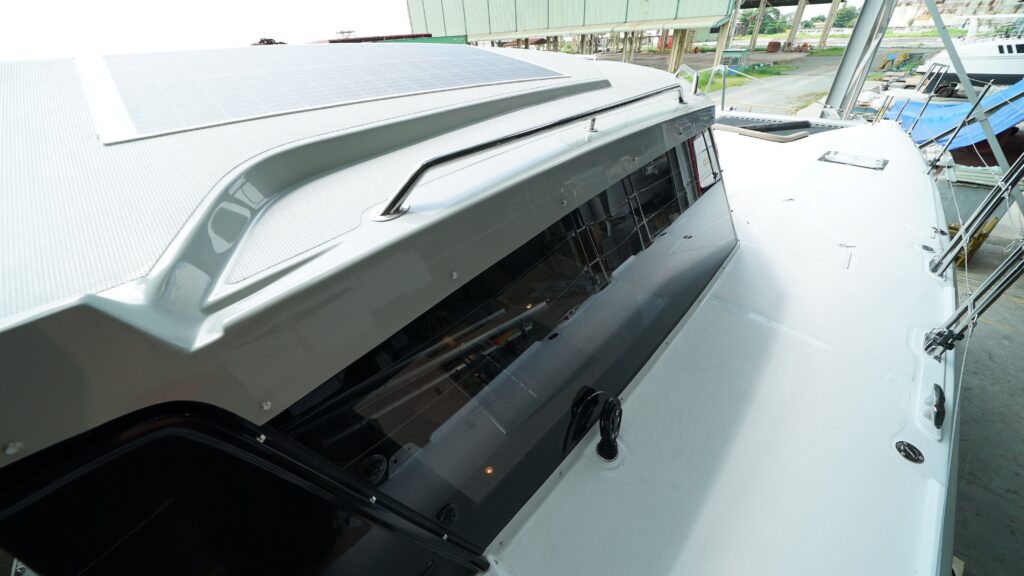

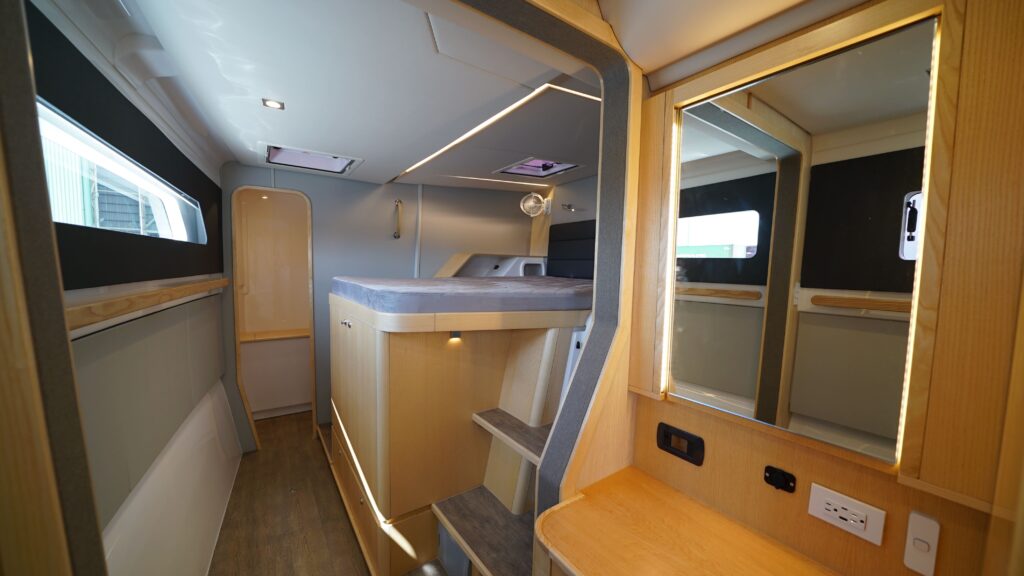

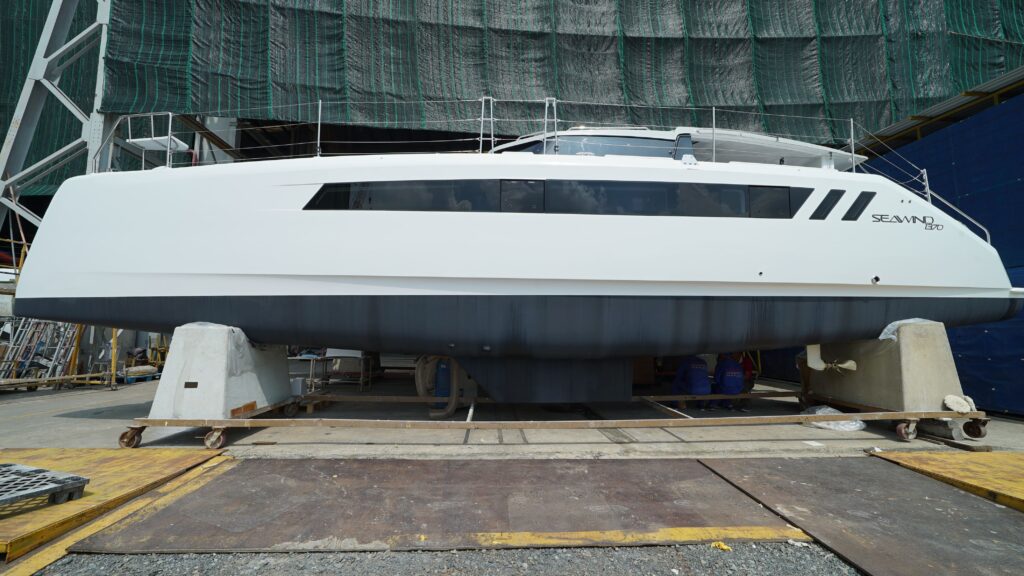

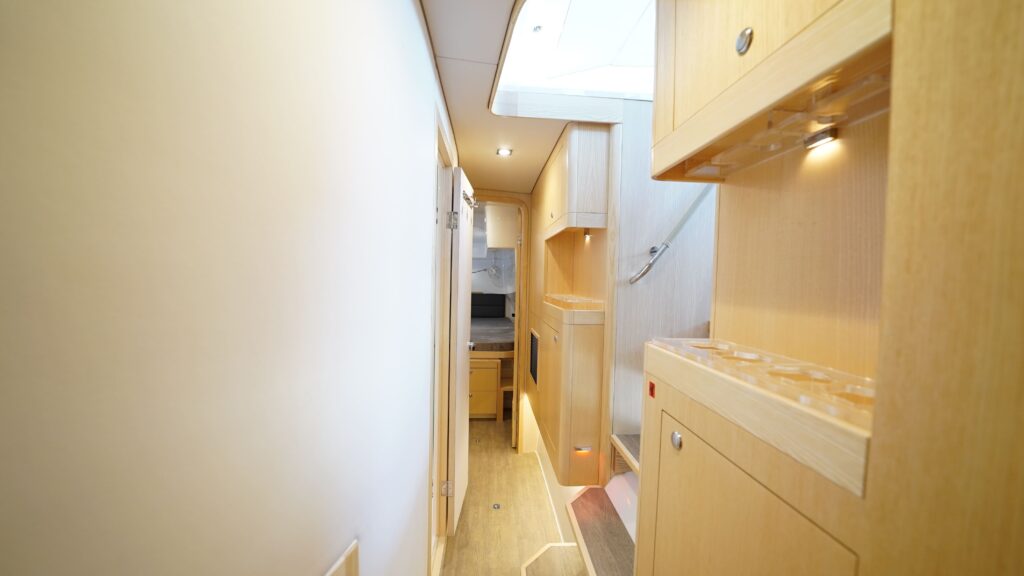

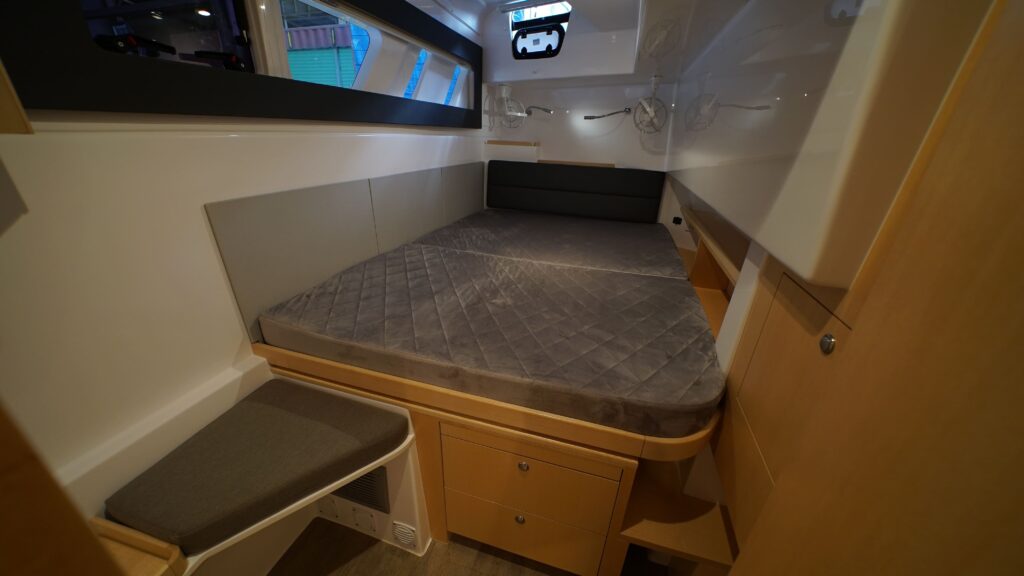

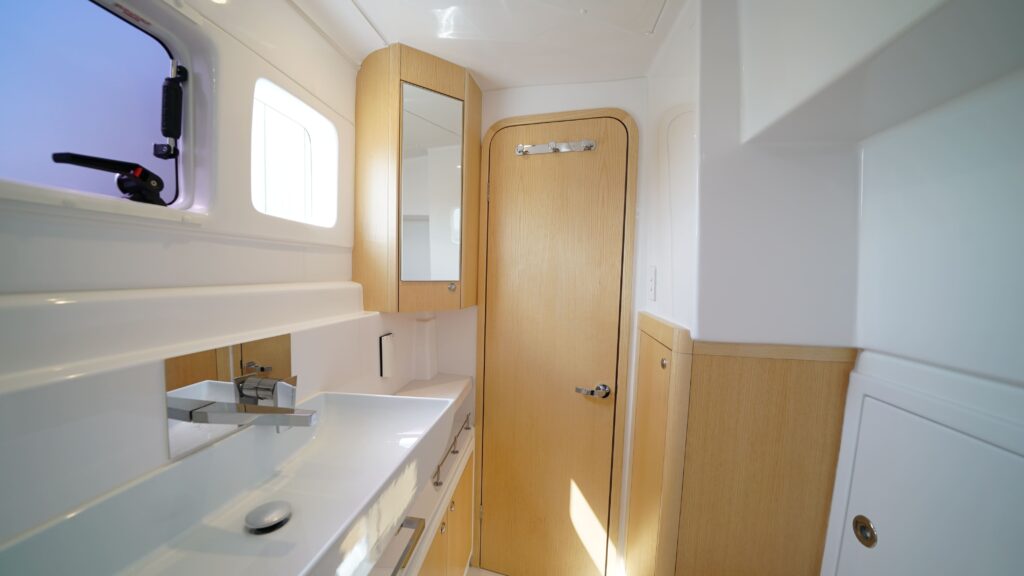

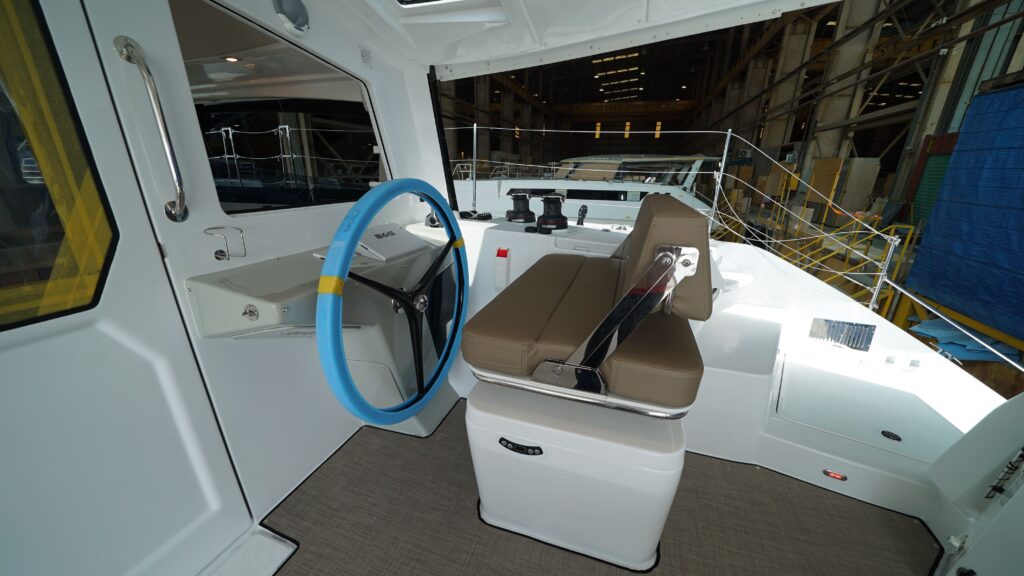

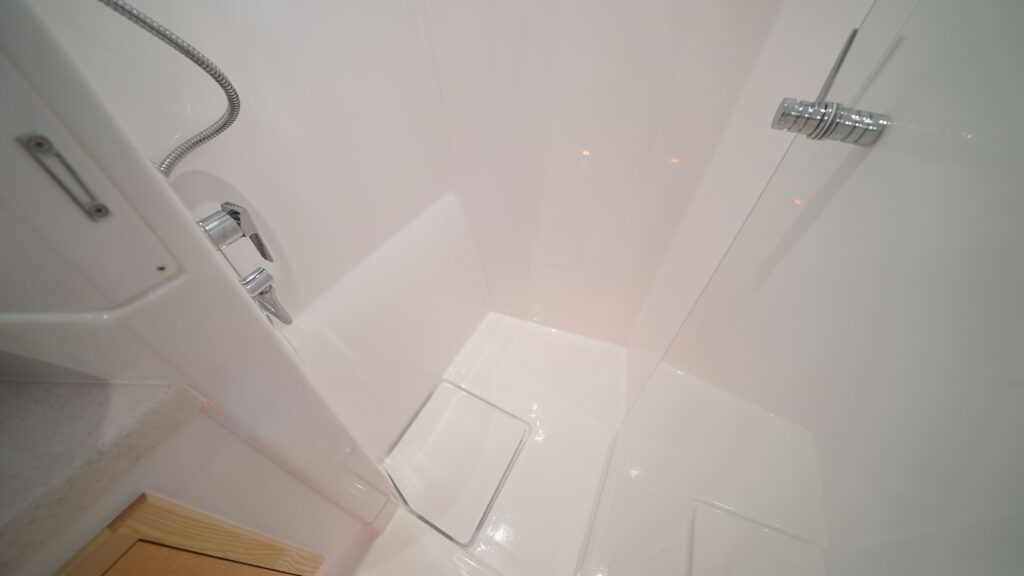

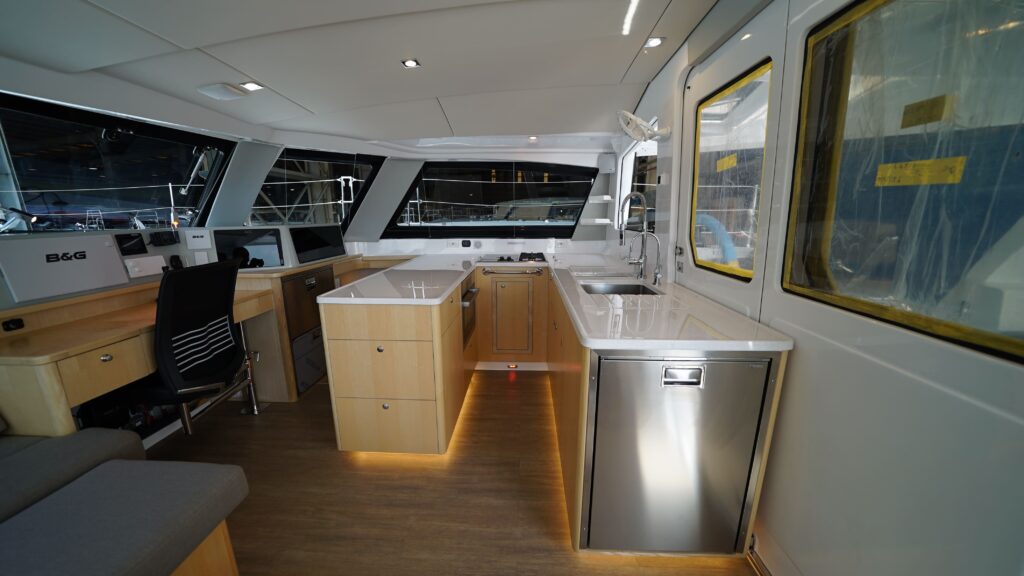

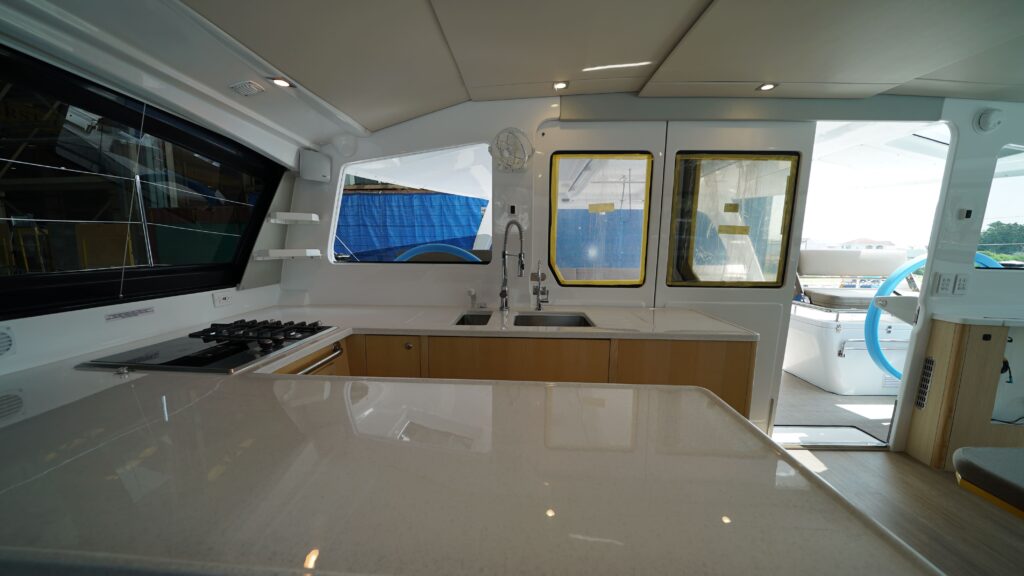

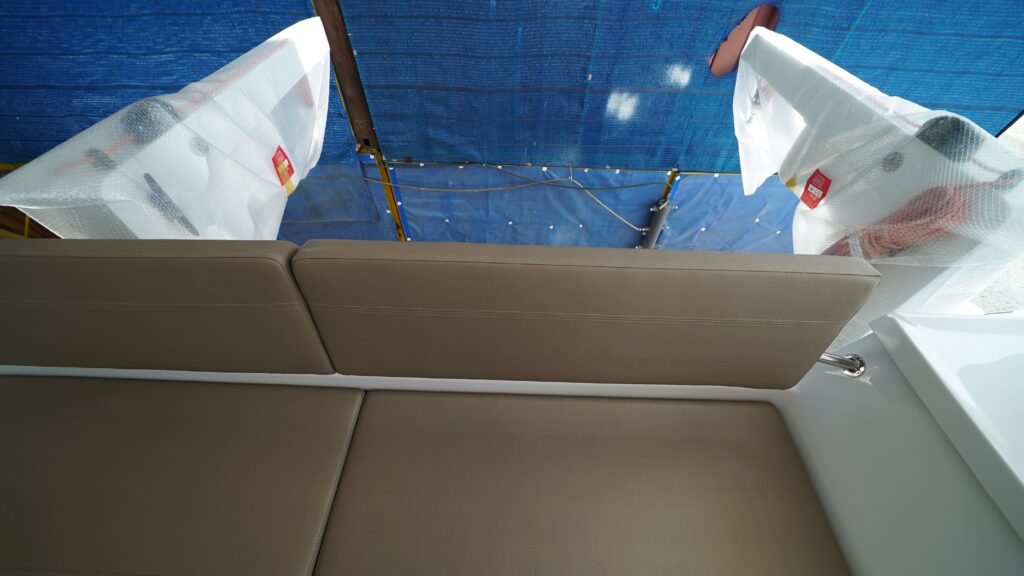

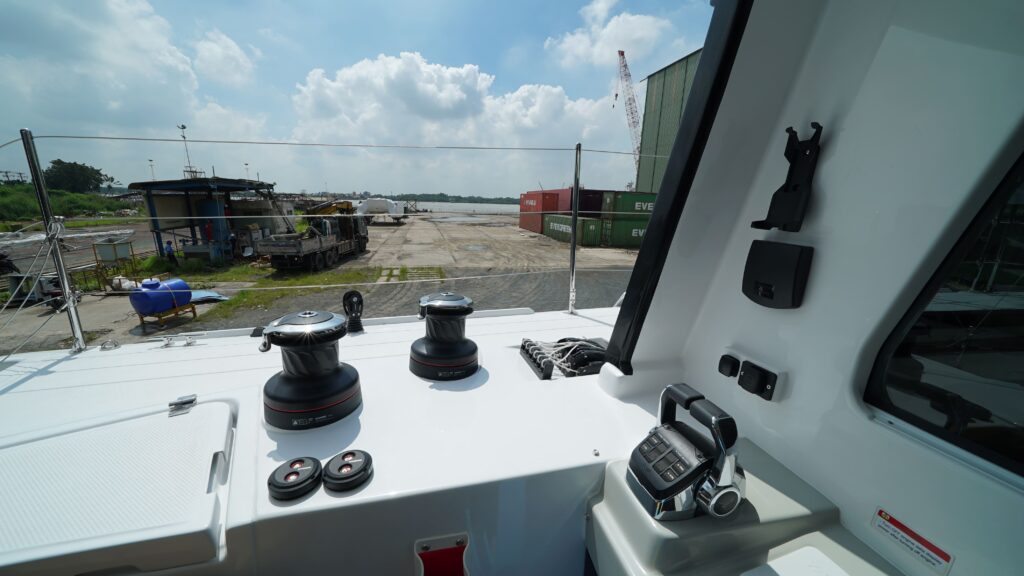

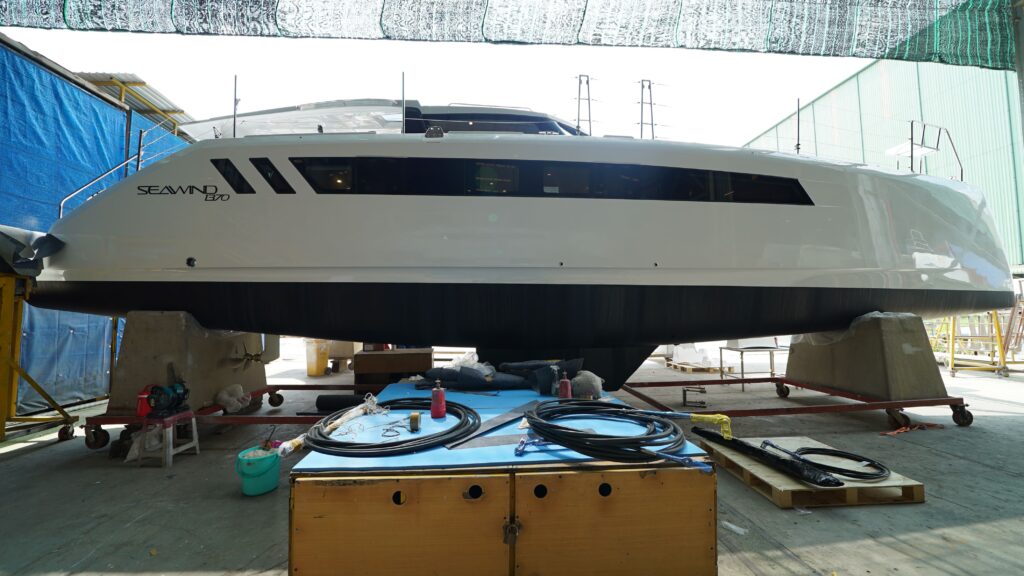

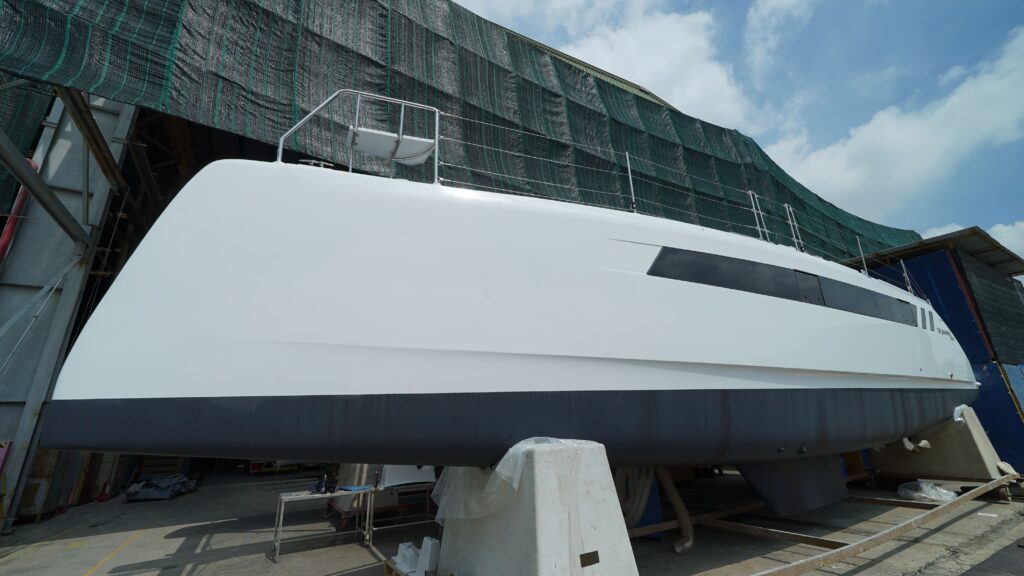

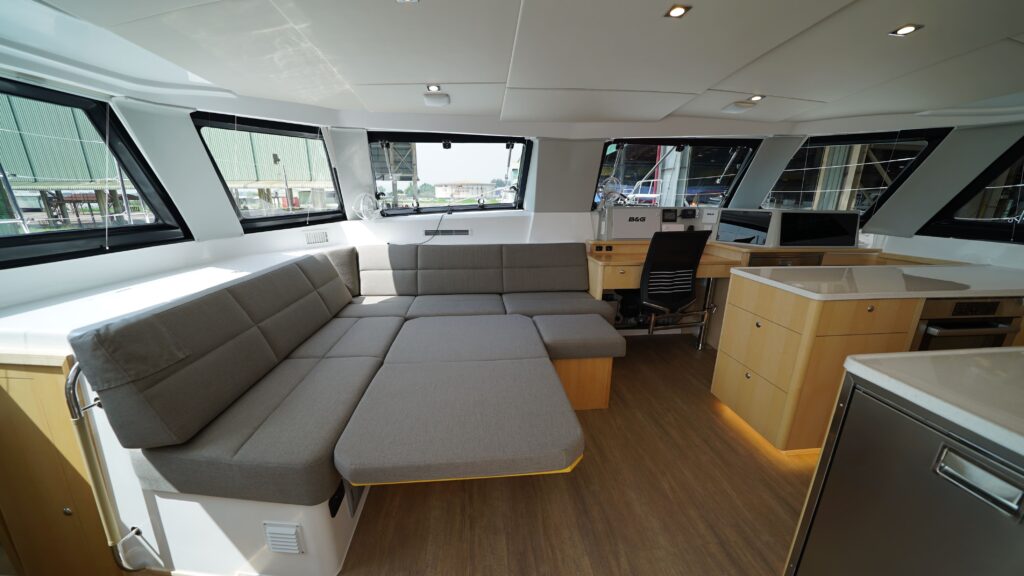

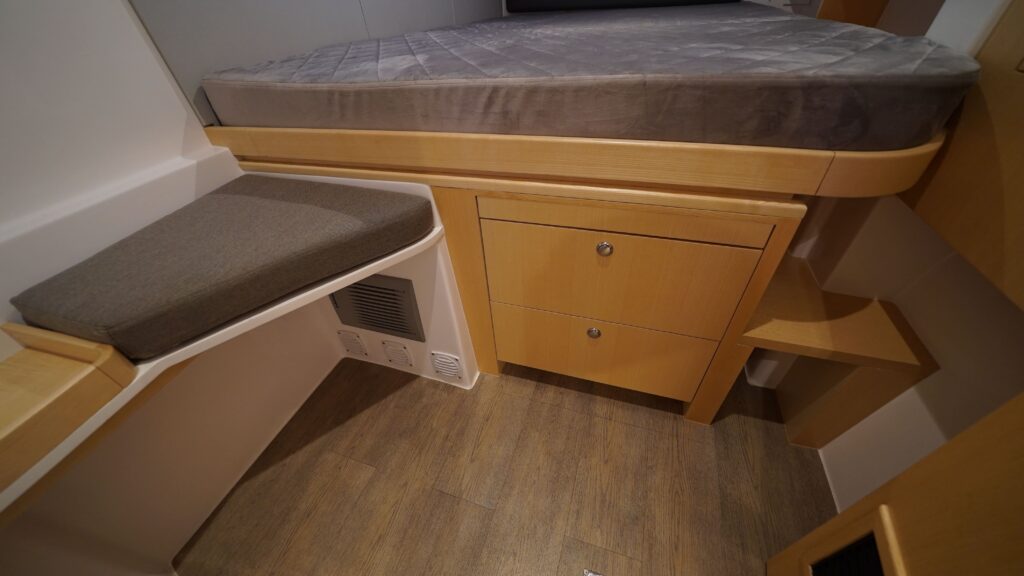

Production Update – Completion

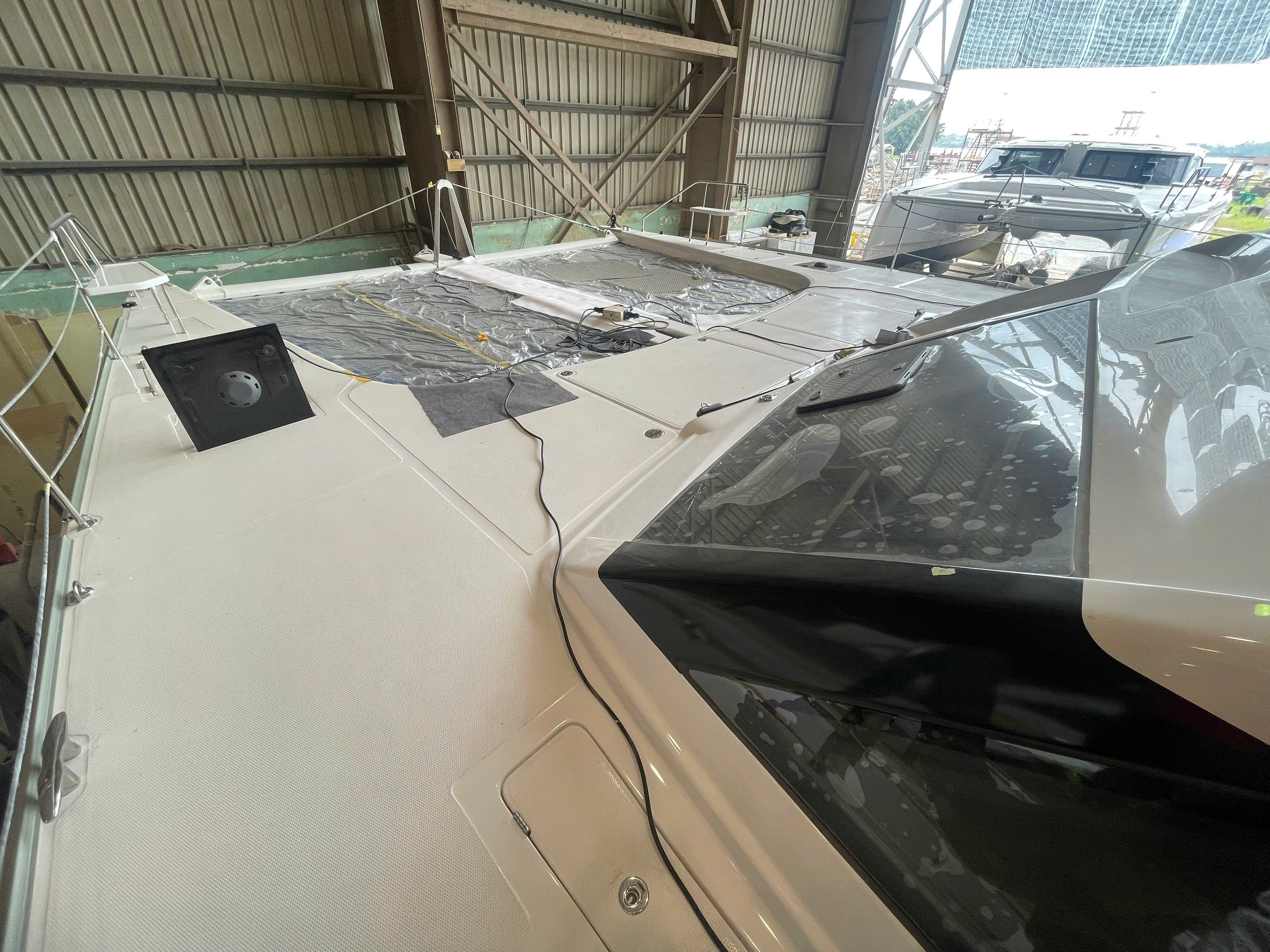

We are excited to announce that your boat is now completed and left our factory to the storage yard.

Please see below for some photos of the boat in her final days before being wrapped up. Let us also take you on a tour around your boat via thisĀ Youtube video.

It has been a pleasure building your boat and on behalf of the entire team at Seawind Catamarans, we wish you many years of fun-filled enjoyment aboard your new Seawind 1170.

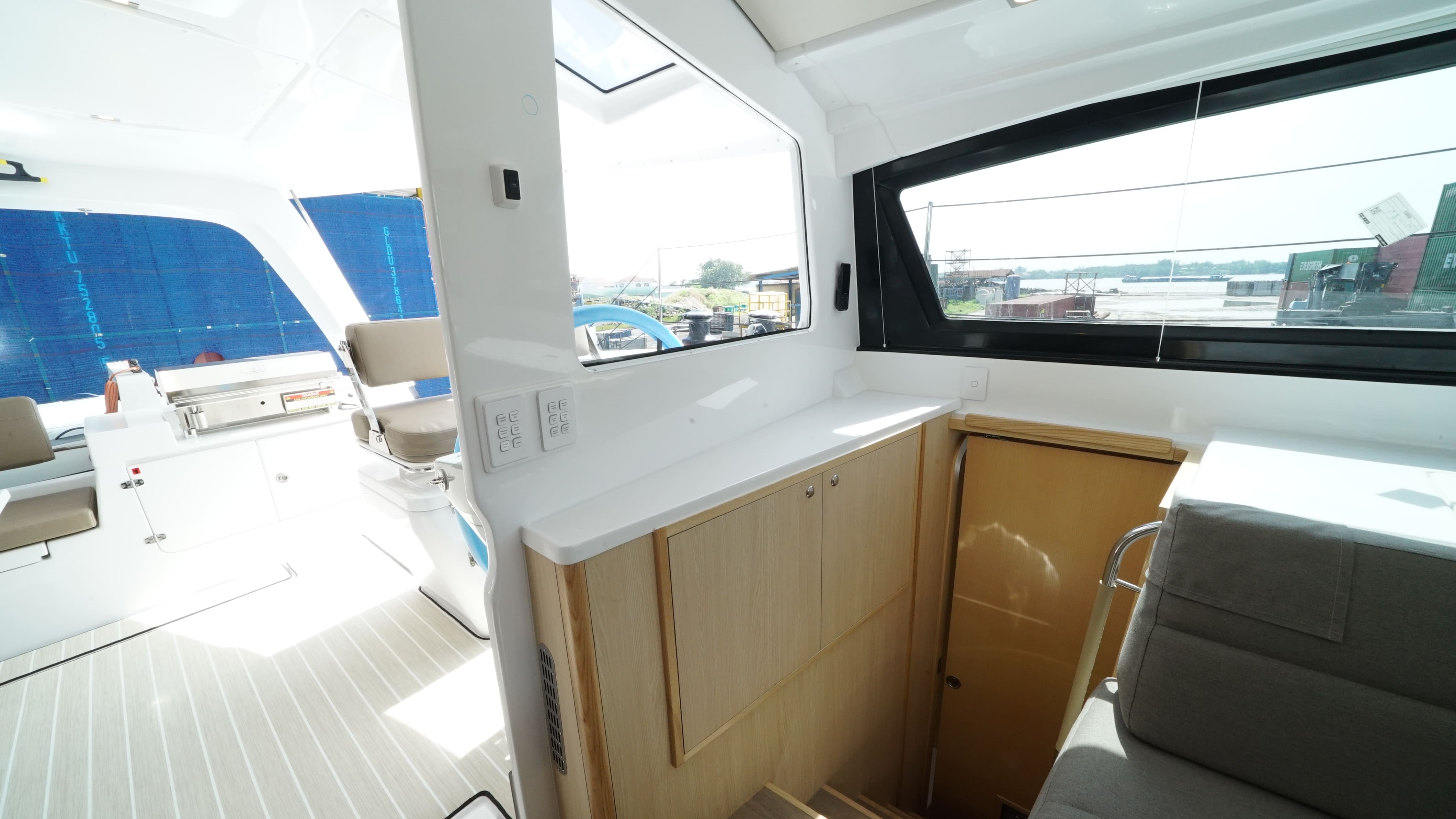

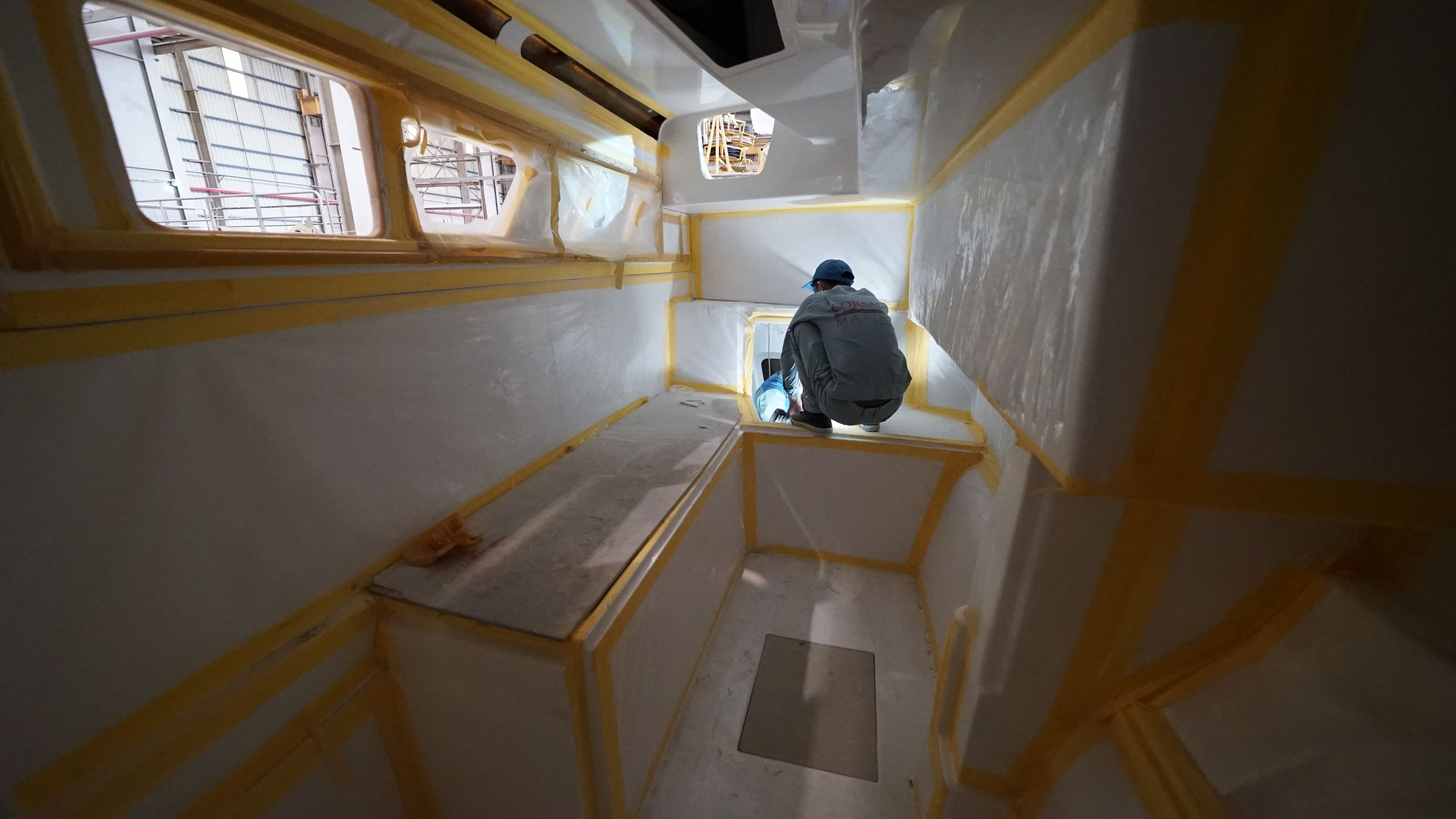

Production Update – Fit out

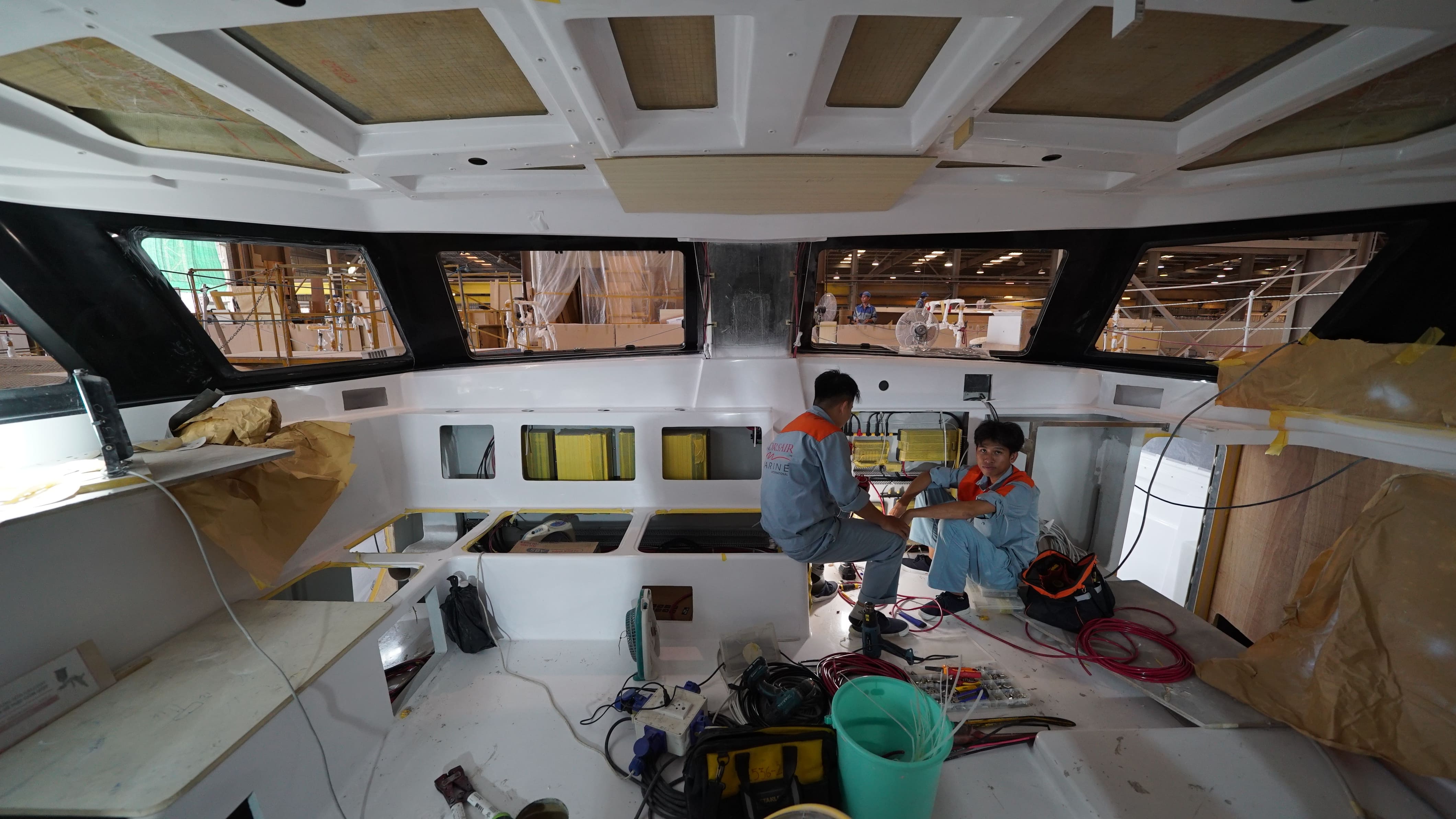

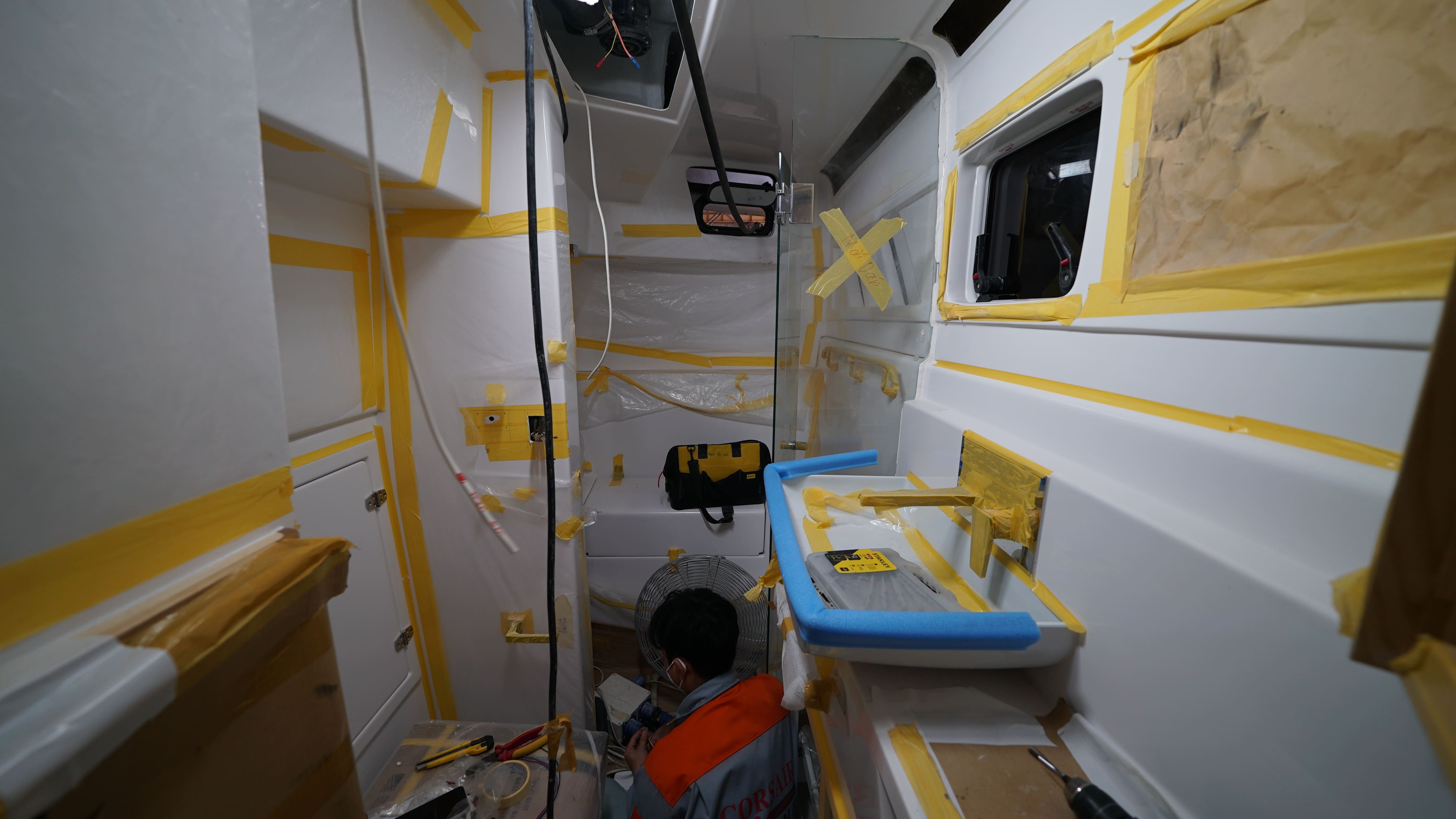

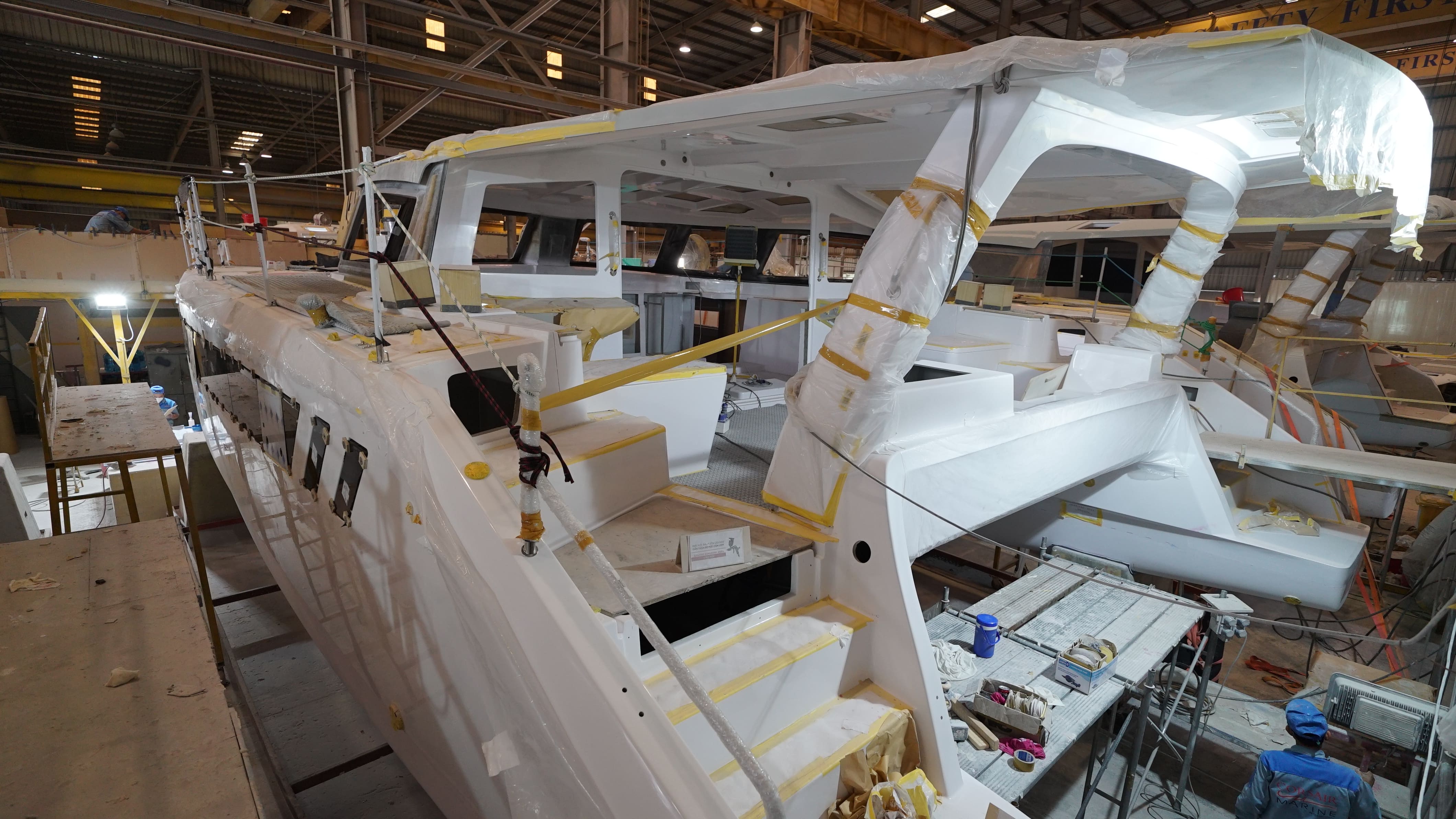

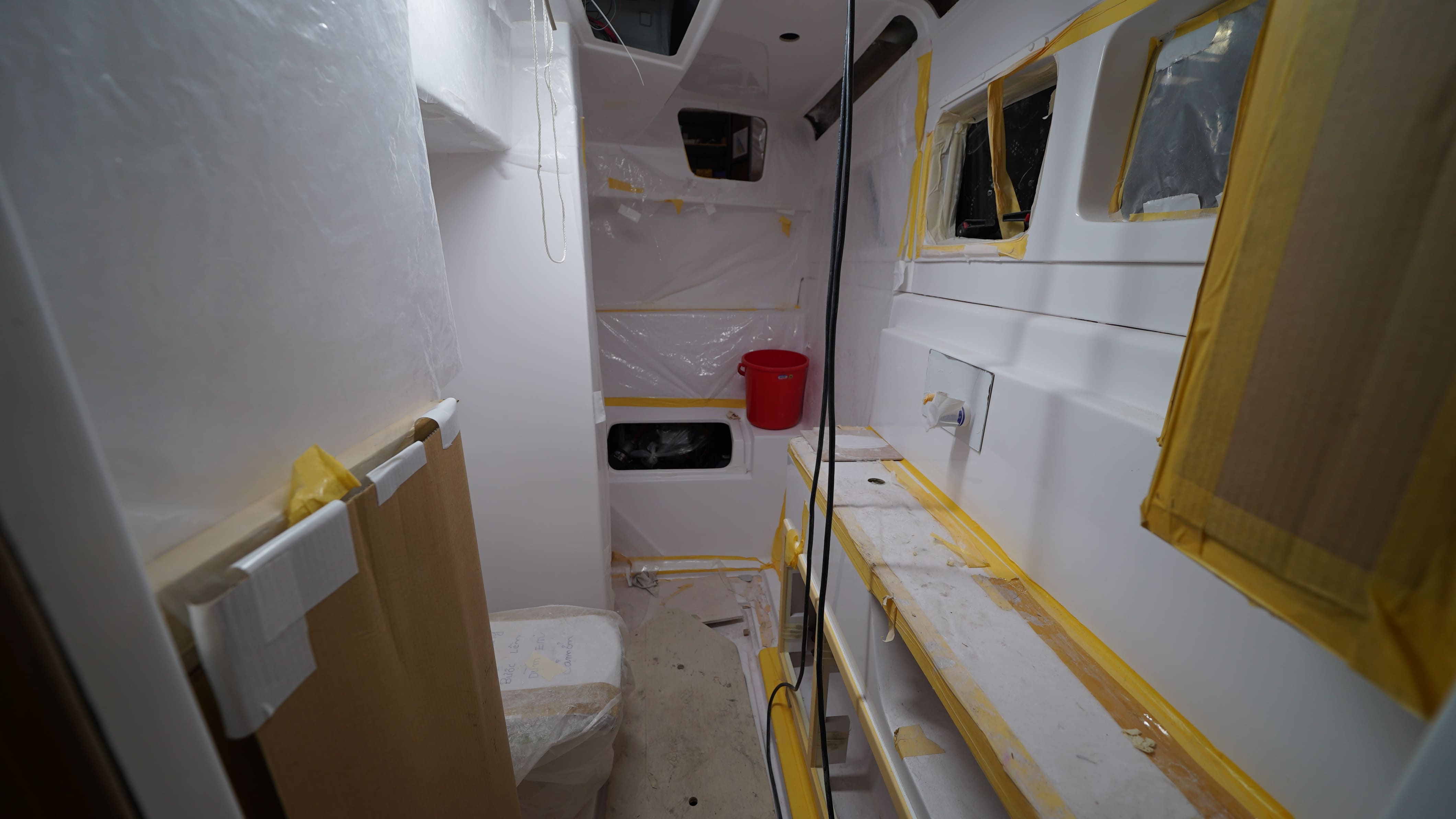

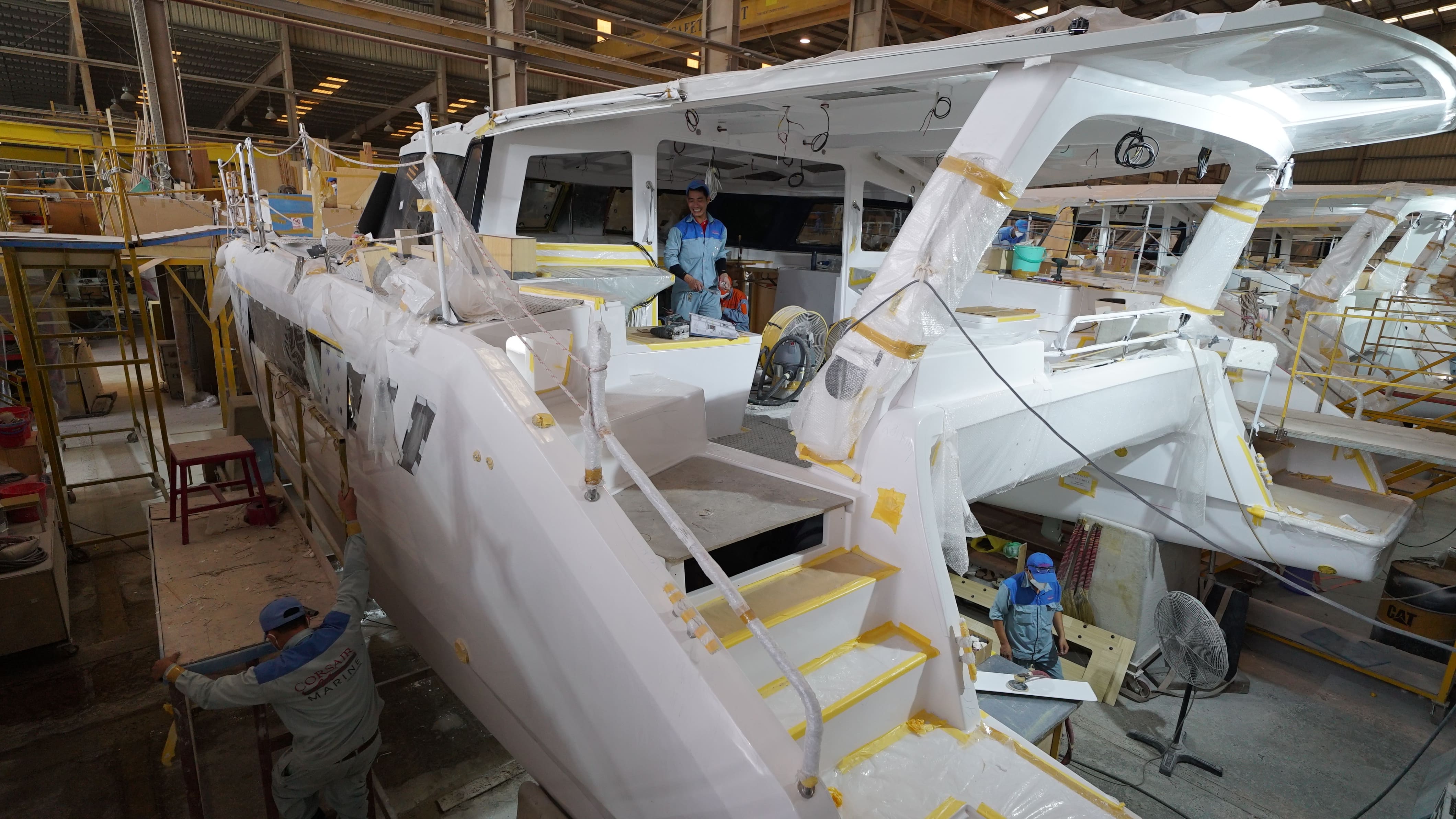

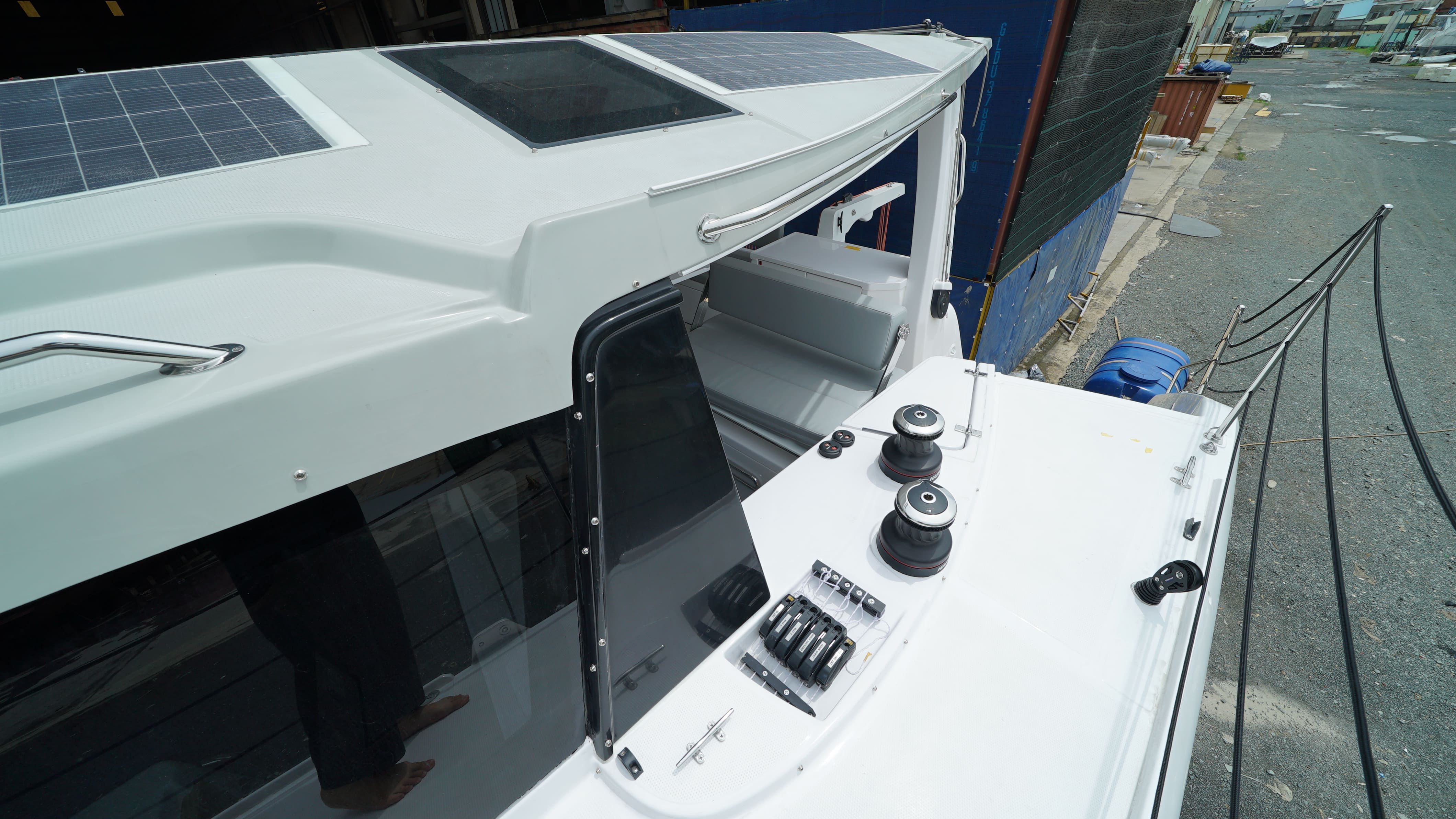

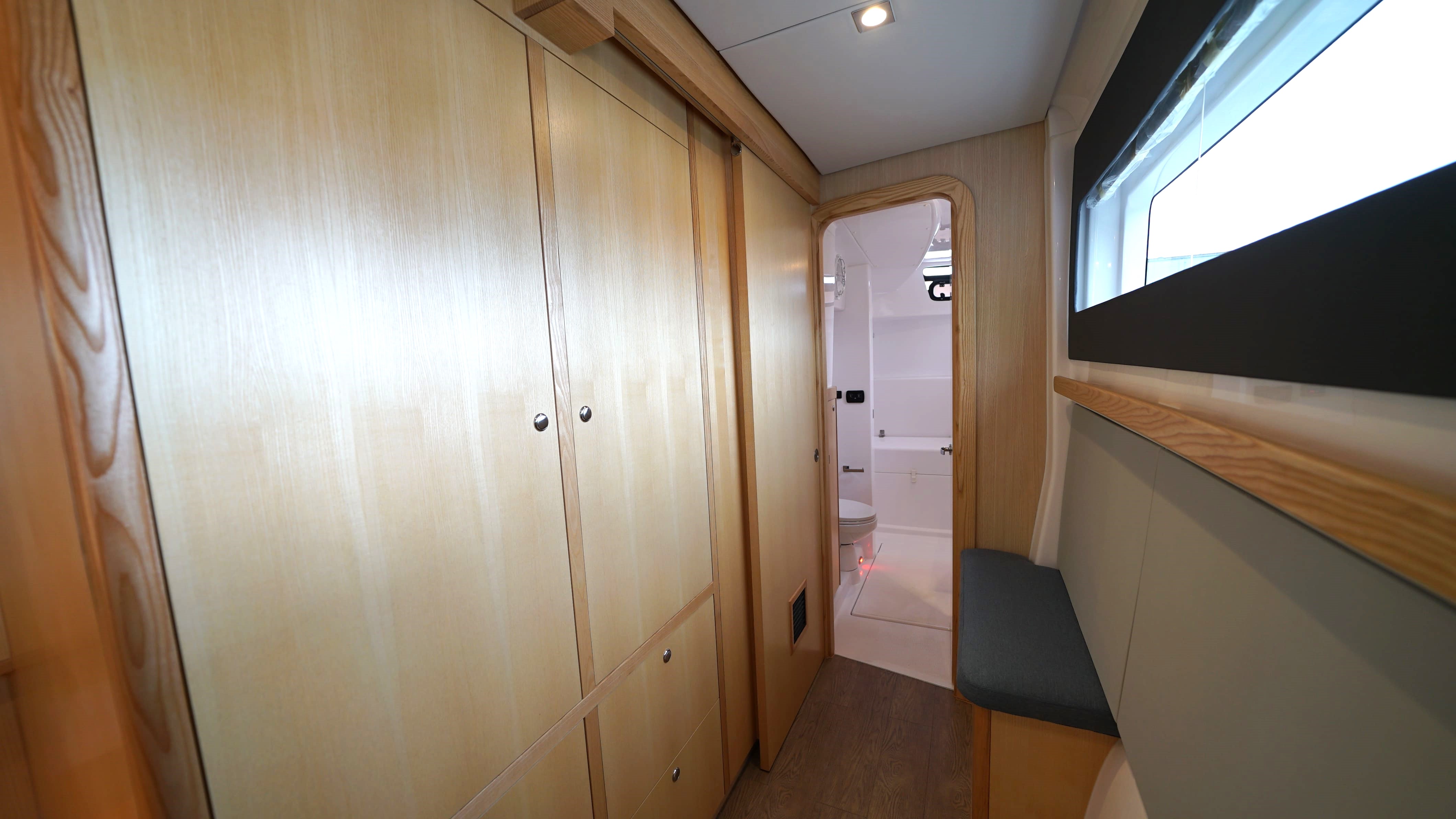

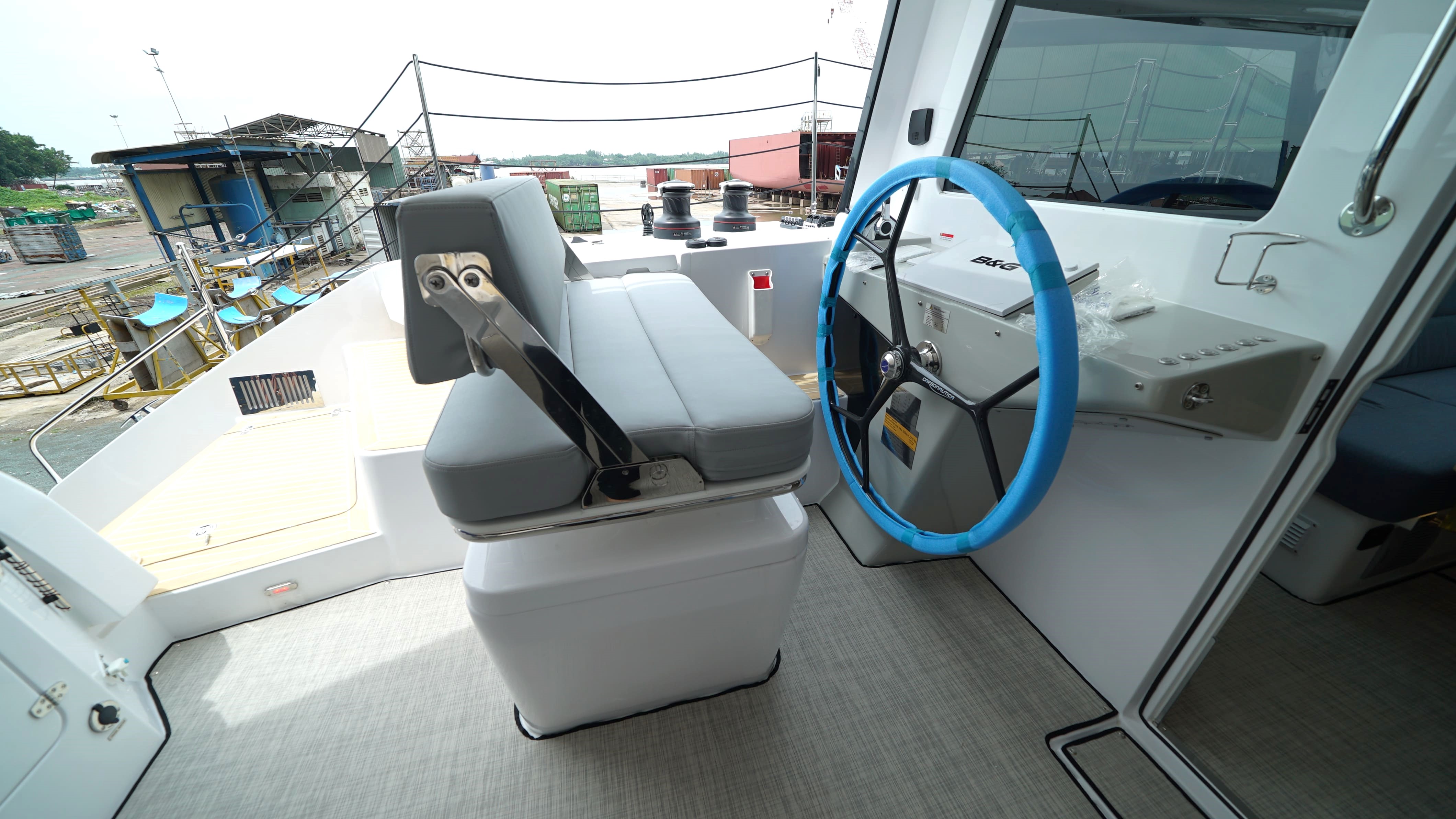

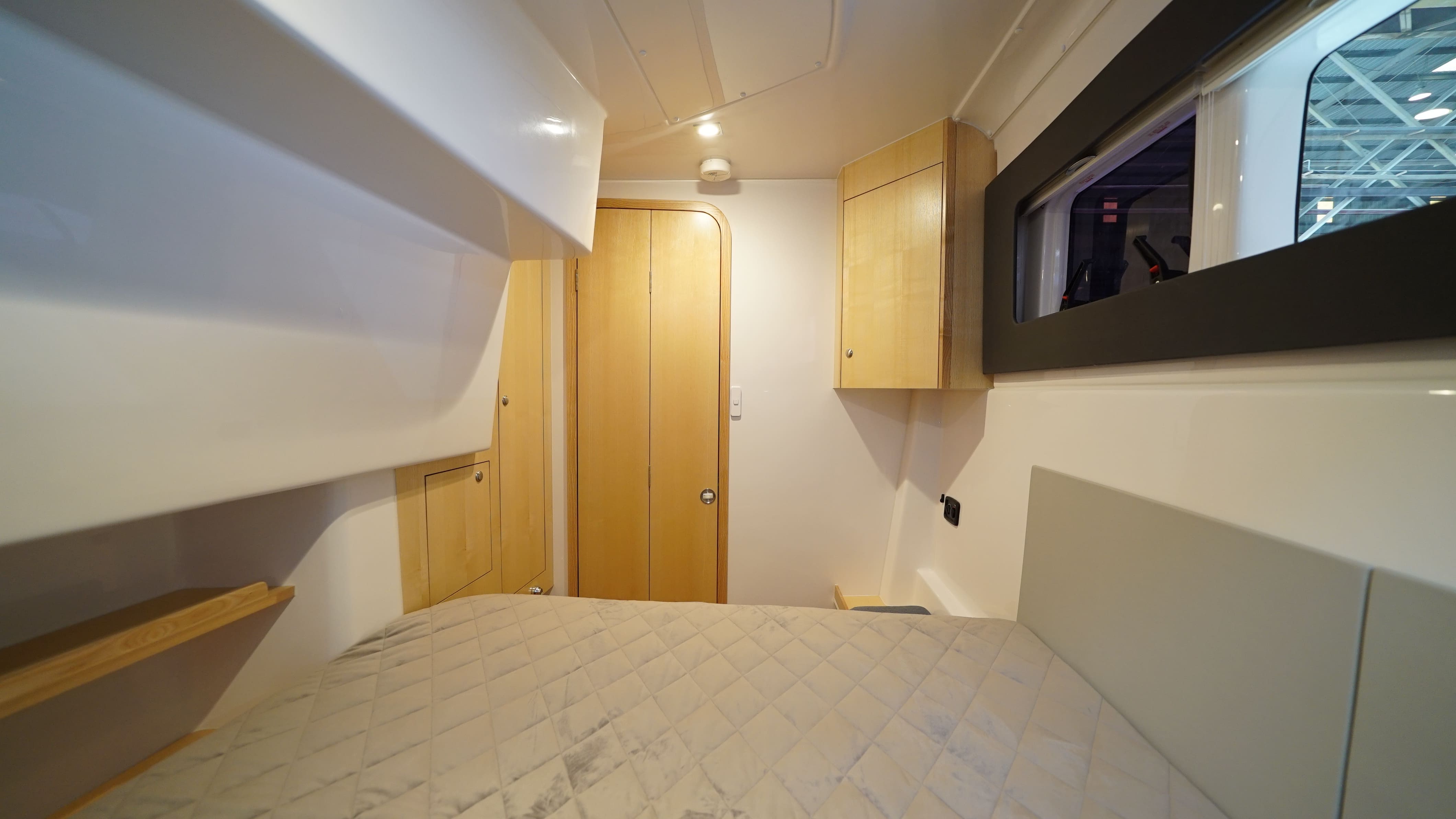

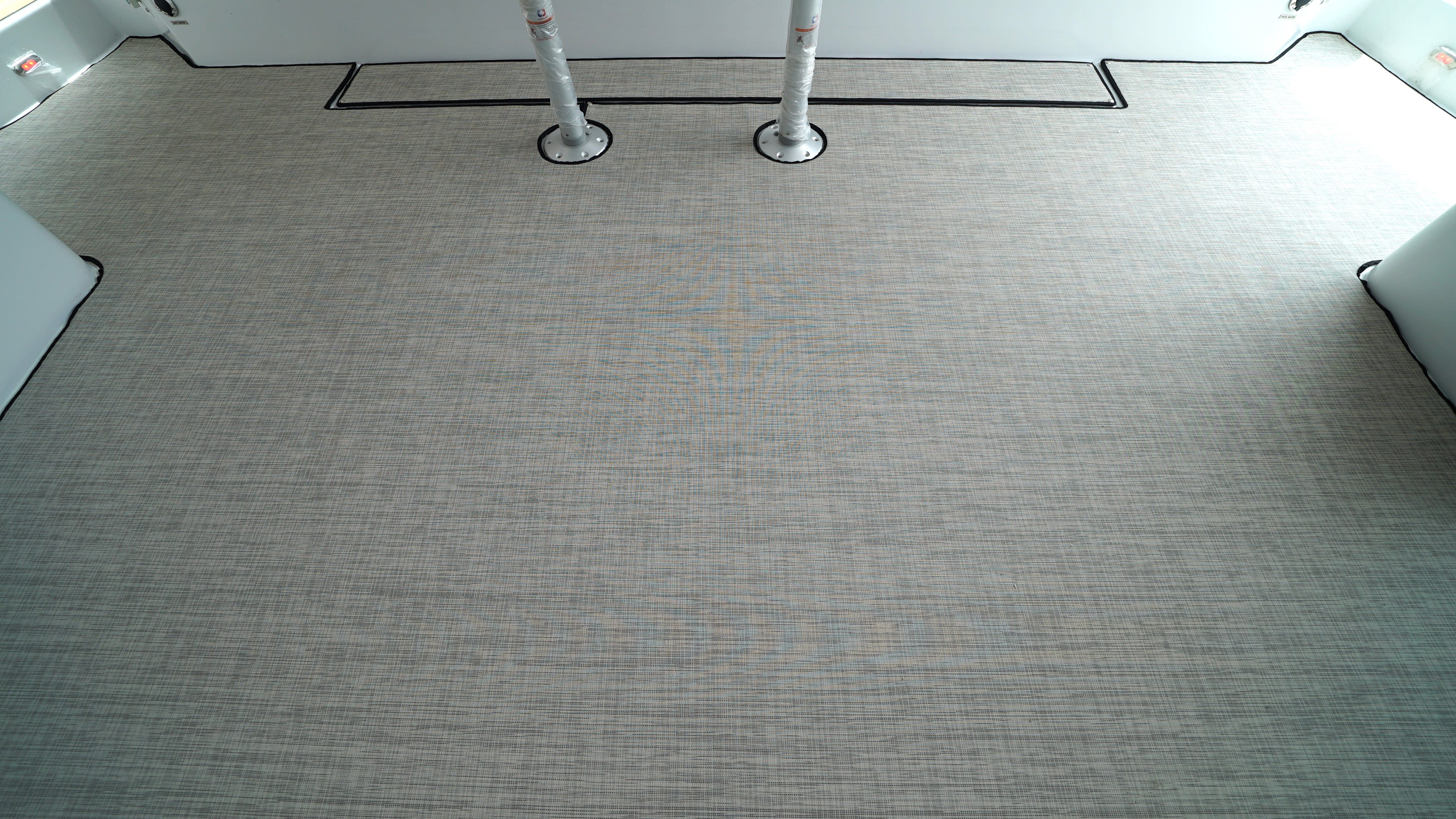

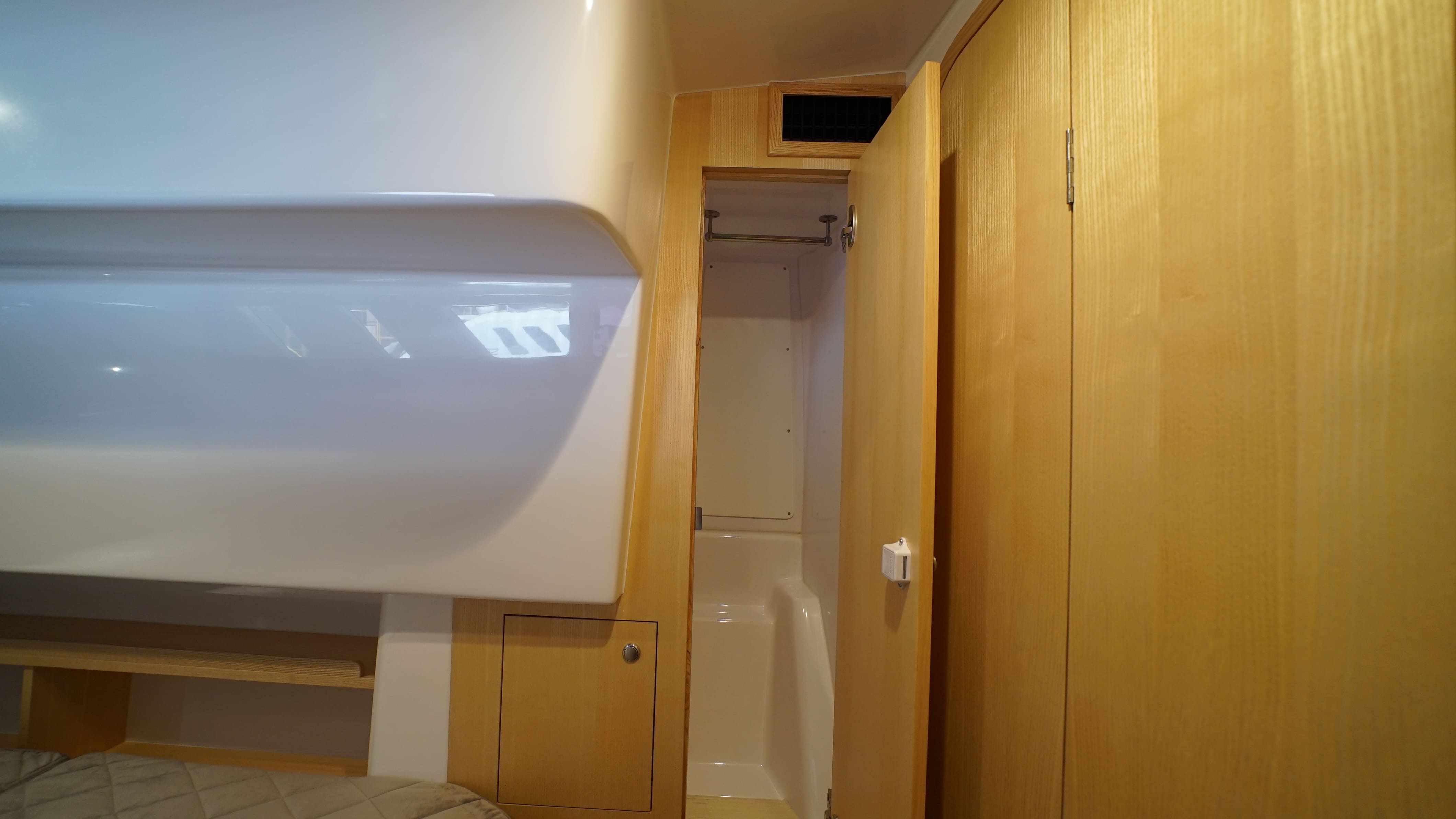

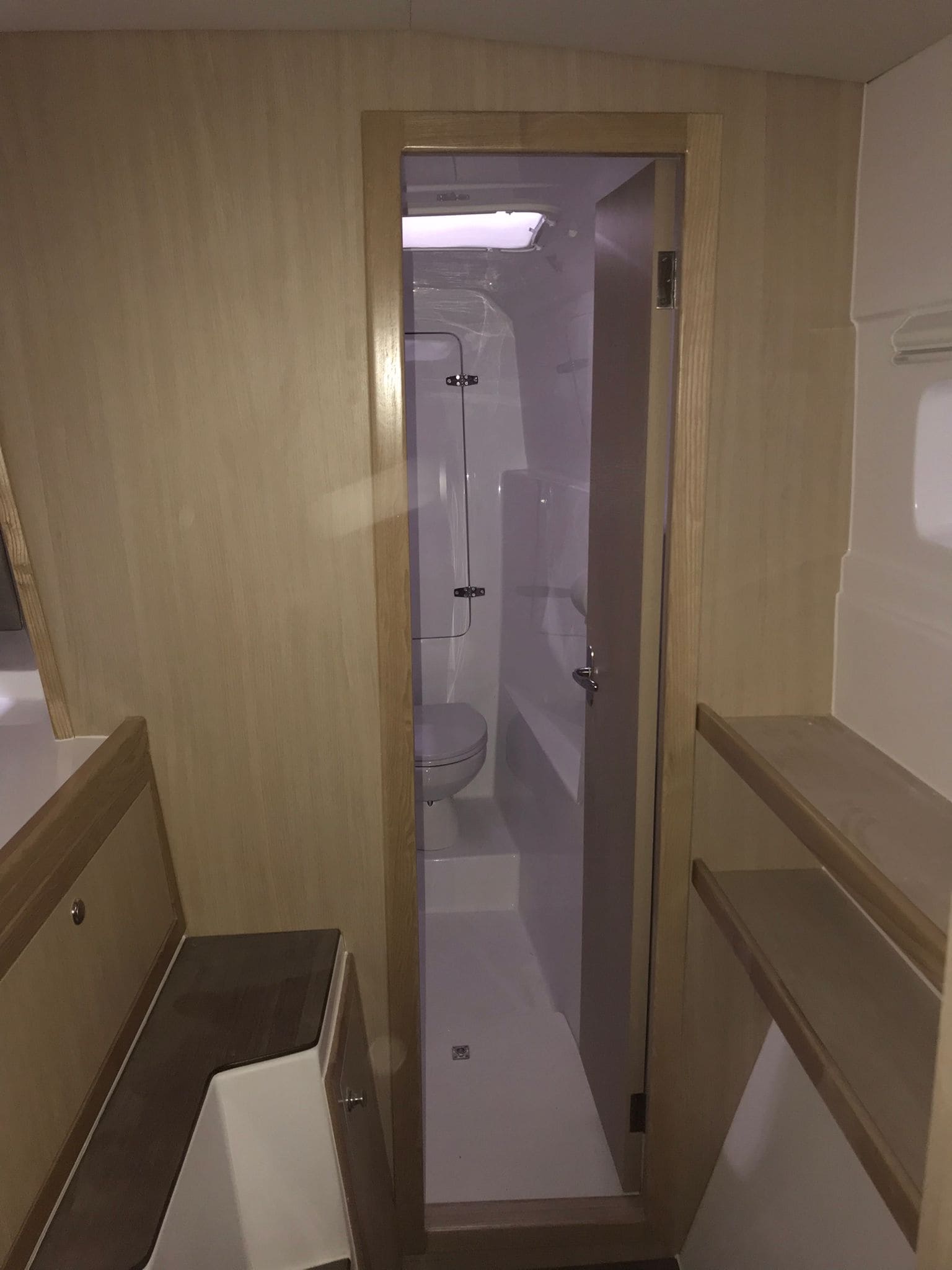

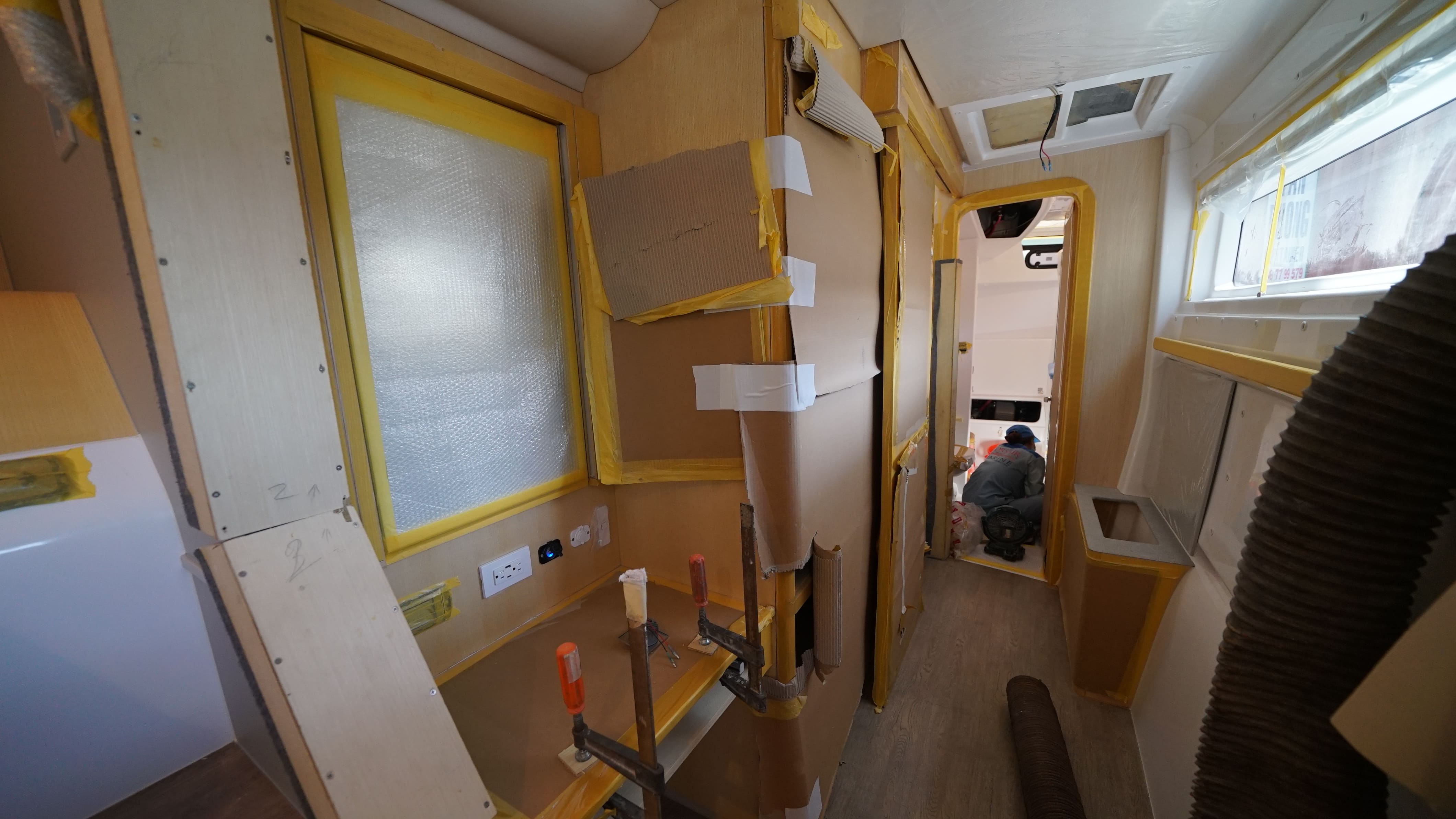

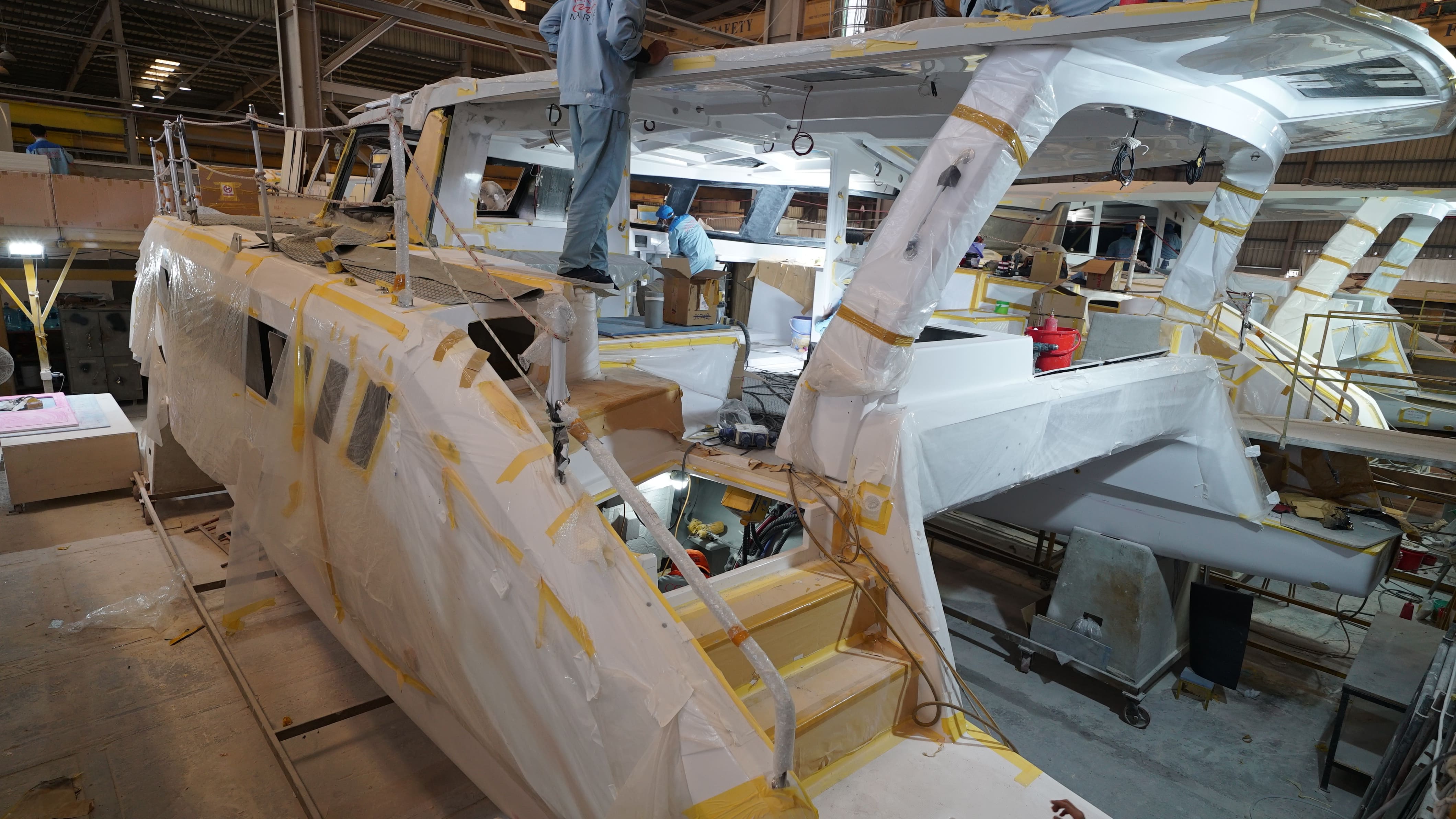

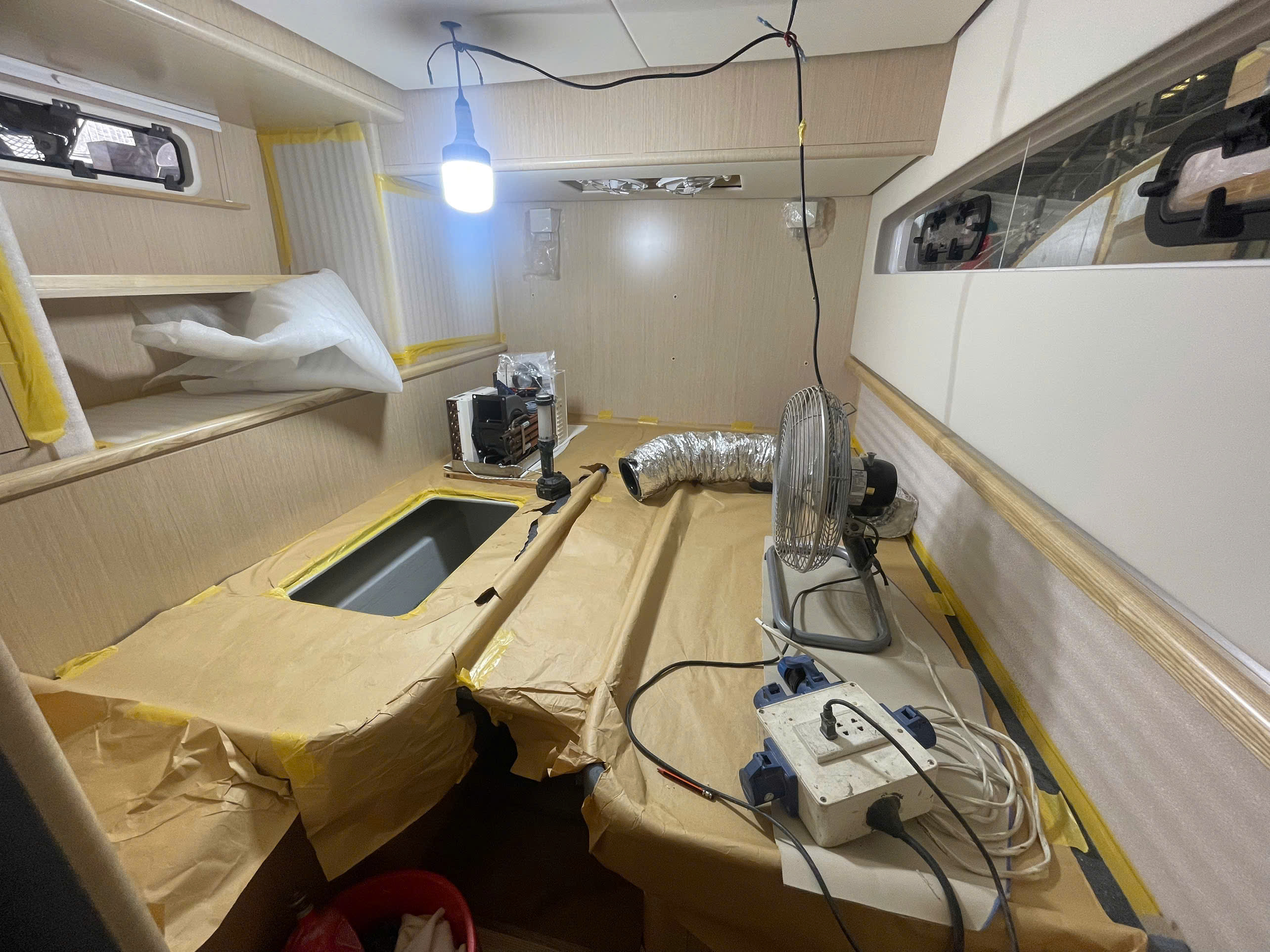

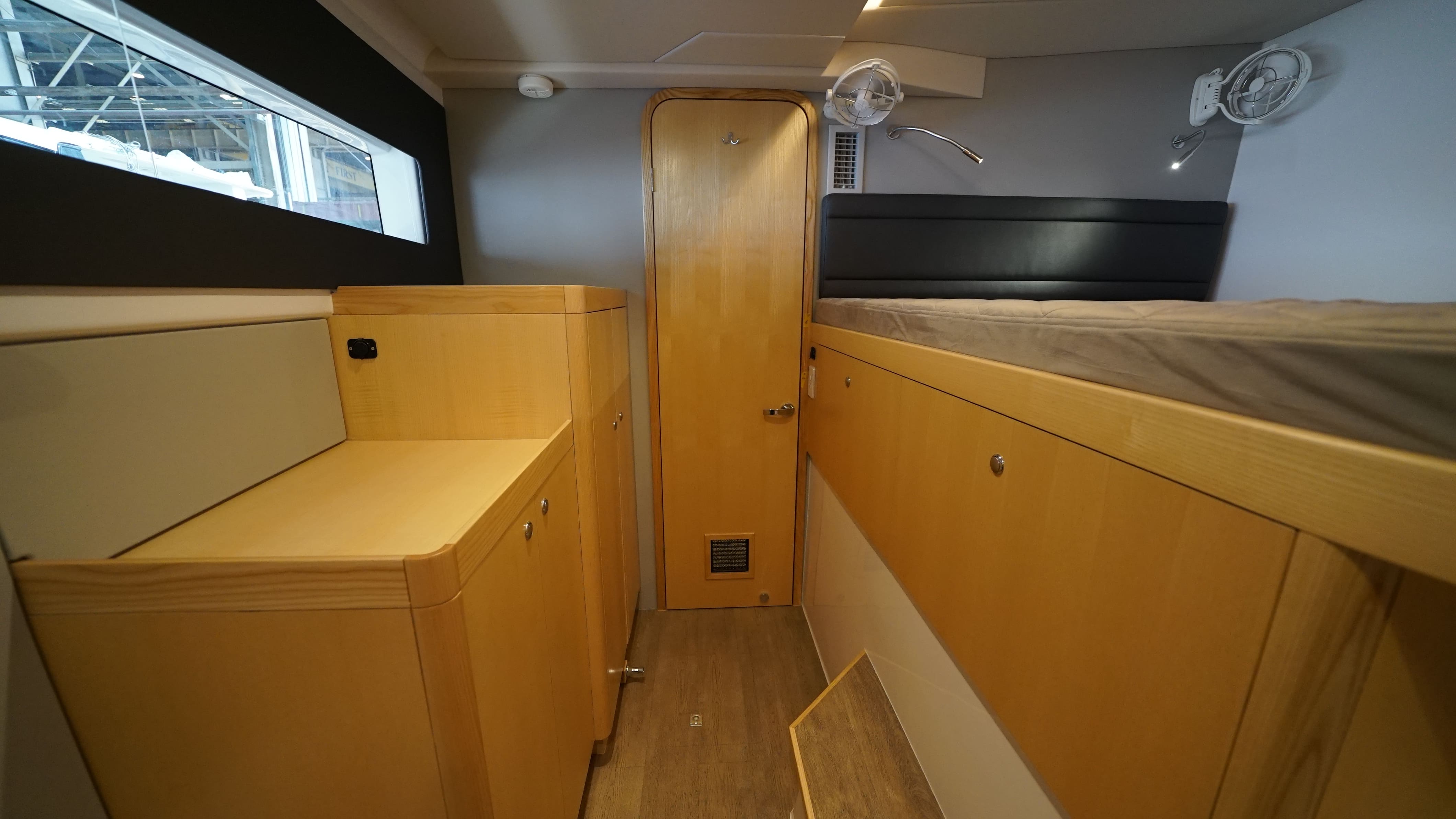

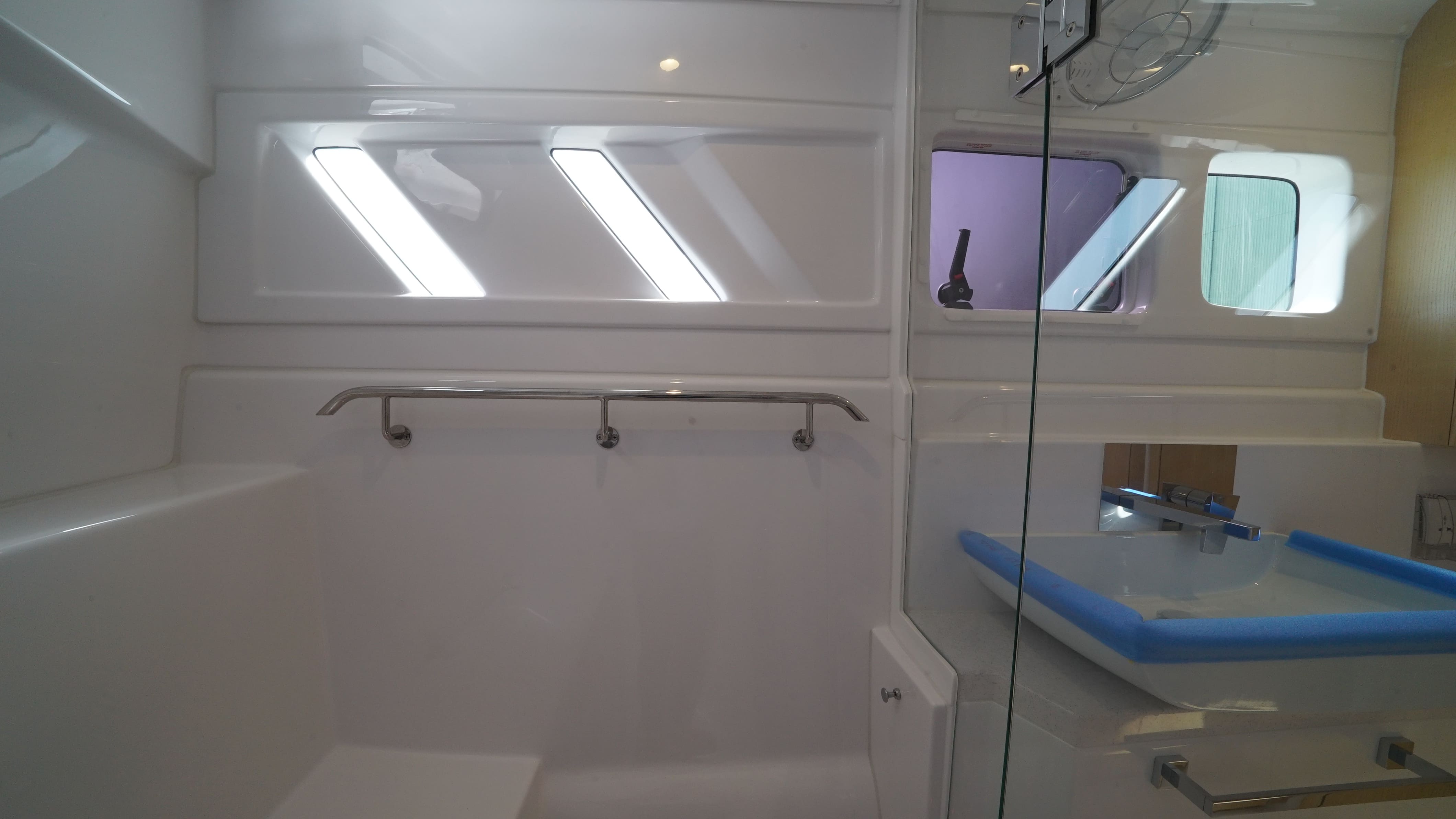

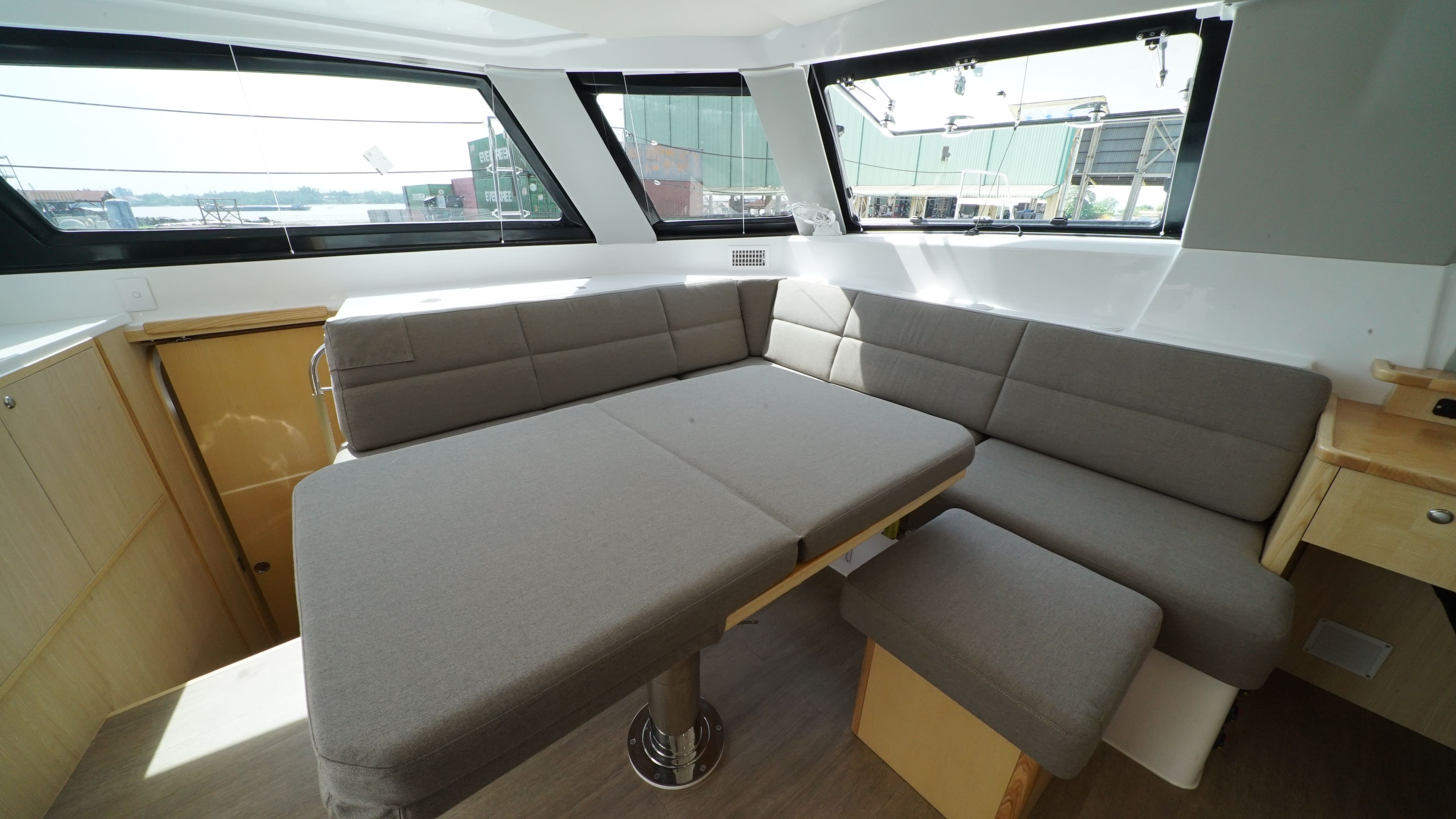

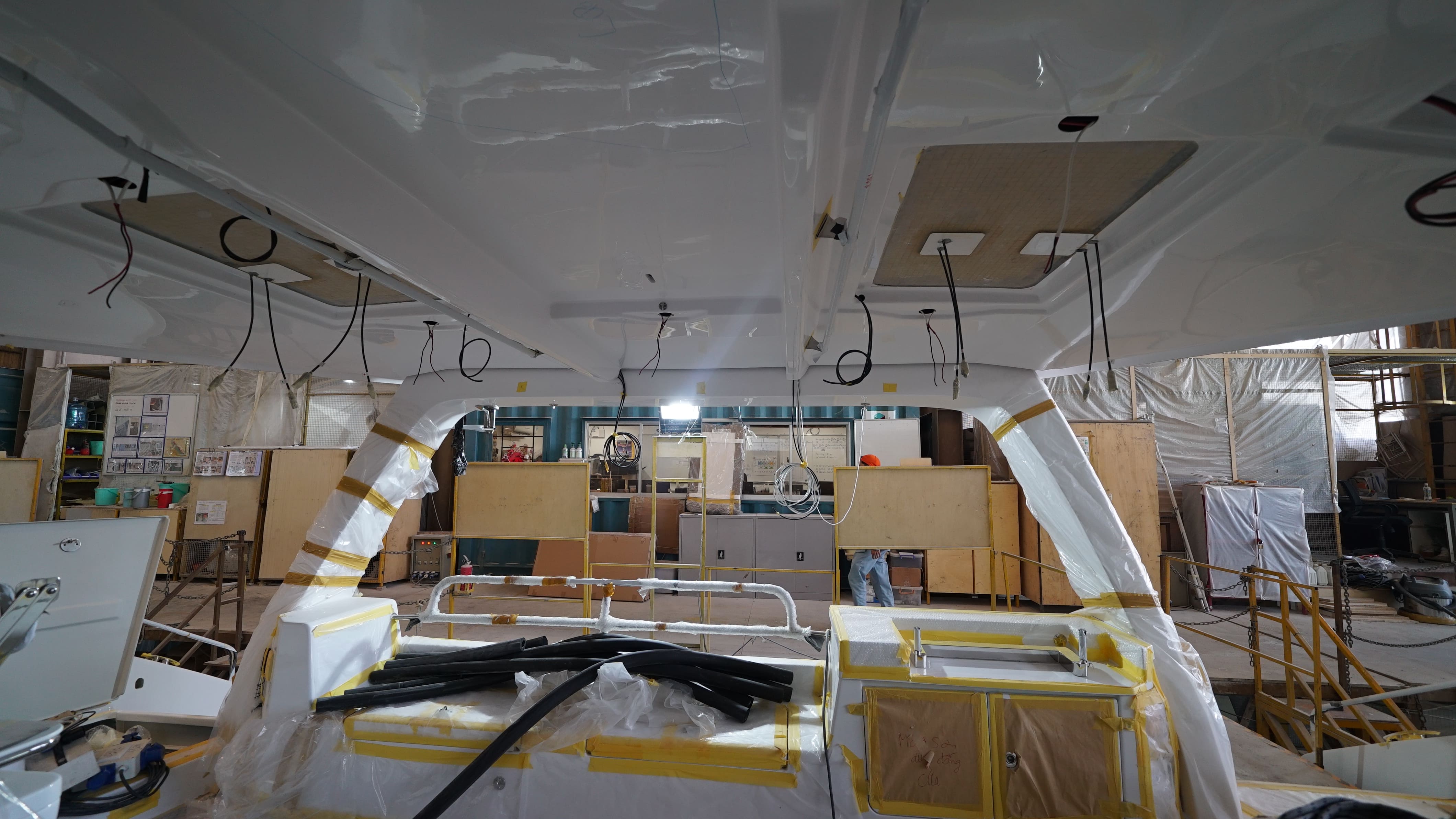

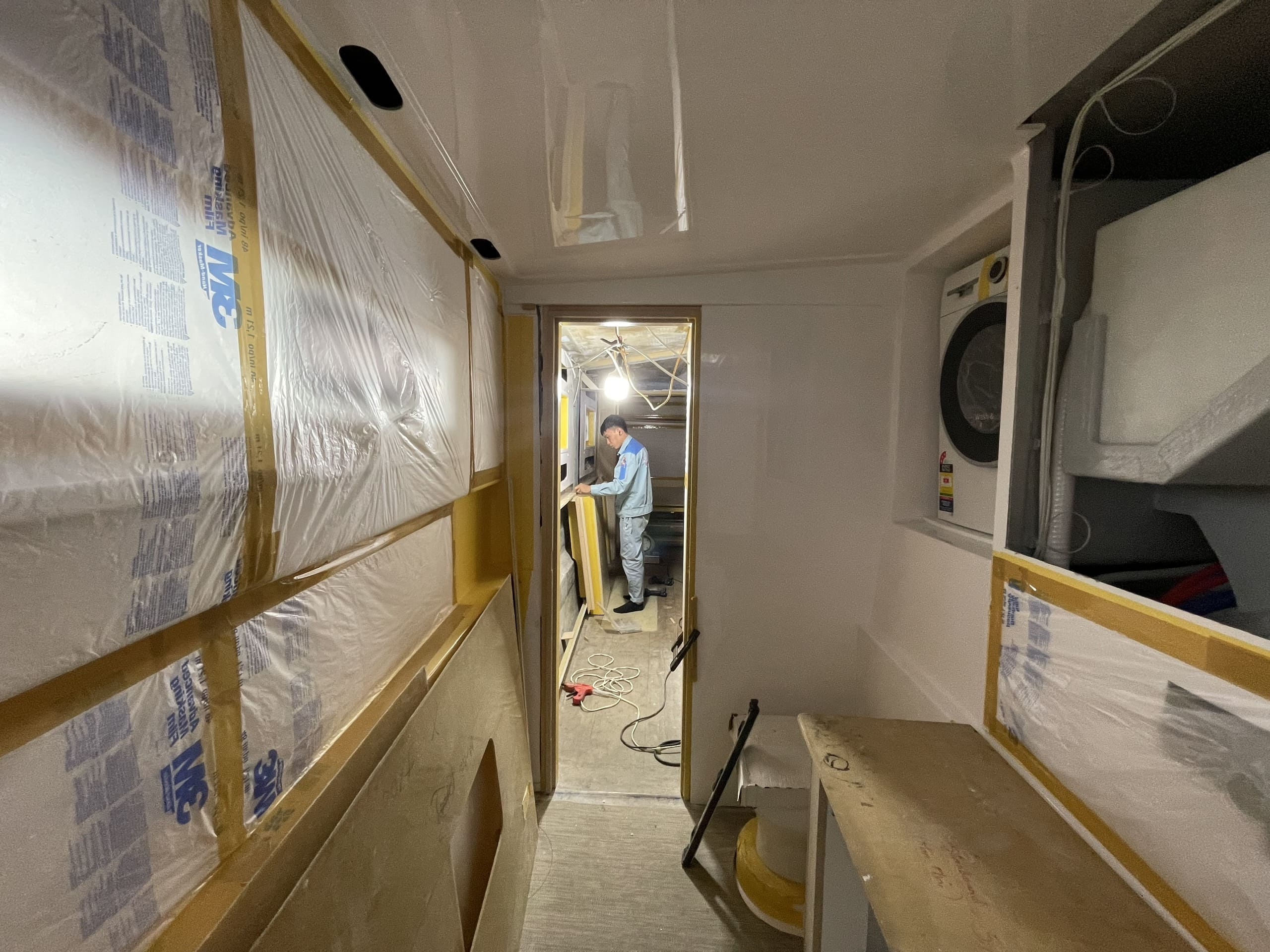

Your boat is progressing well in the Fit out stage.

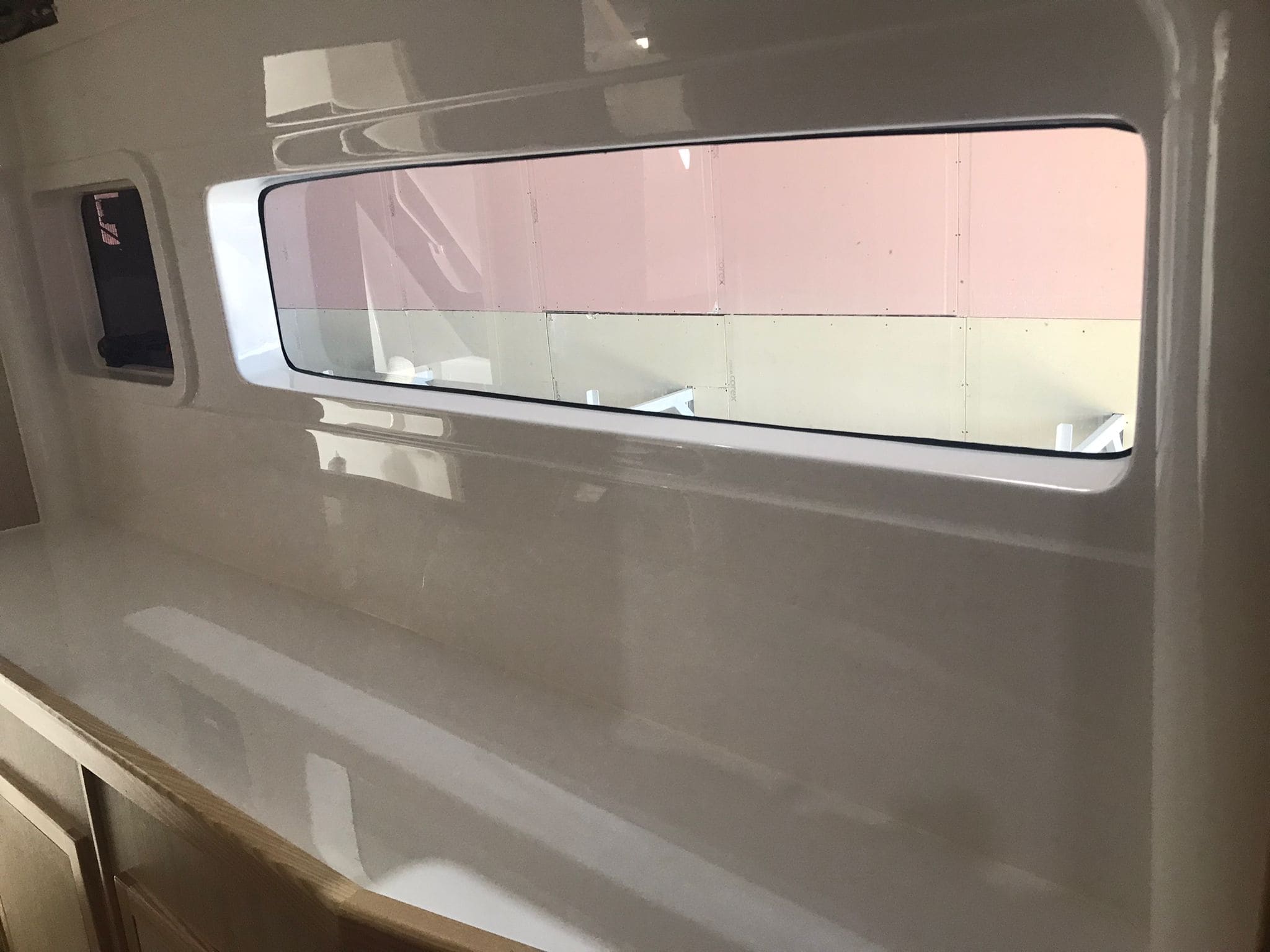

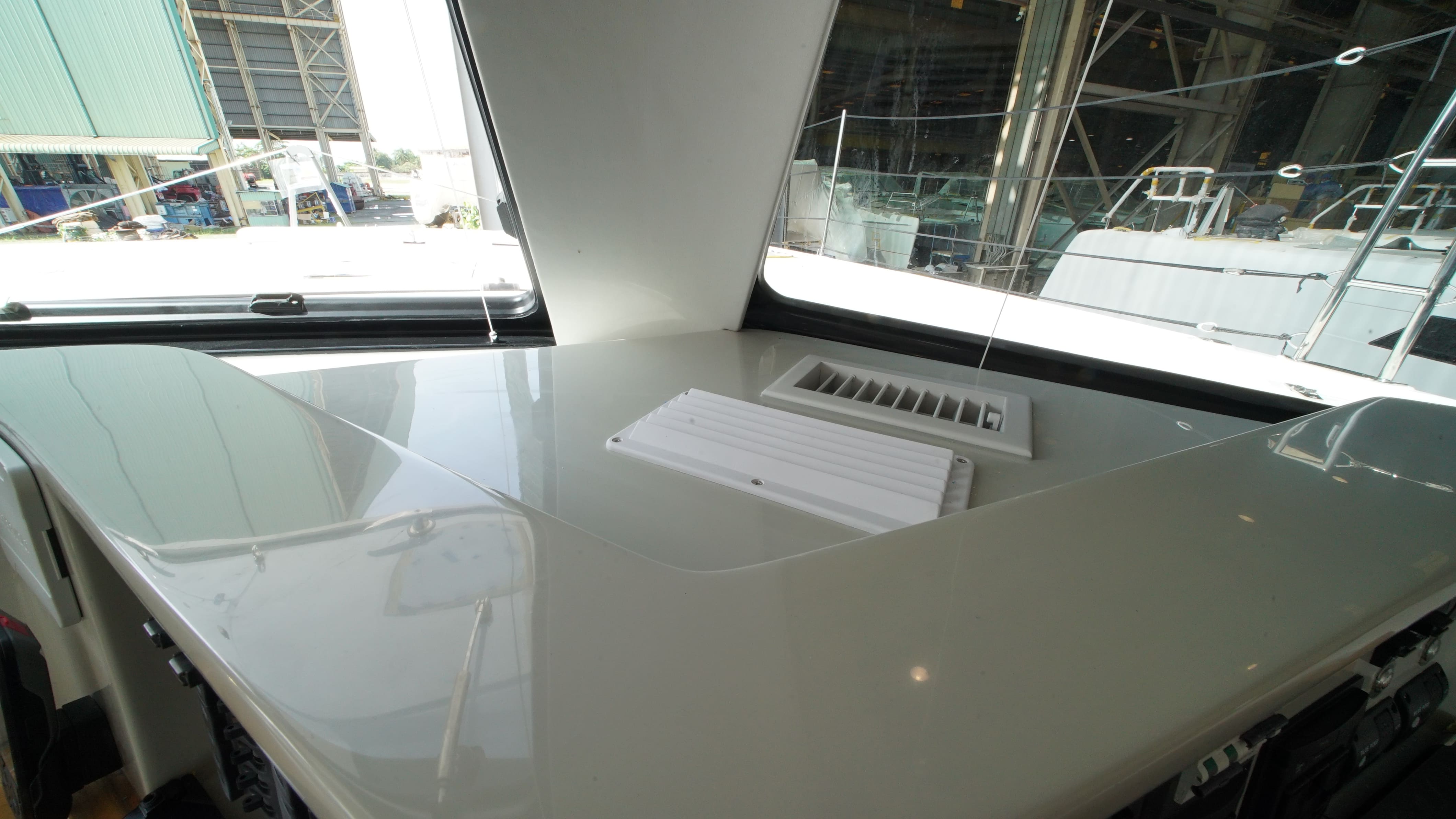

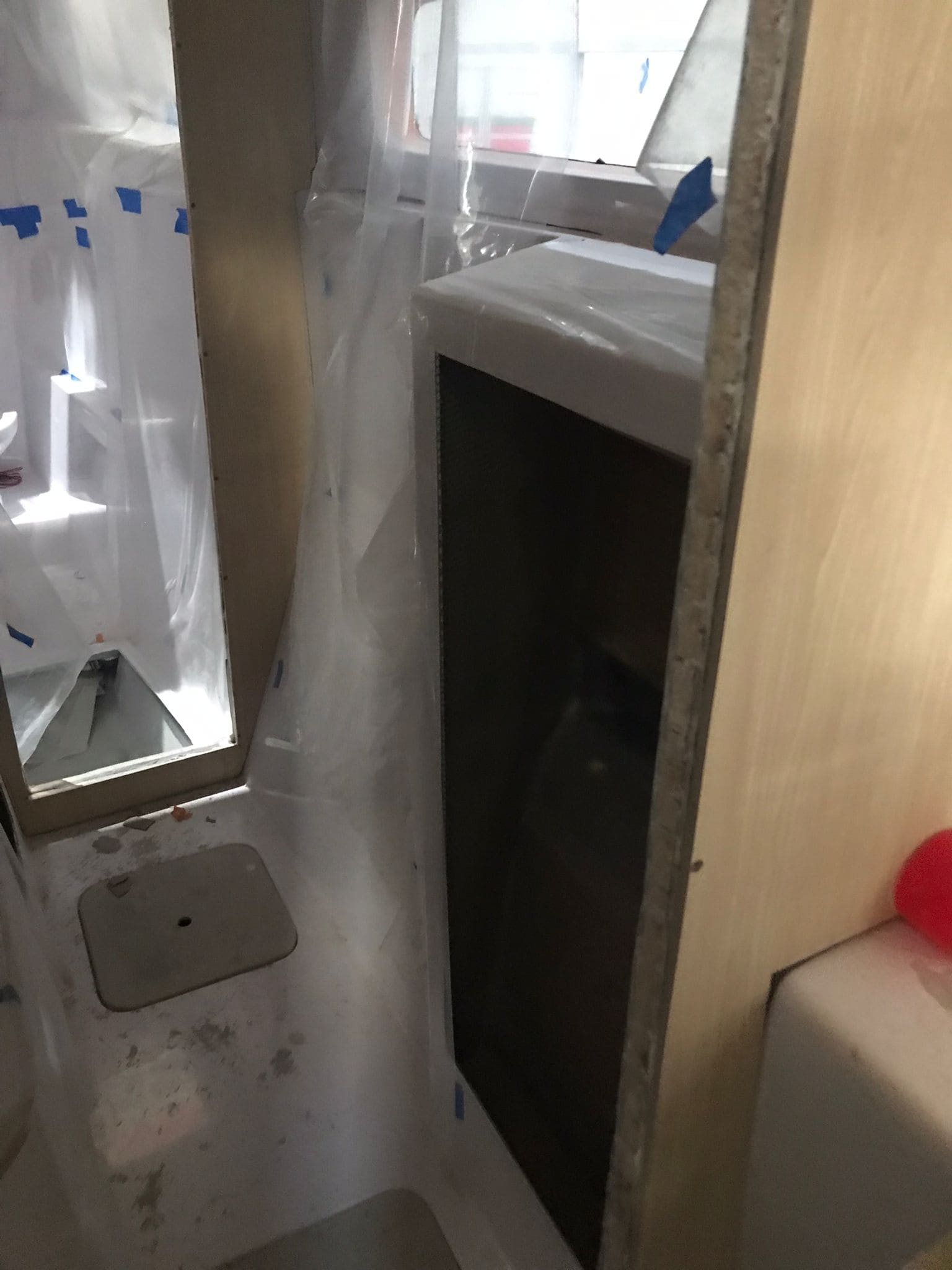

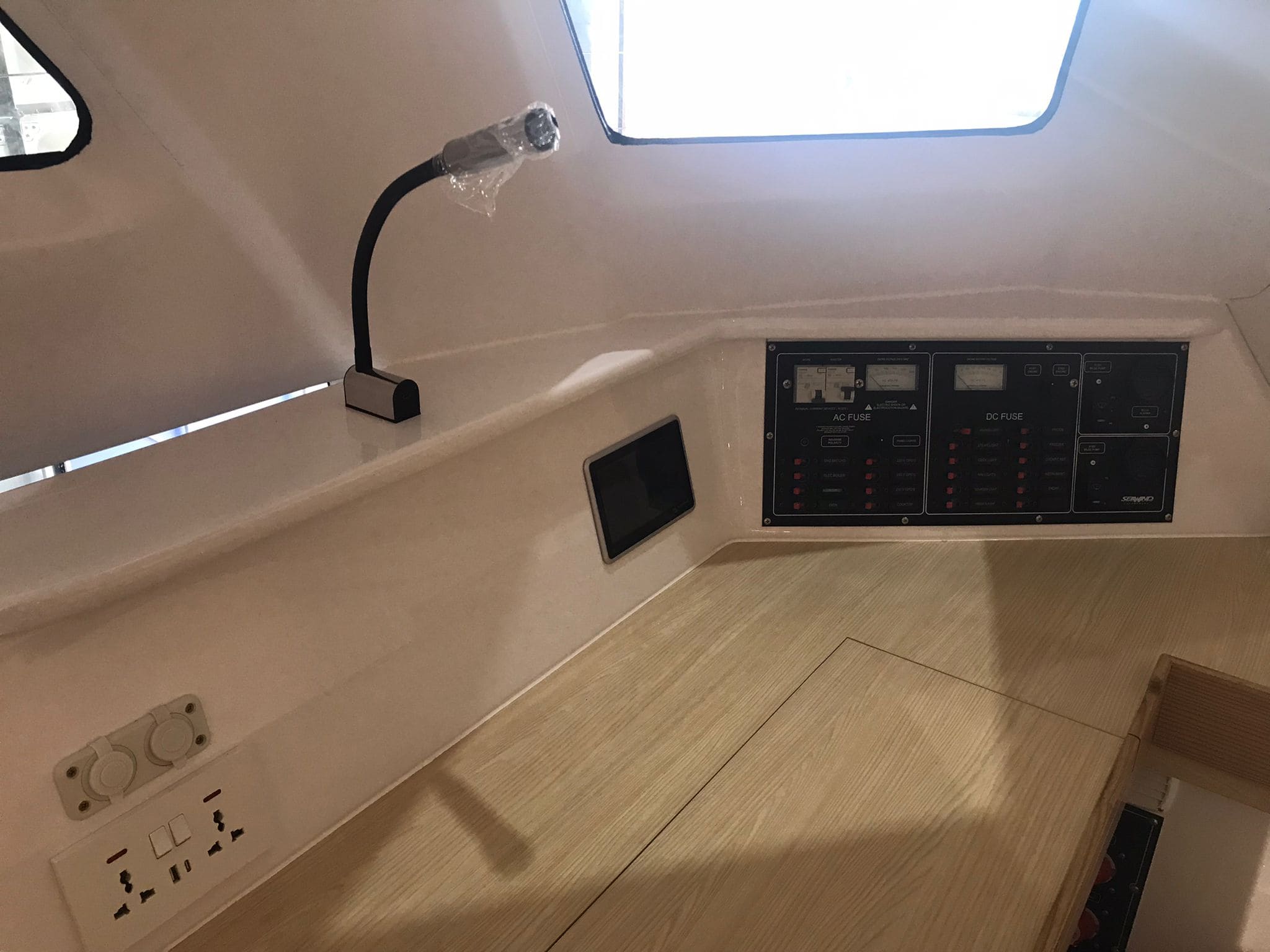

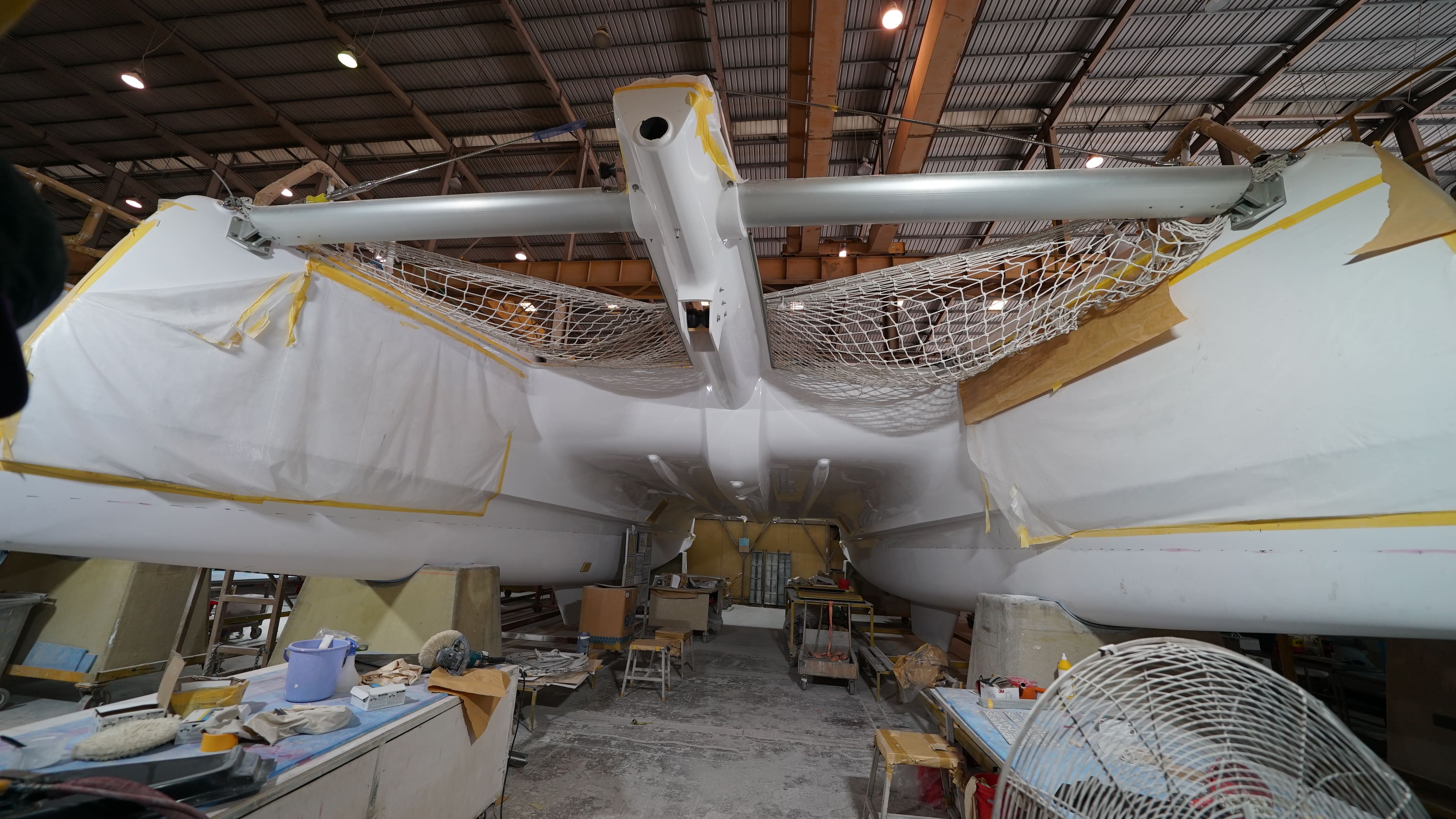

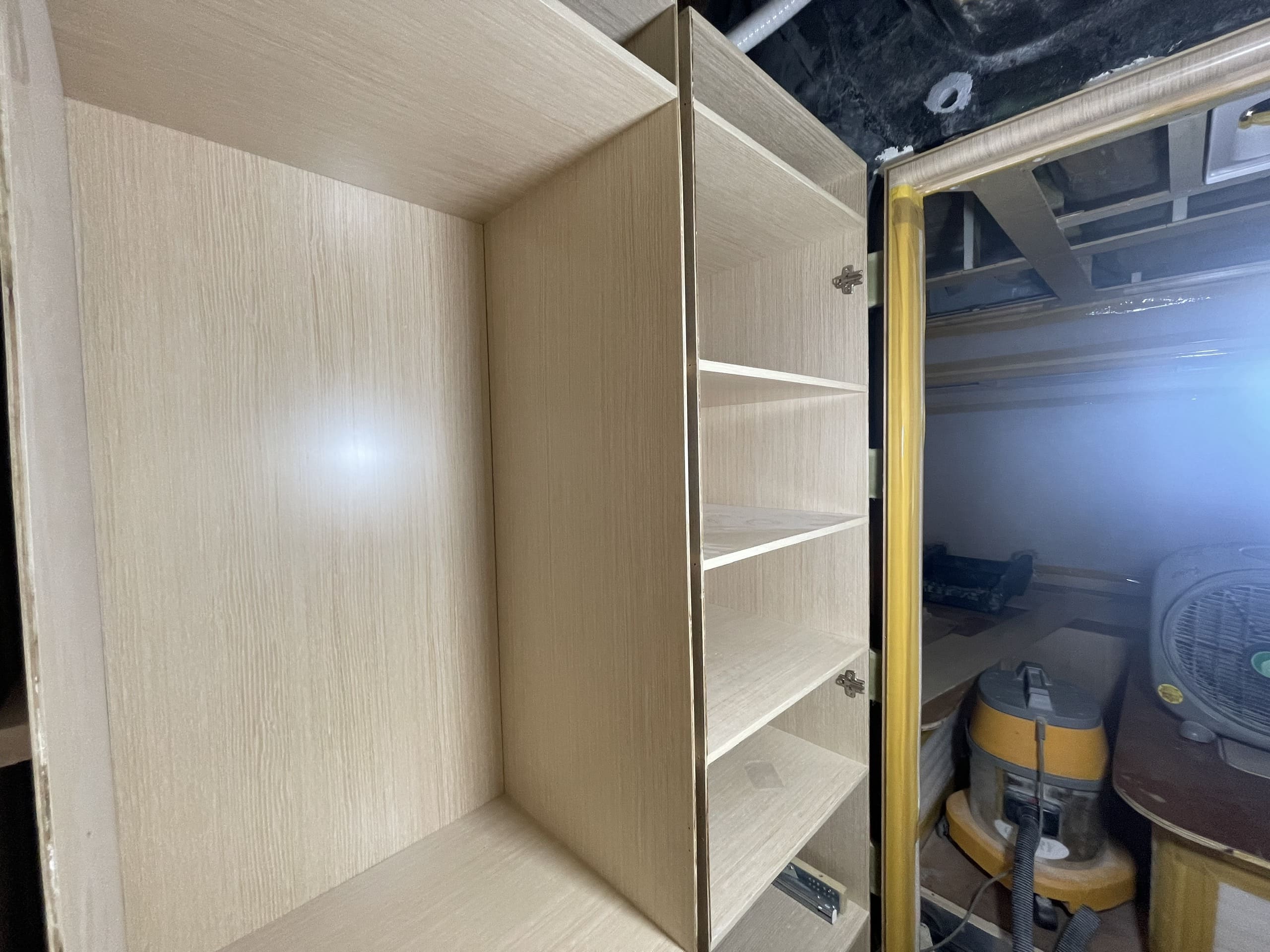

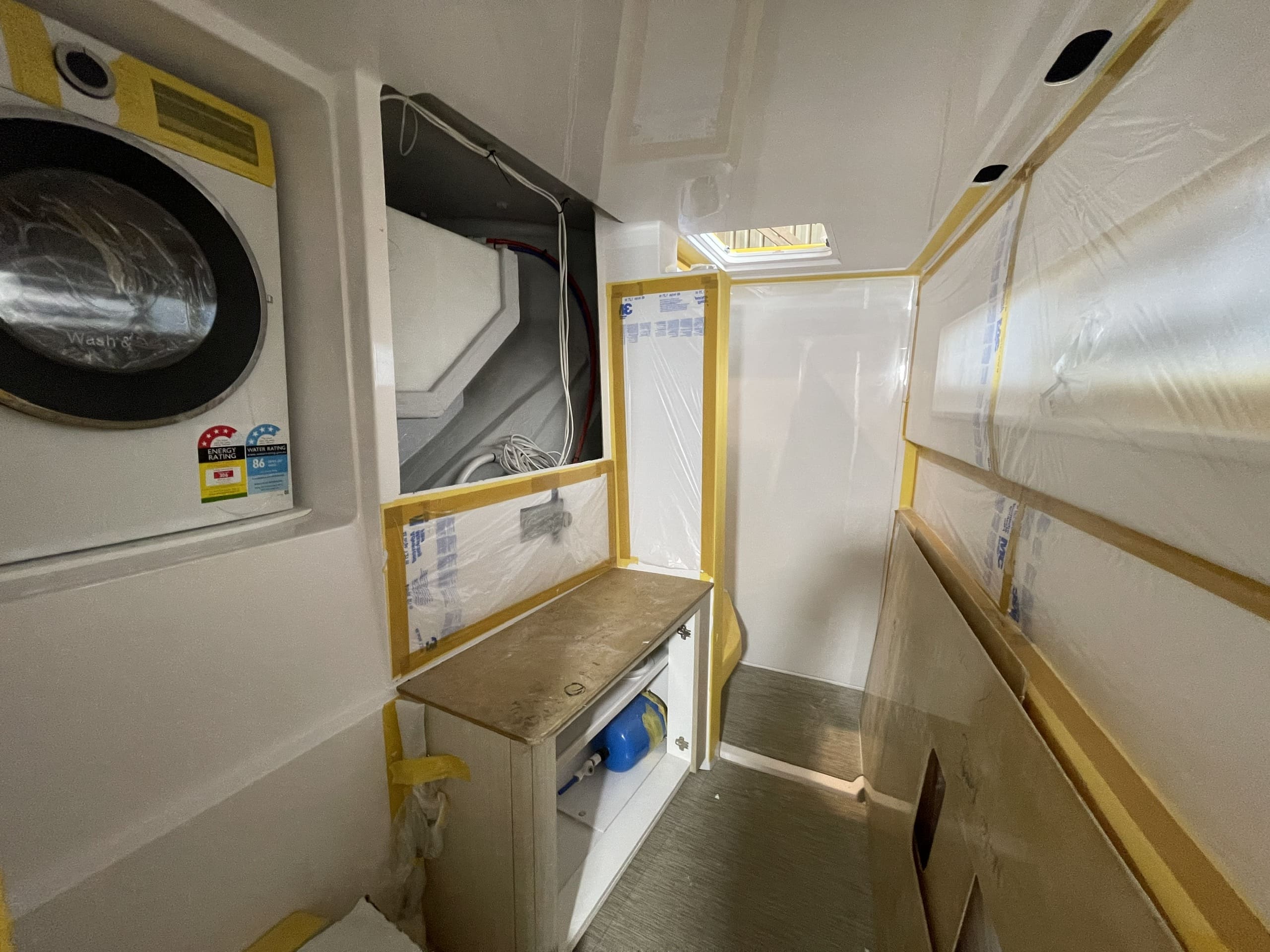

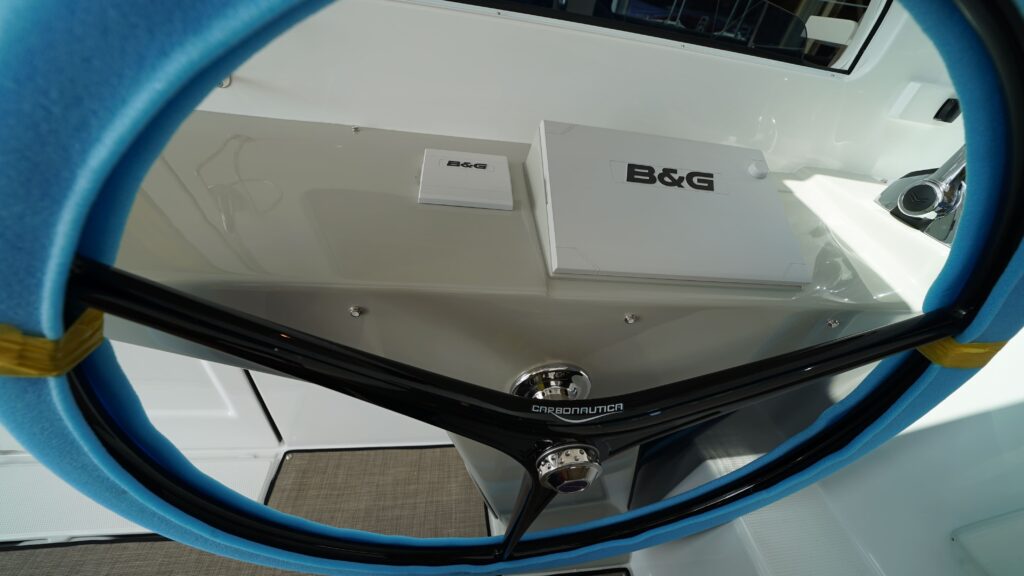

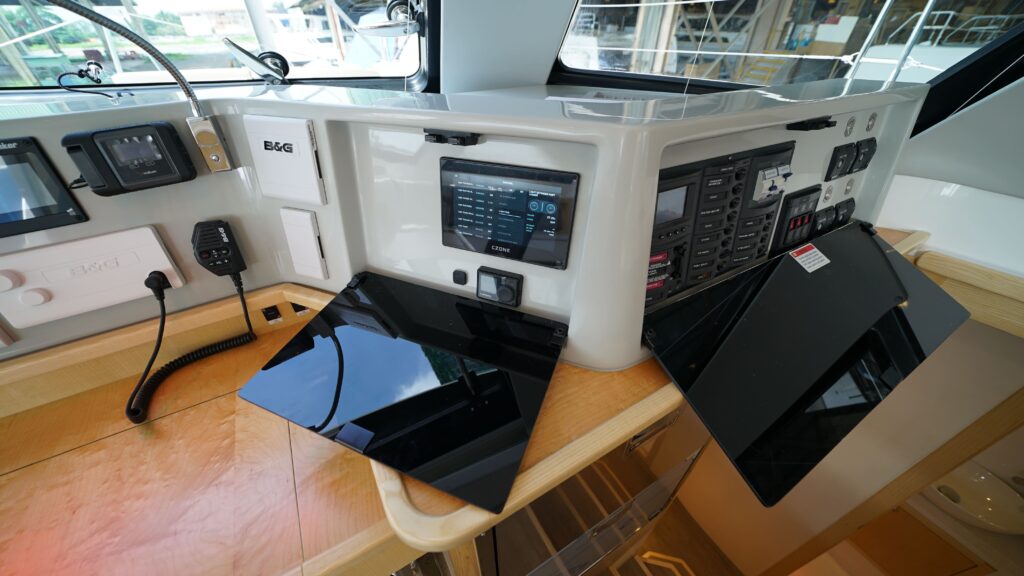

We recently completed the installation of stanchion, longeron, anchor box, engines, windows, and hatches.

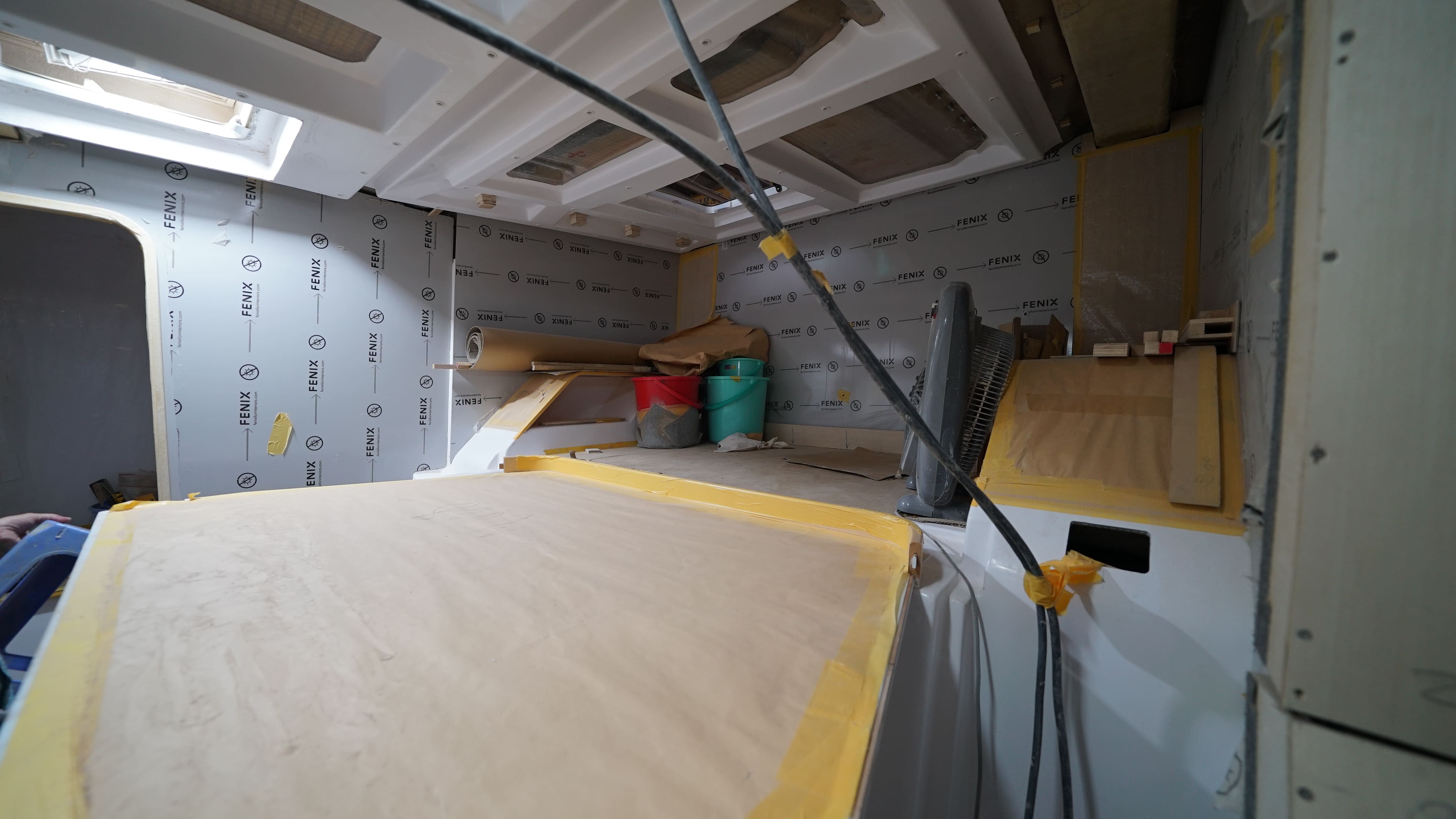

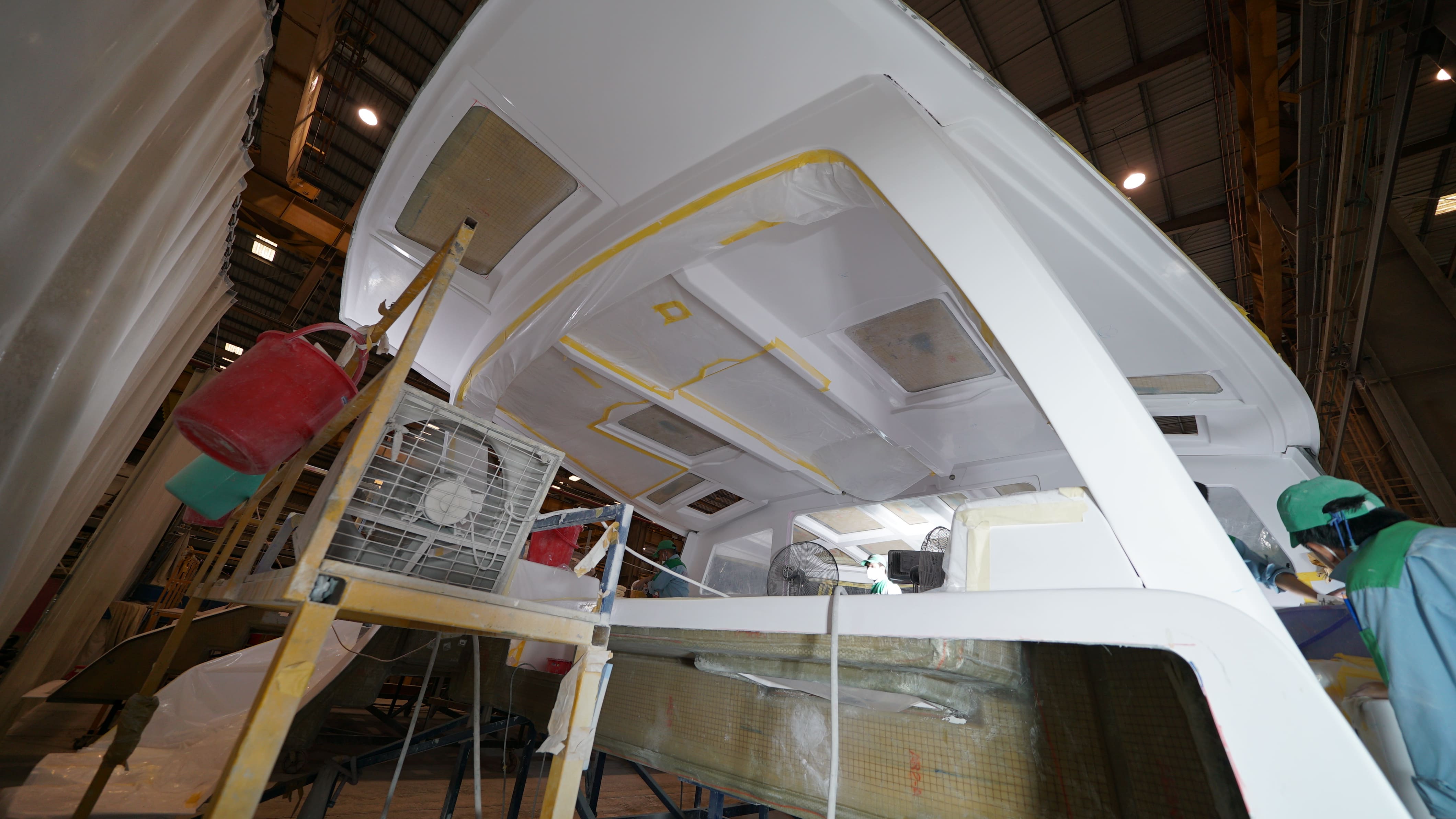

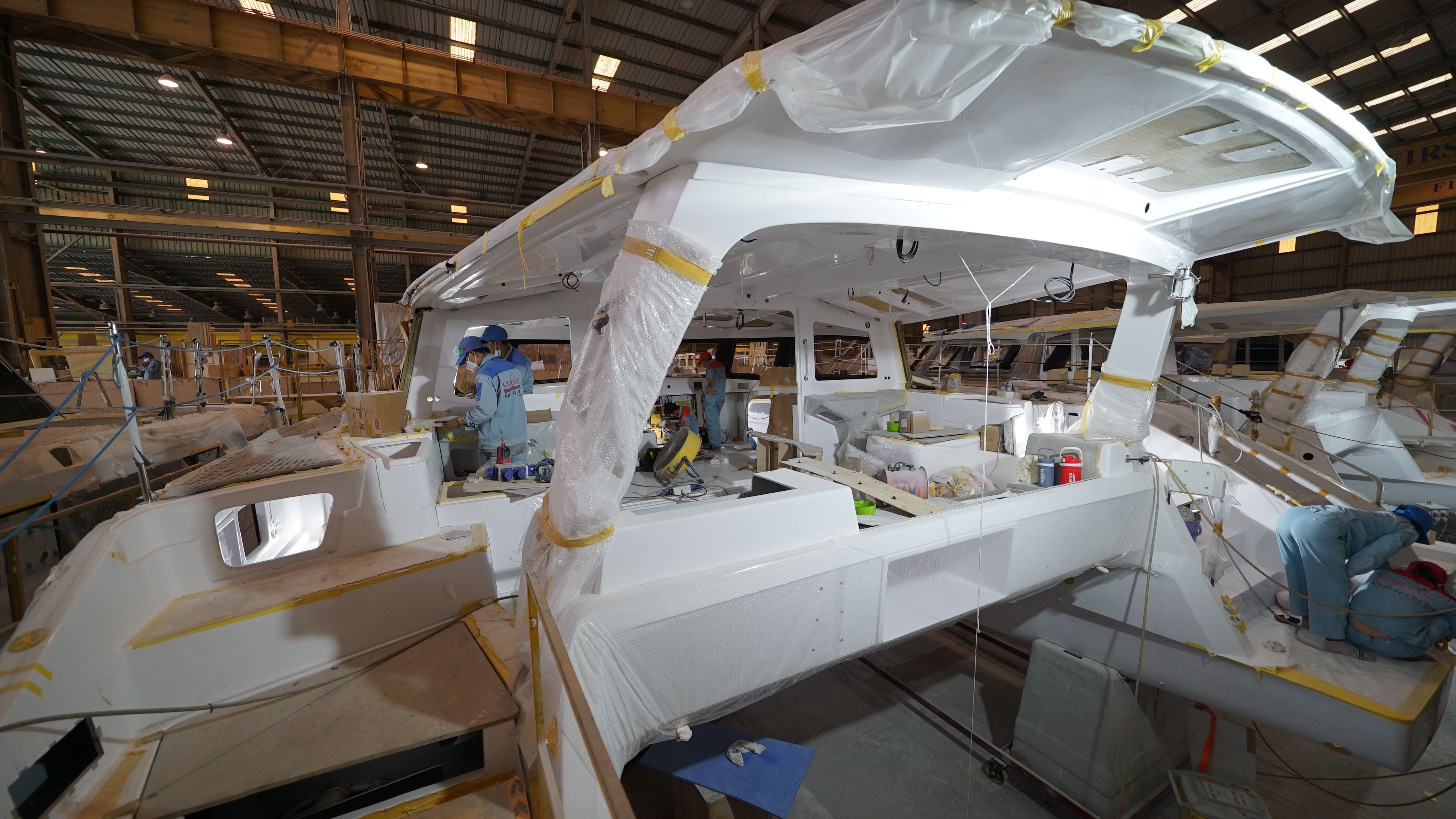

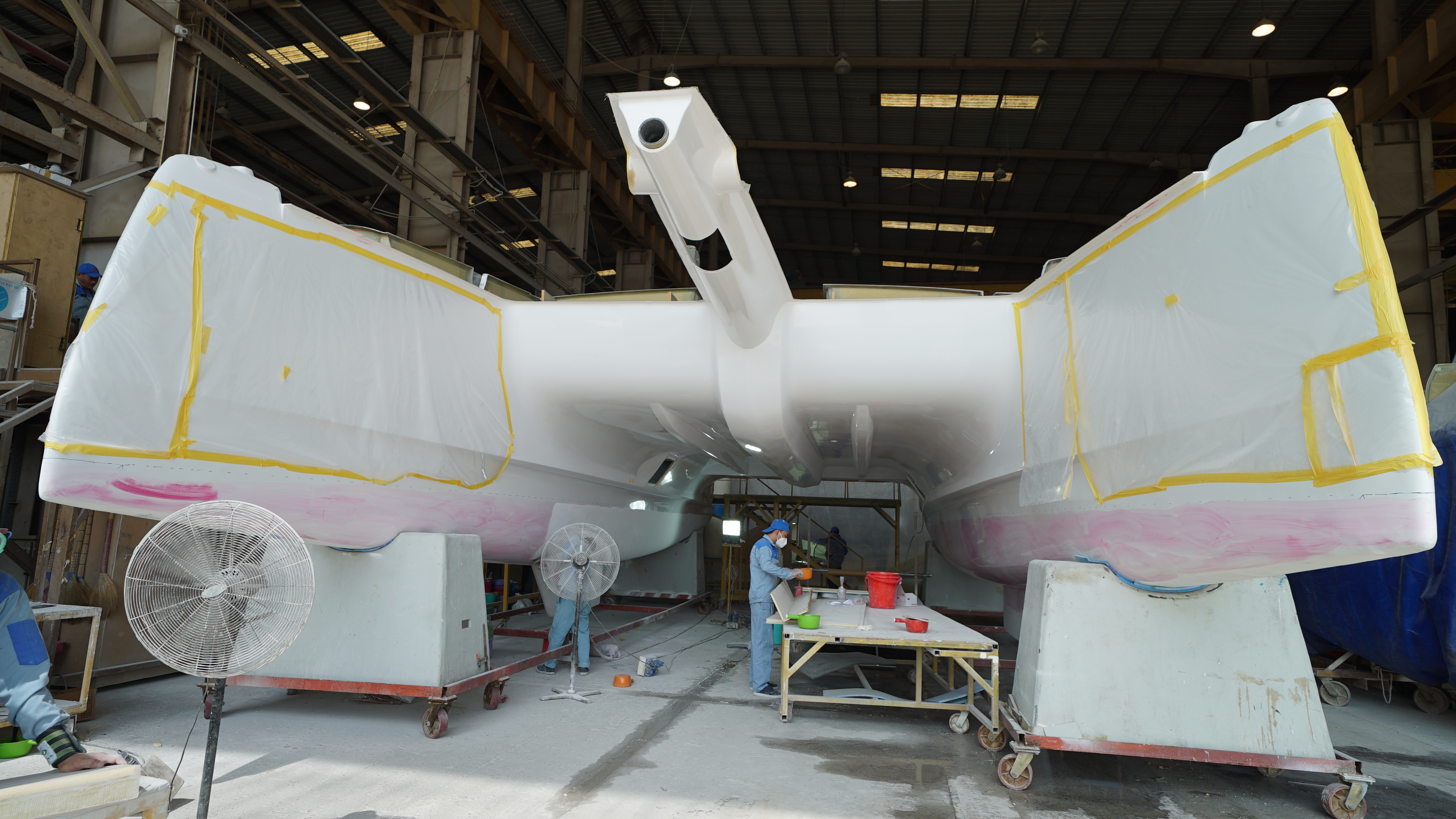

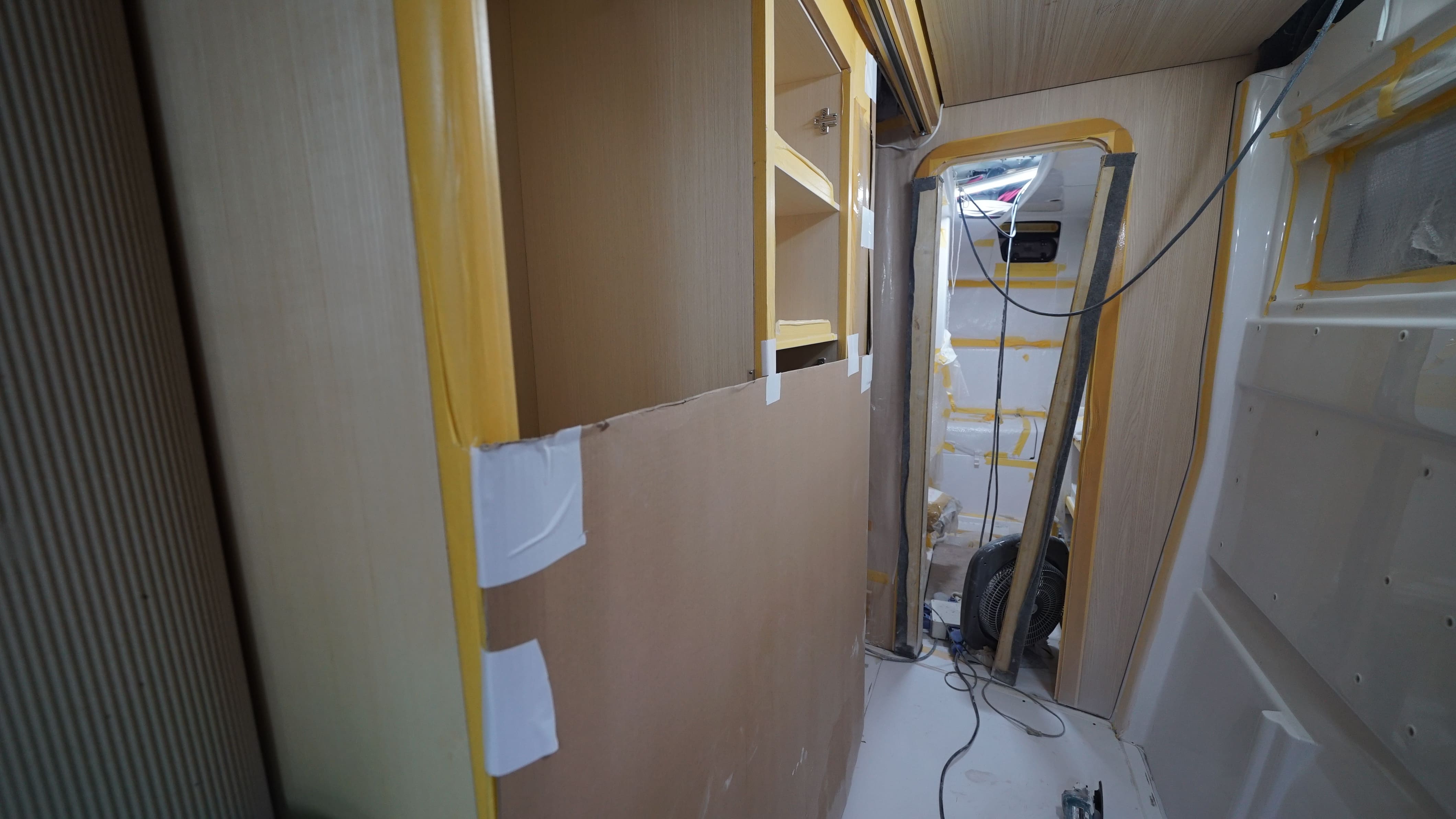

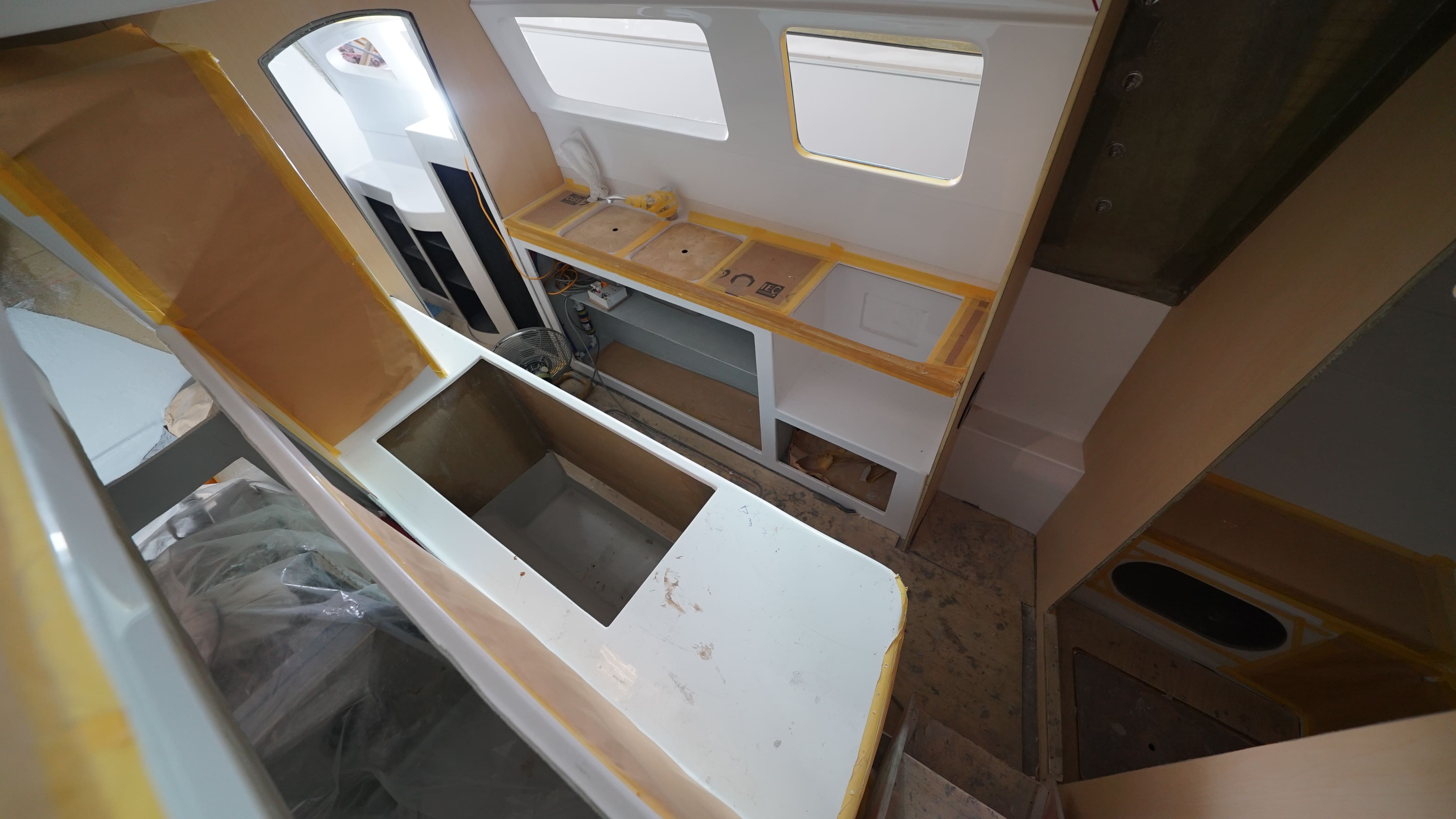

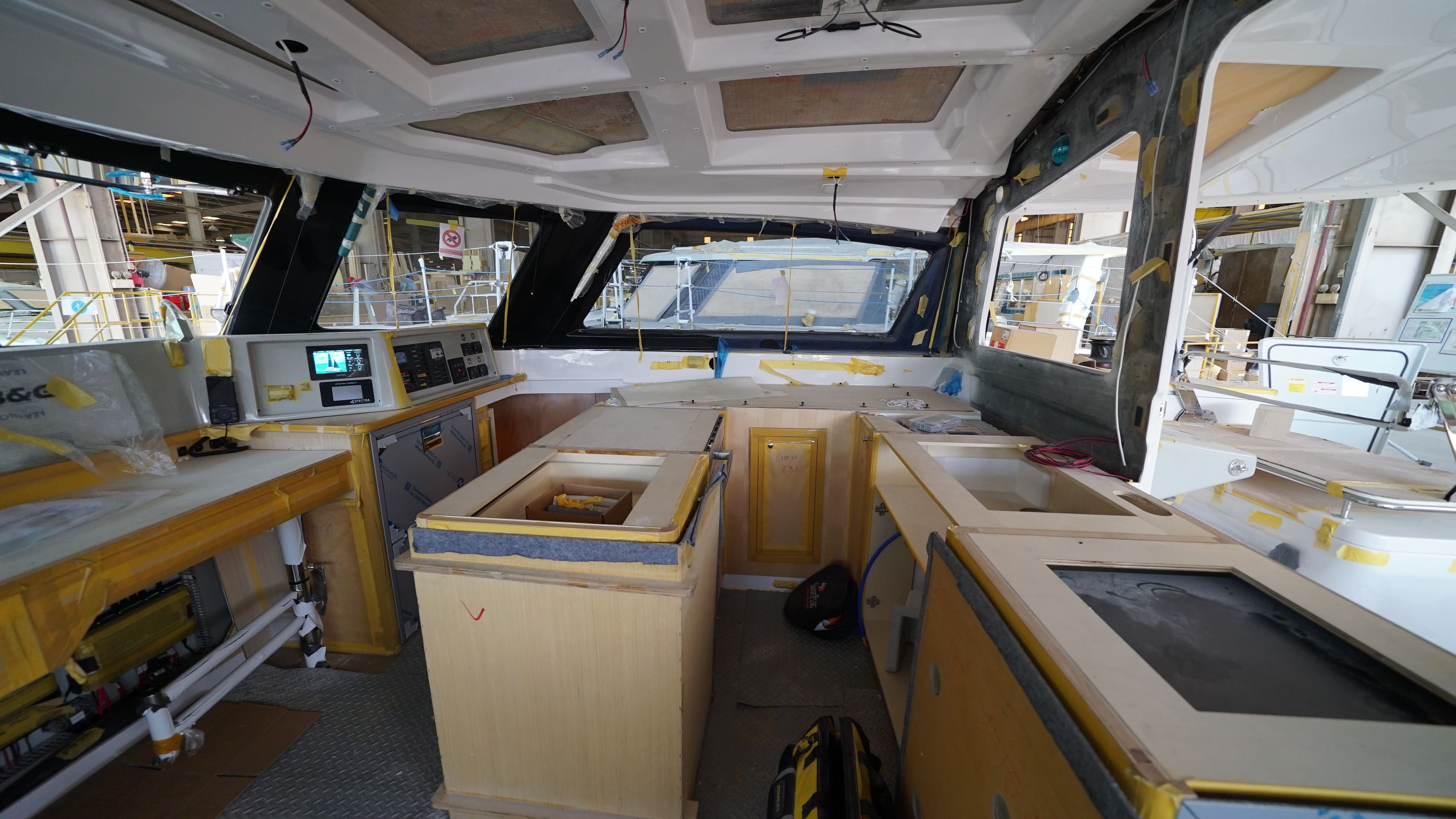

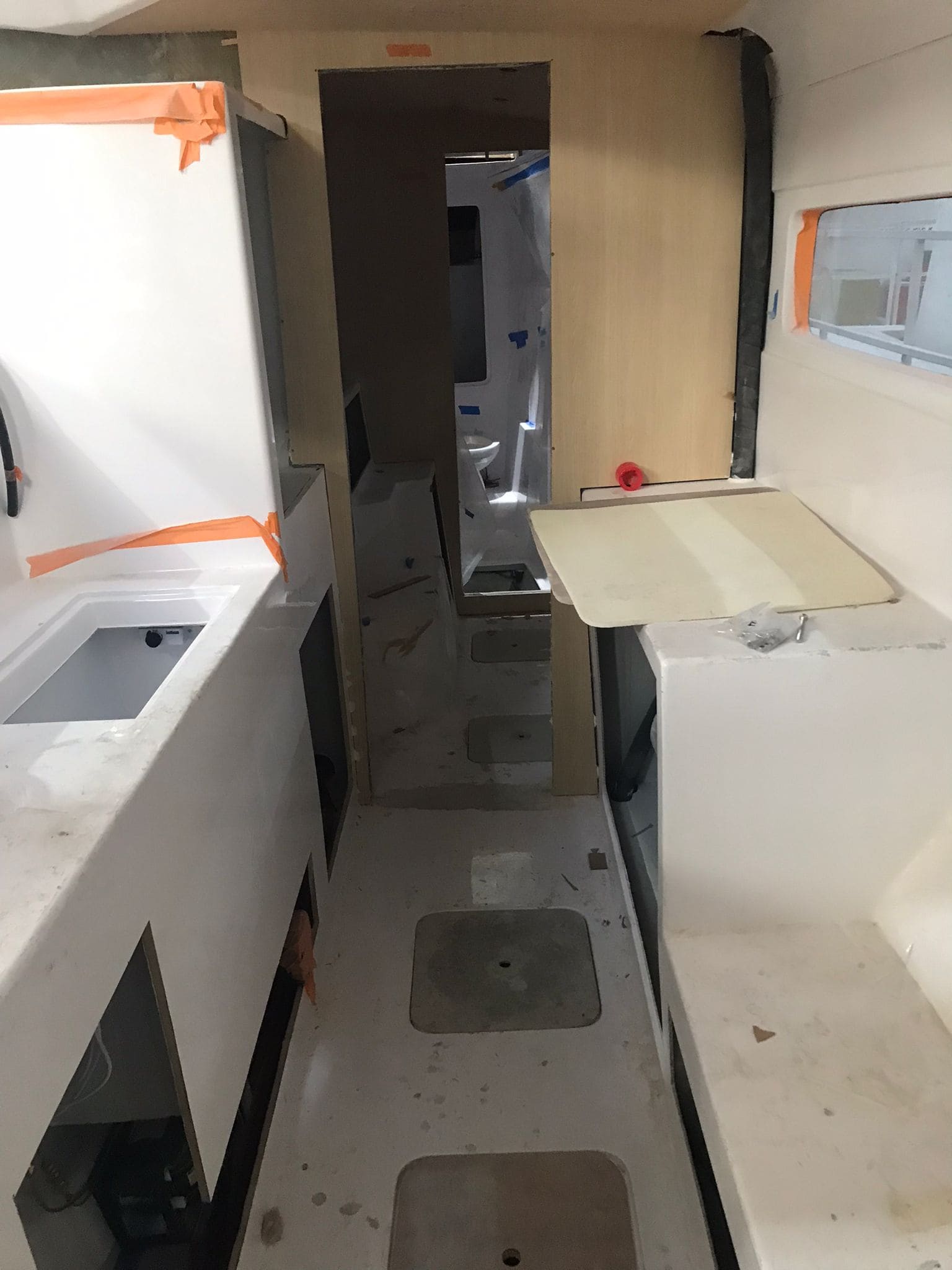

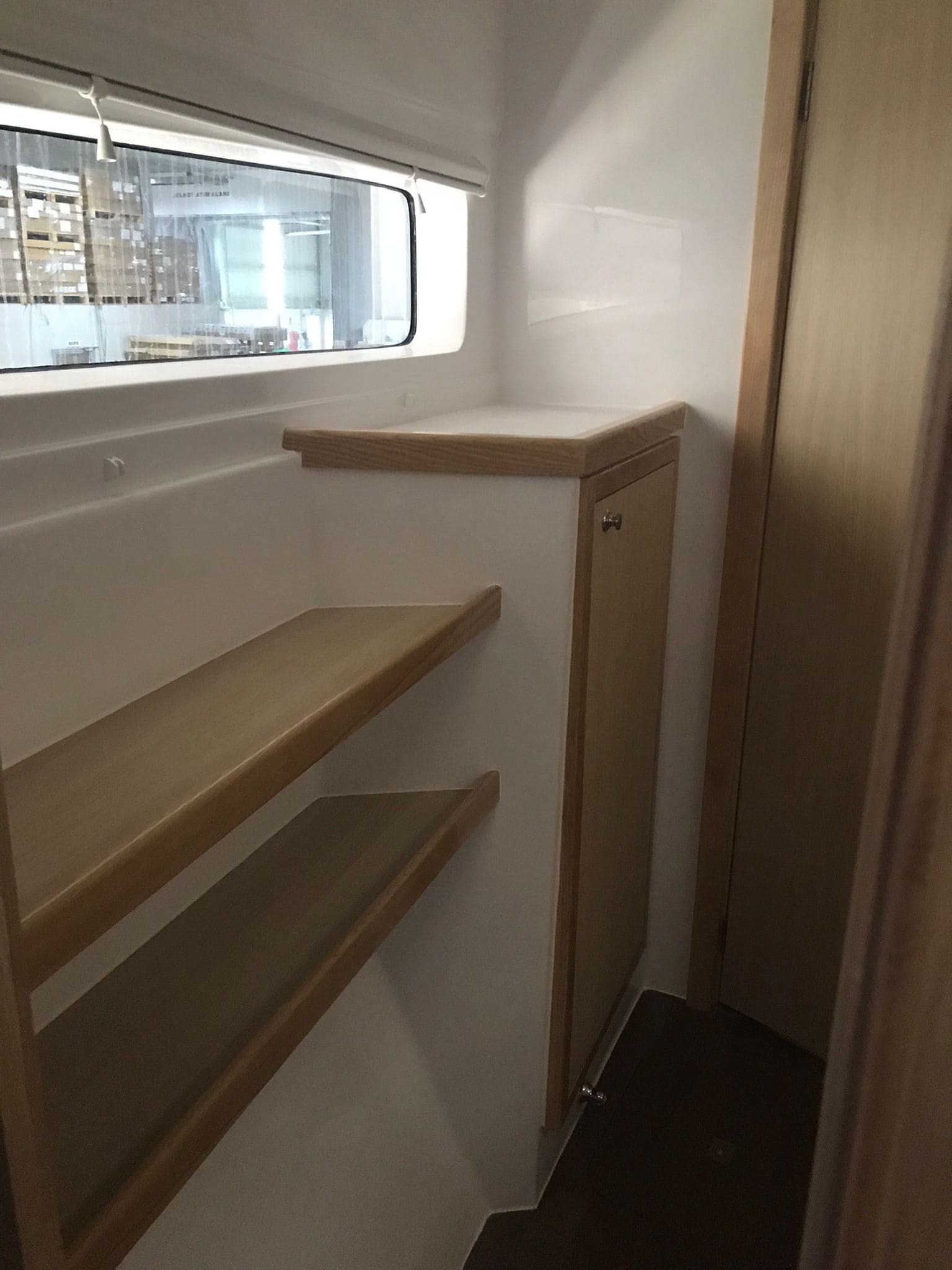

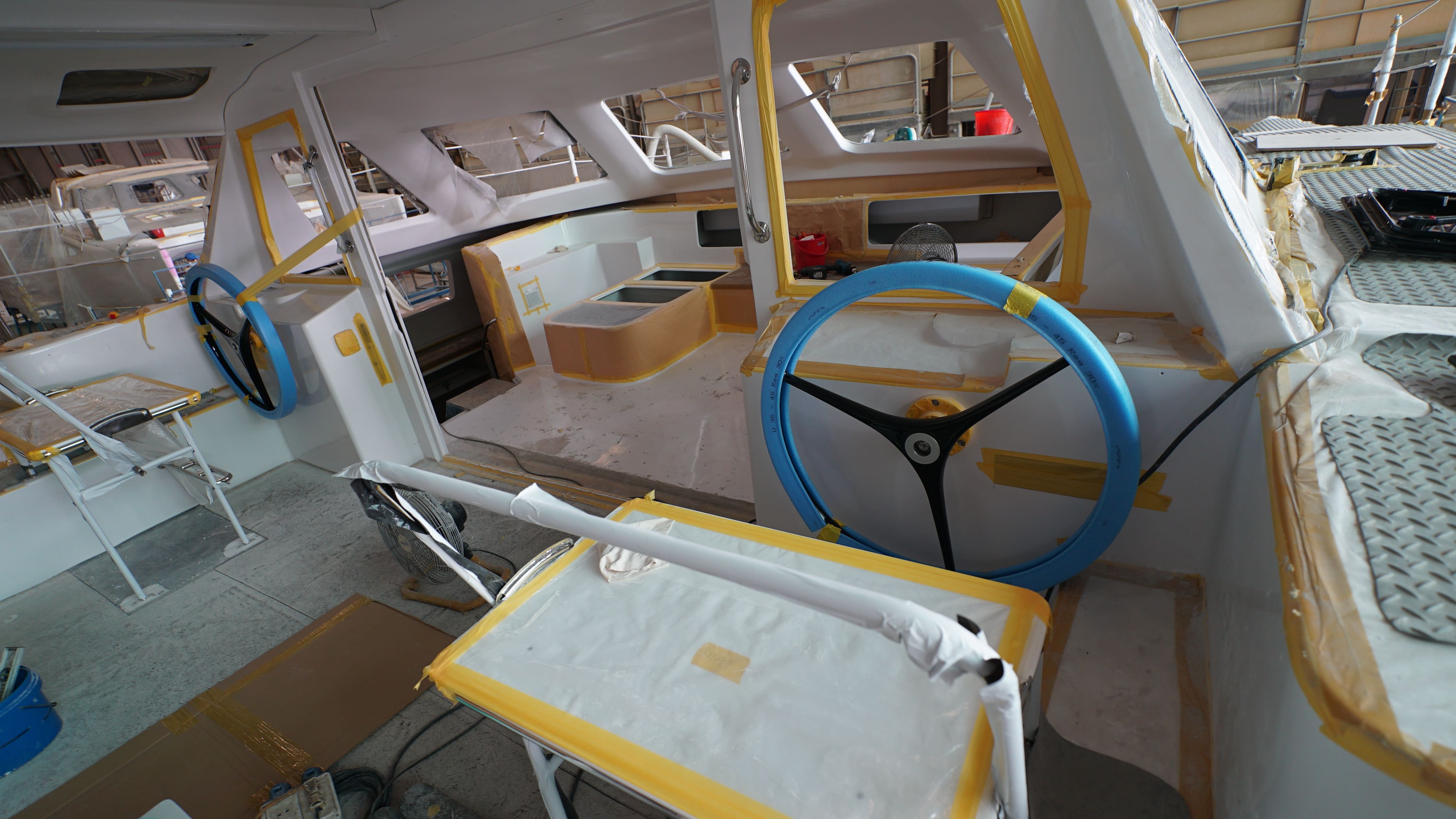

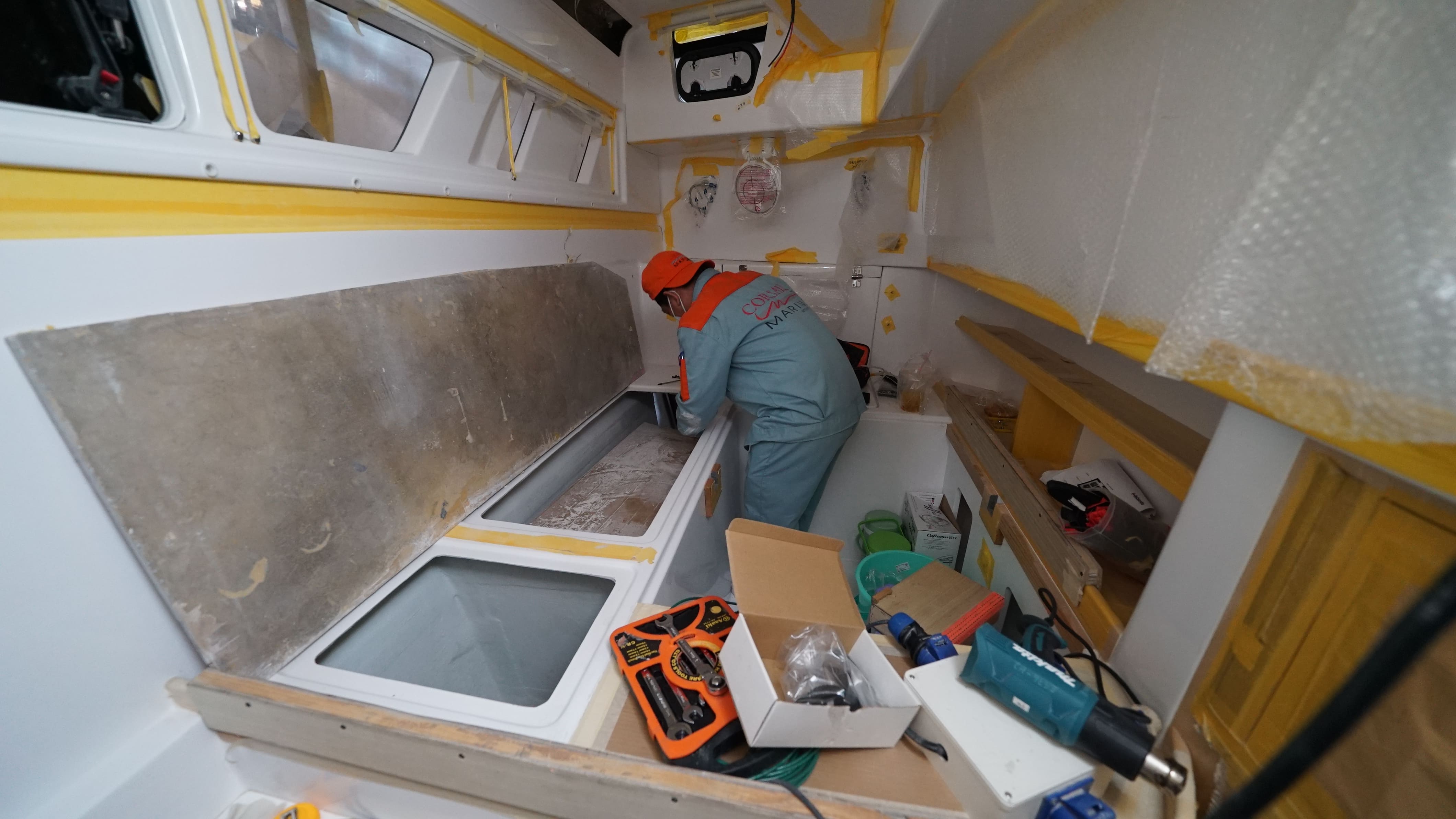

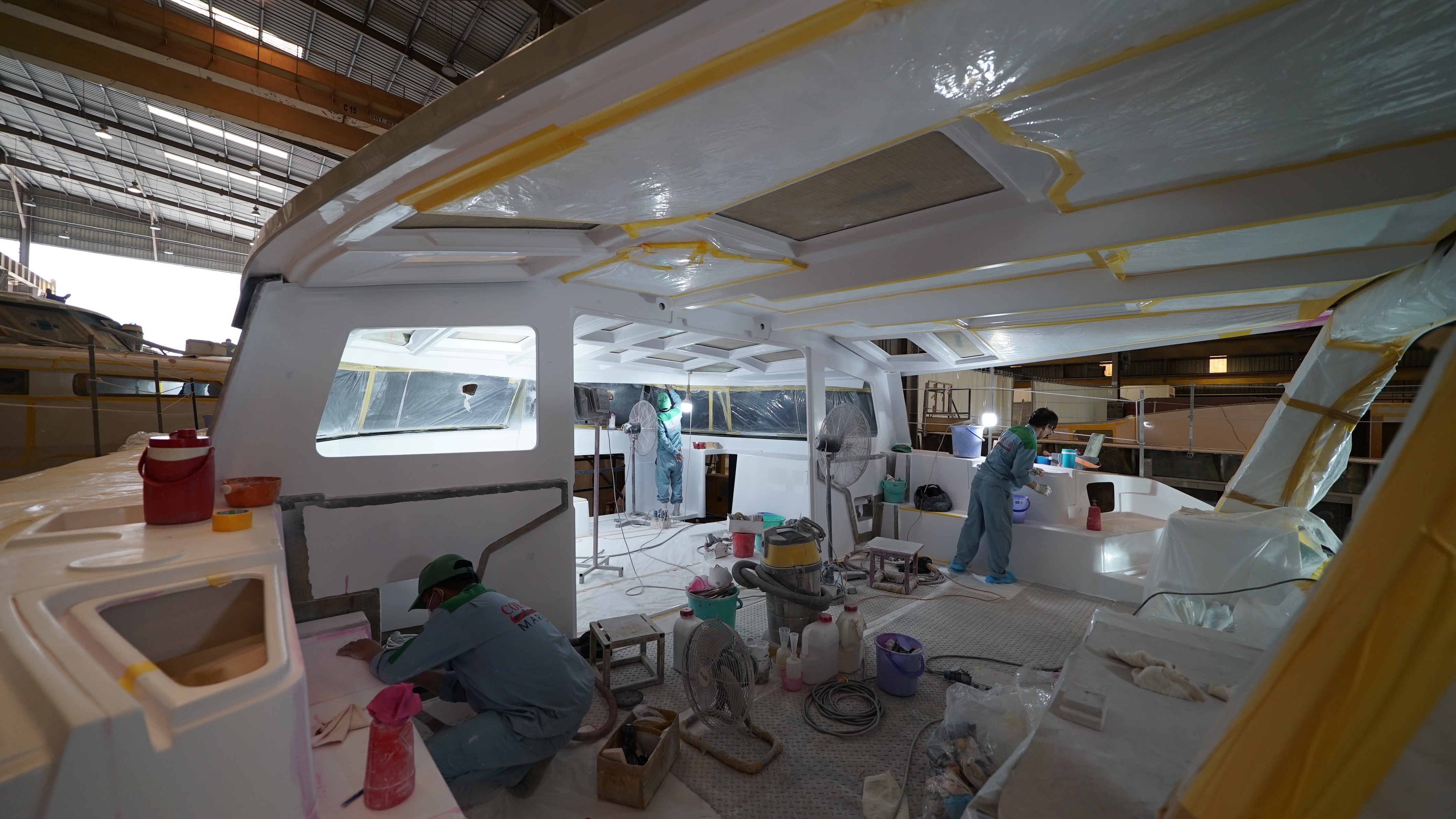

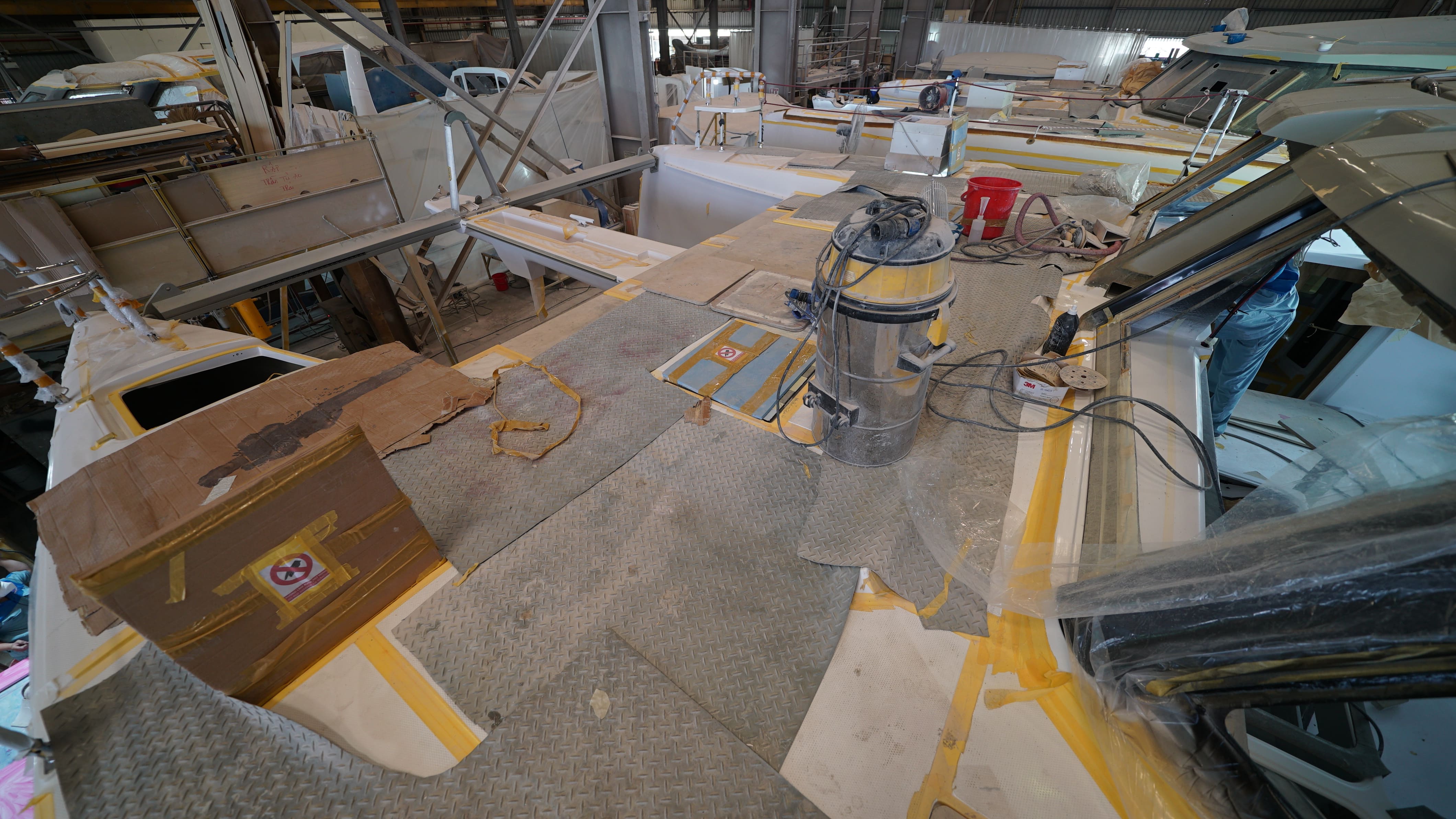

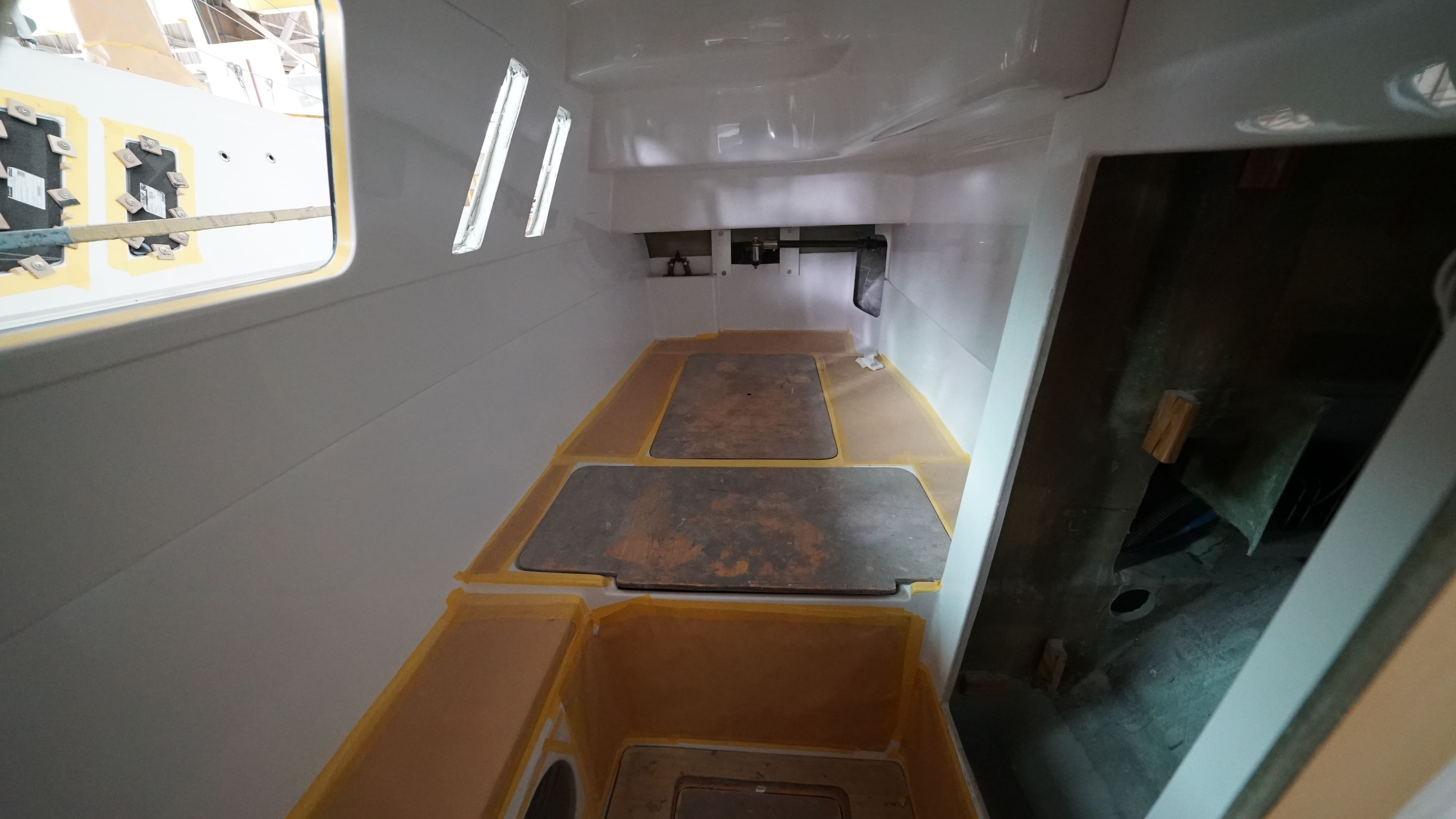

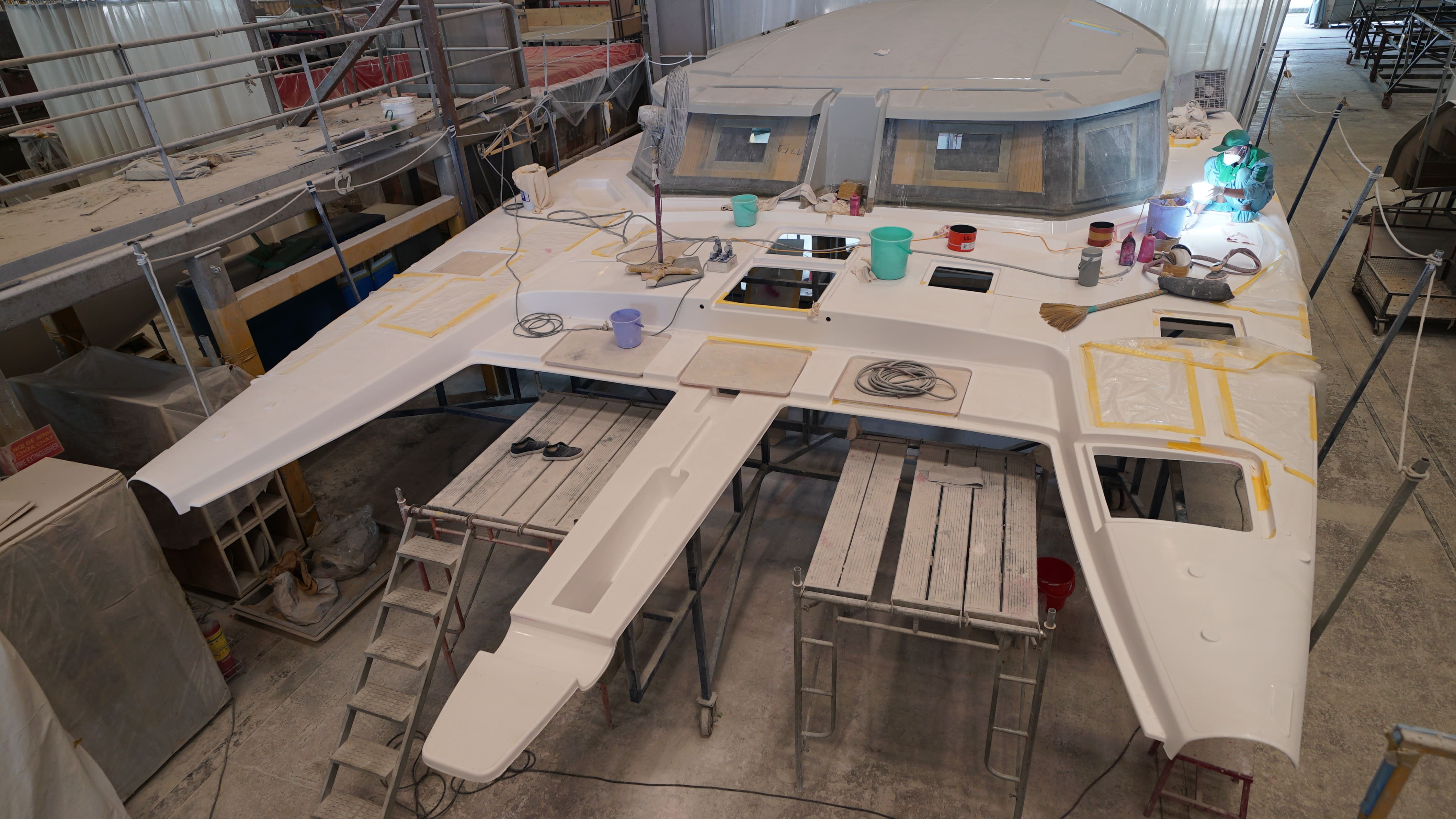

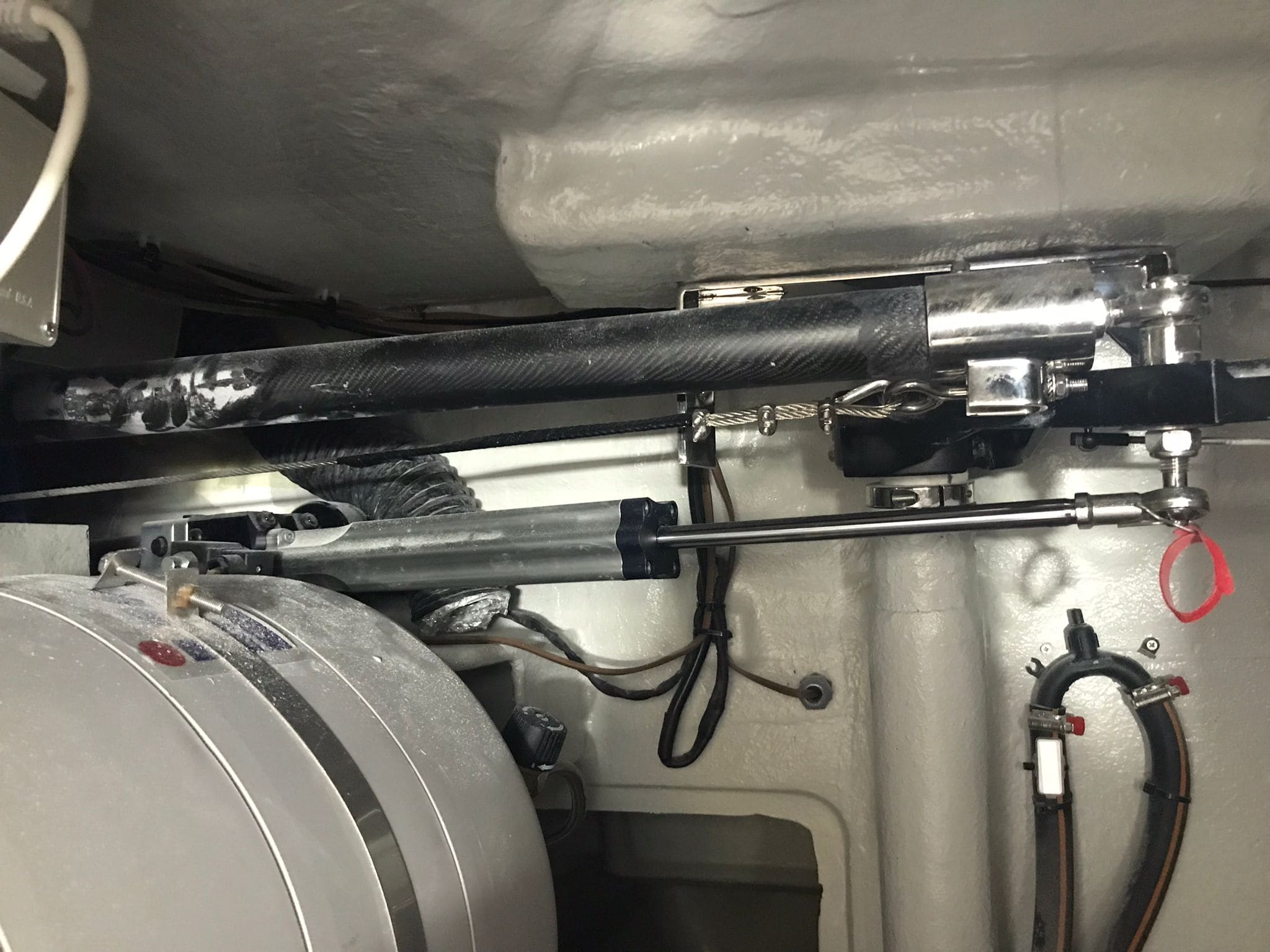

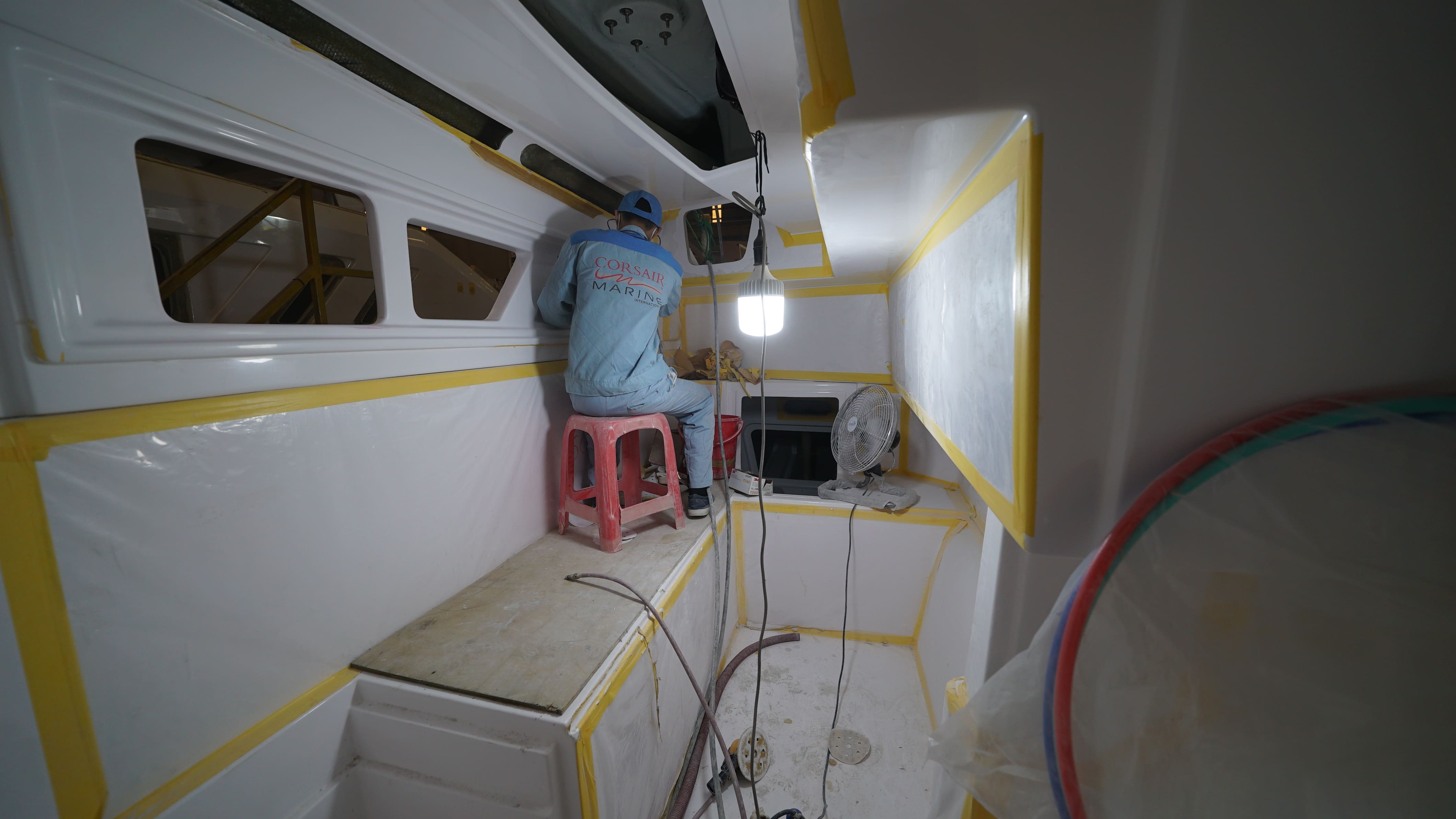

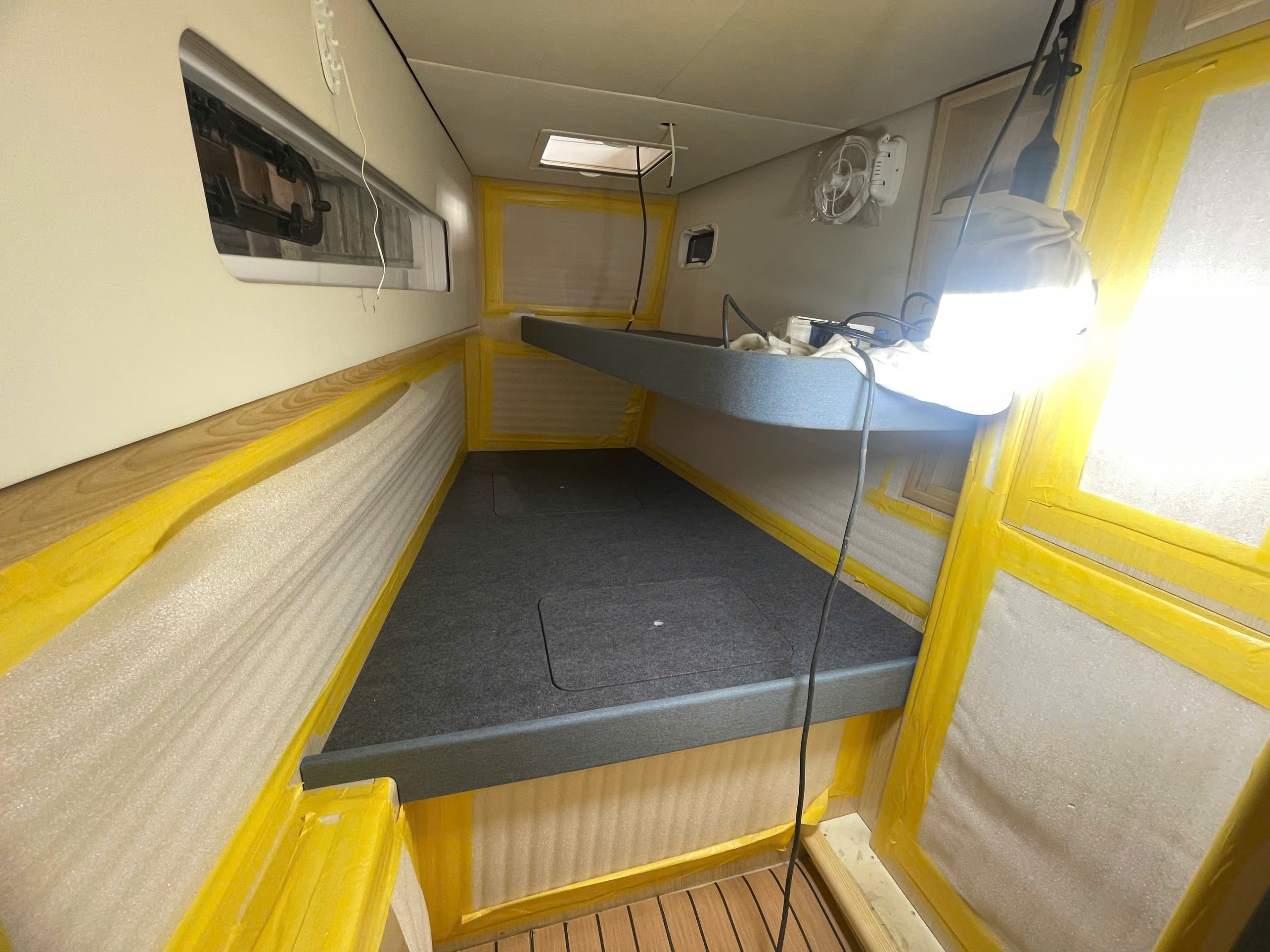

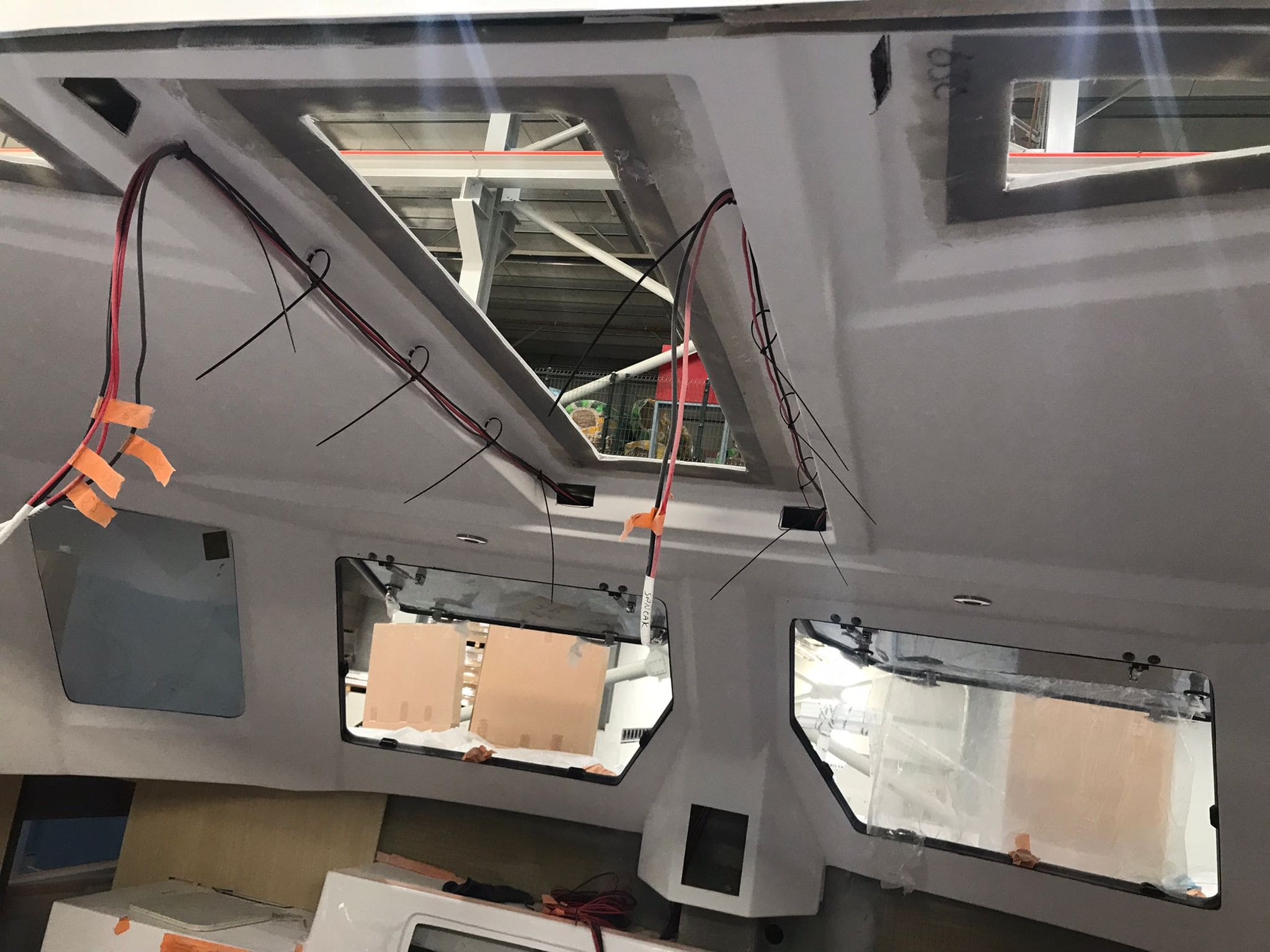

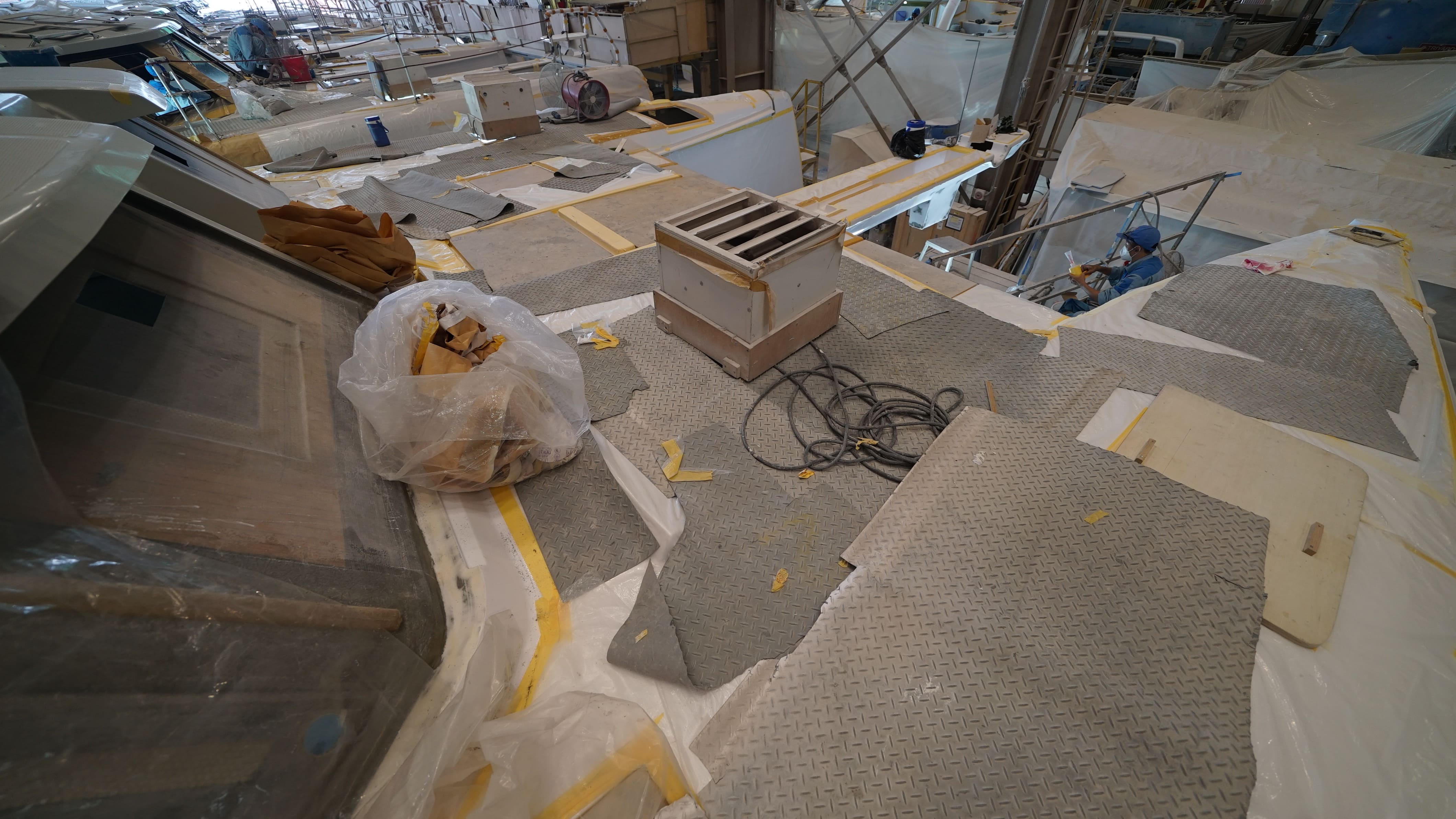

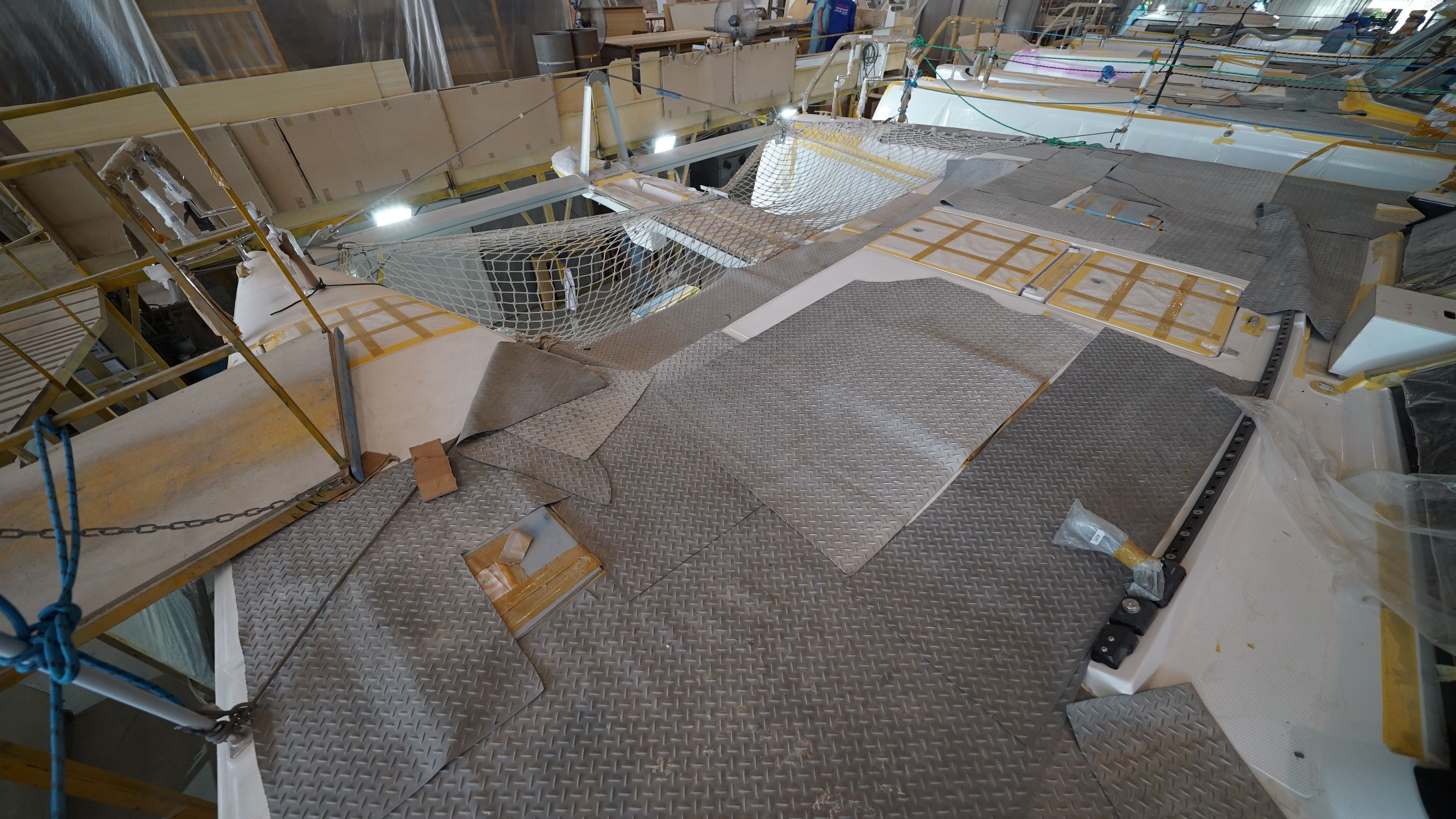

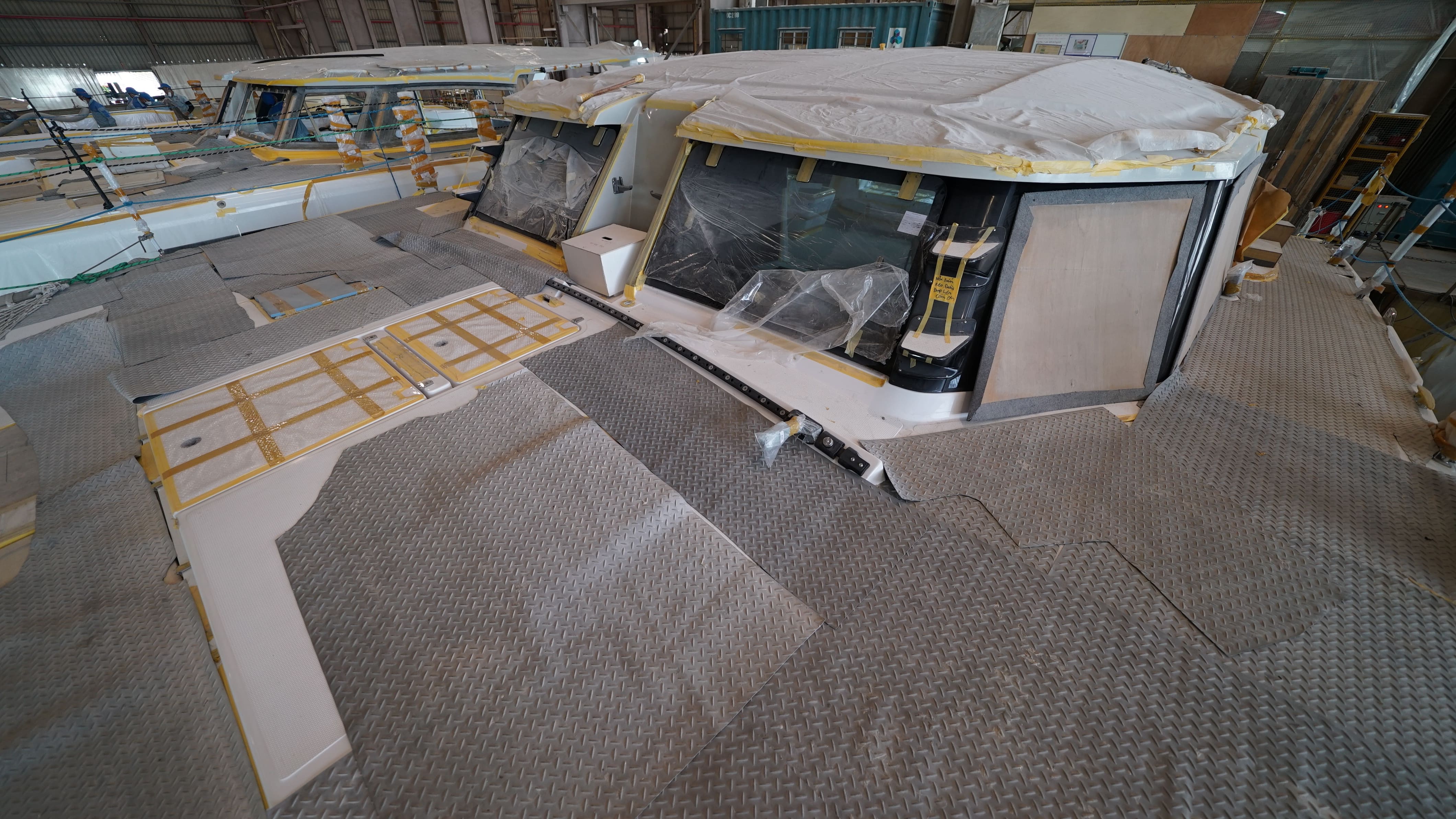

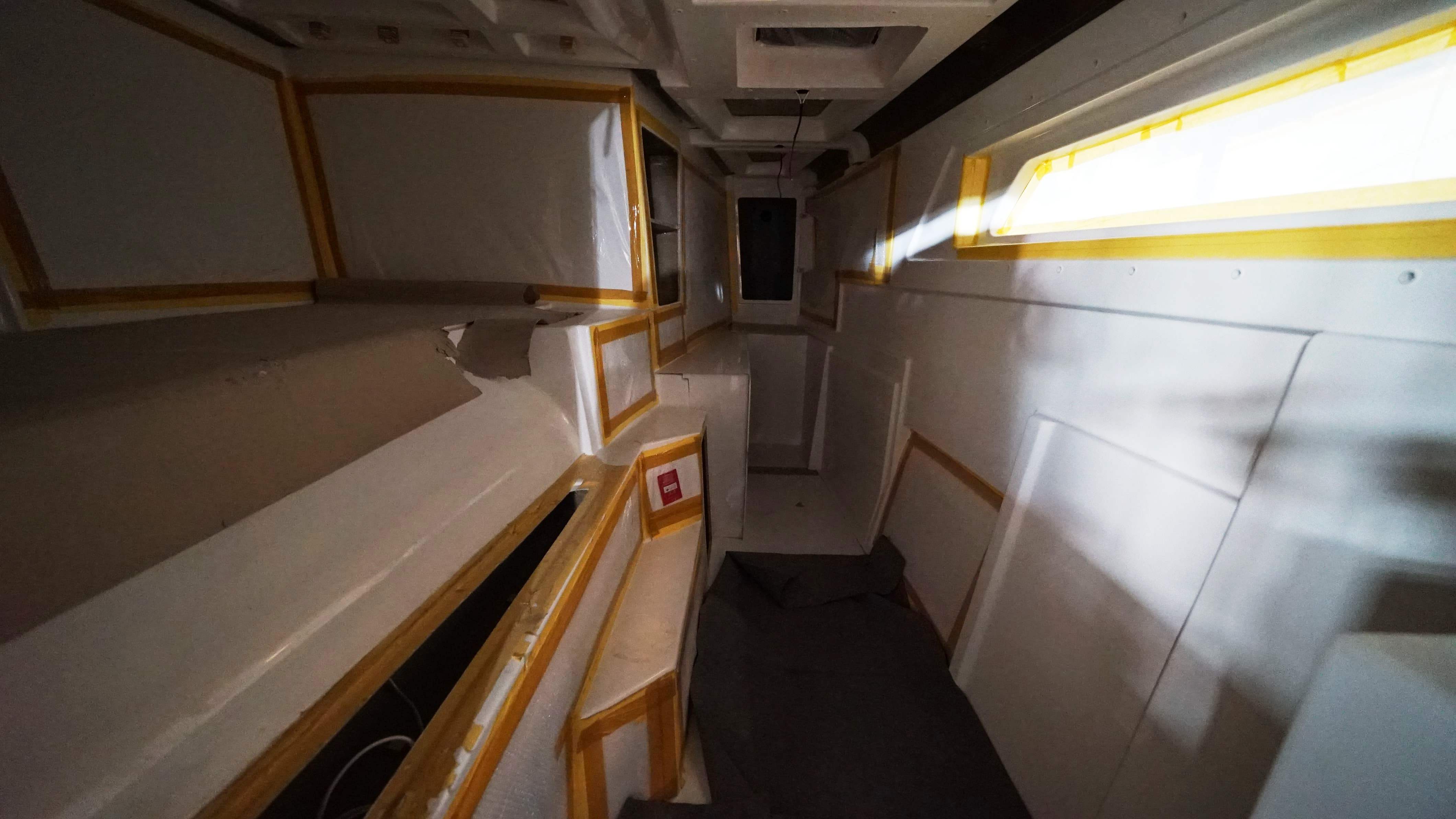

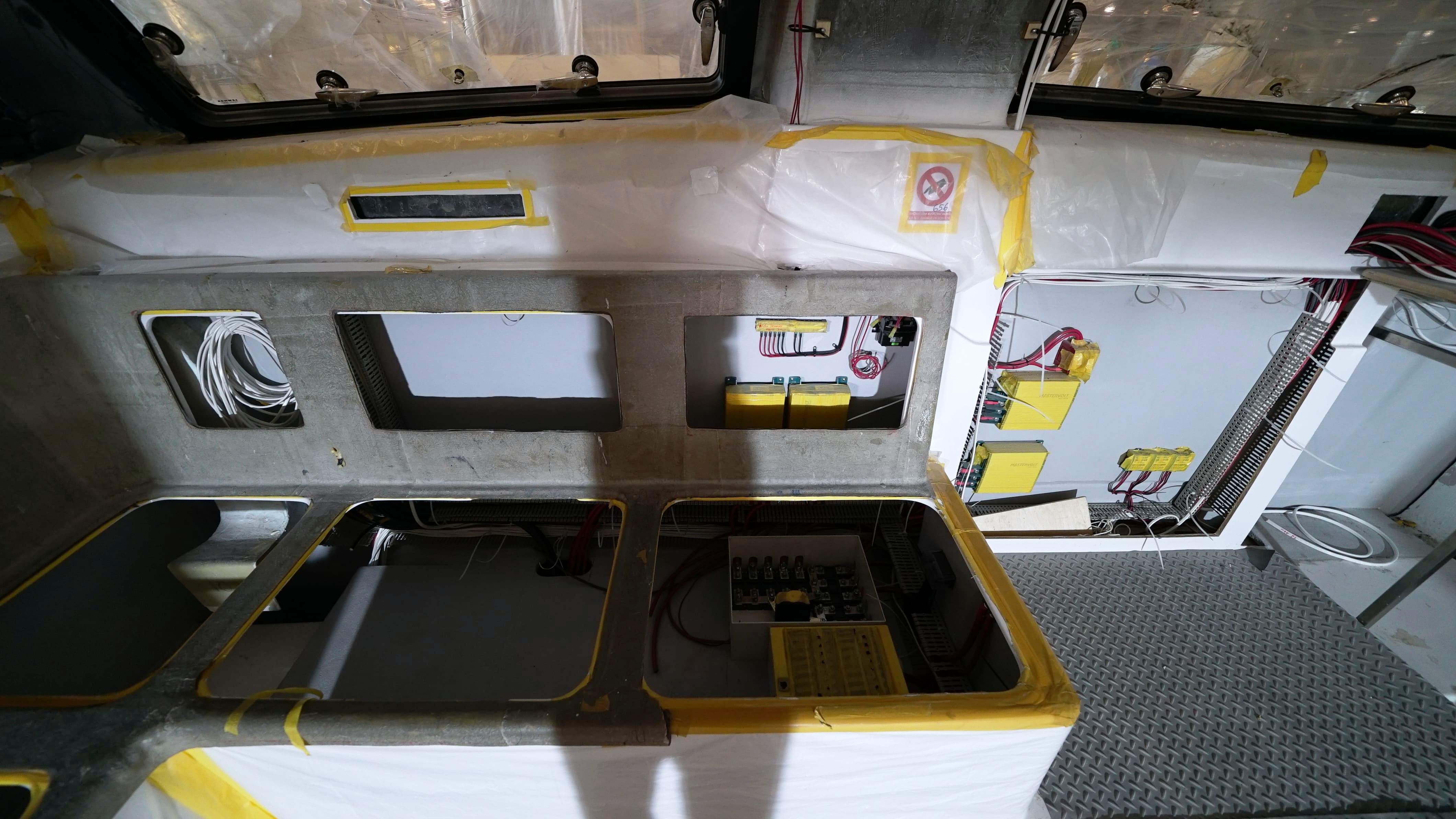

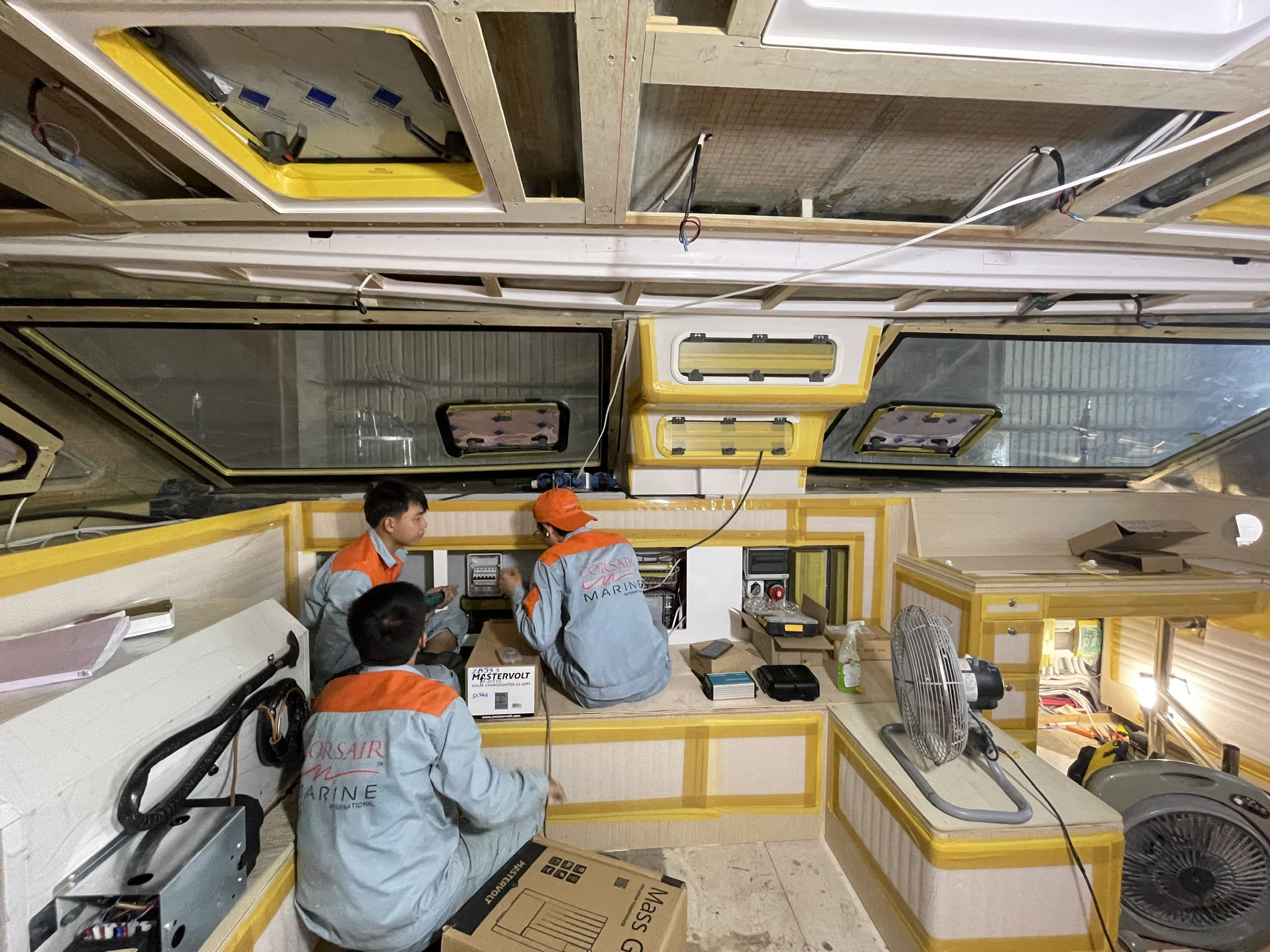

Our Production team is working on deck hardware (90%), steering (70%), plumbing & LPG (50%), electric works (50%), navigation (25%), timber fitout (50%), anti fouling paint, daggerboard, fwd beam, and A-frame.

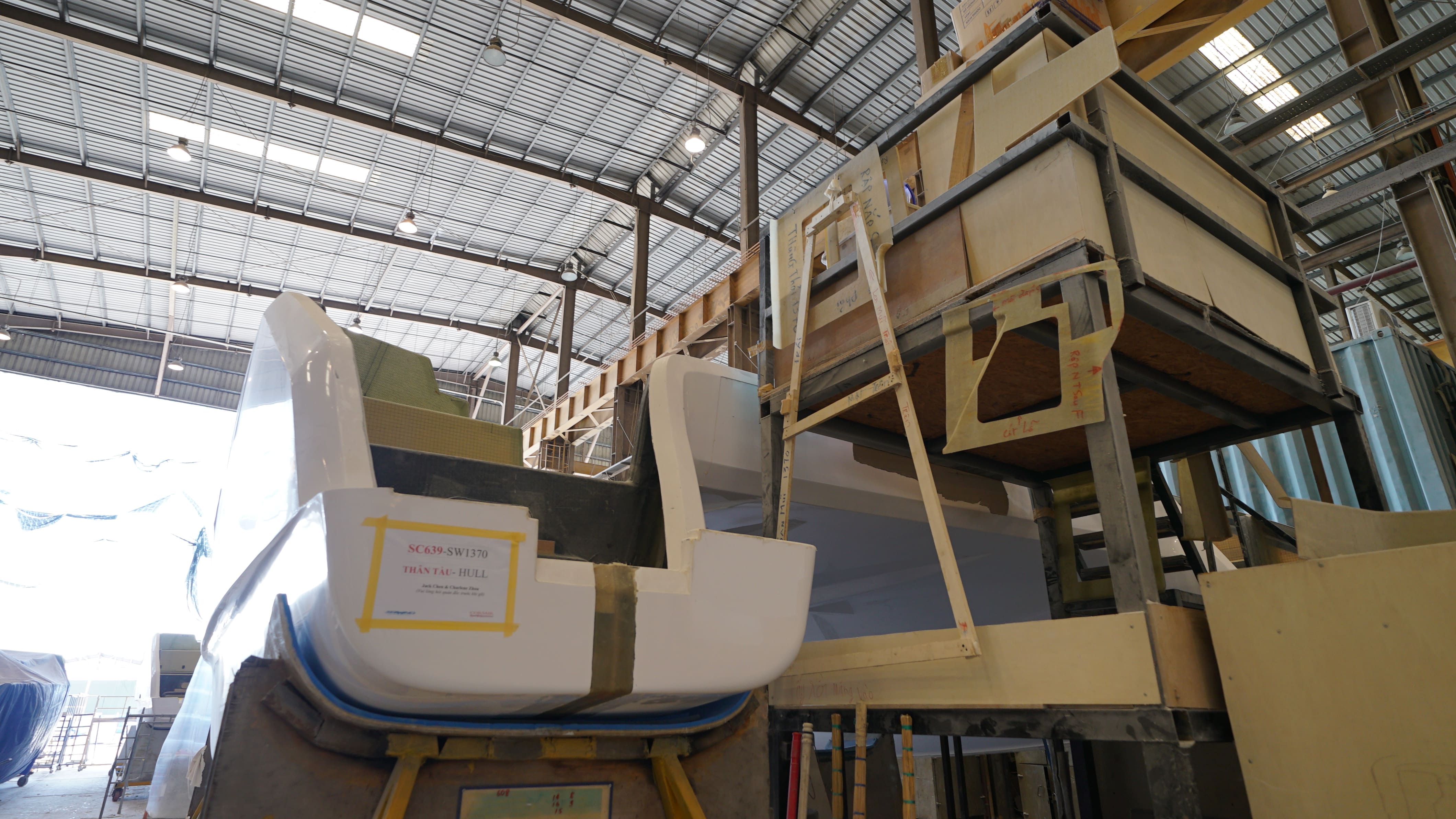

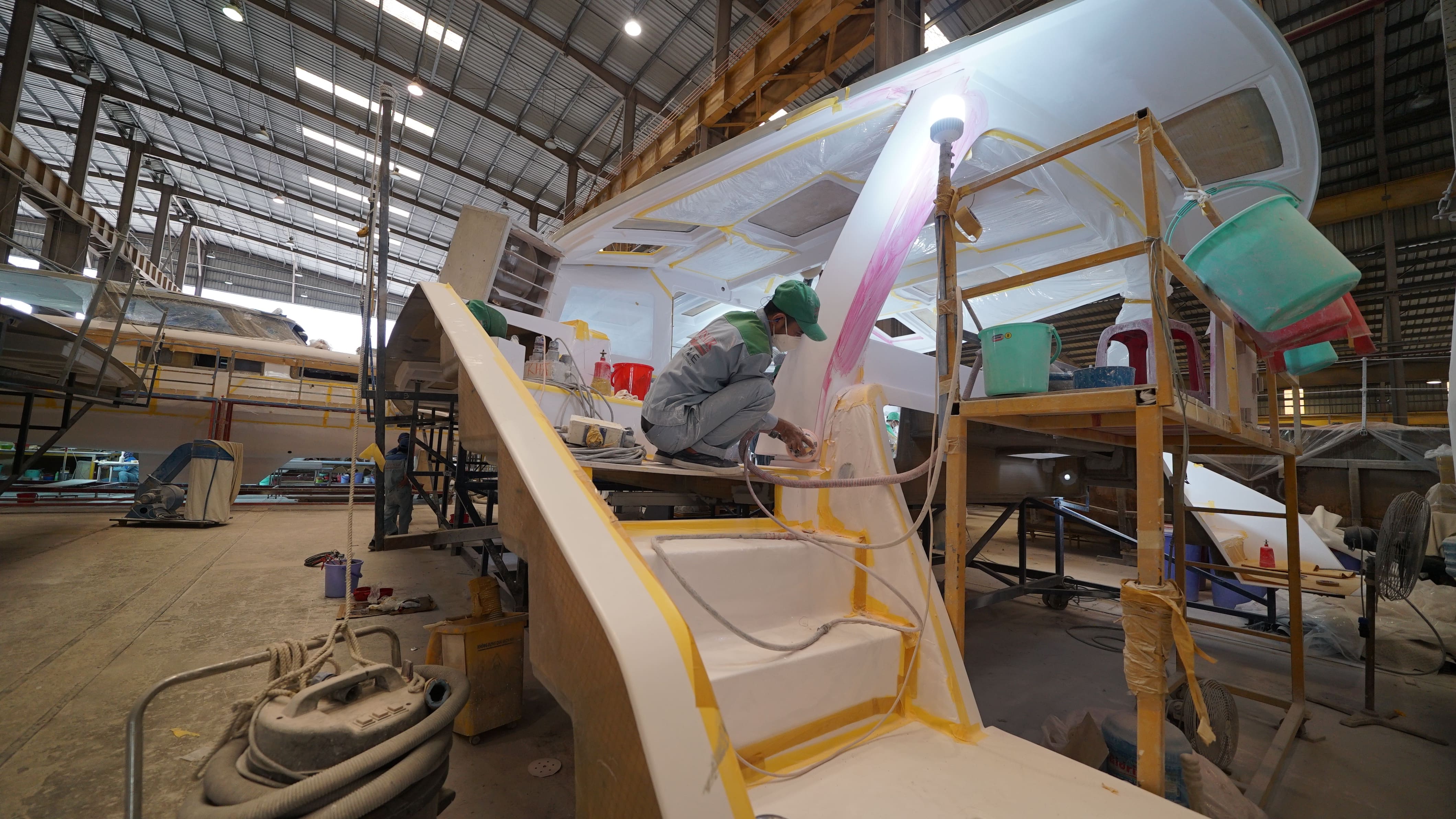

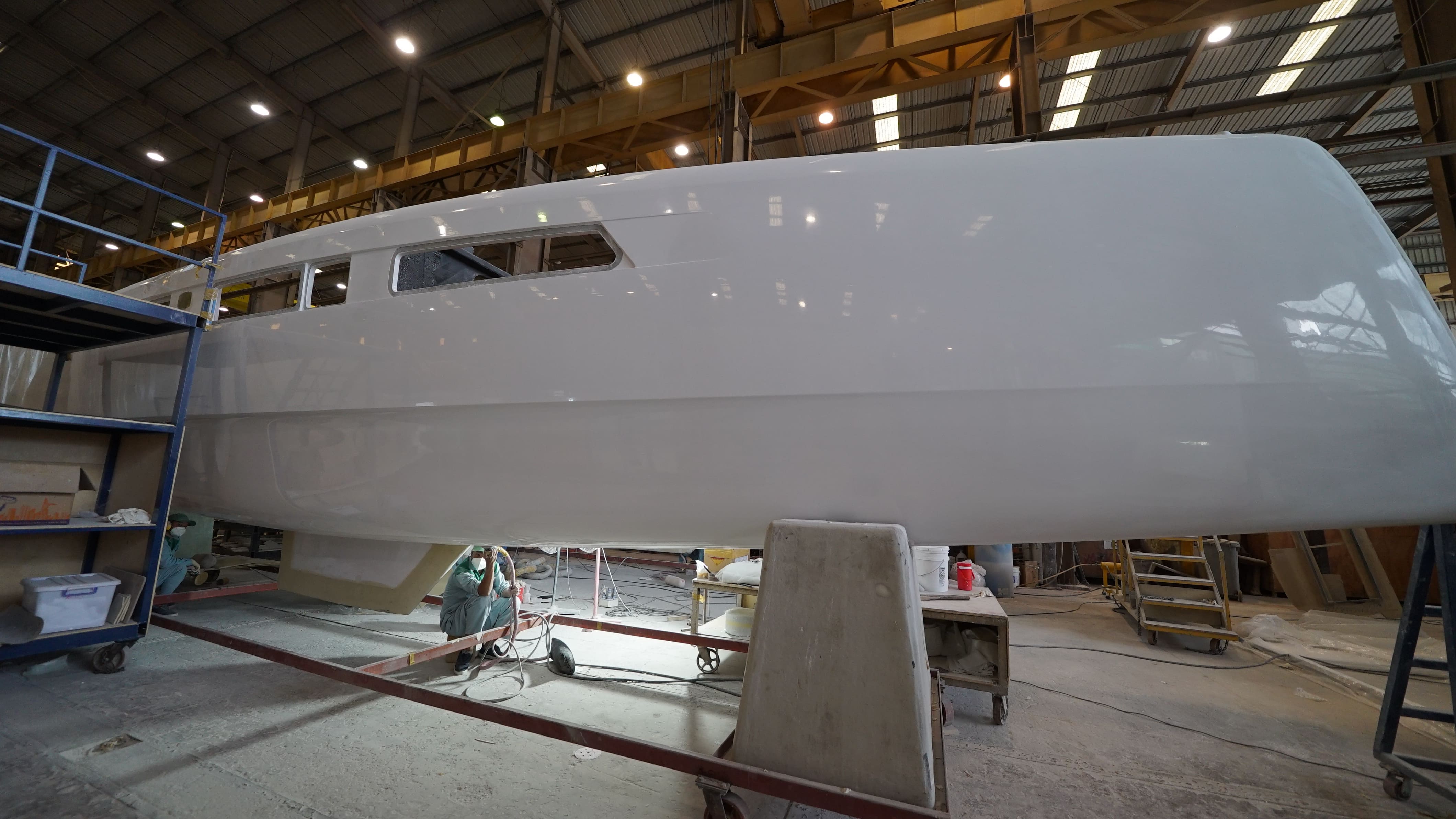

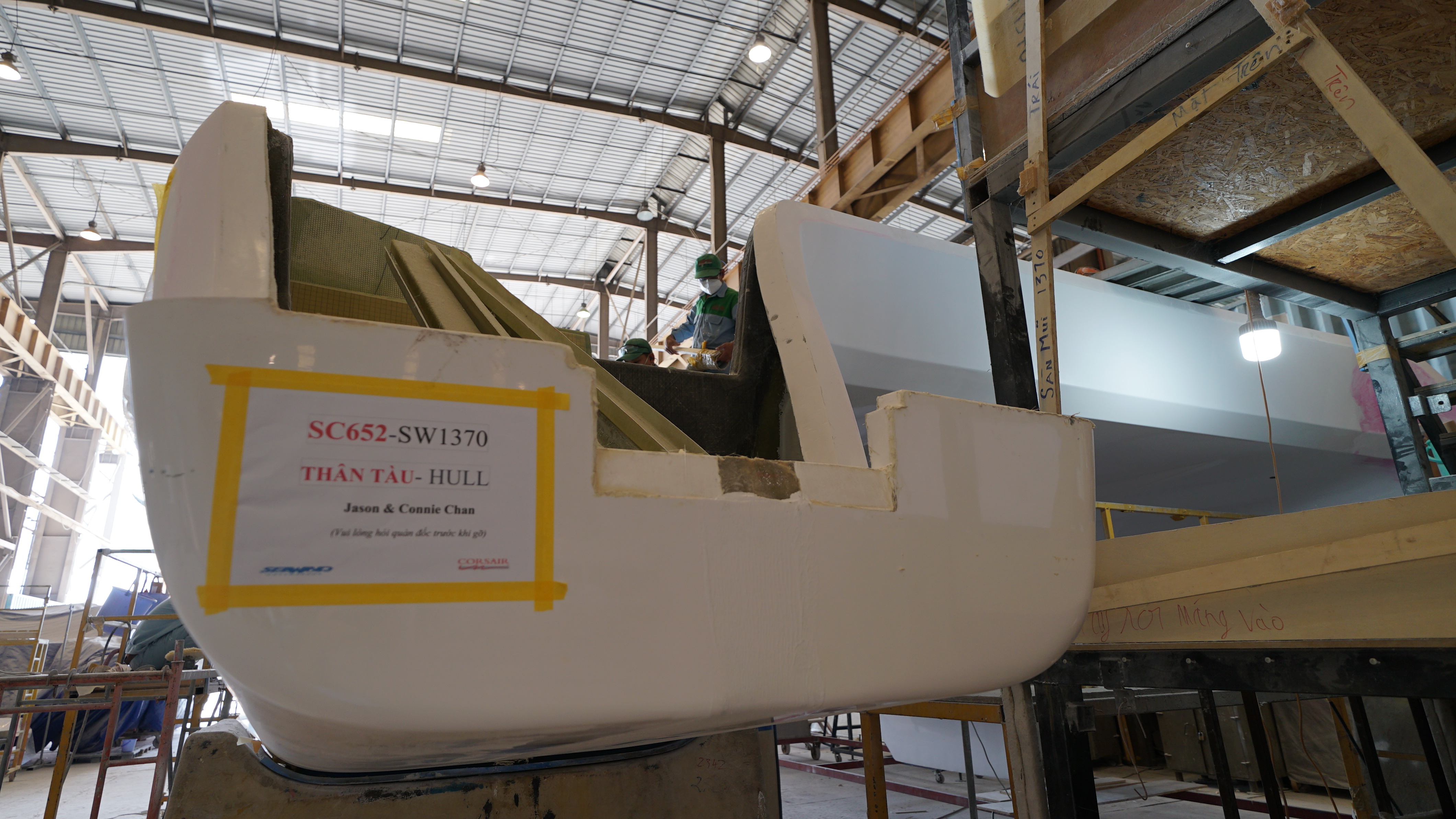

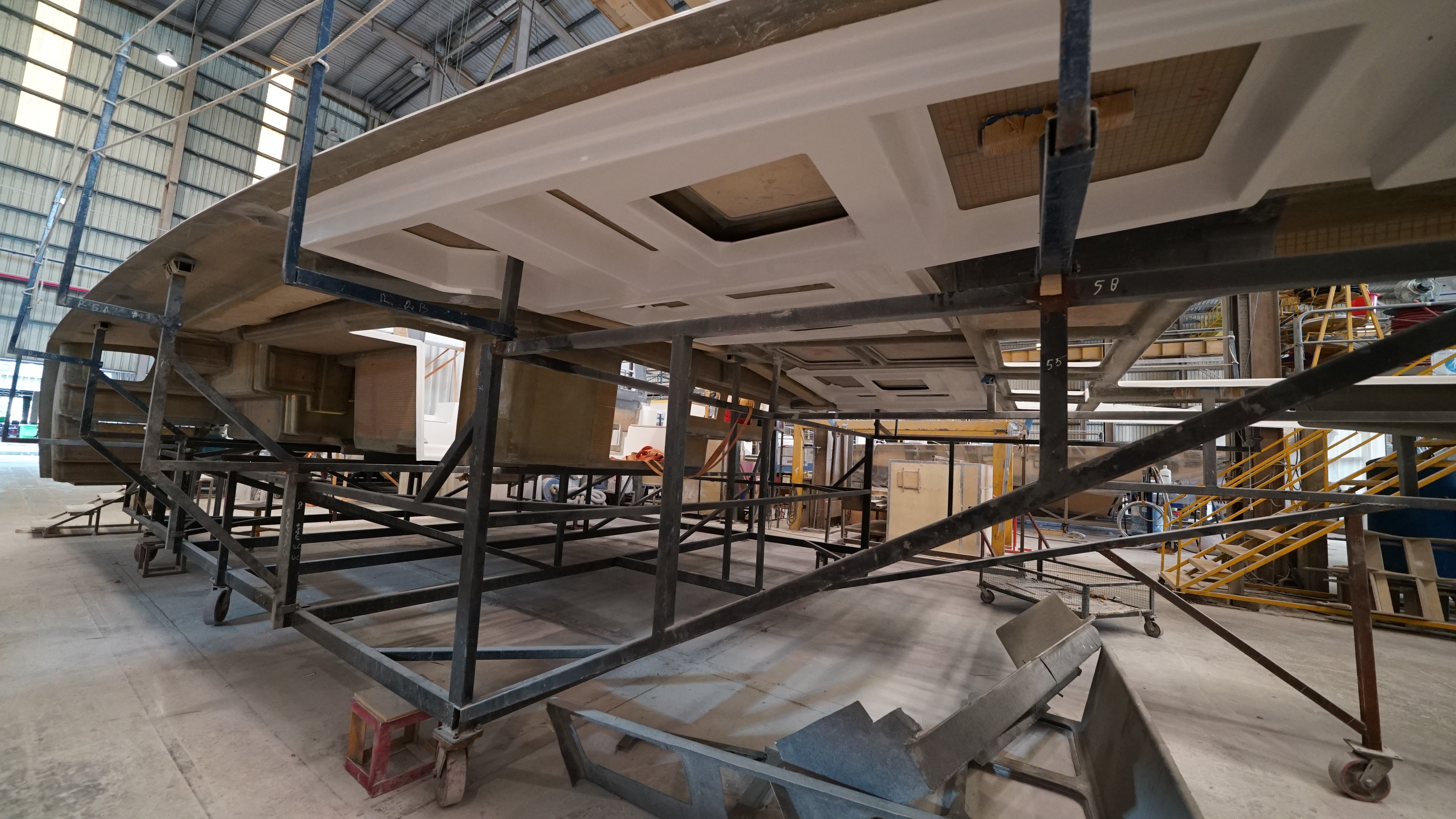

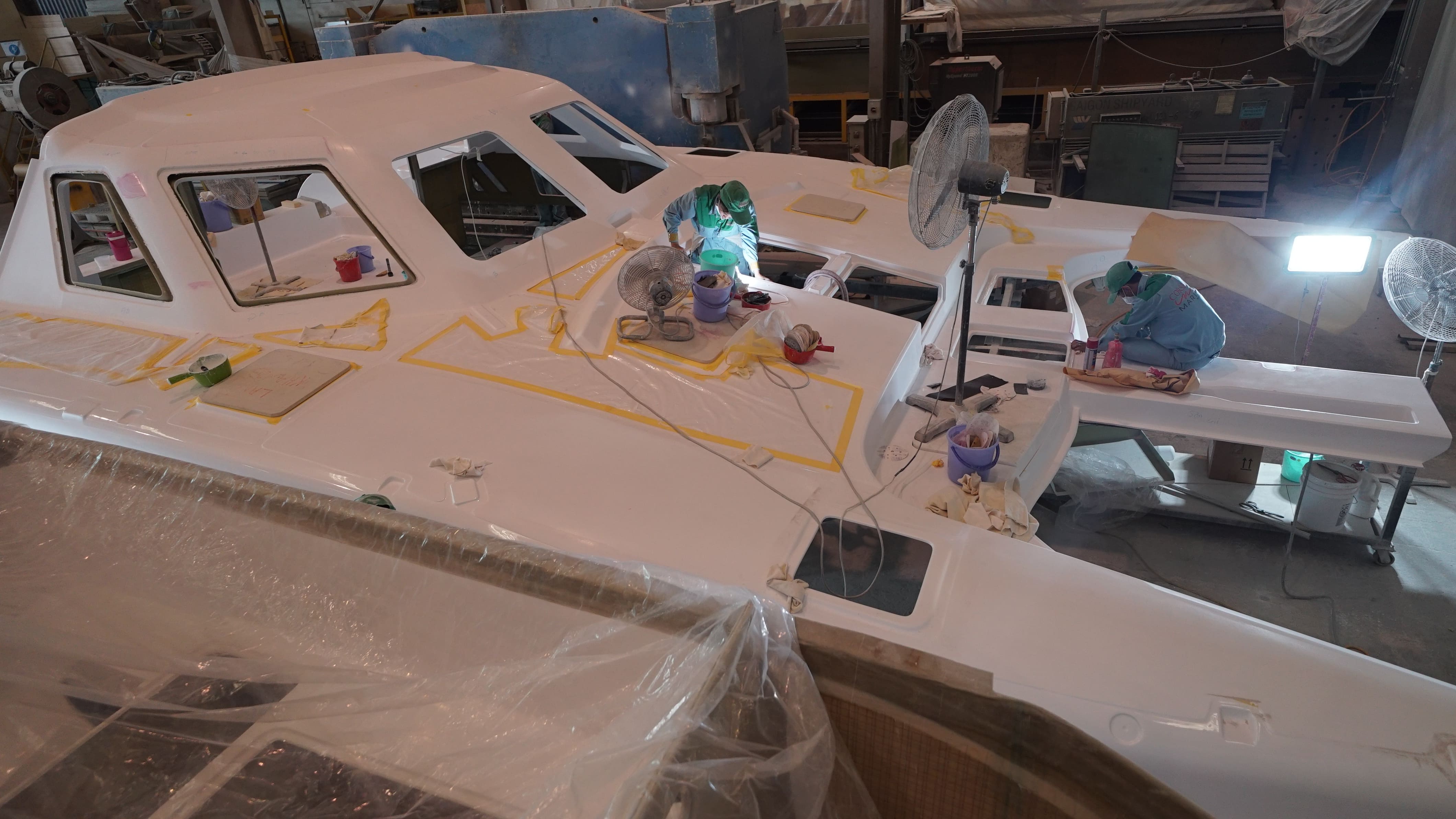

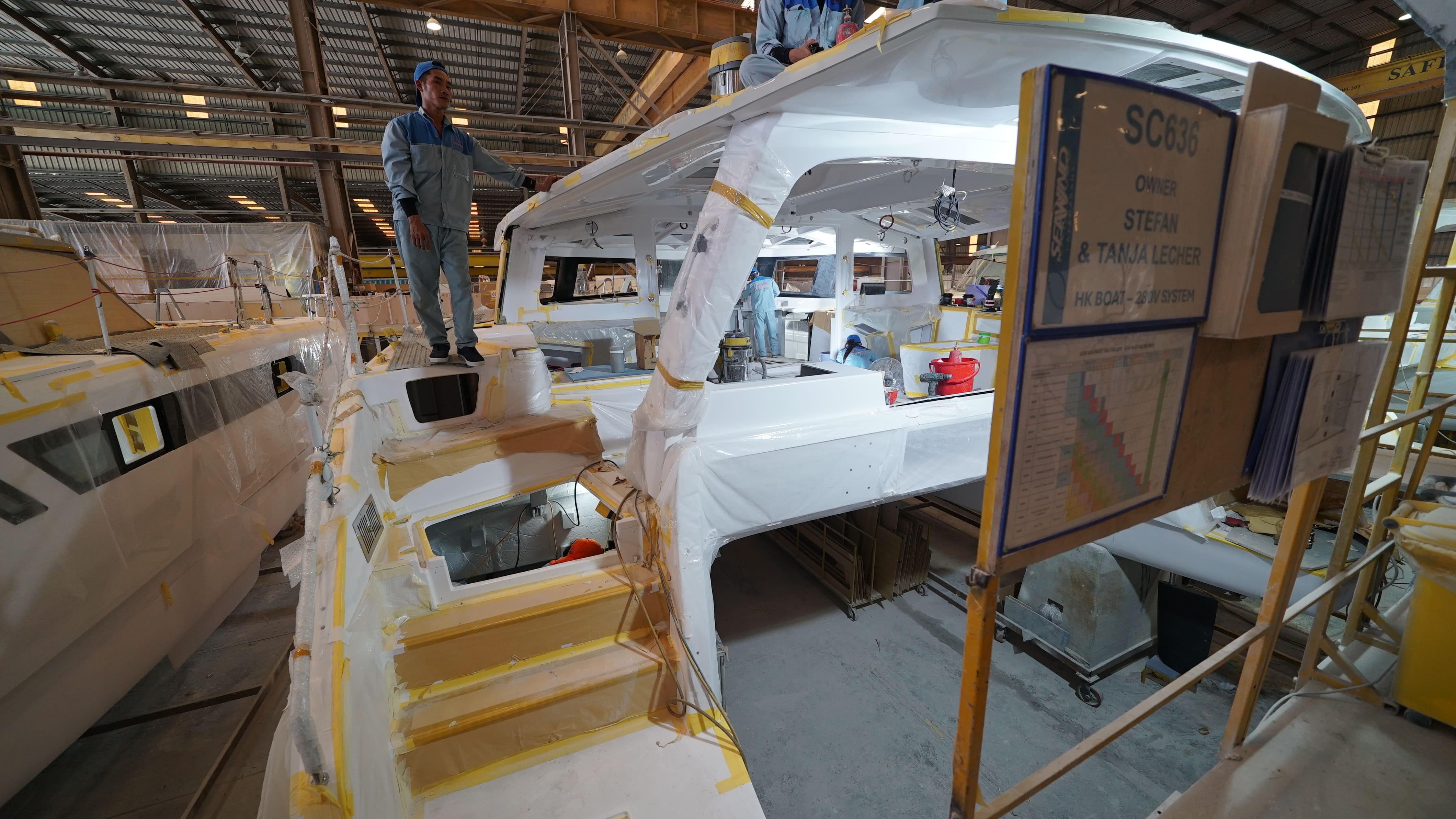

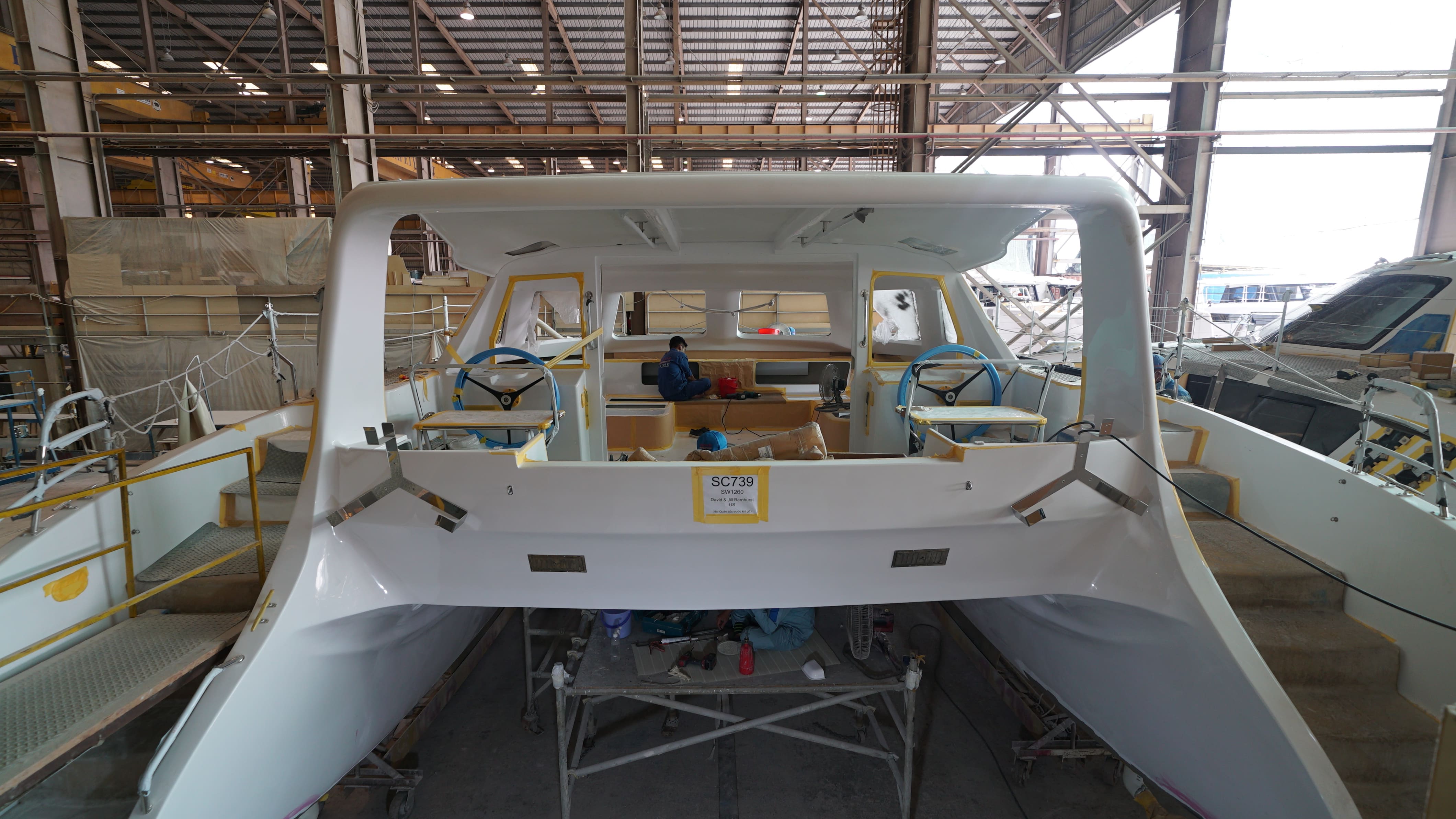

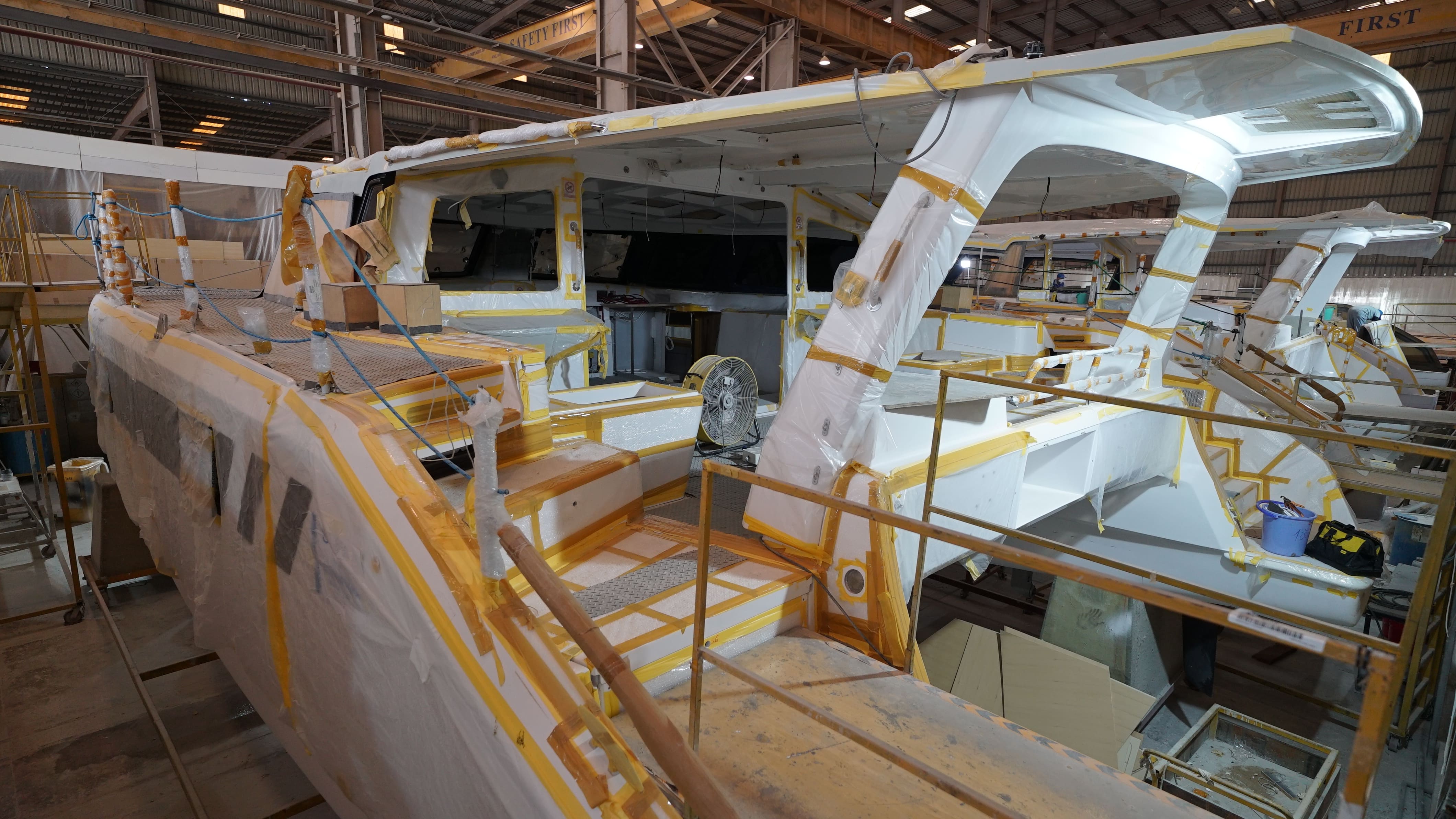

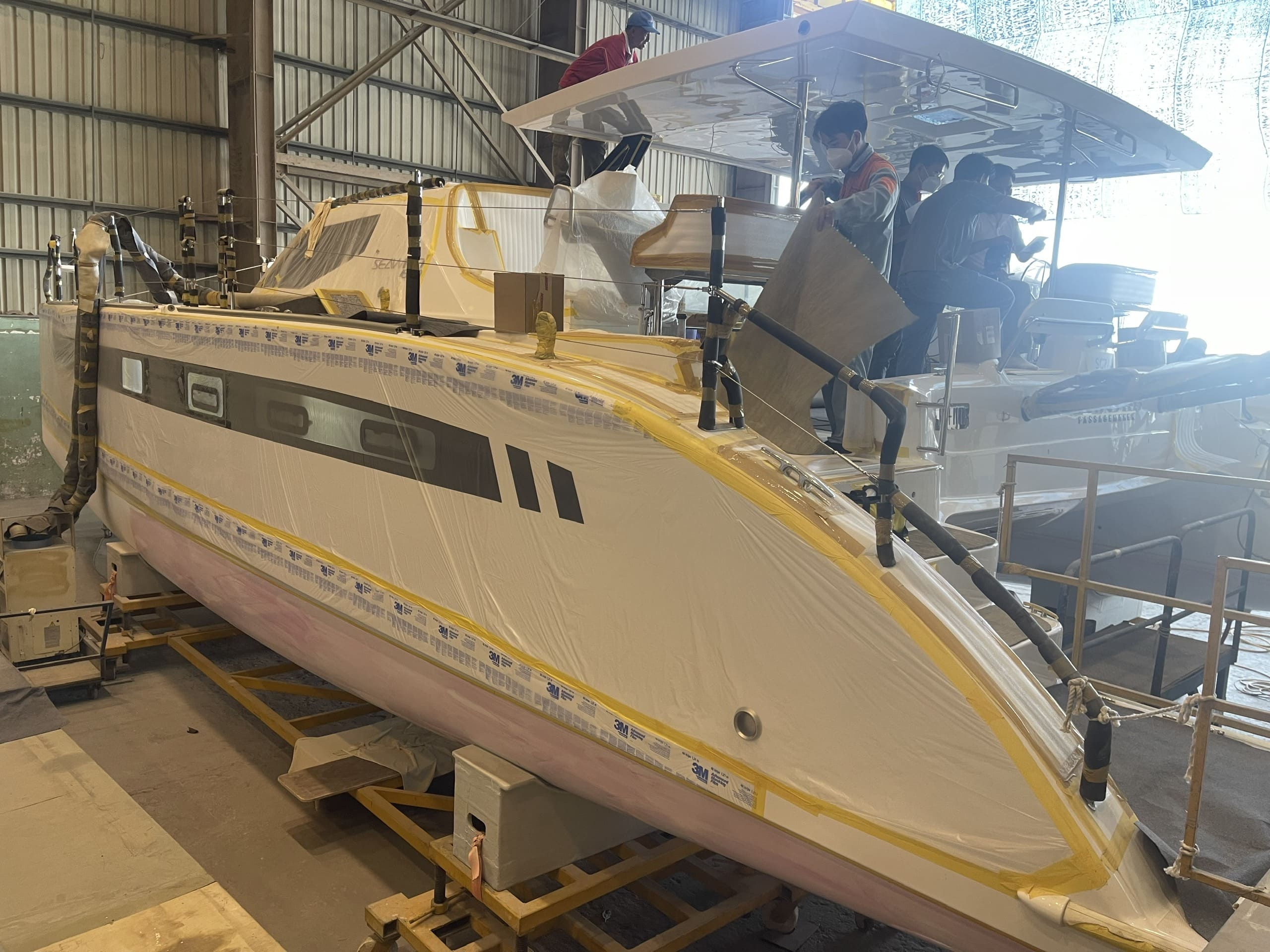

Production Update – Lamination

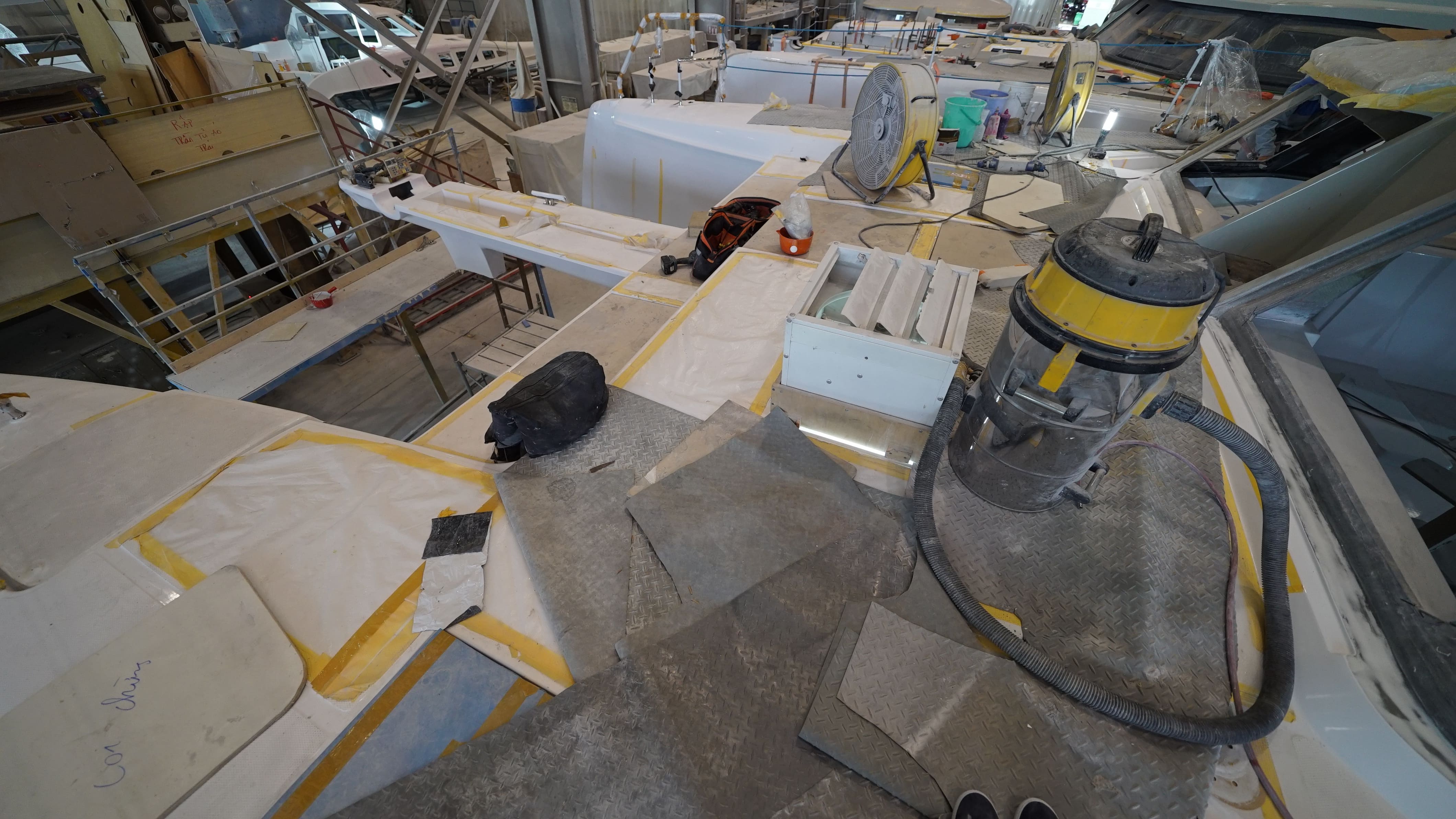

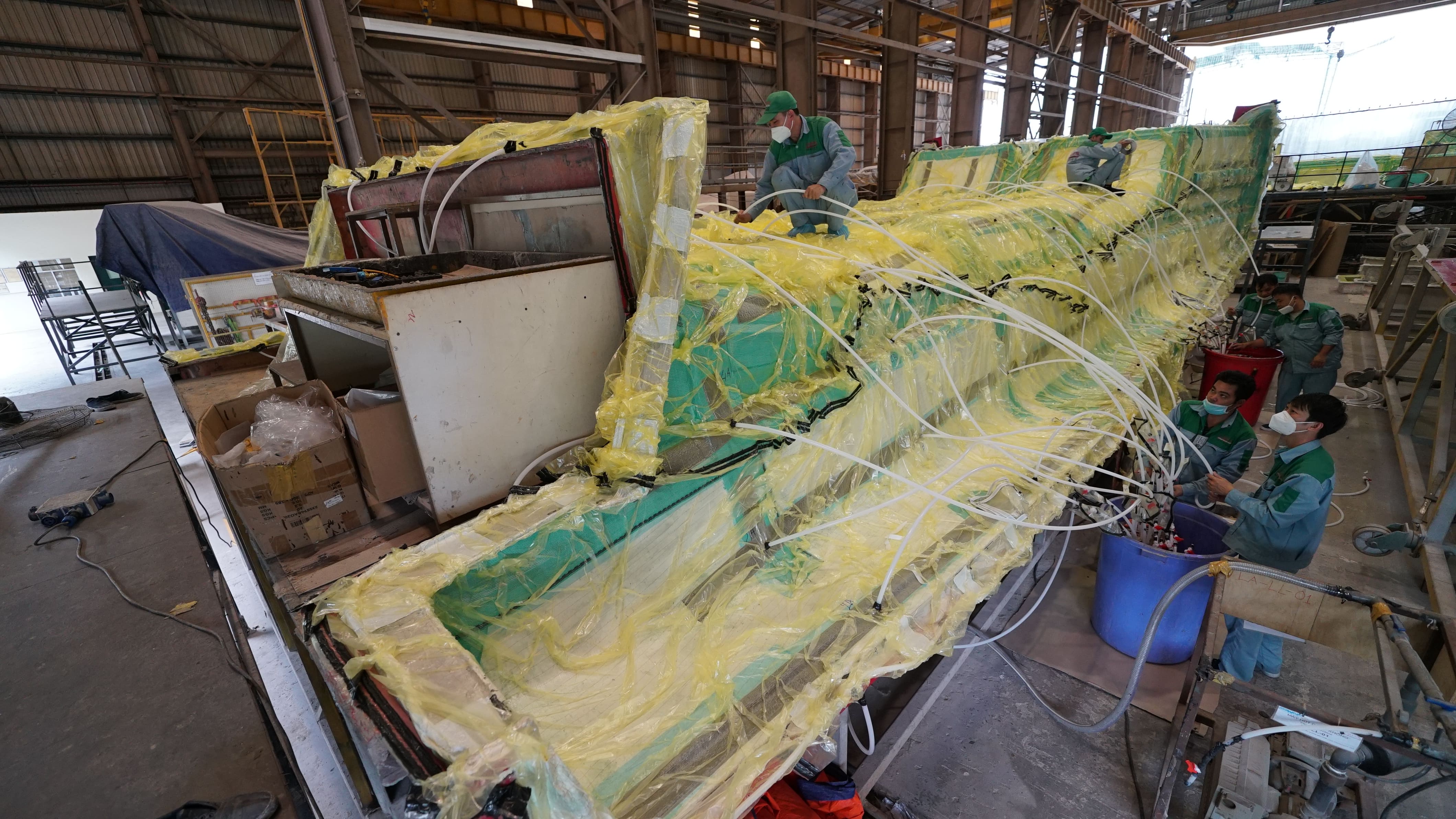

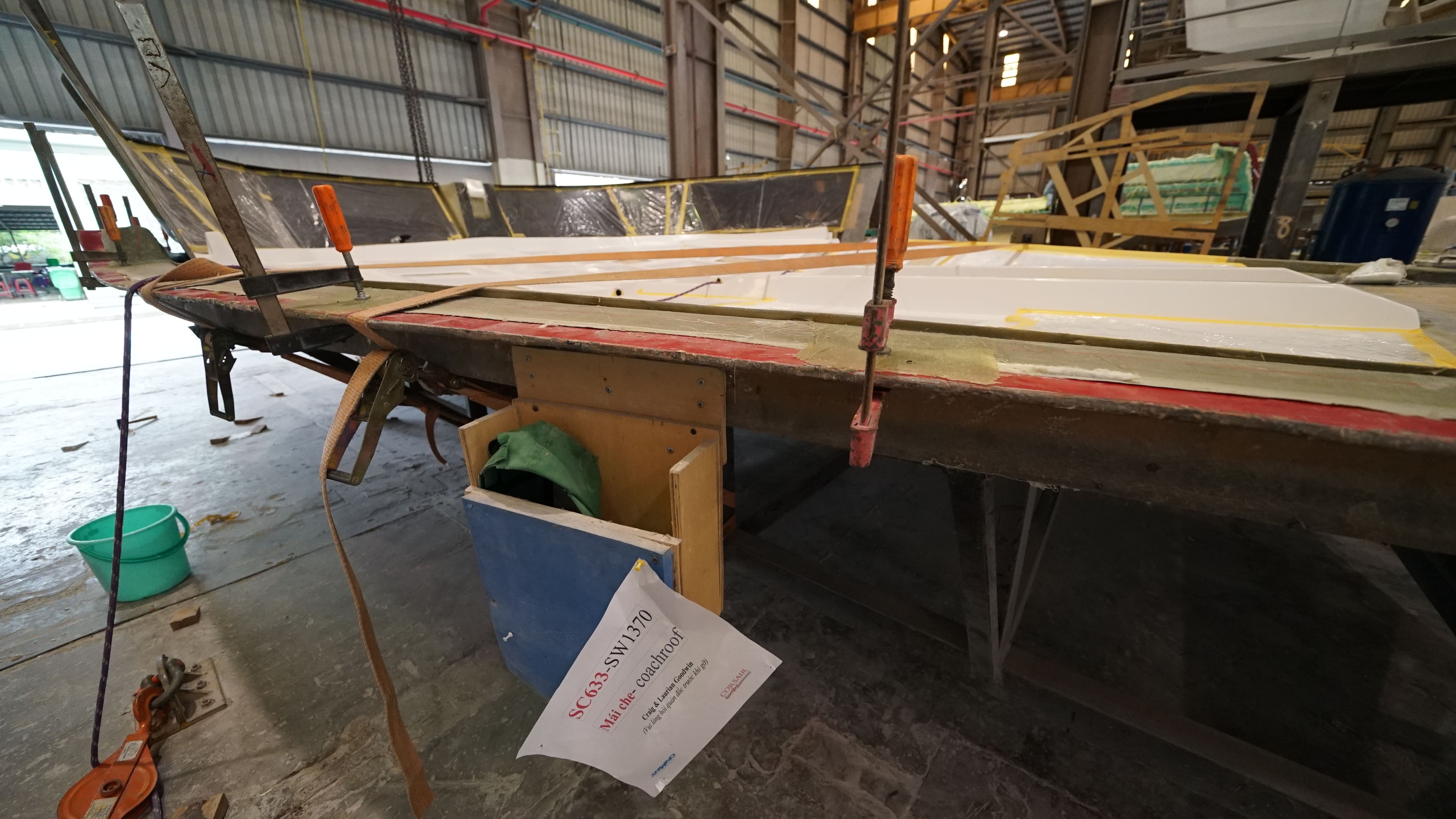

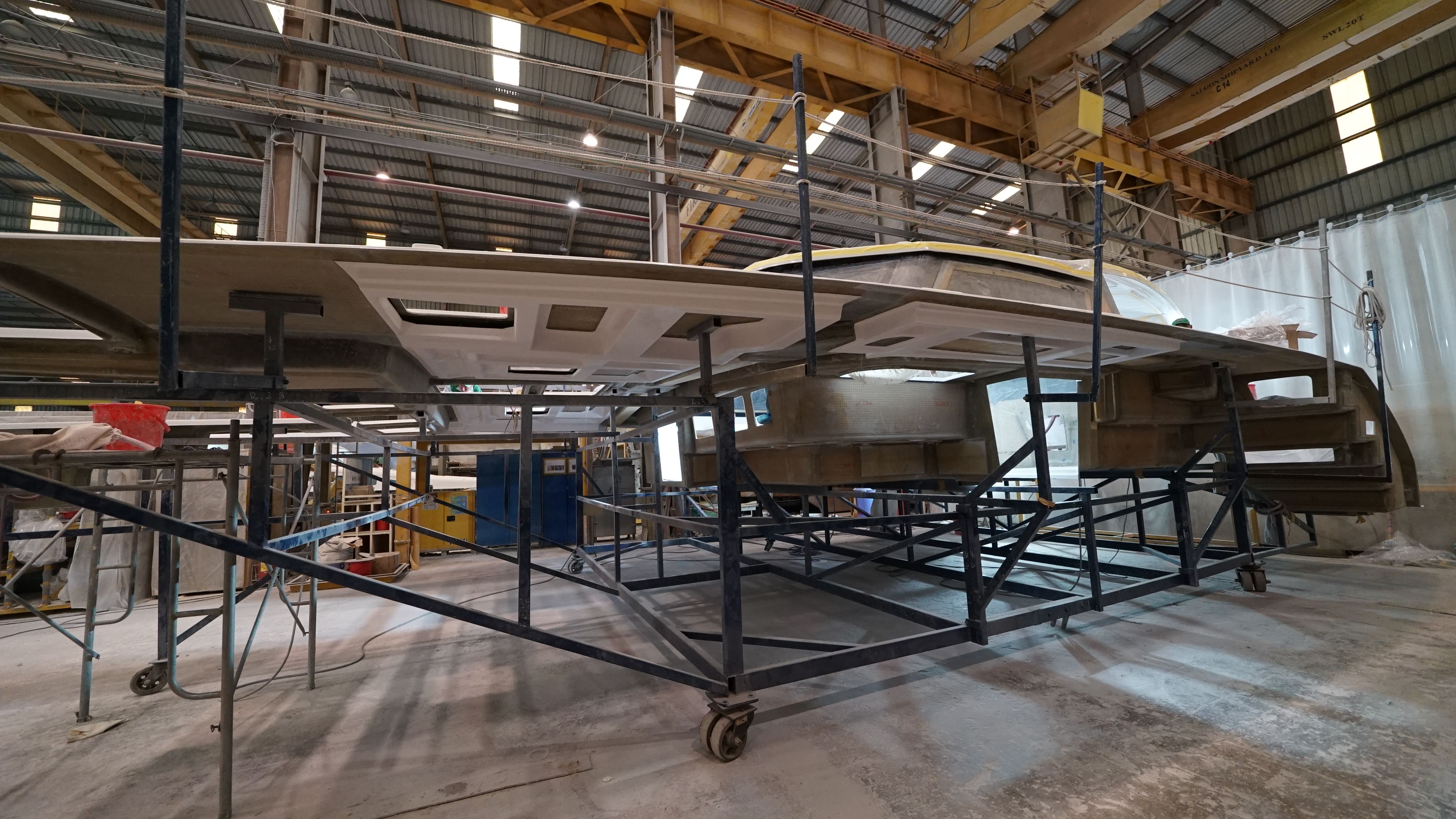

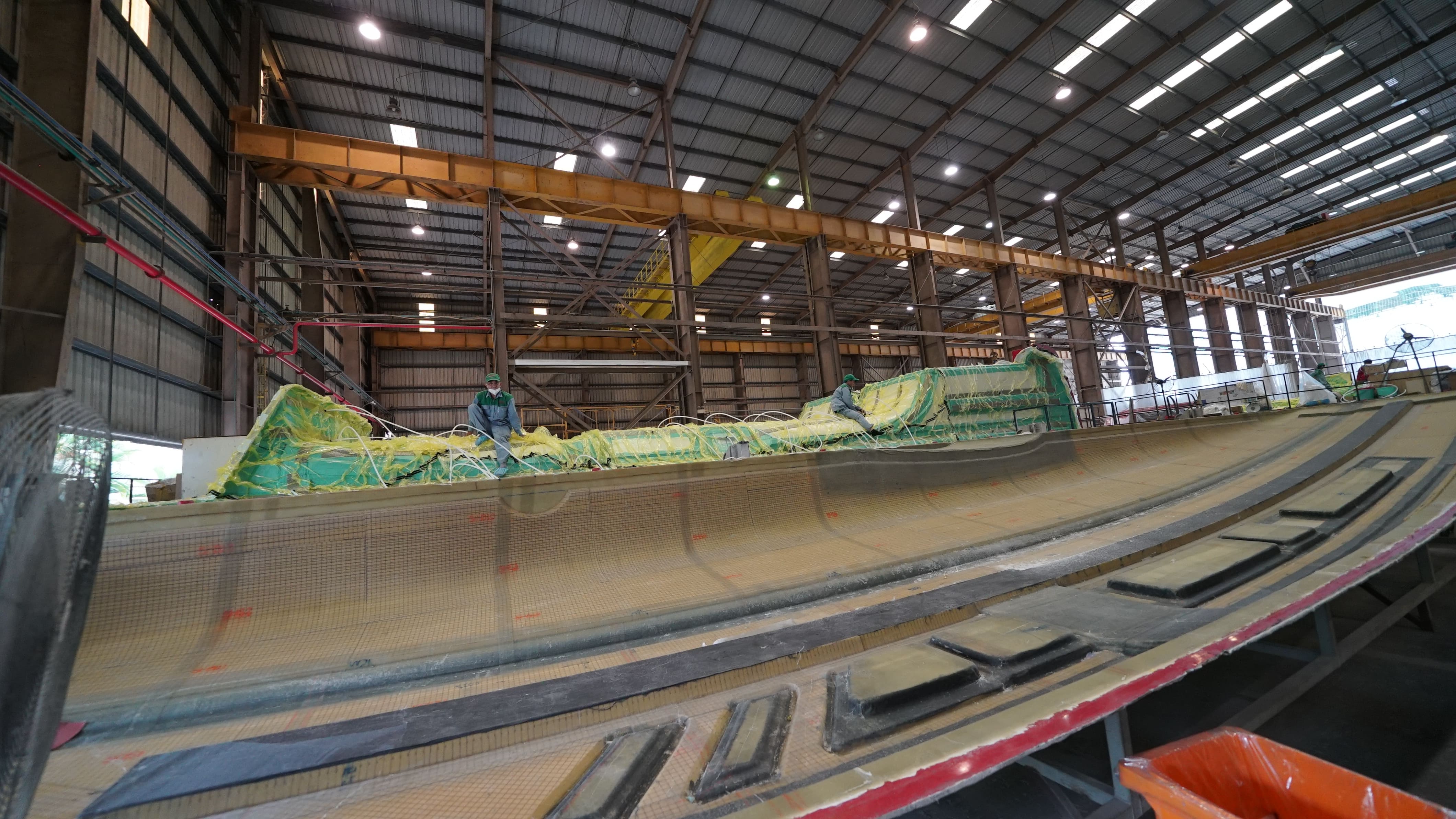

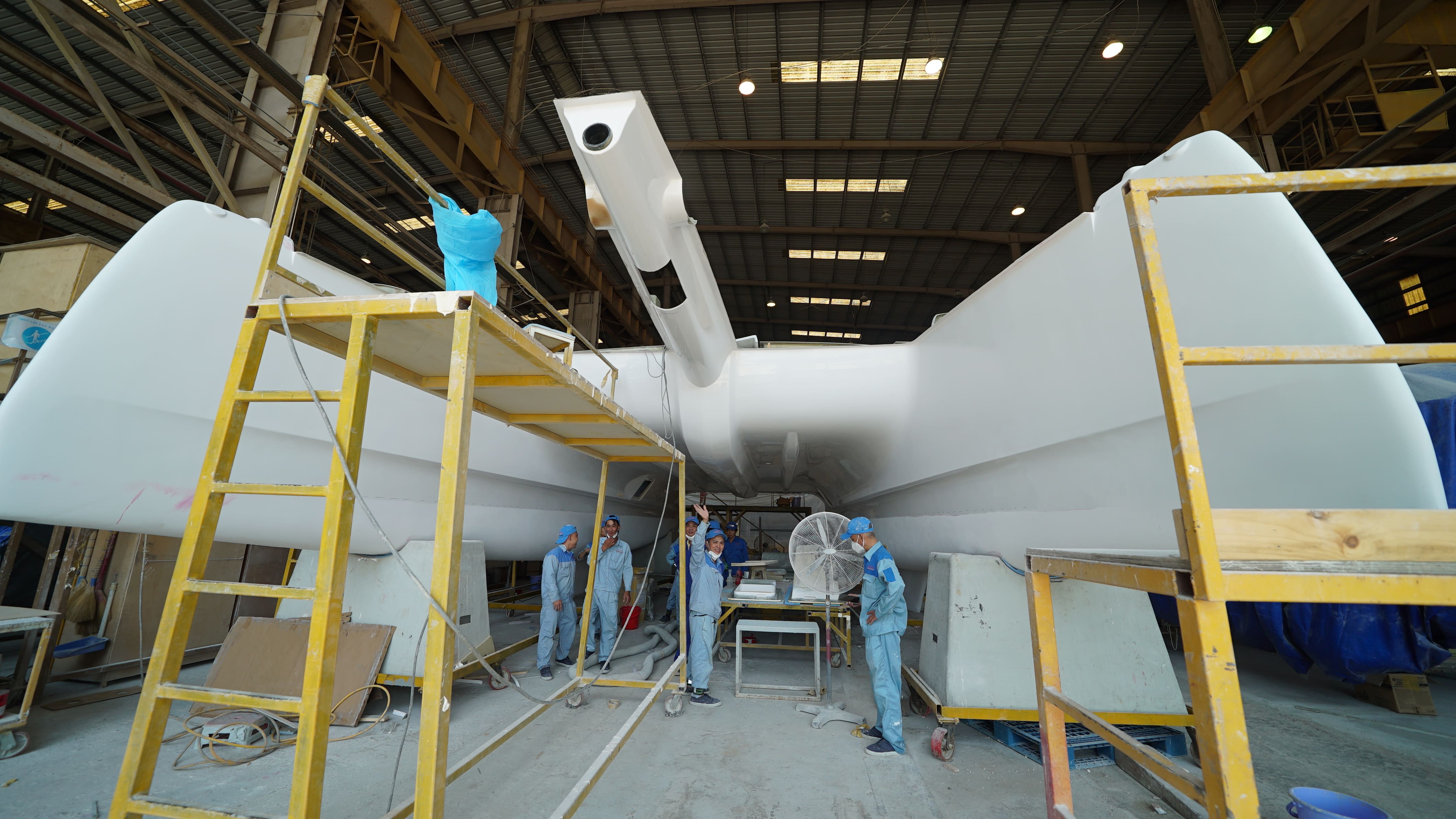

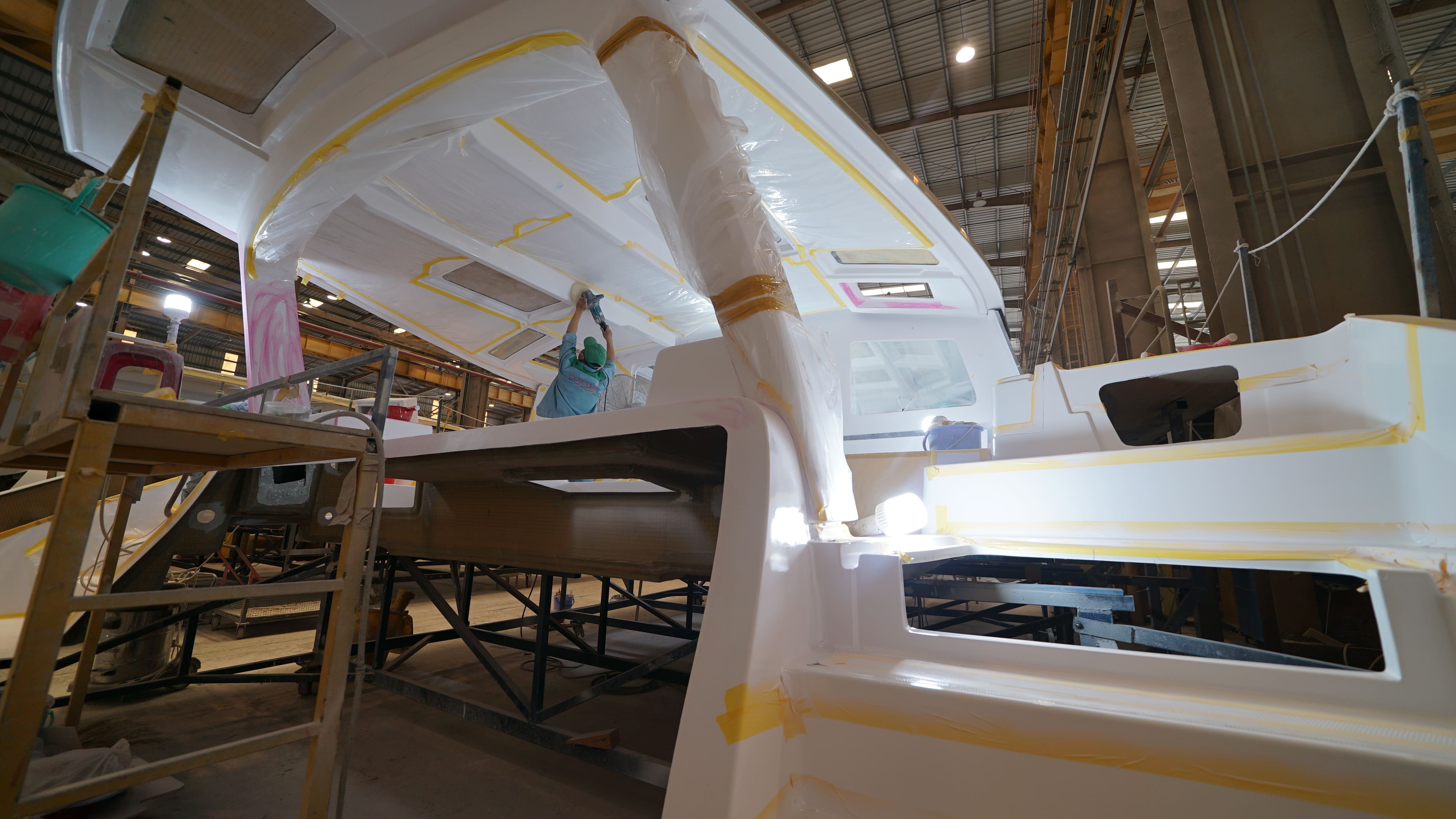

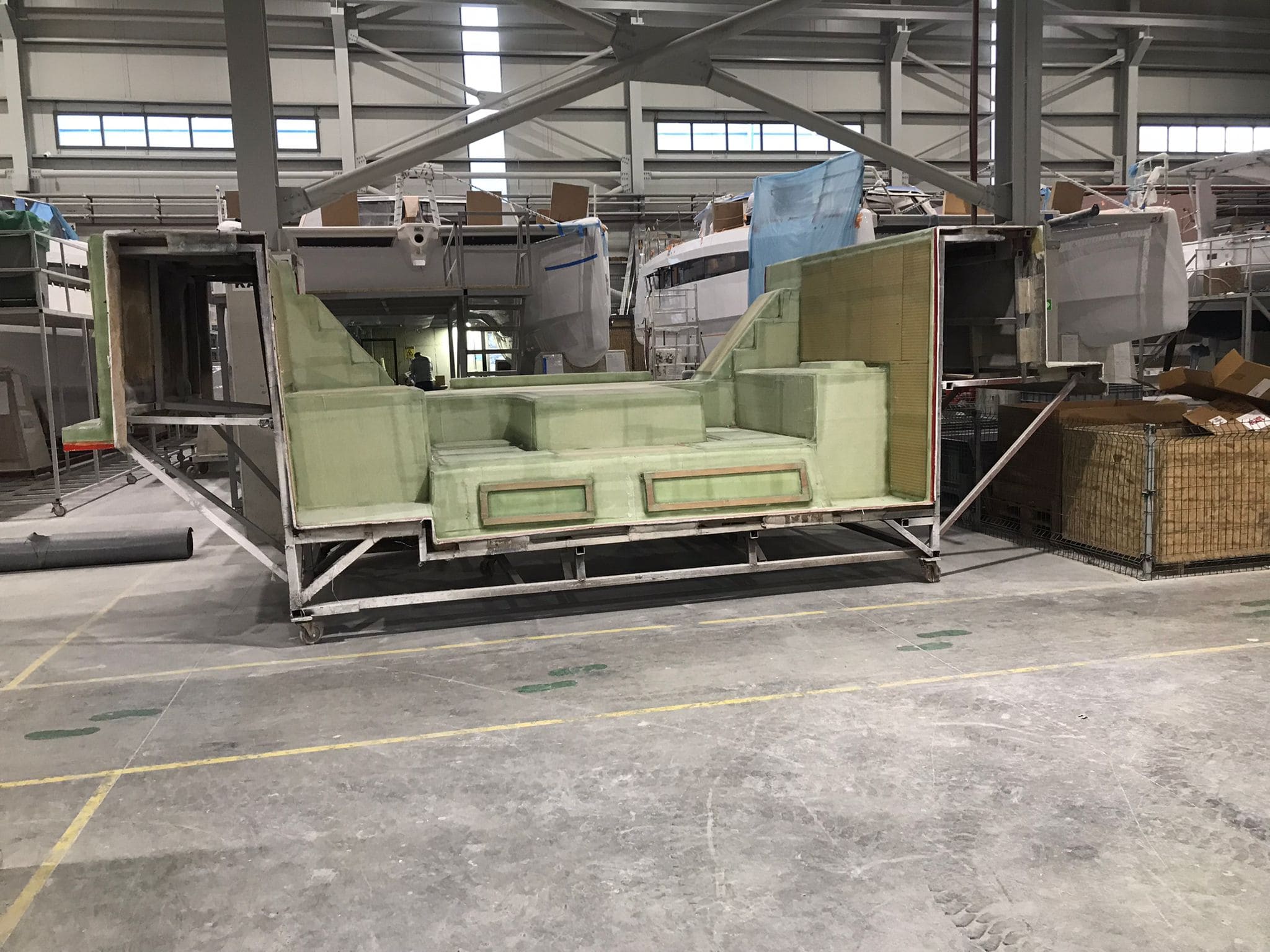

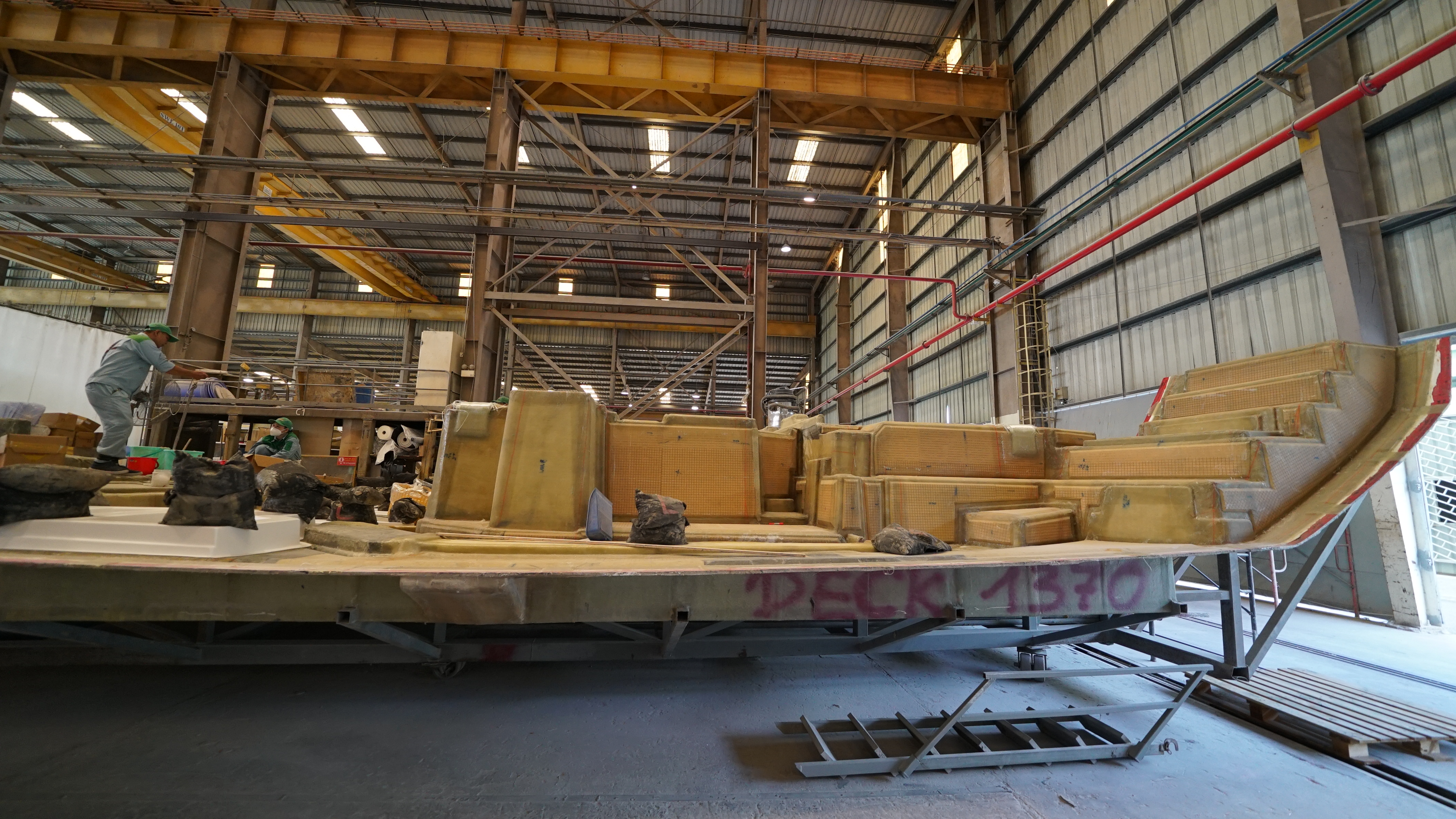

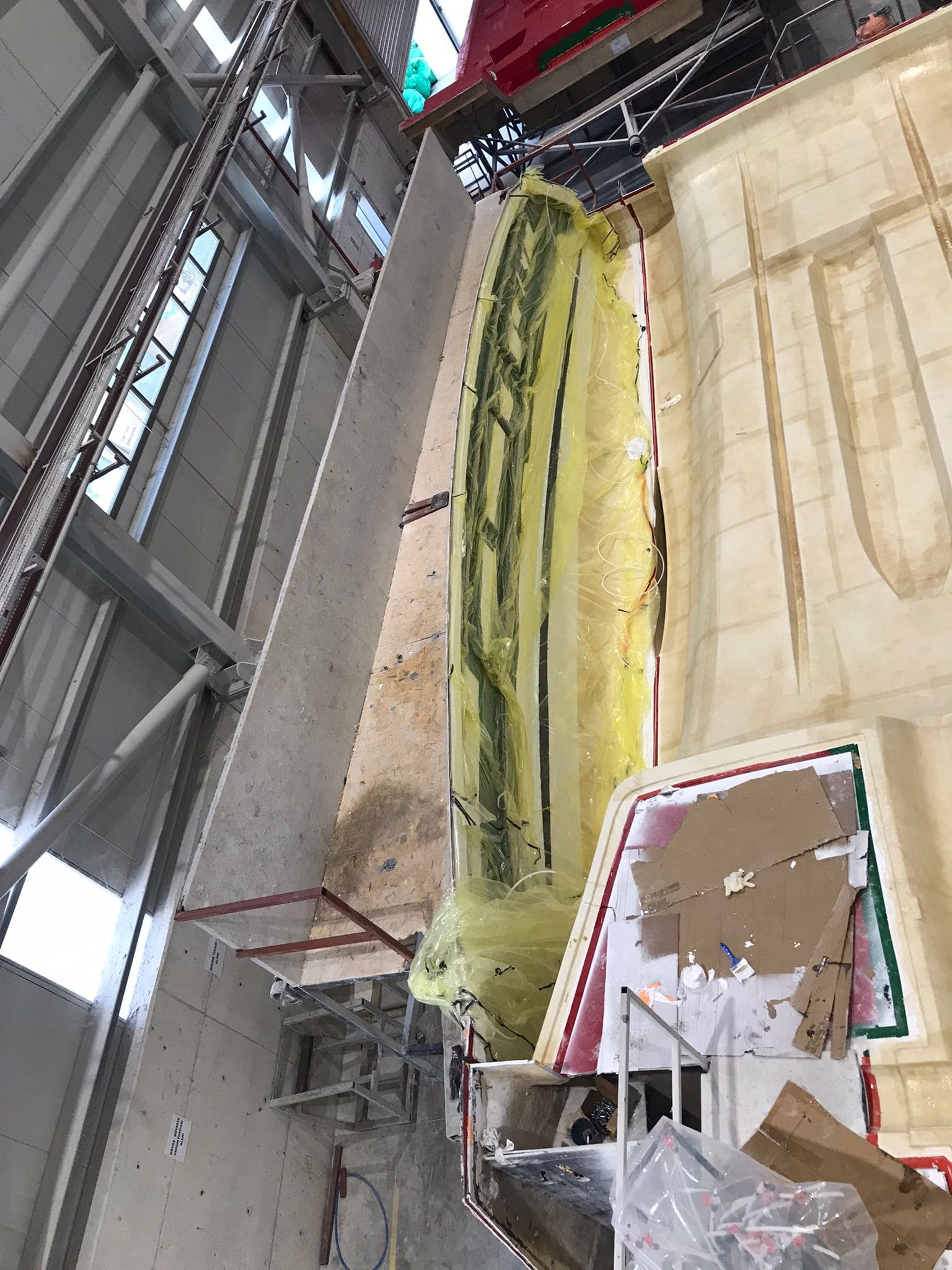

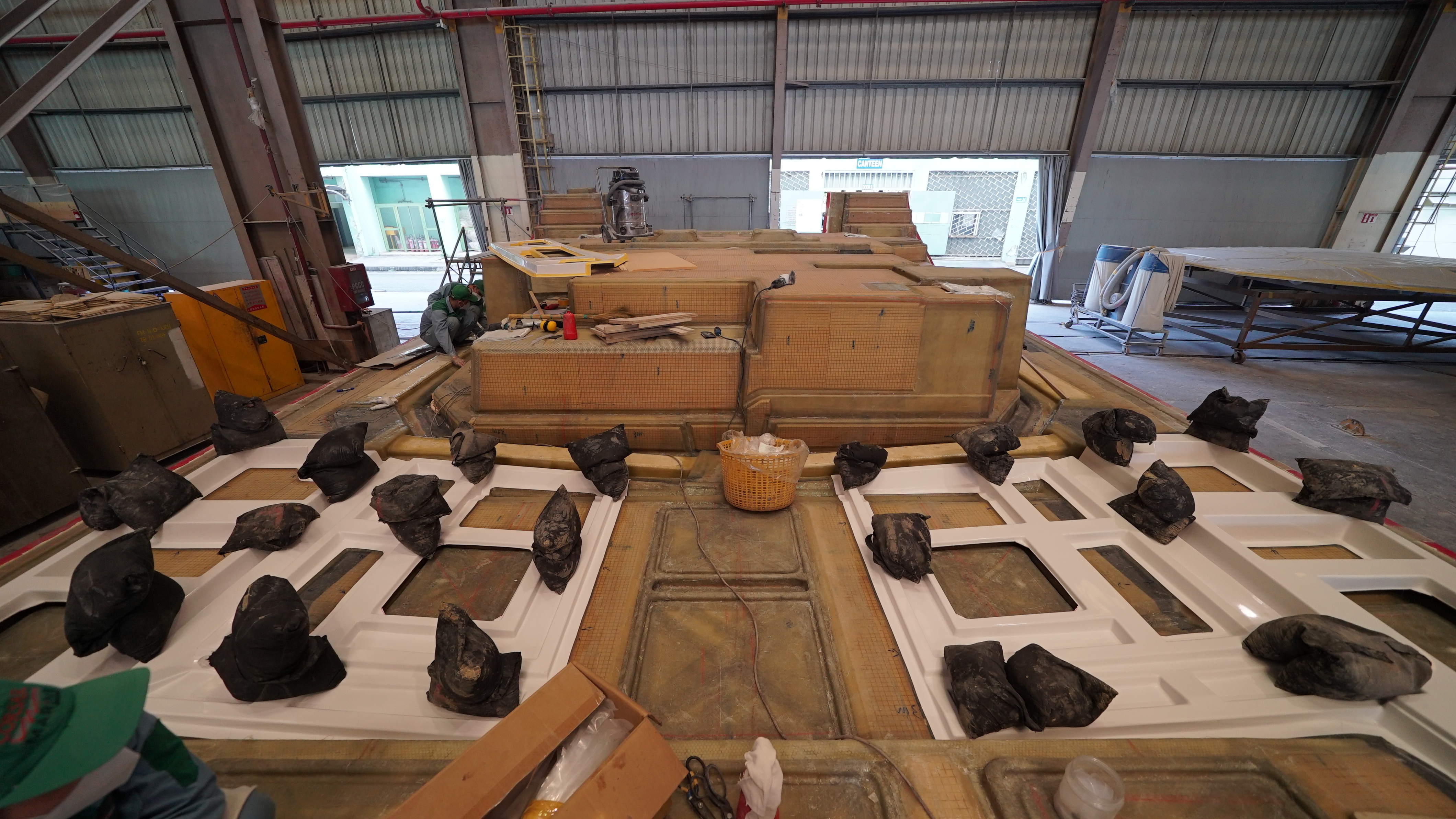

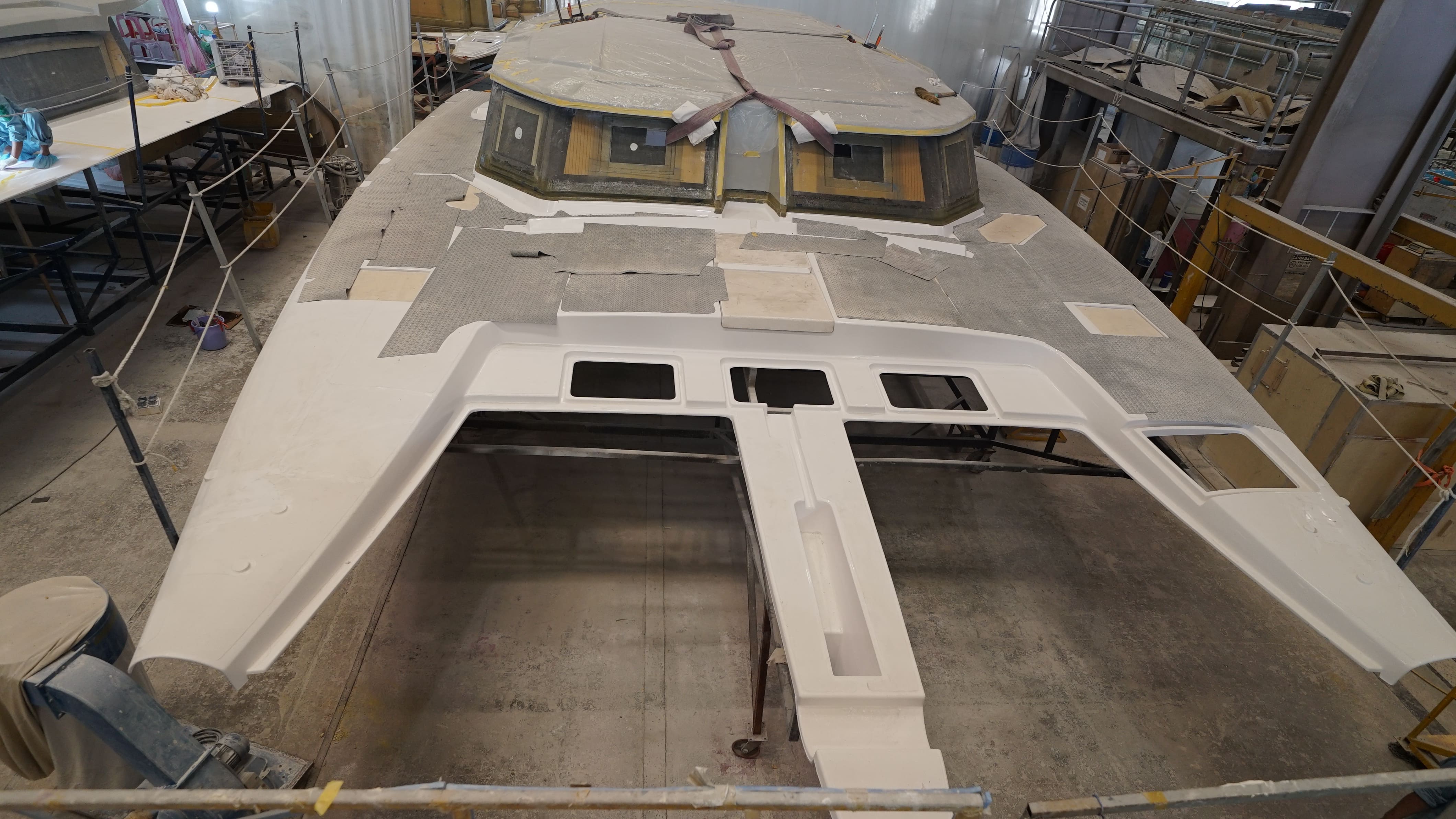

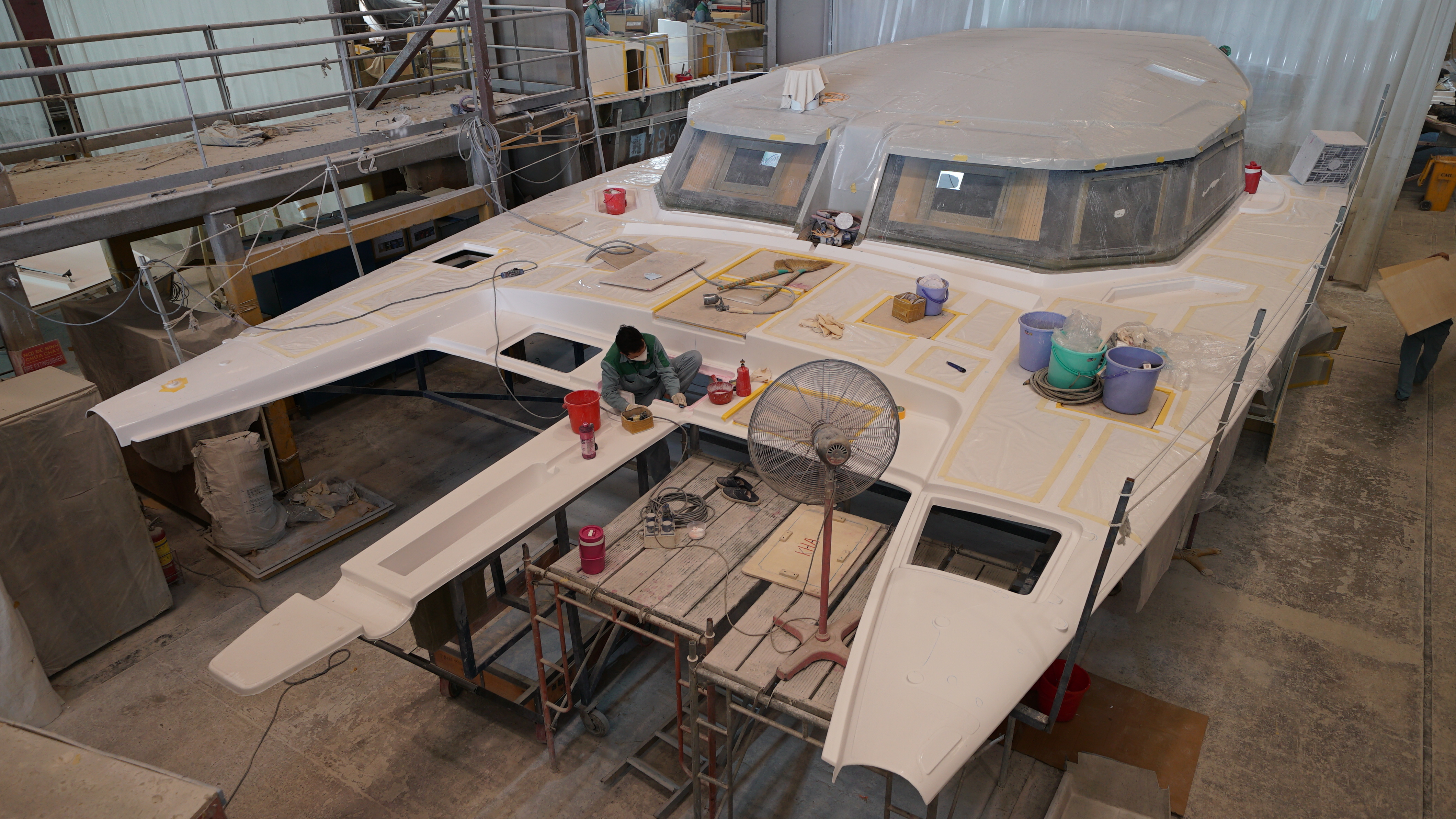

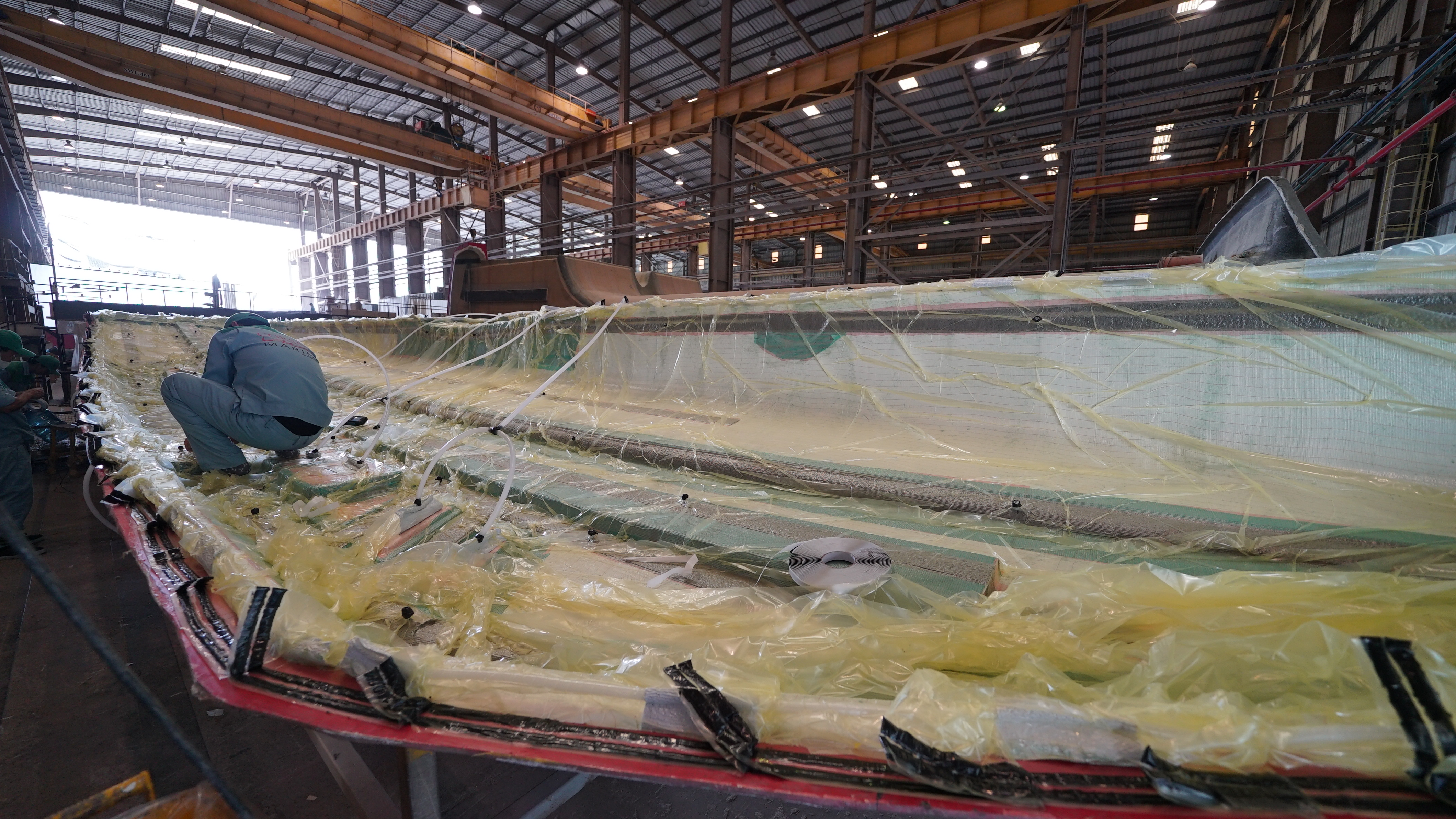

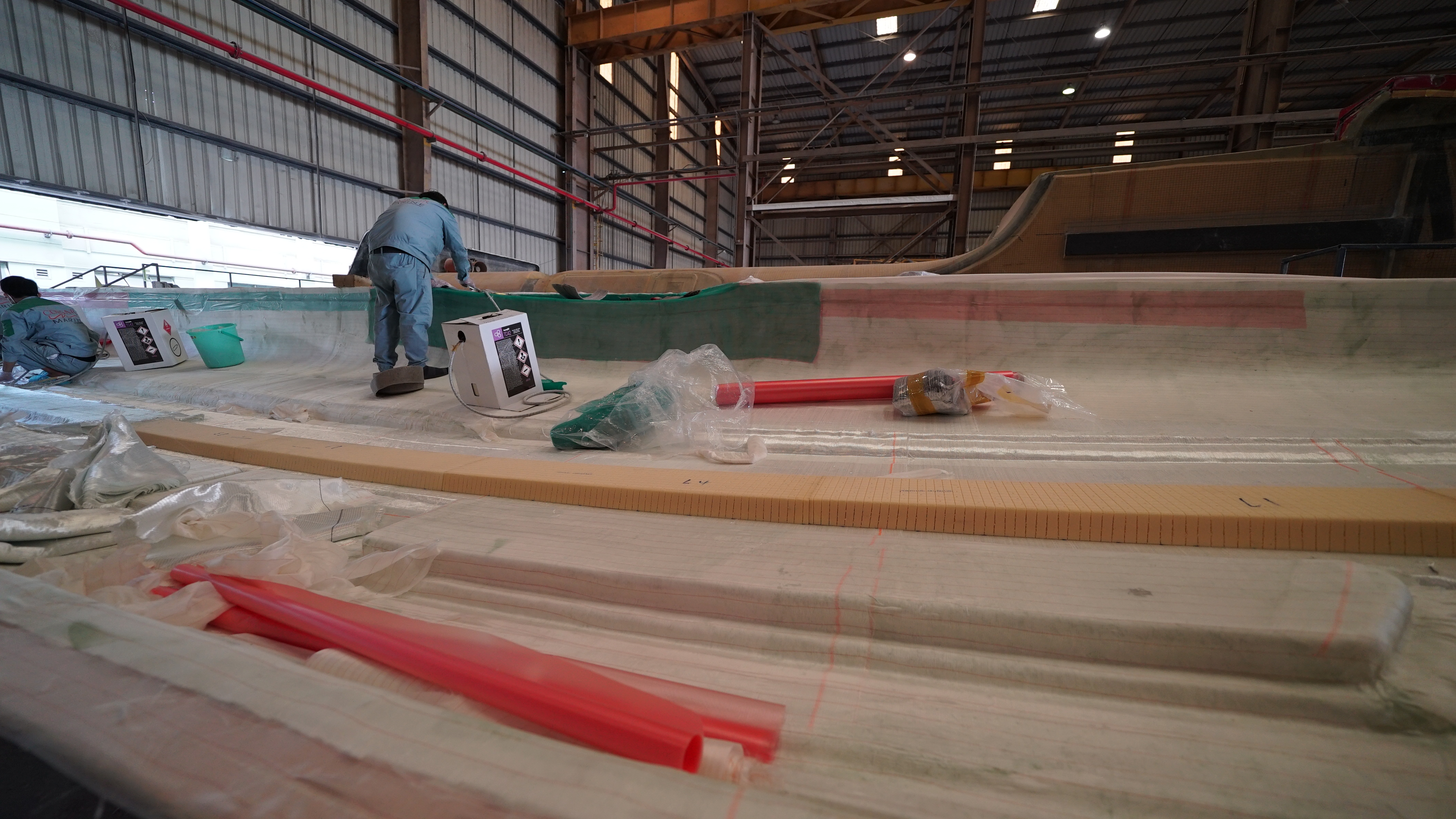

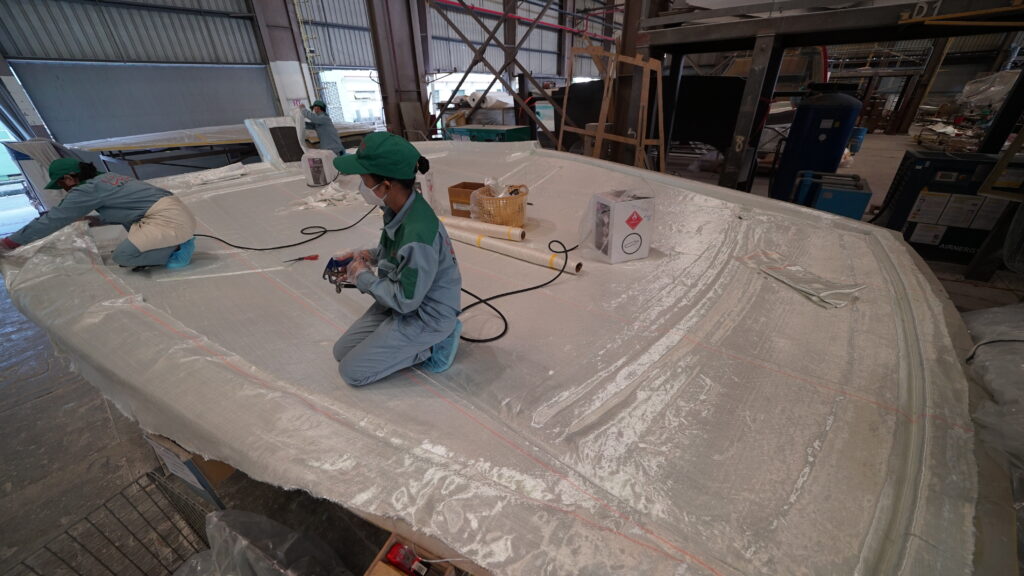

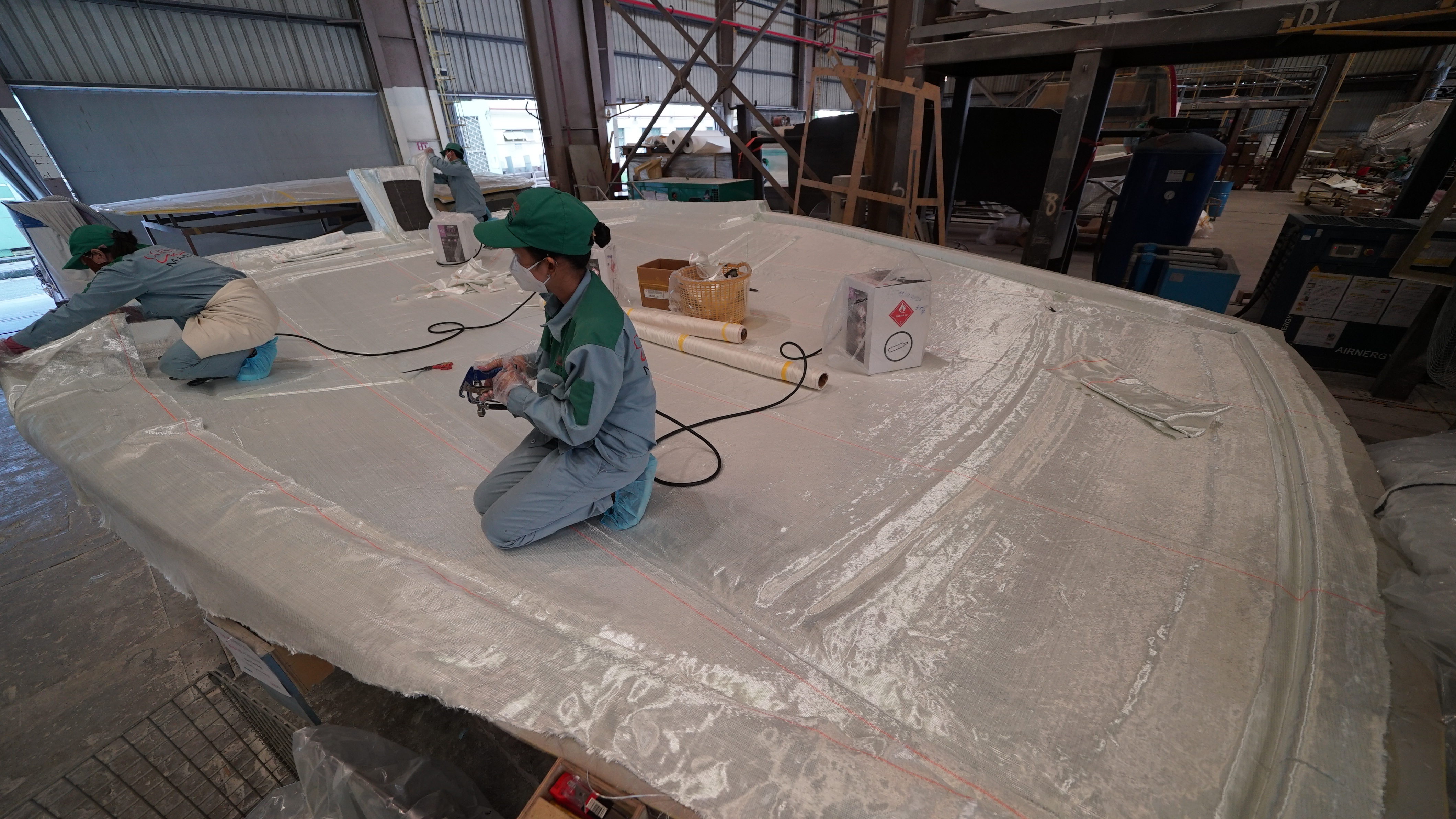

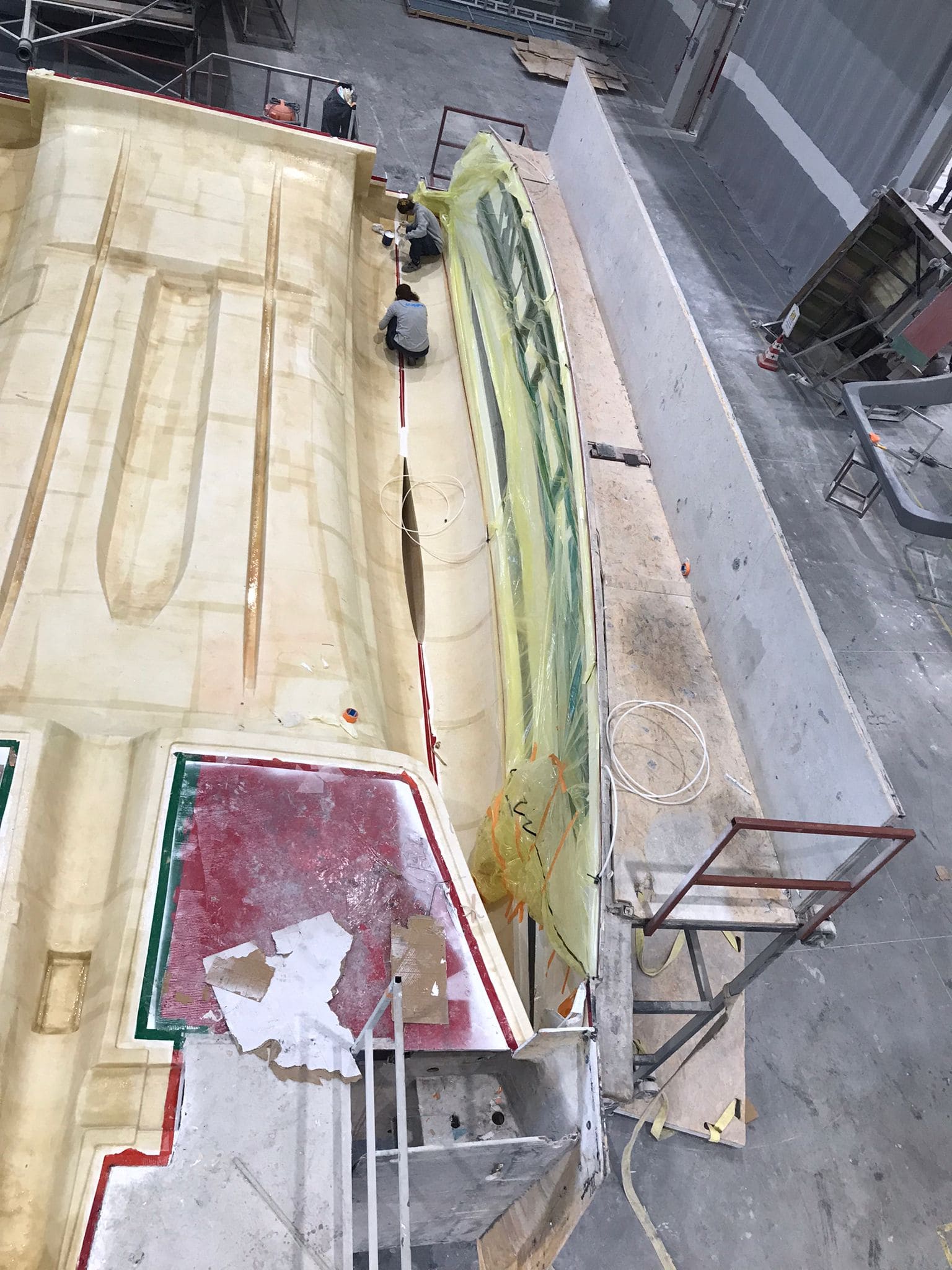

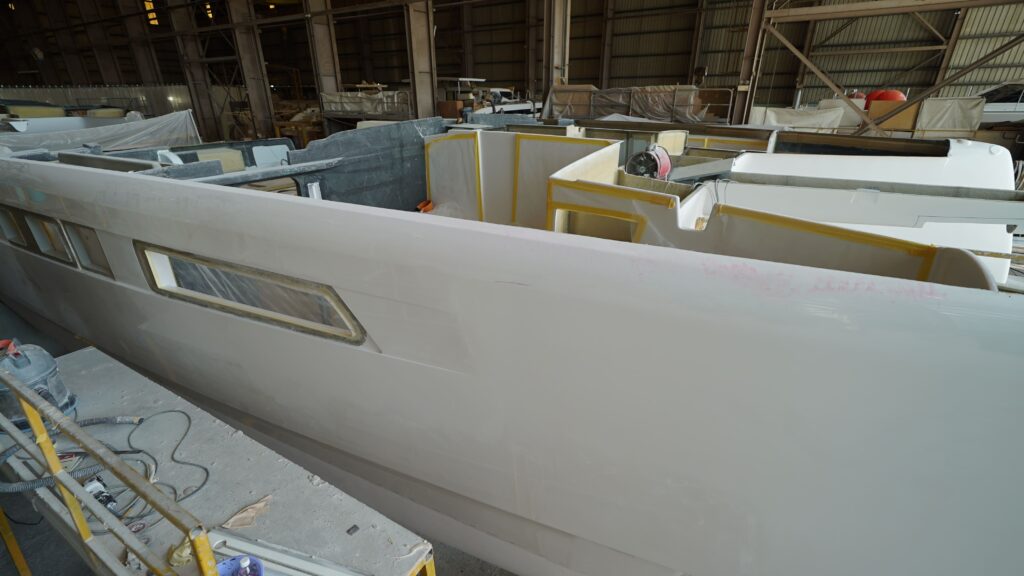

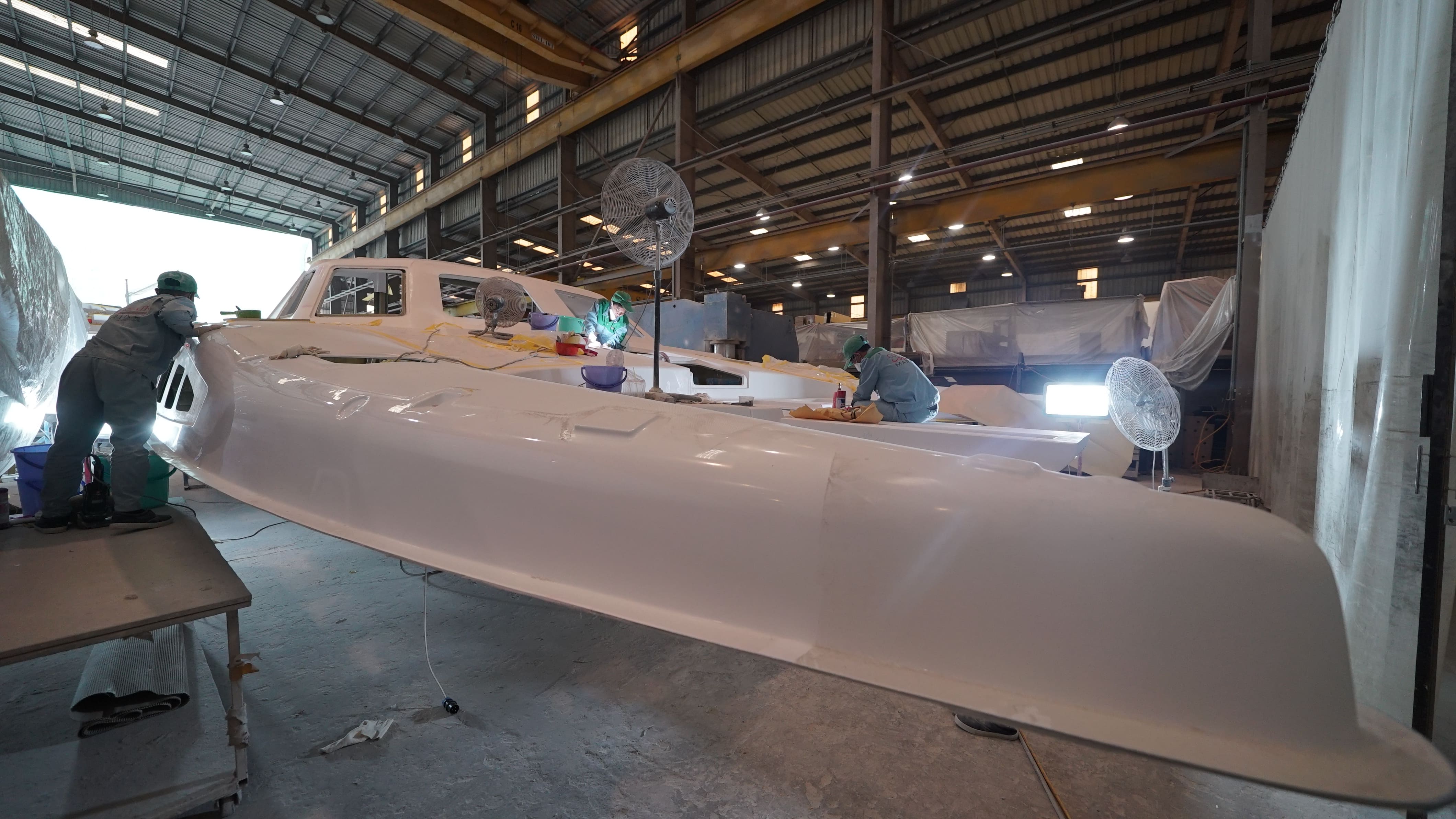

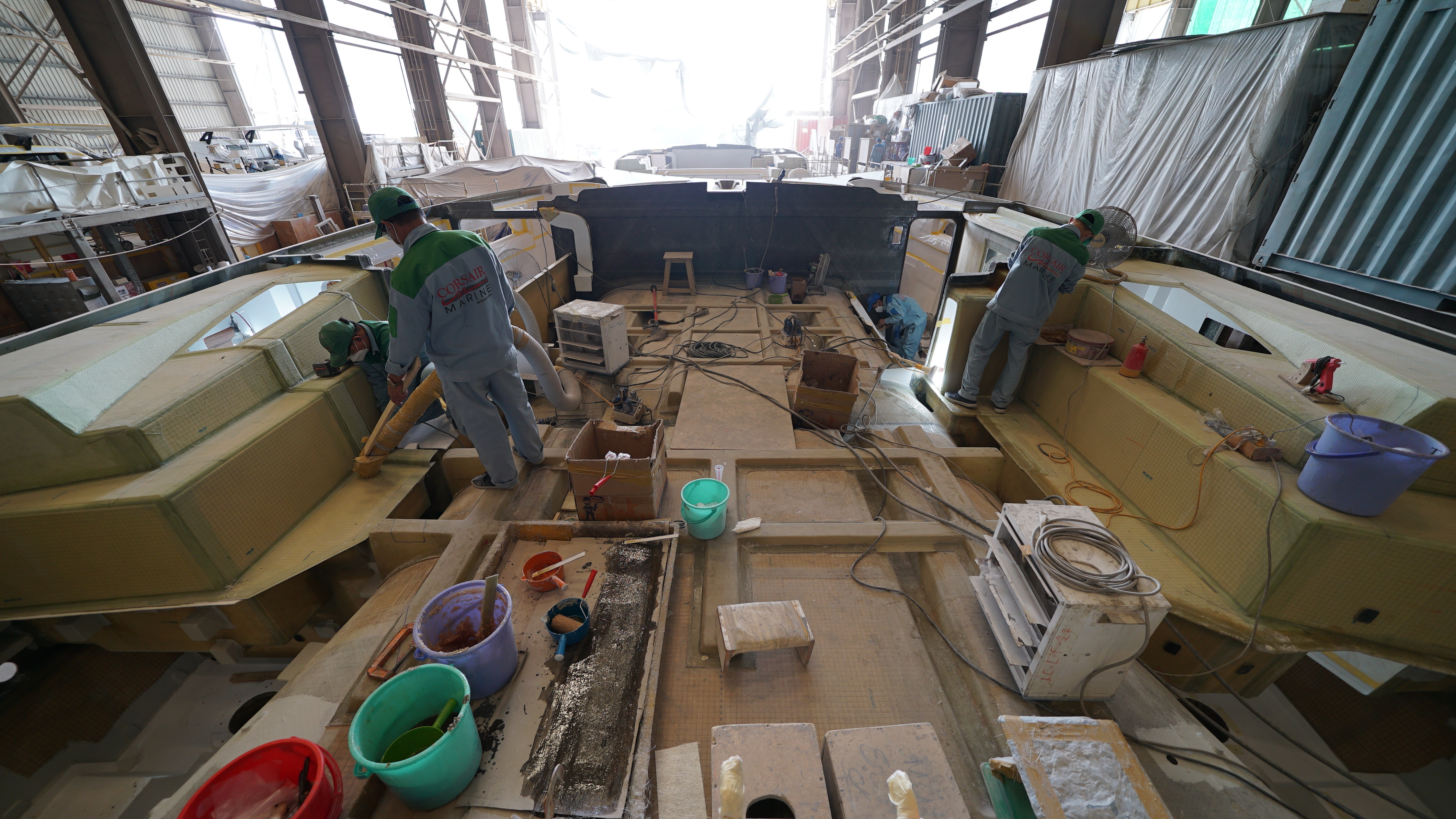

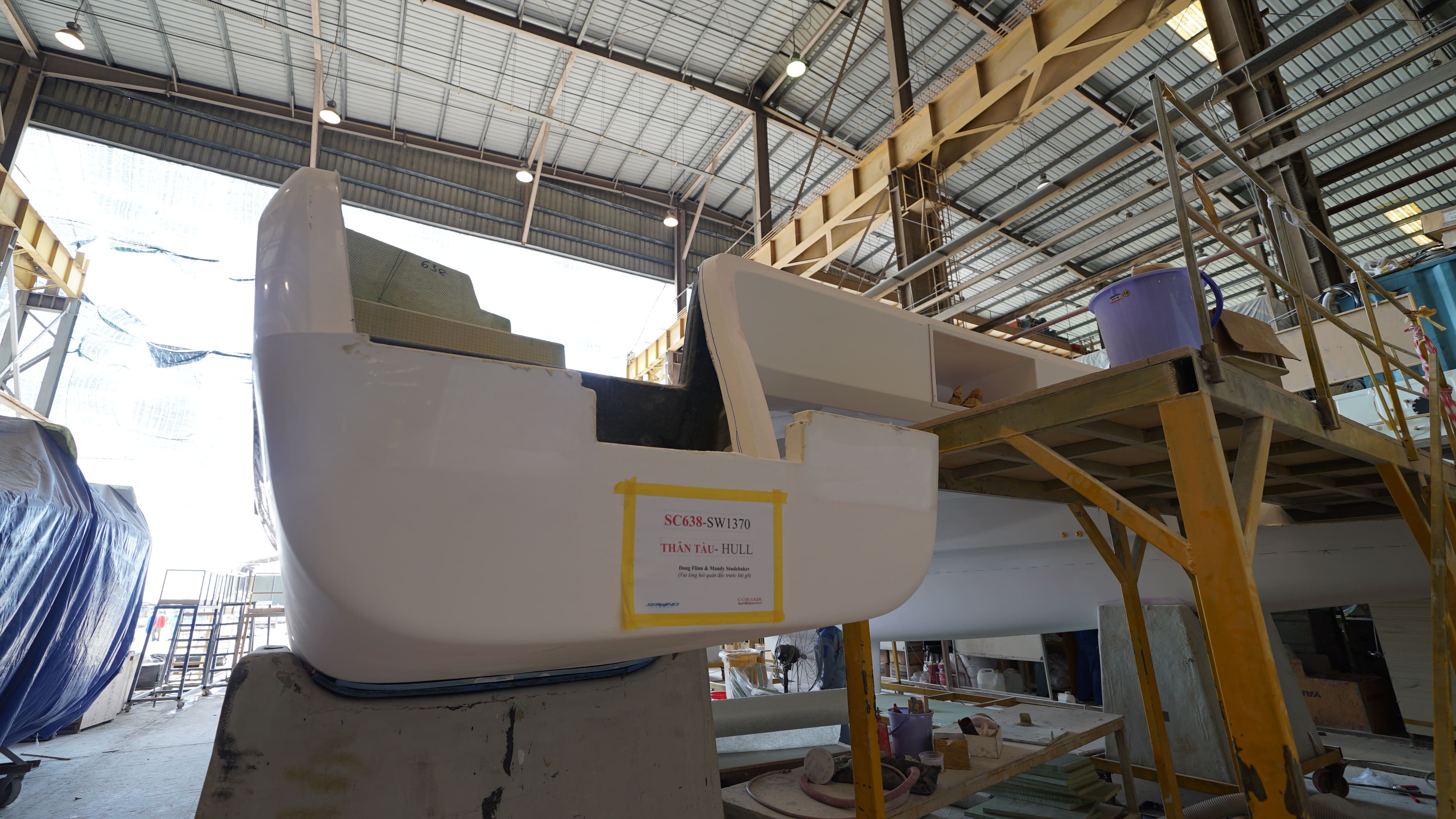

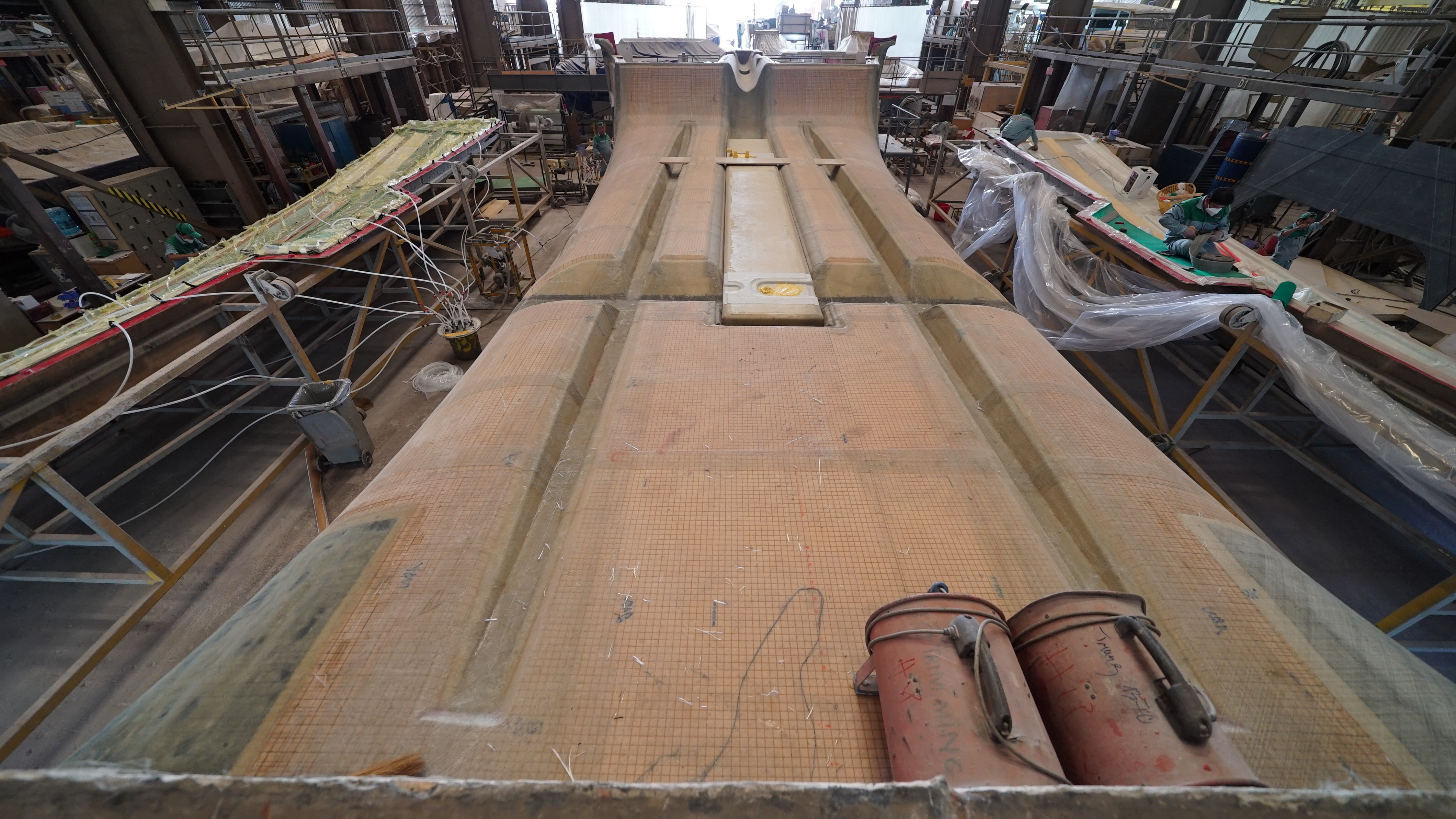

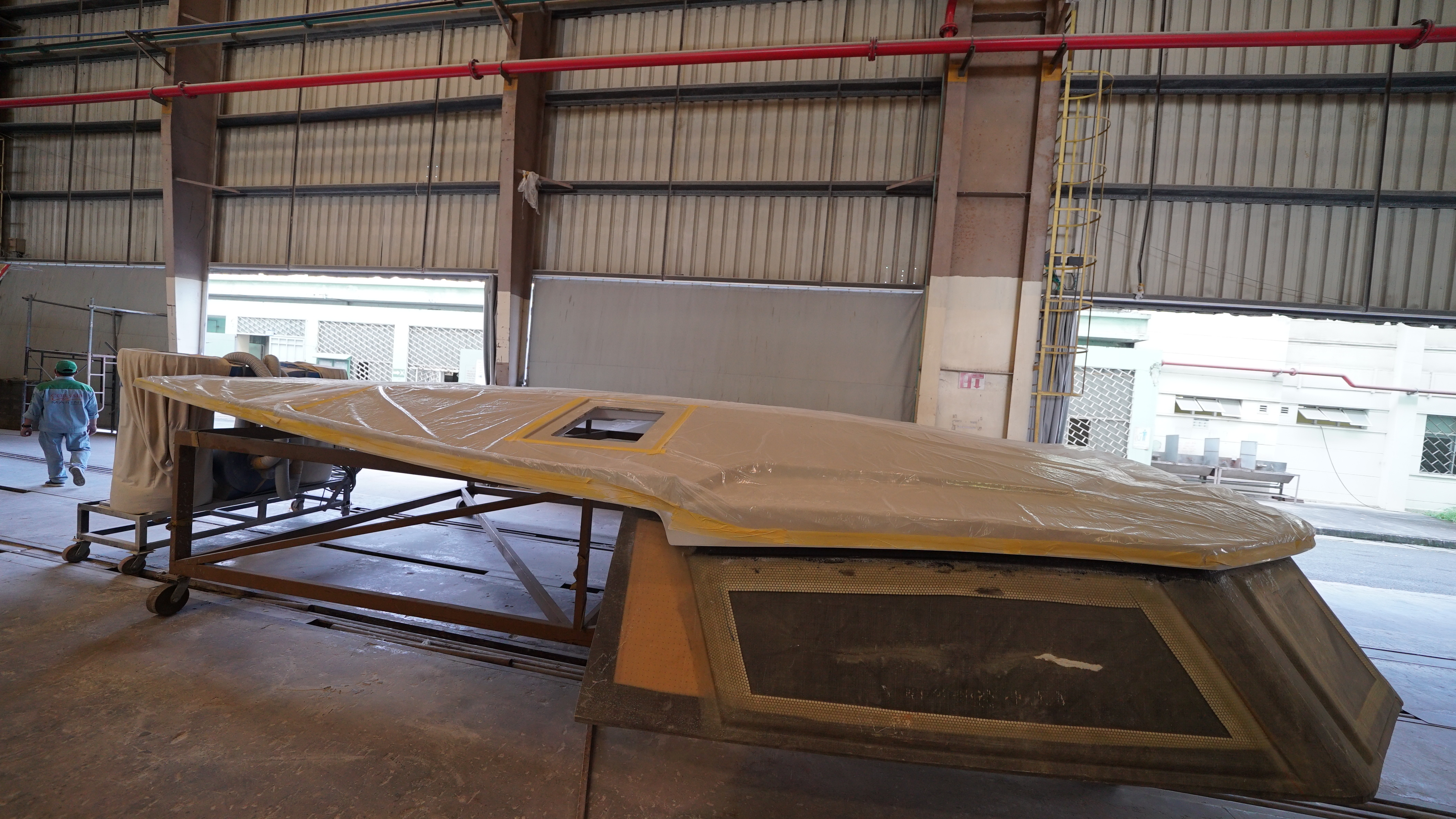

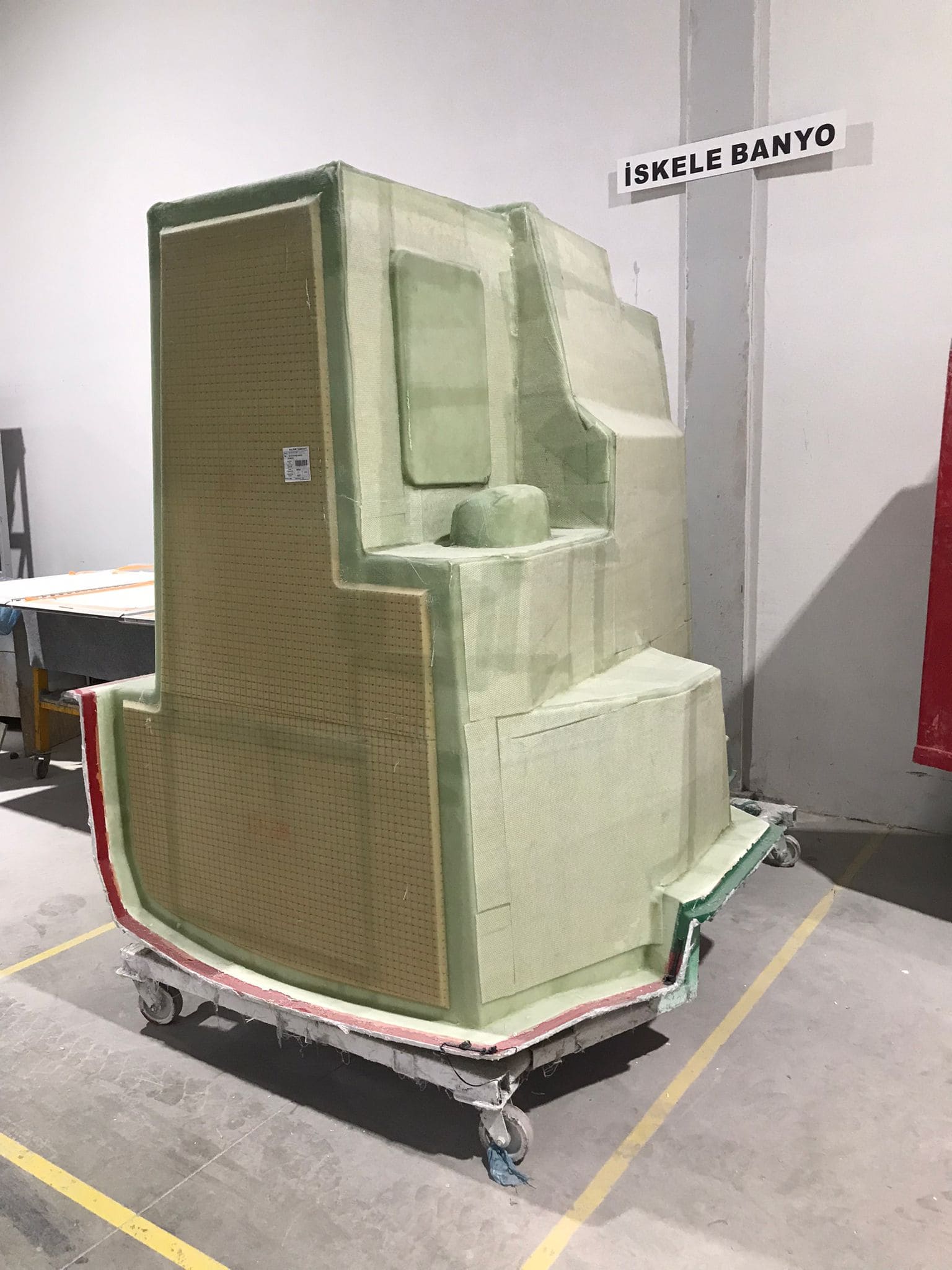

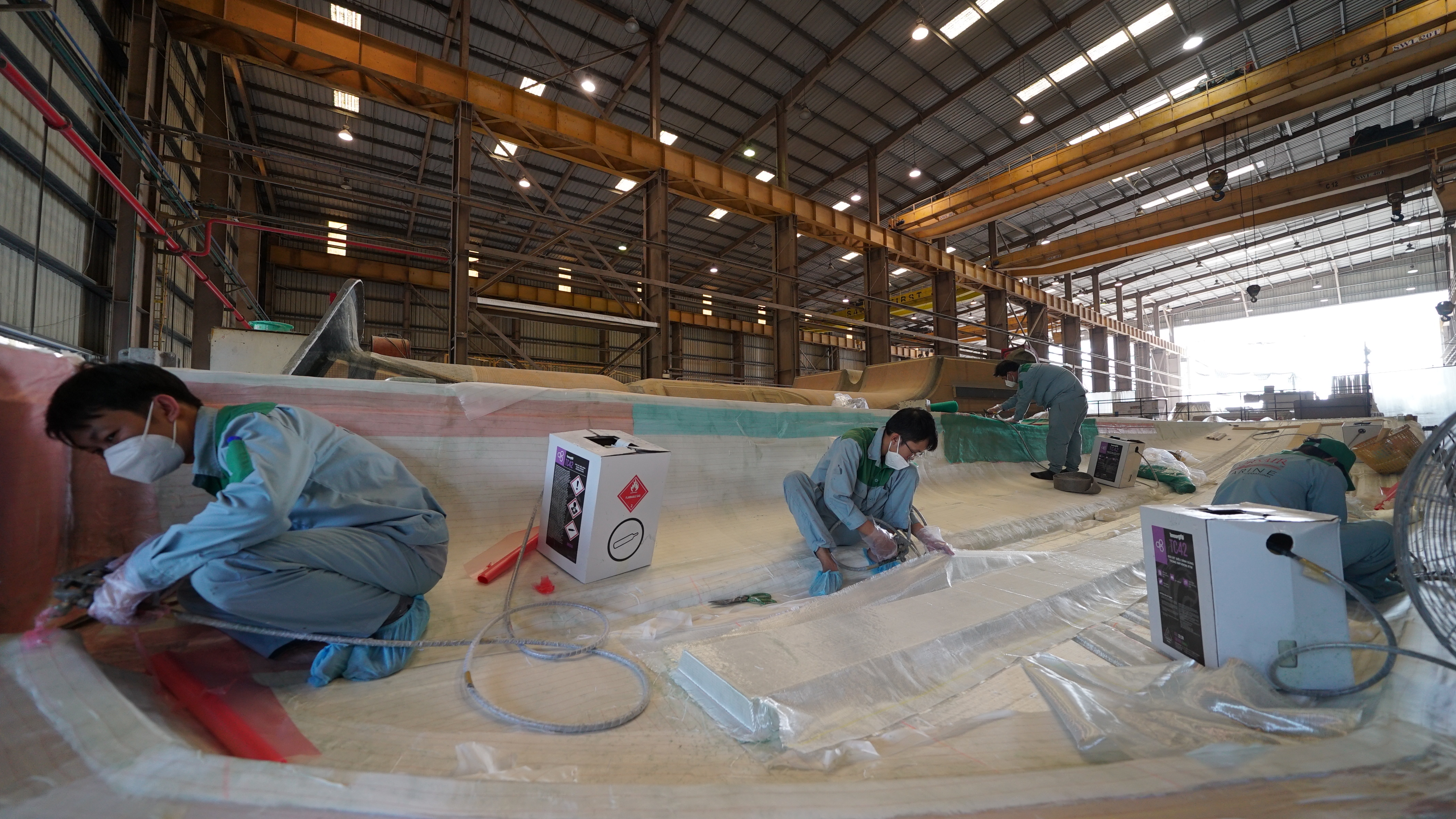

An exciting journey has started. Your boat is making progress in the first stage of production – Lamination.

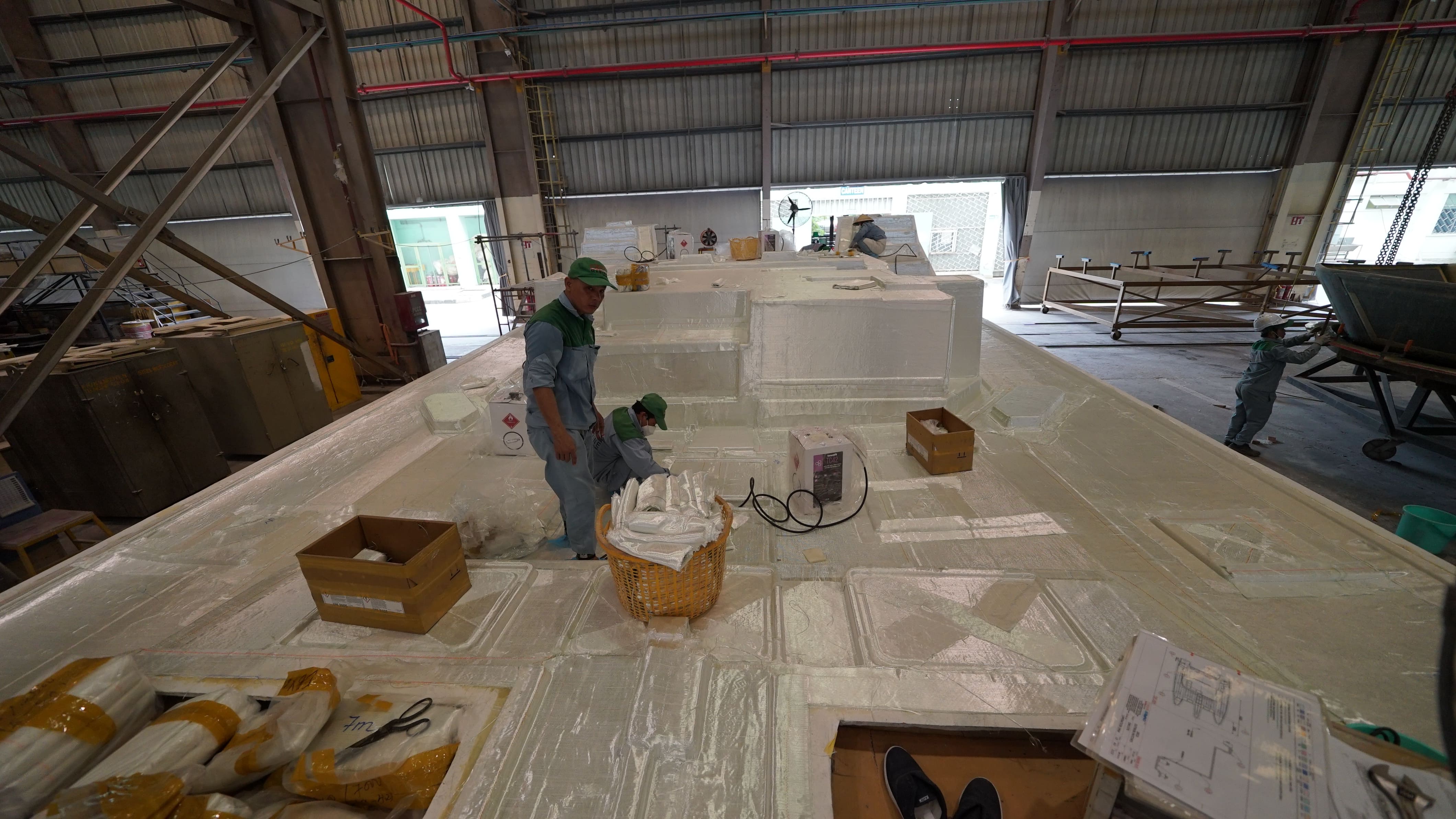

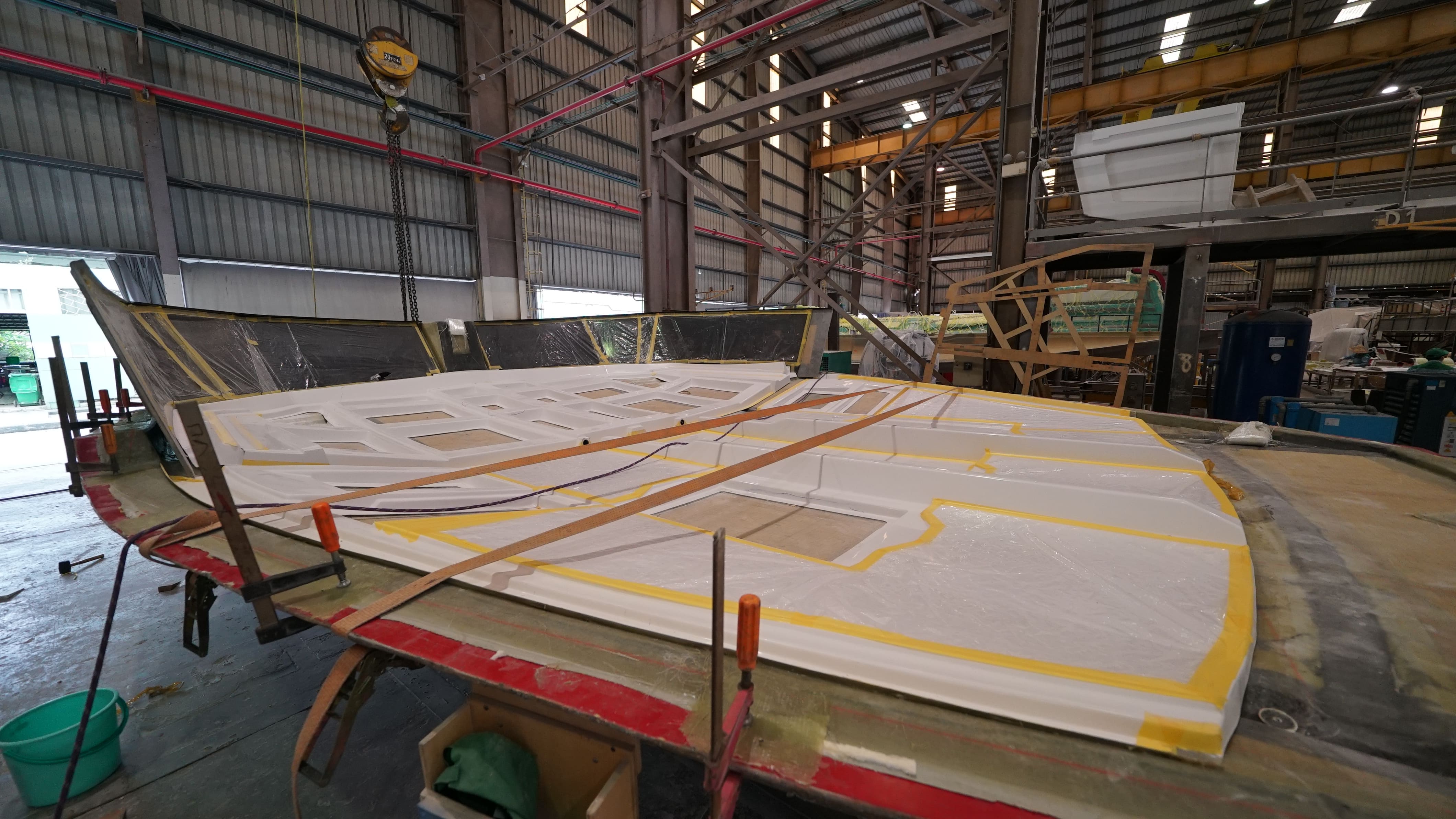

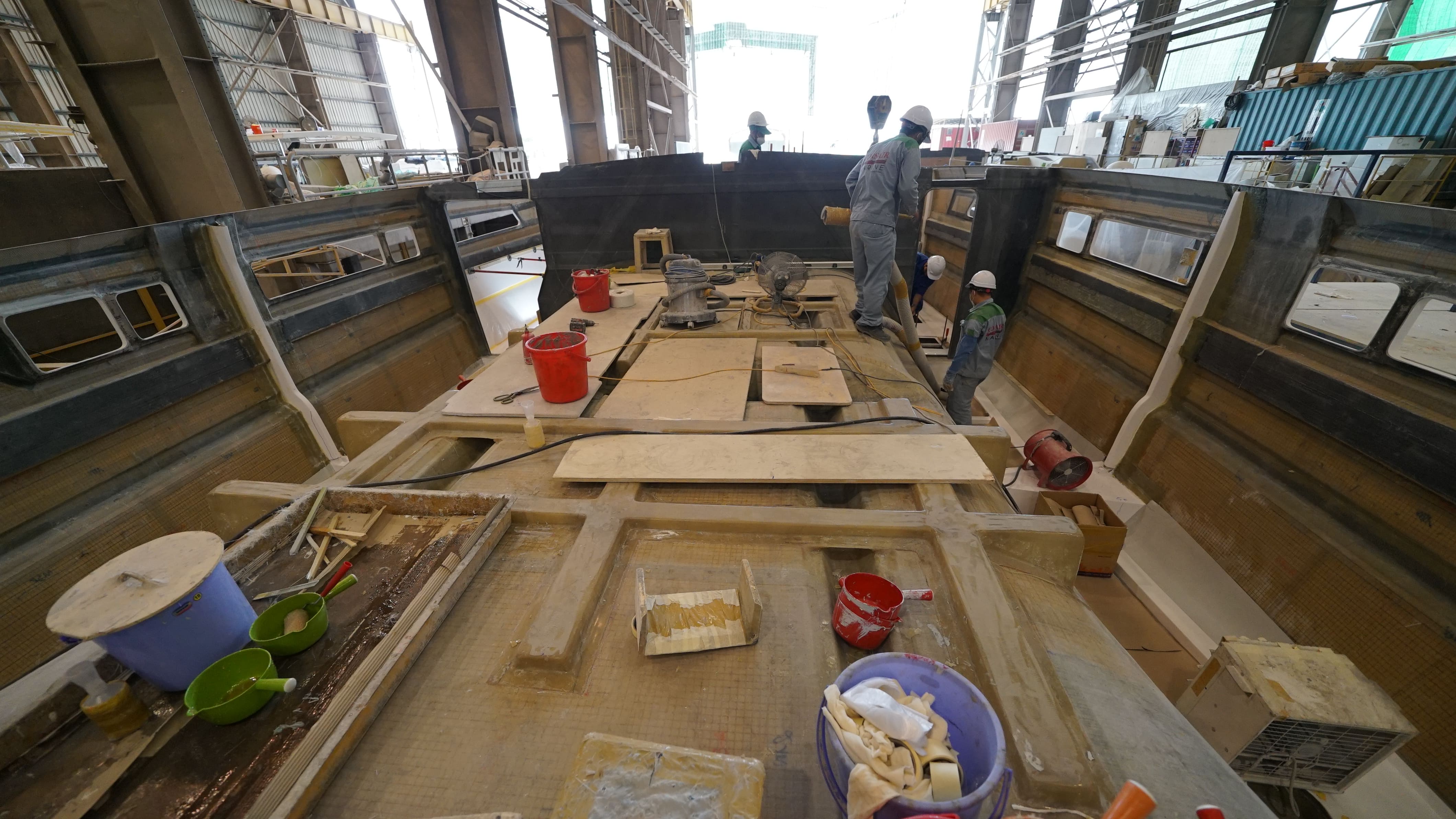

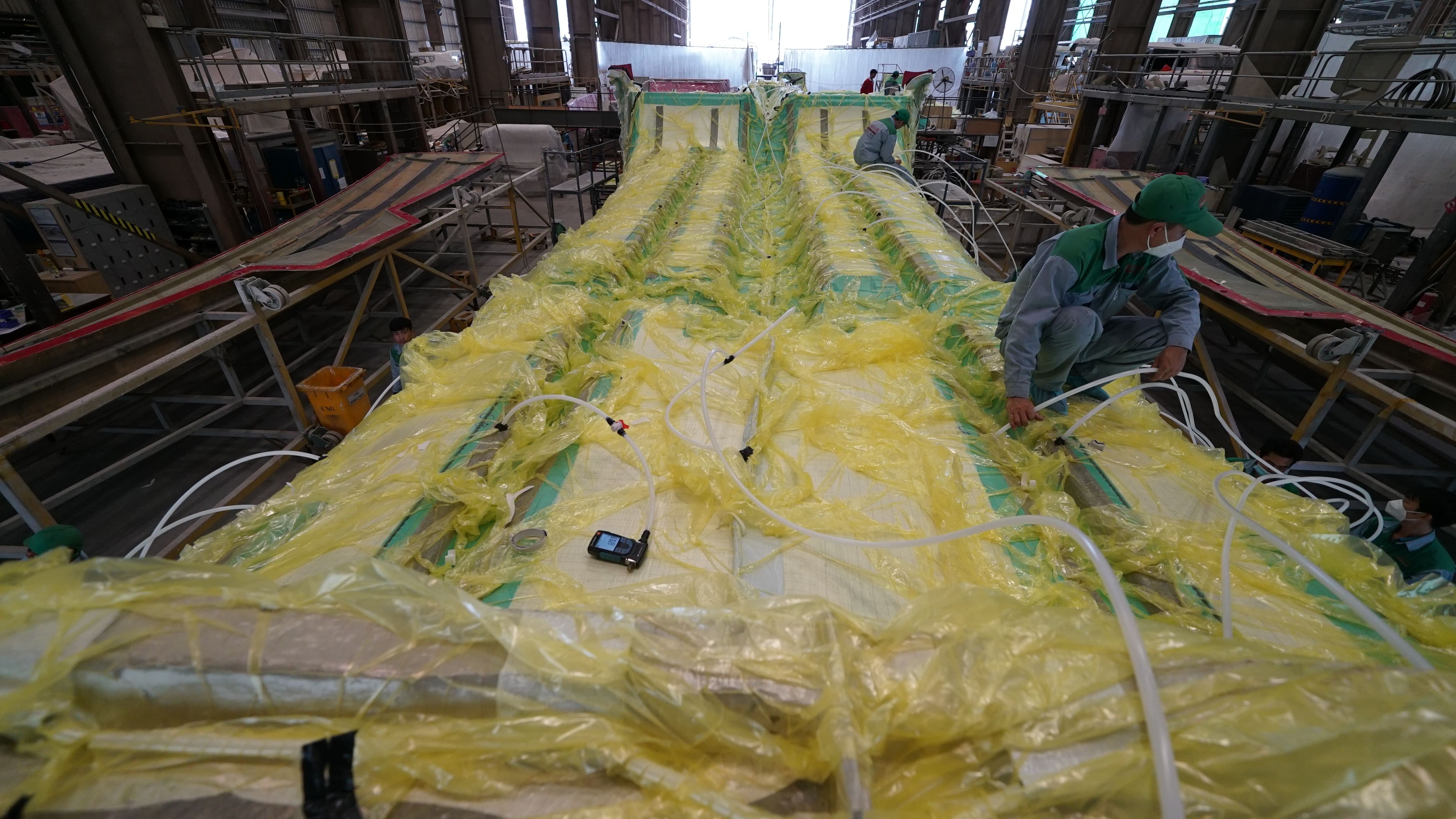

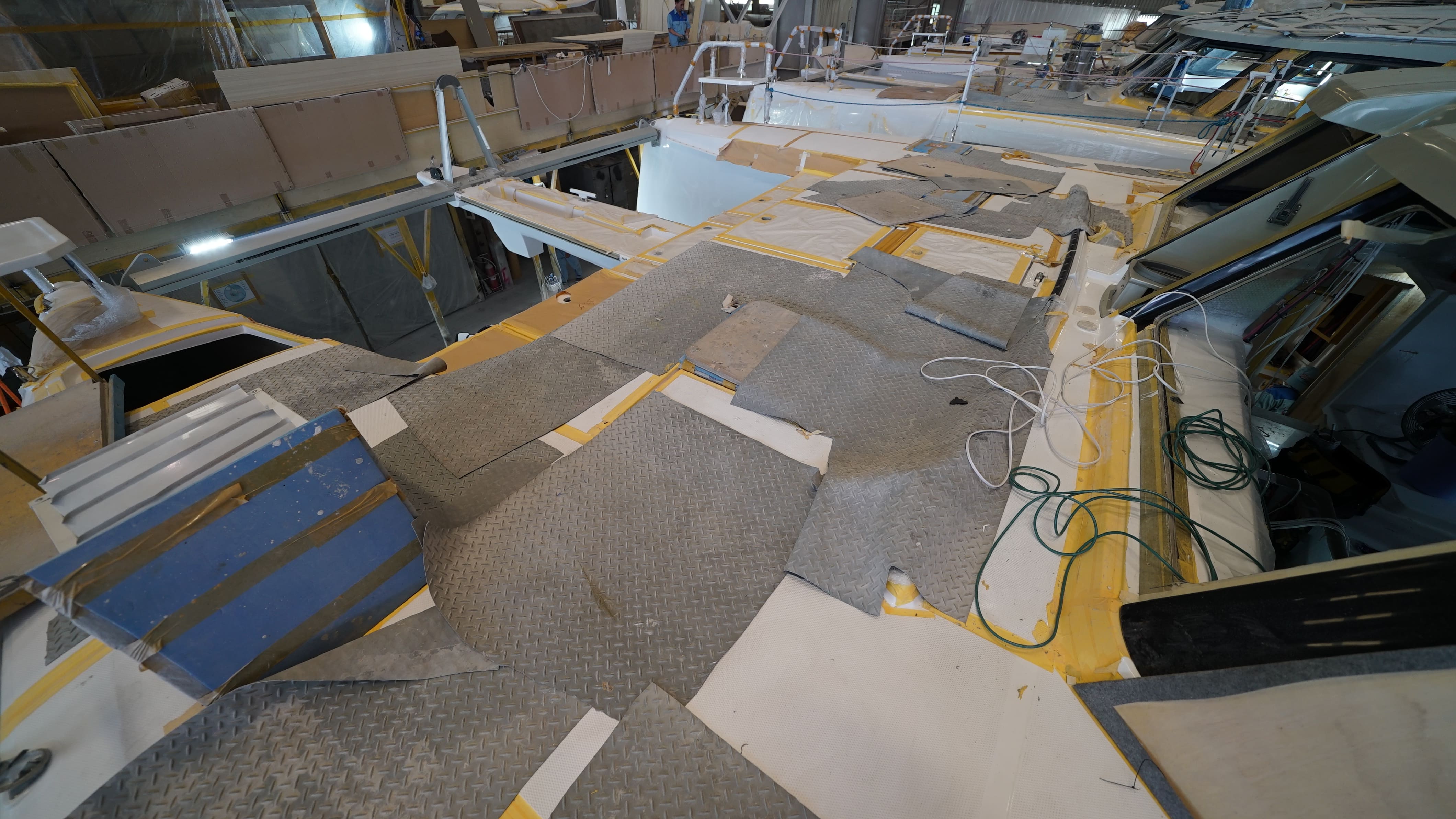

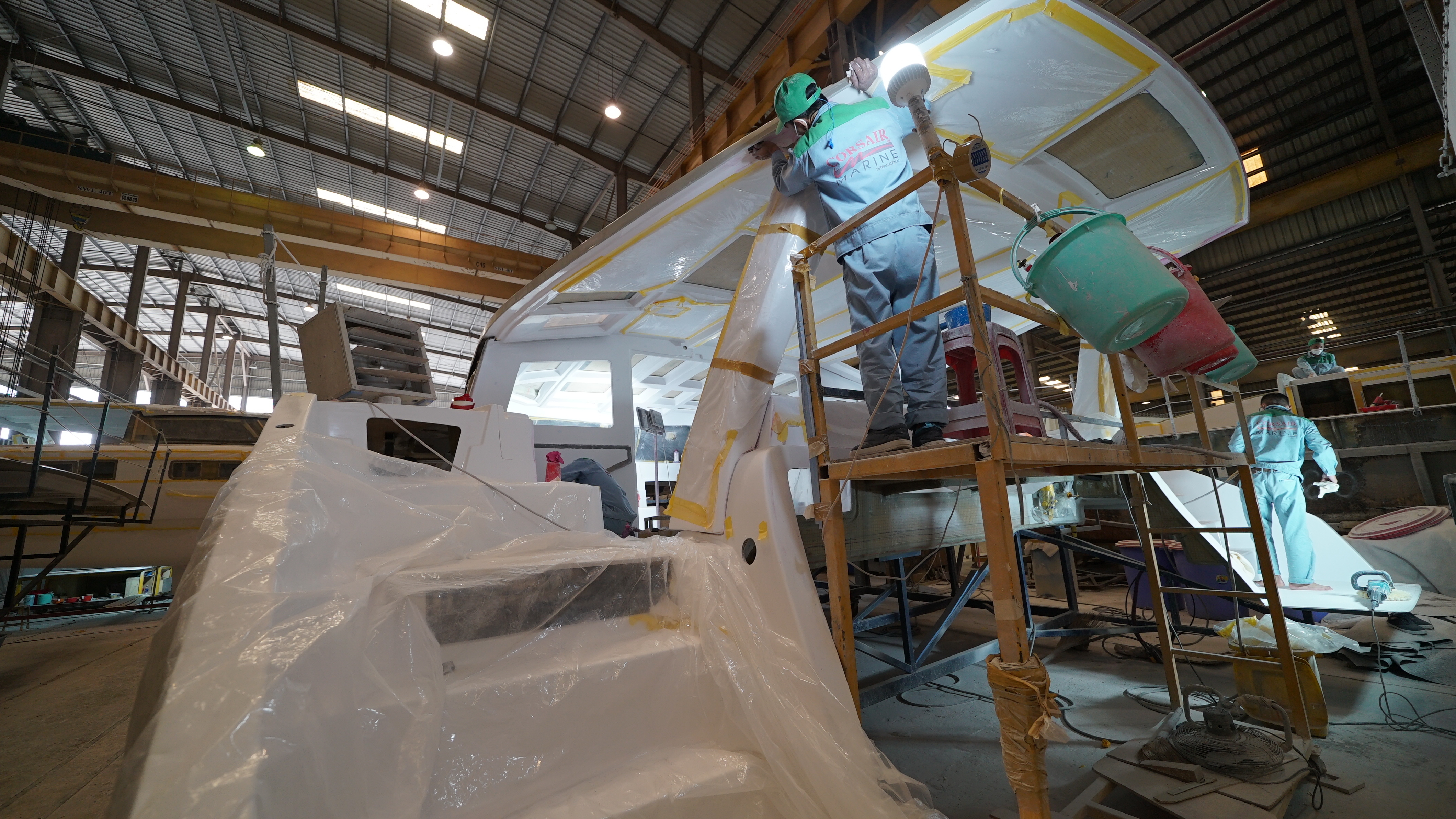

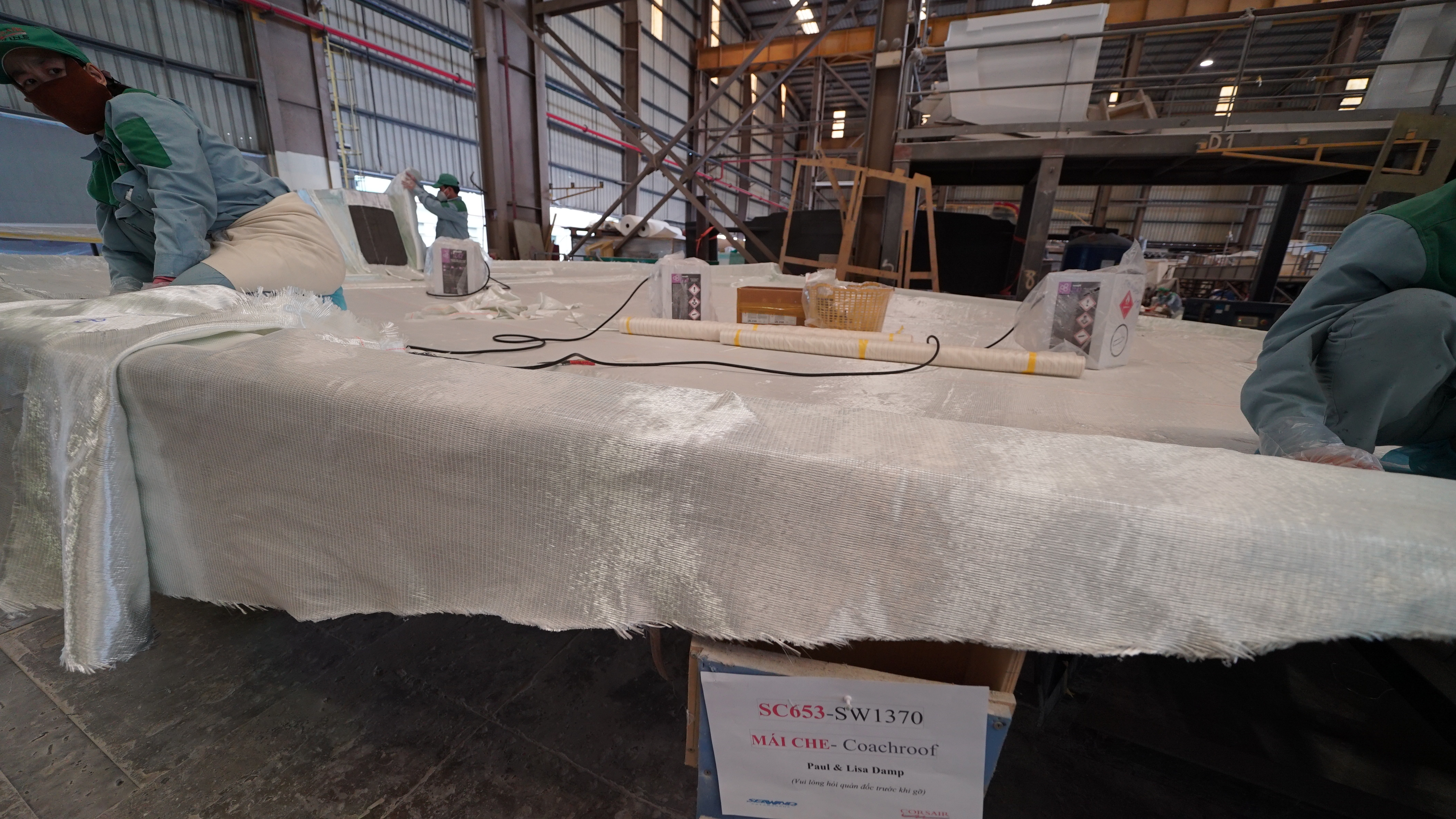

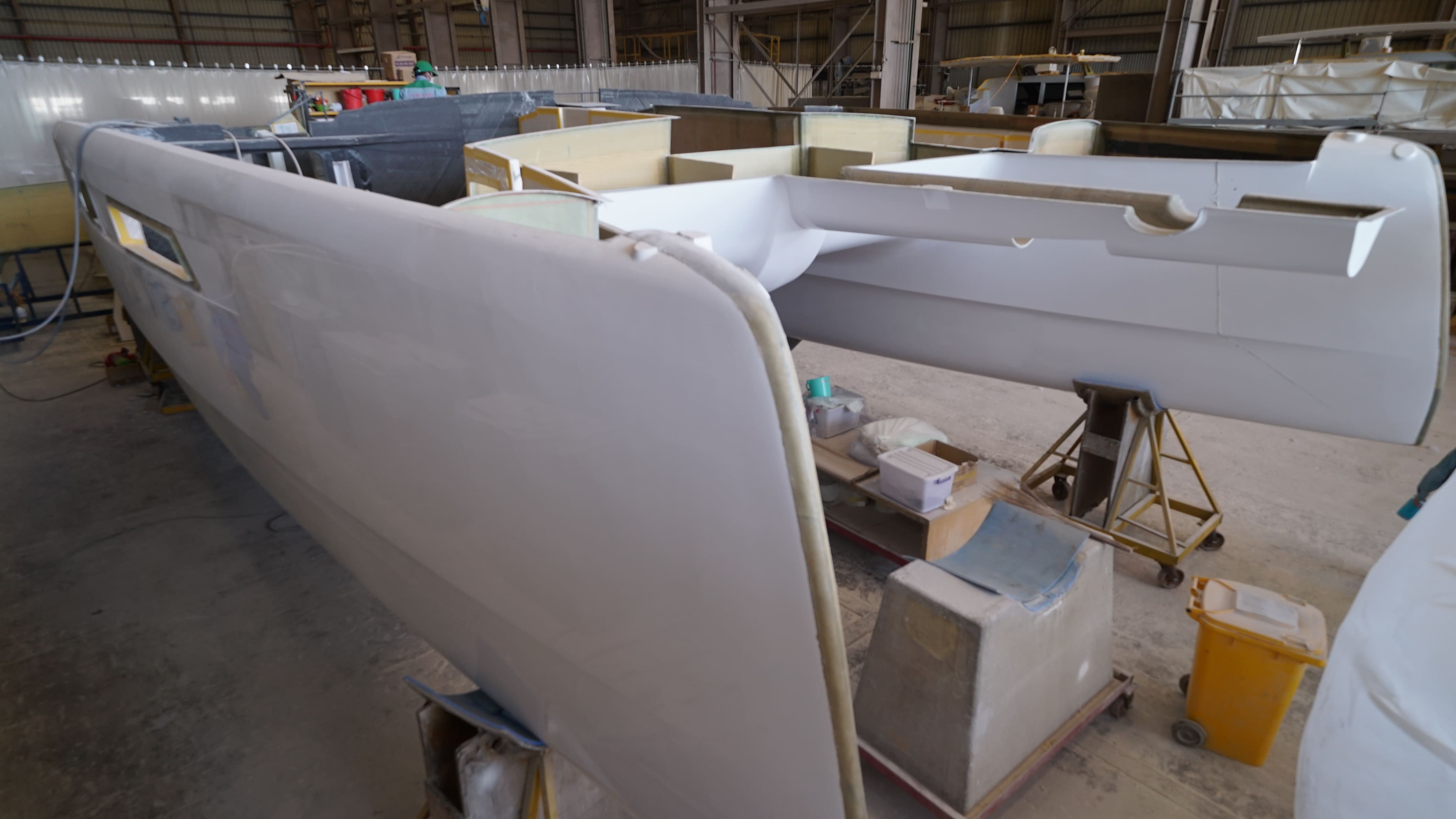

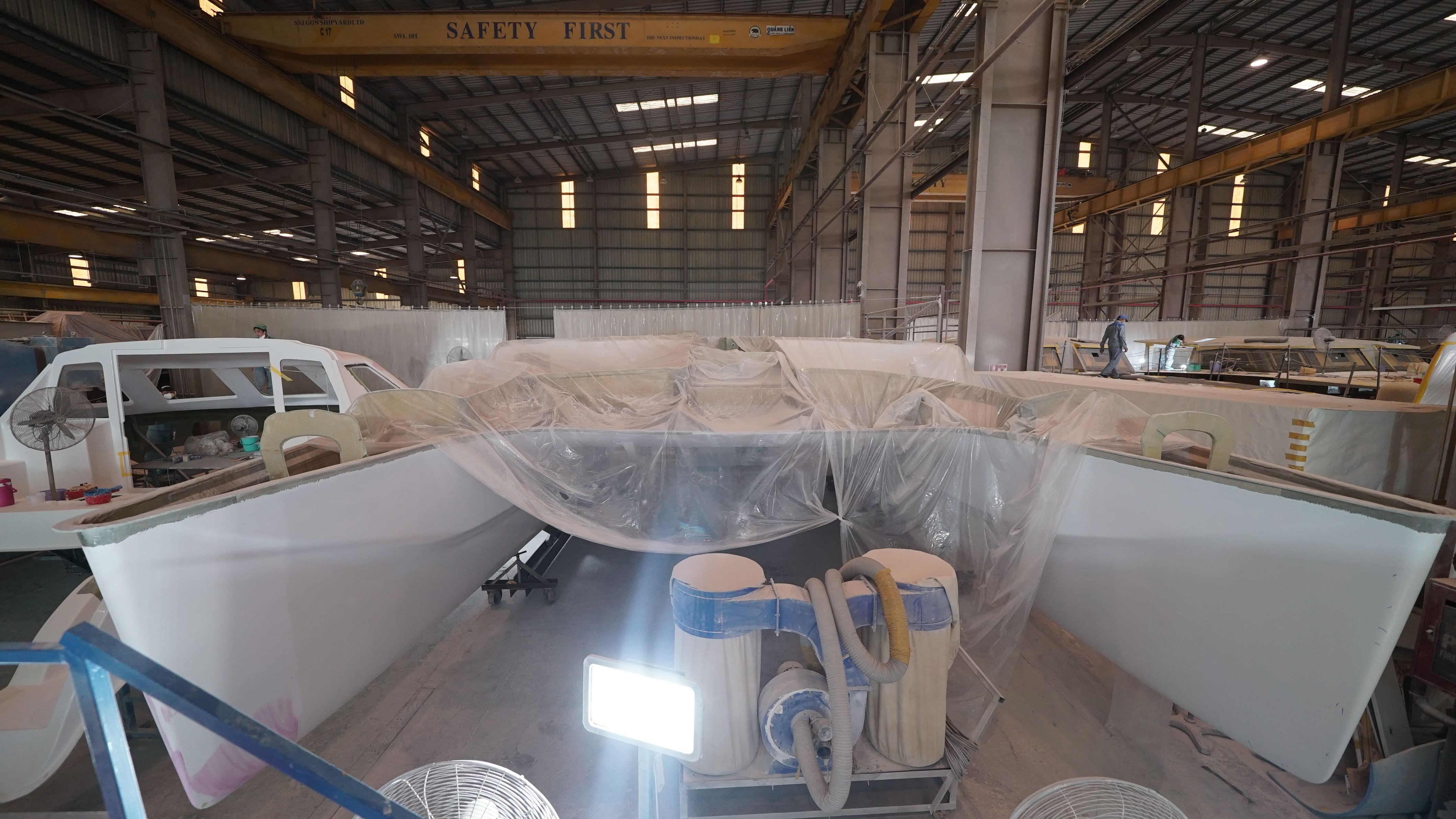

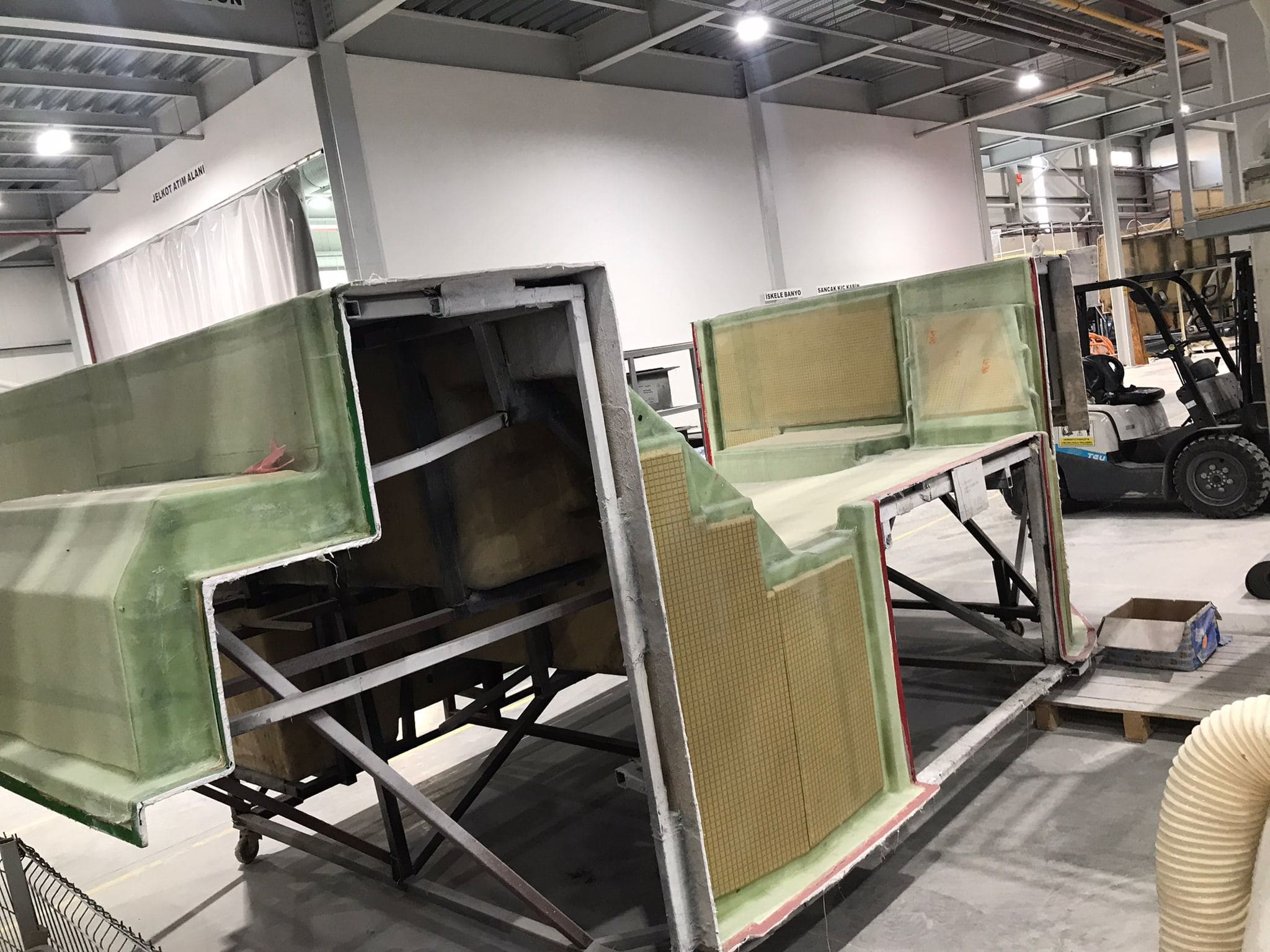

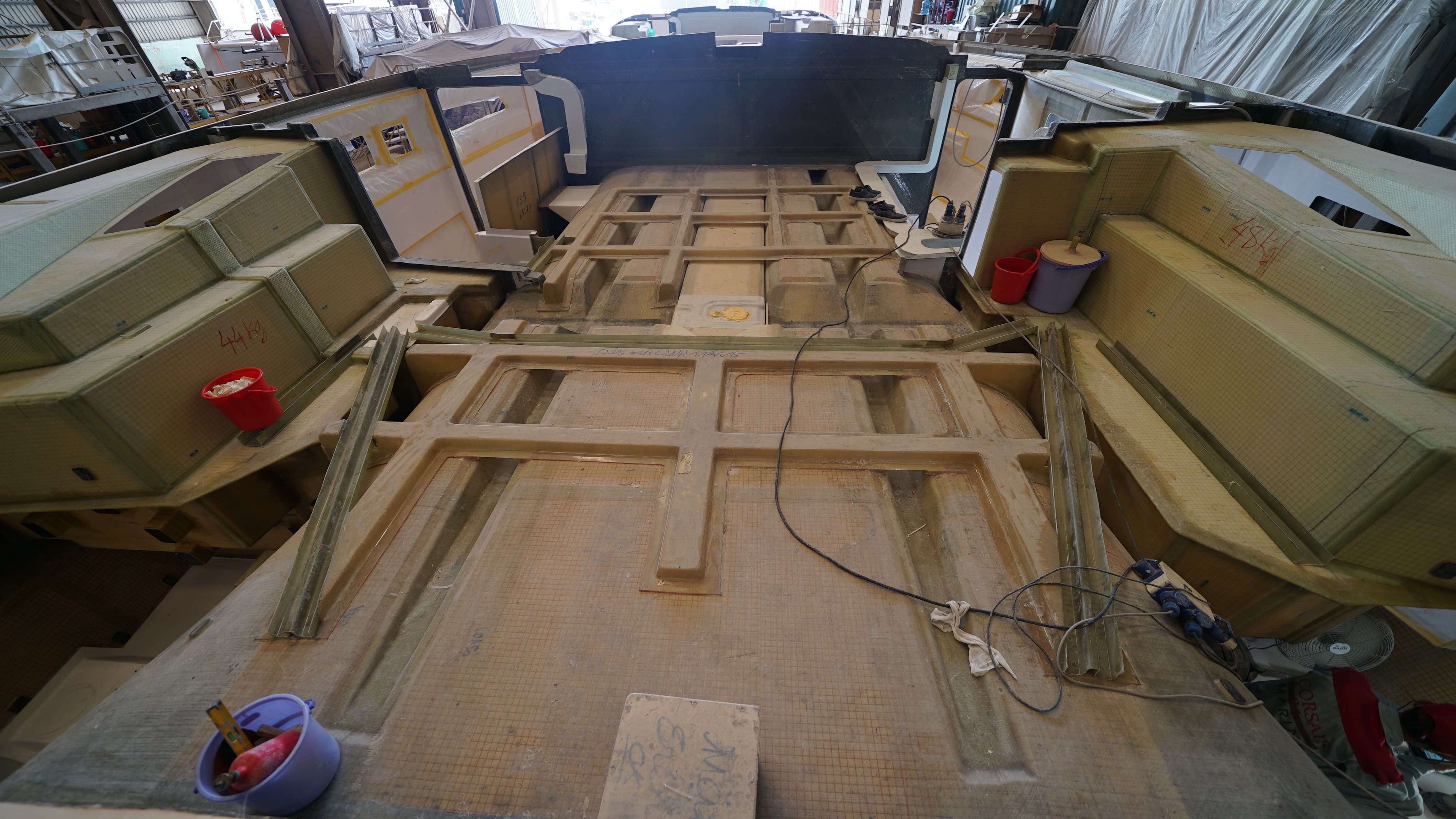

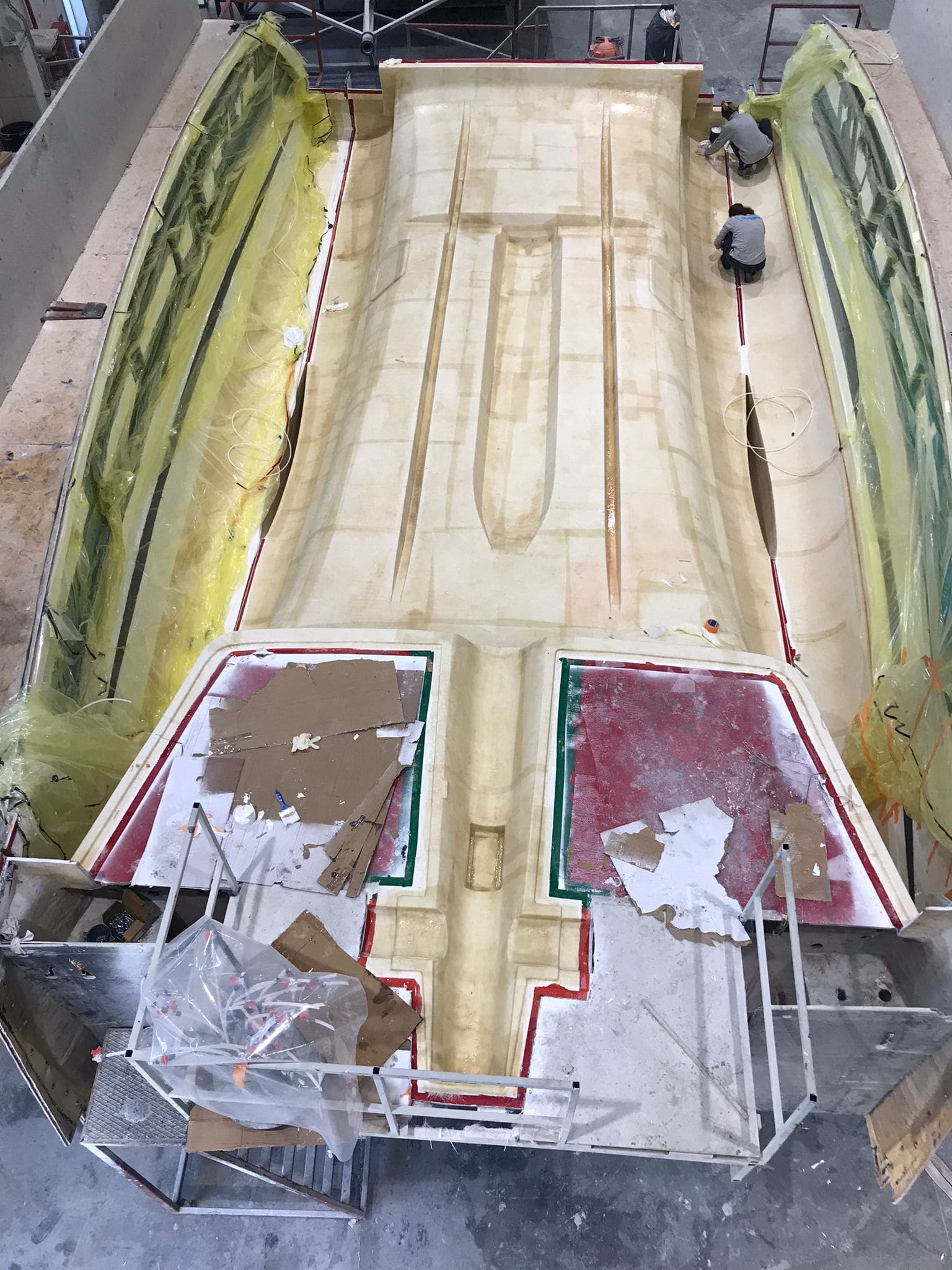

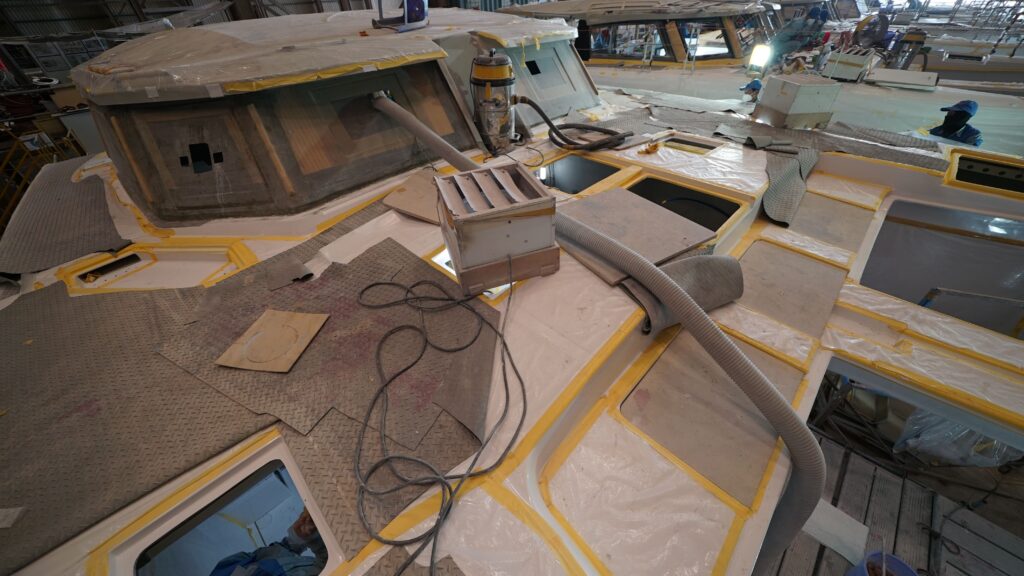

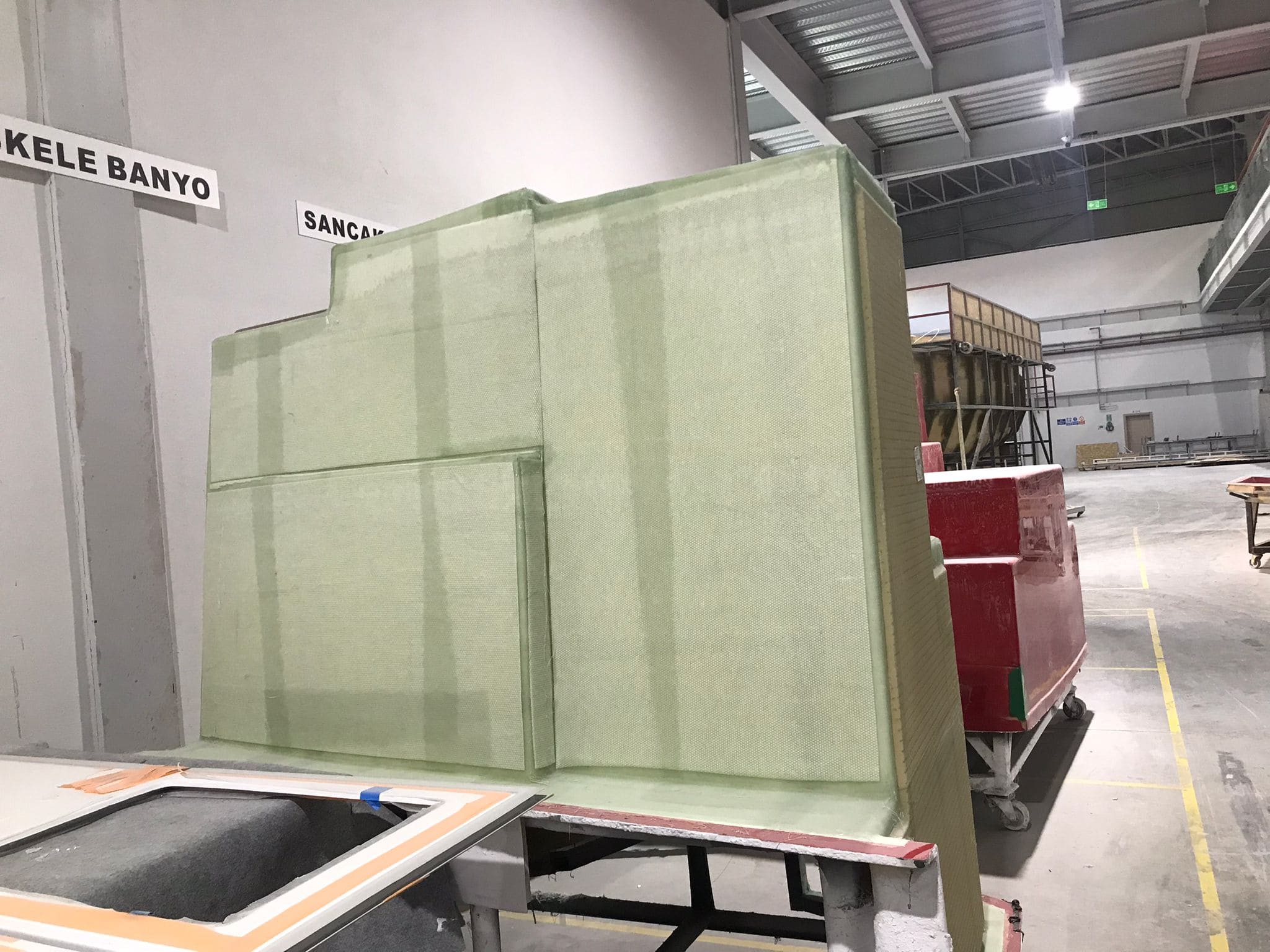

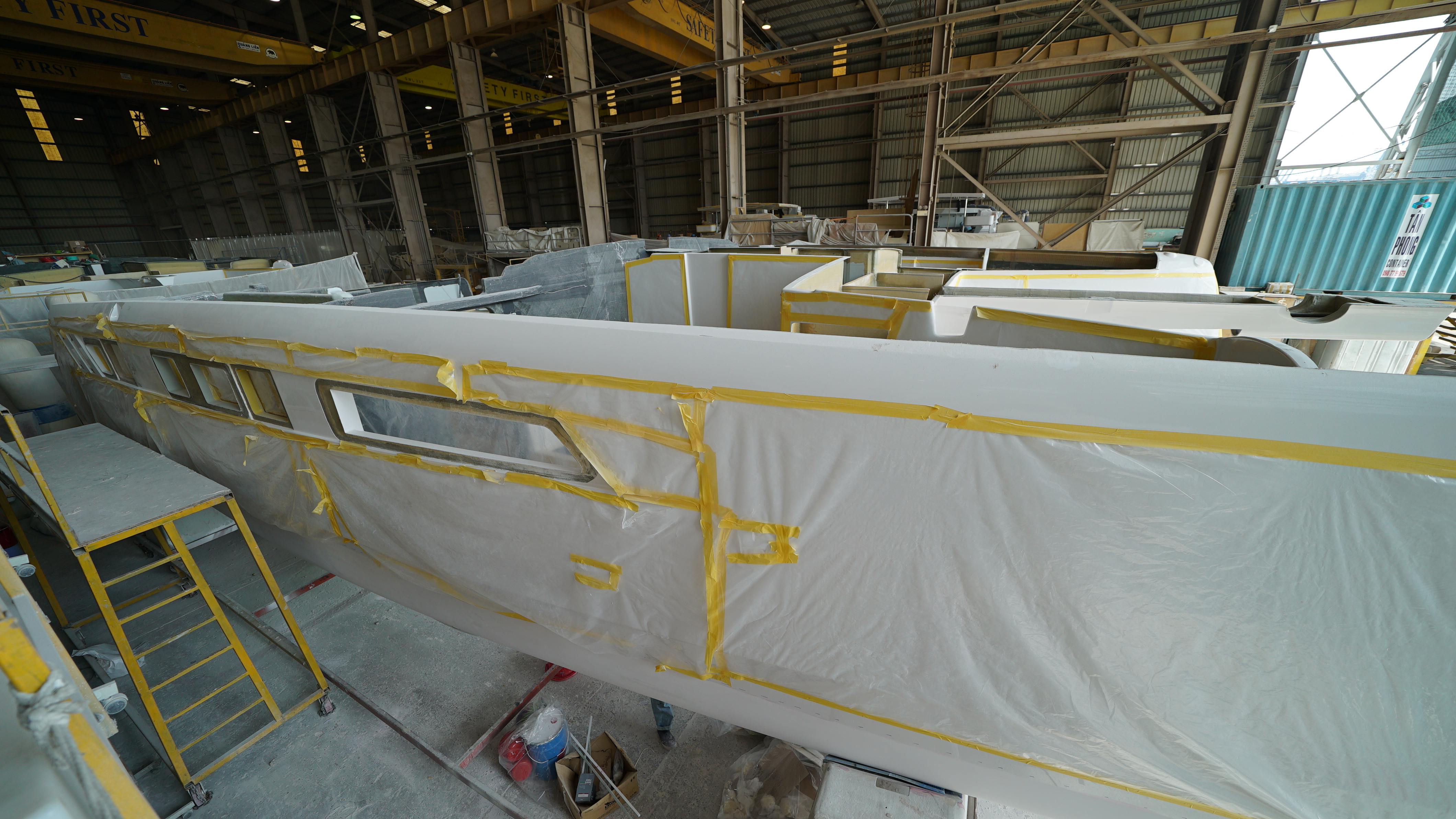

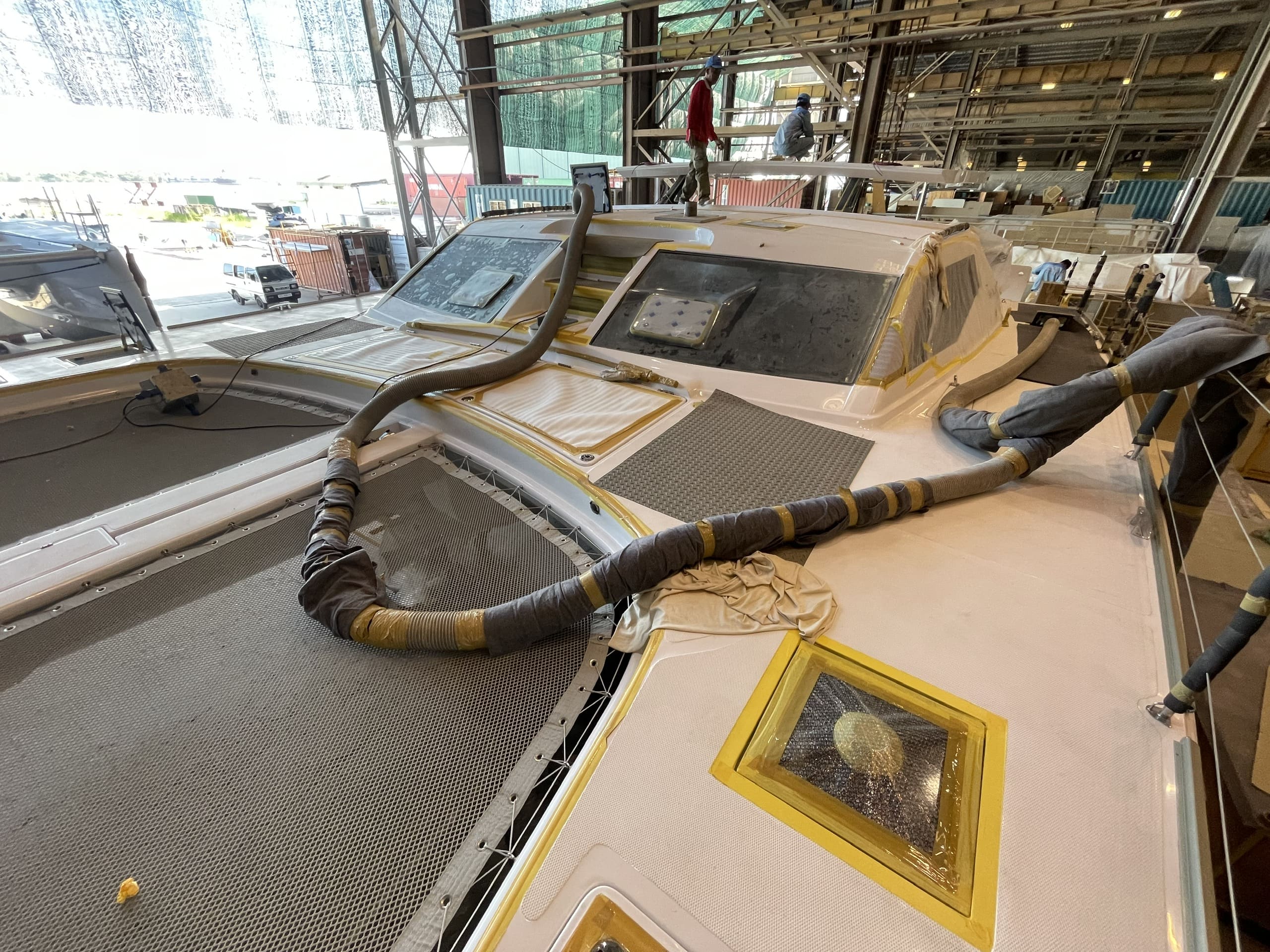

The hull and deck are being steadily constructed in the molds. Our lamination team is carrying out fiberglass and foam lay-up operations.

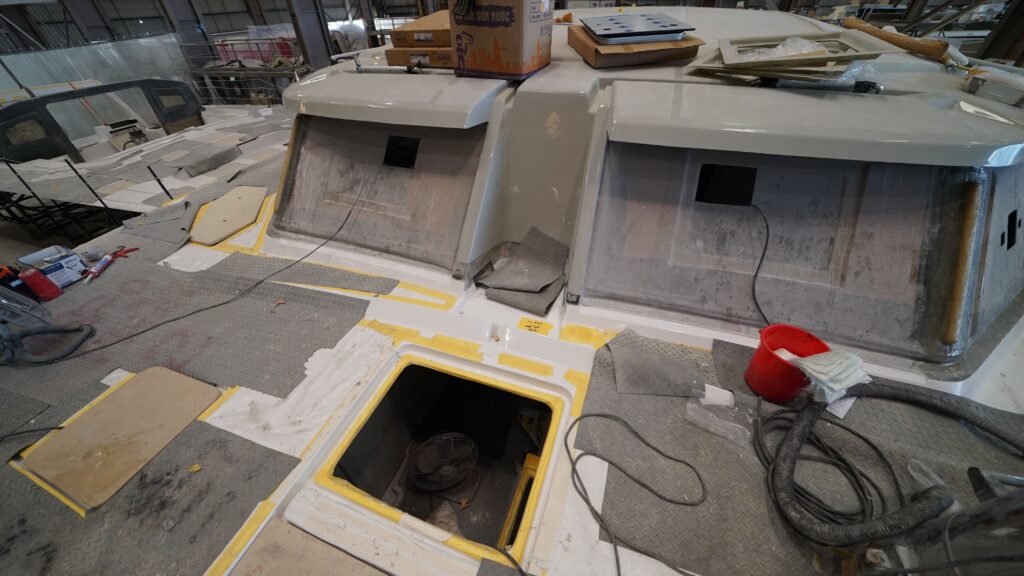

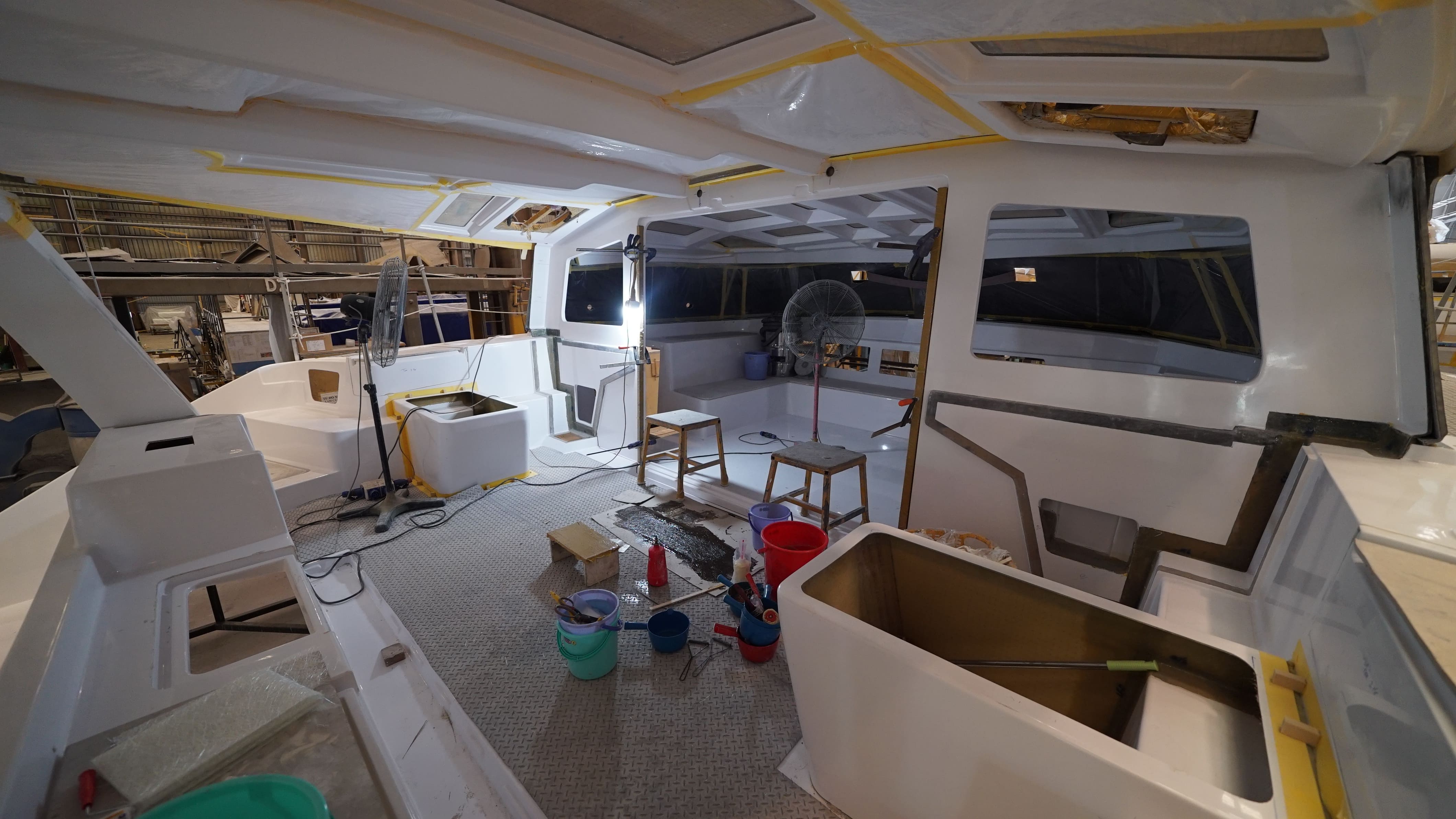

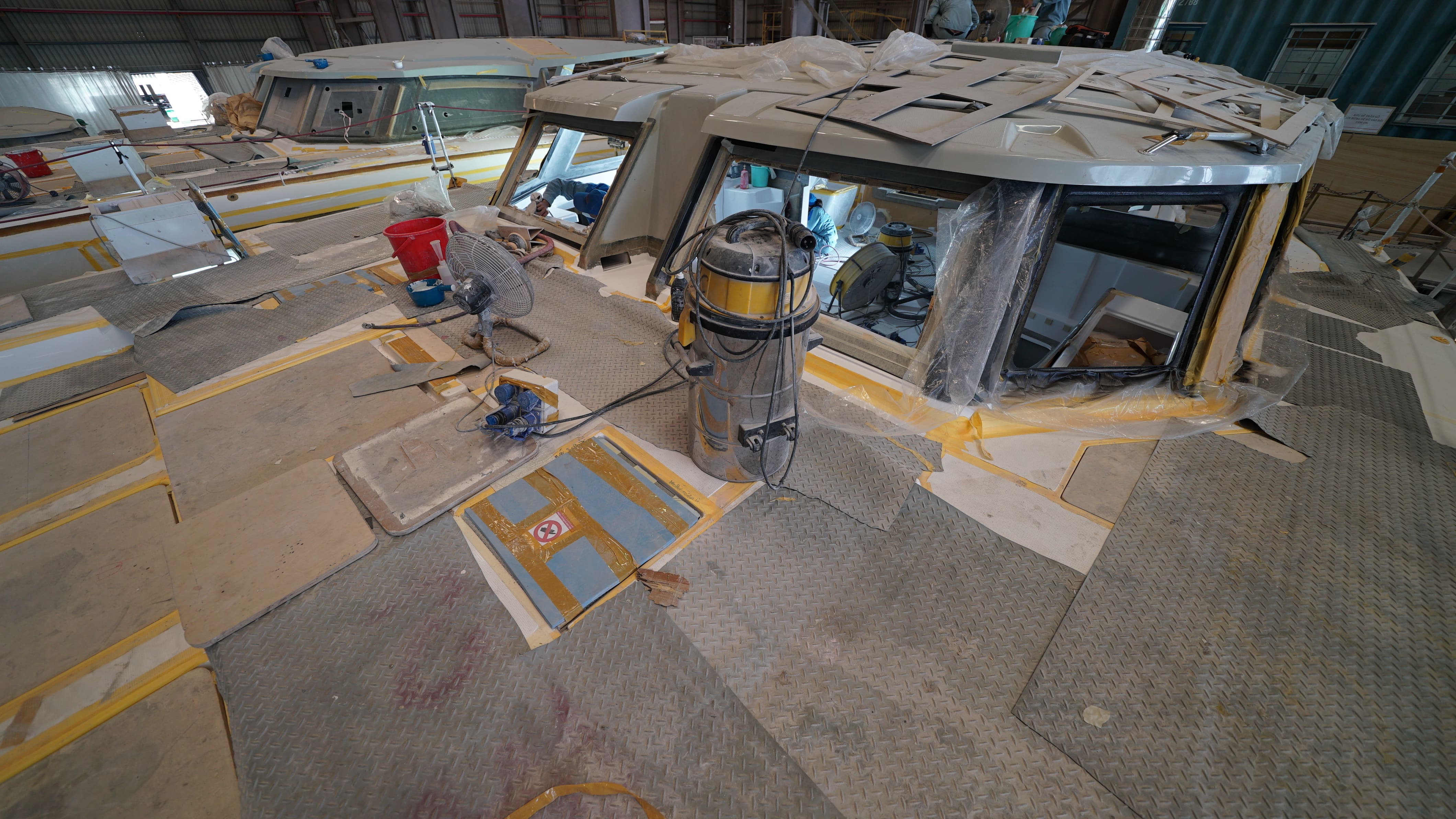

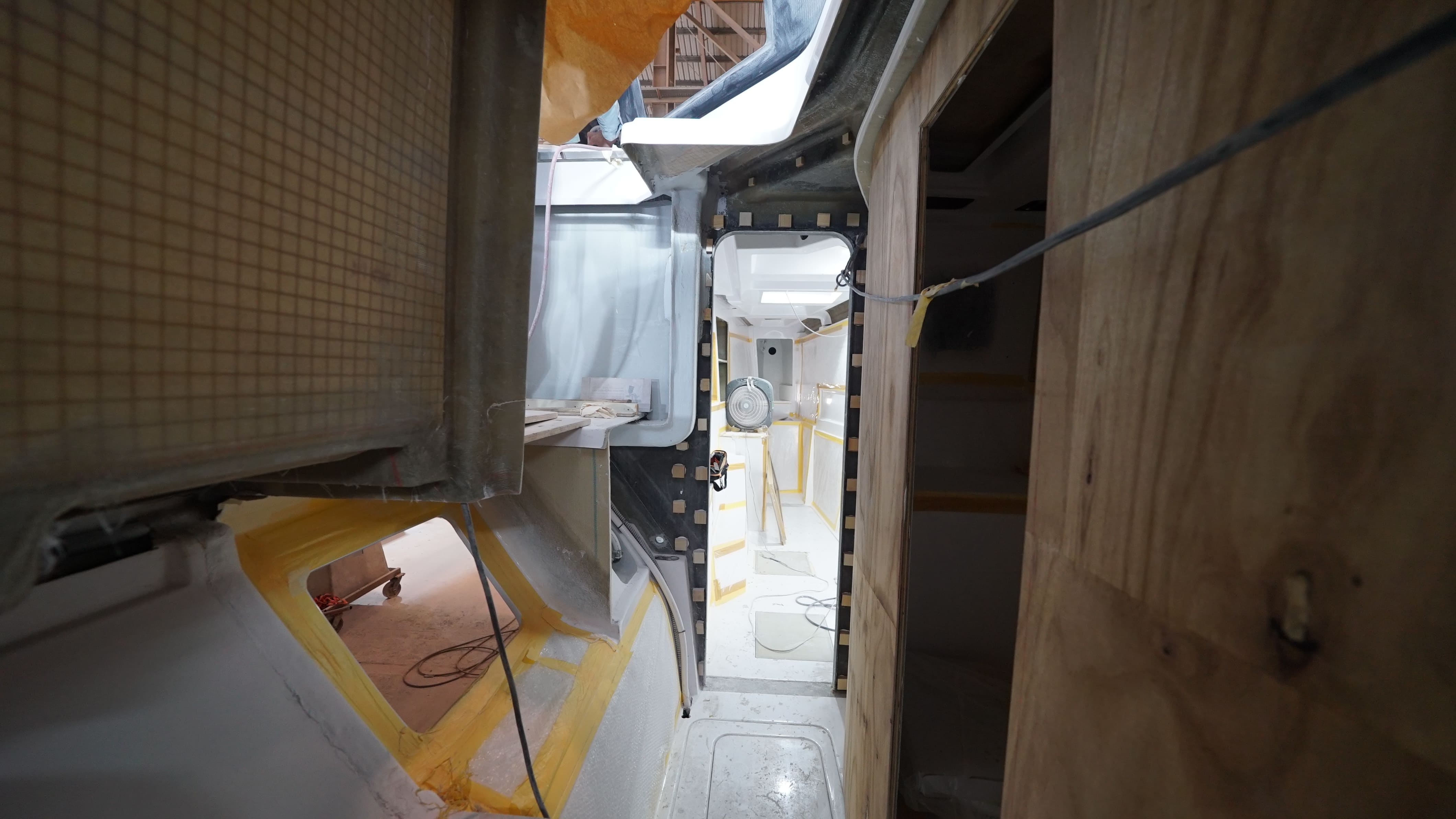

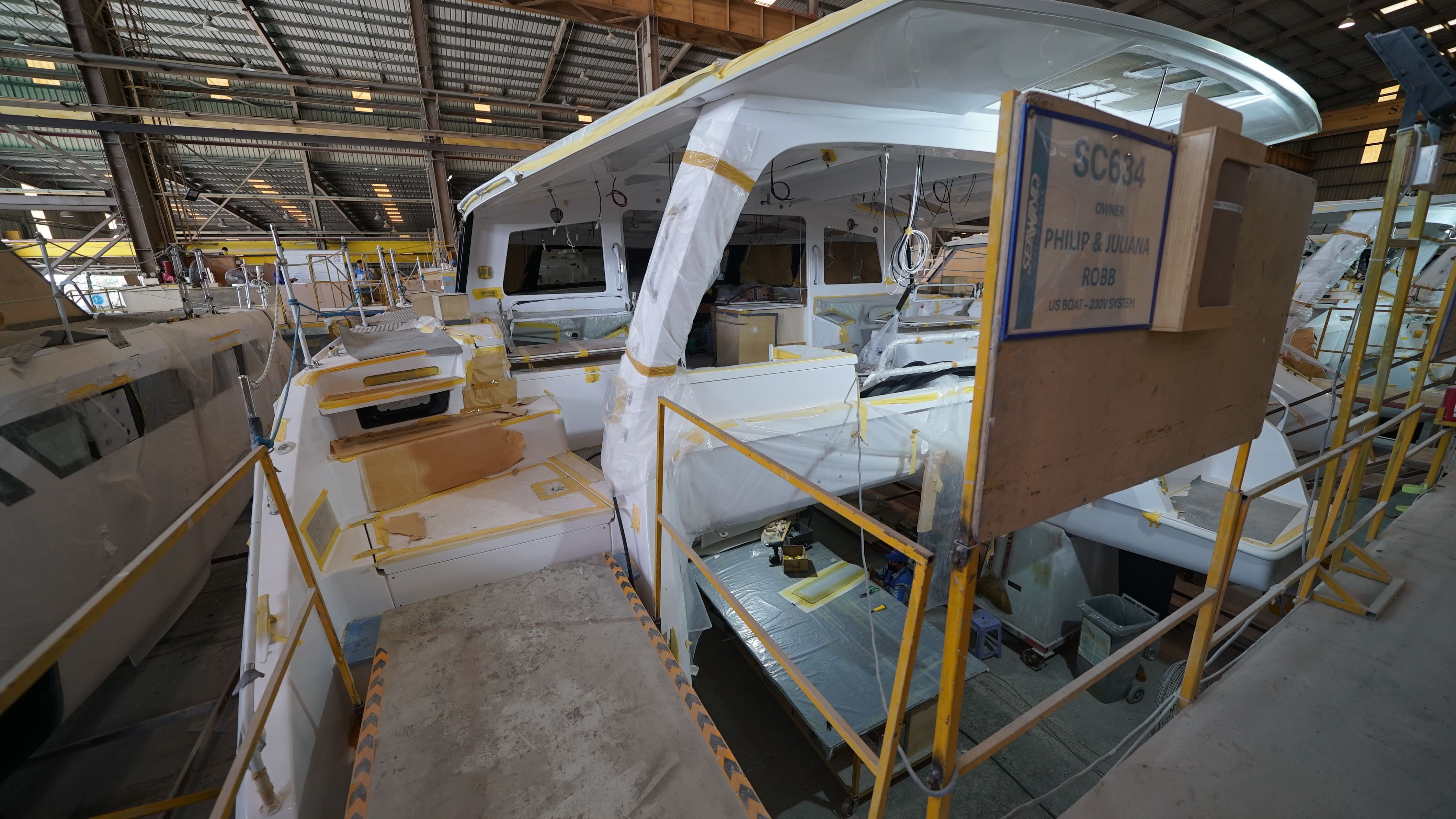

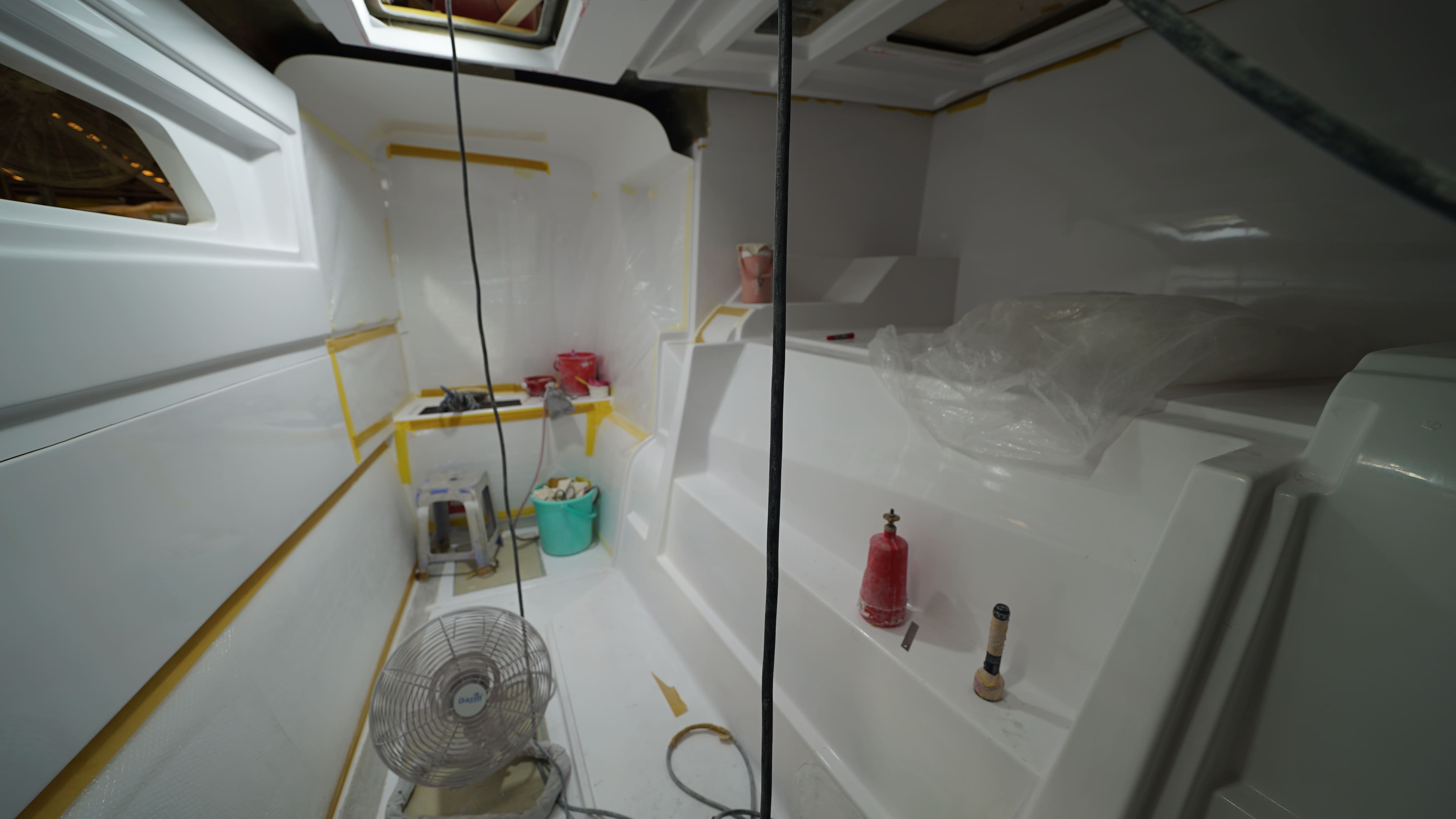

Production Update – Assembly

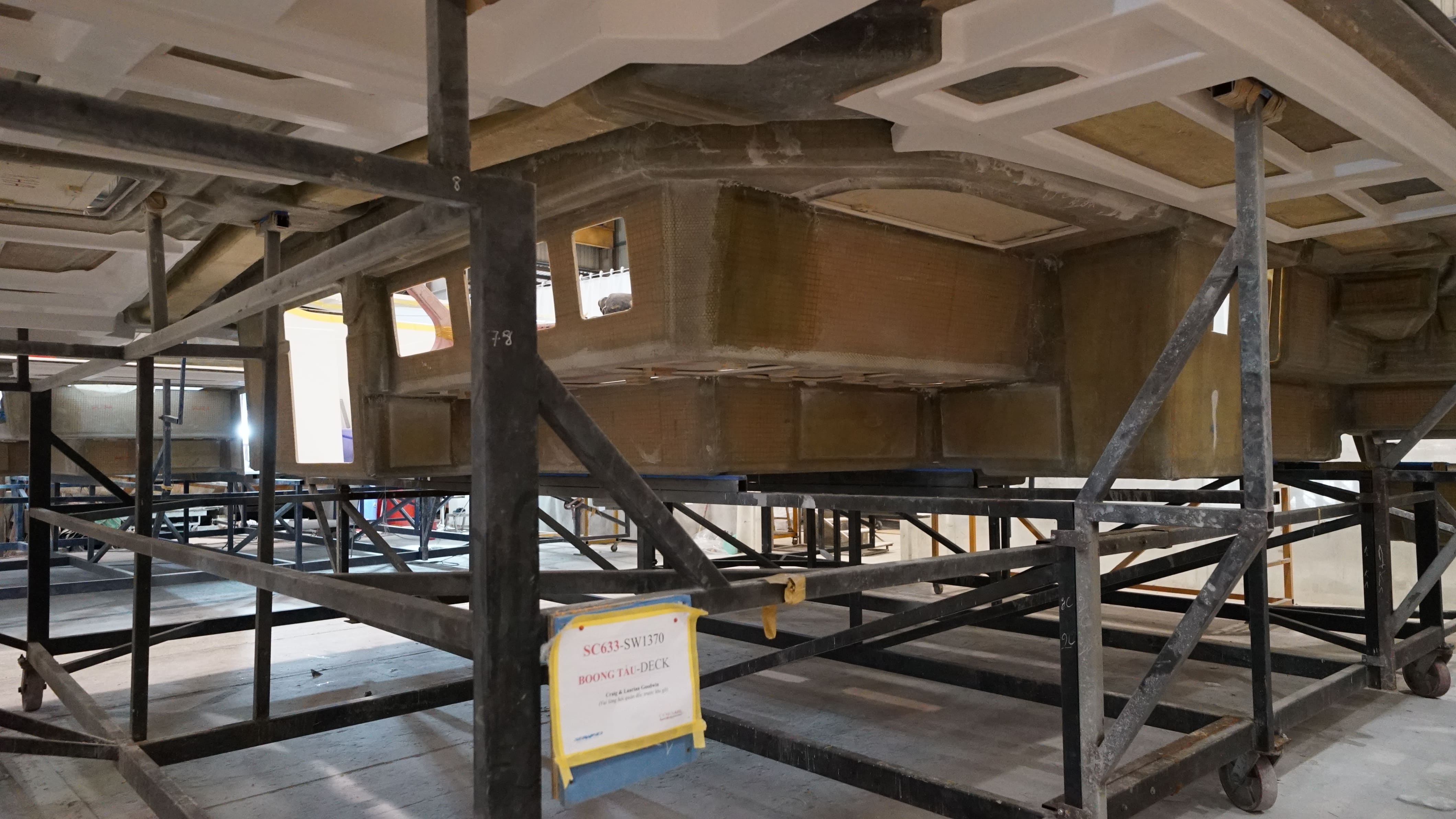

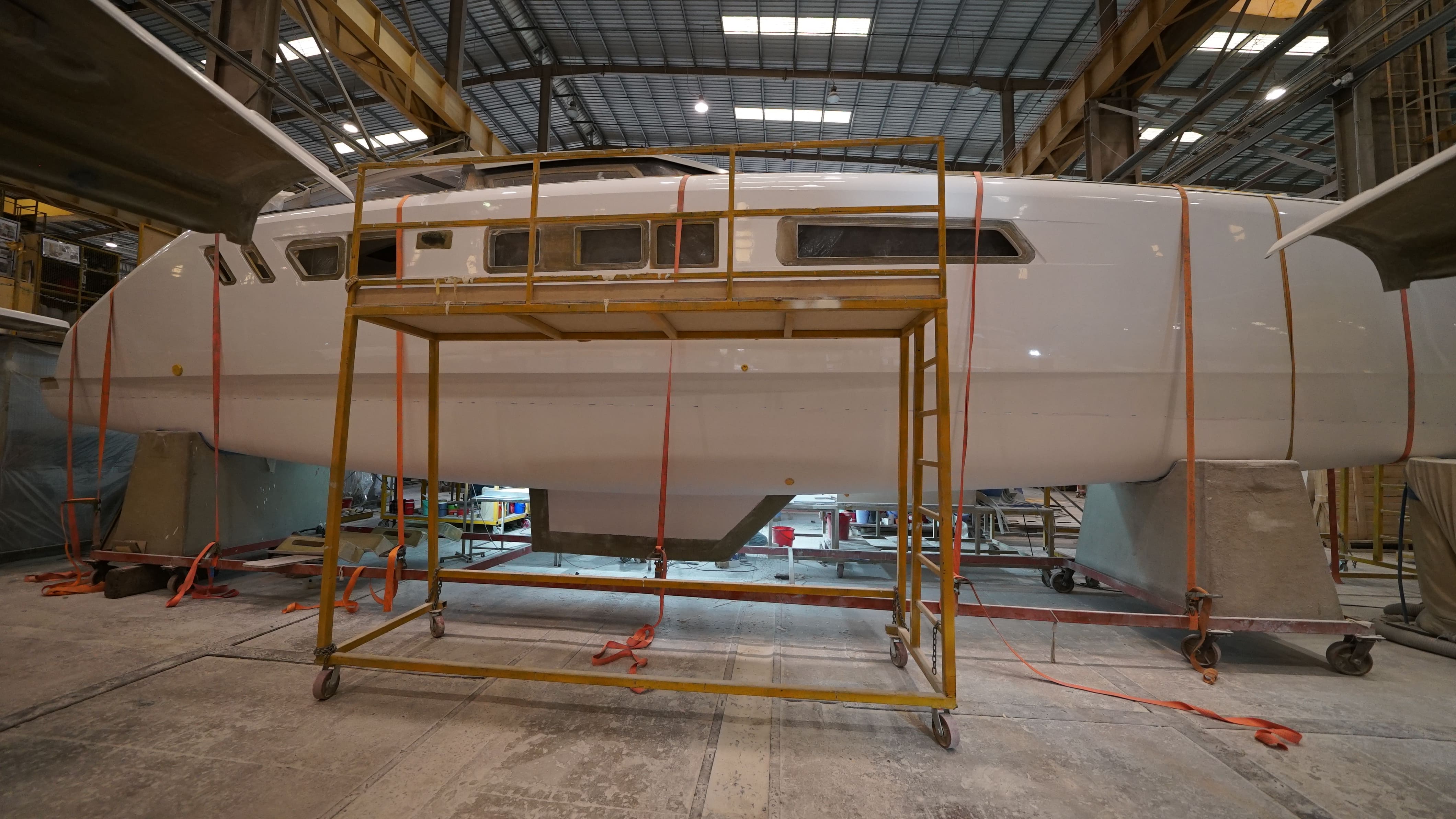

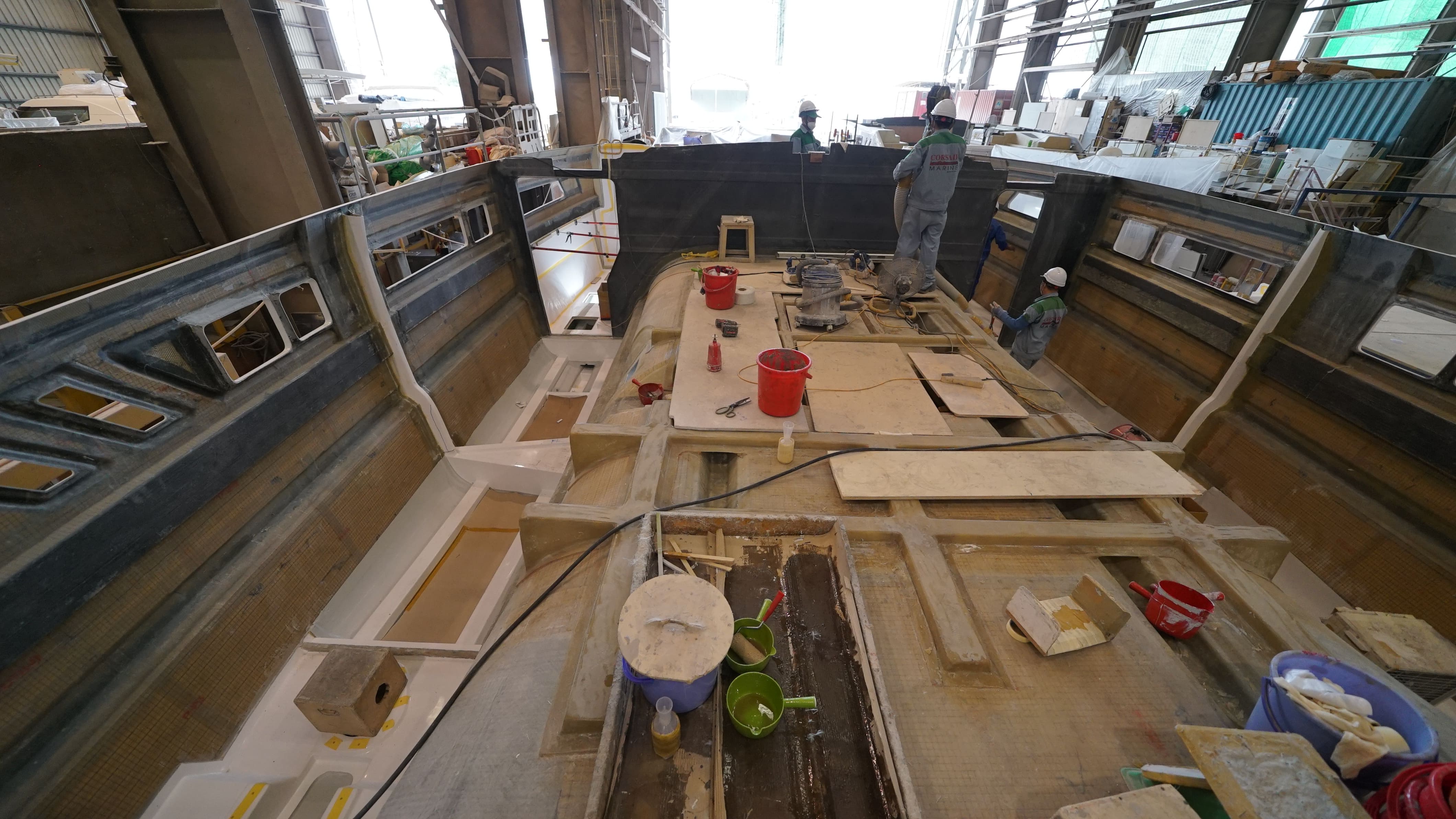

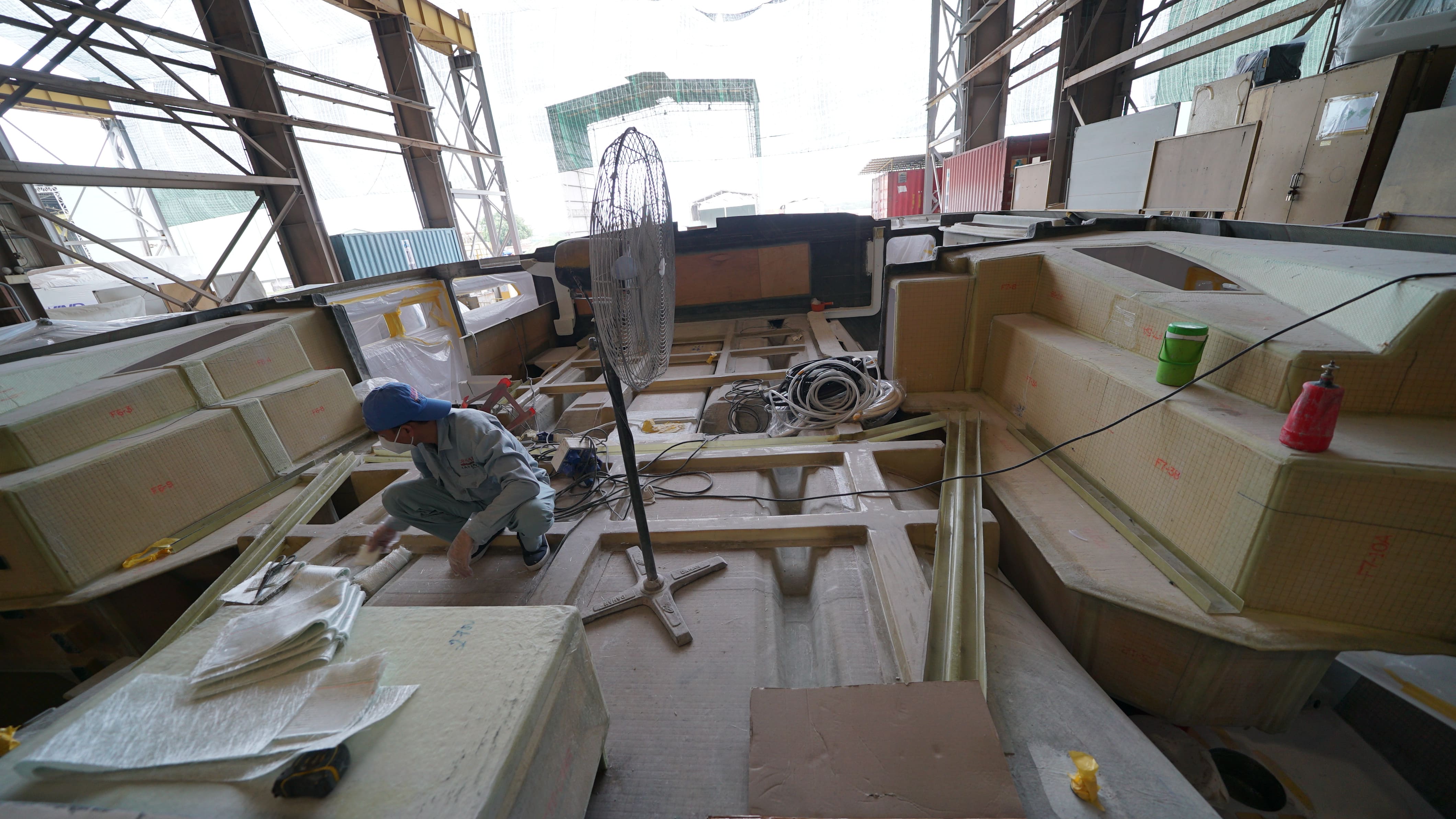

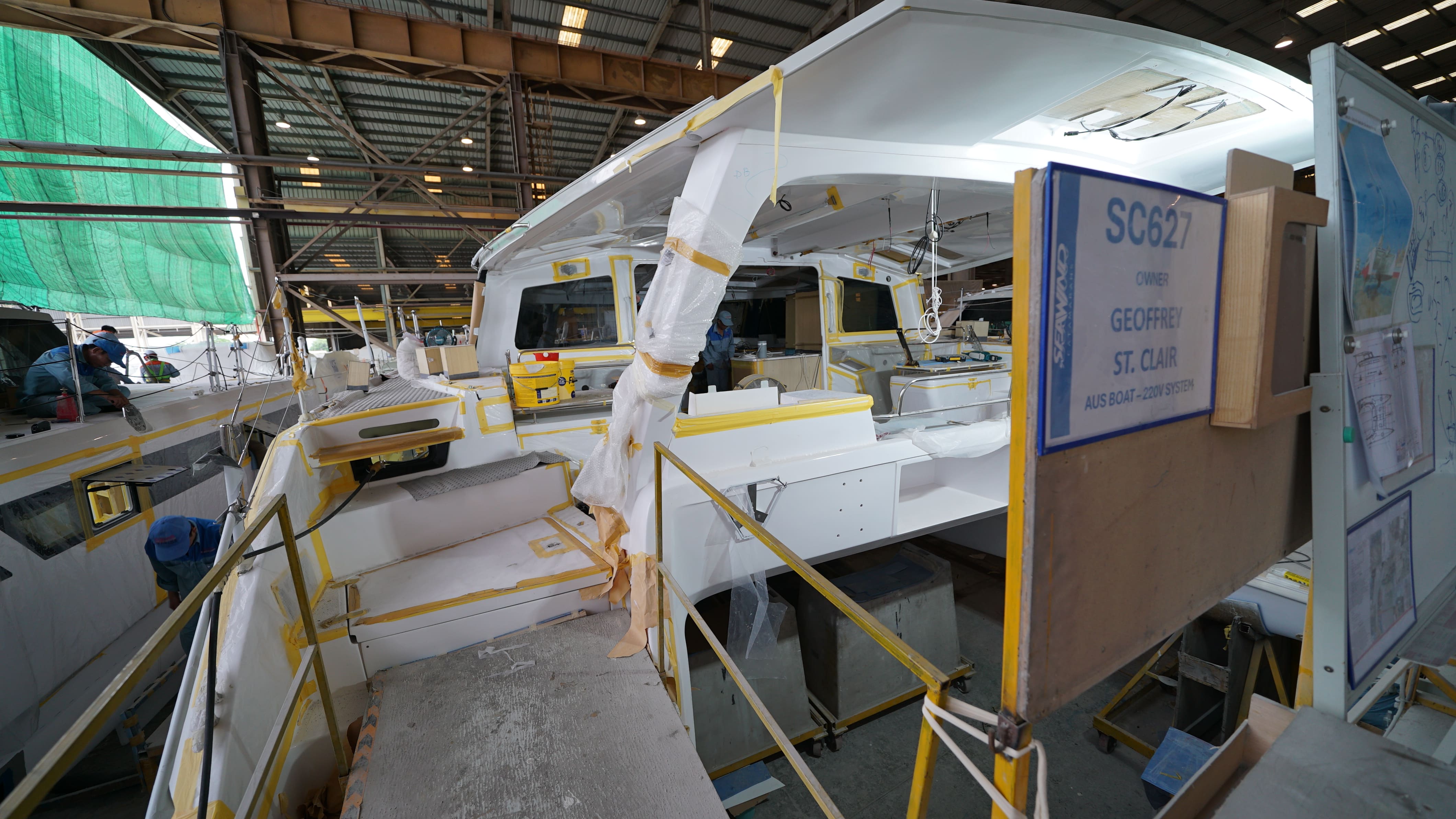

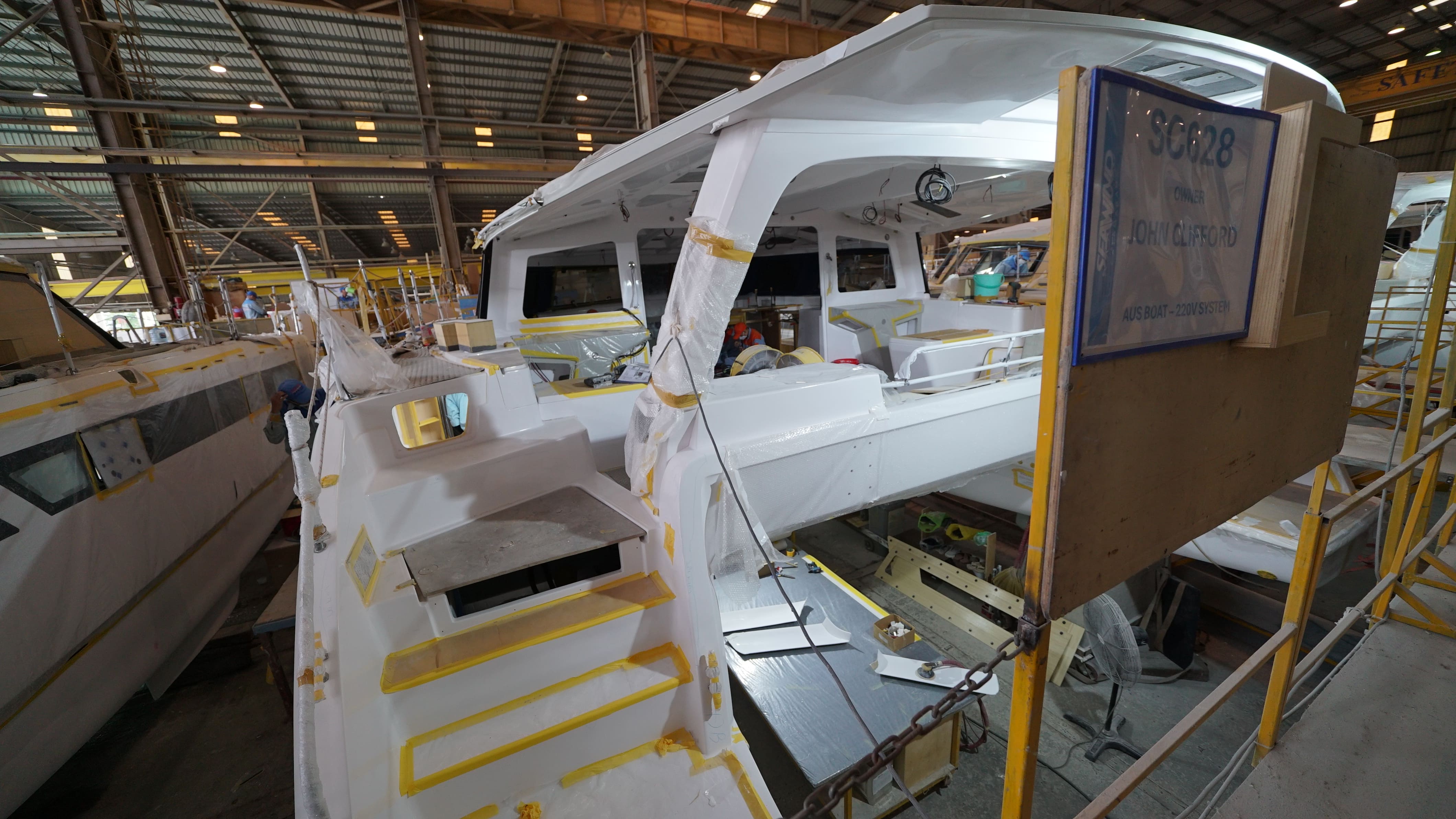

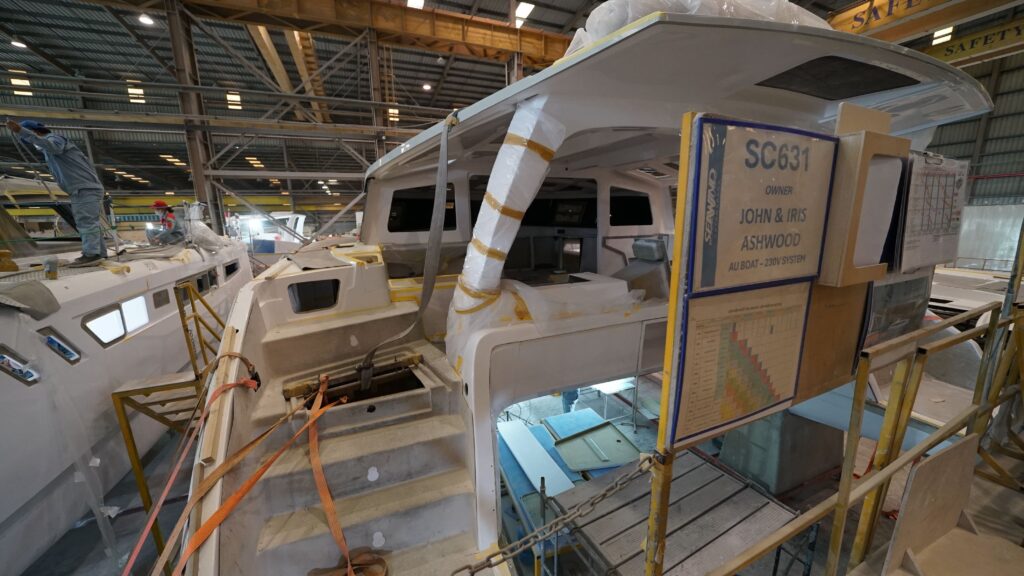

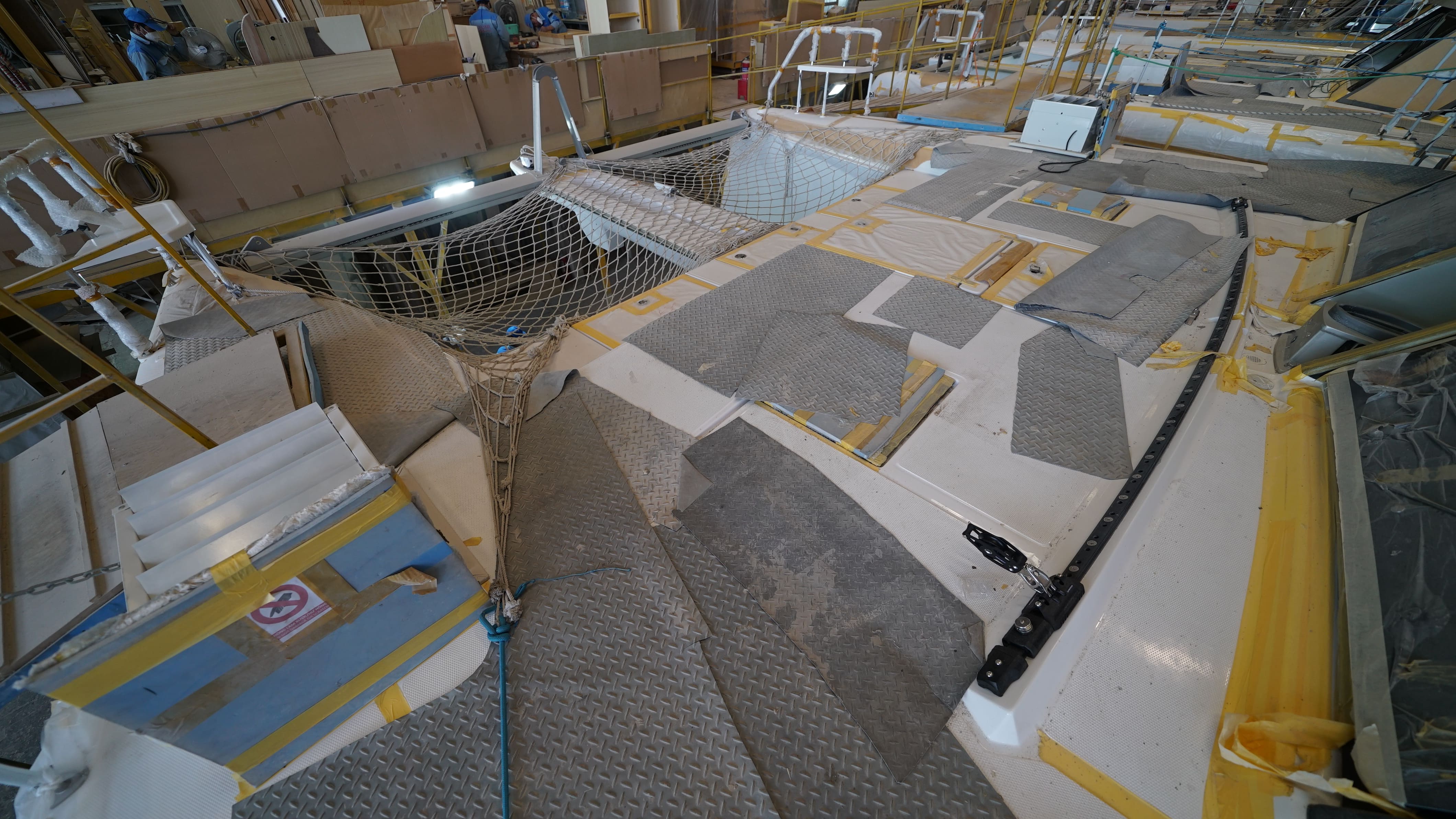

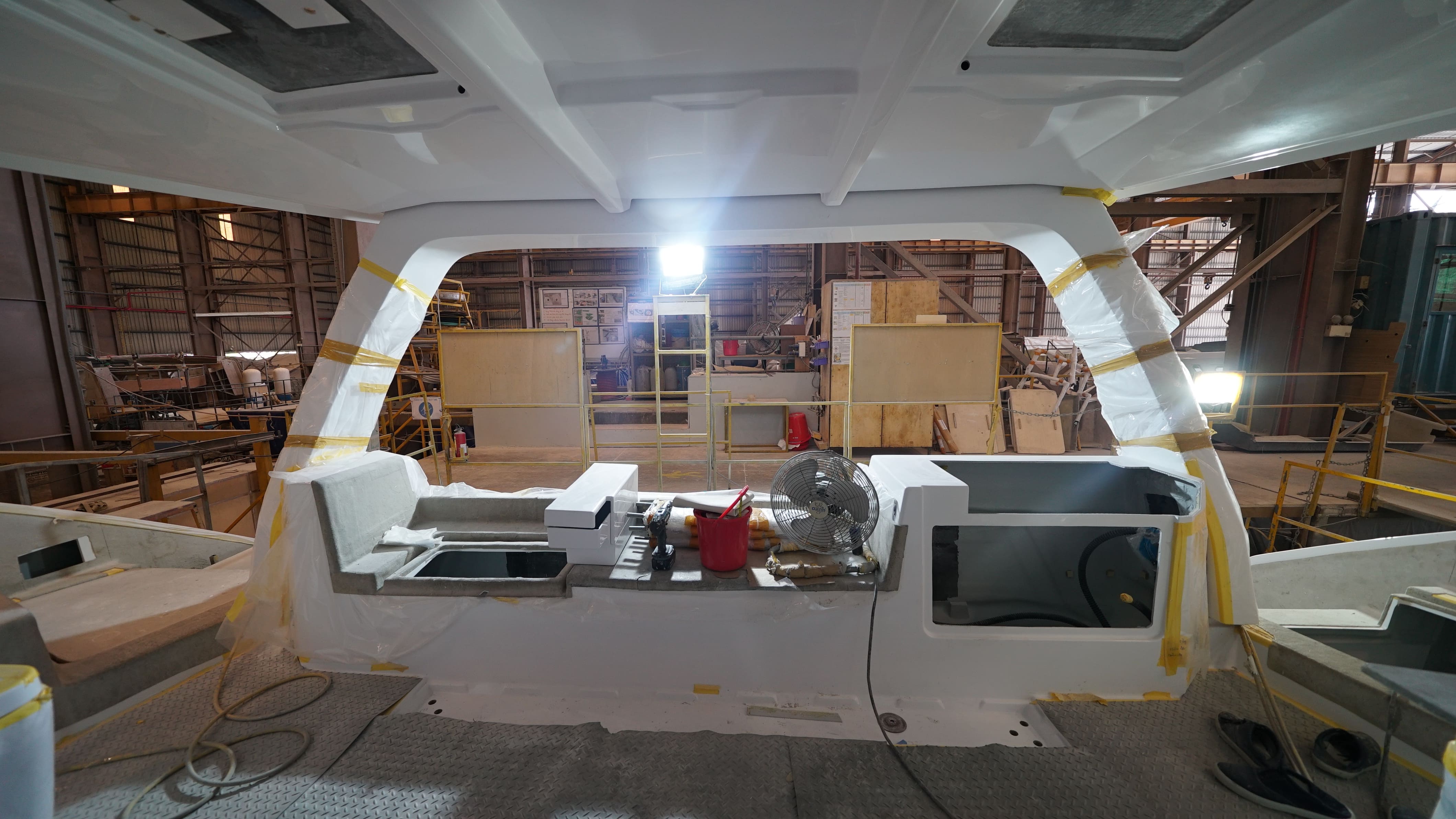

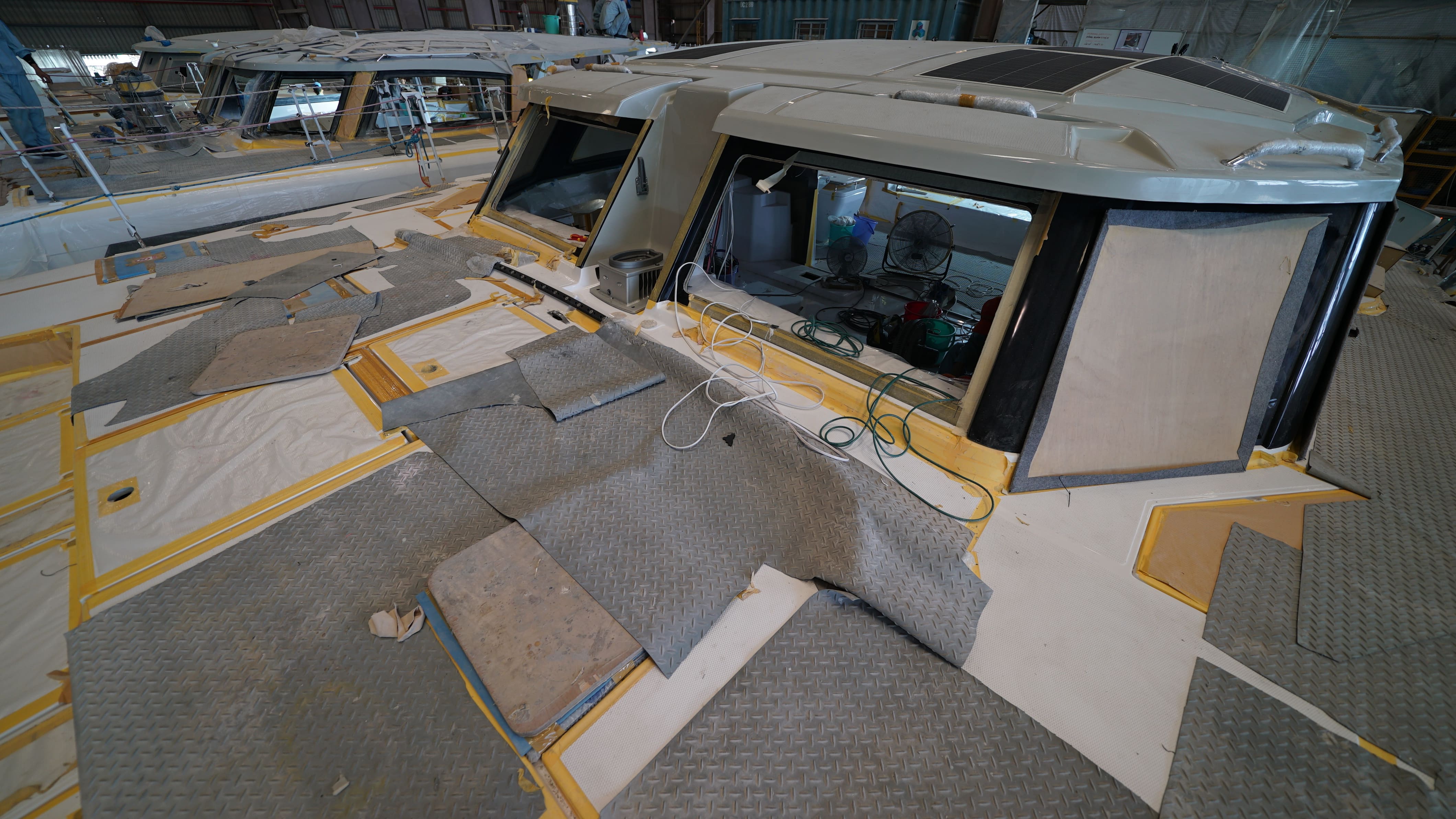

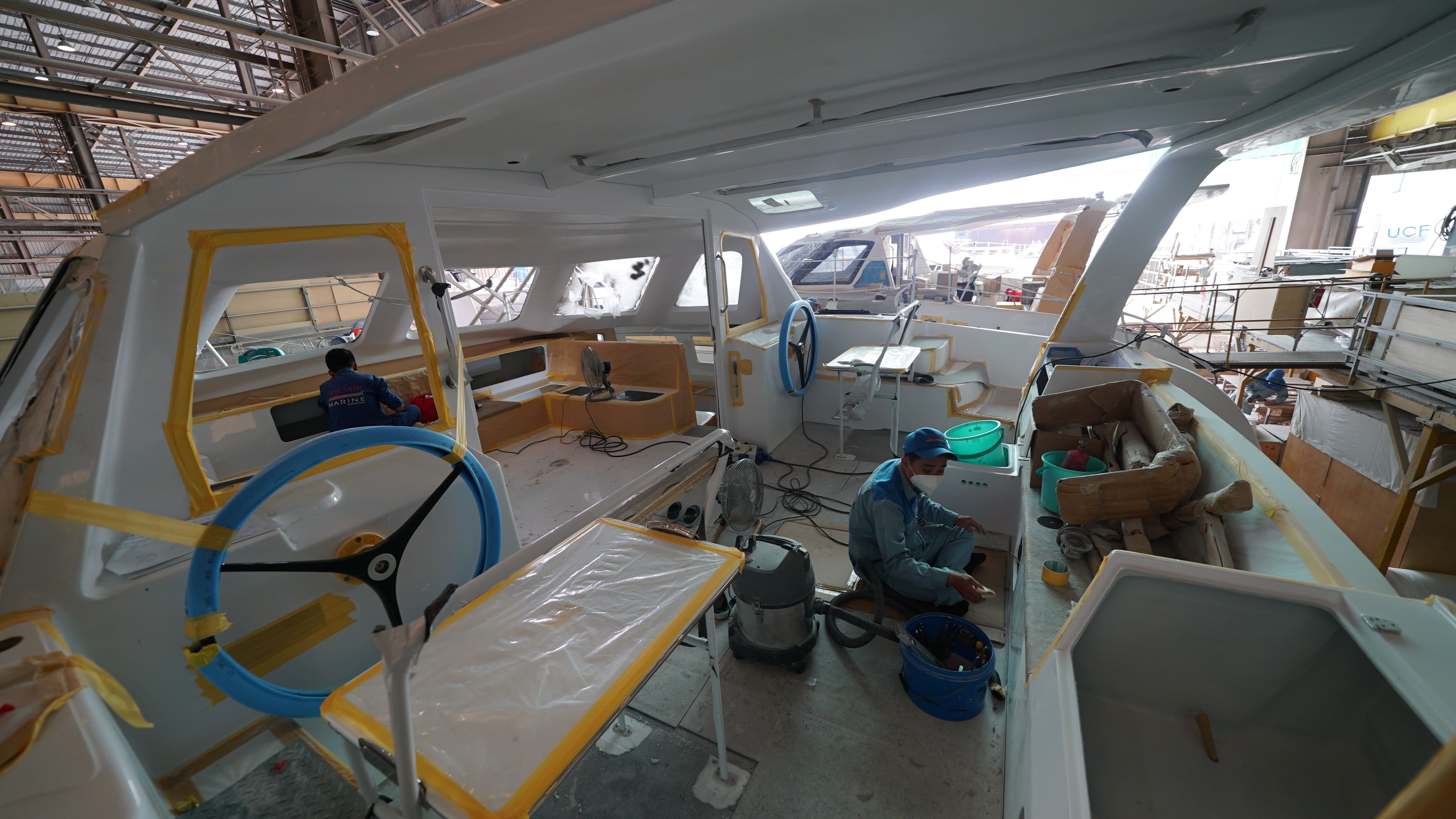

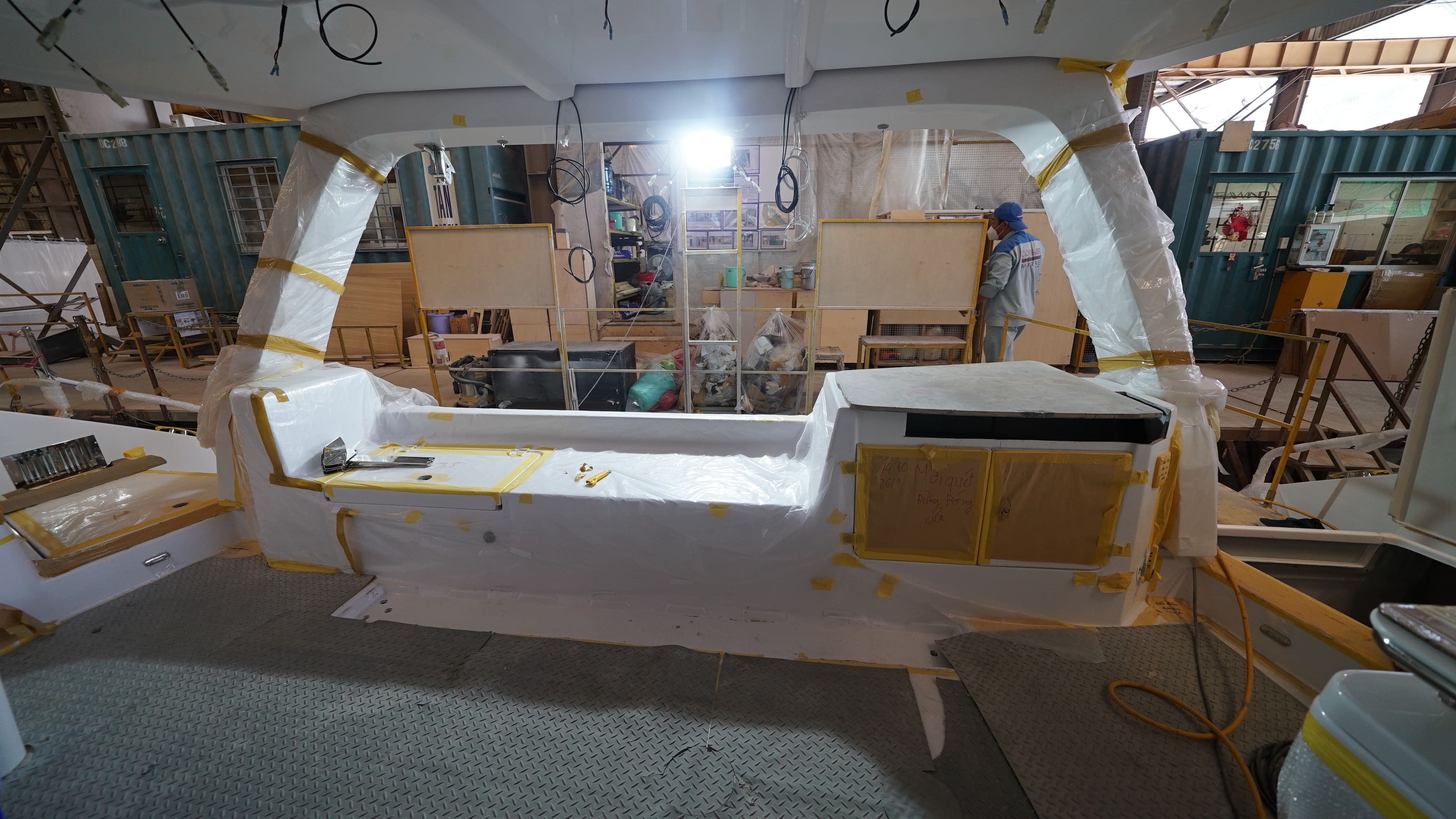

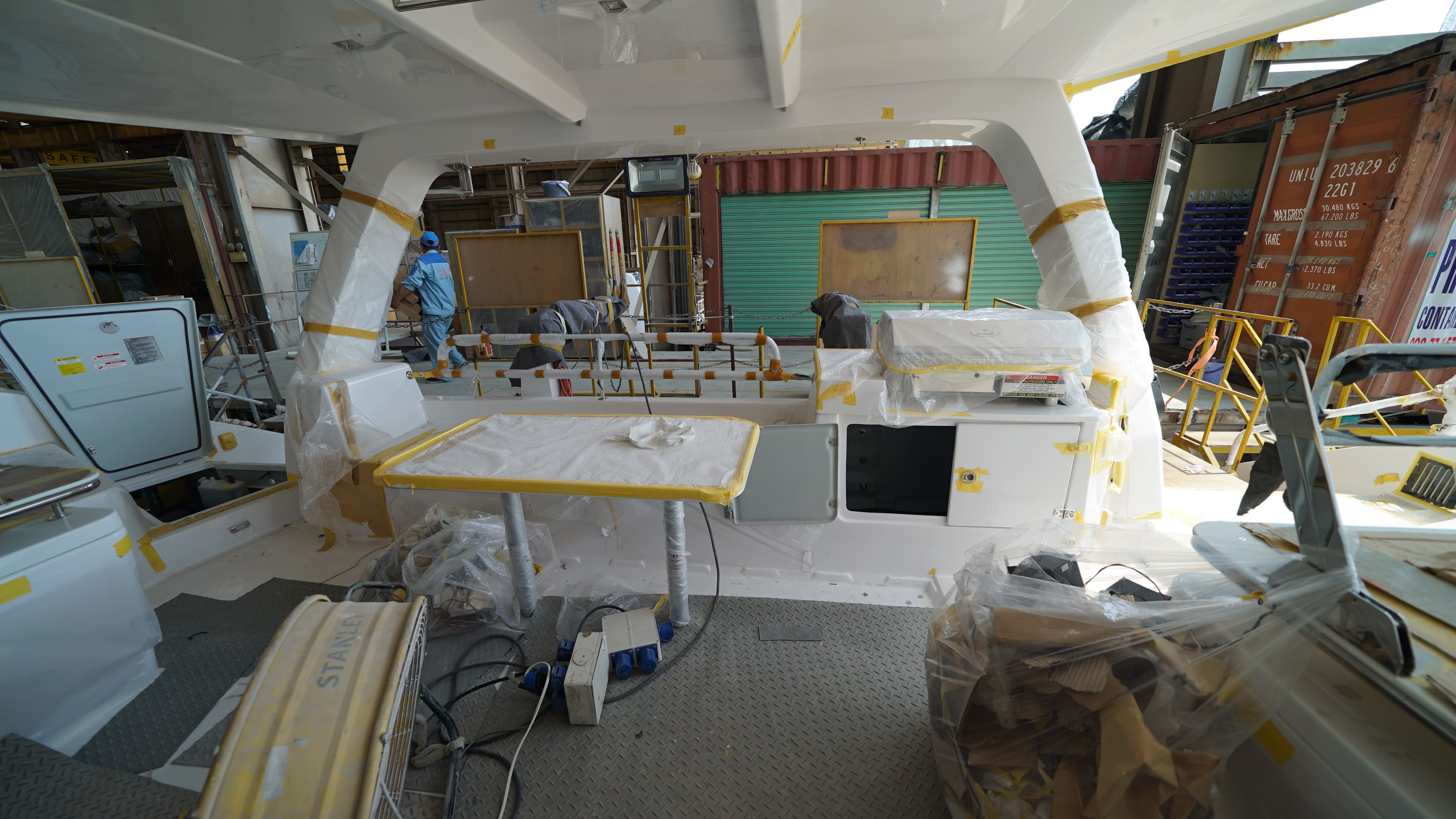

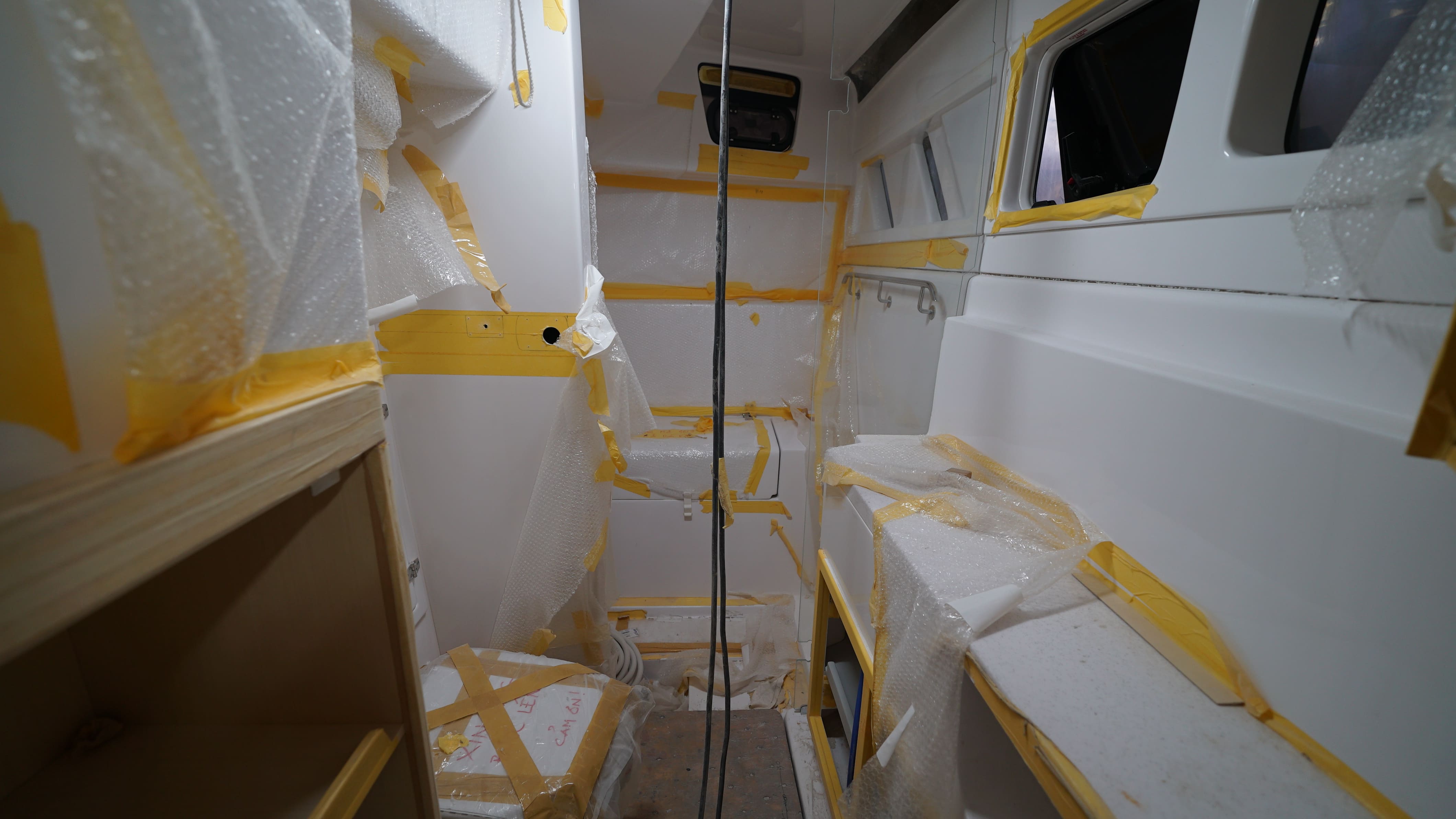

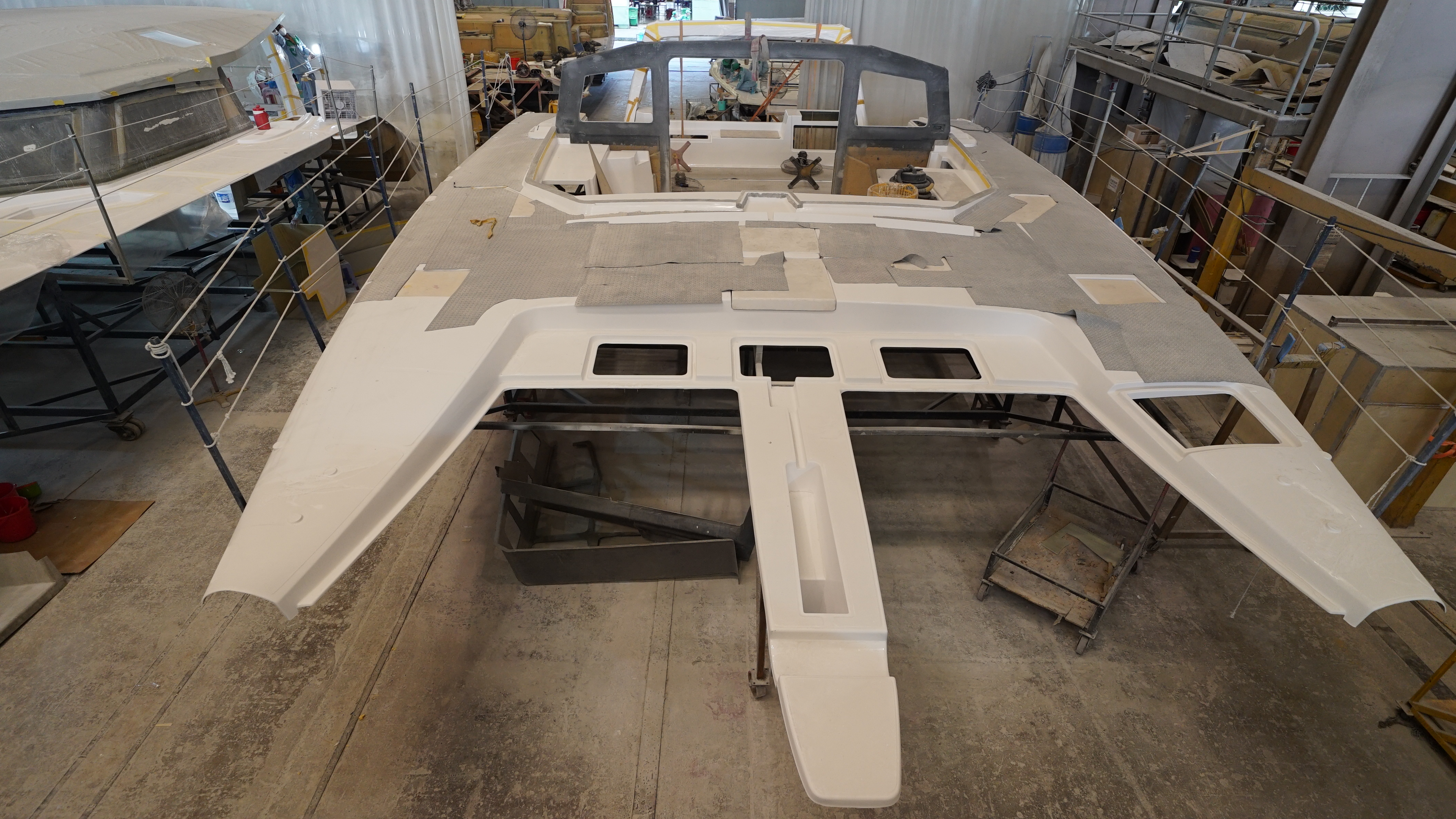

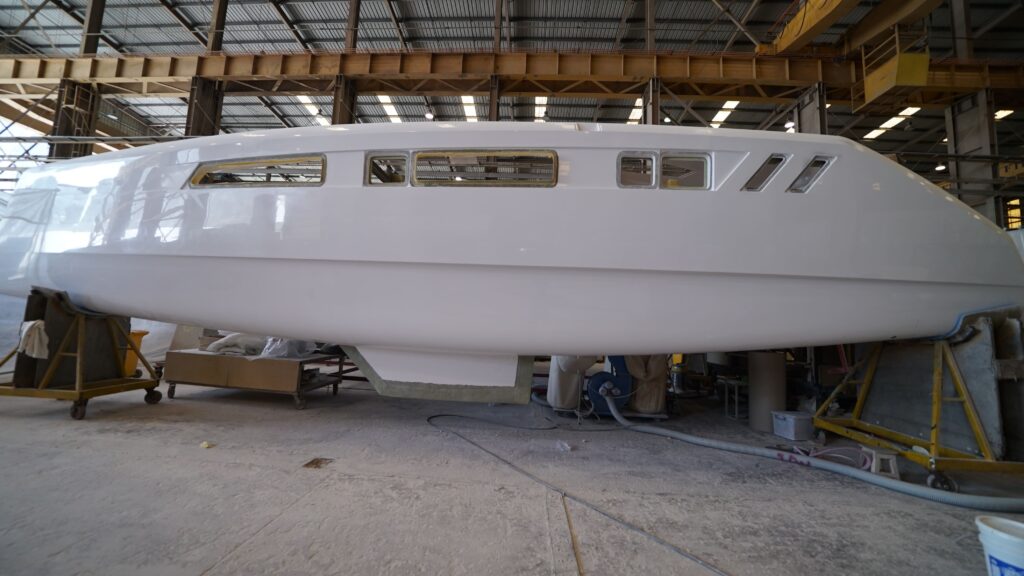

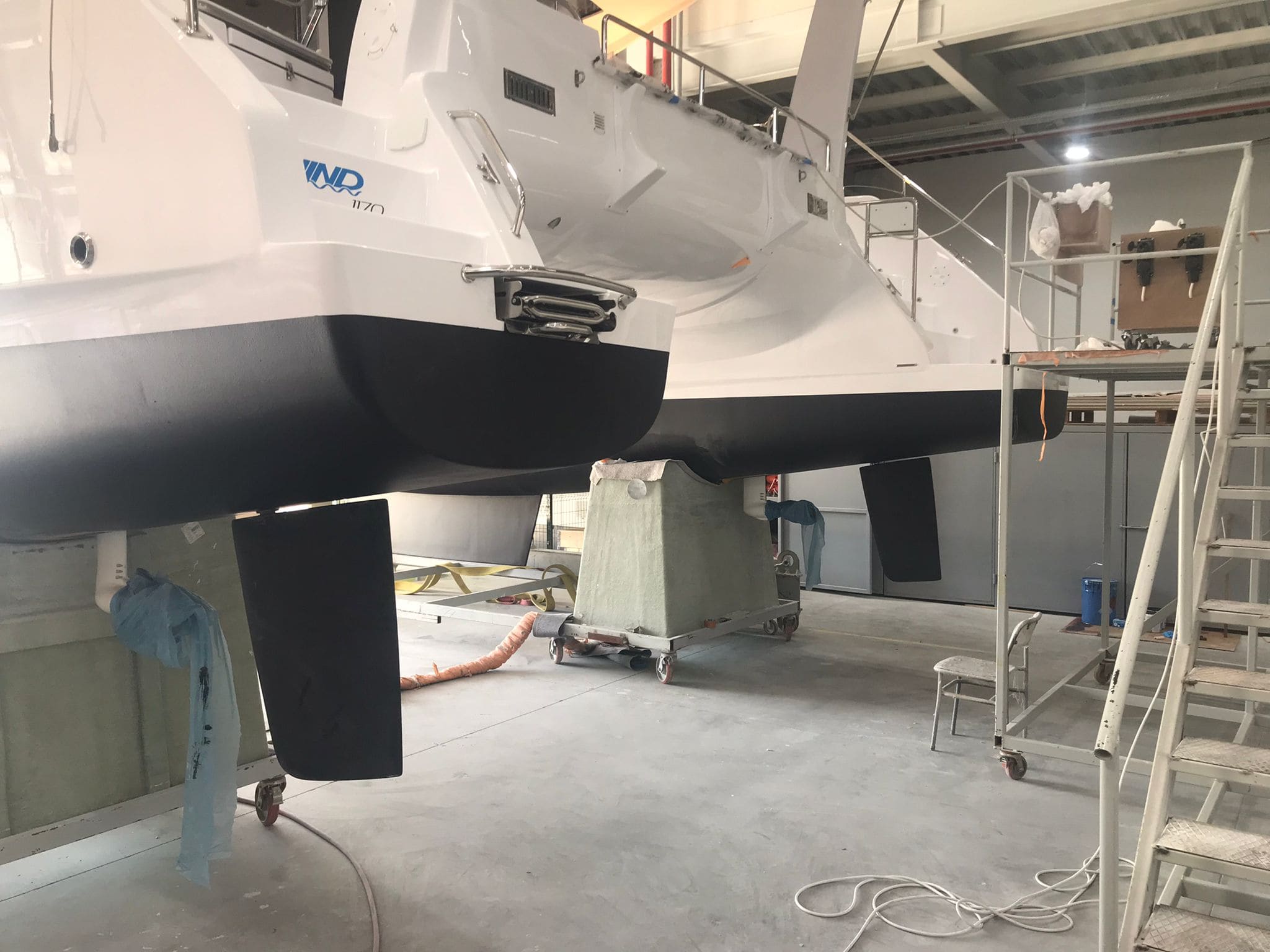

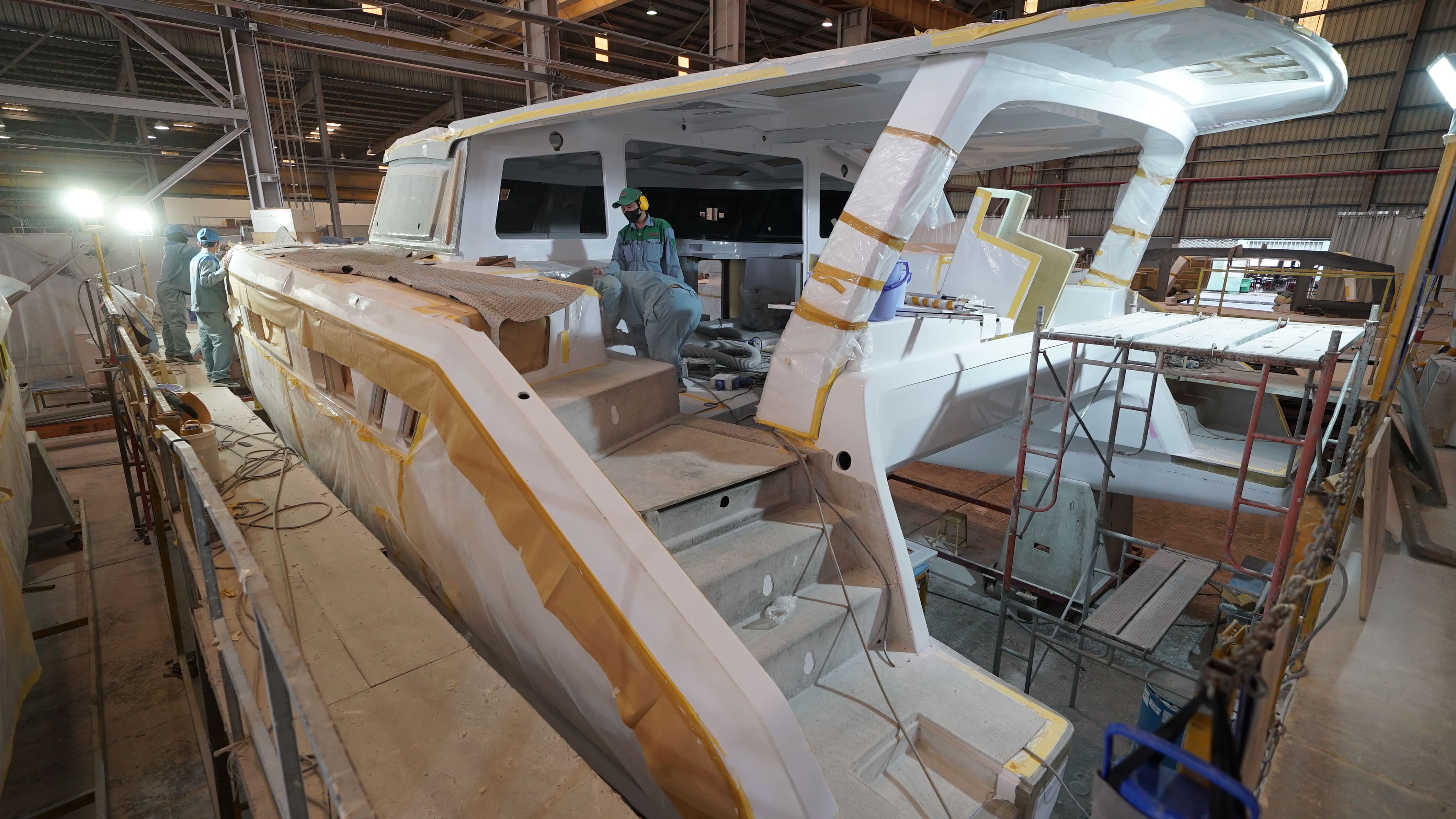

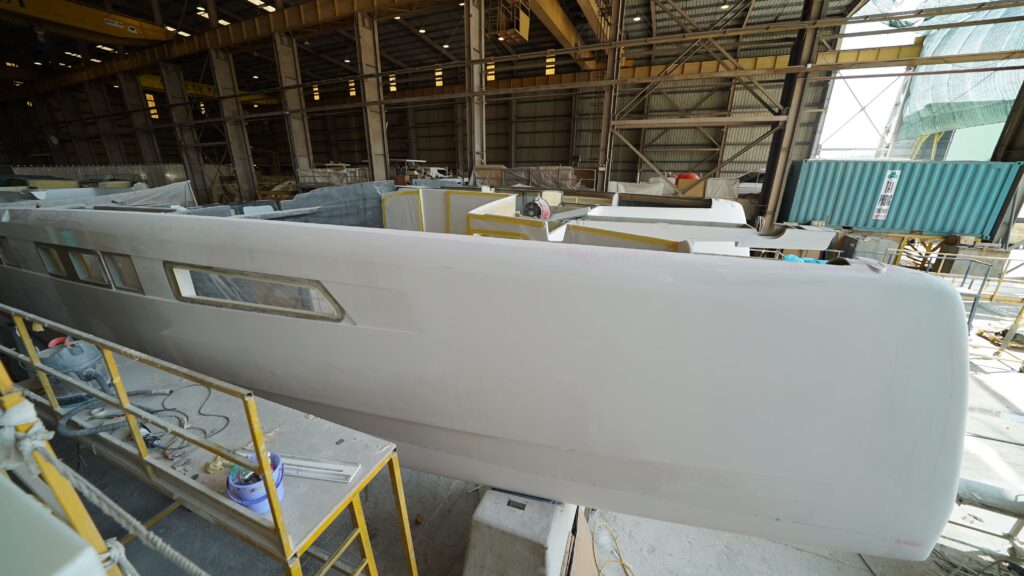

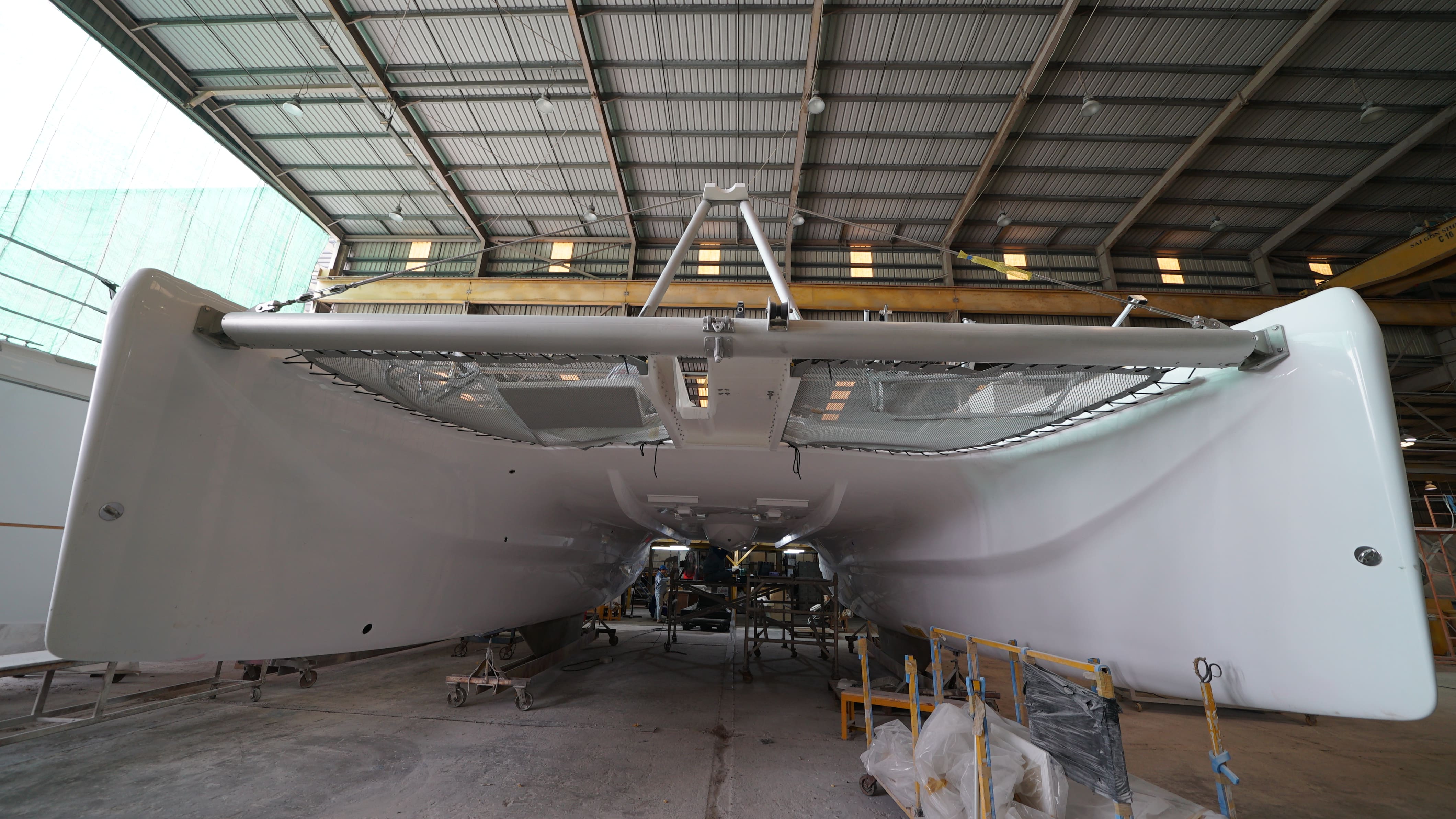

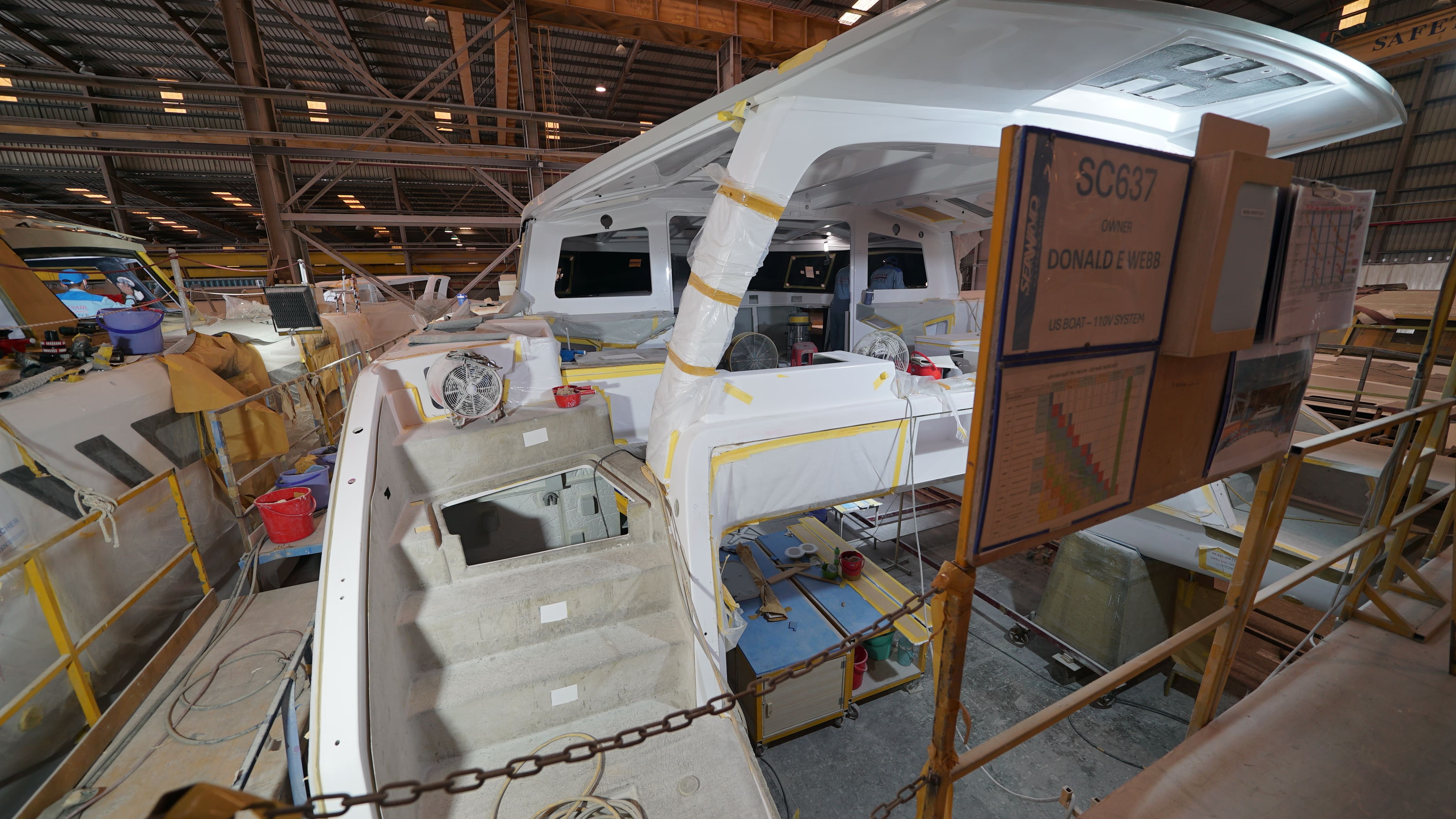

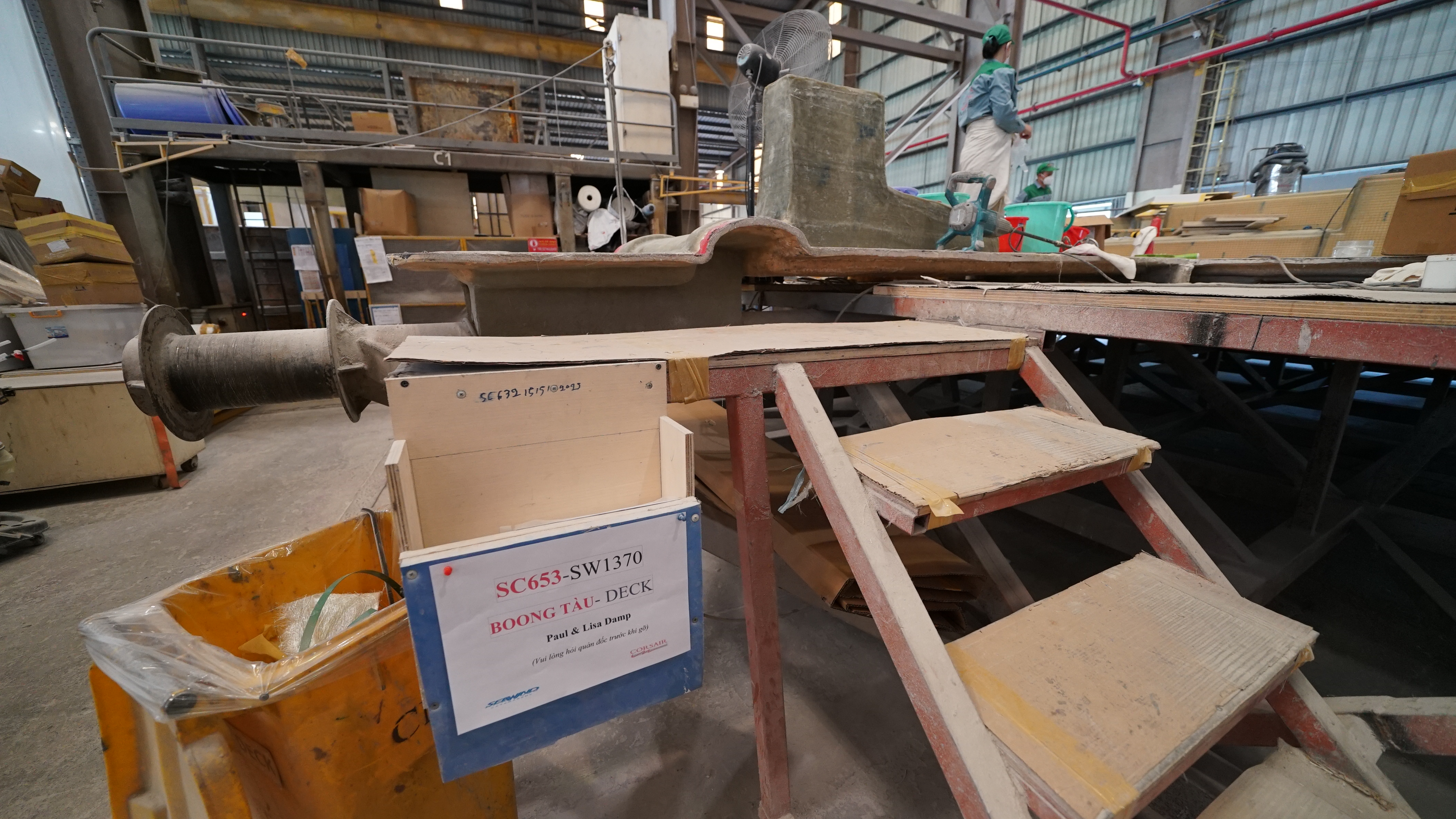

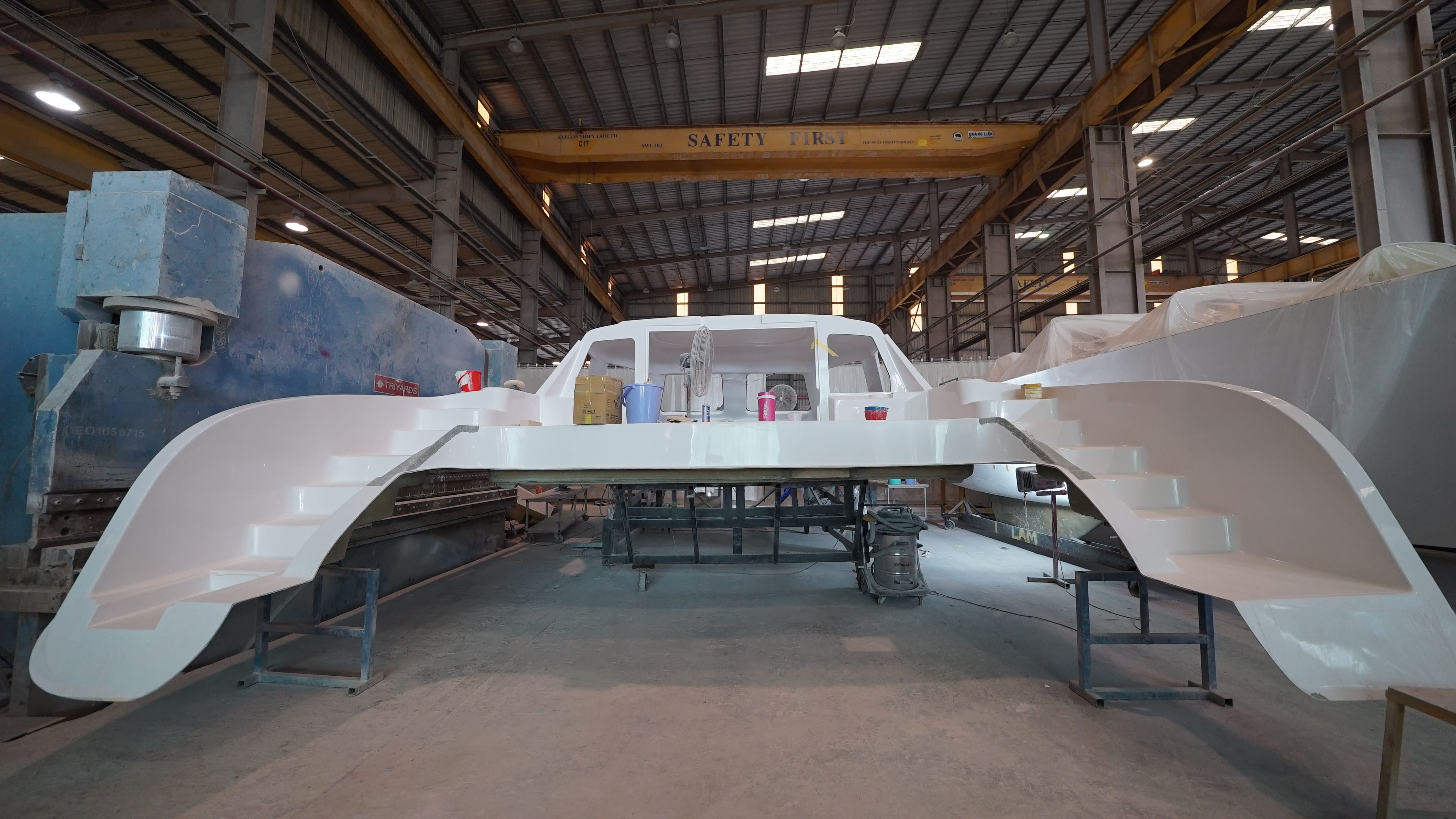

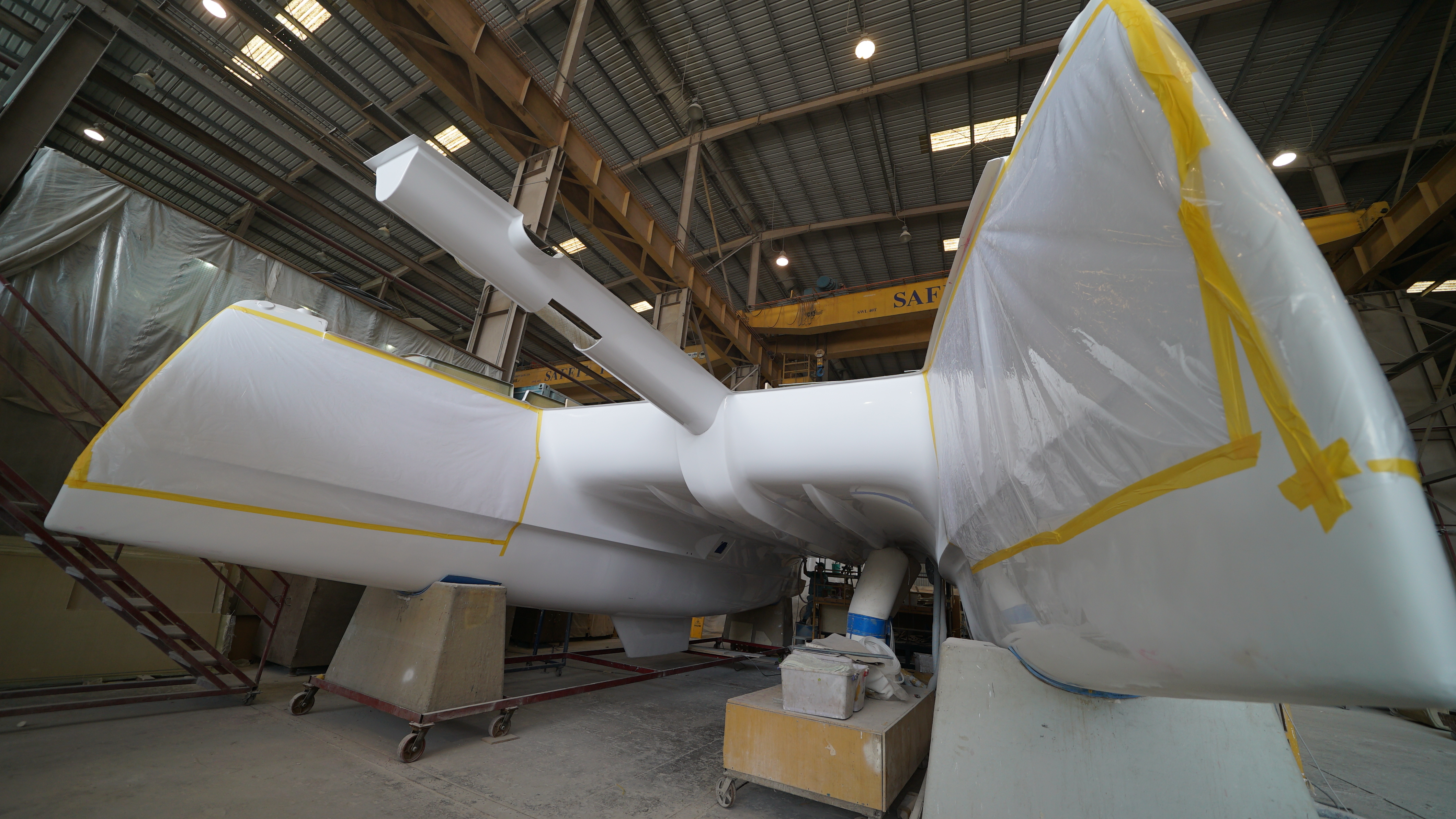

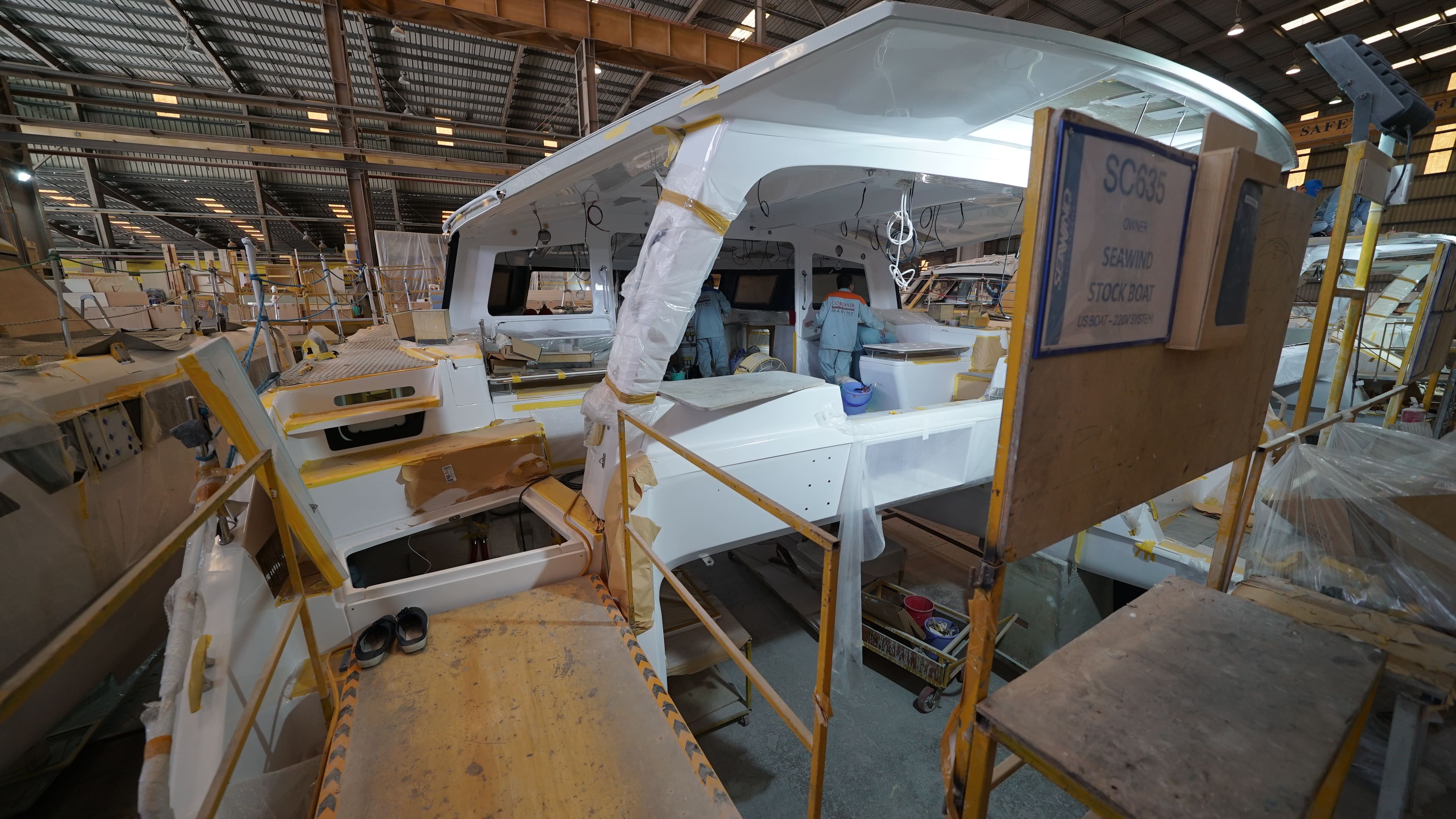

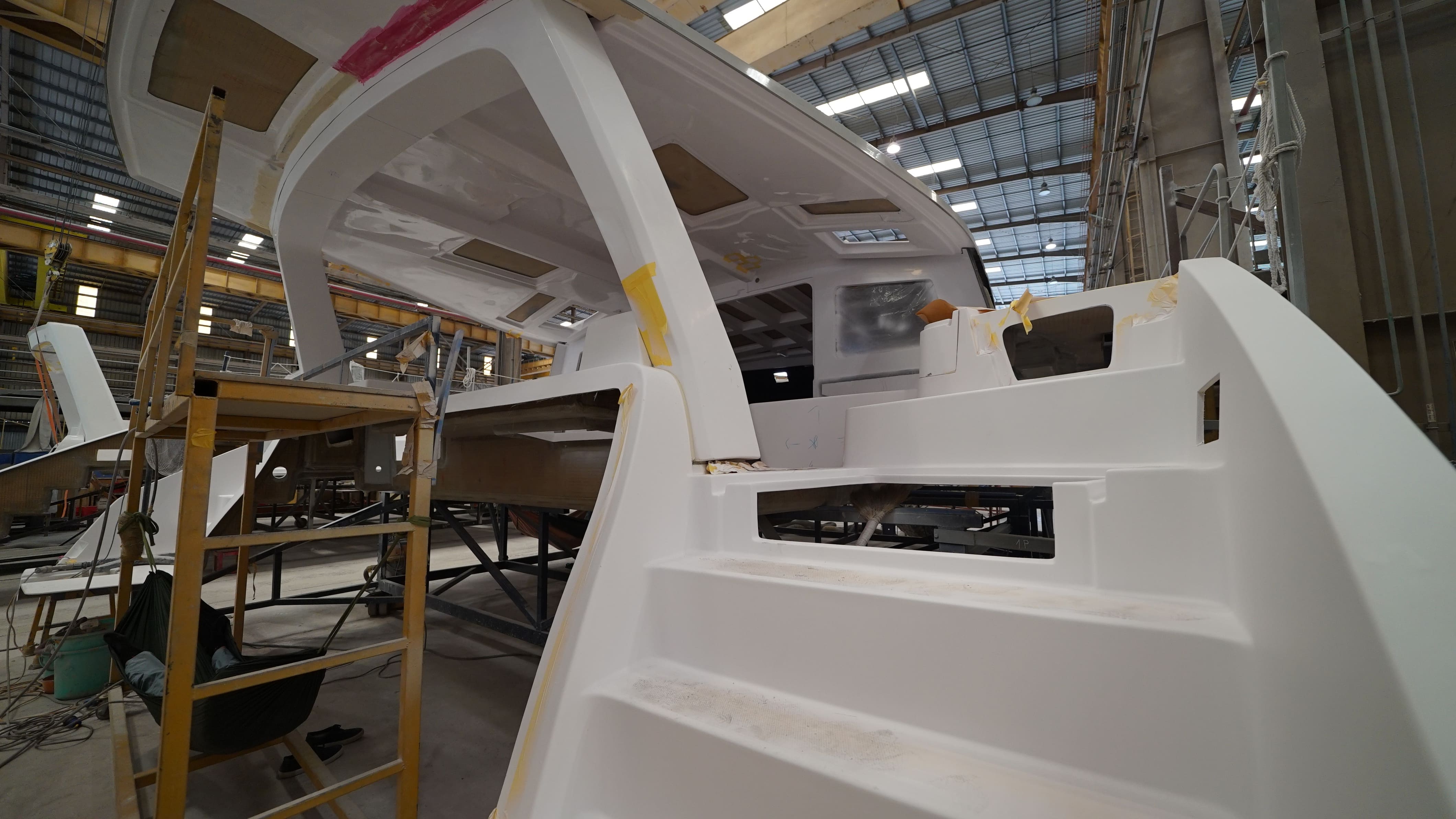

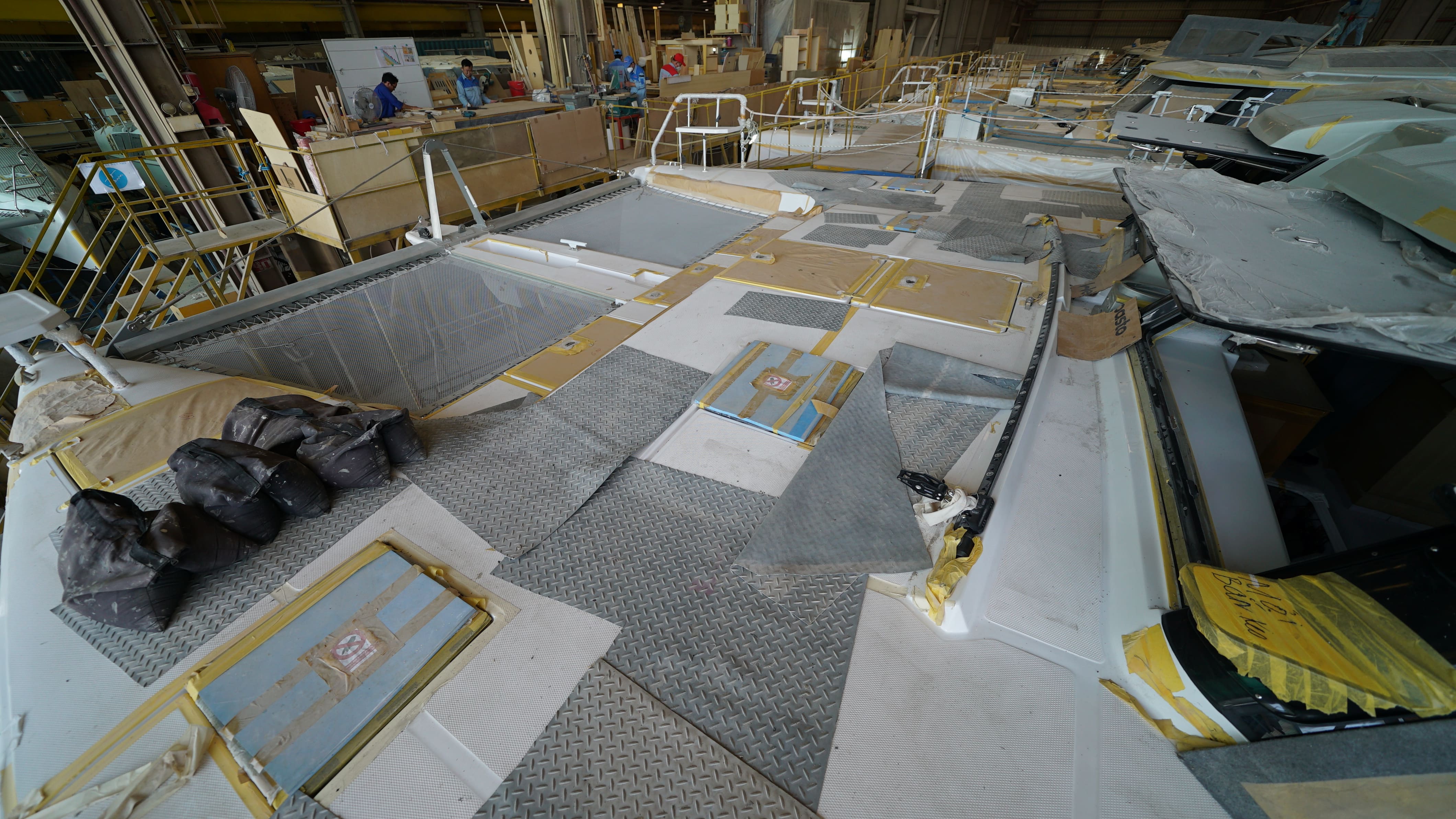

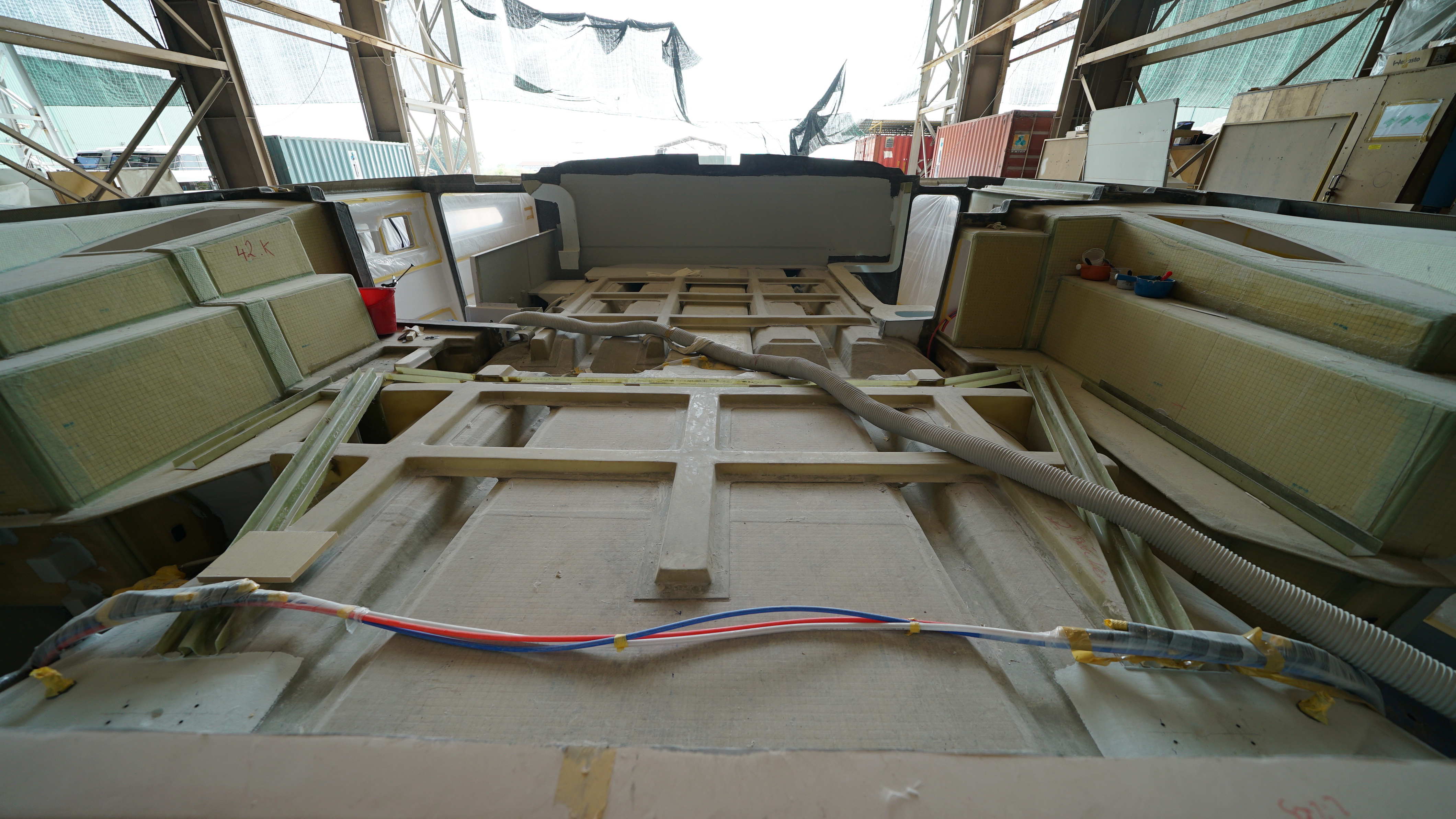

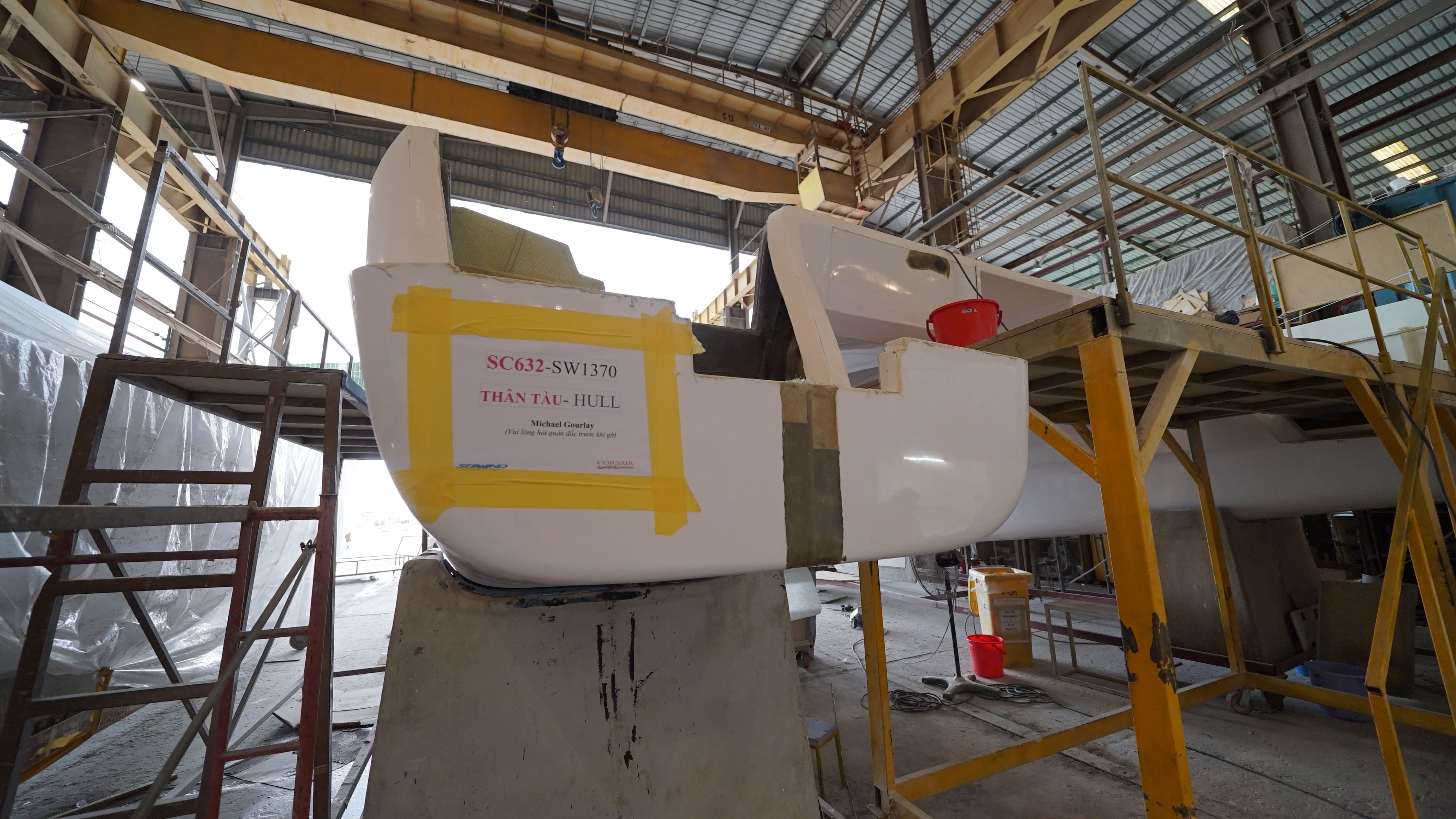

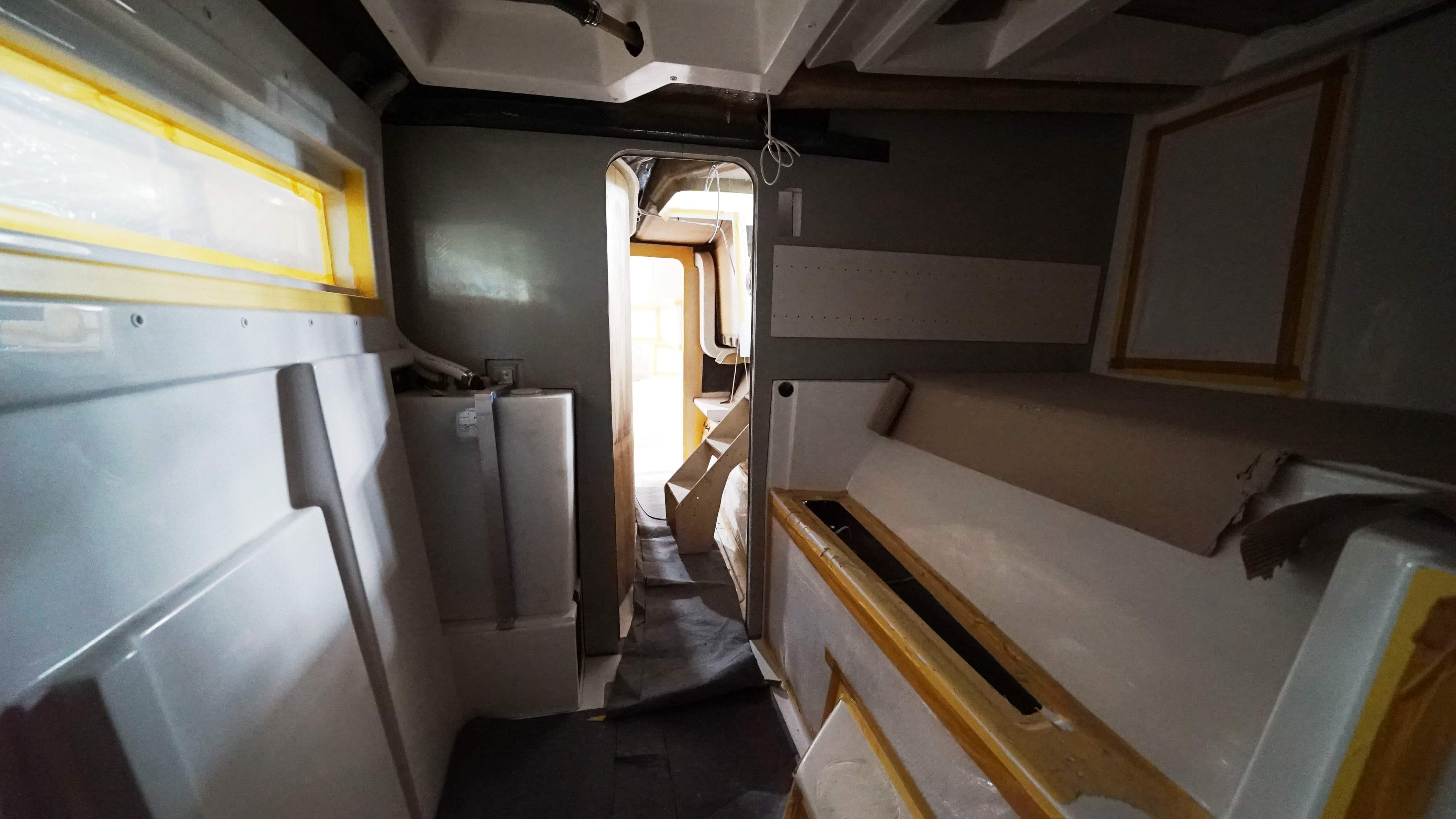

We are excited to inform you that your boat has been moved to the Assembly stage.

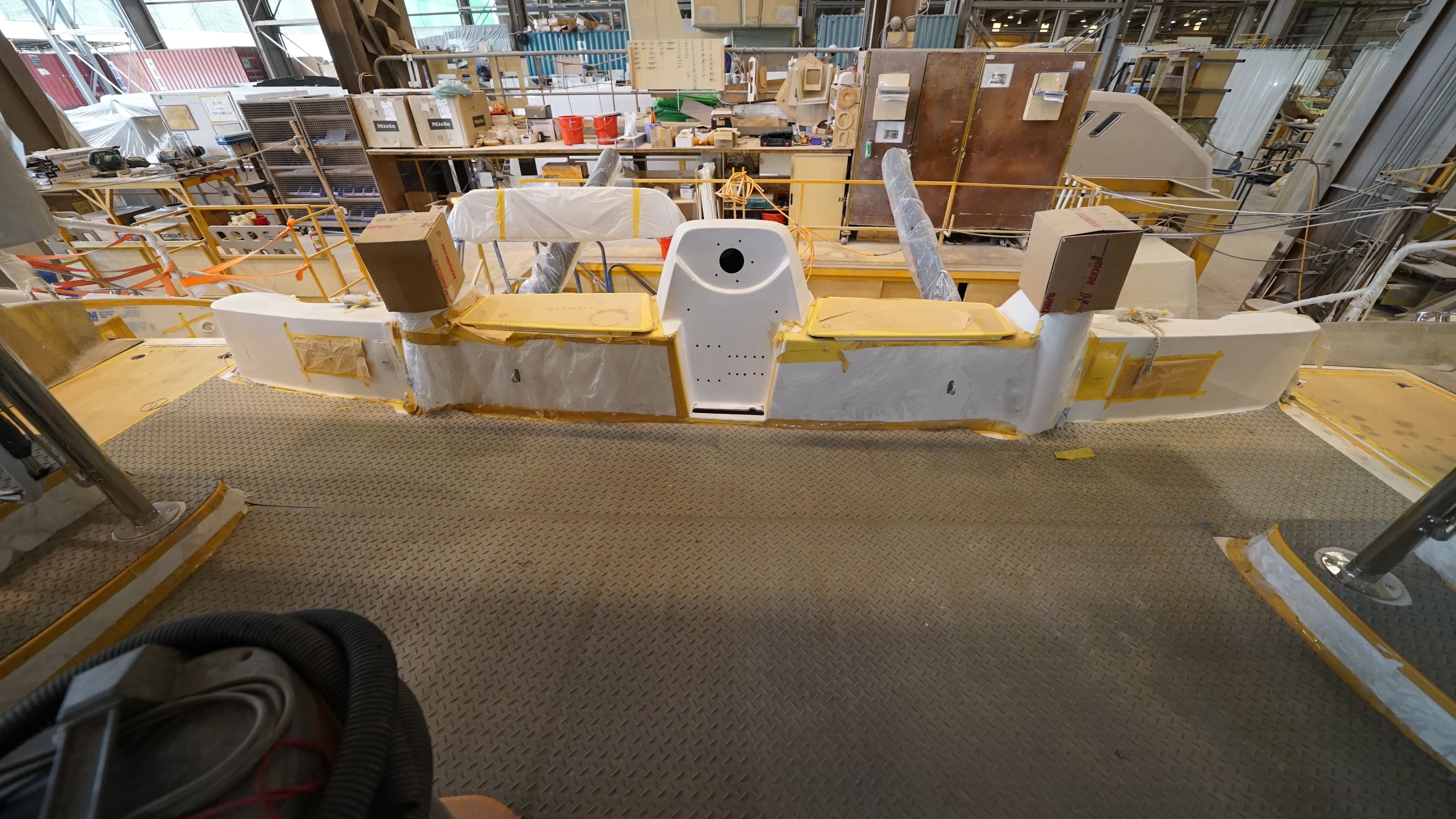

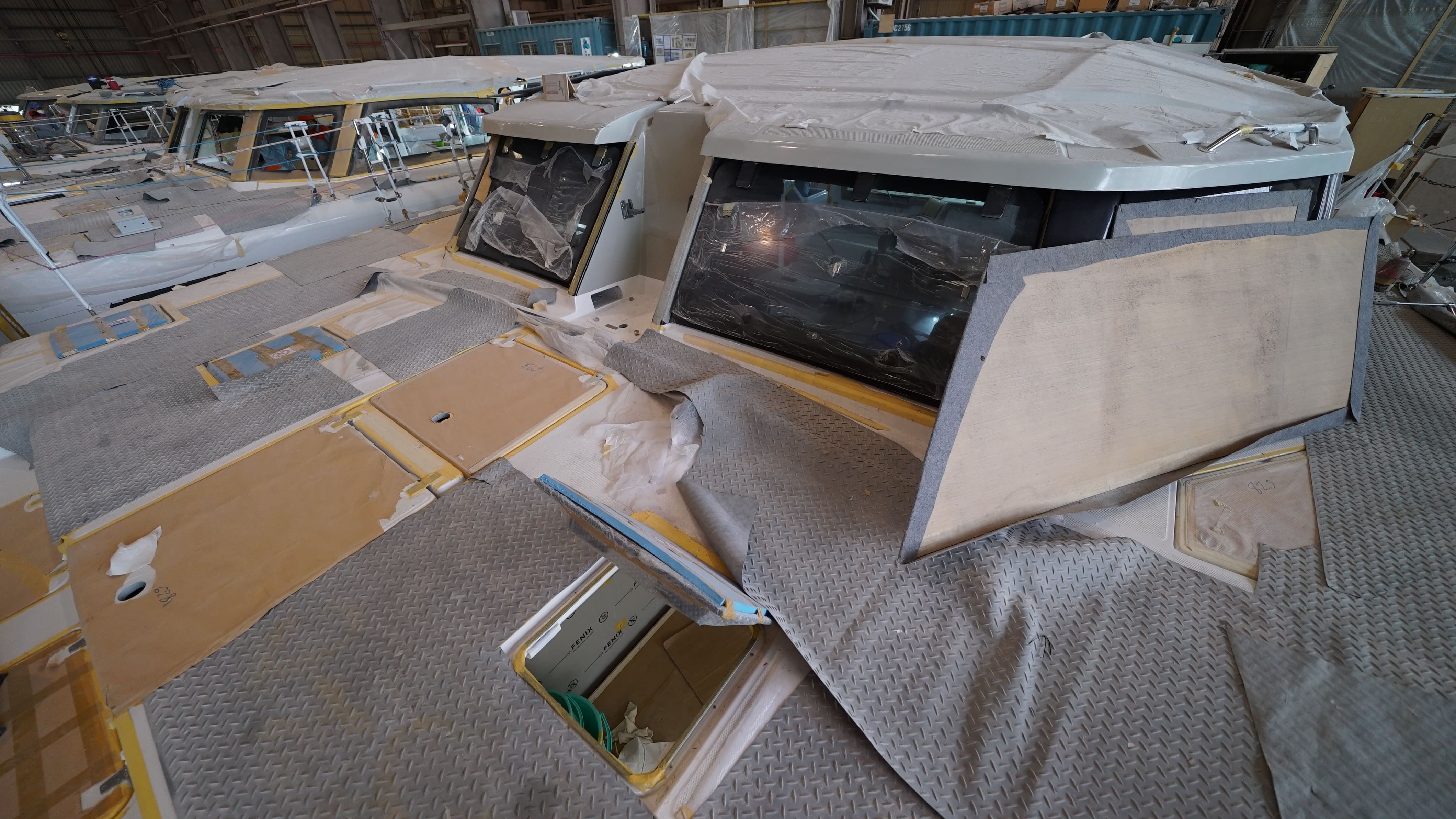

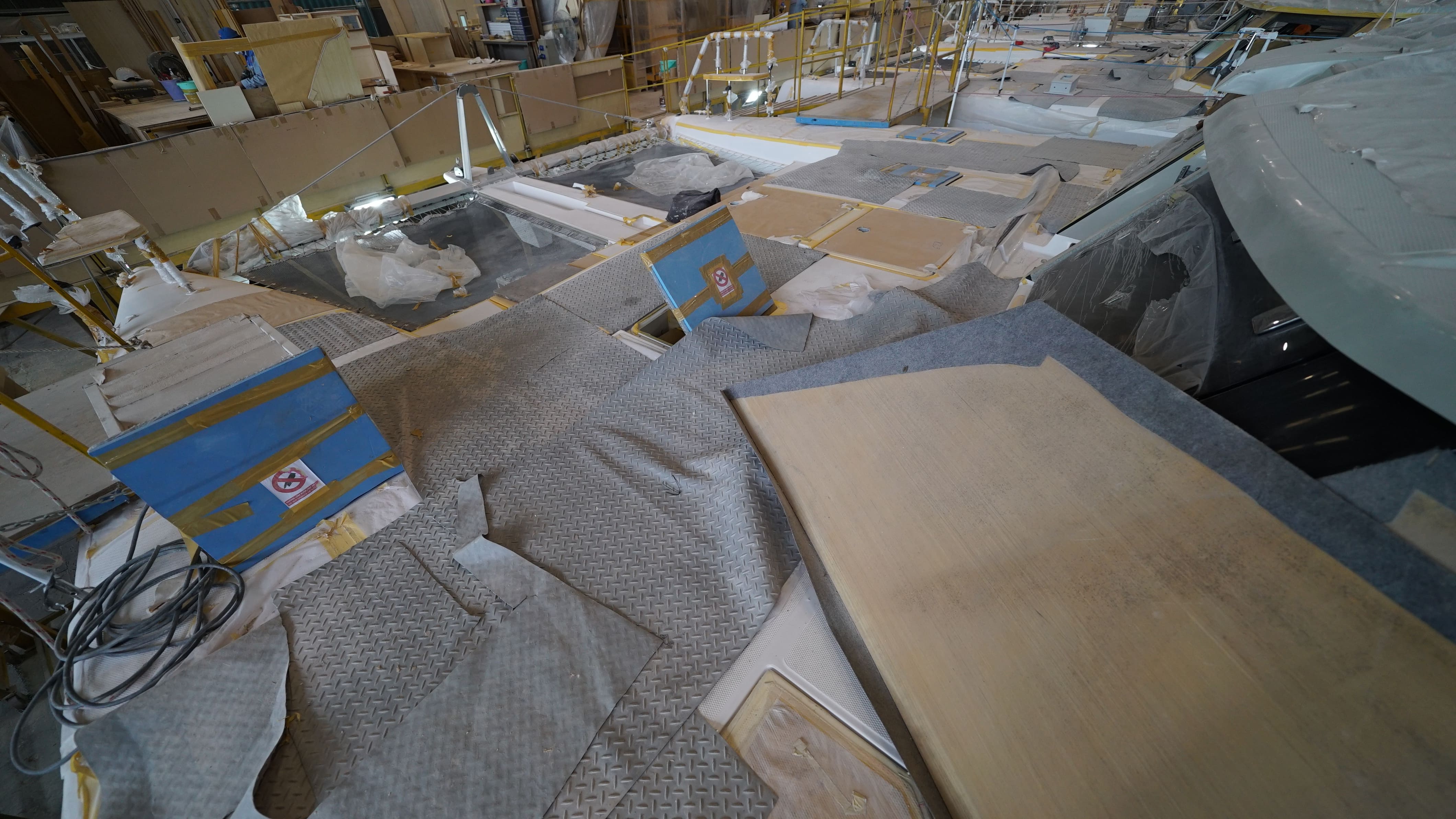

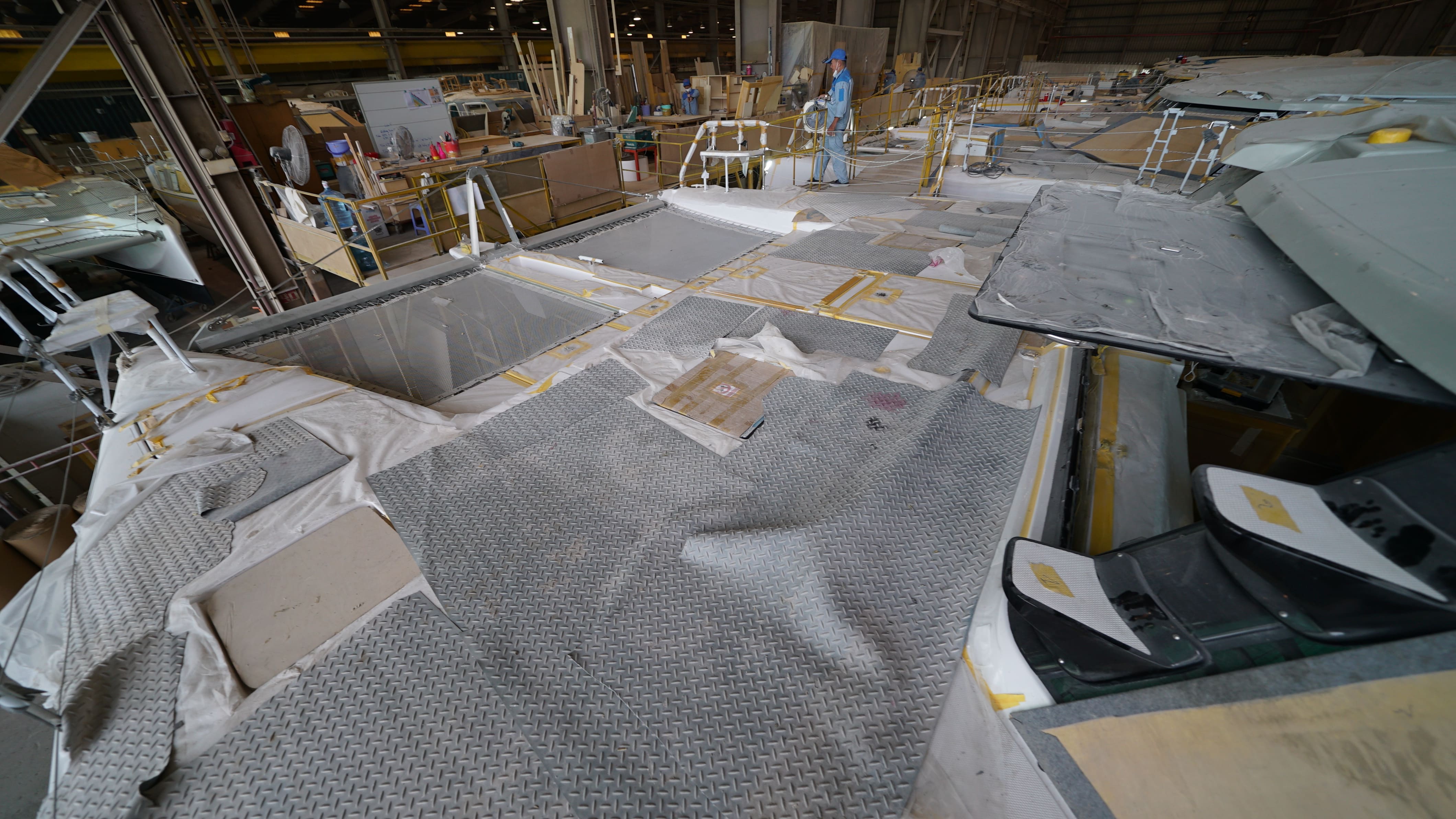

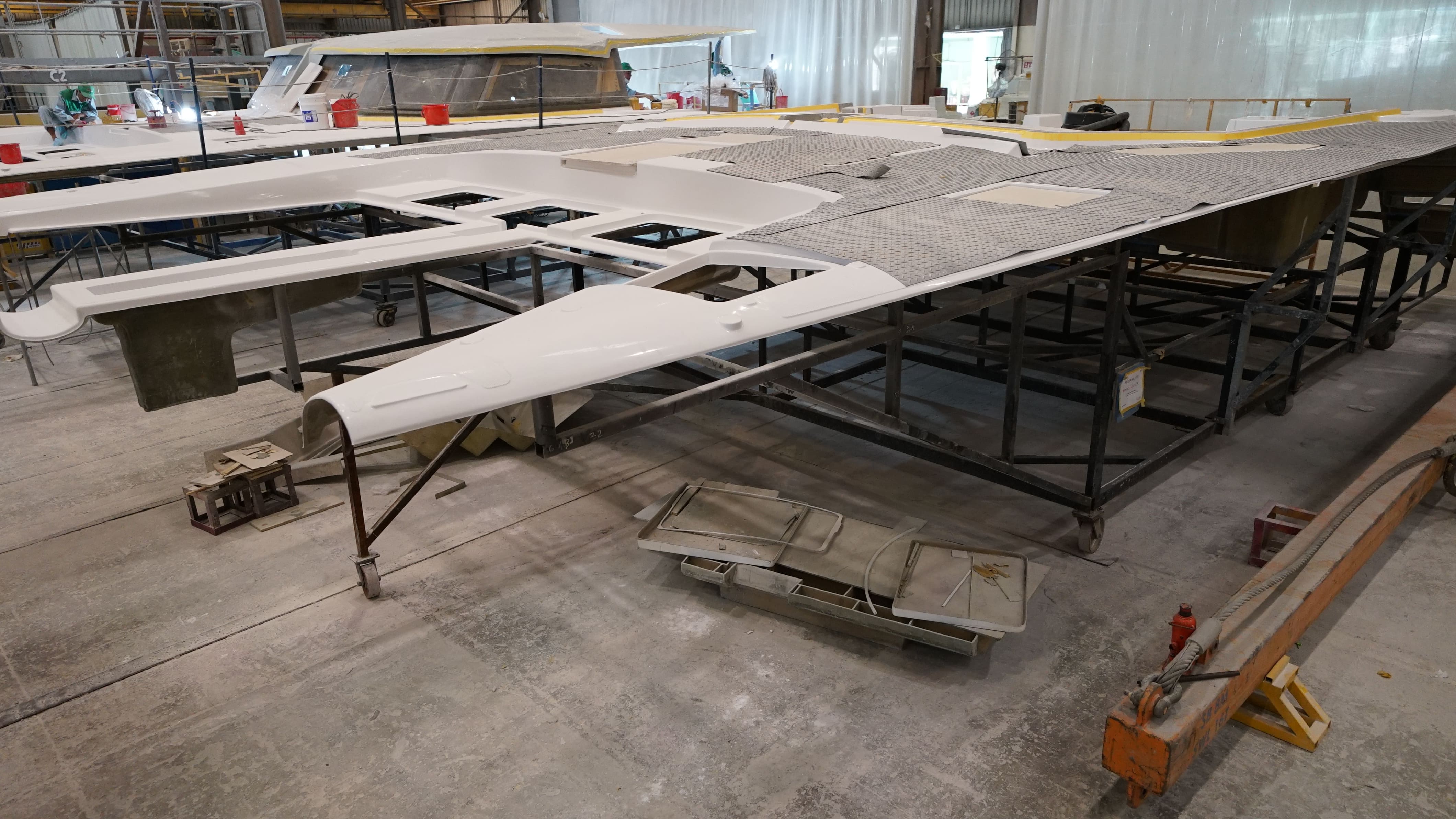

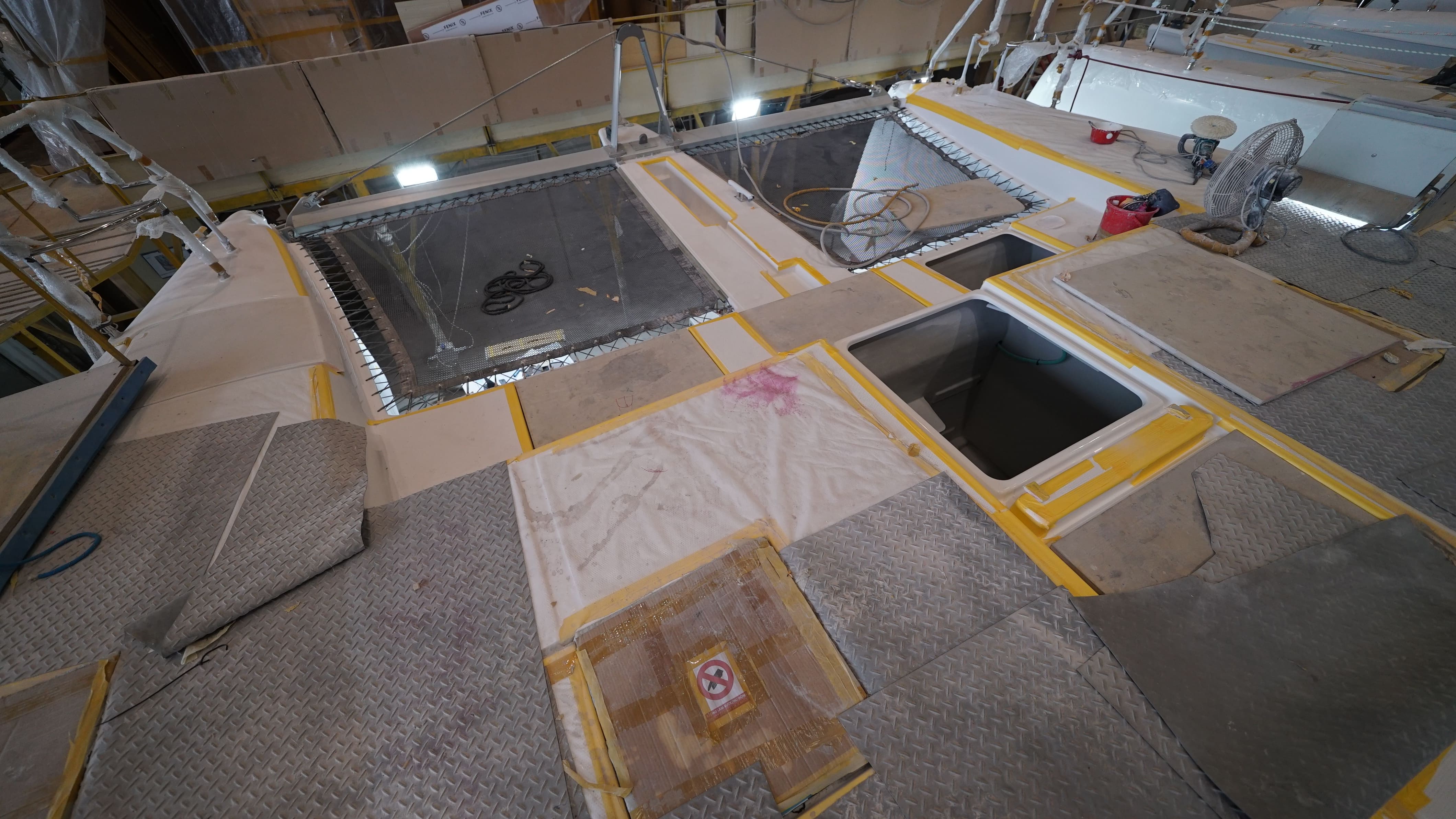

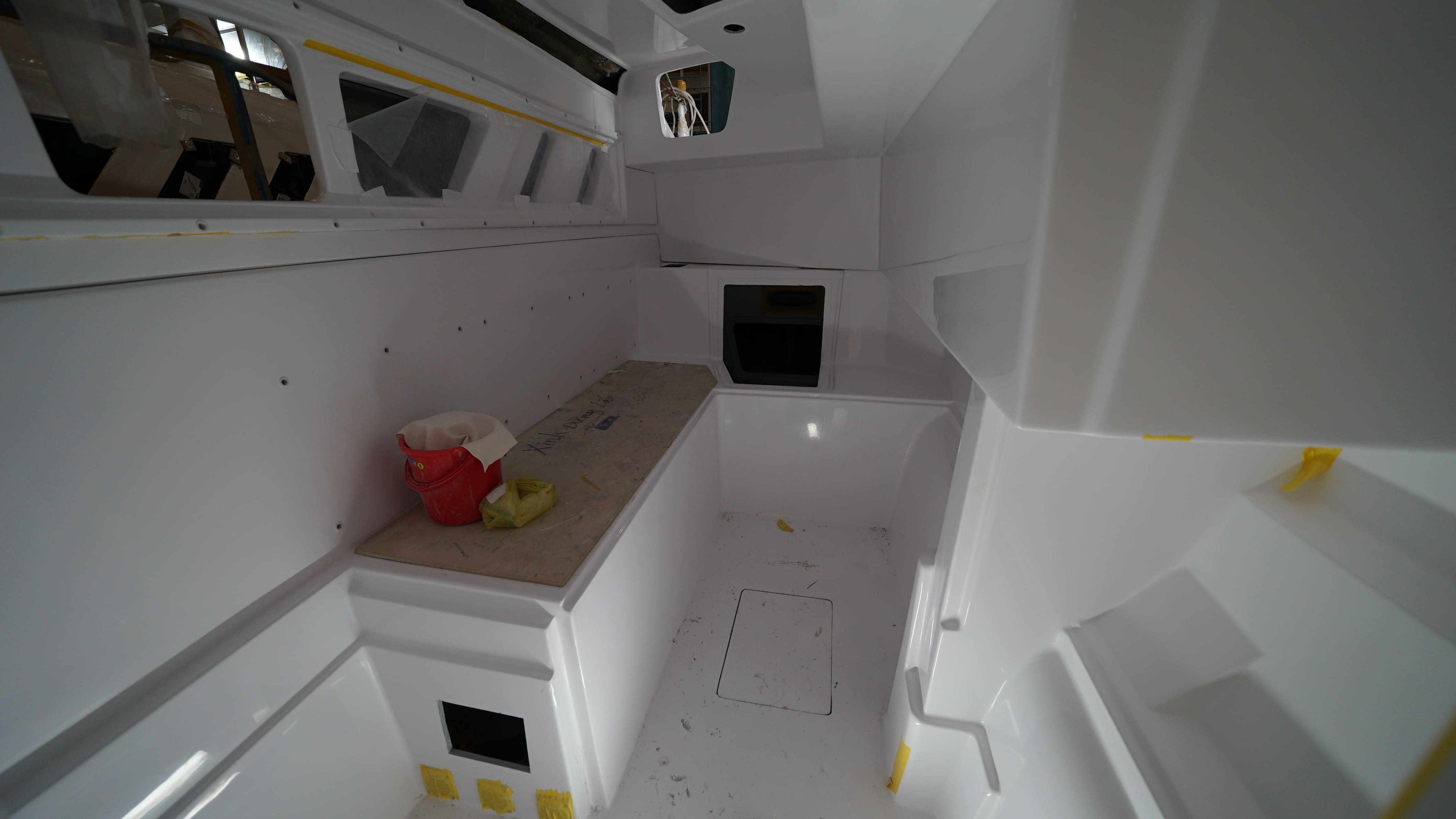

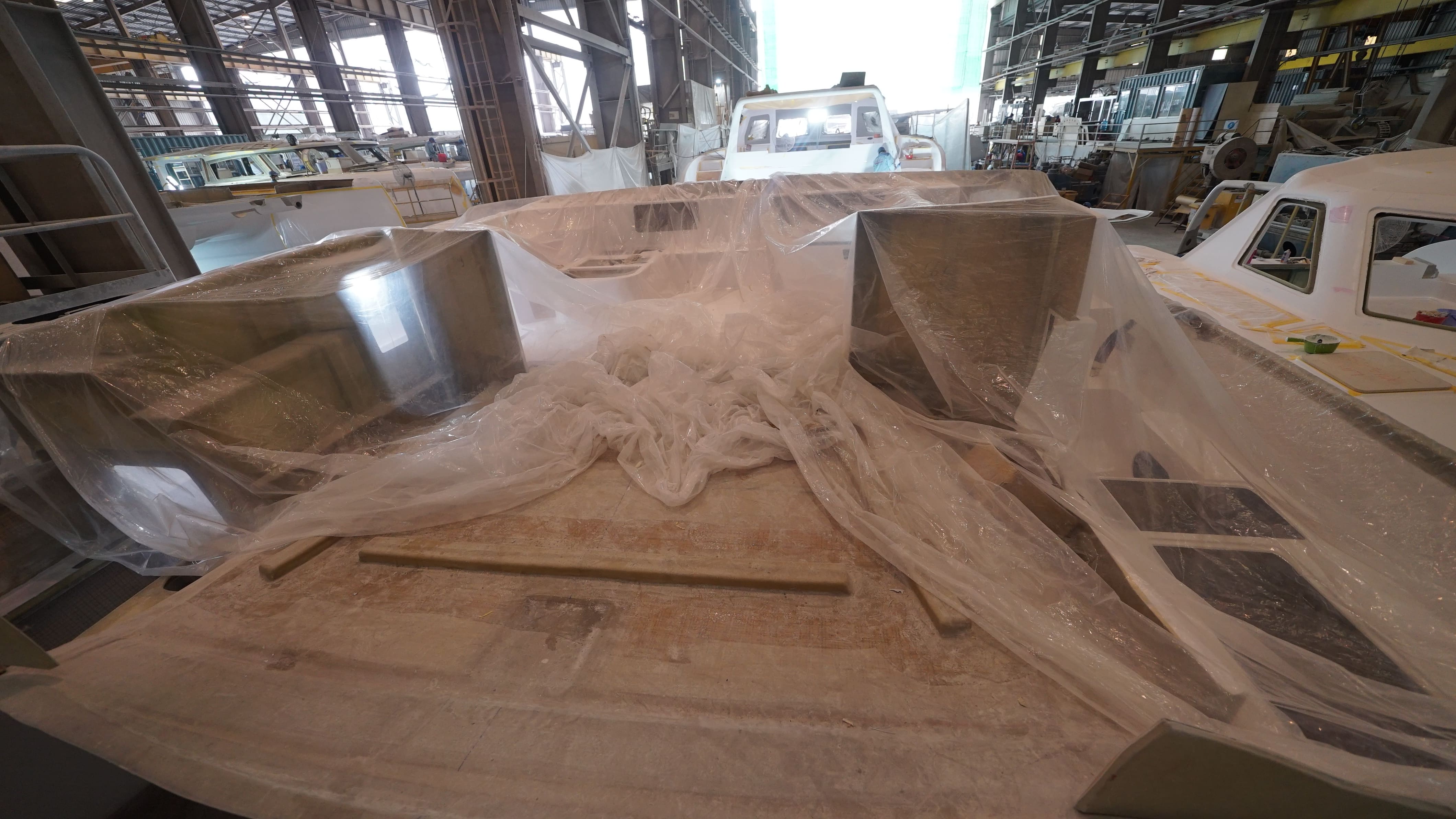

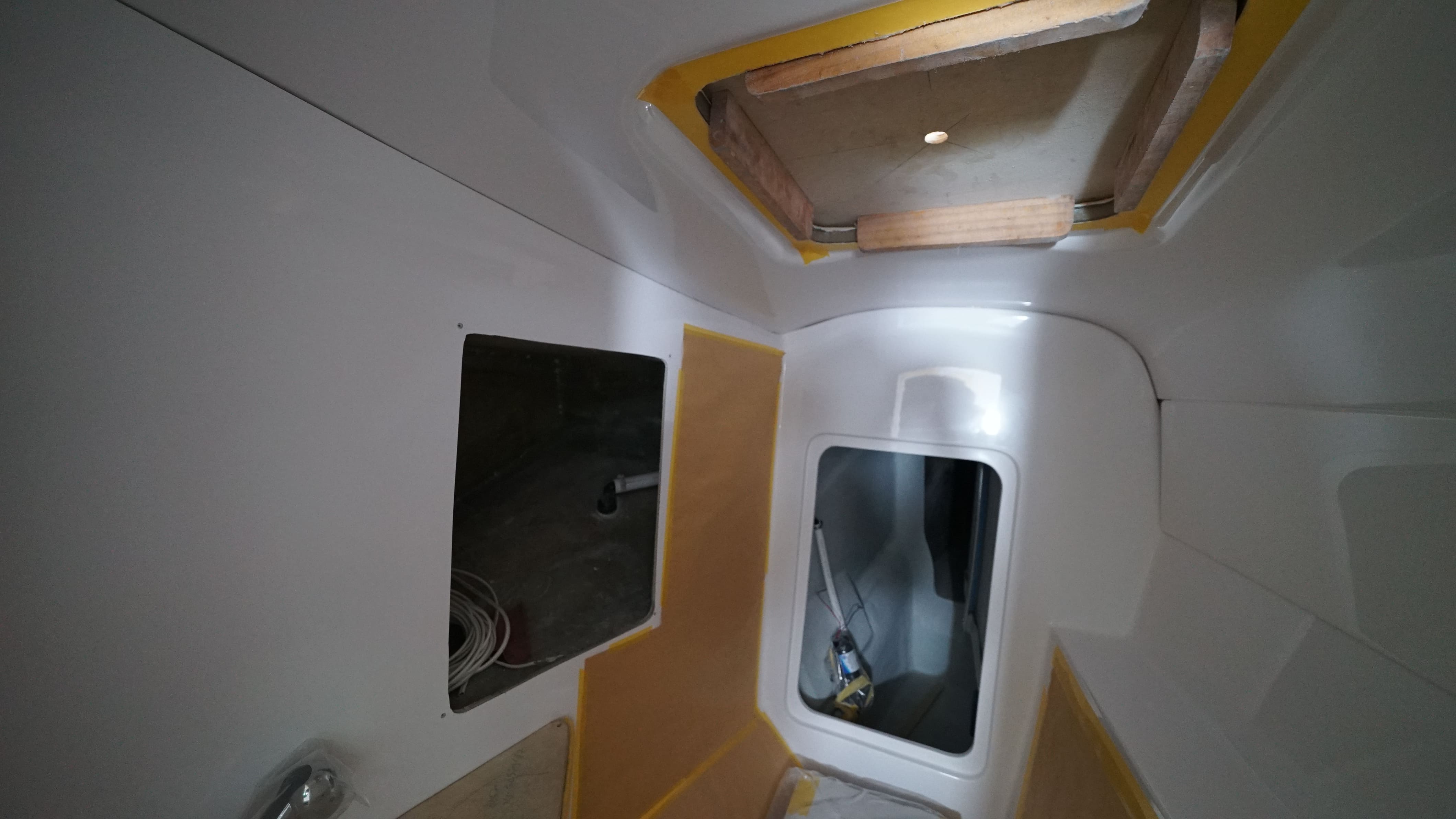

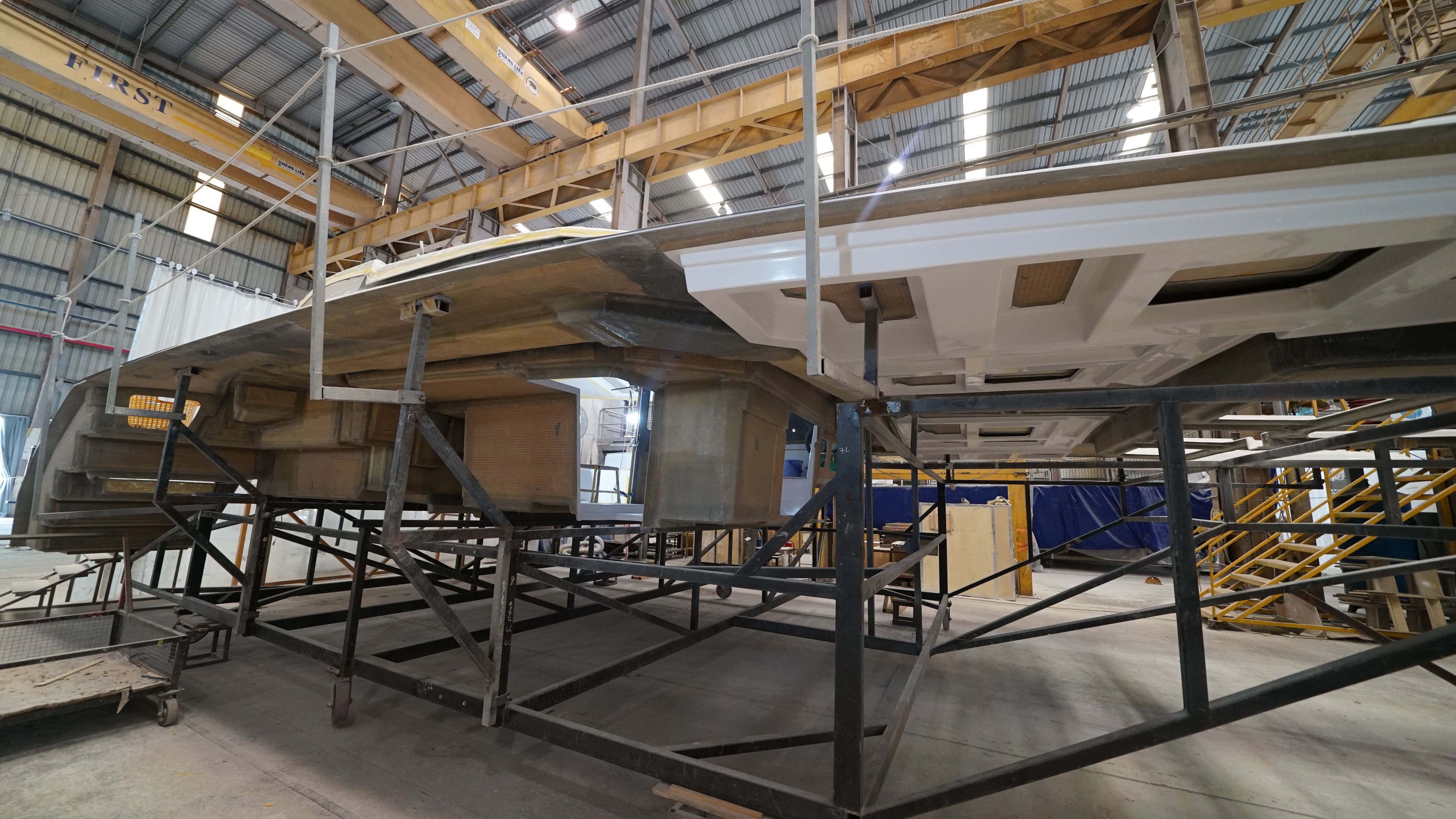

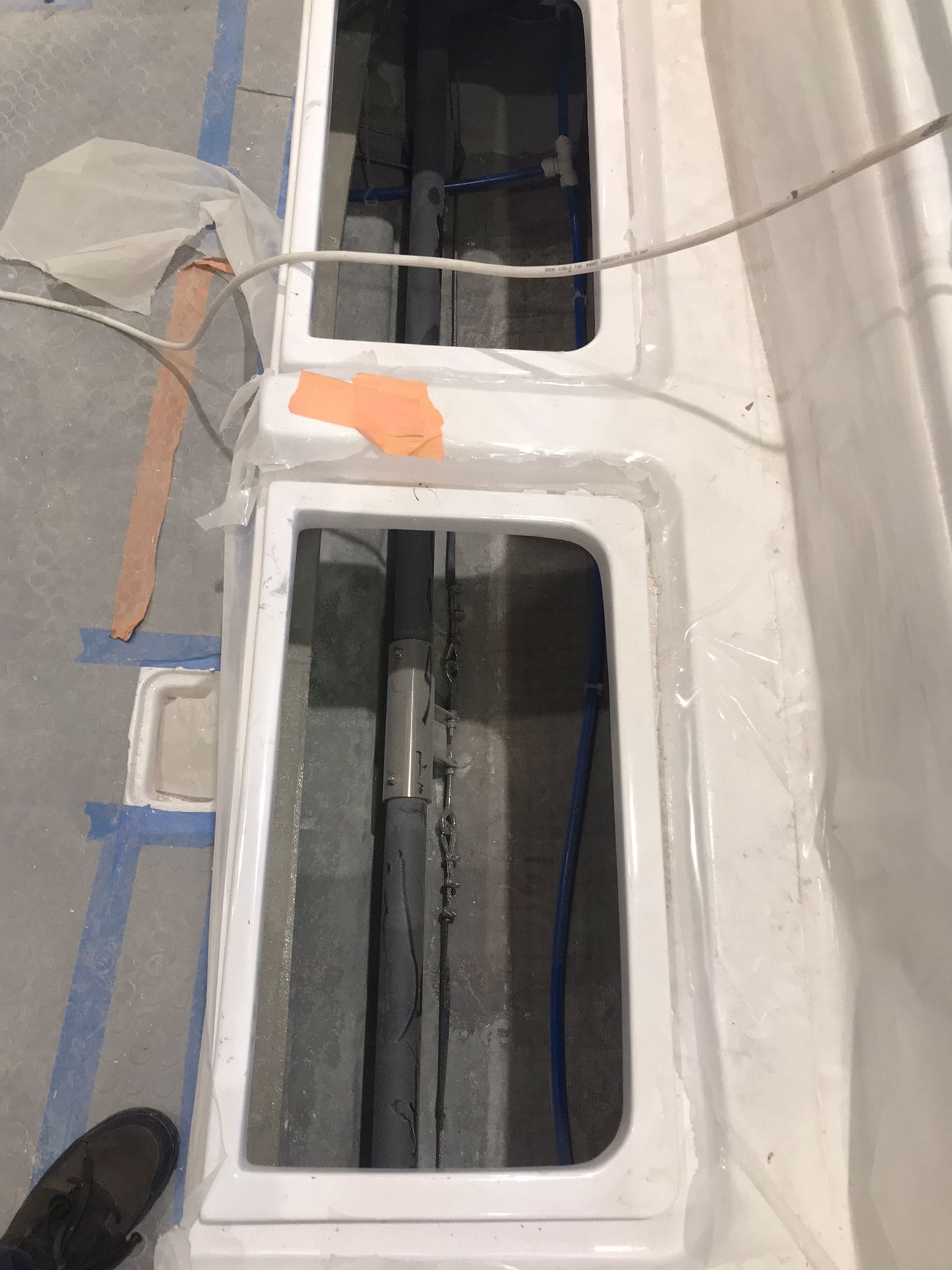

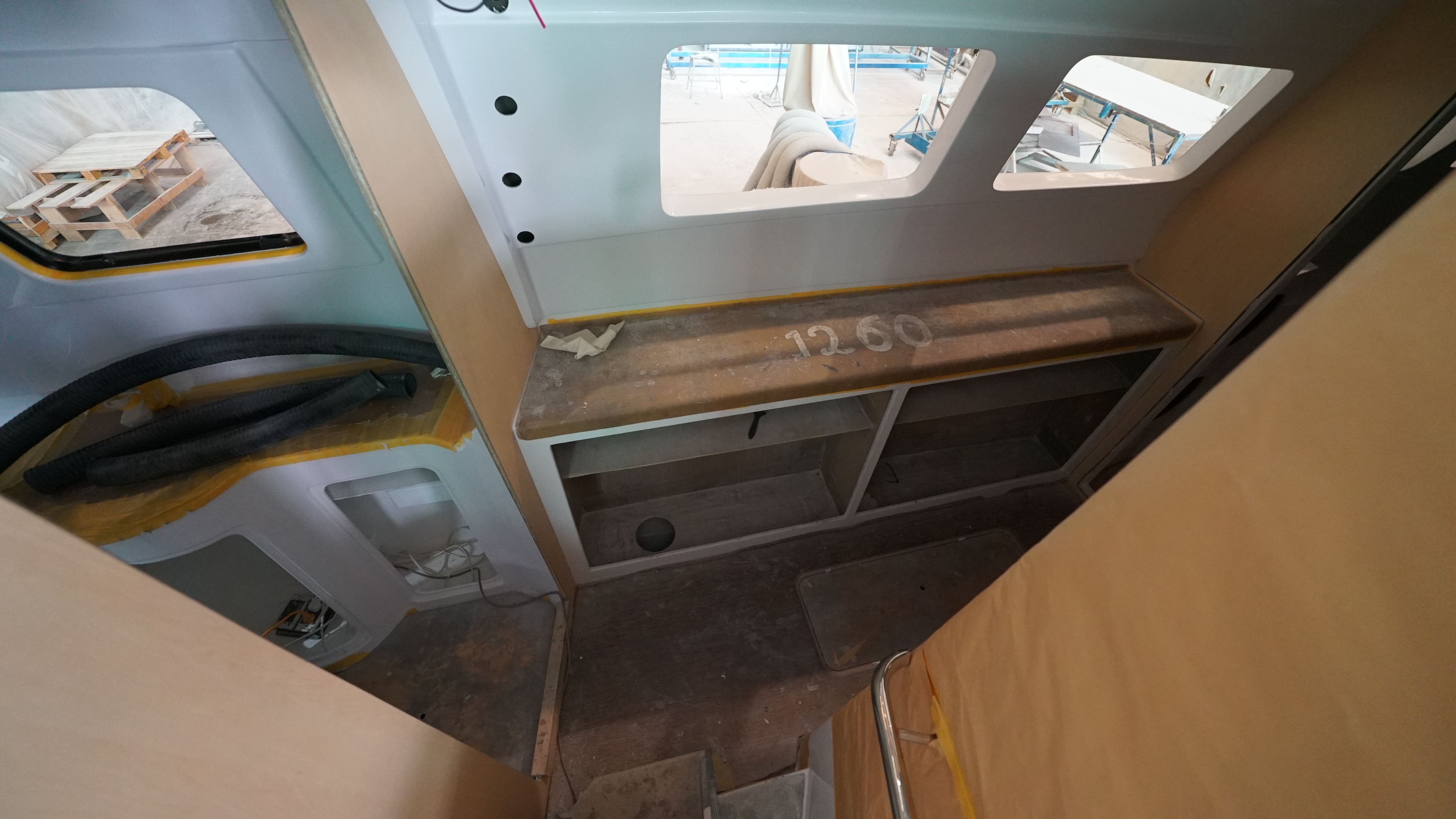

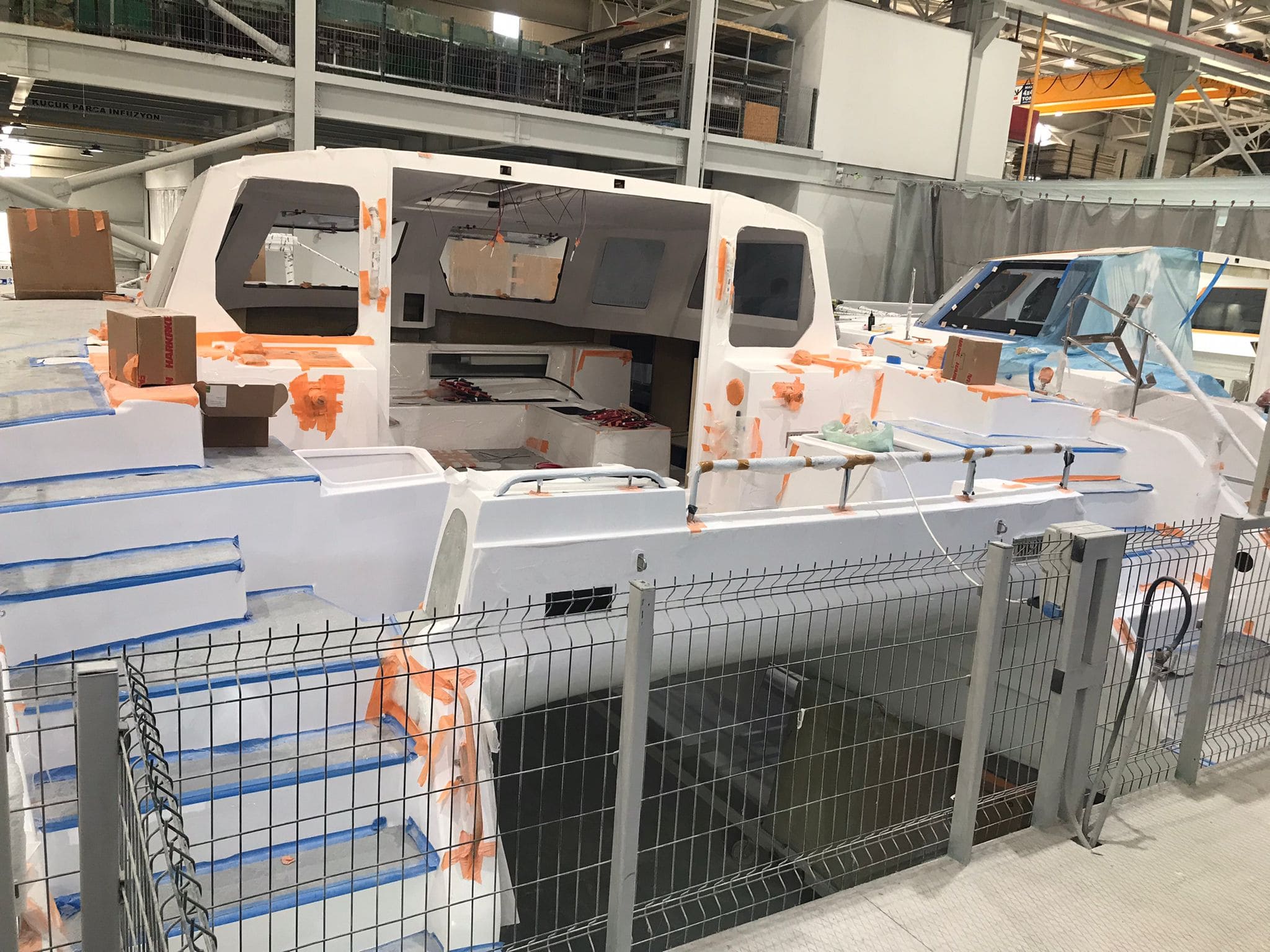

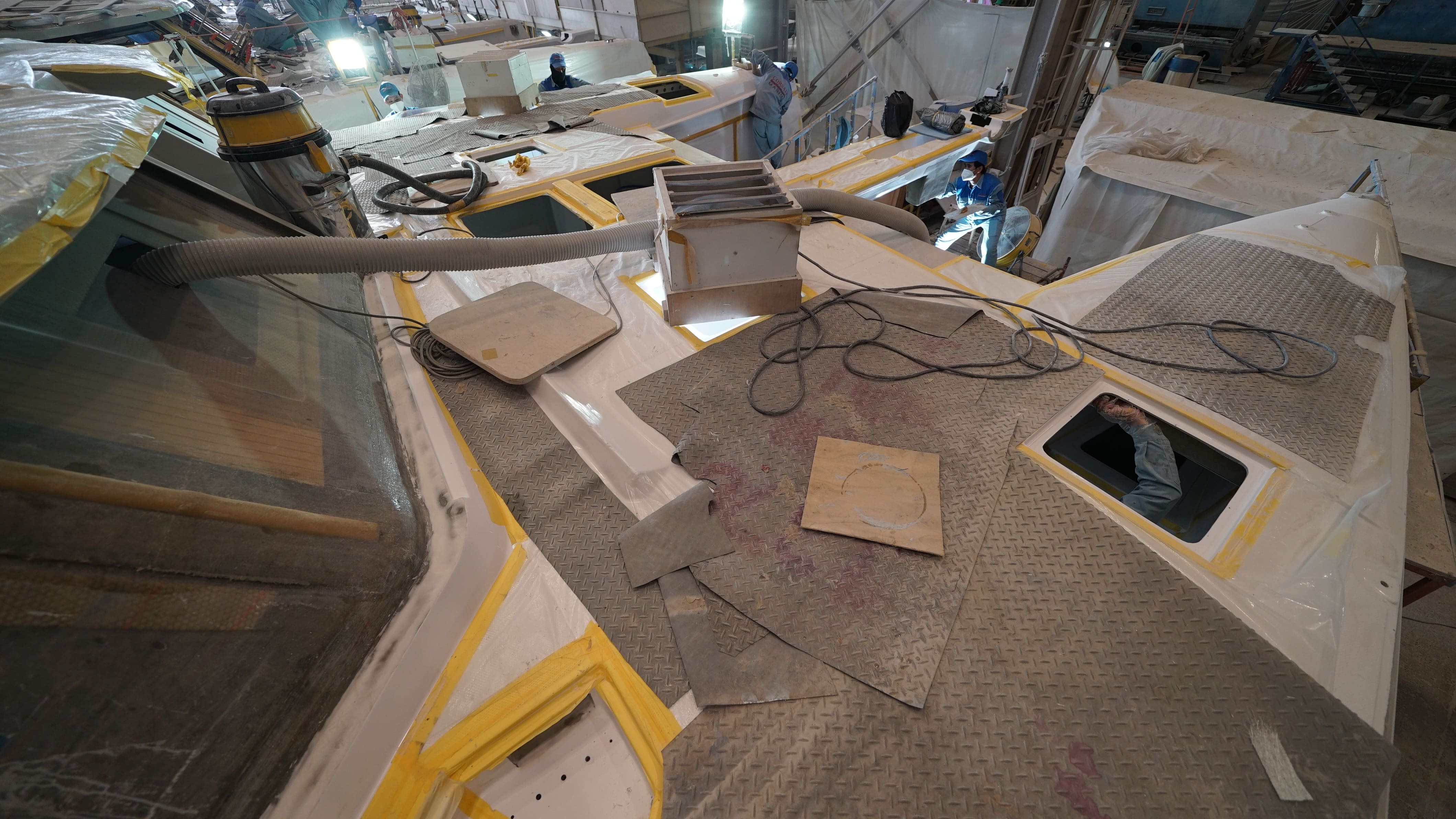

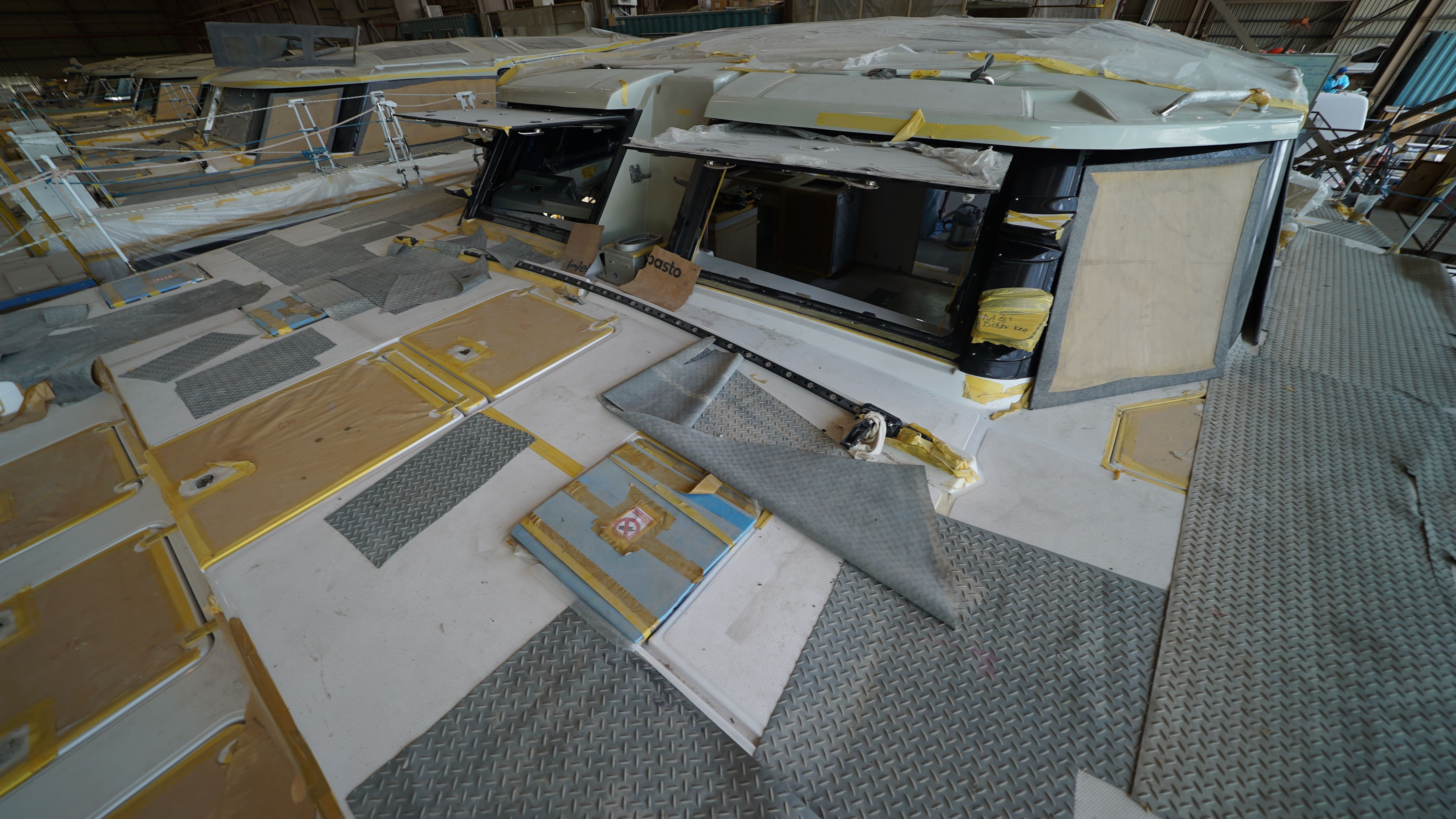

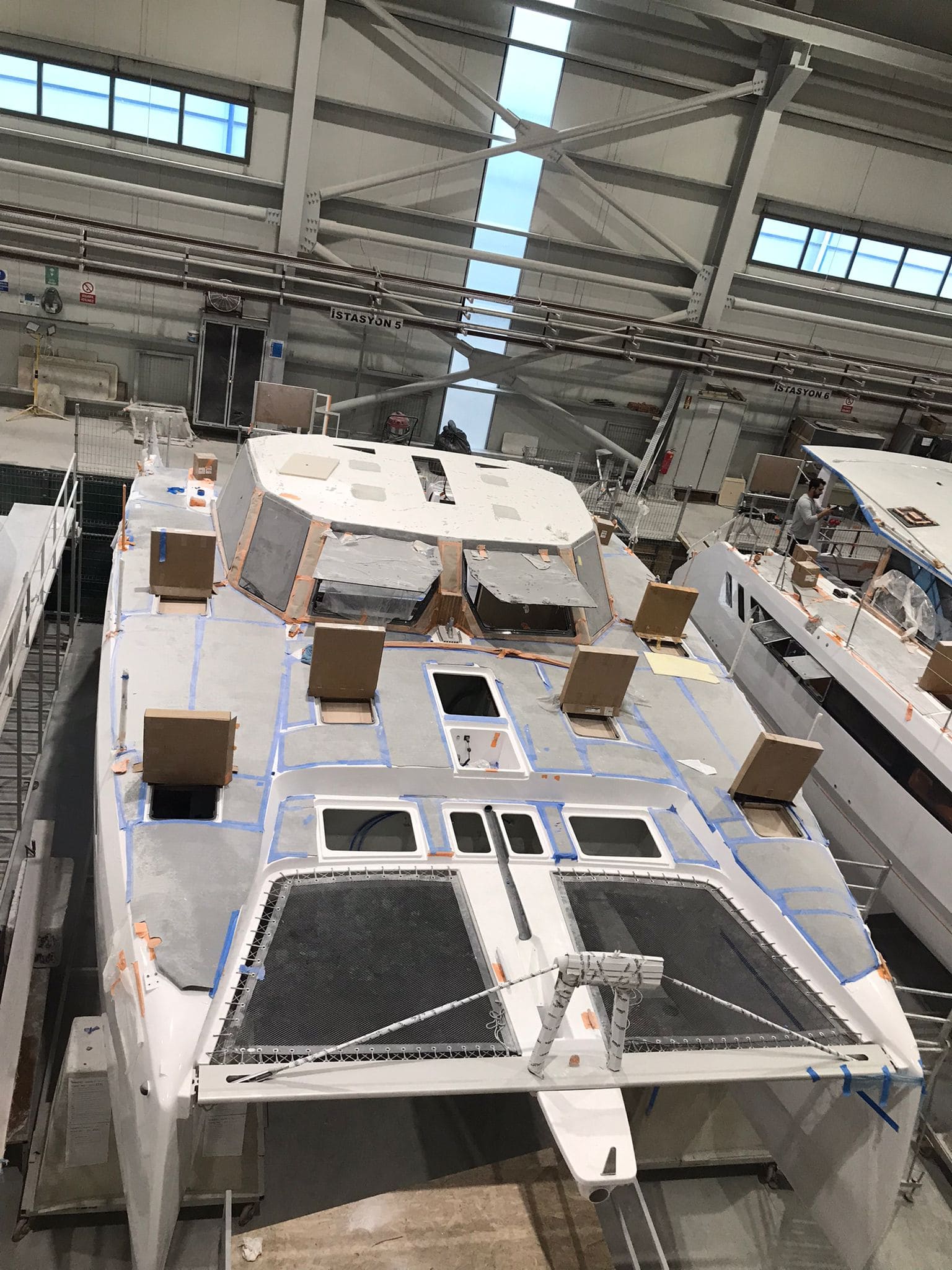

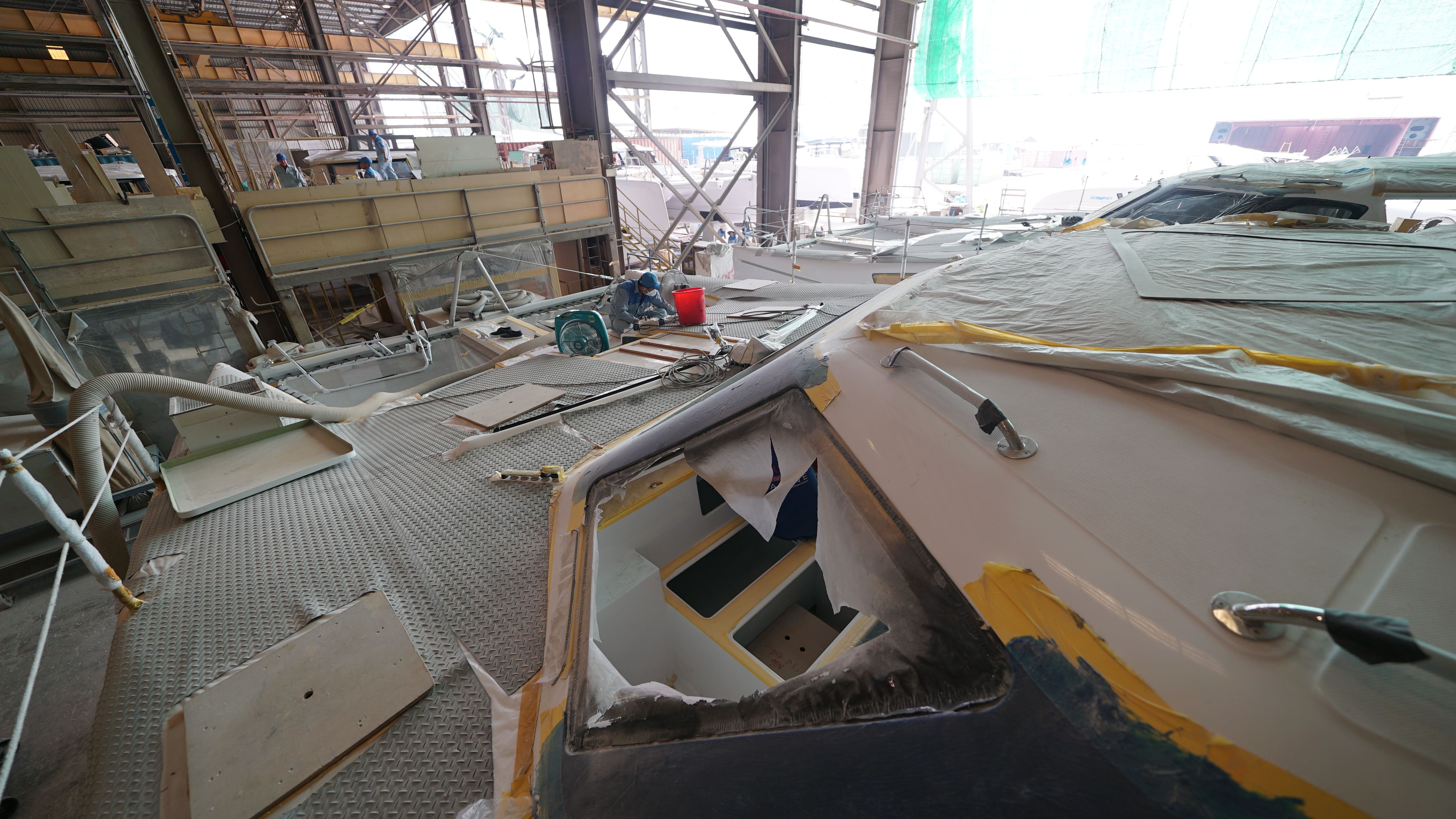

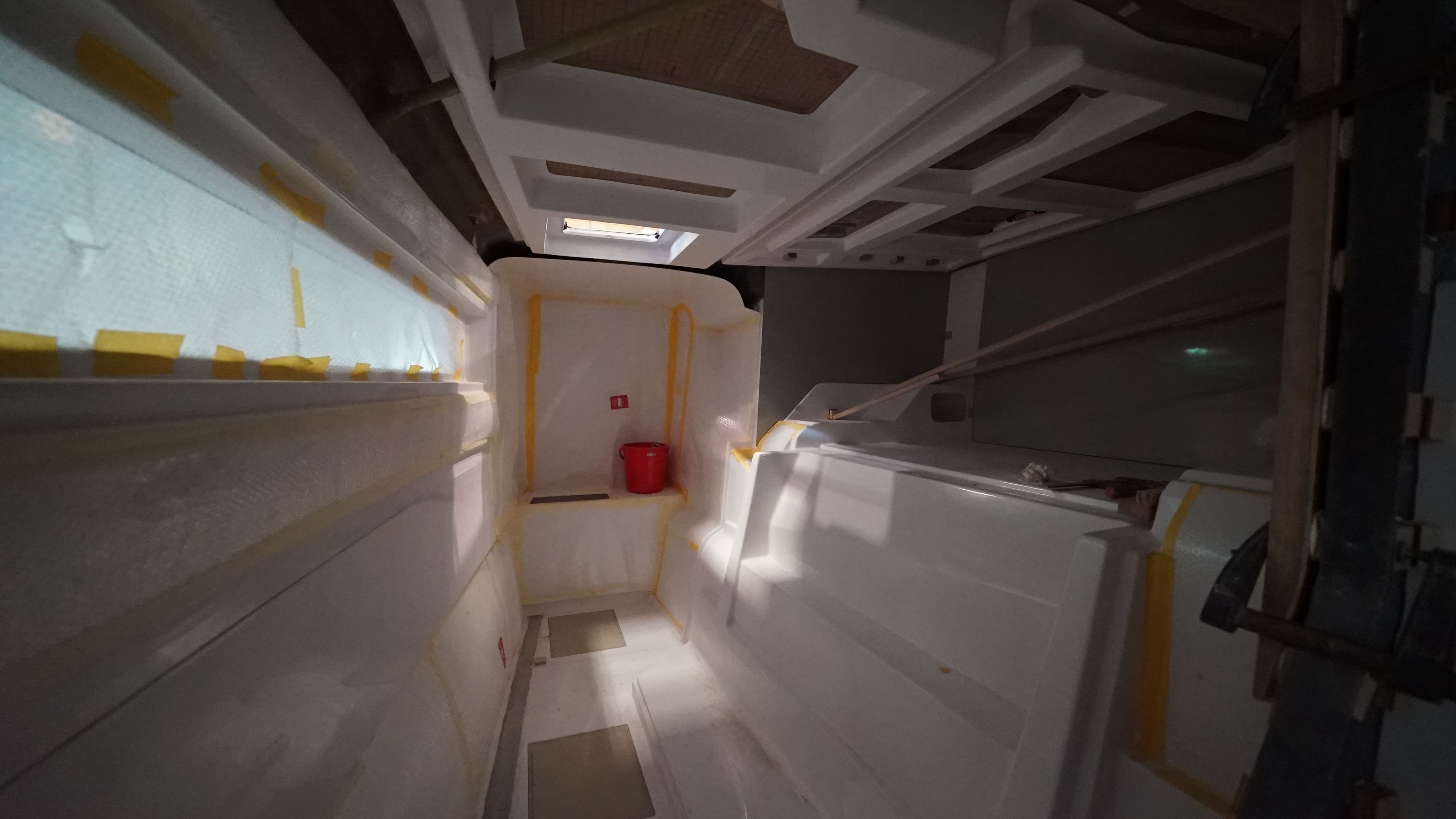

The hull and deck were demolded and IGU installation has been completed.

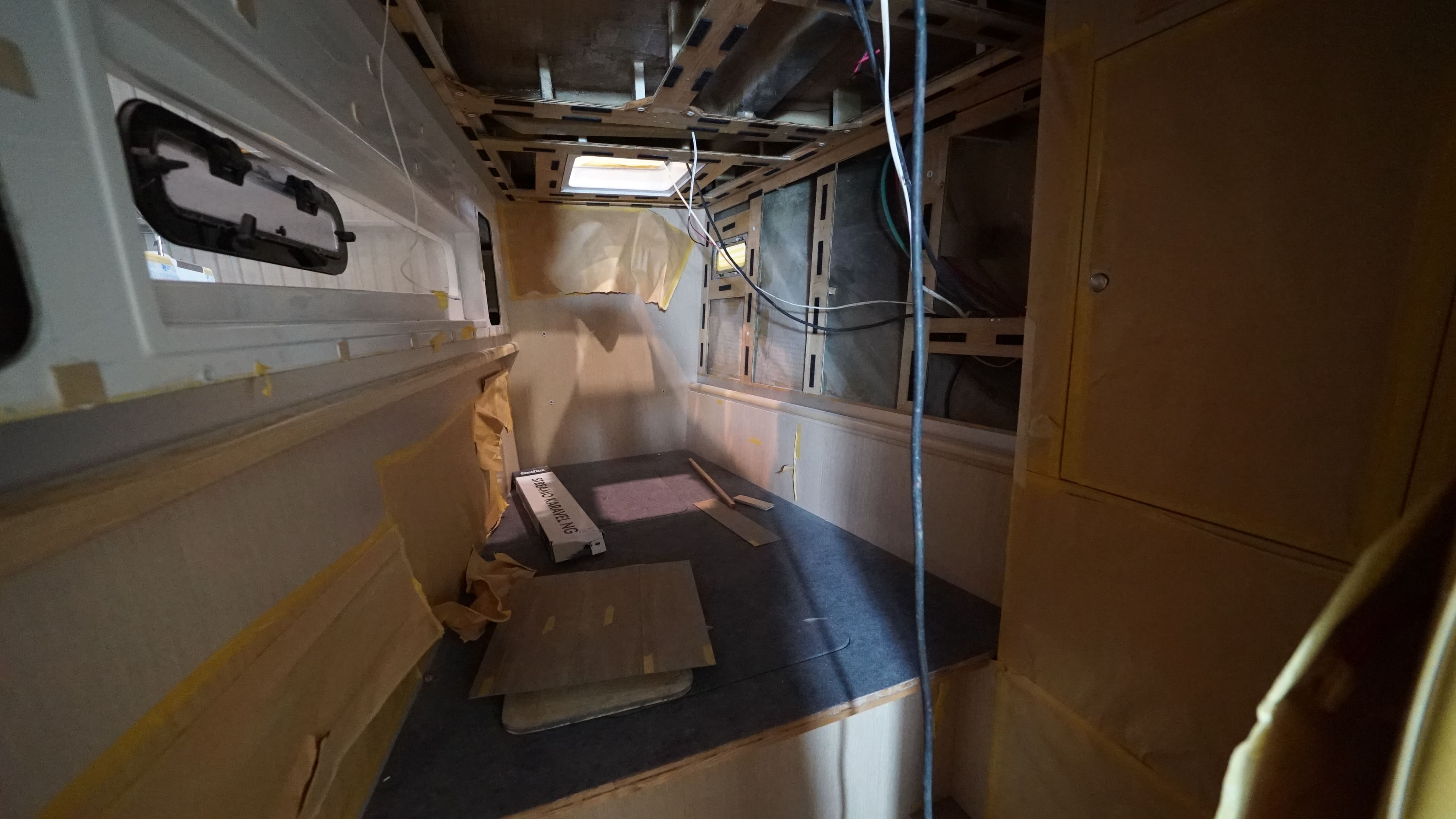

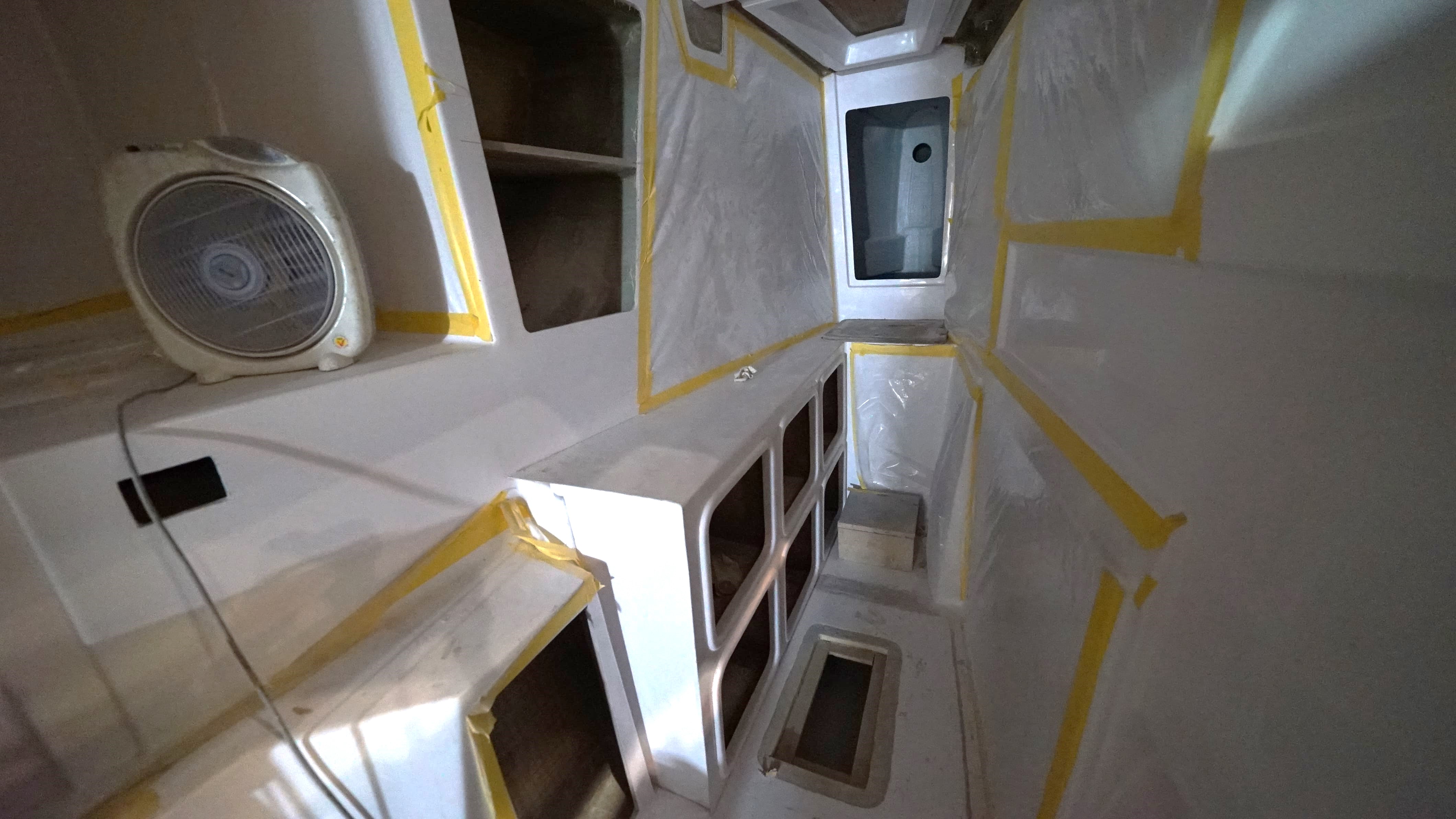

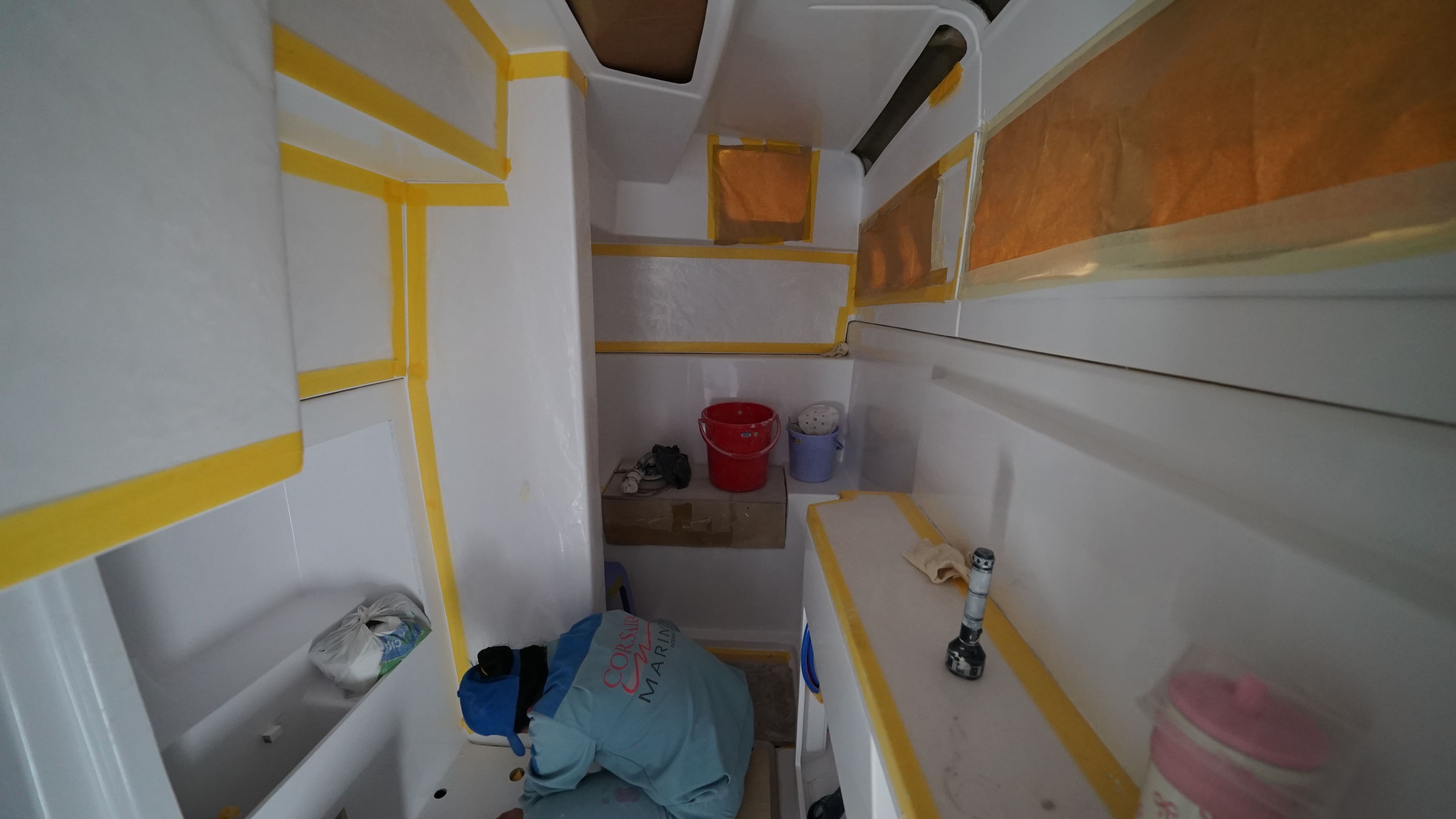

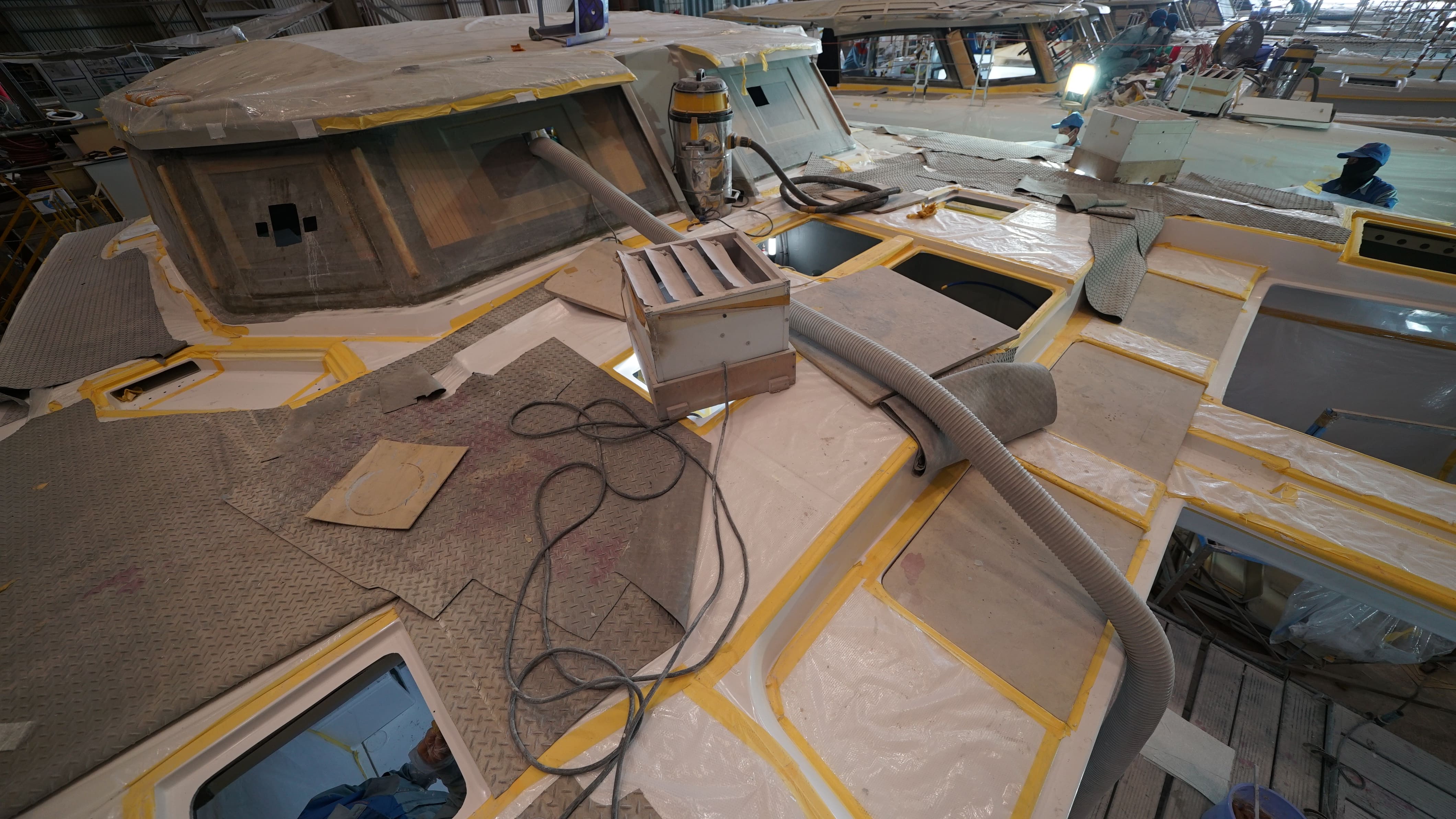

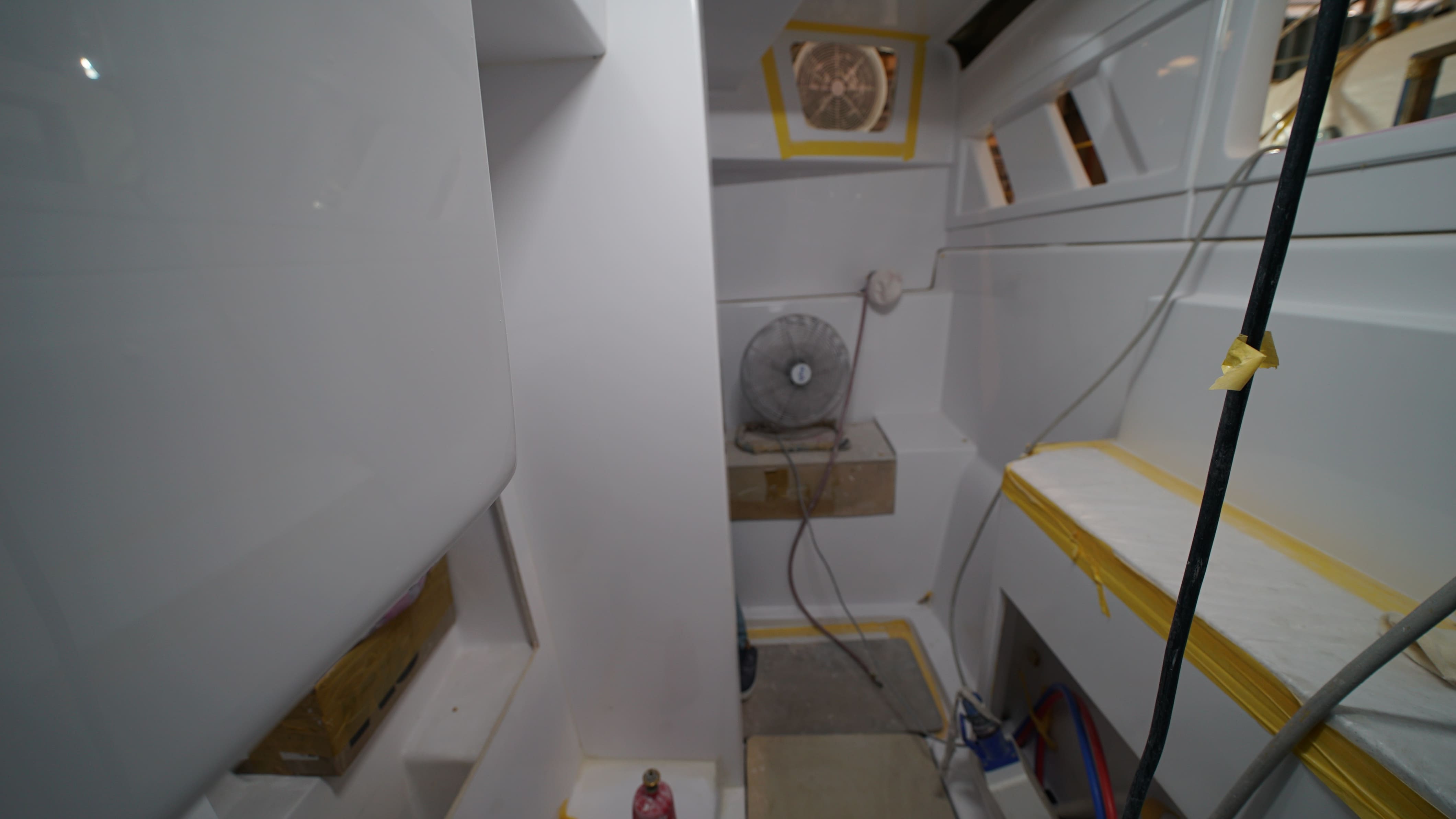

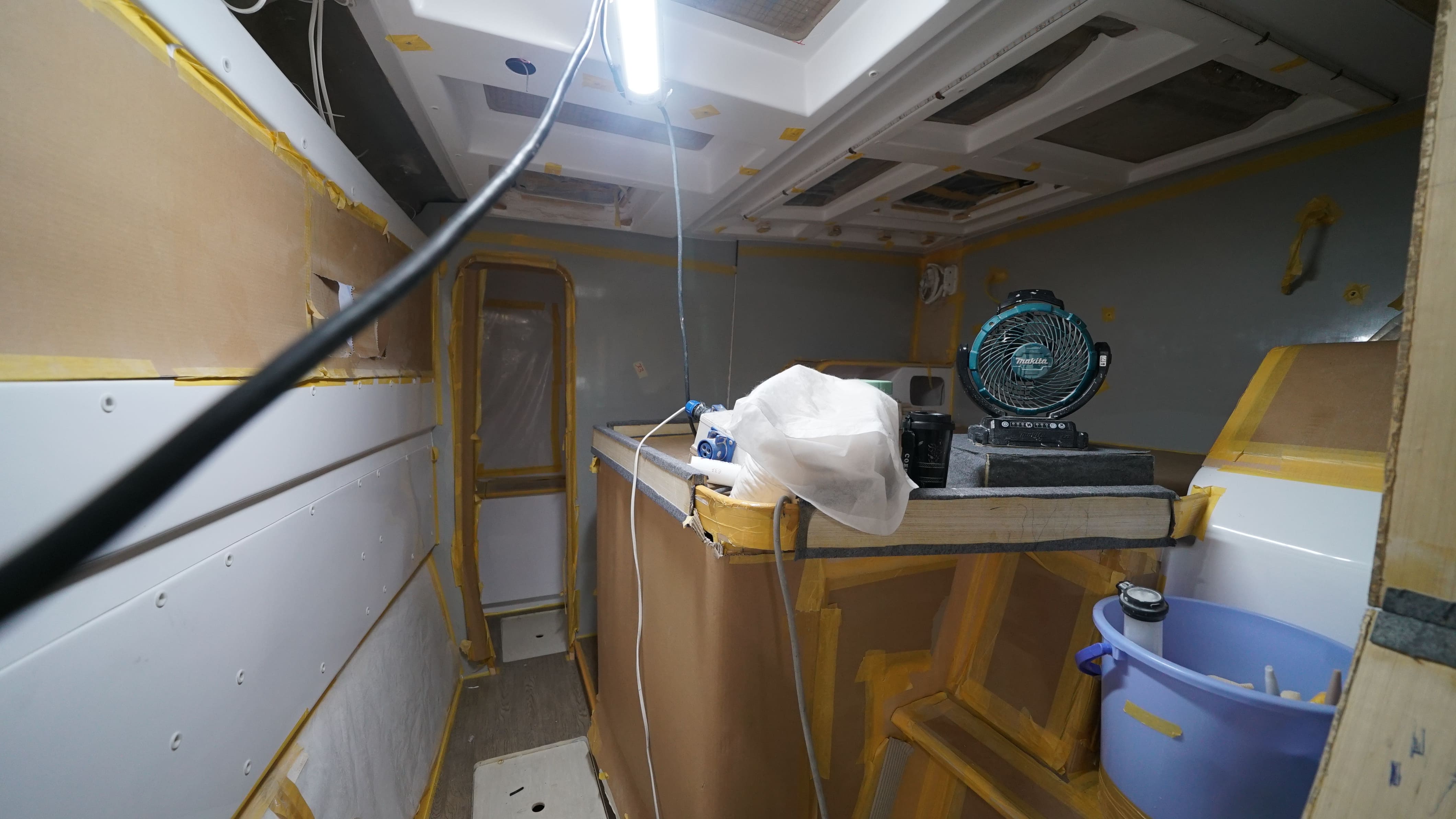

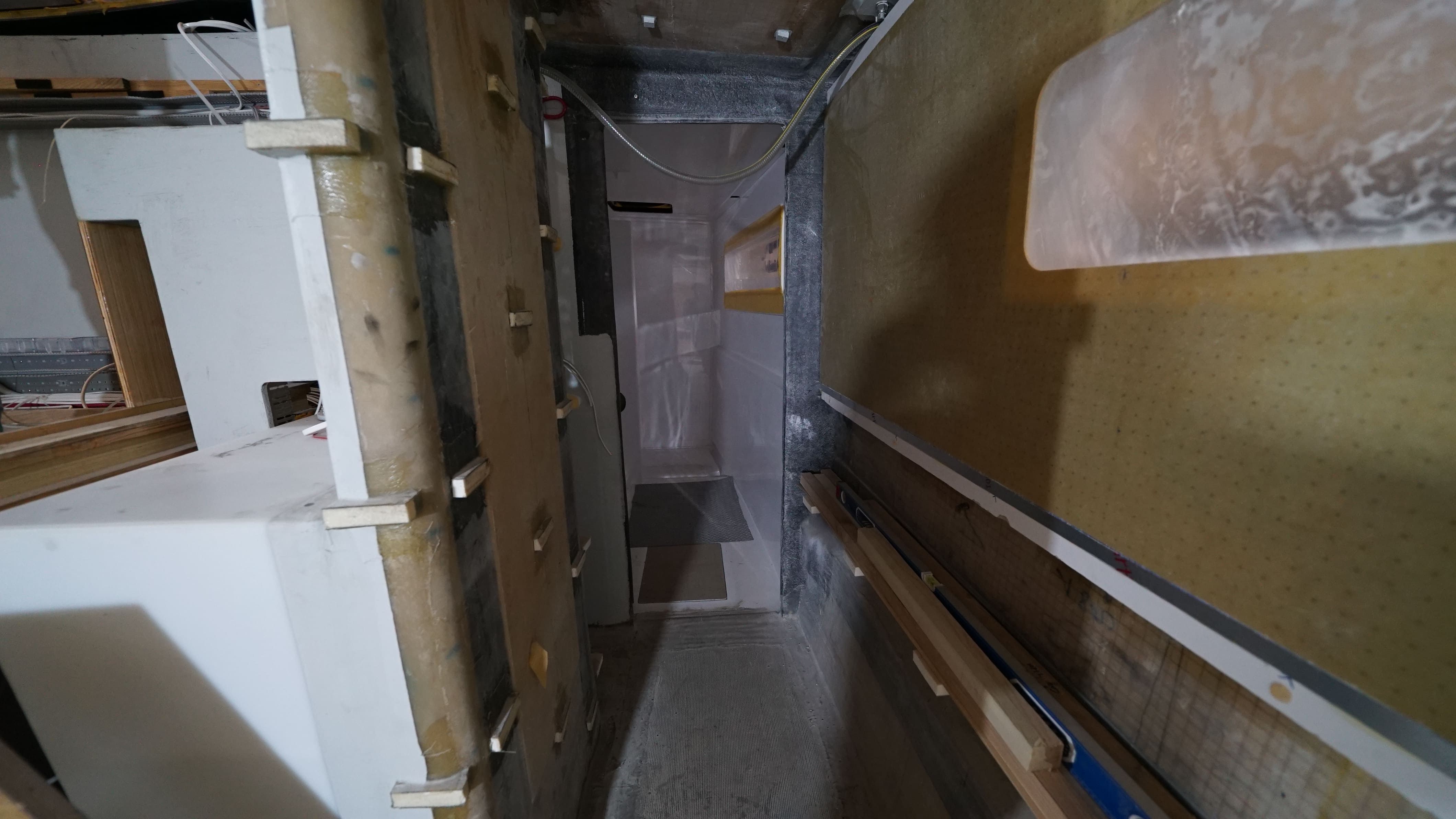

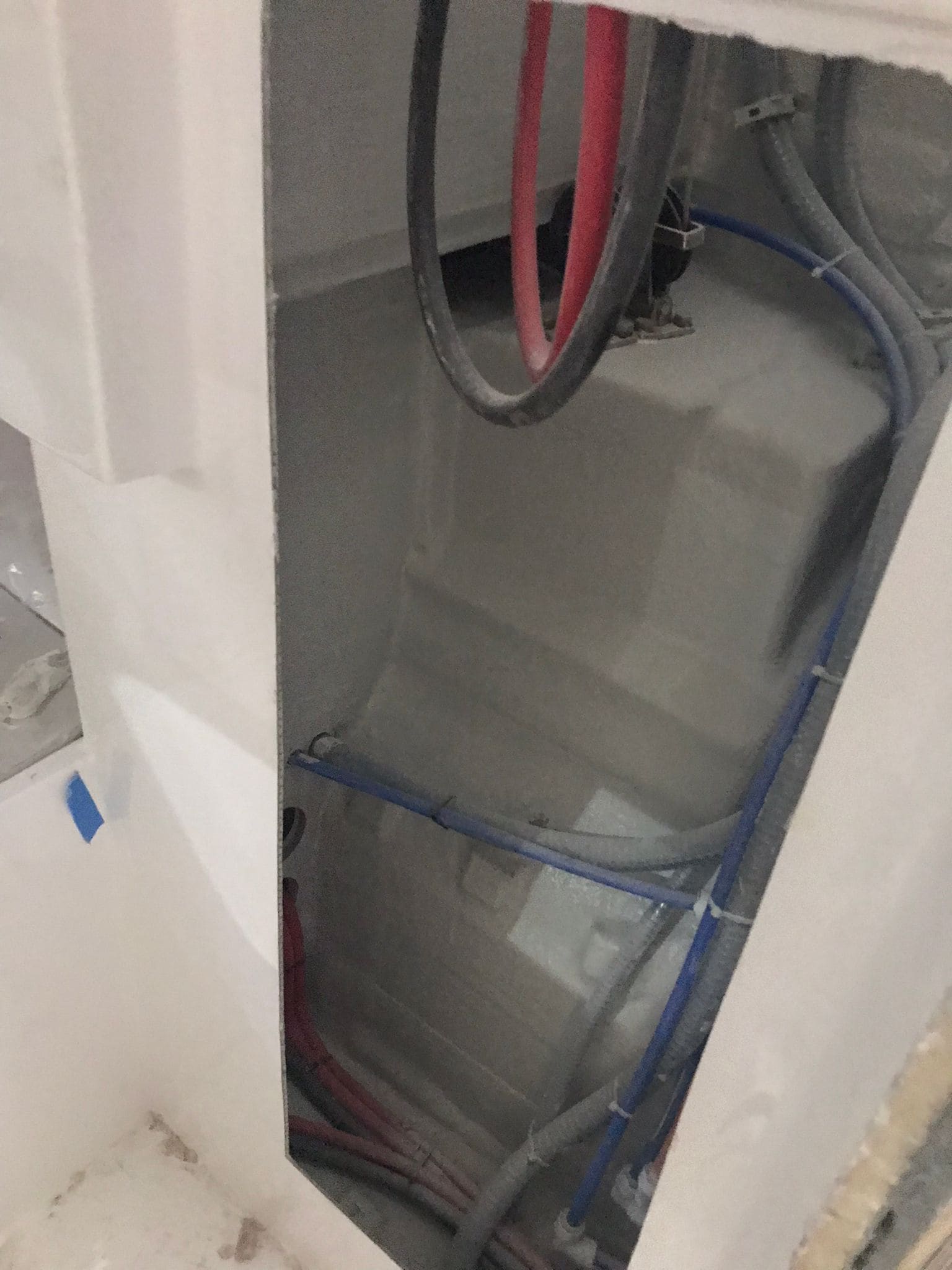

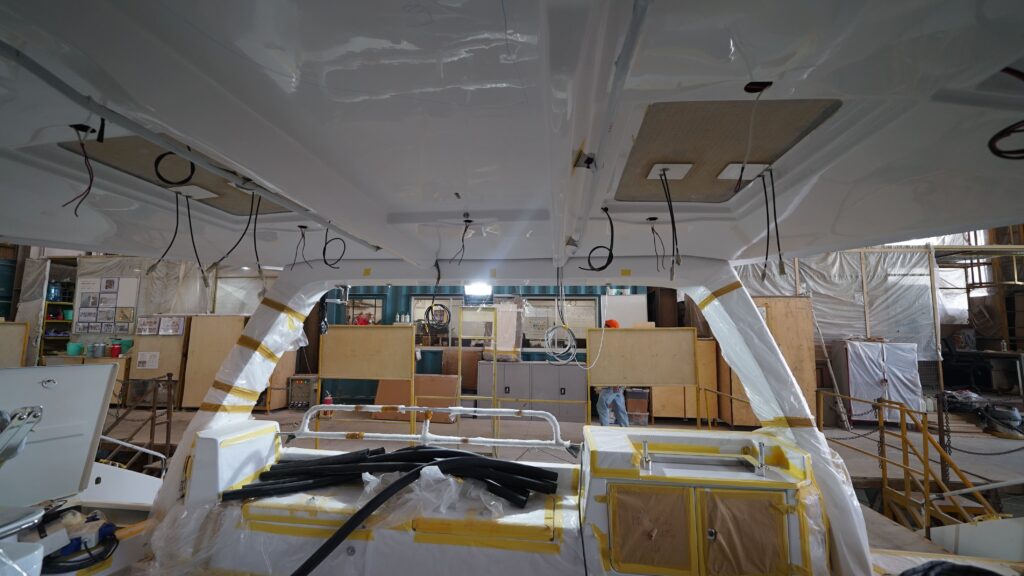

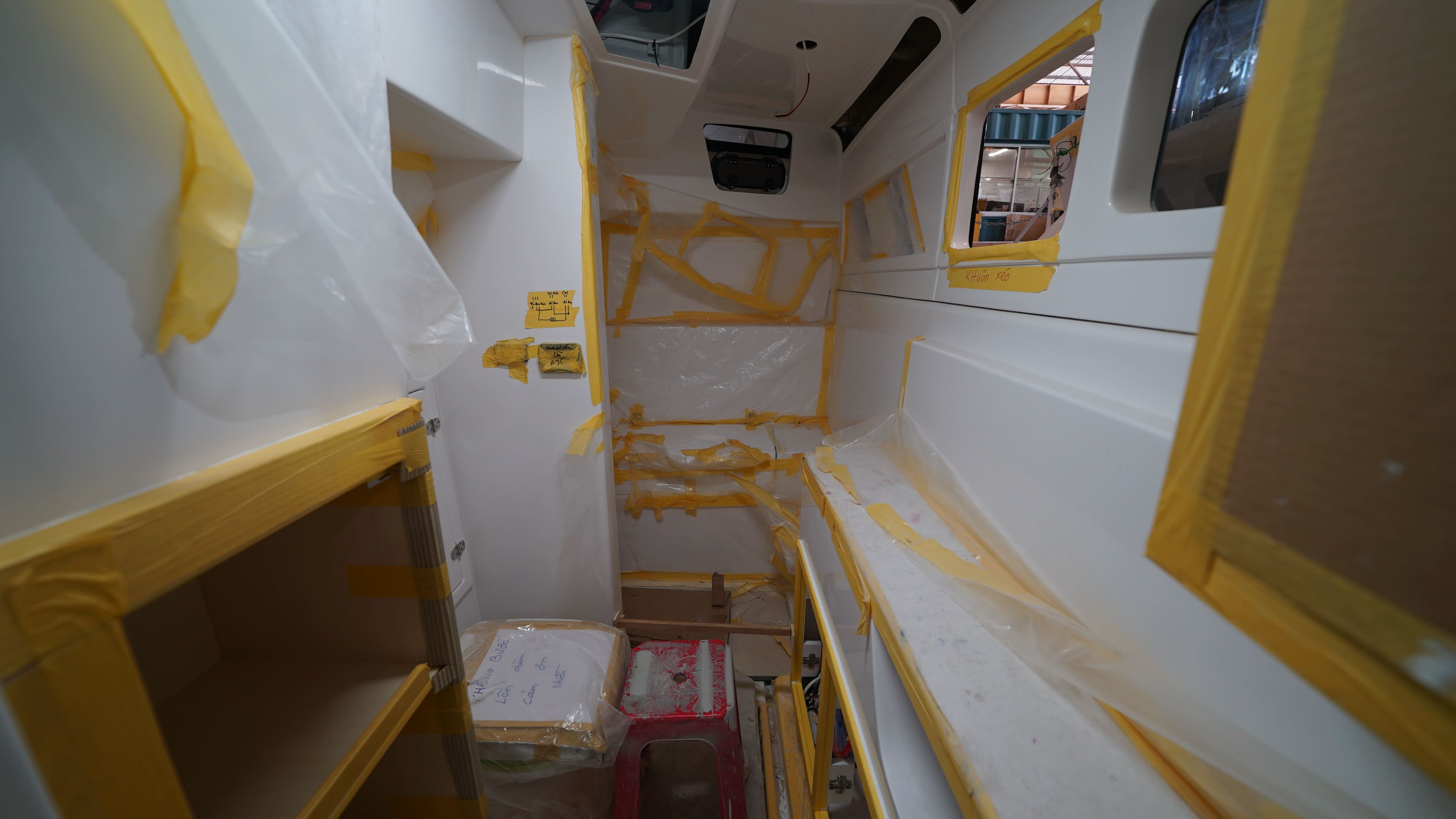

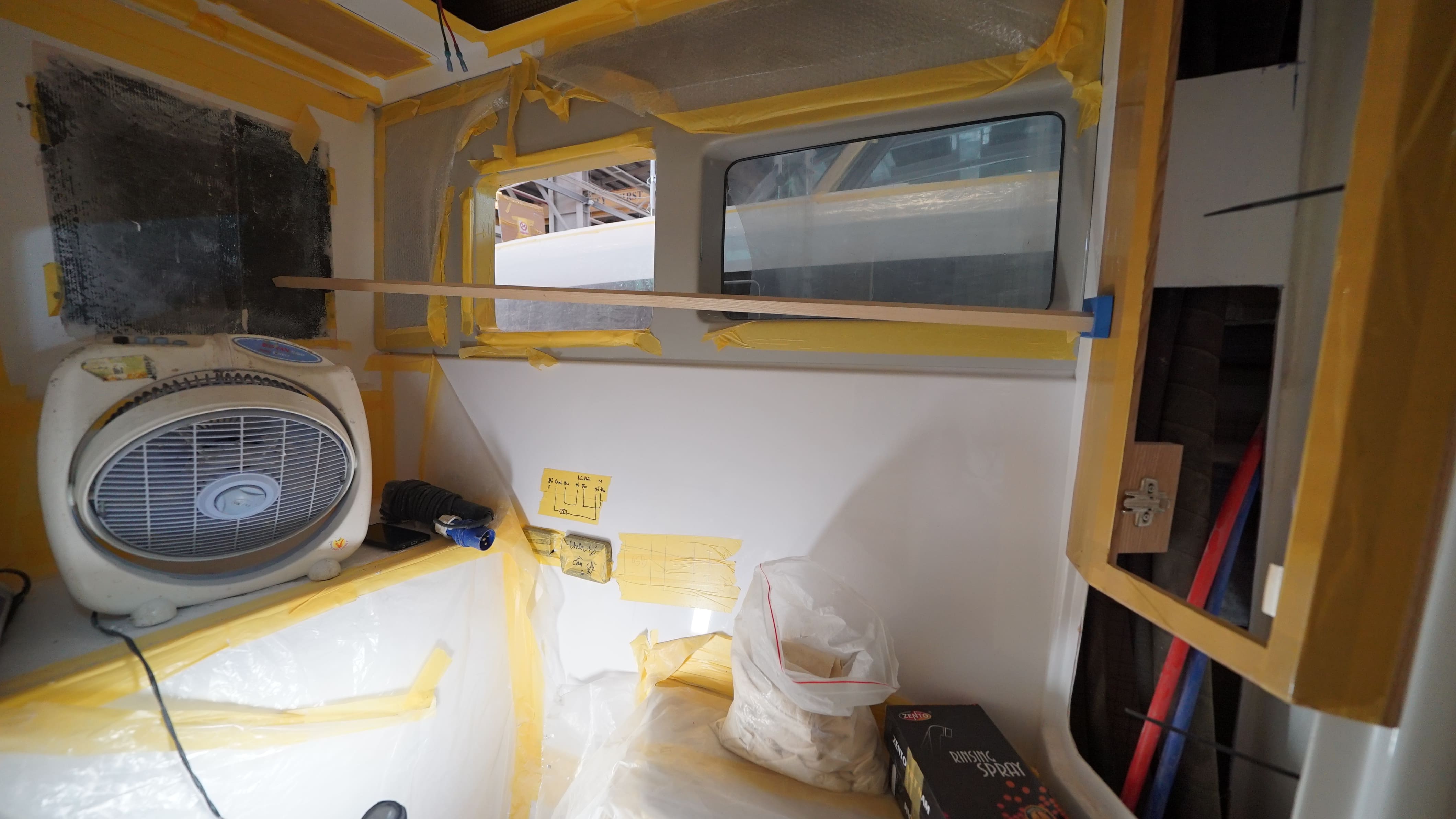

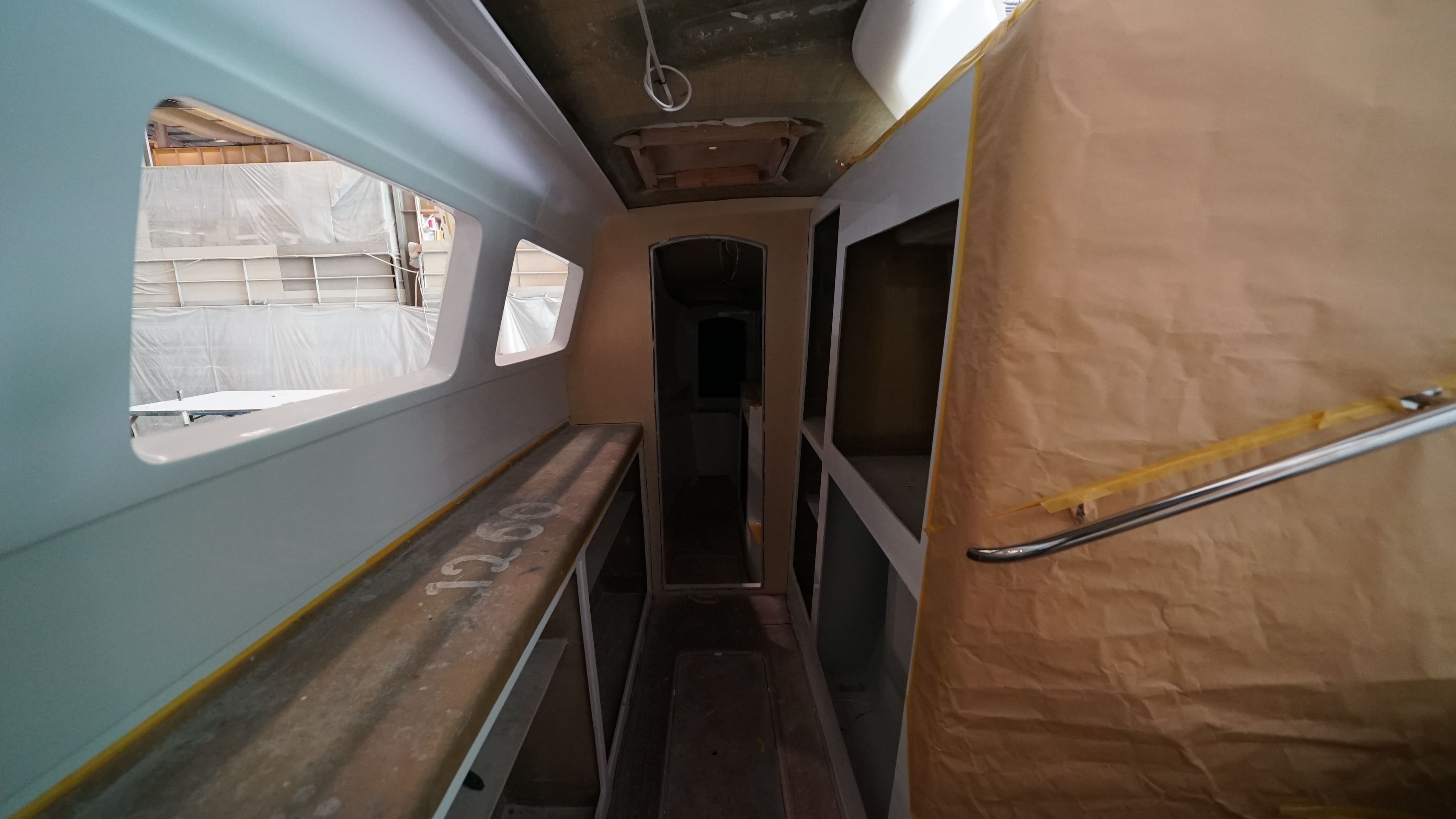

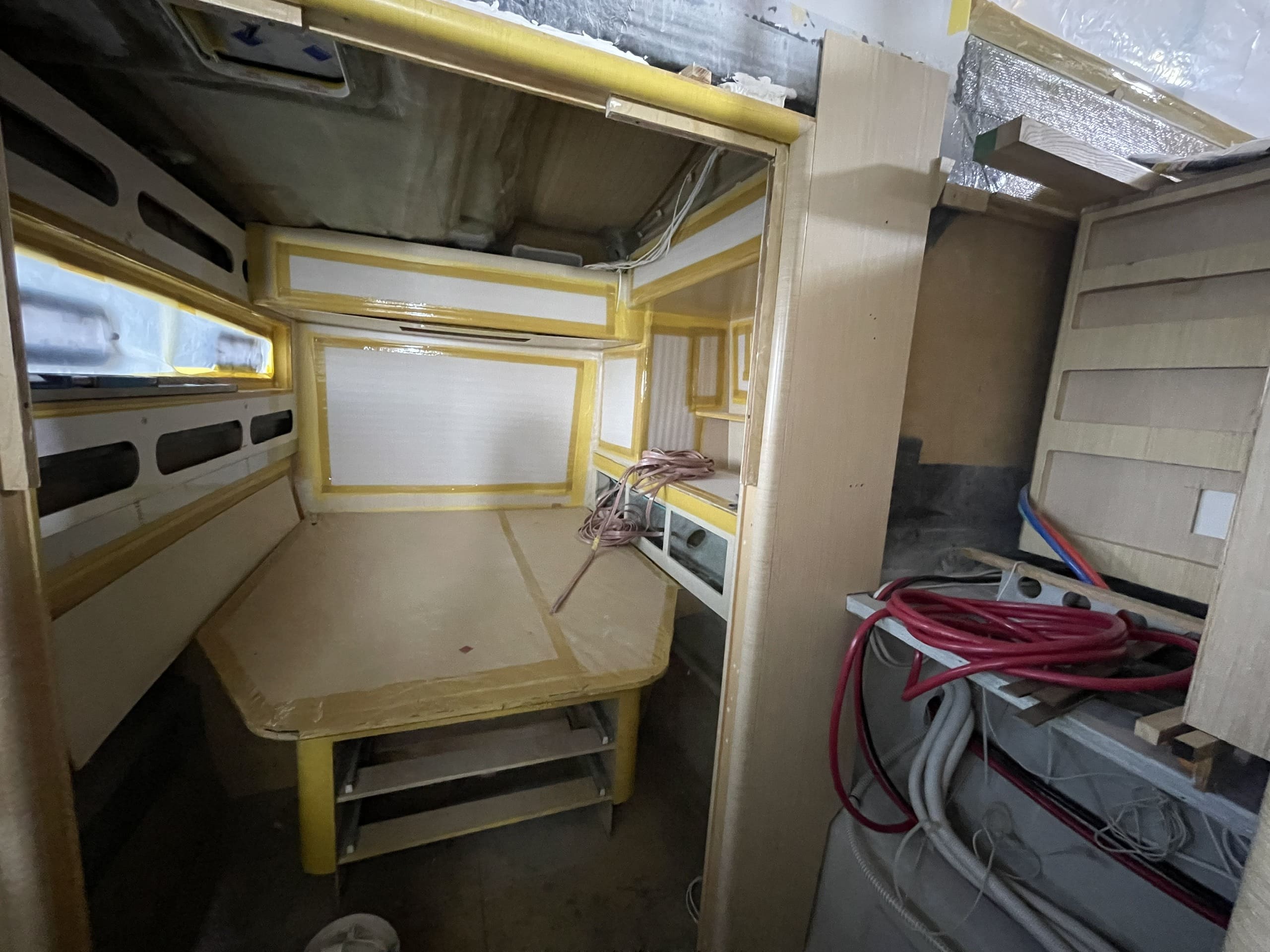

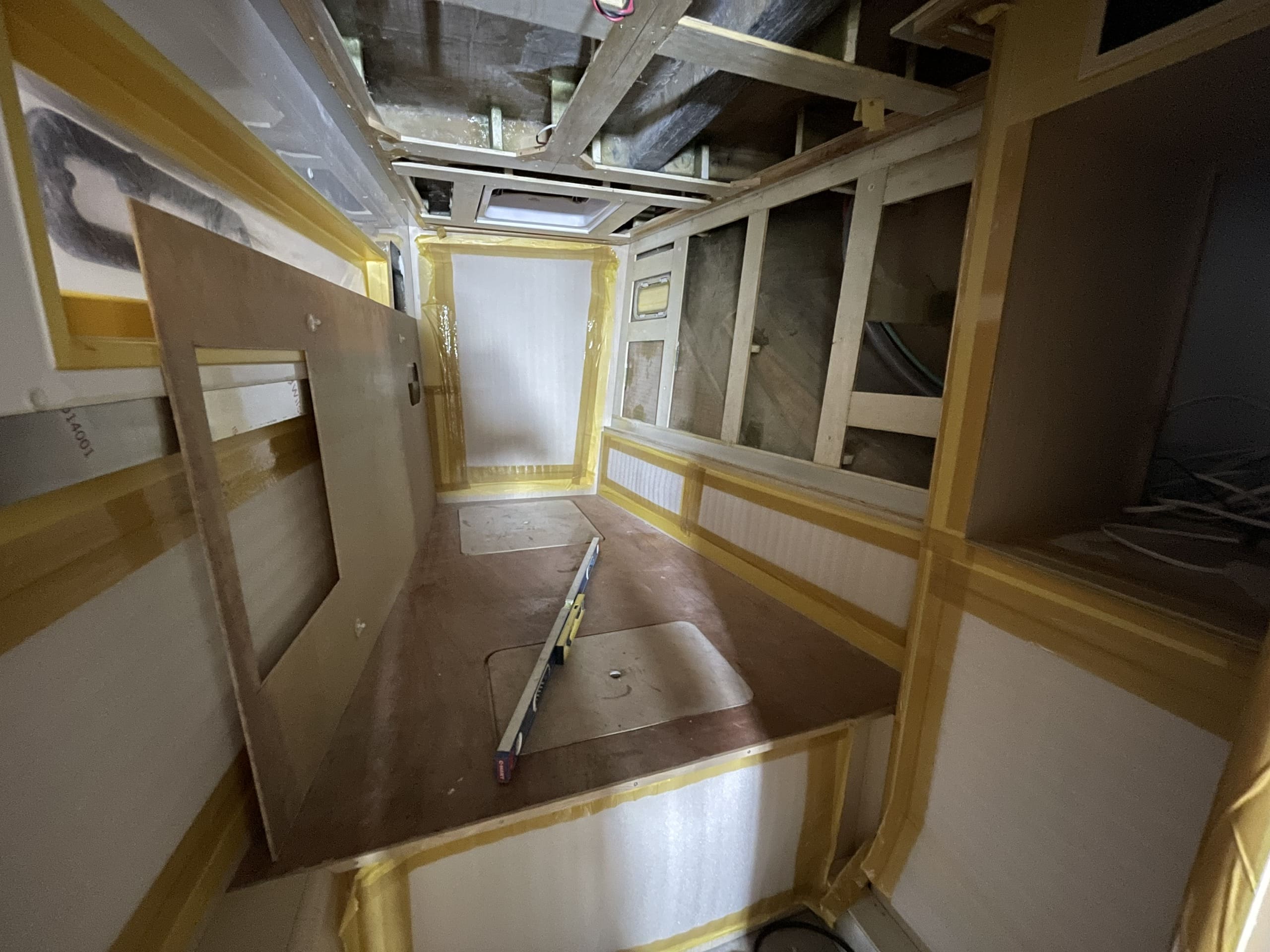

Preparatory works for LPG plumbing, thru-hull fittings, tank installation, and electrical conduit routing are underway.

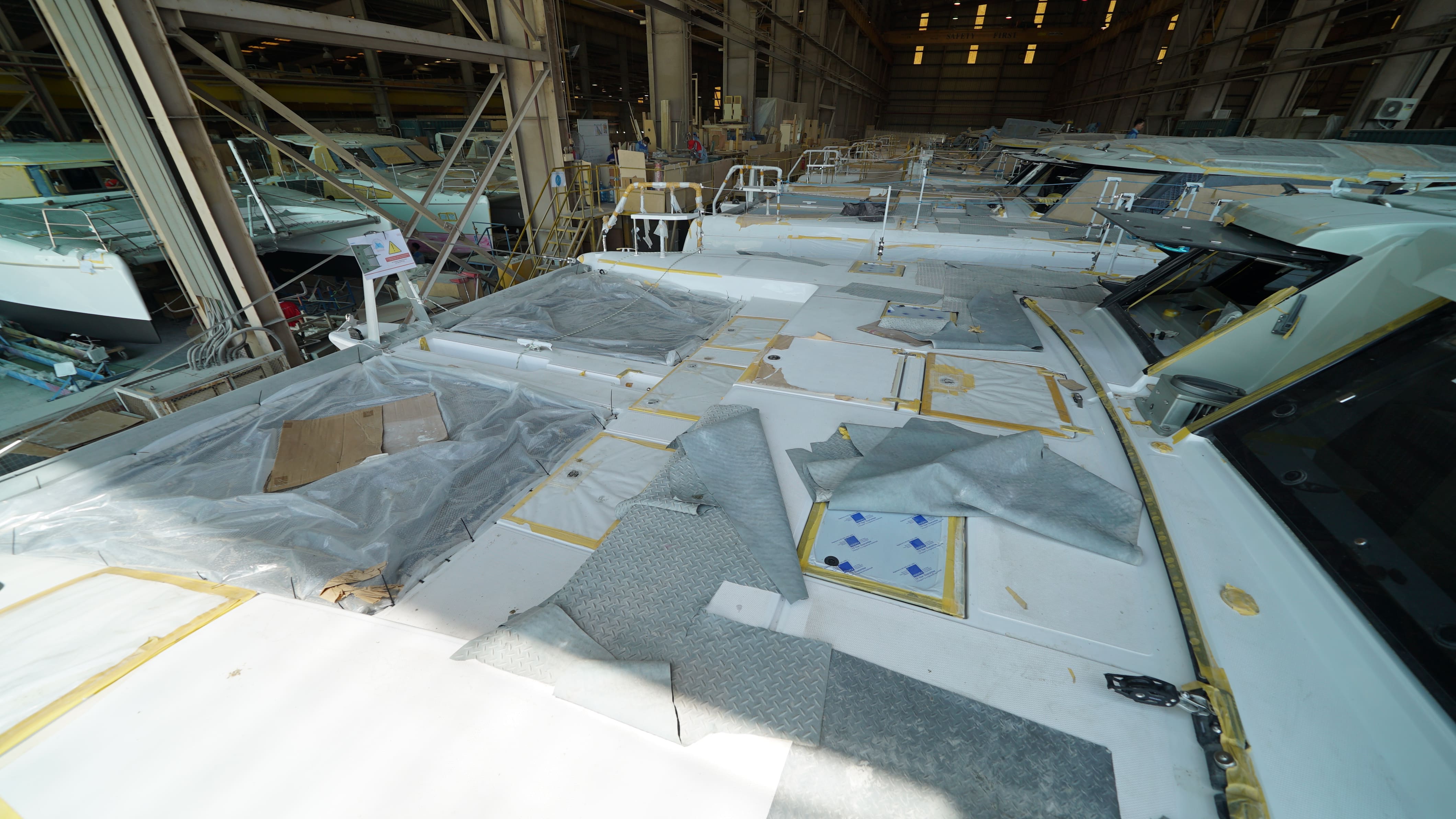

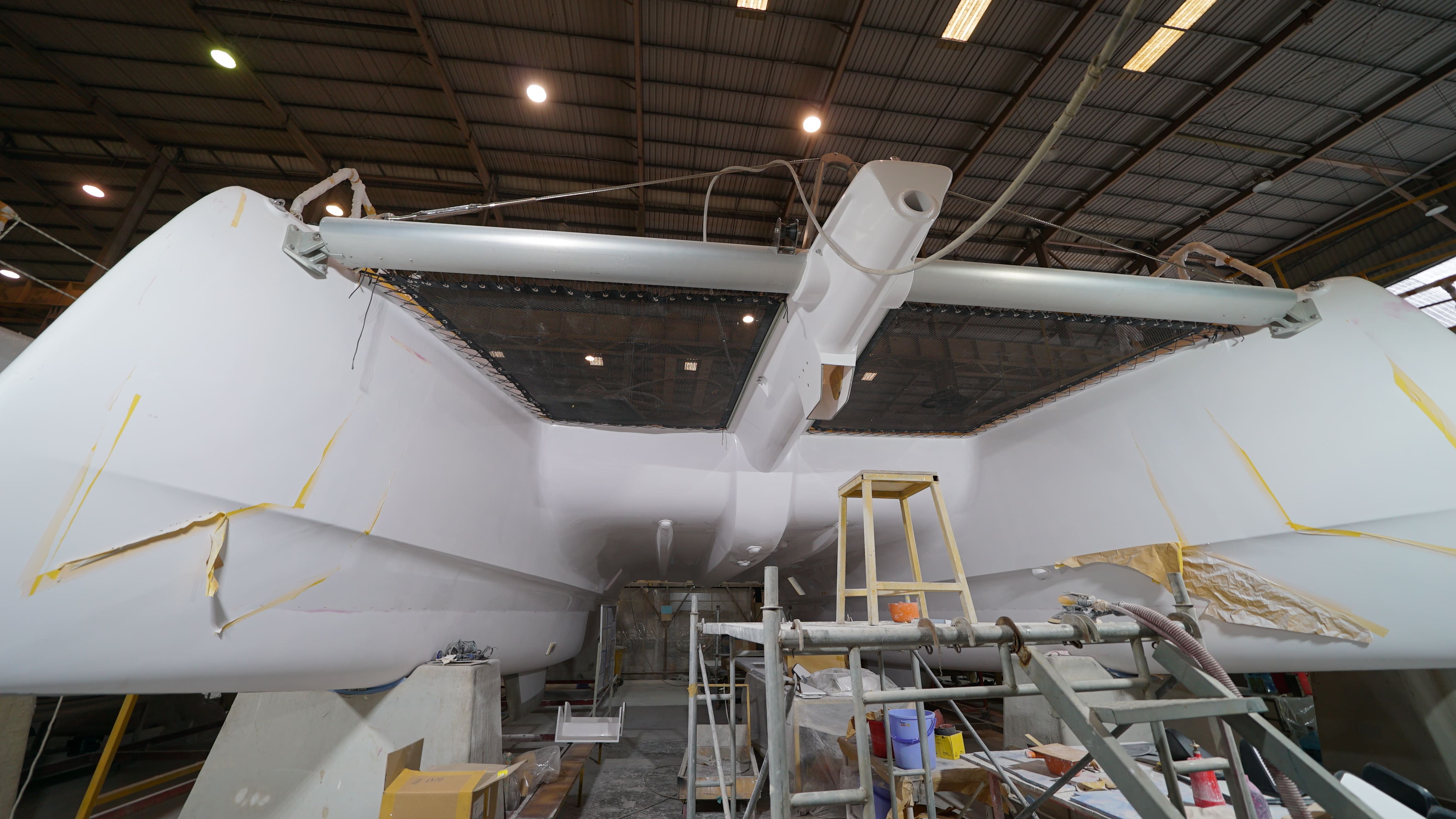

Based on current progress, the hull–deck joining is scheduled to proceed soon.

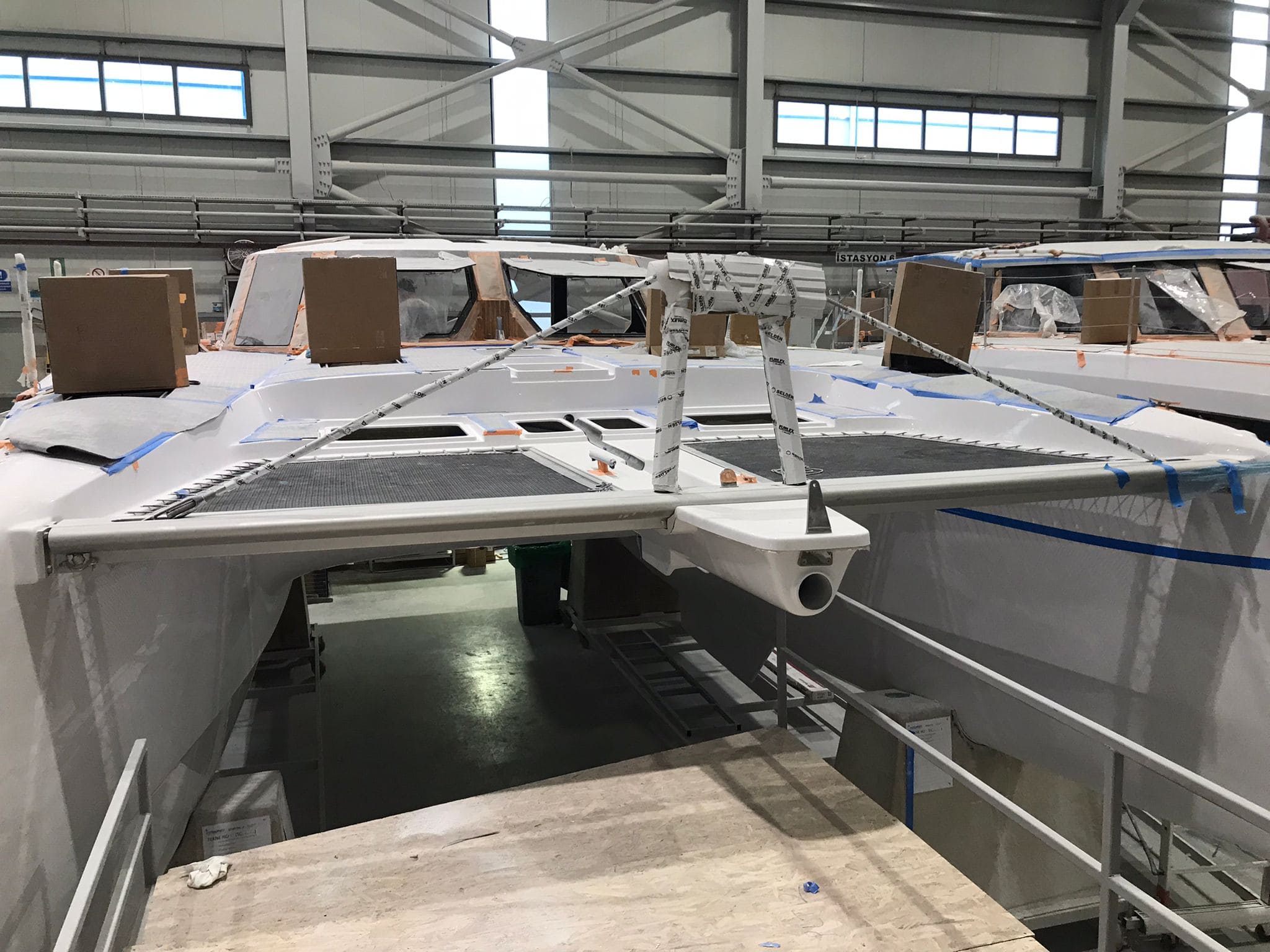

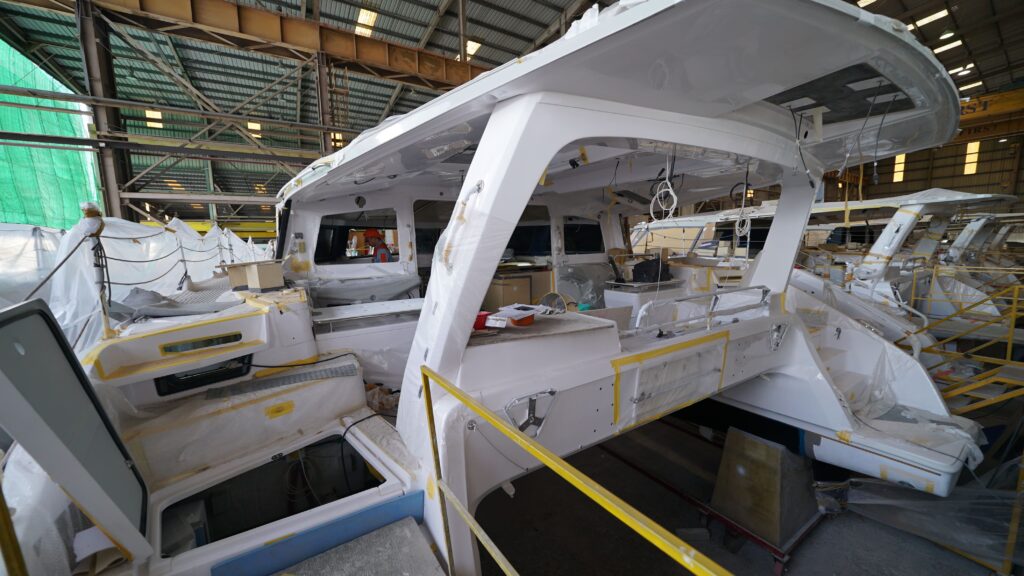

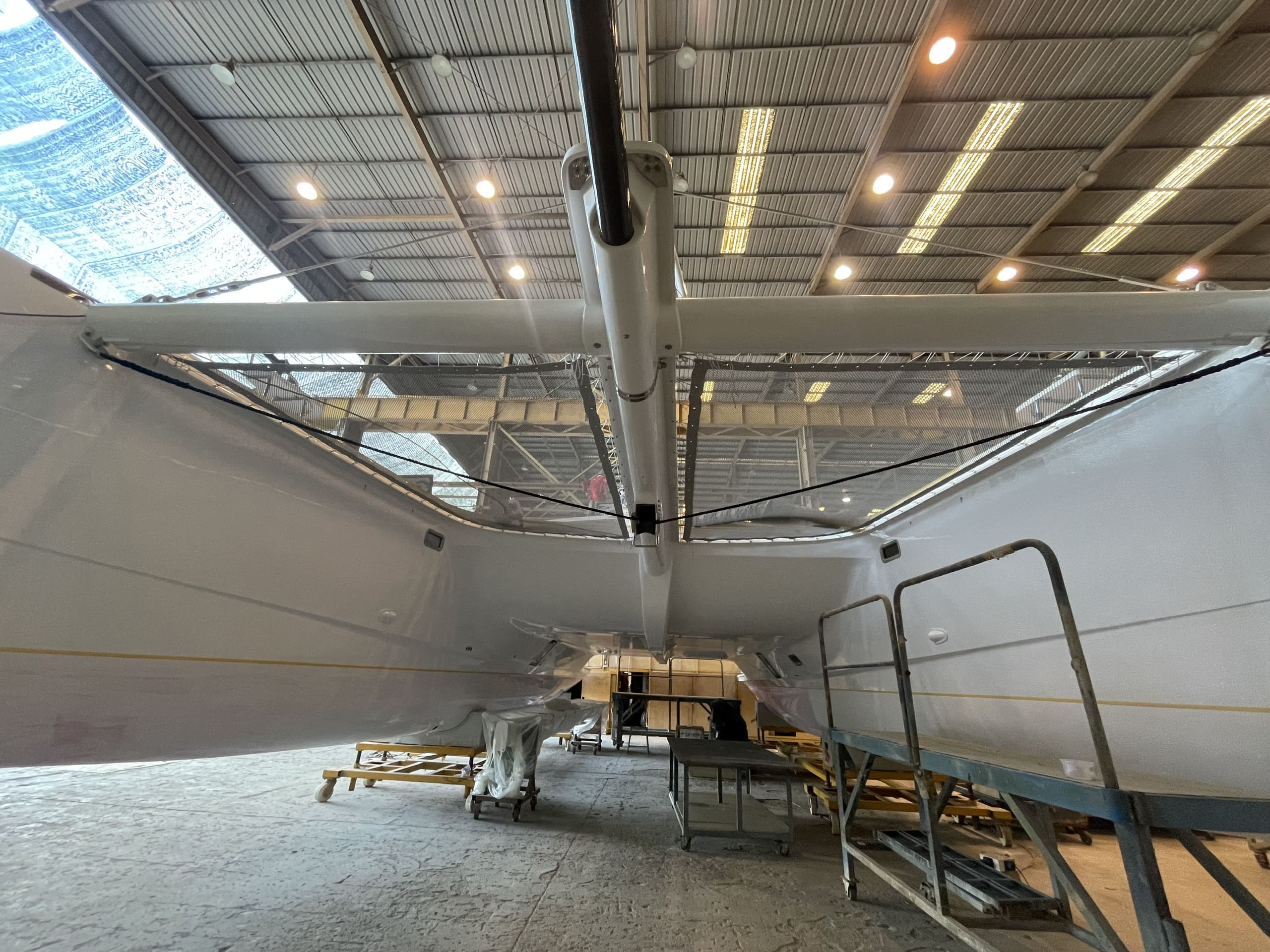

Production Update – Assembly

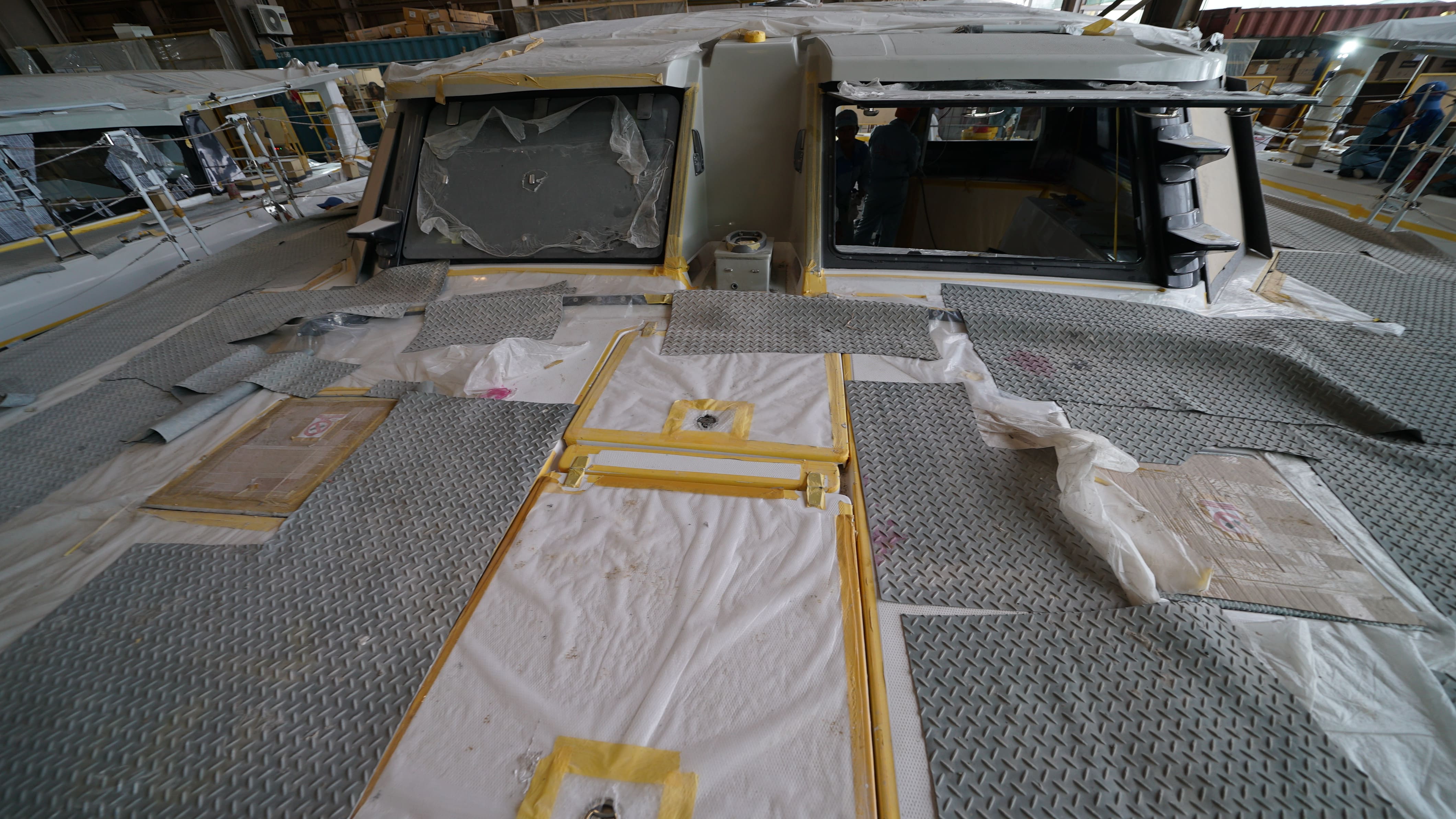

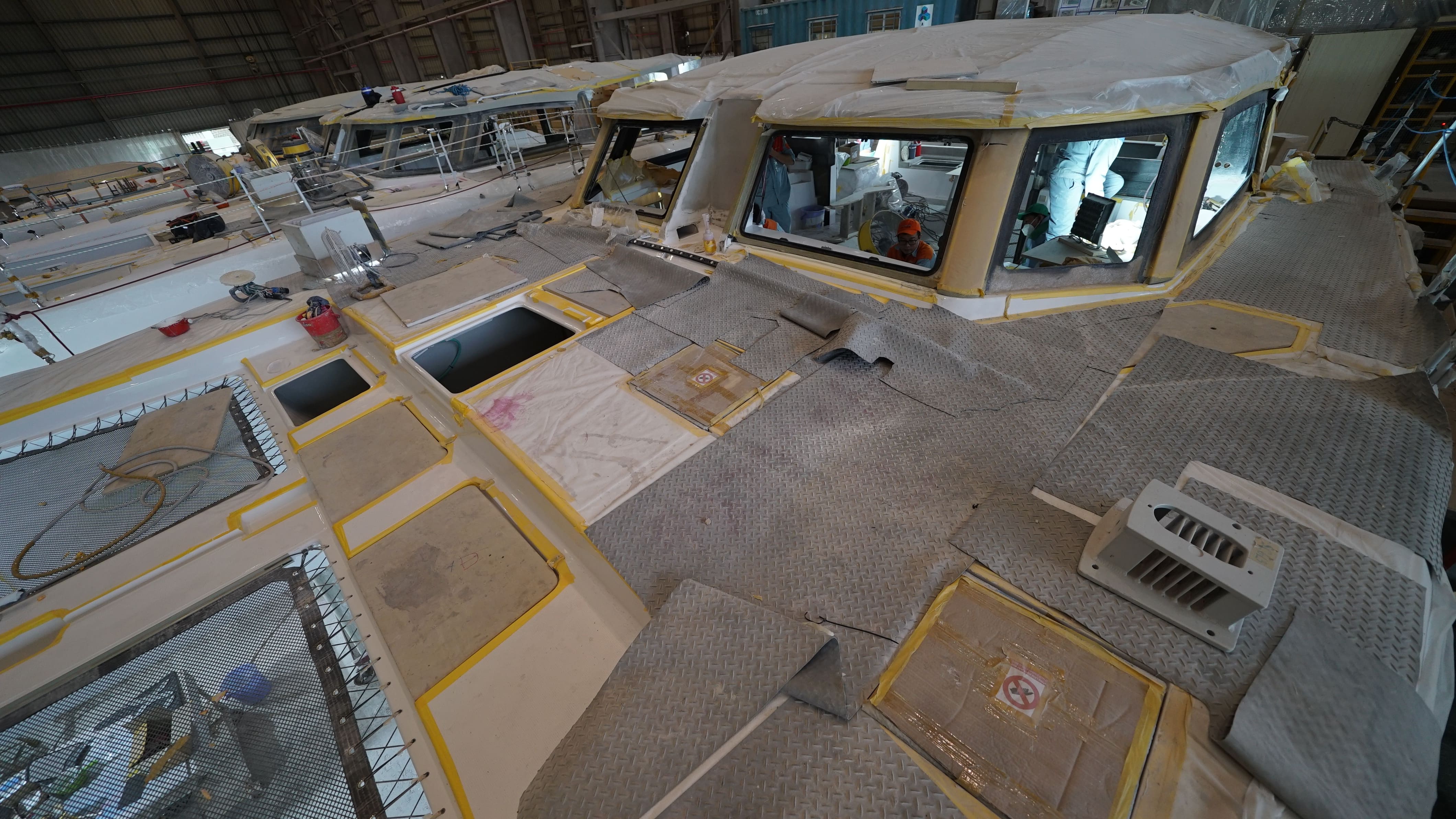

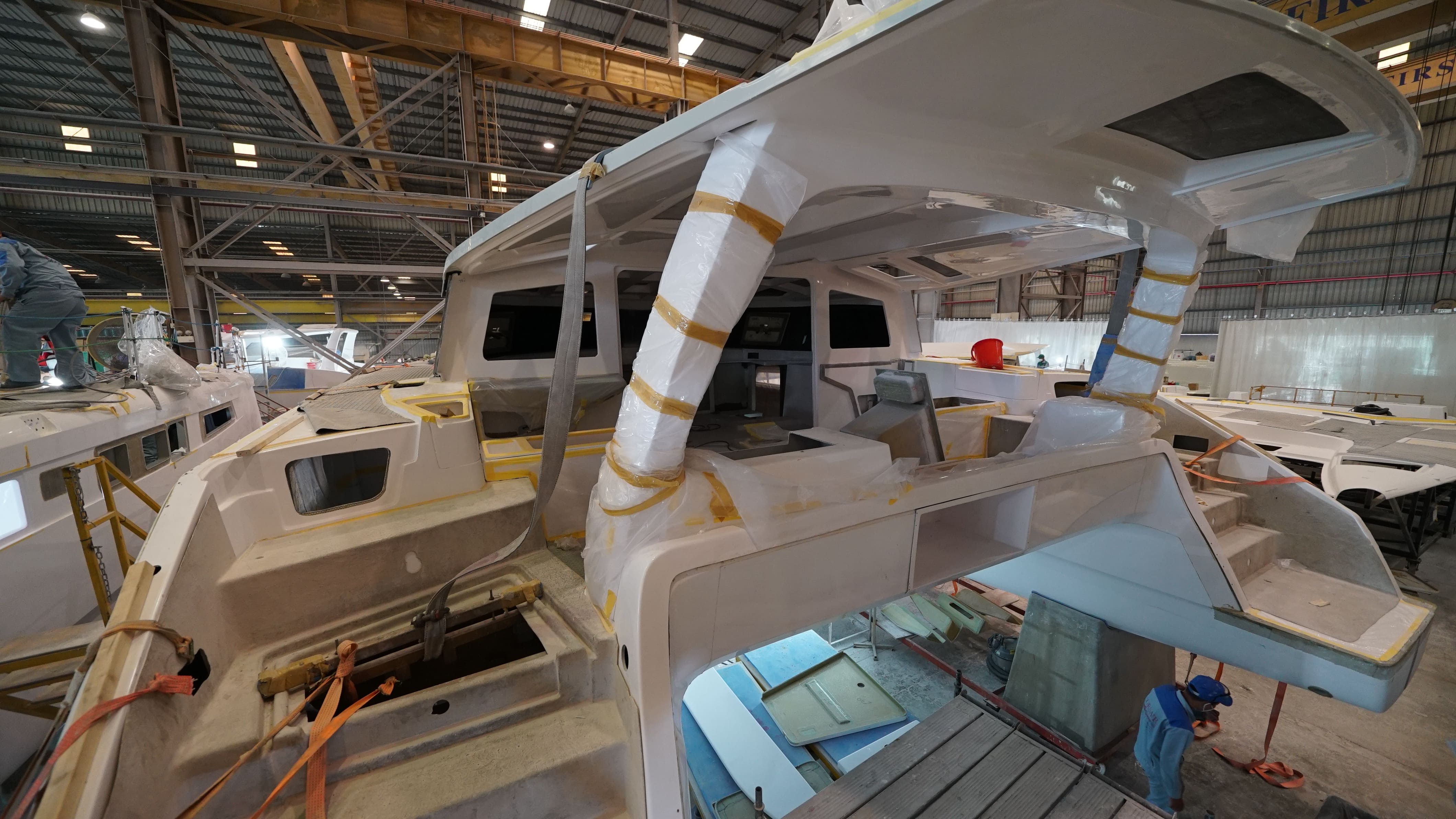

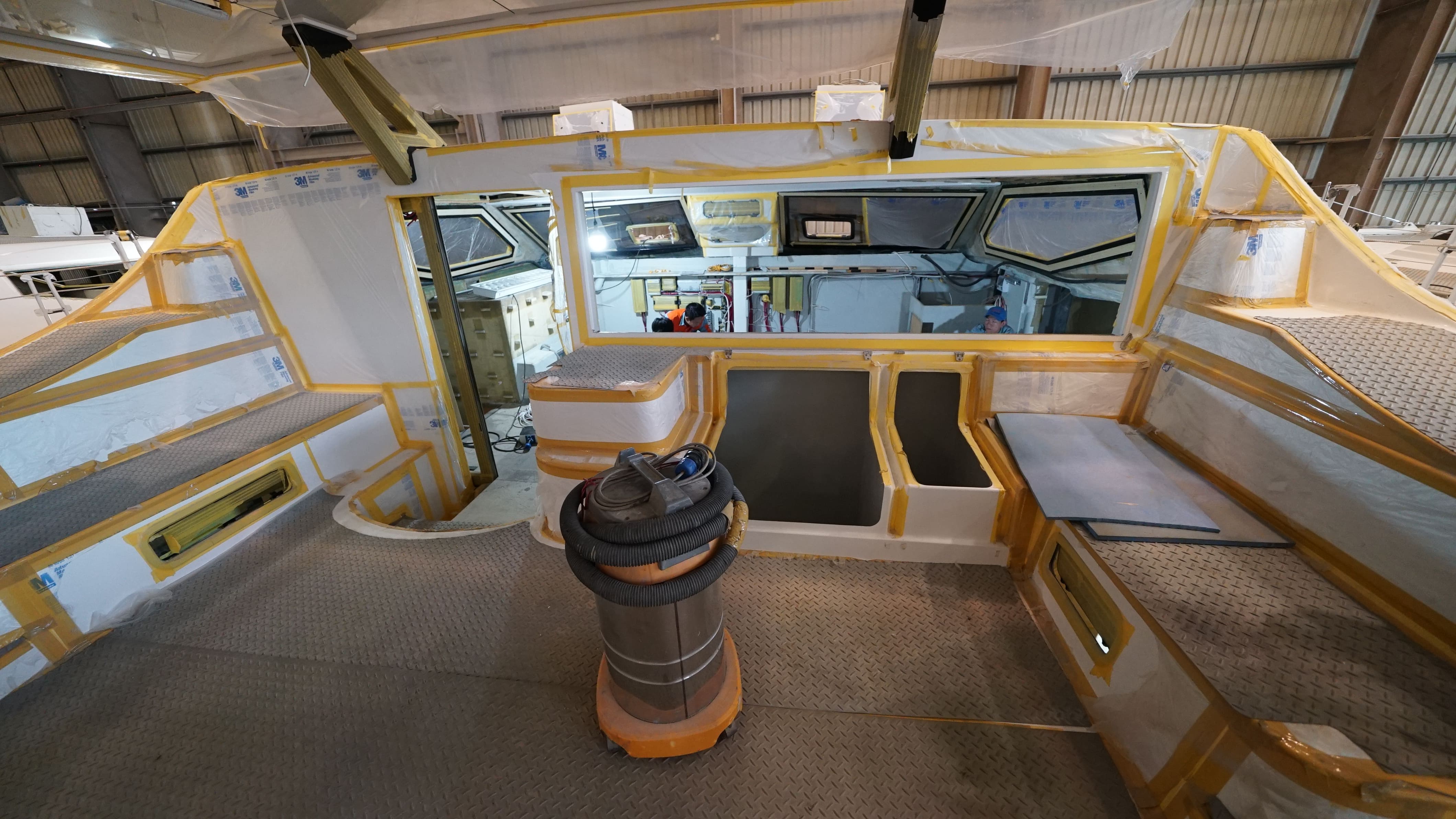

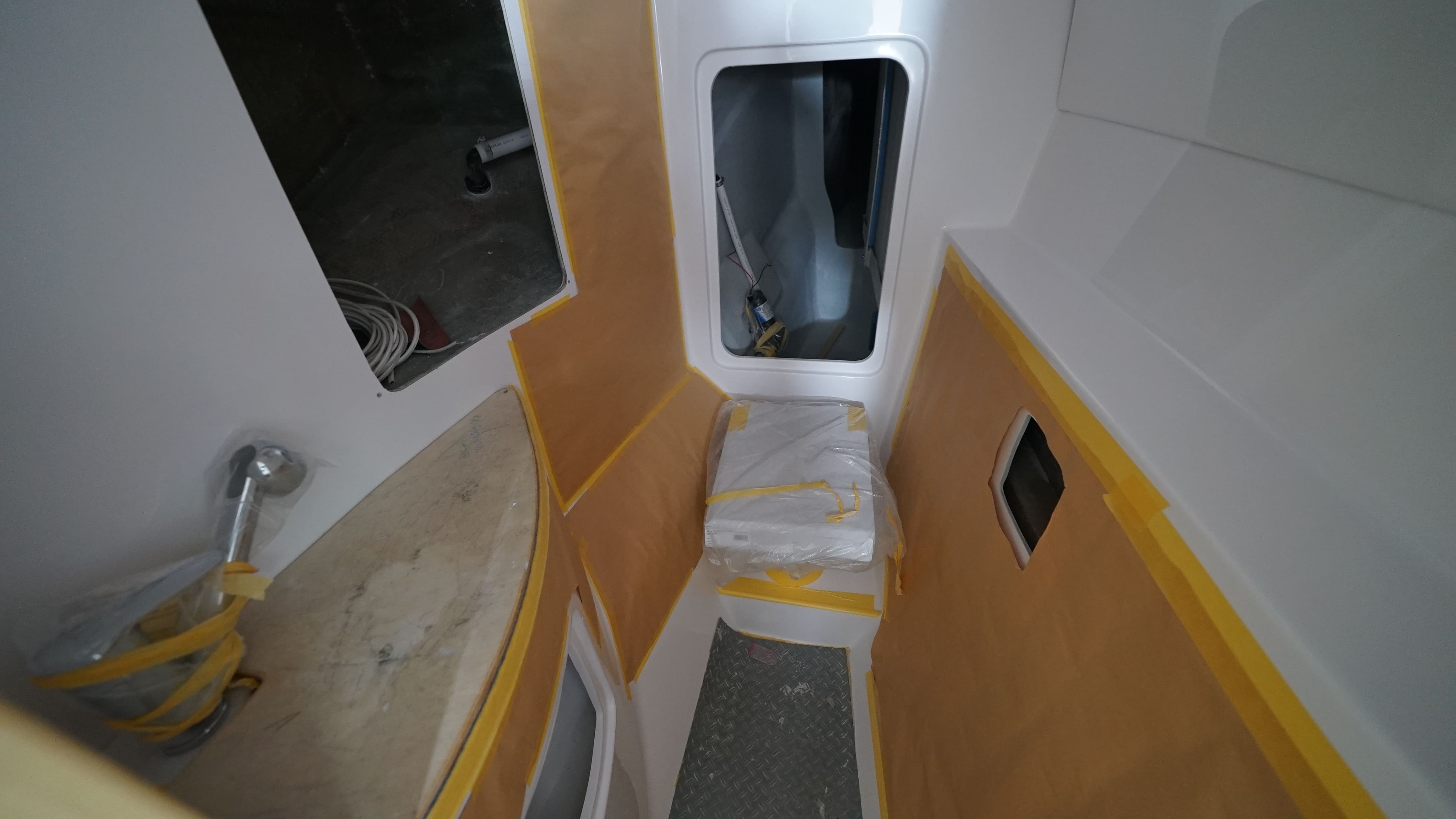

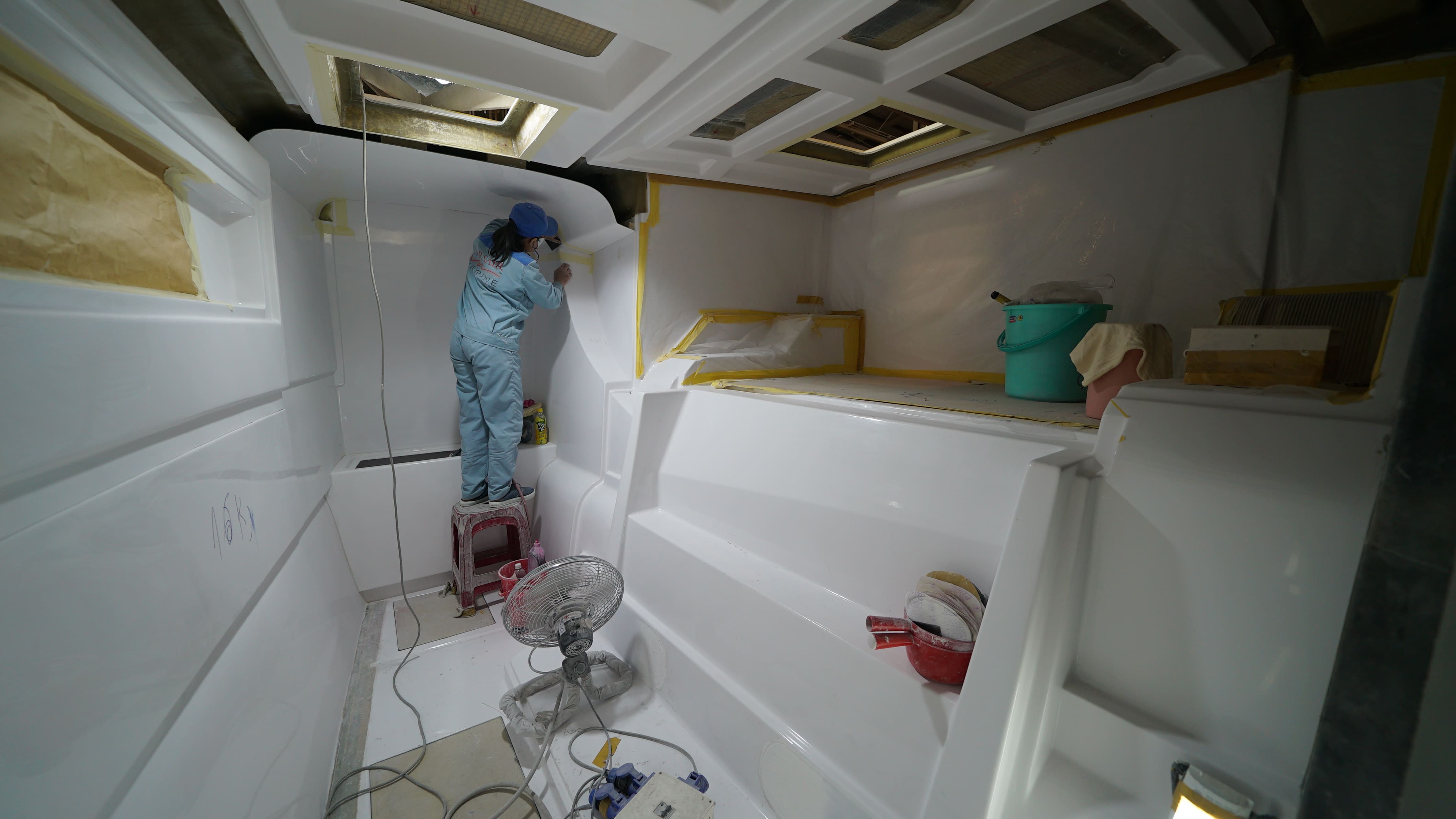

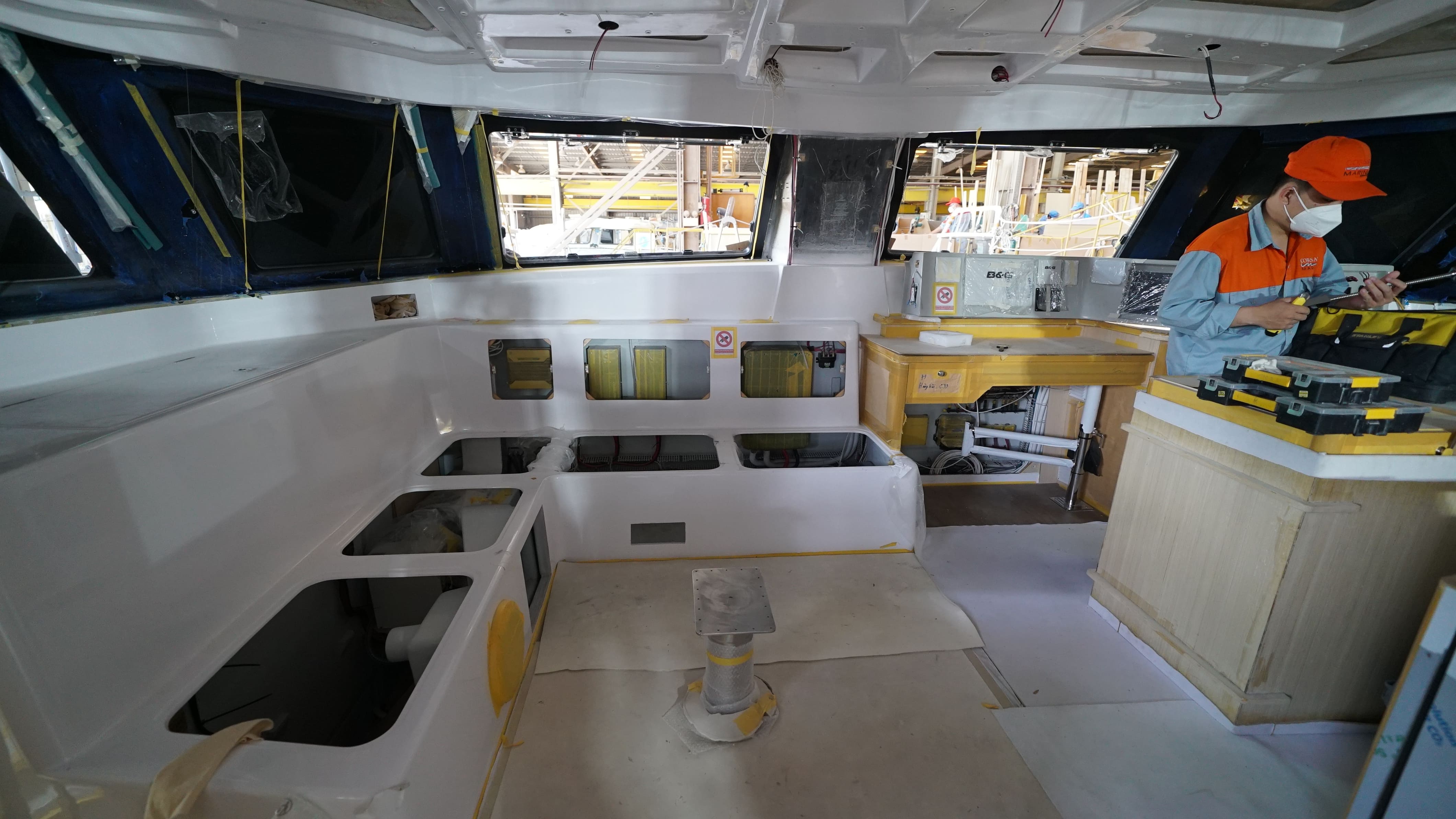

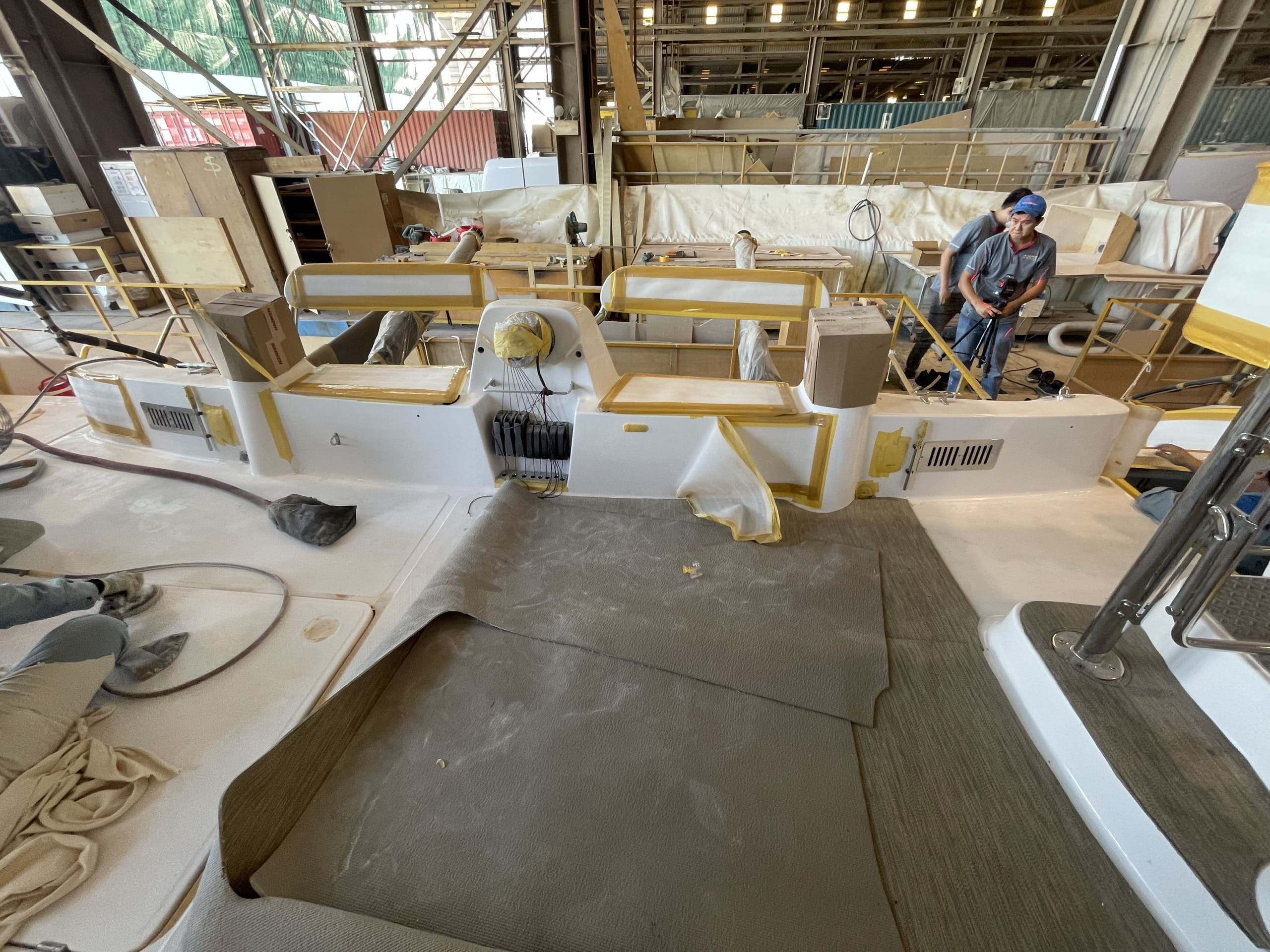

Your boat is progressing well in the Assembly stage.

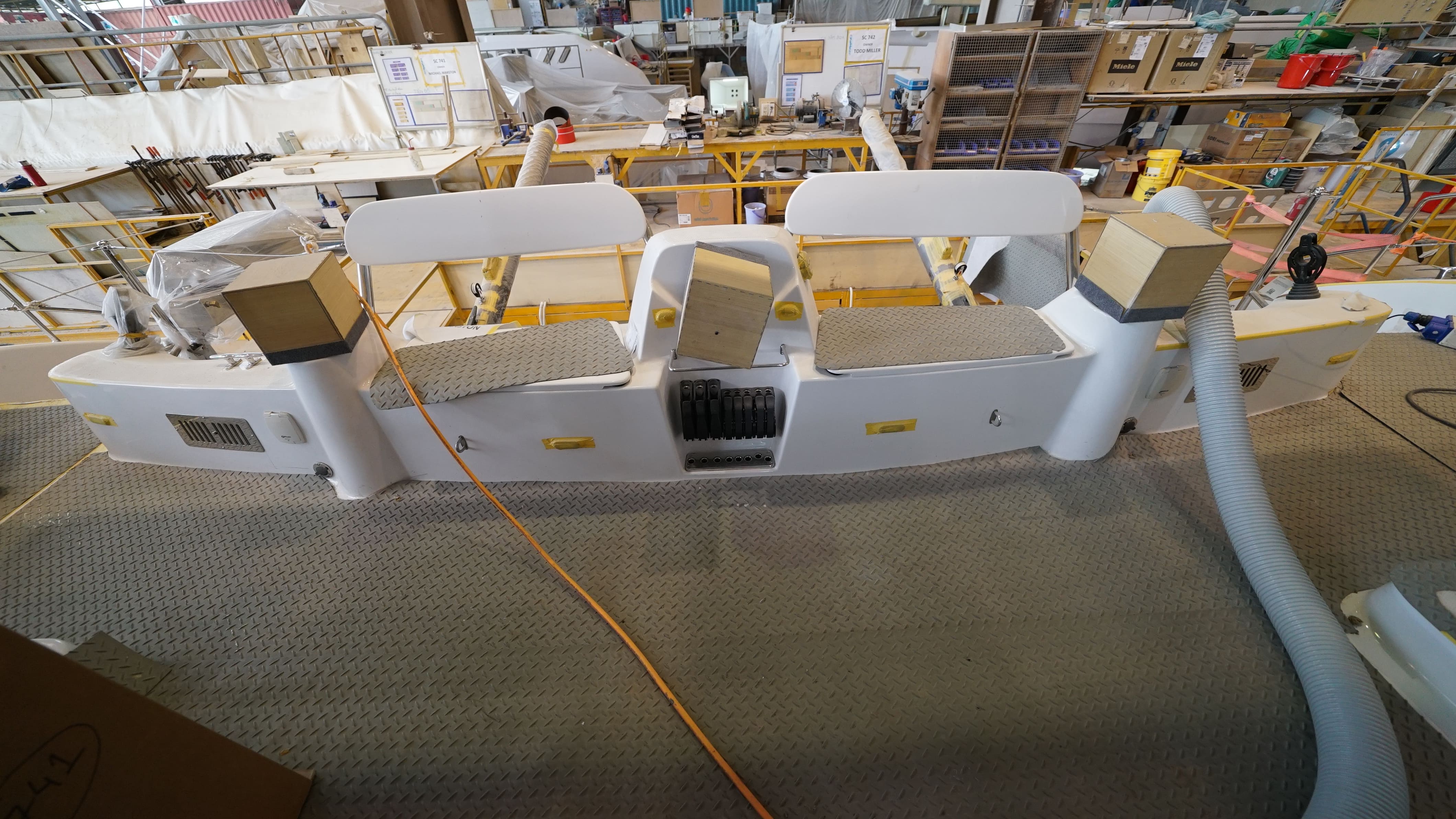

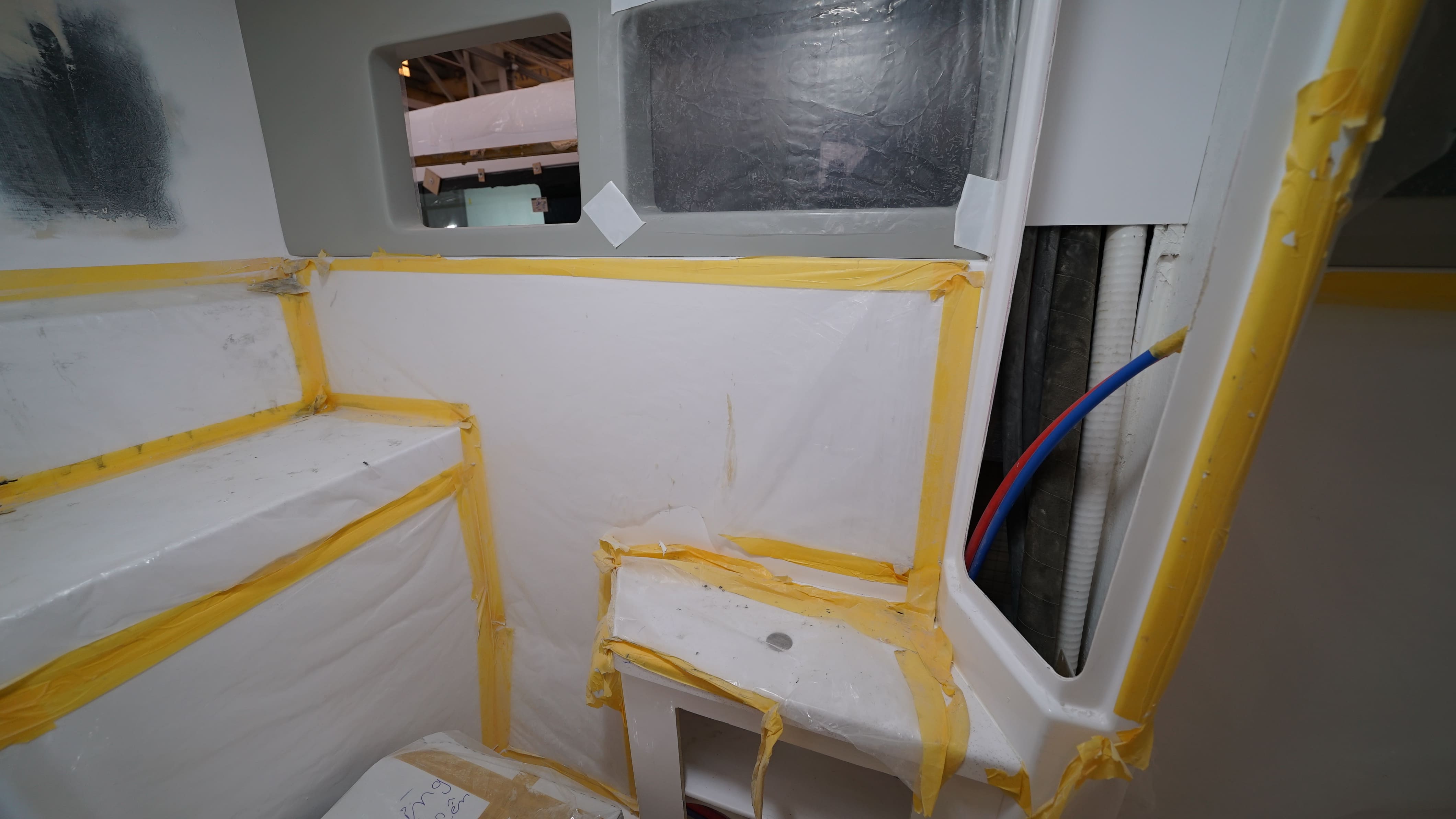

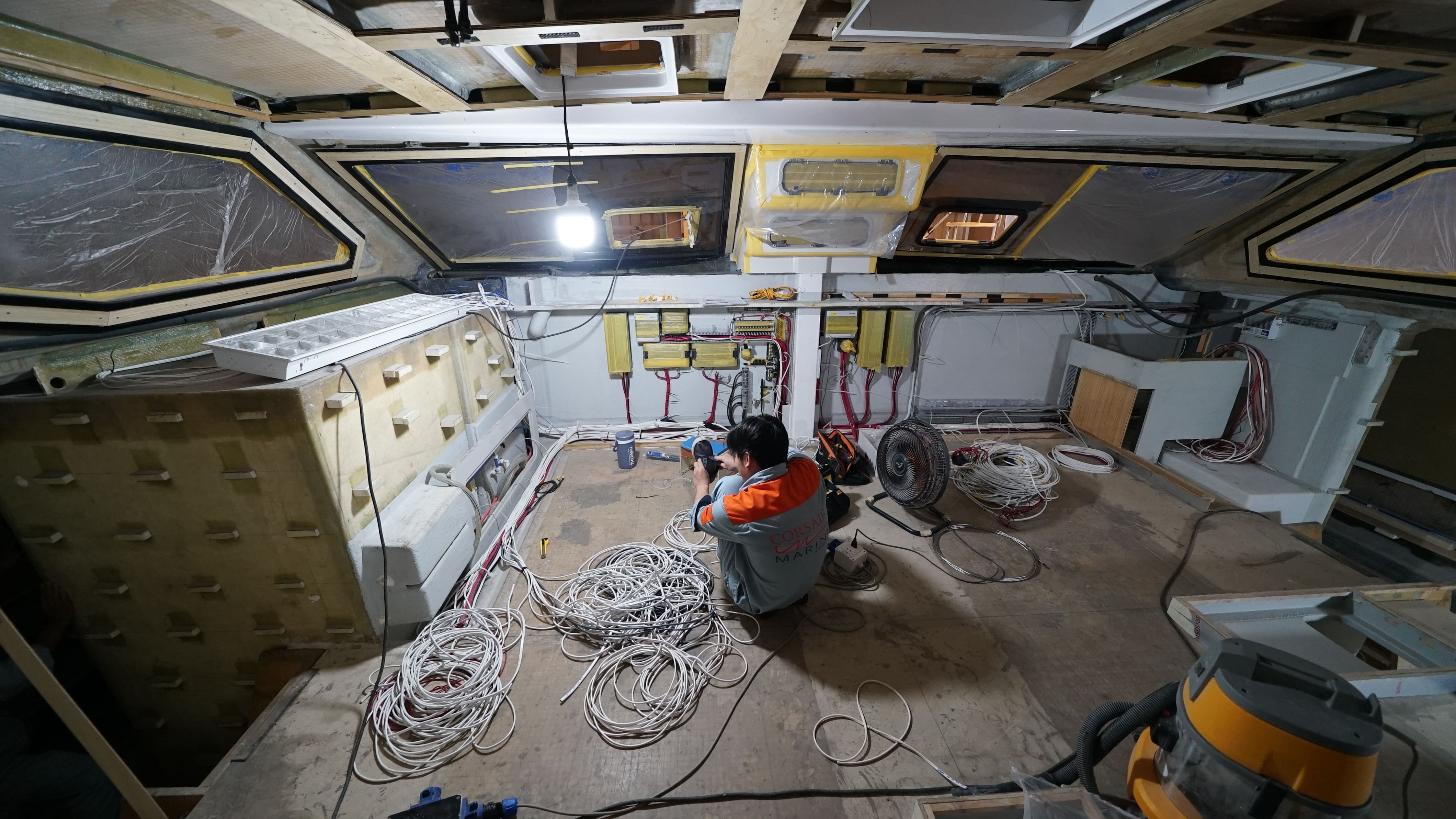

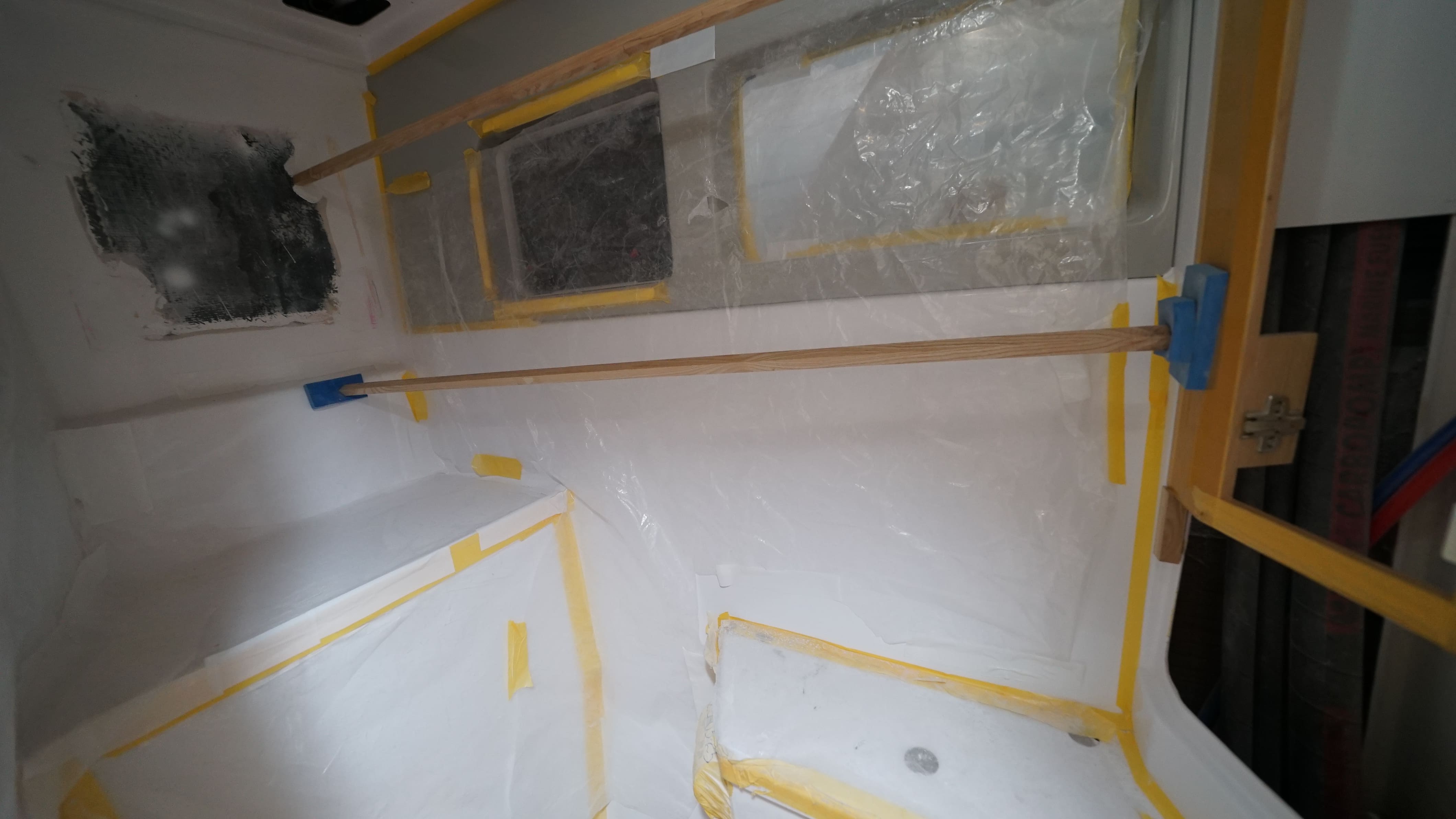

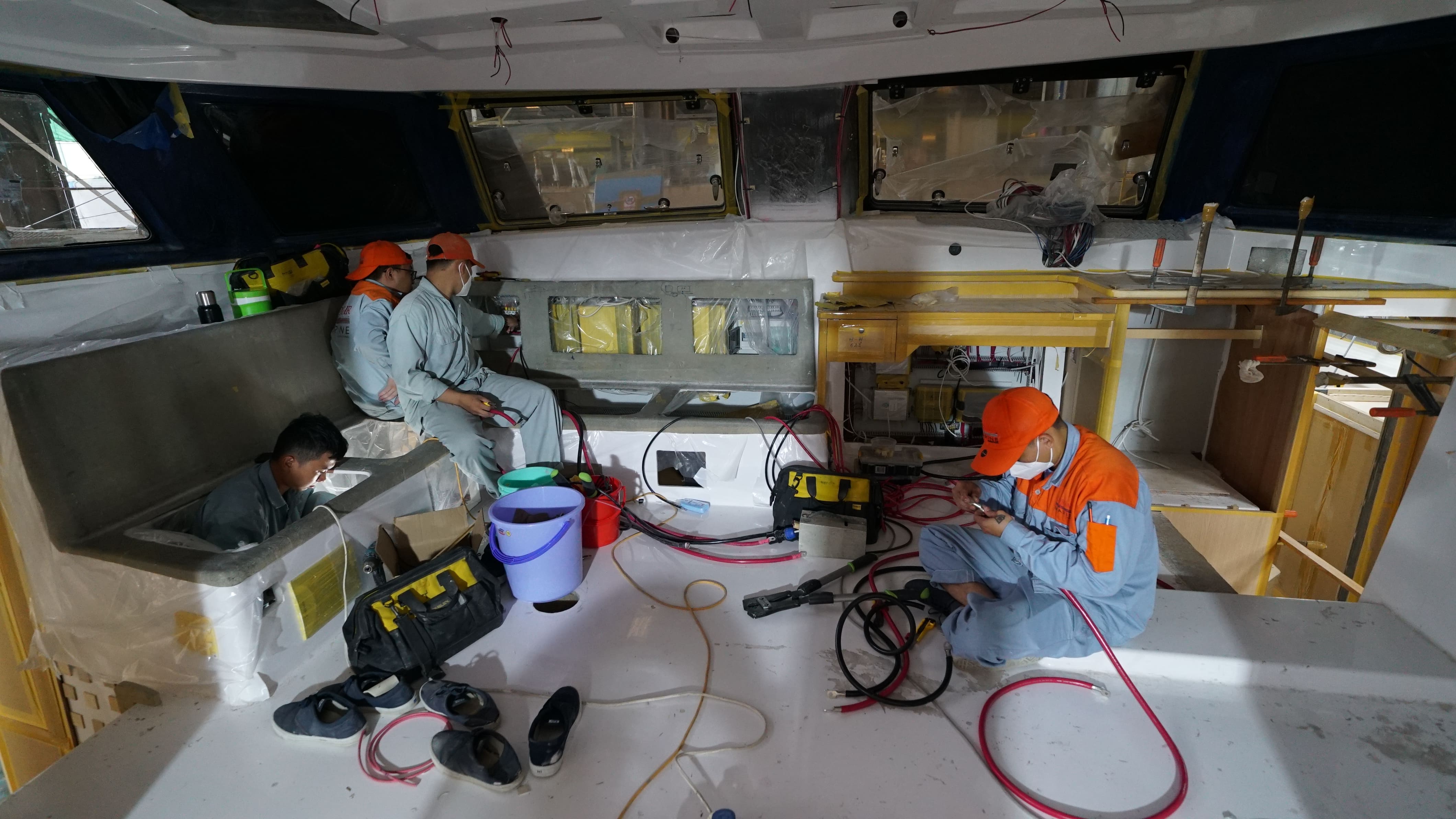

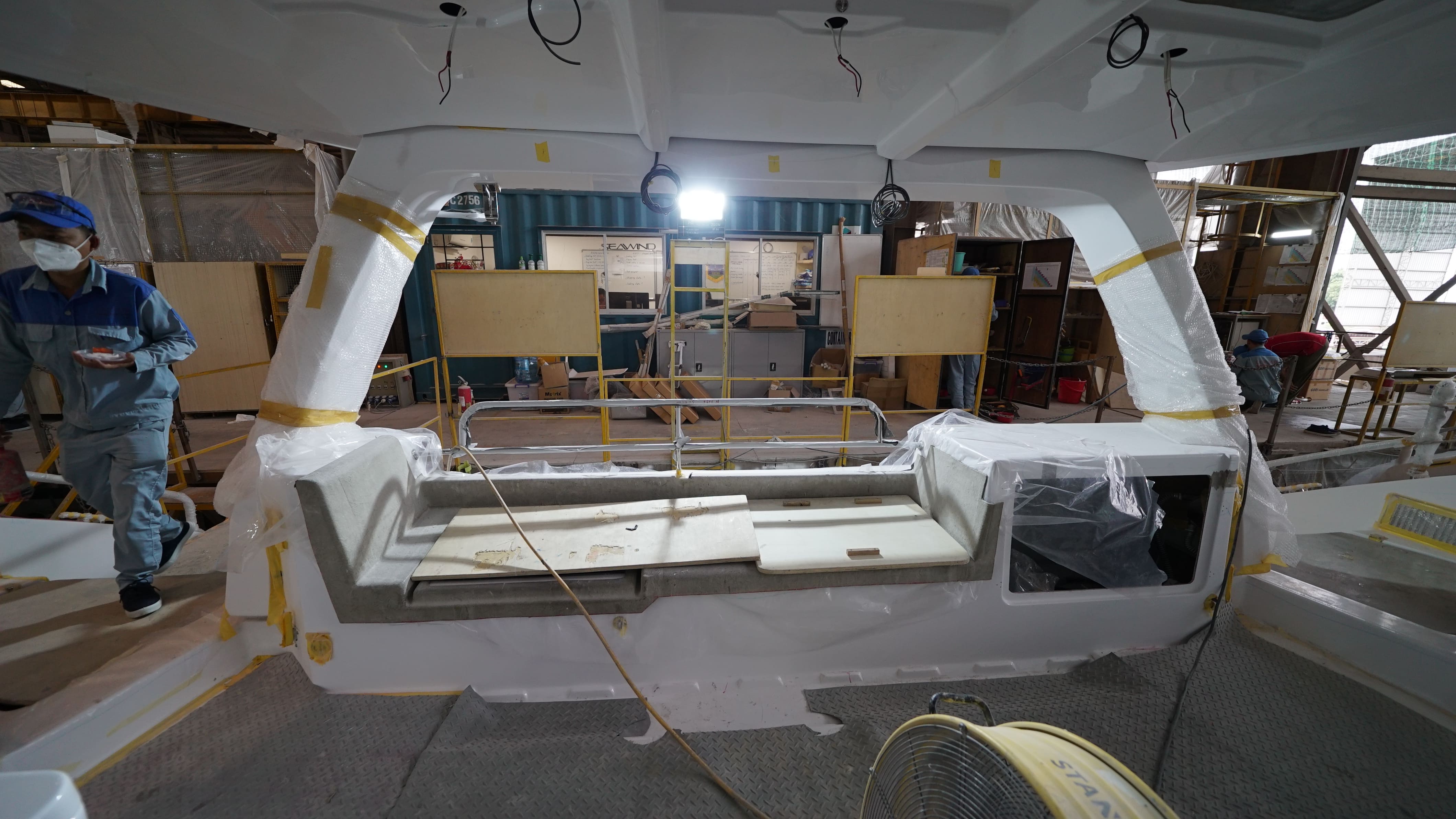

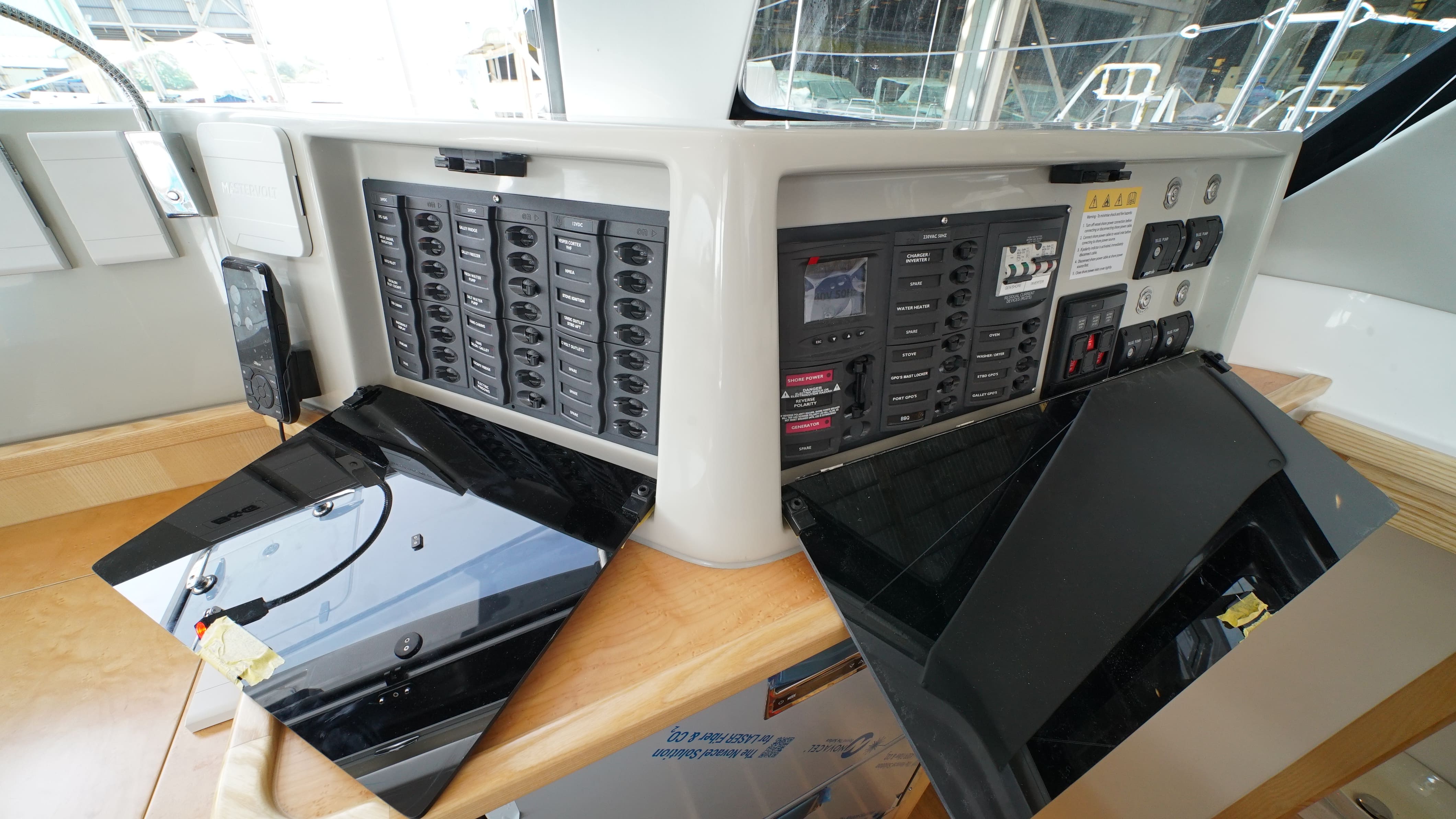

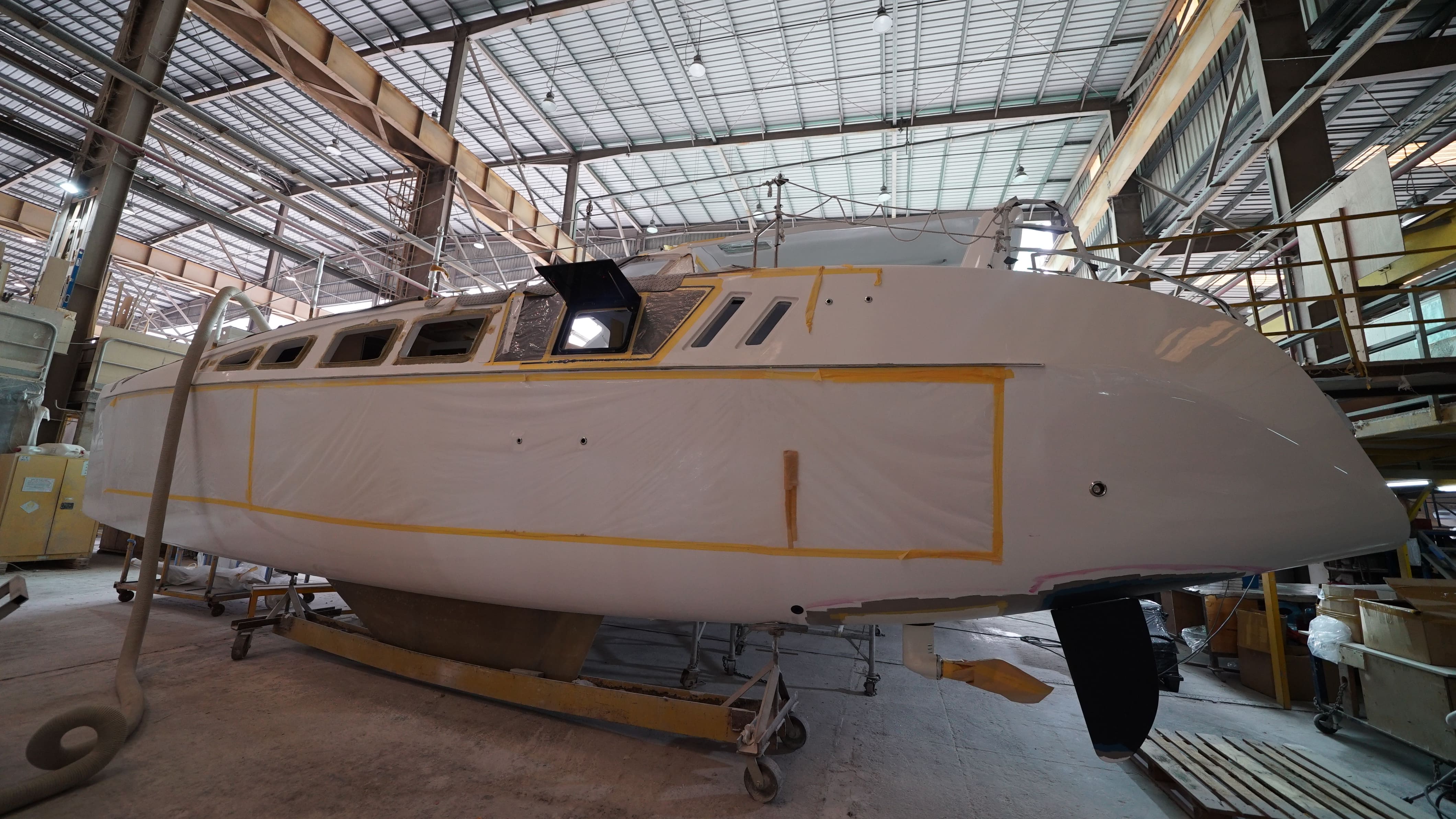

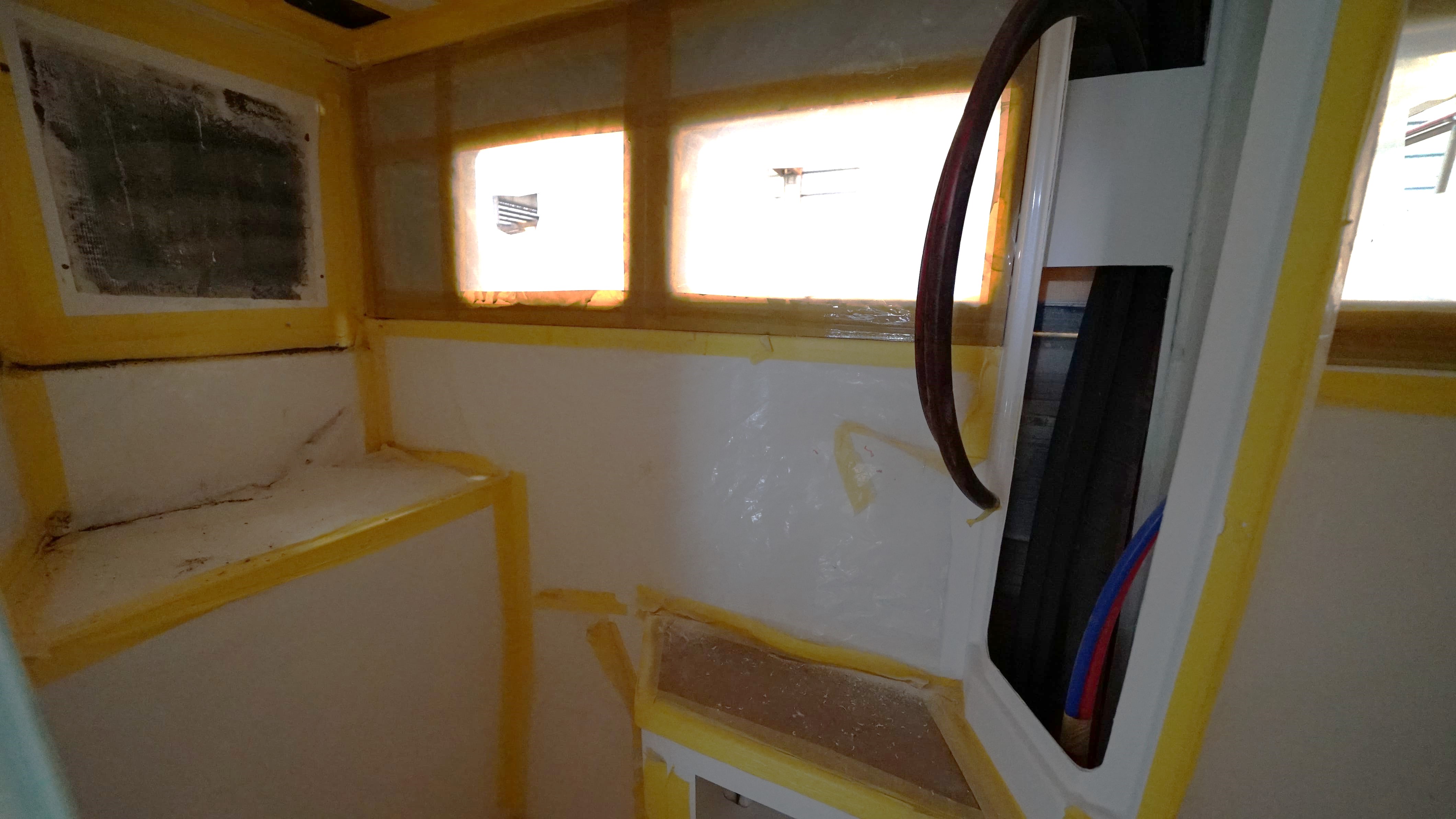

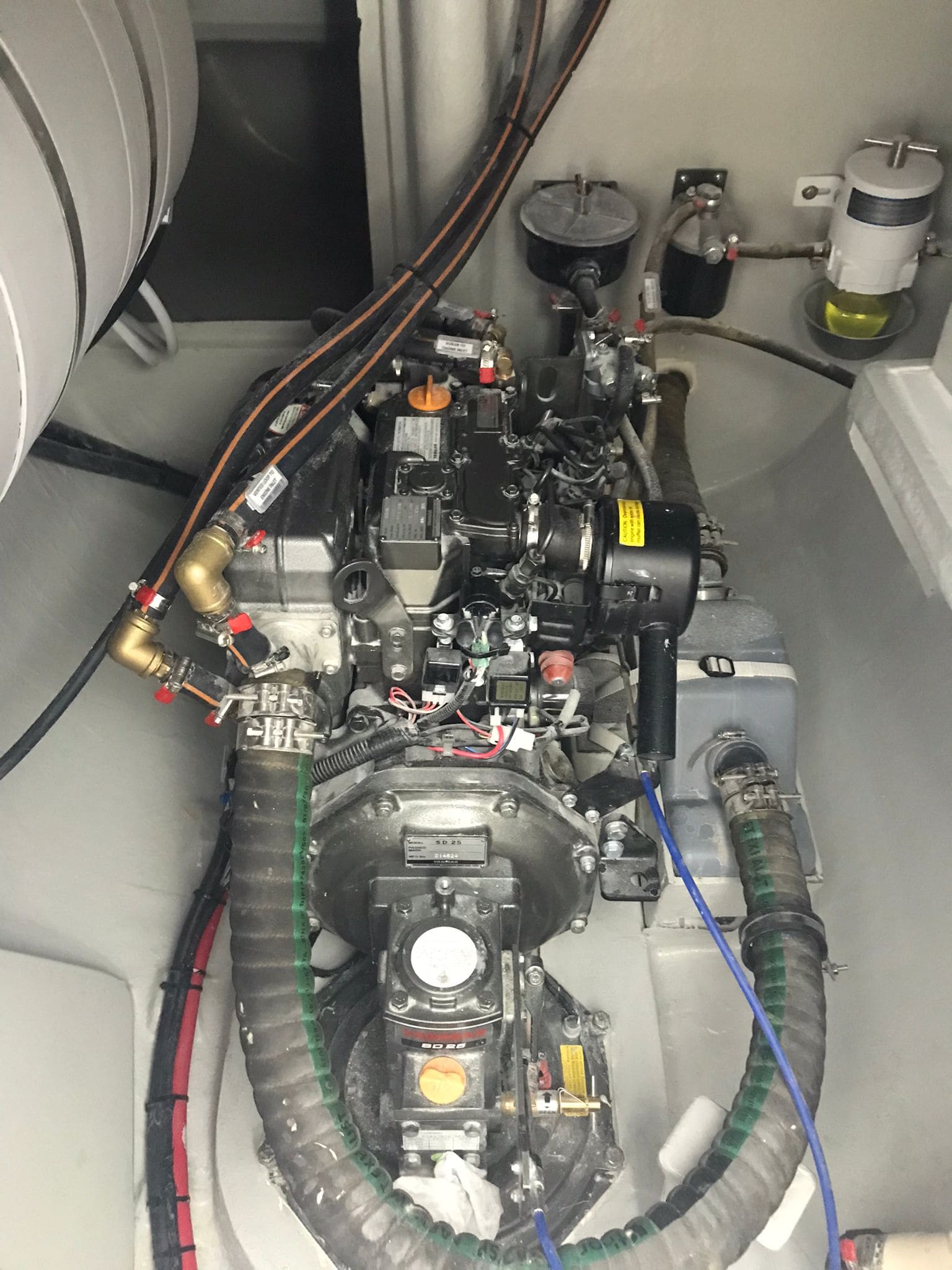

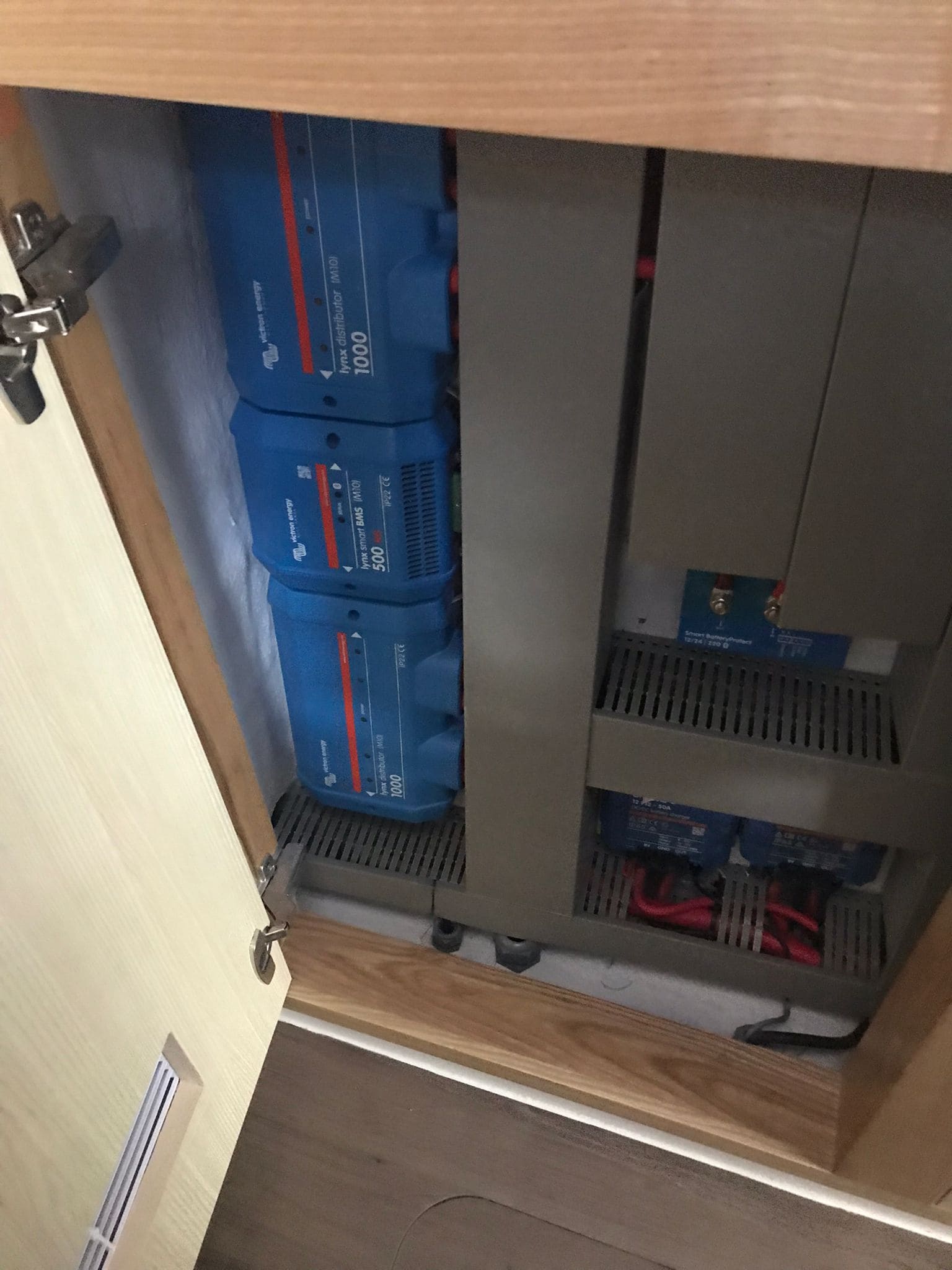

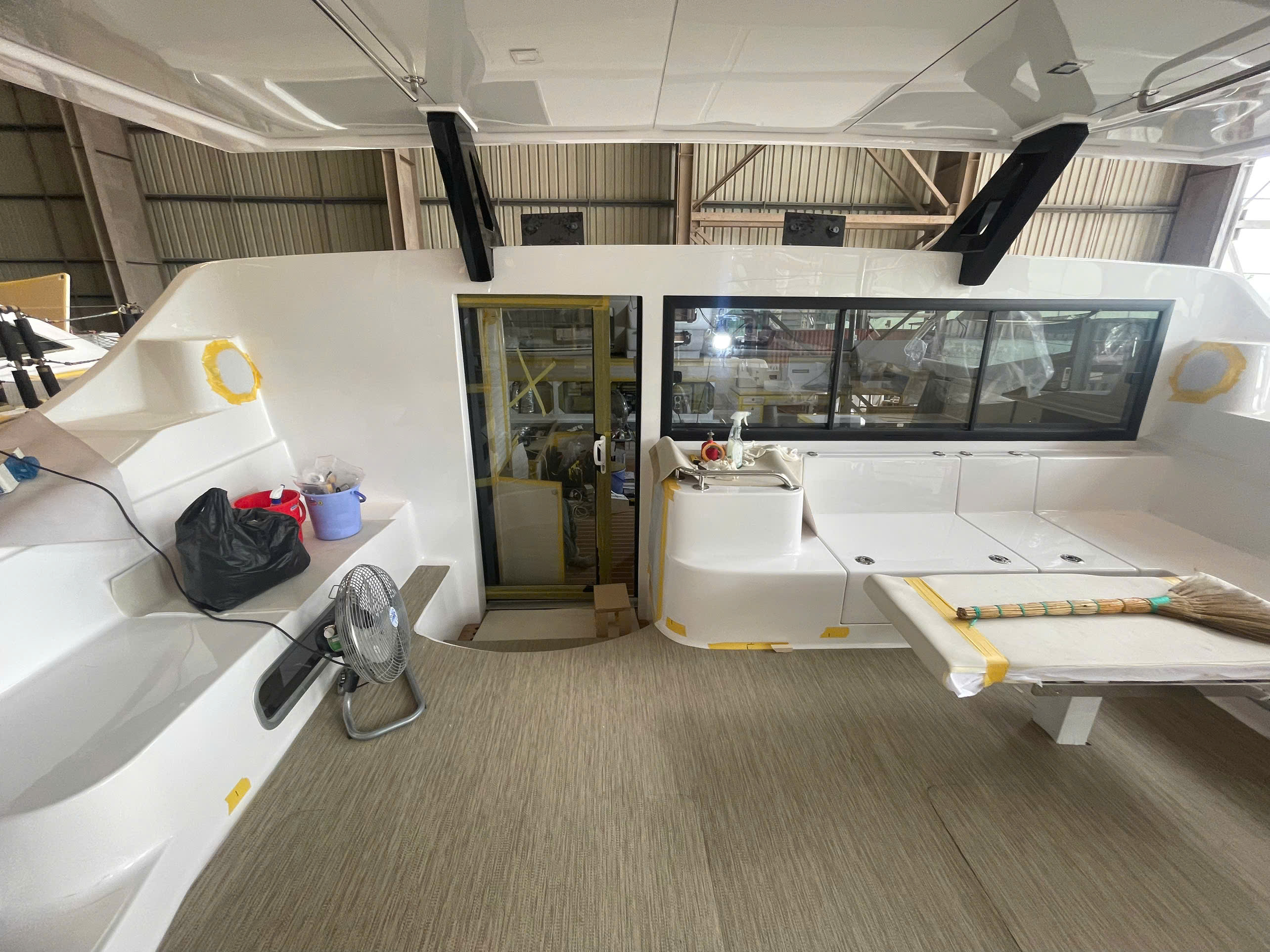

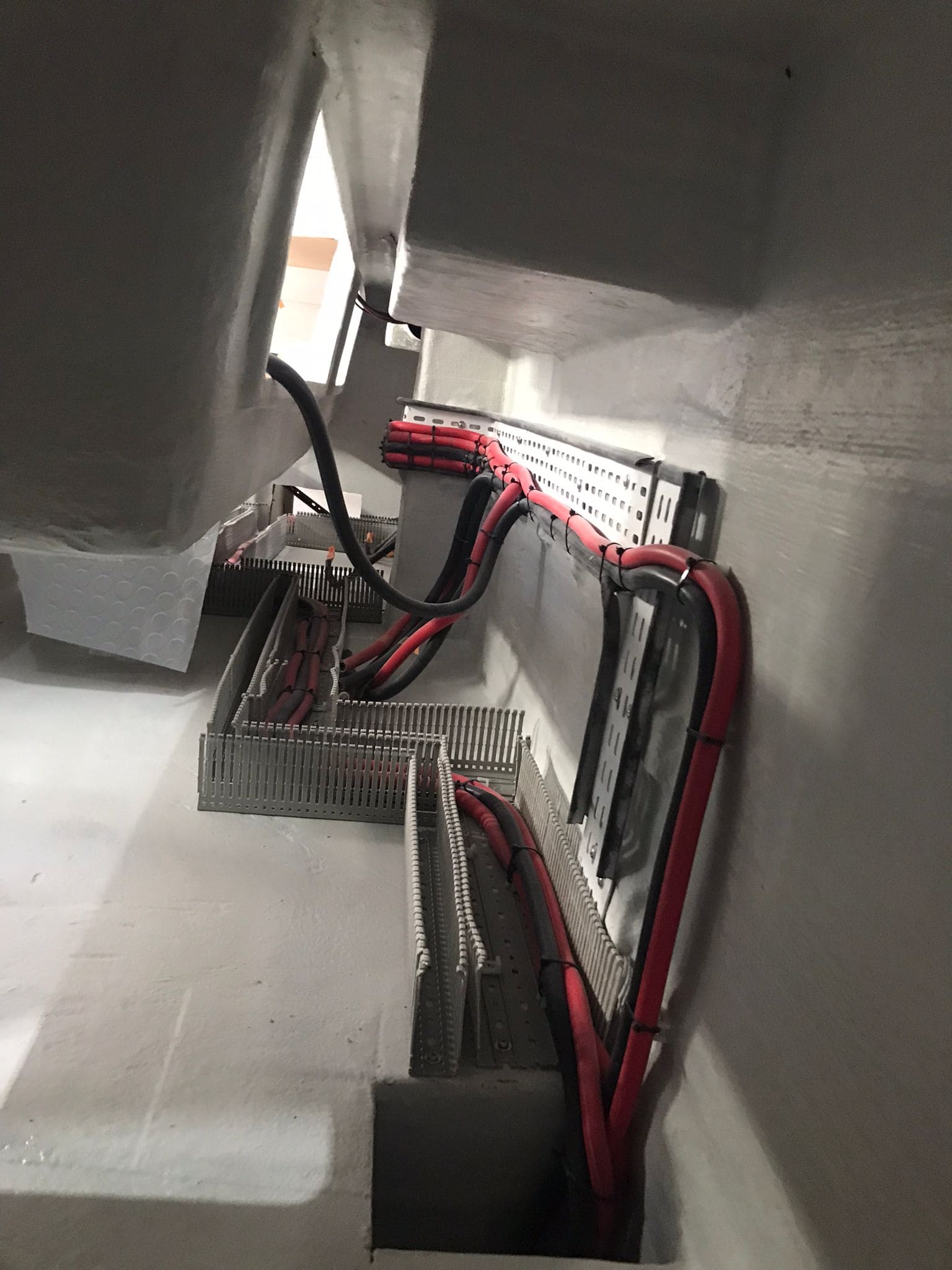

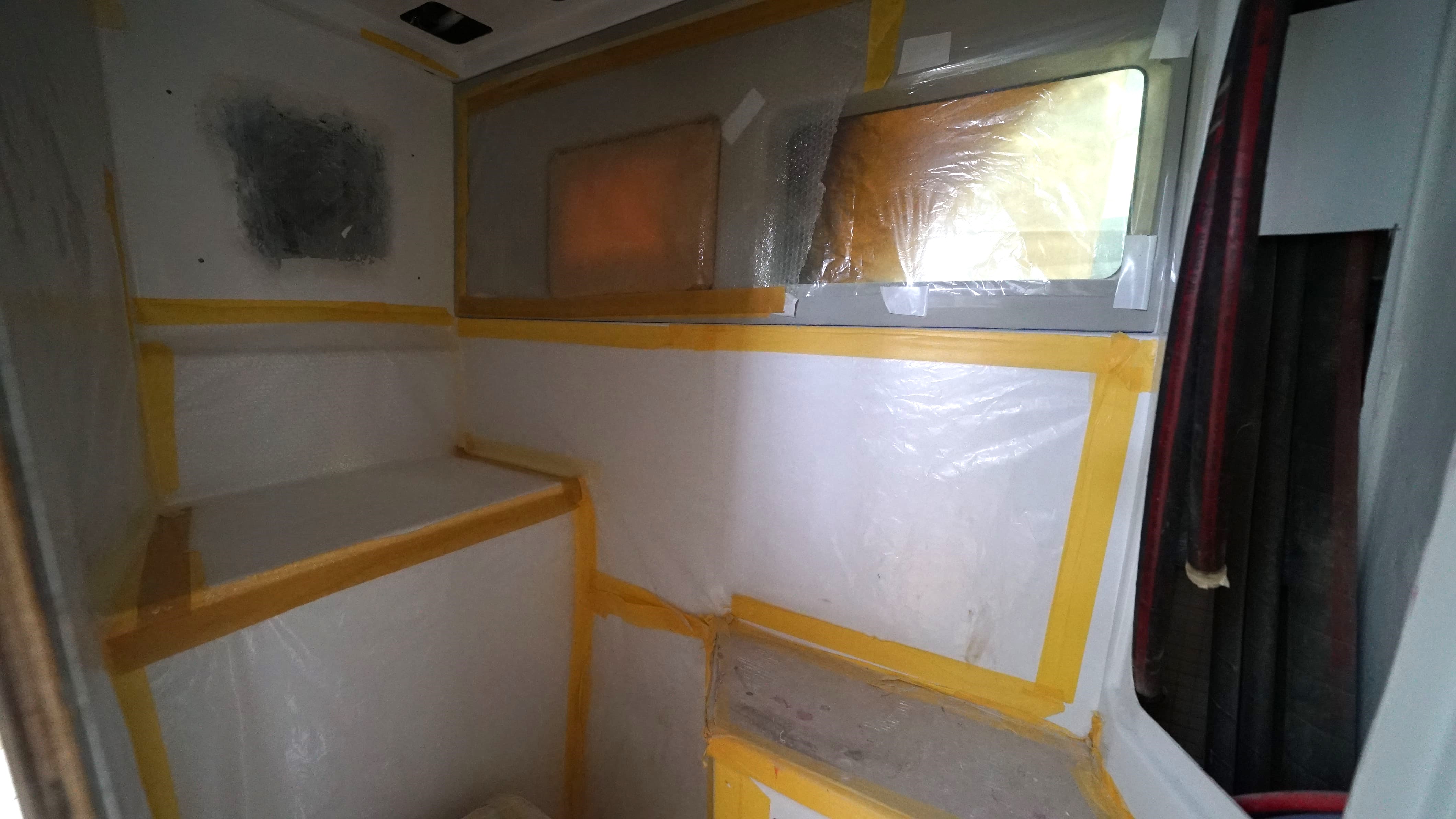

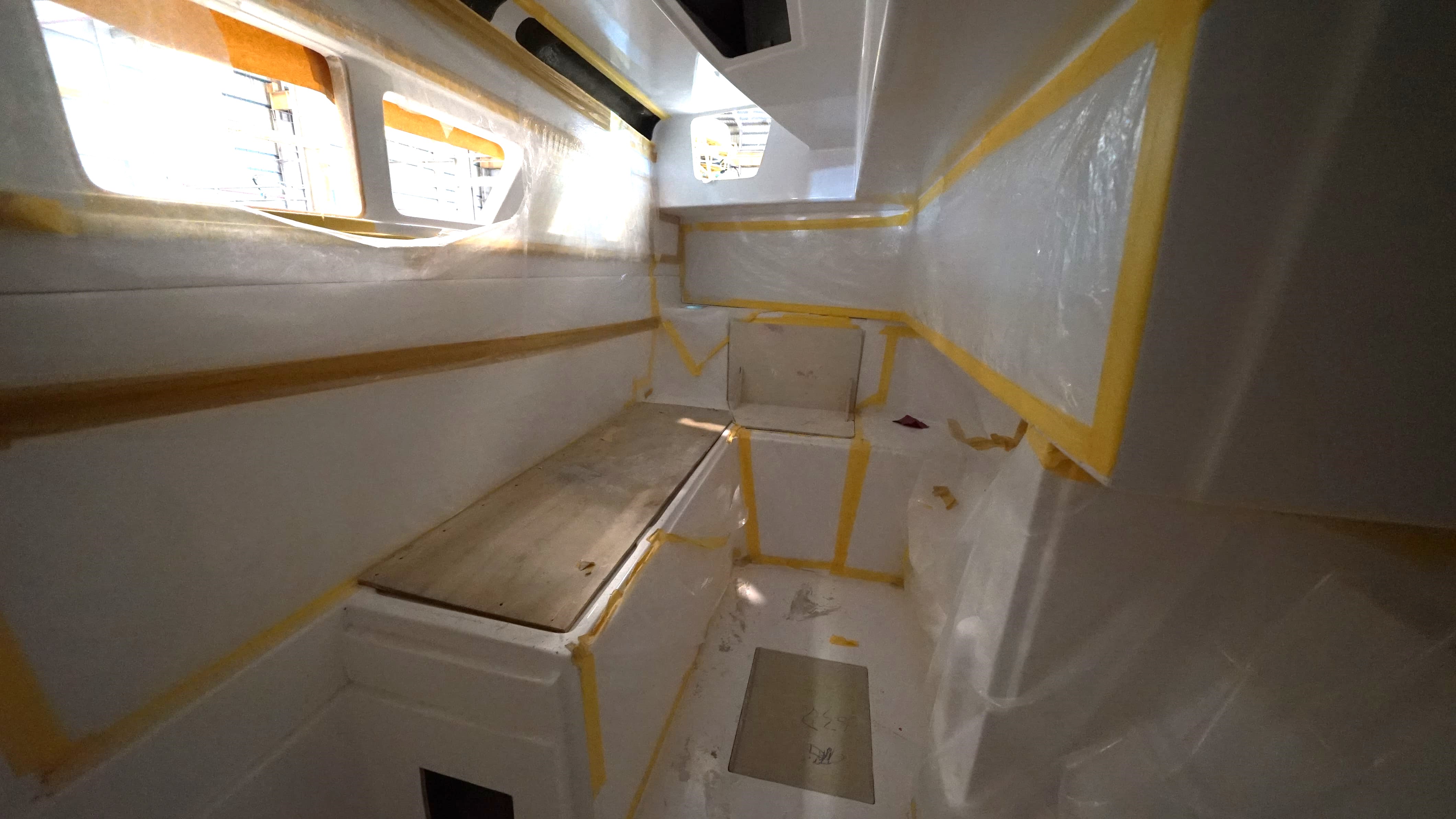

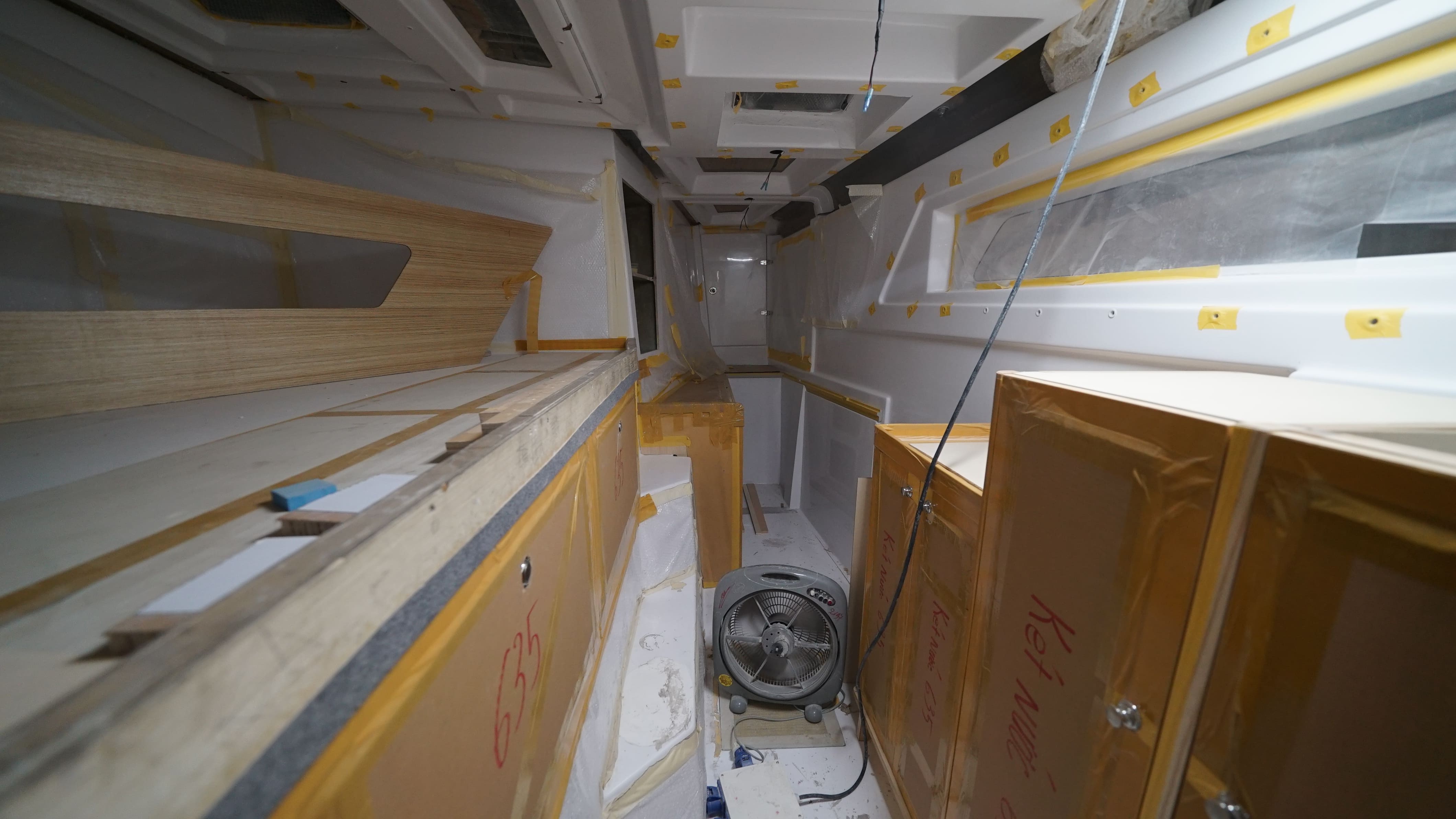

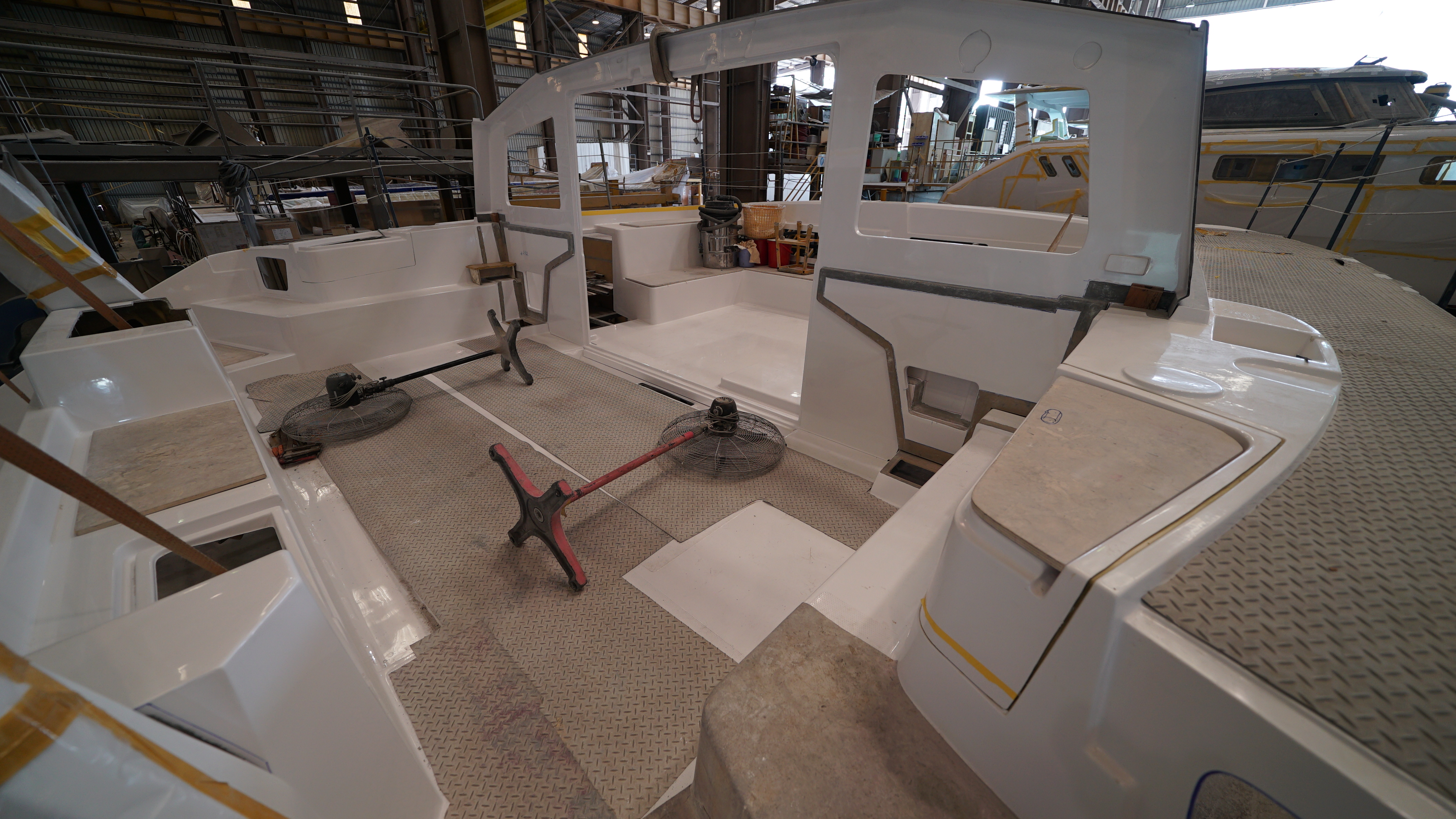

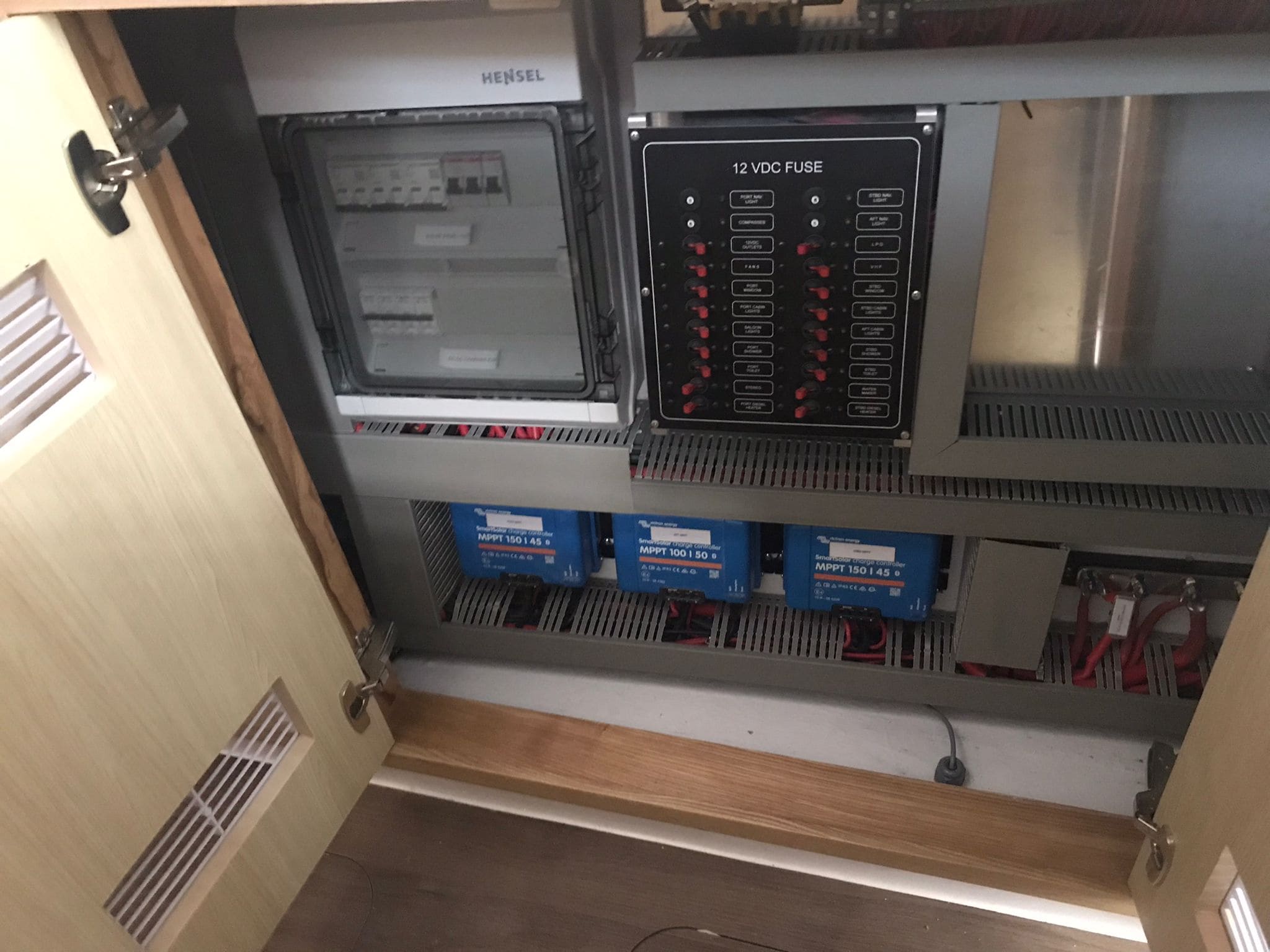

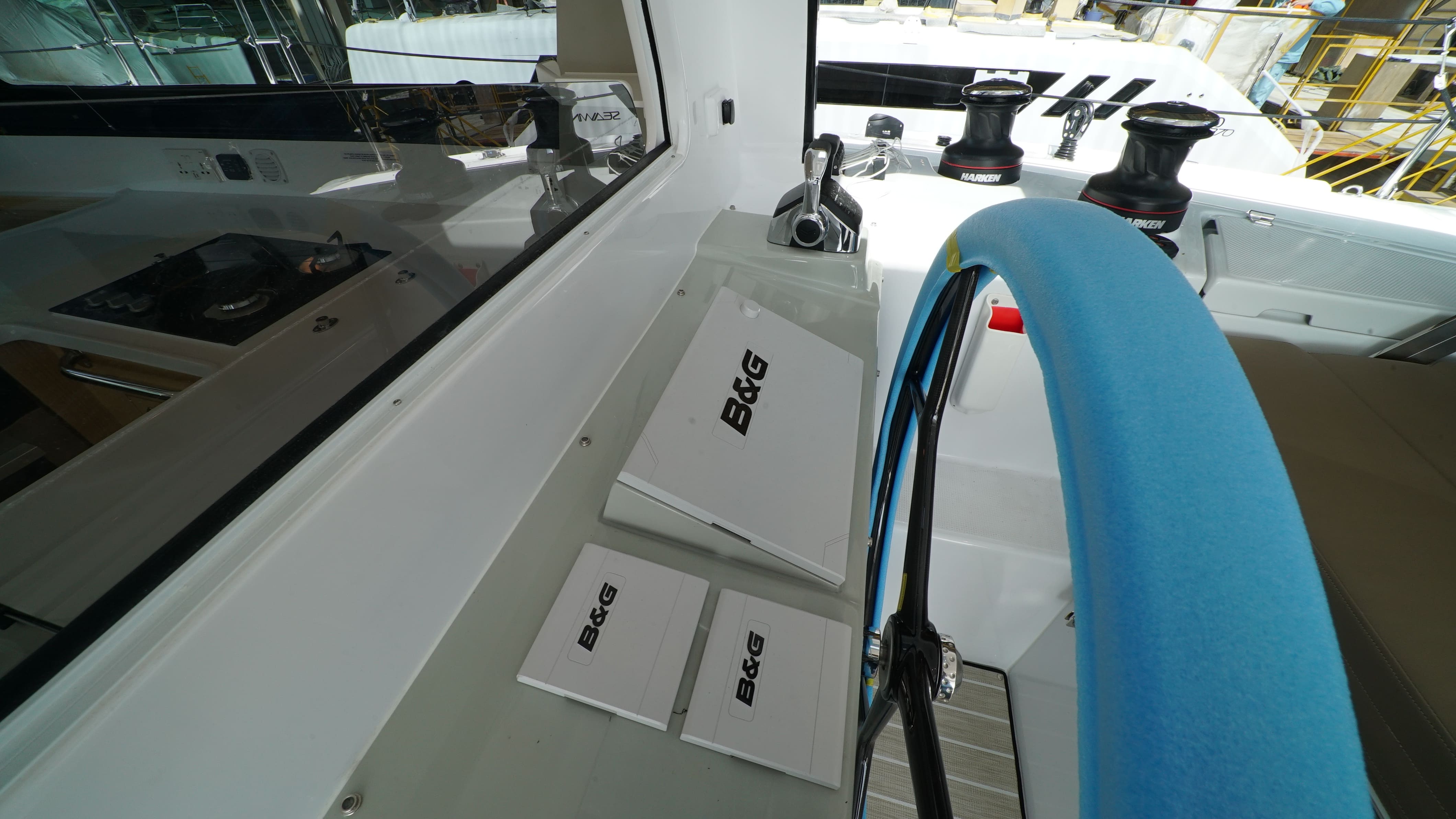

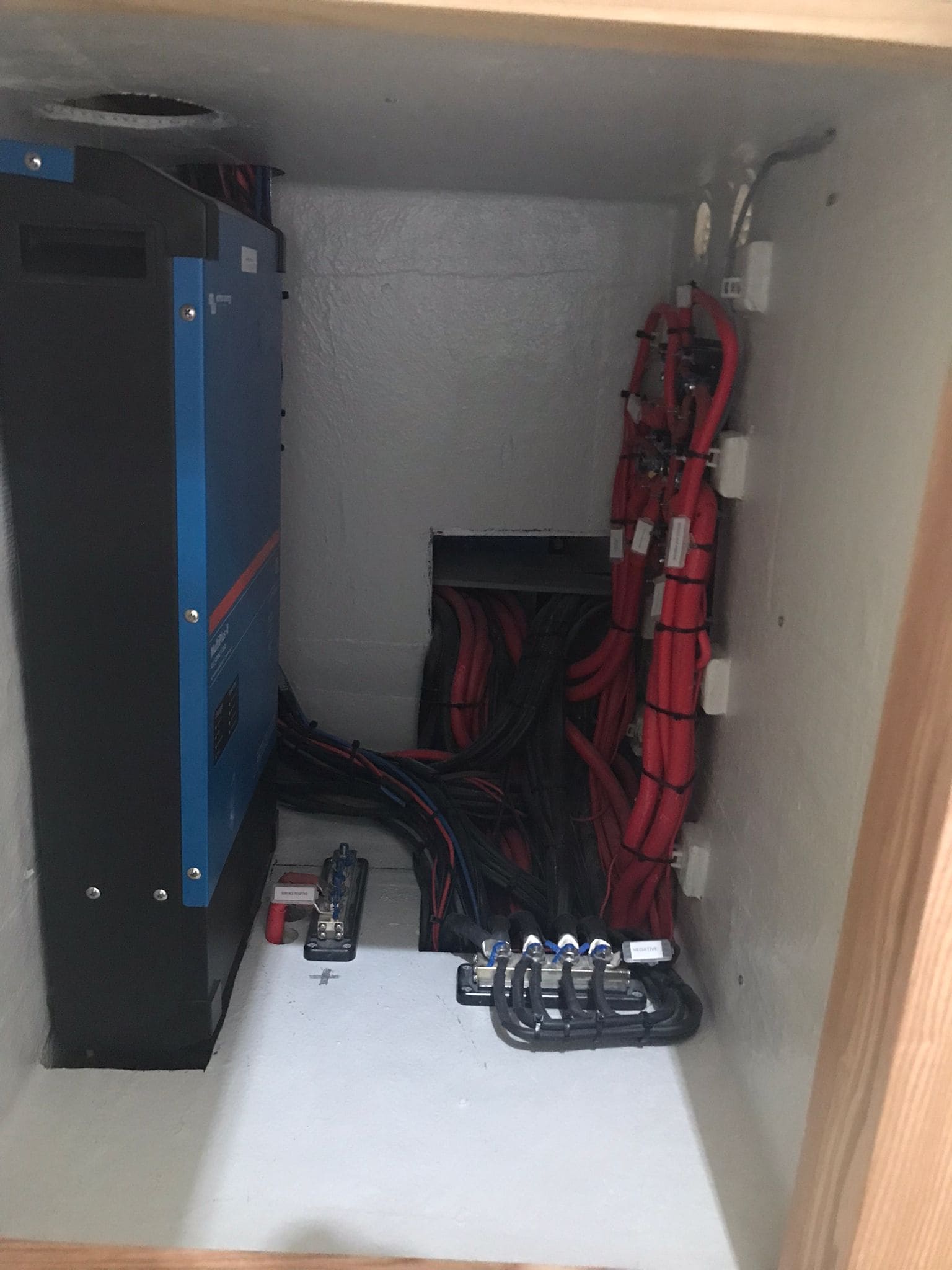

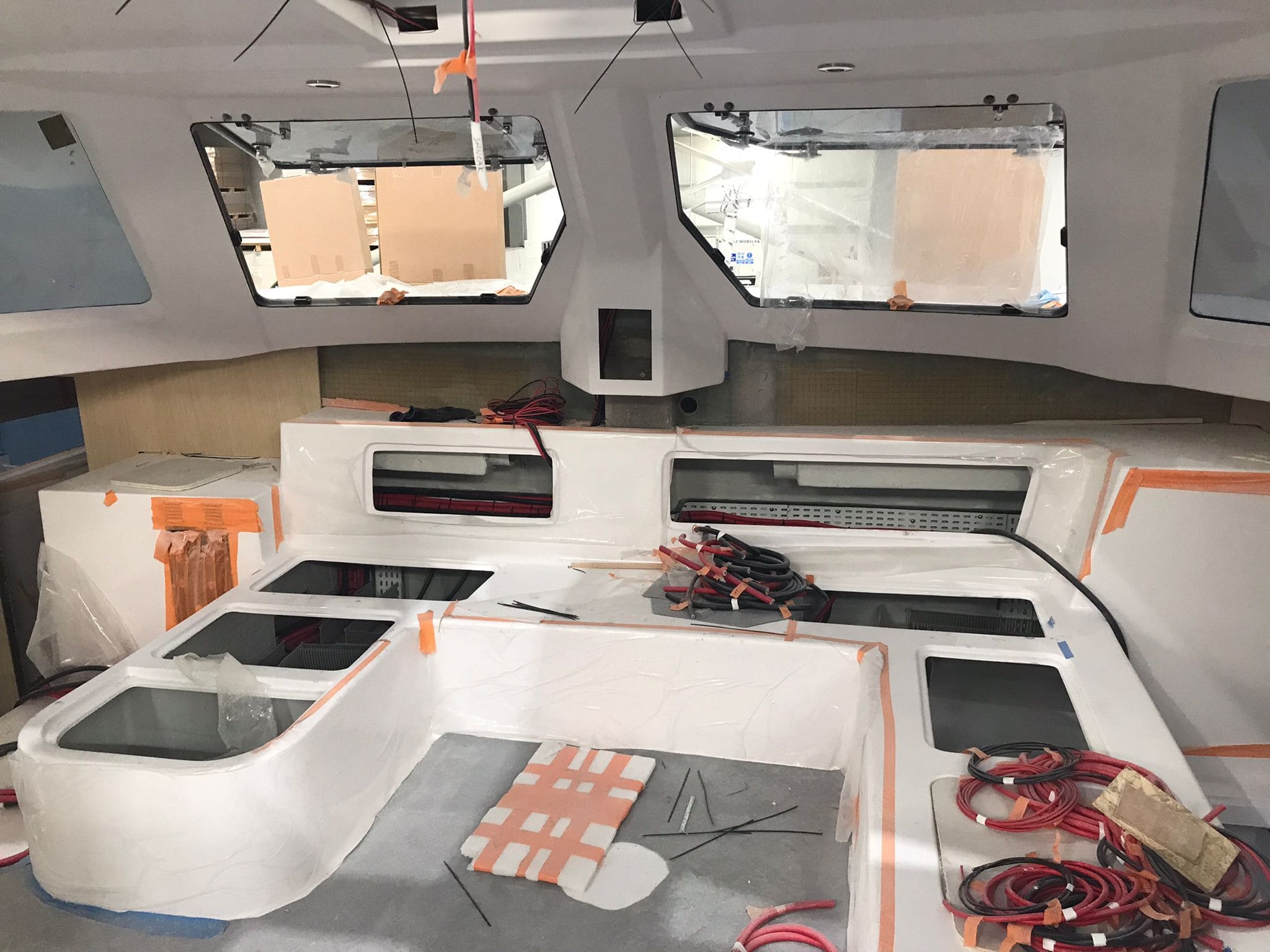

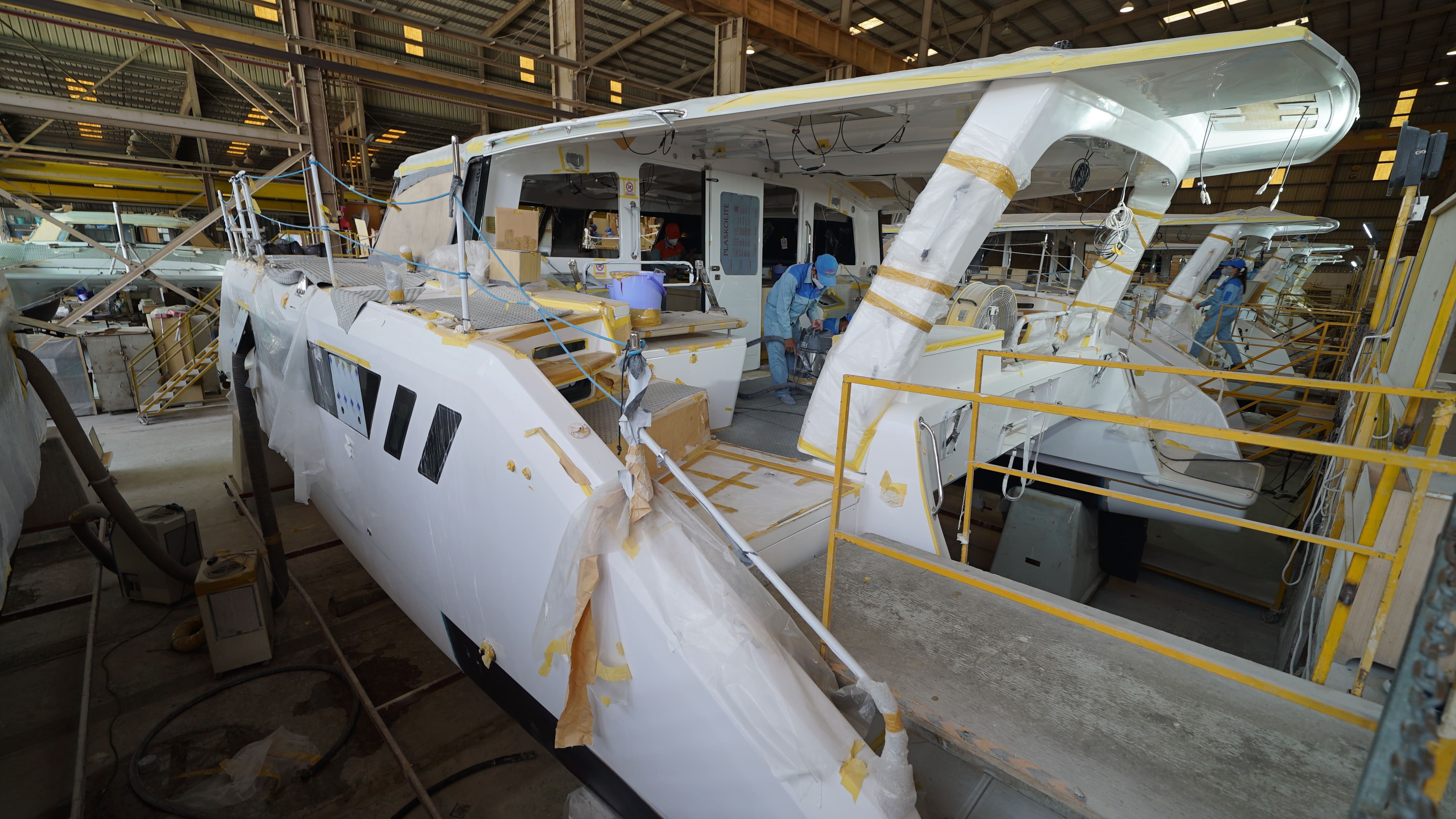

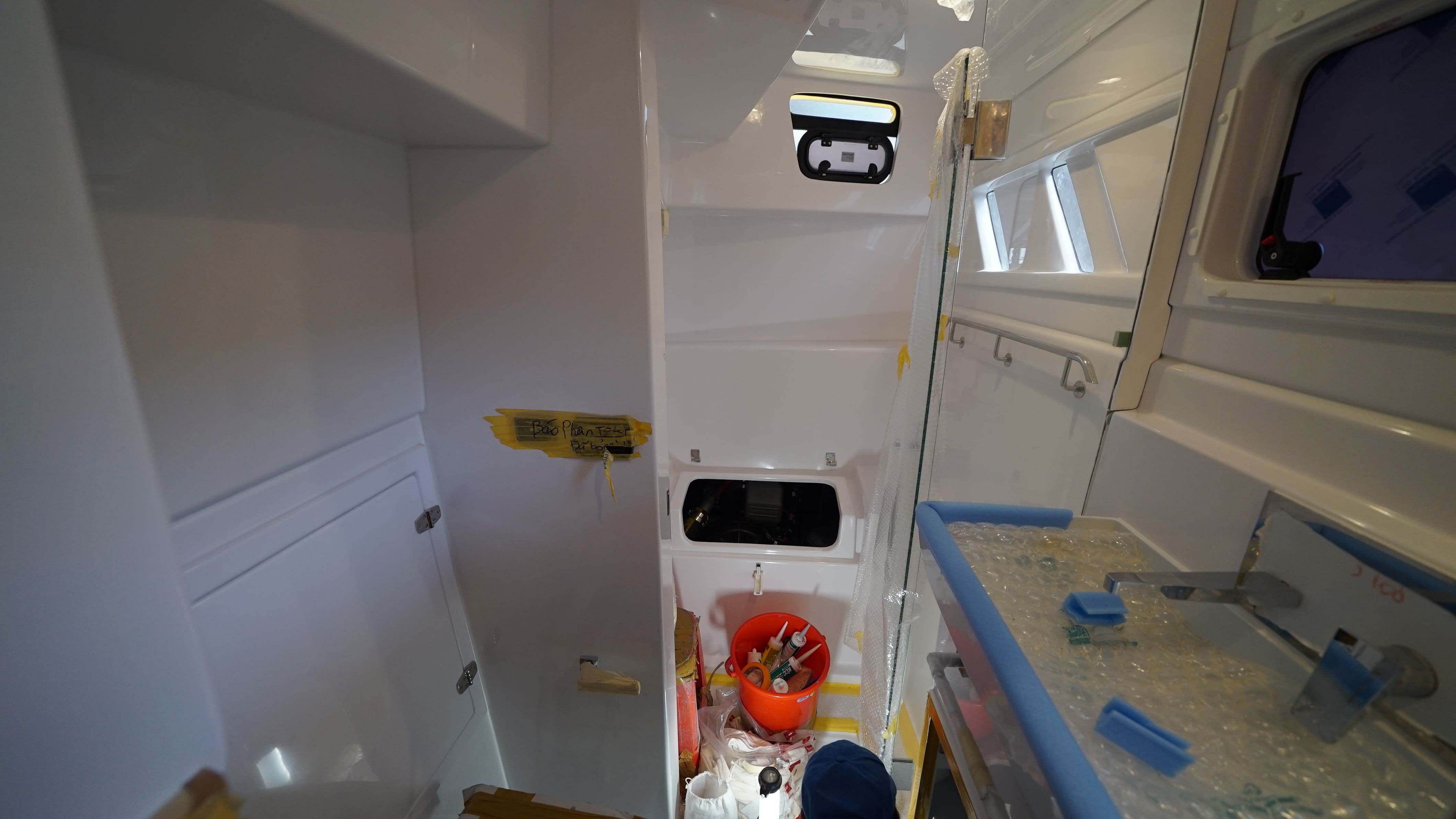

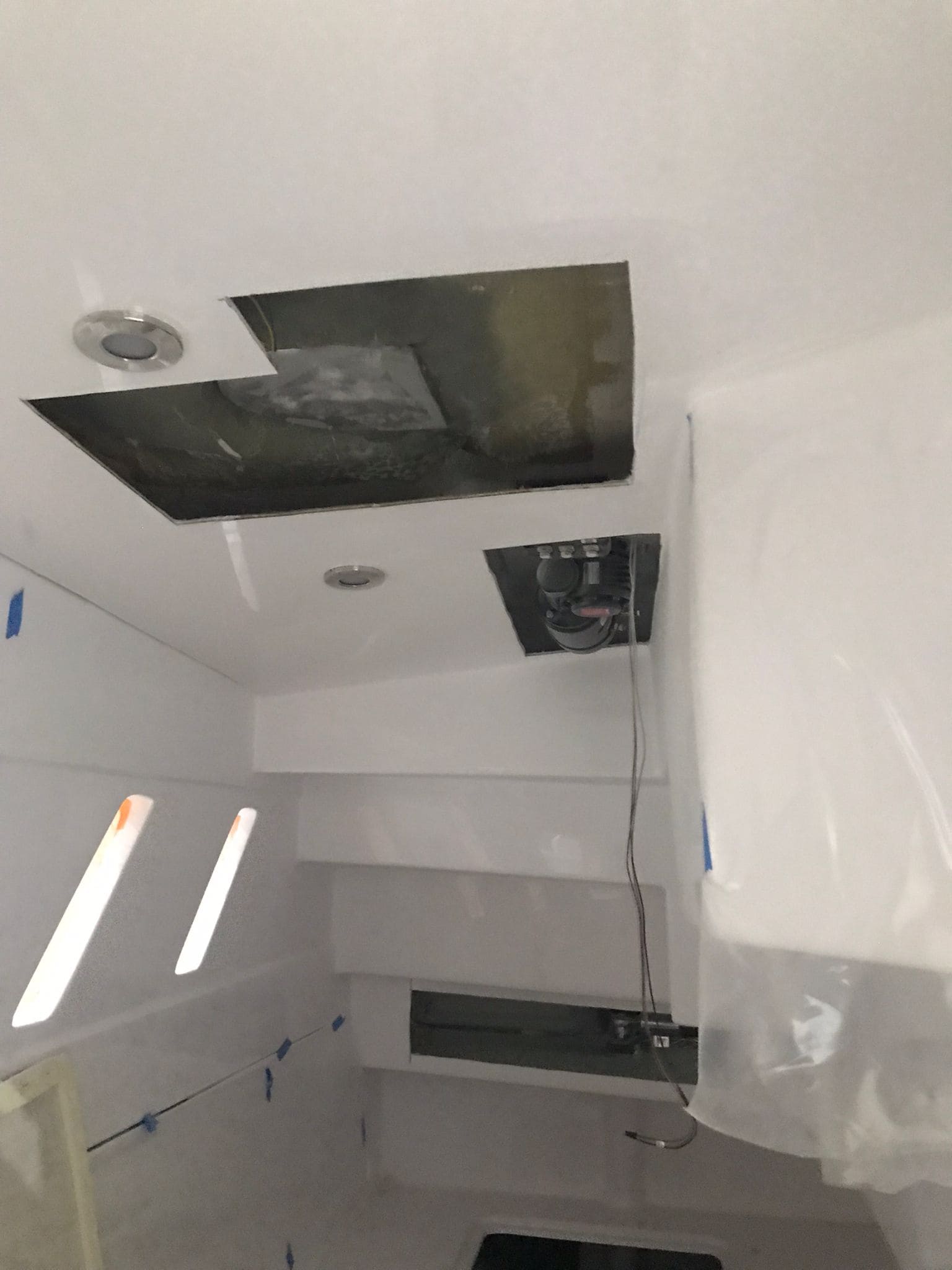

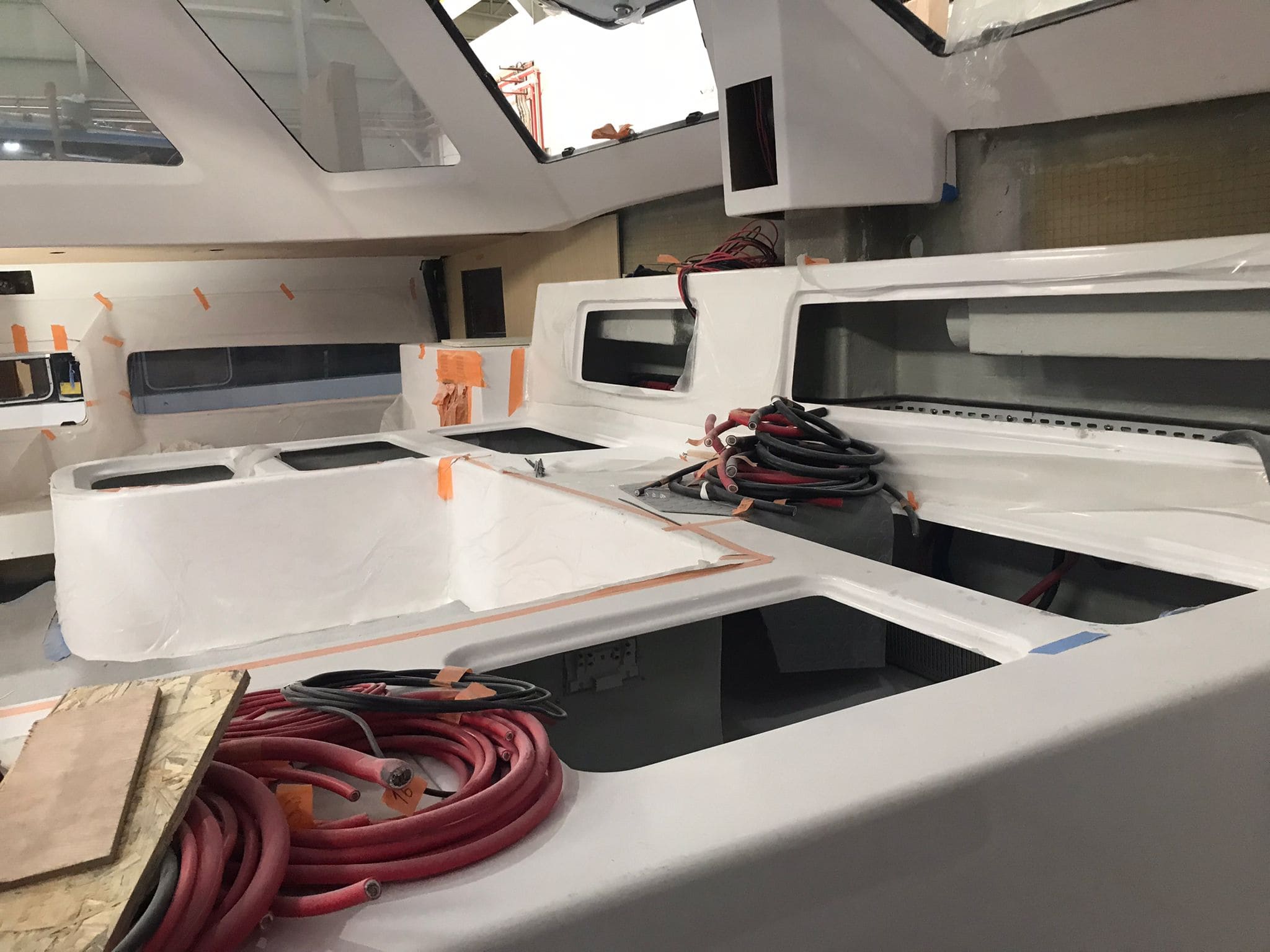

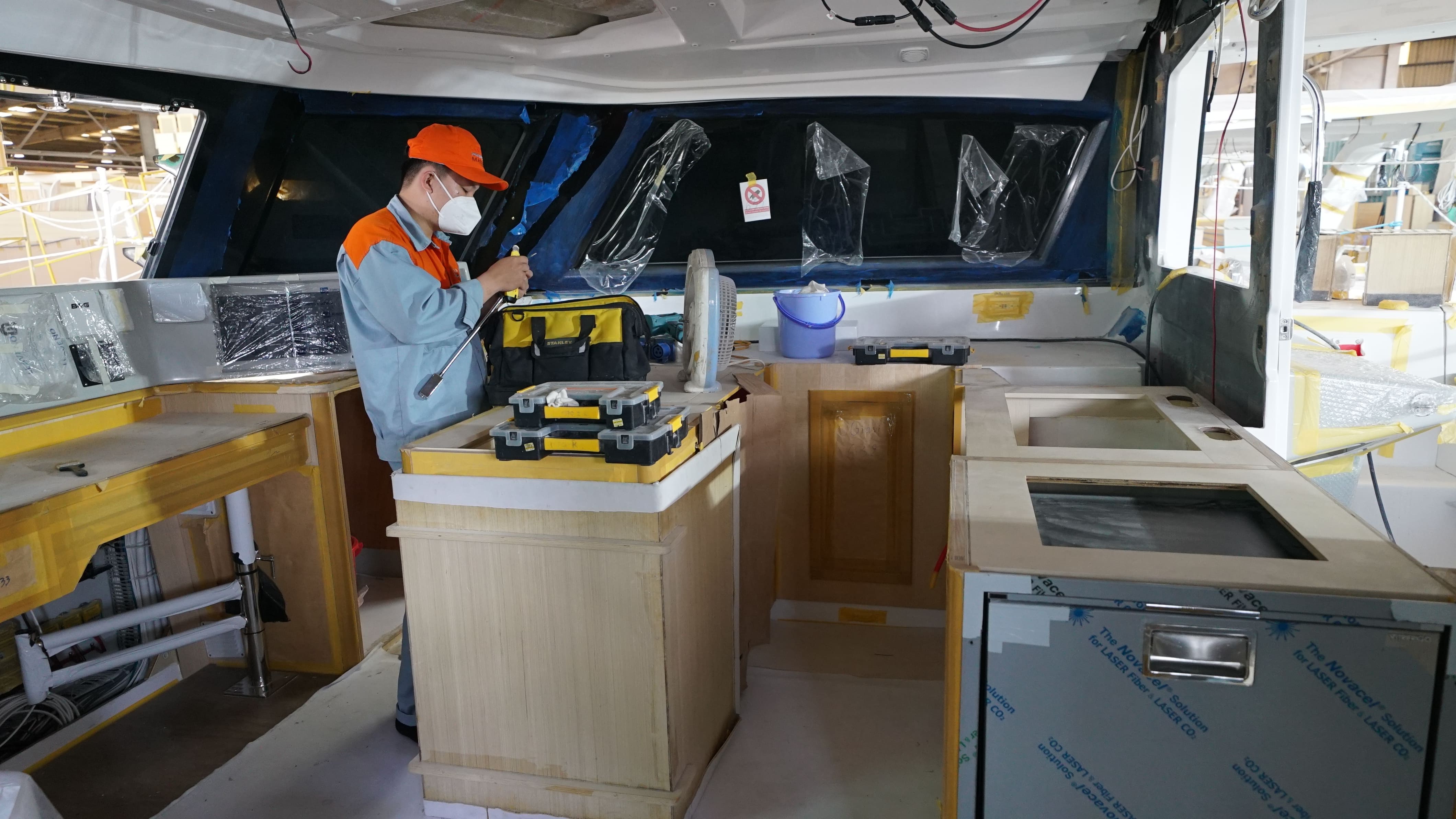

Being moved to the main 1370 production line, the hull and deck were joined last week. Our Production team is currently working on gelcoat repair, LPG plumbing, and electrical wiring.

Production Update – Assembly

Your boat is progressing well in the last phase of Assembly stage.

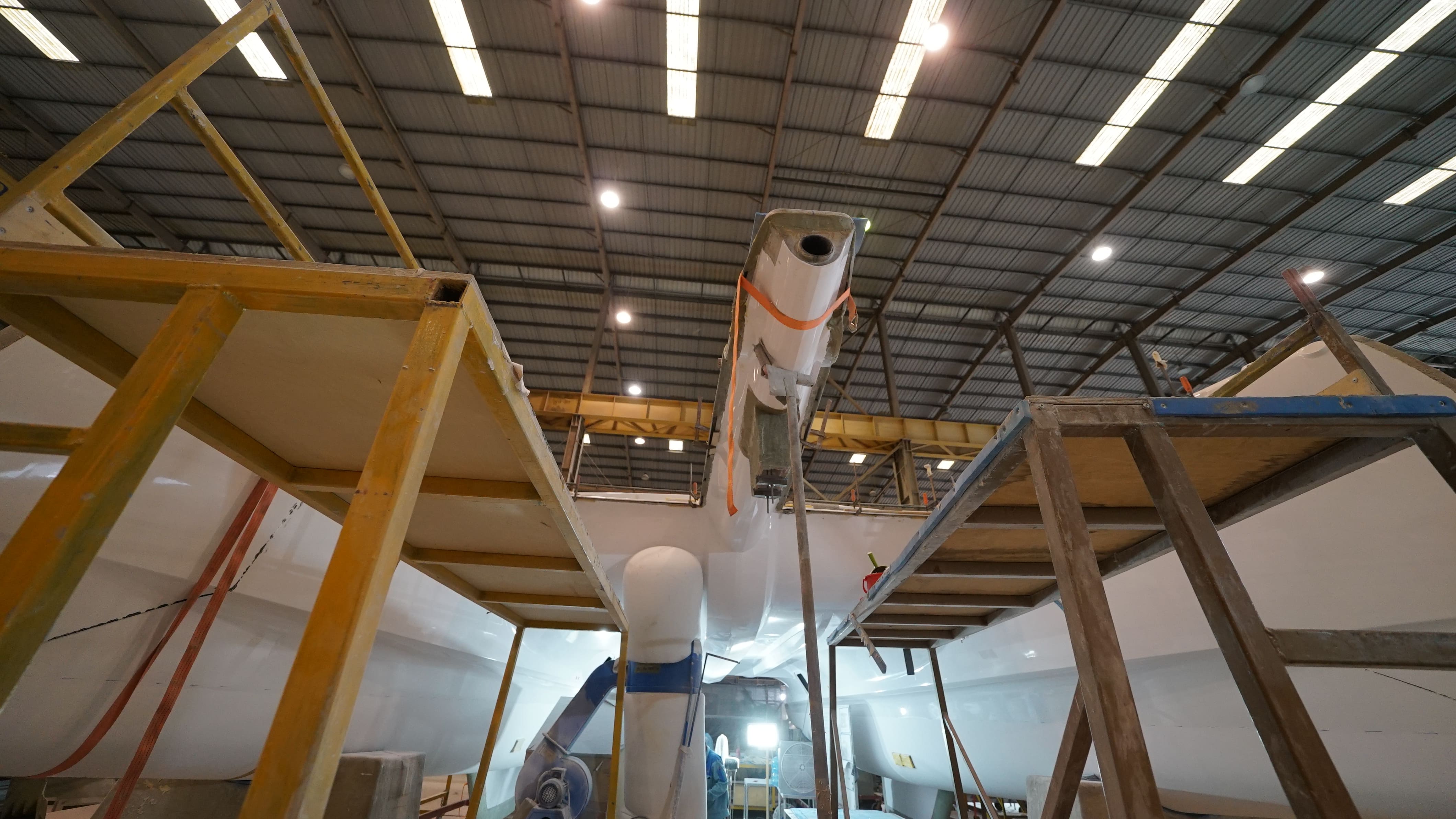

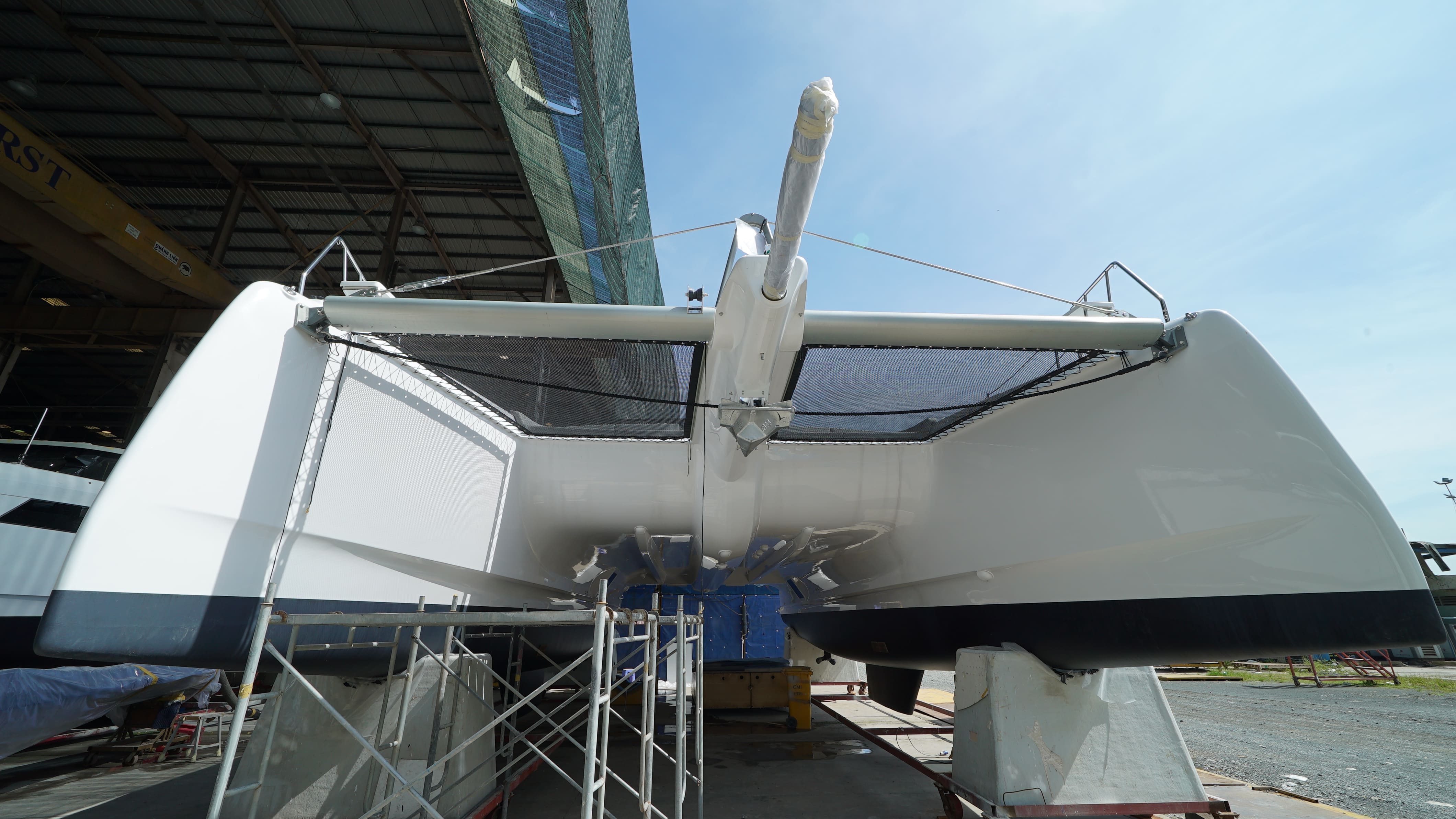

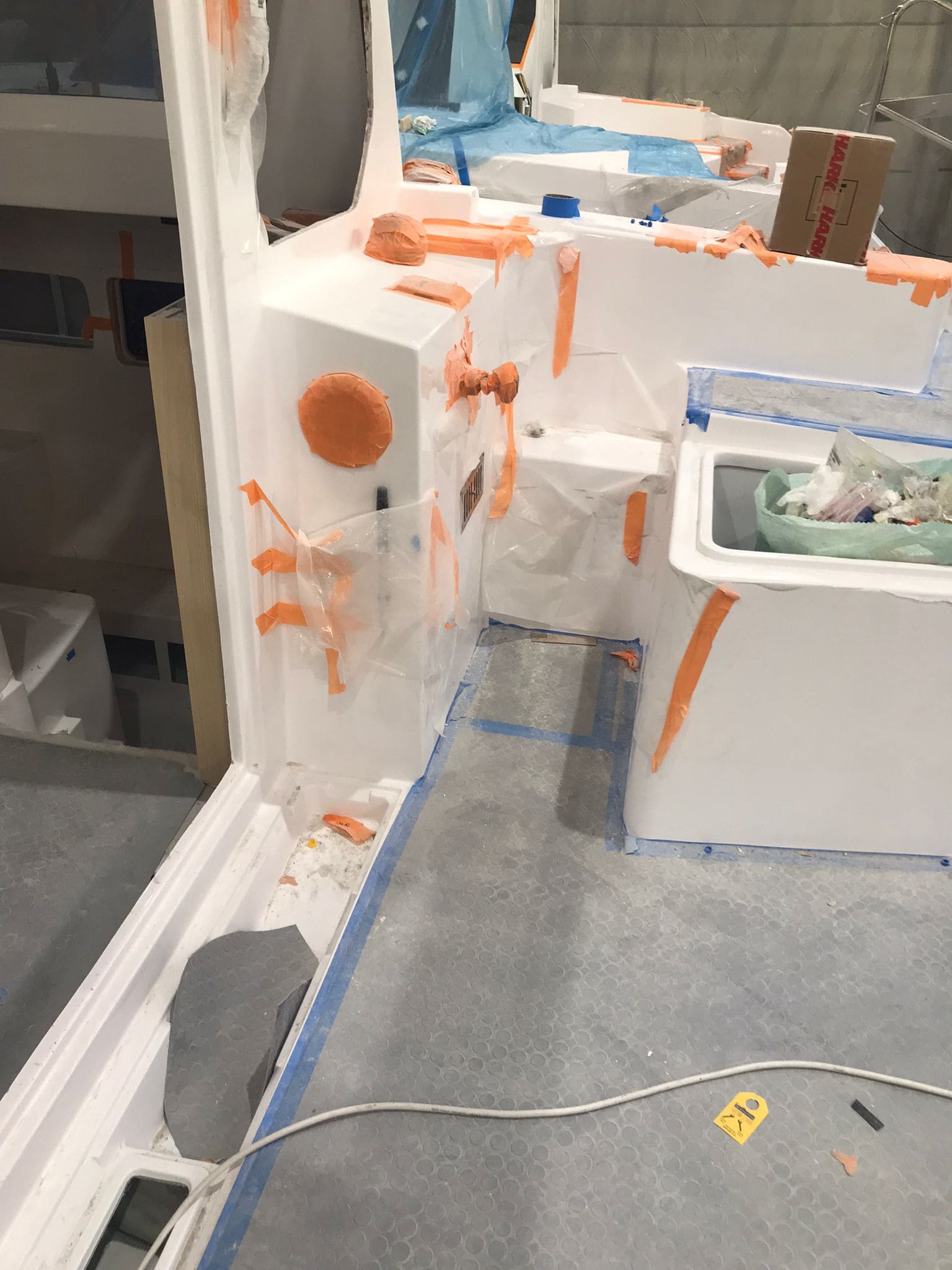

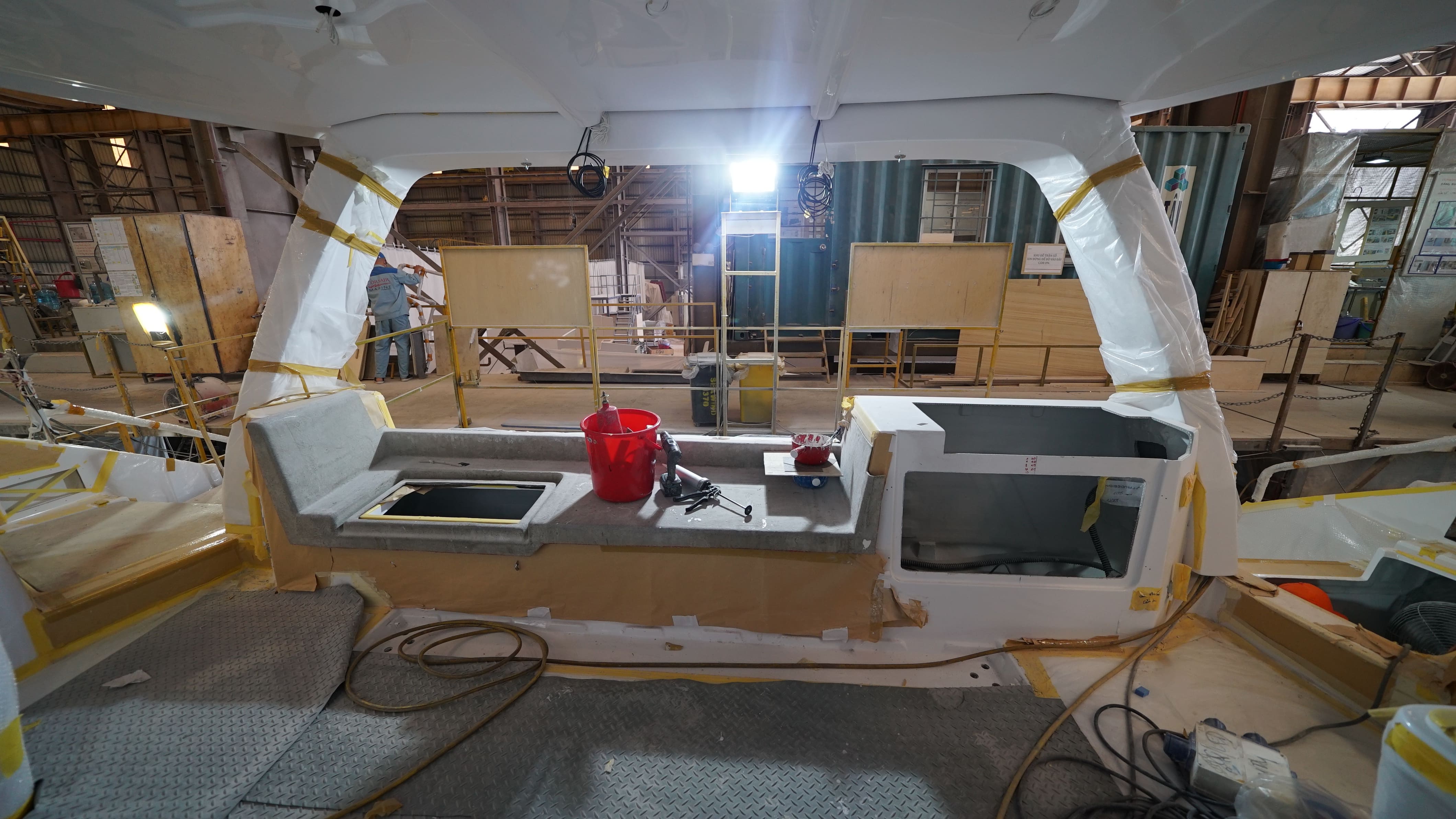

We recently complete the hull-deck joining, engines & saildrive installation.

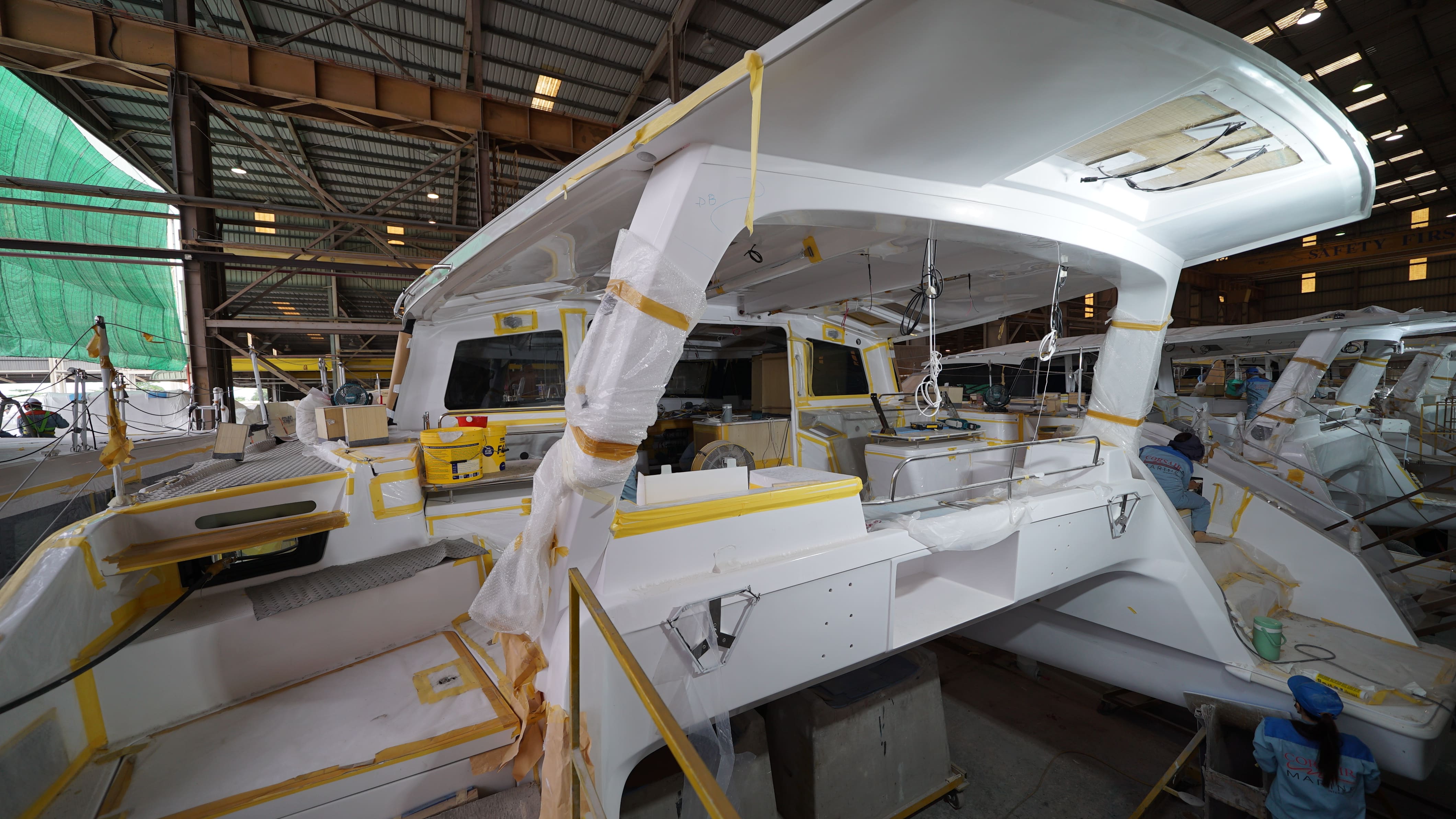

Our Production team is currently working on A-frame & beam (50%), electric work (15%), plumbing LPG at 15%, steering (20%), gelcoat (50%), stanchion at 25%, and deck hardware at 25%.

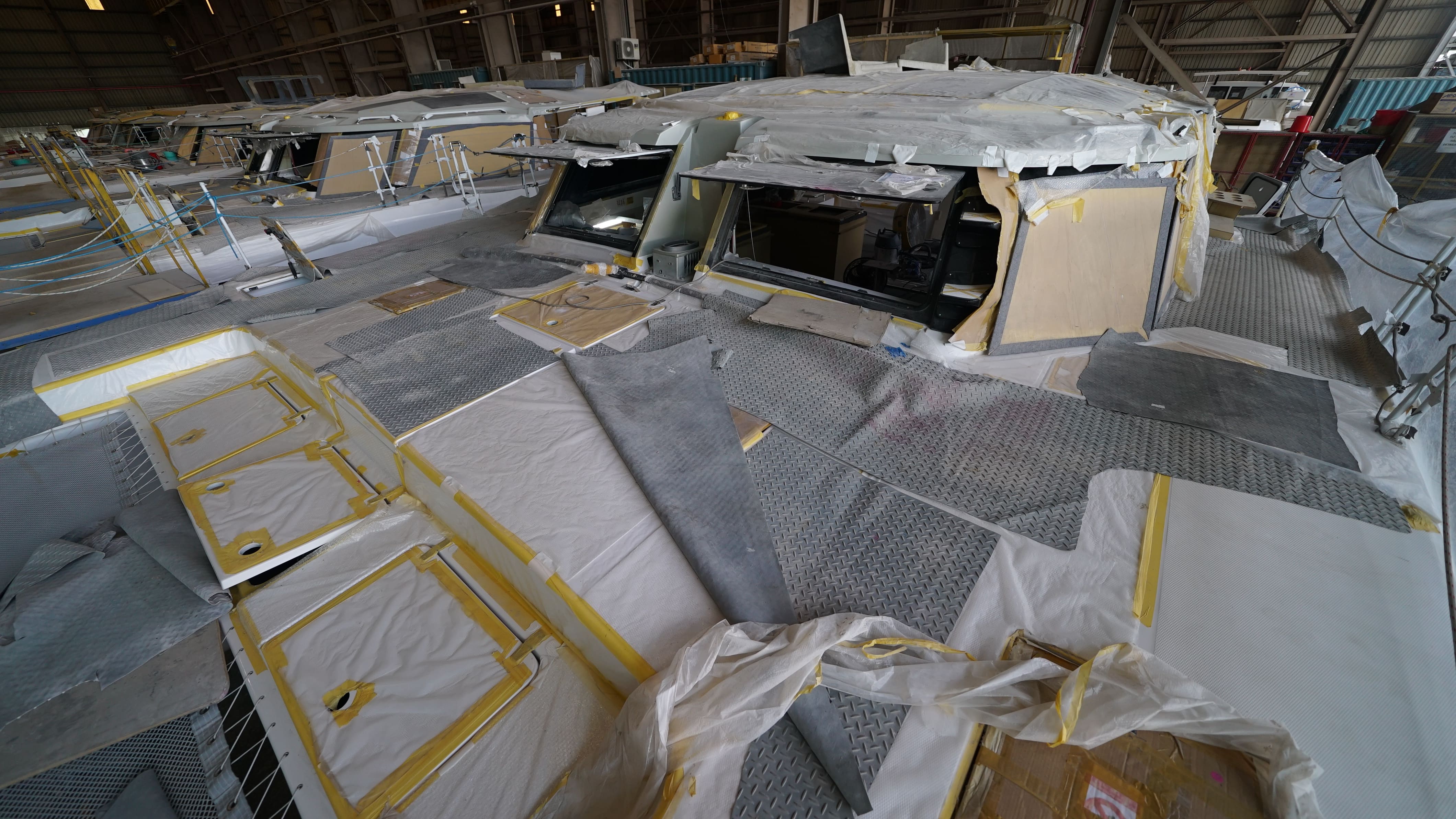

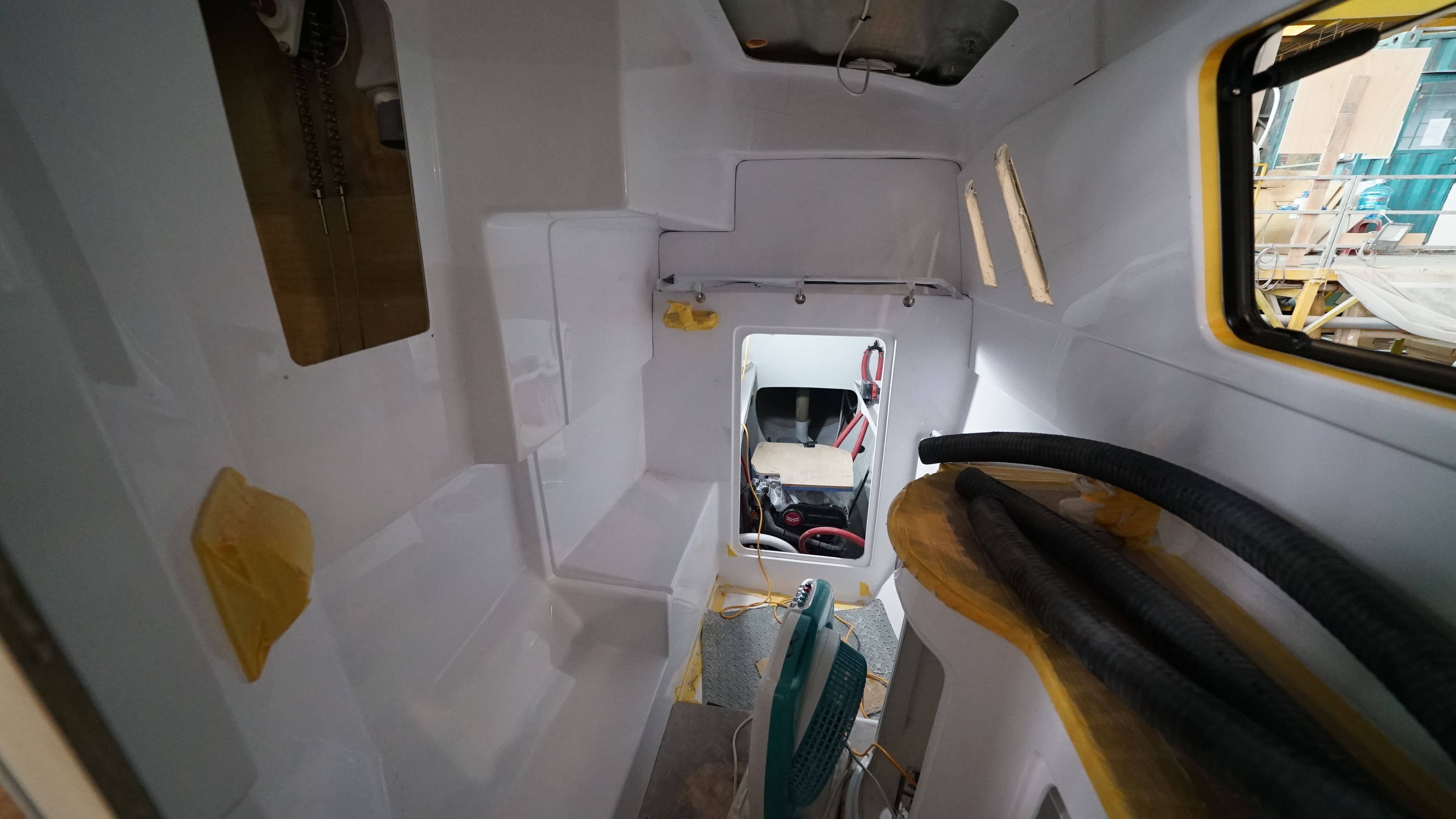

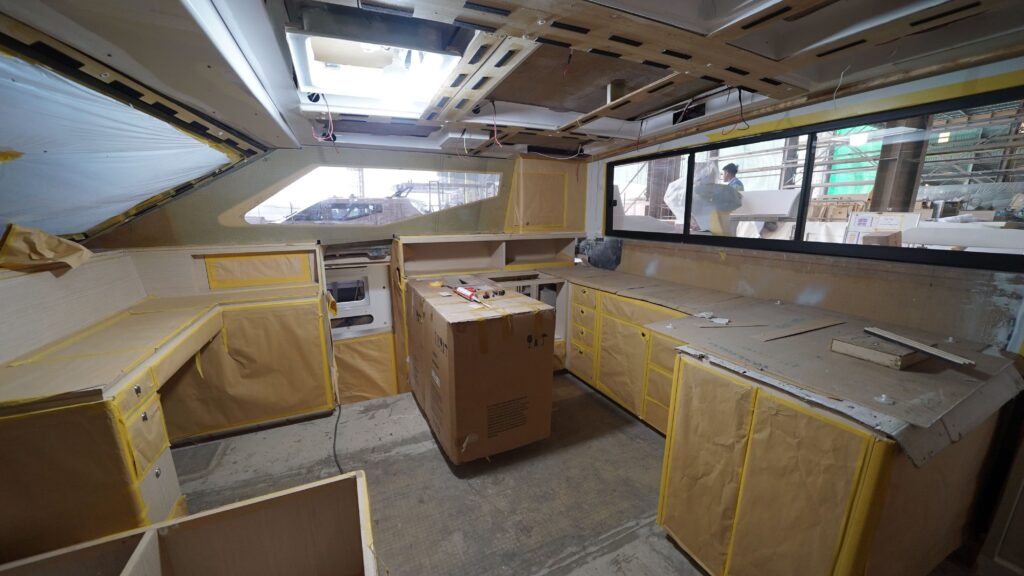

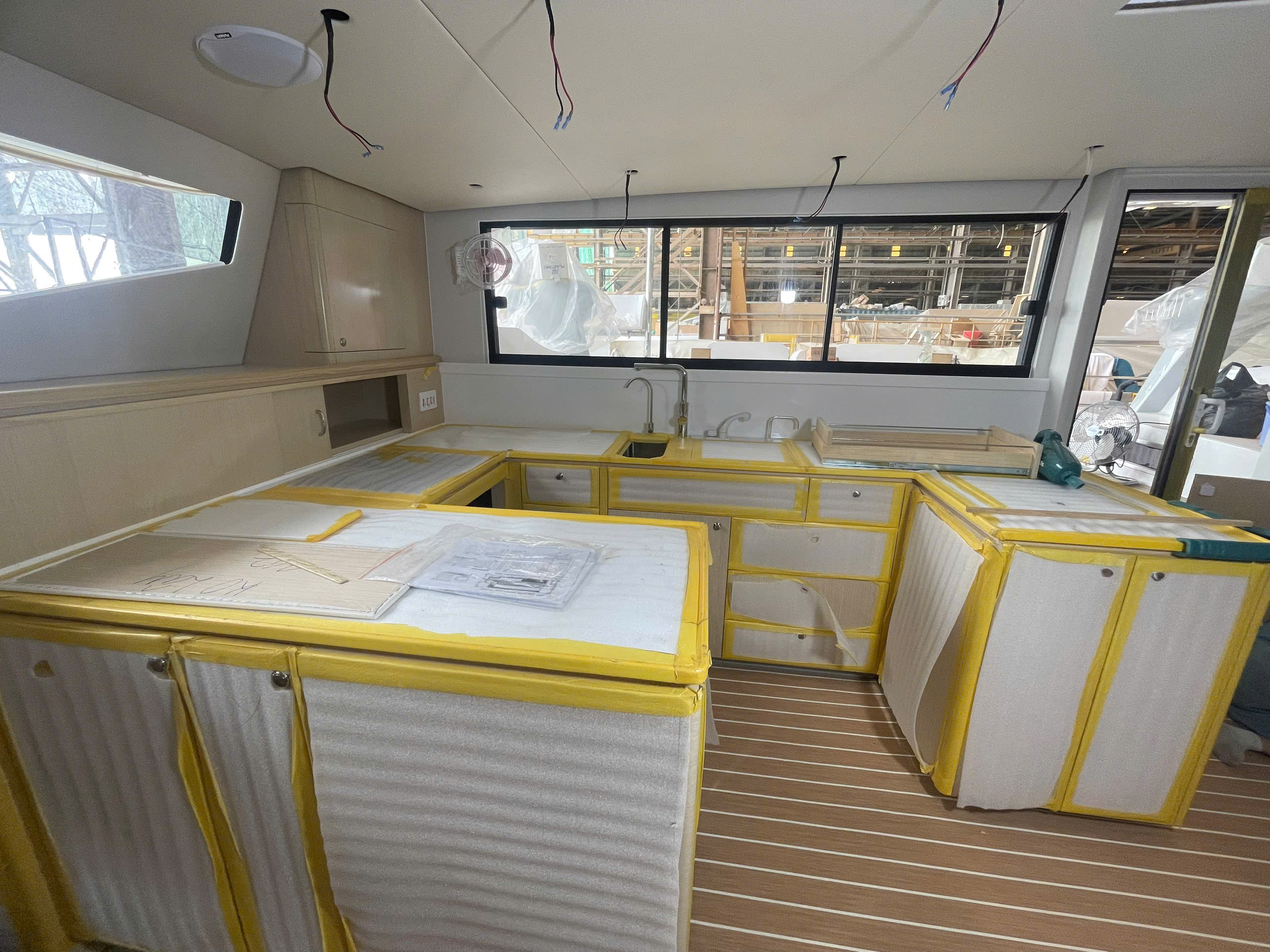

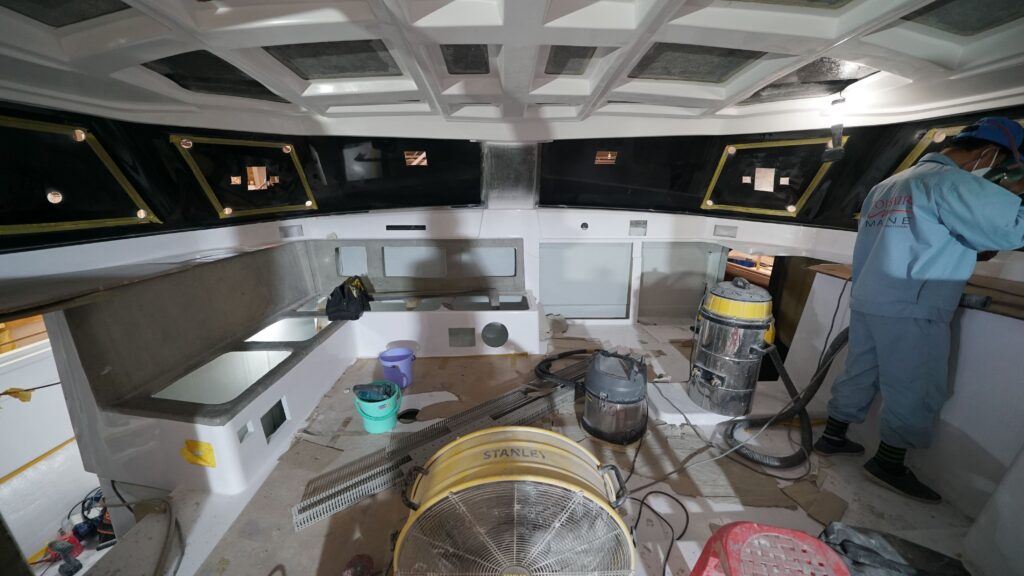

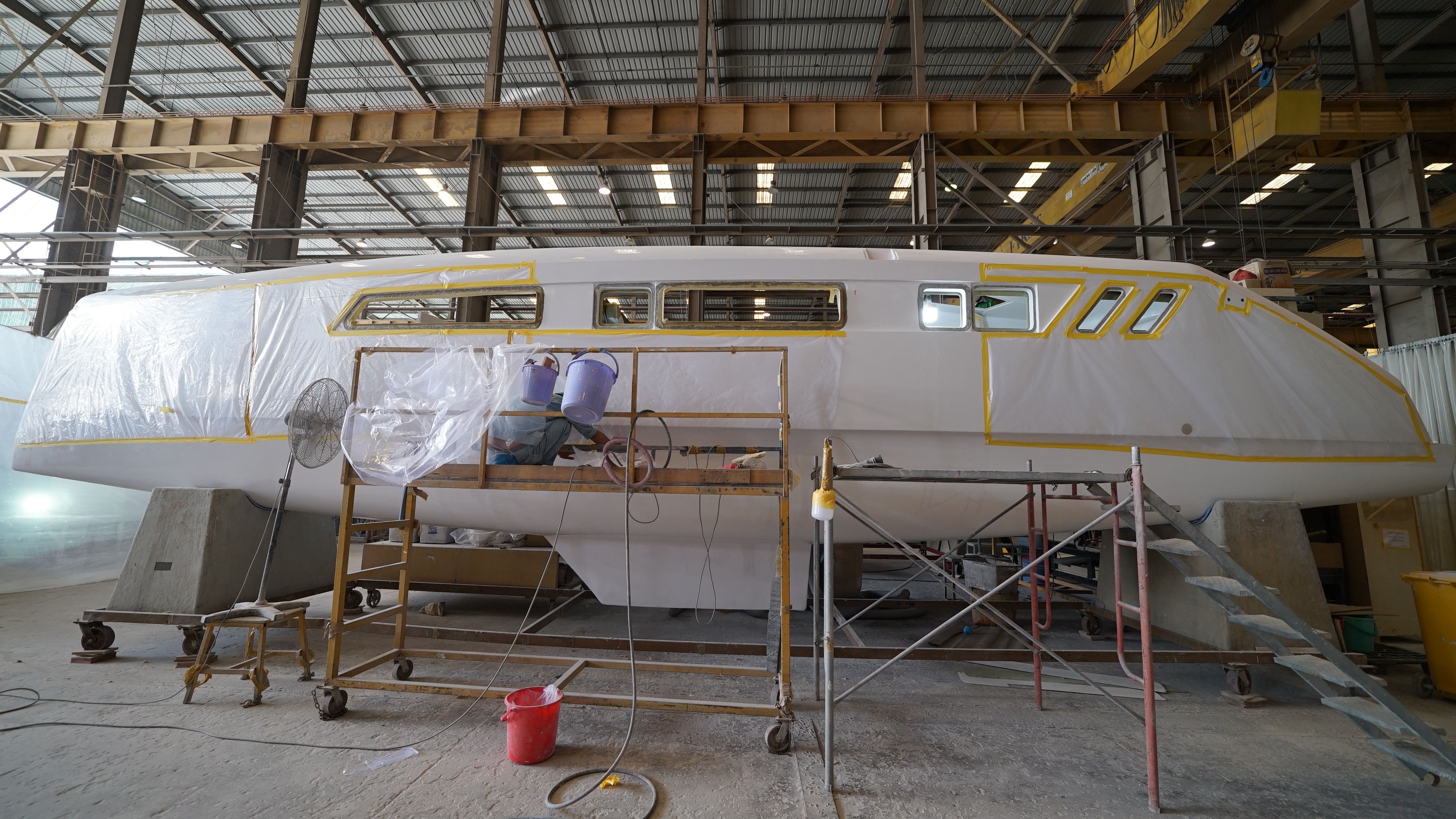

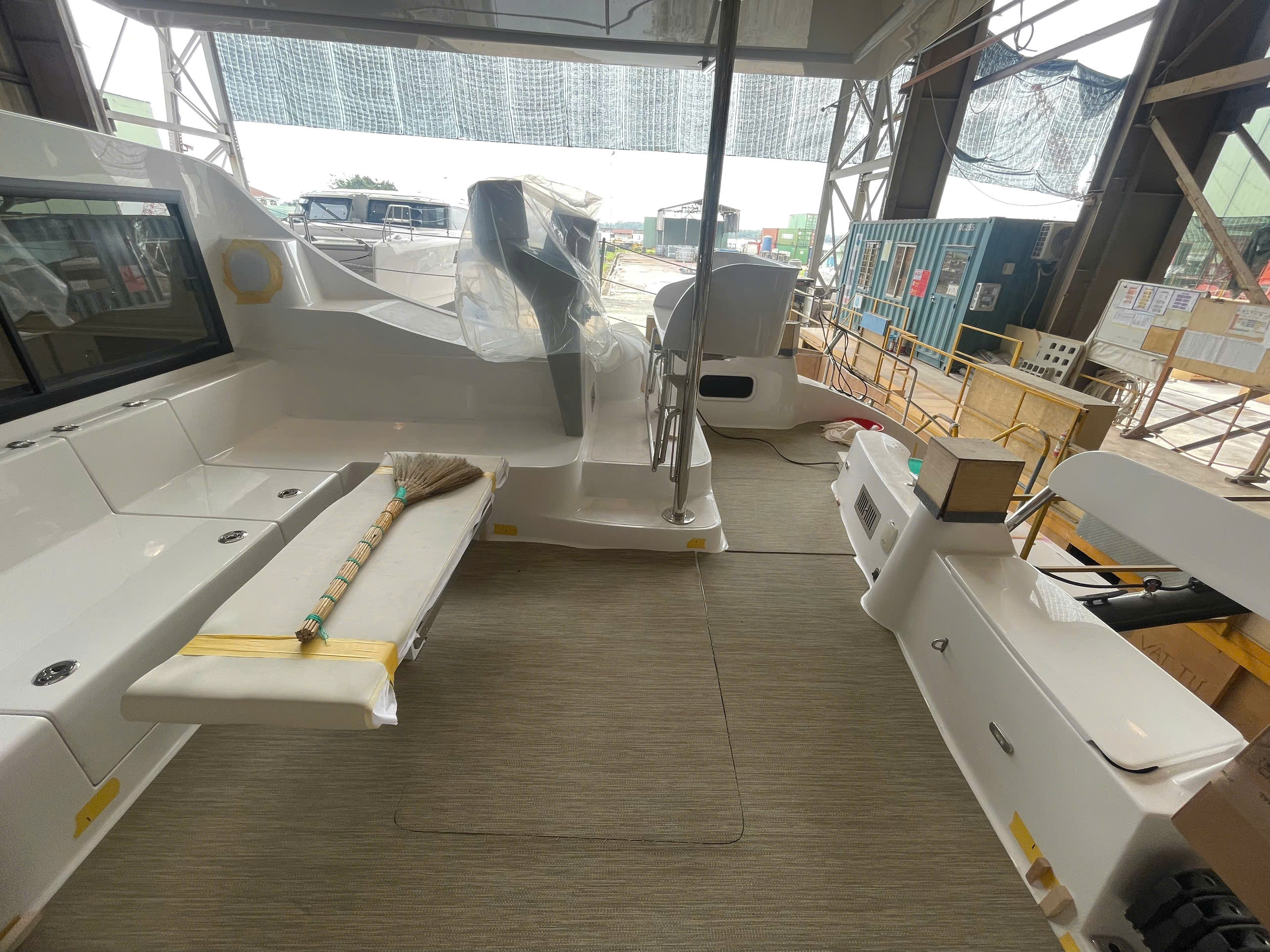

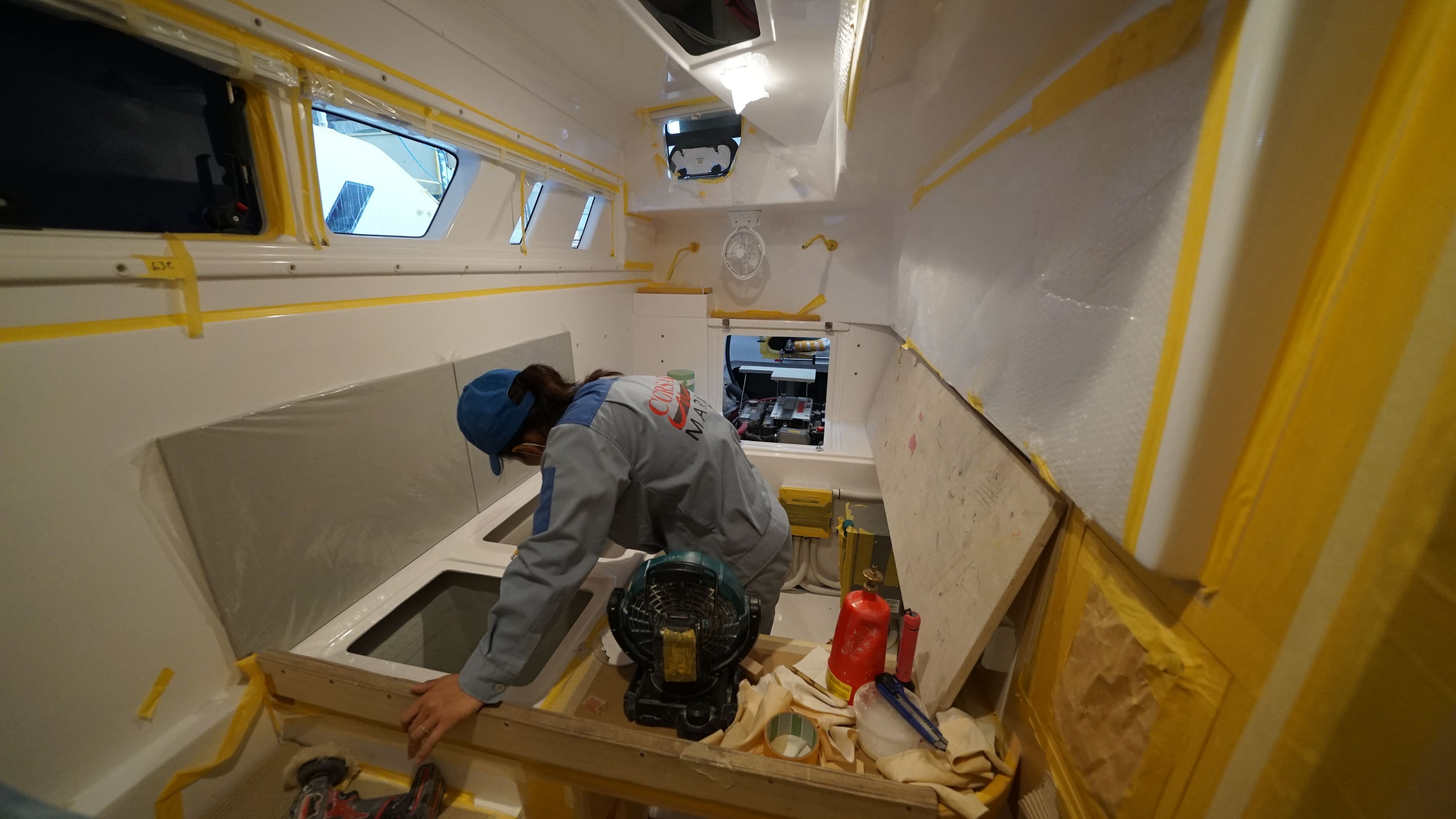

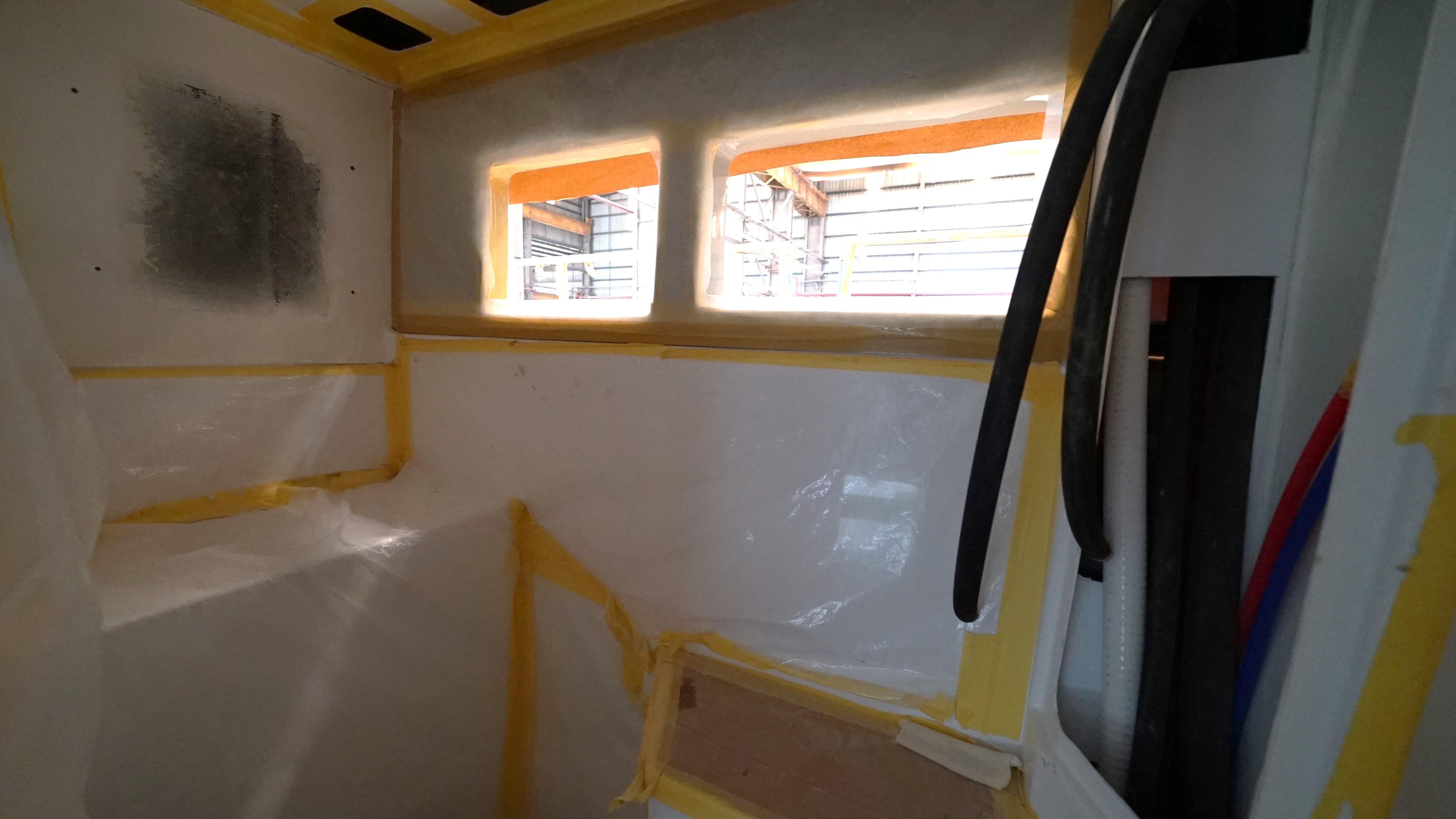

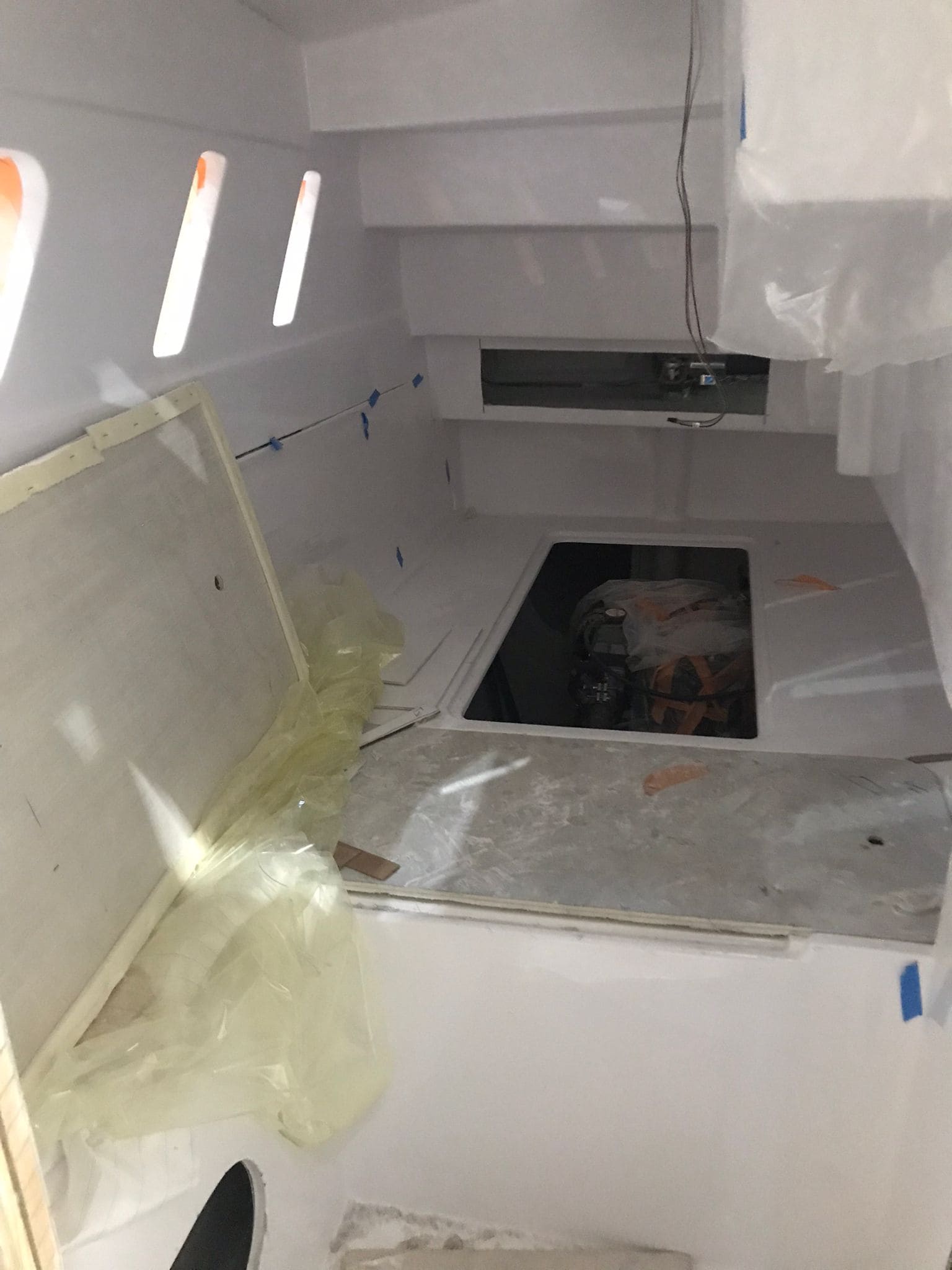

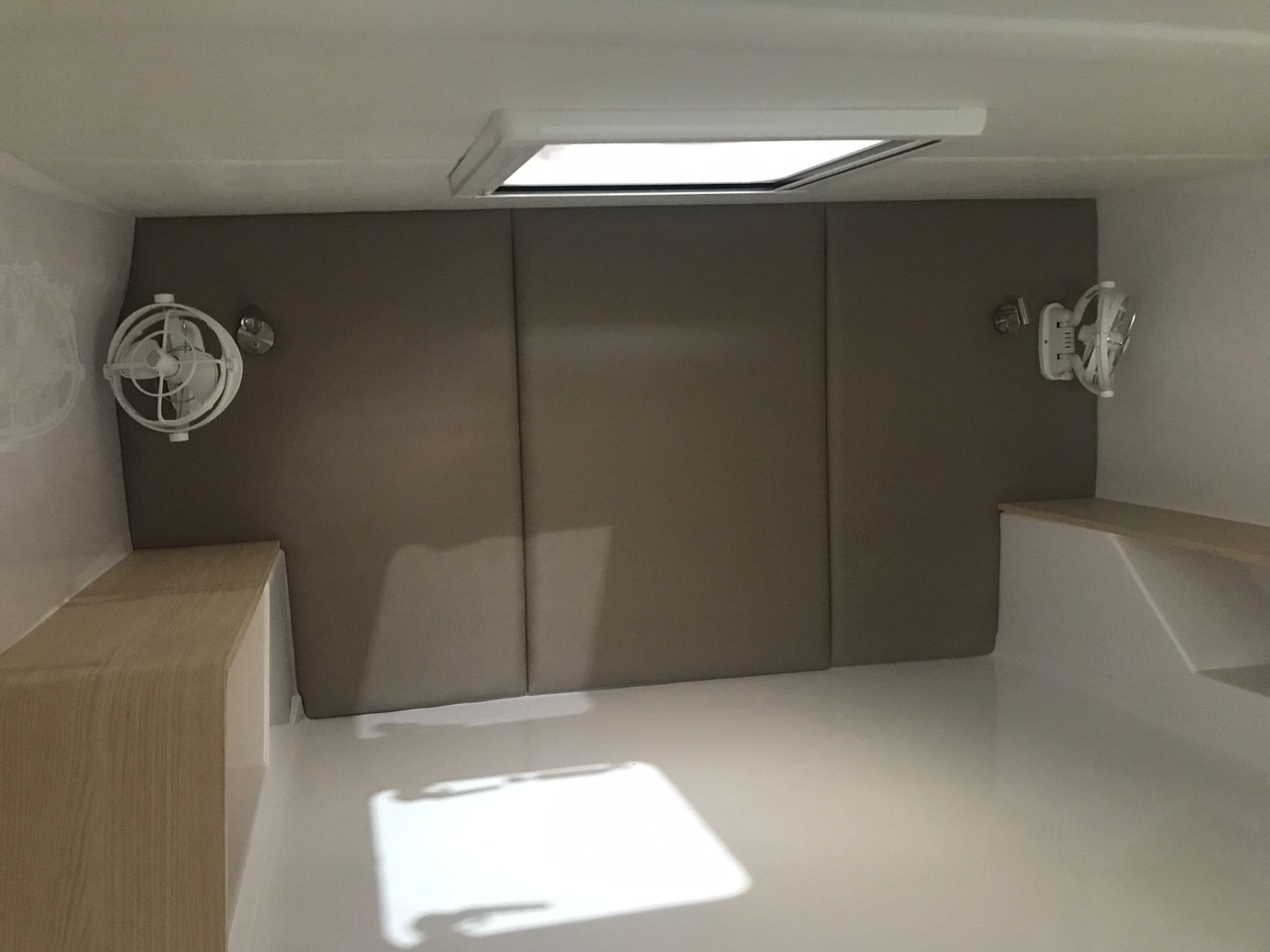

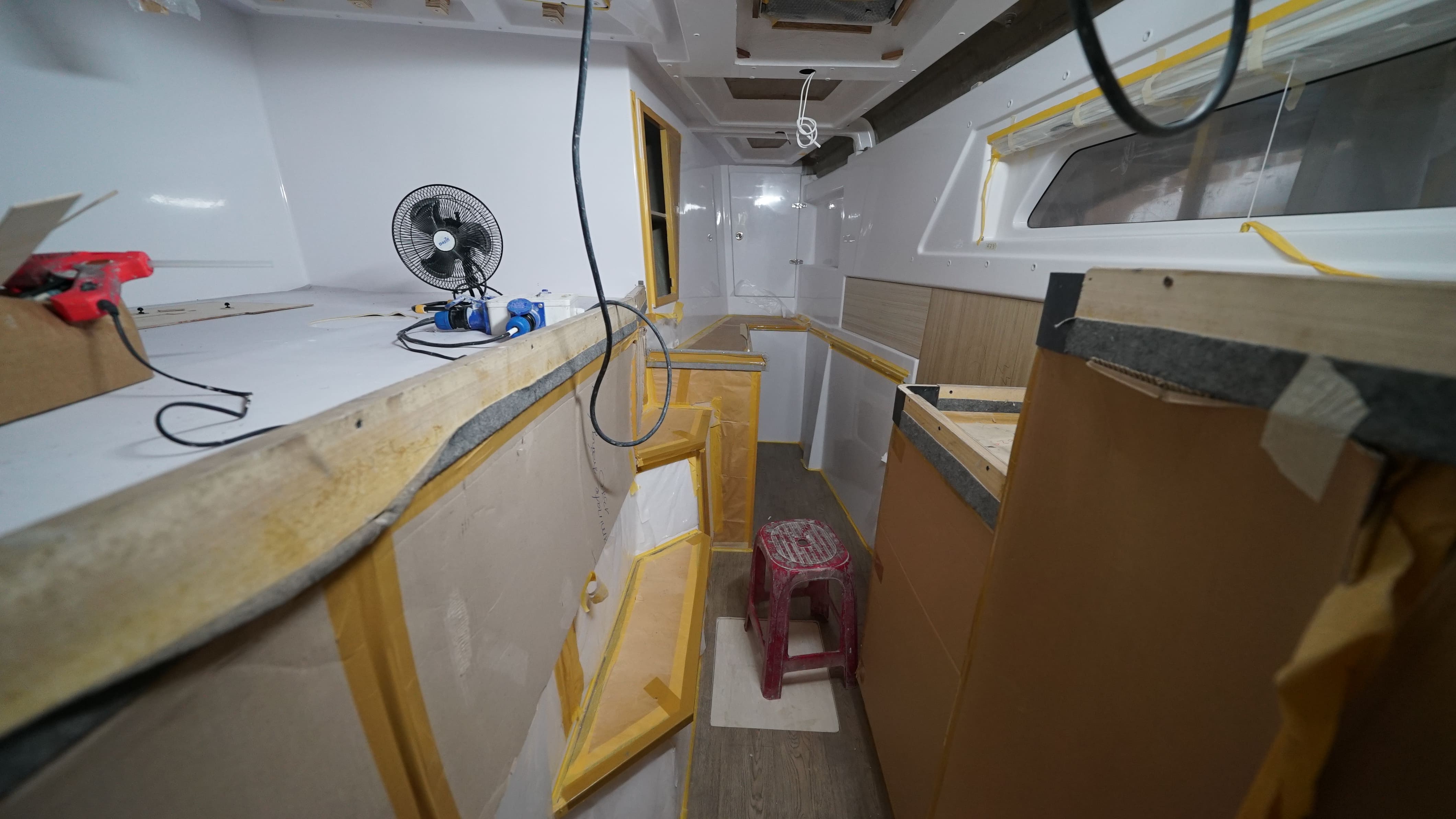

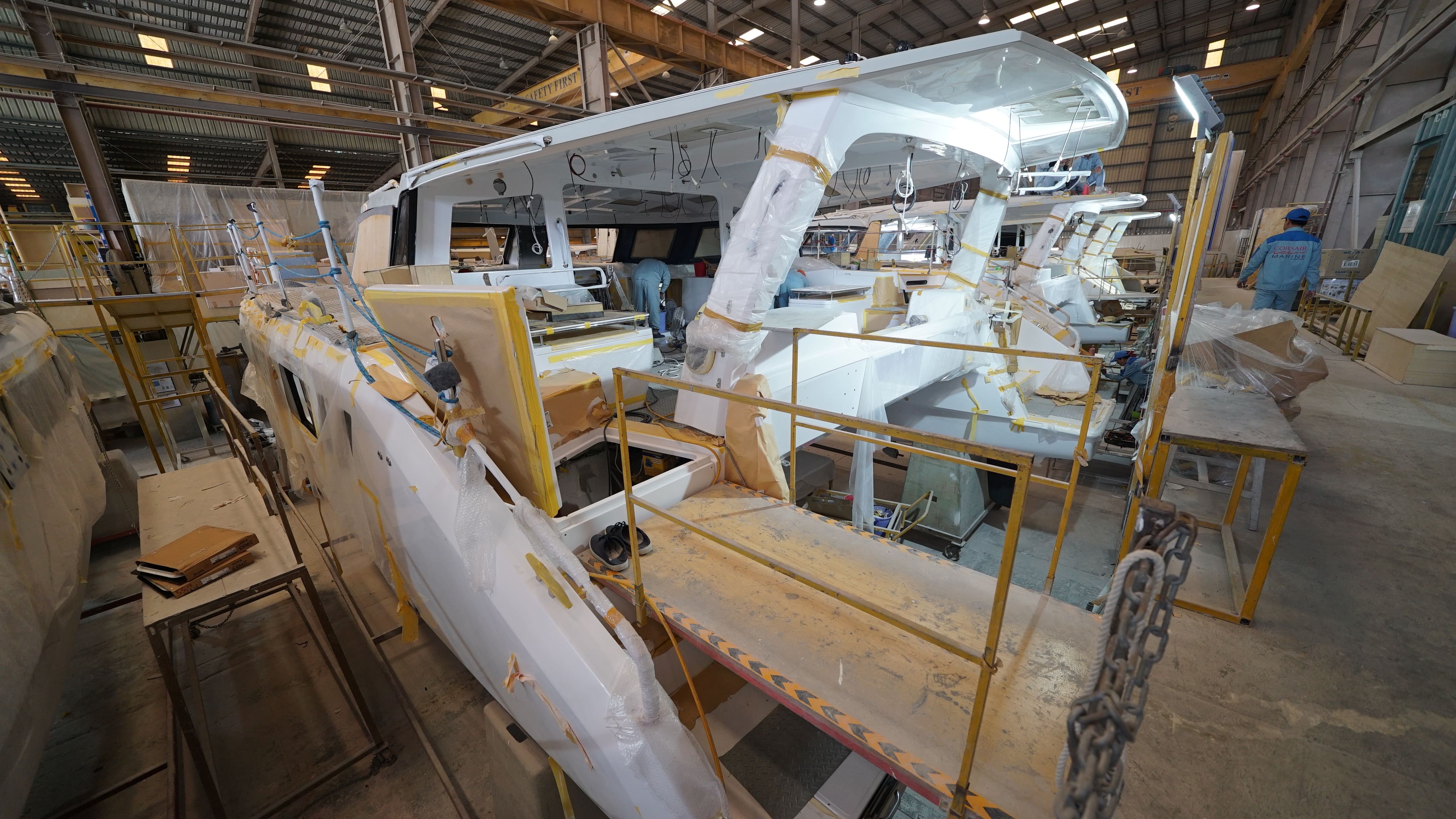

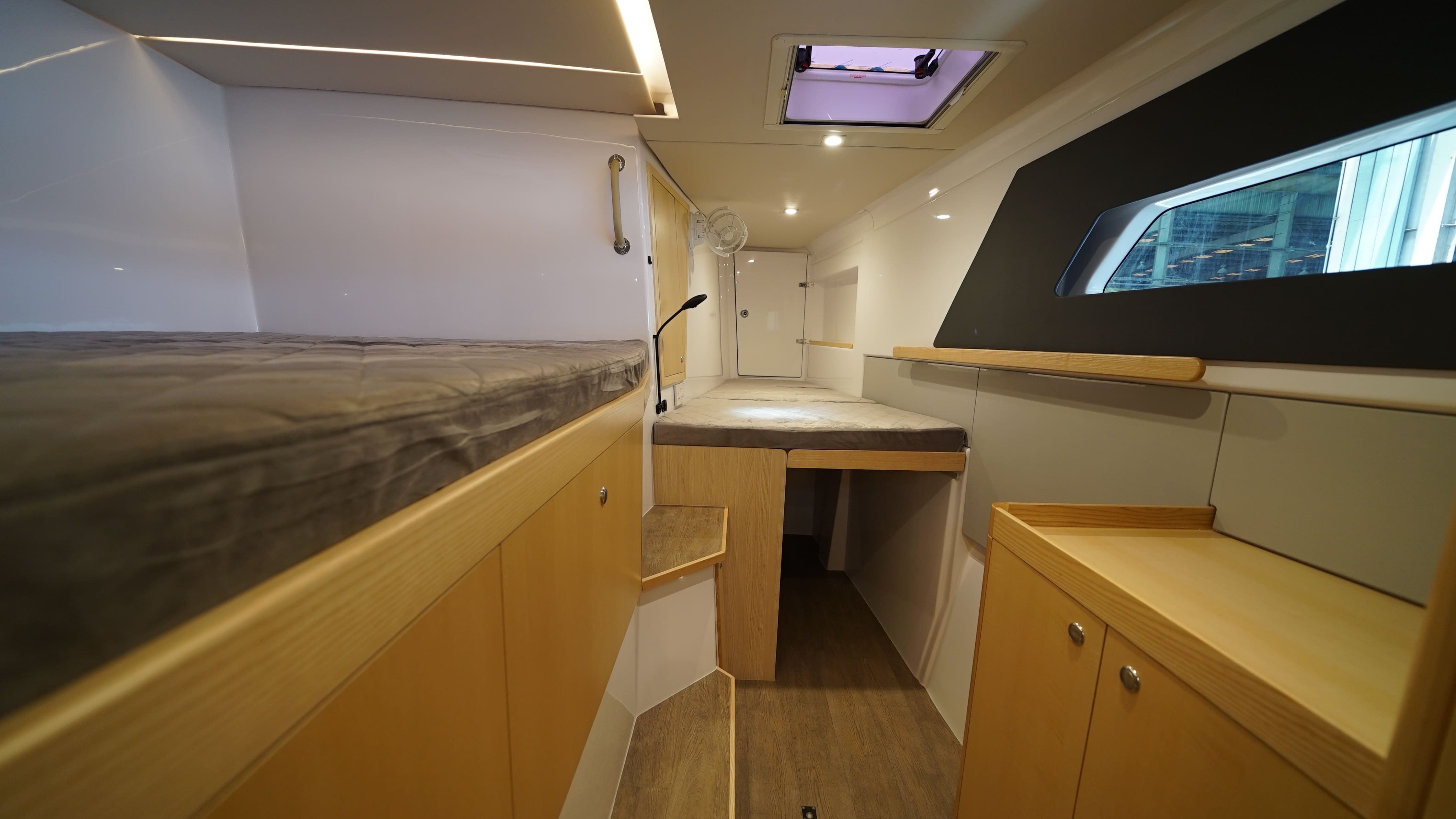

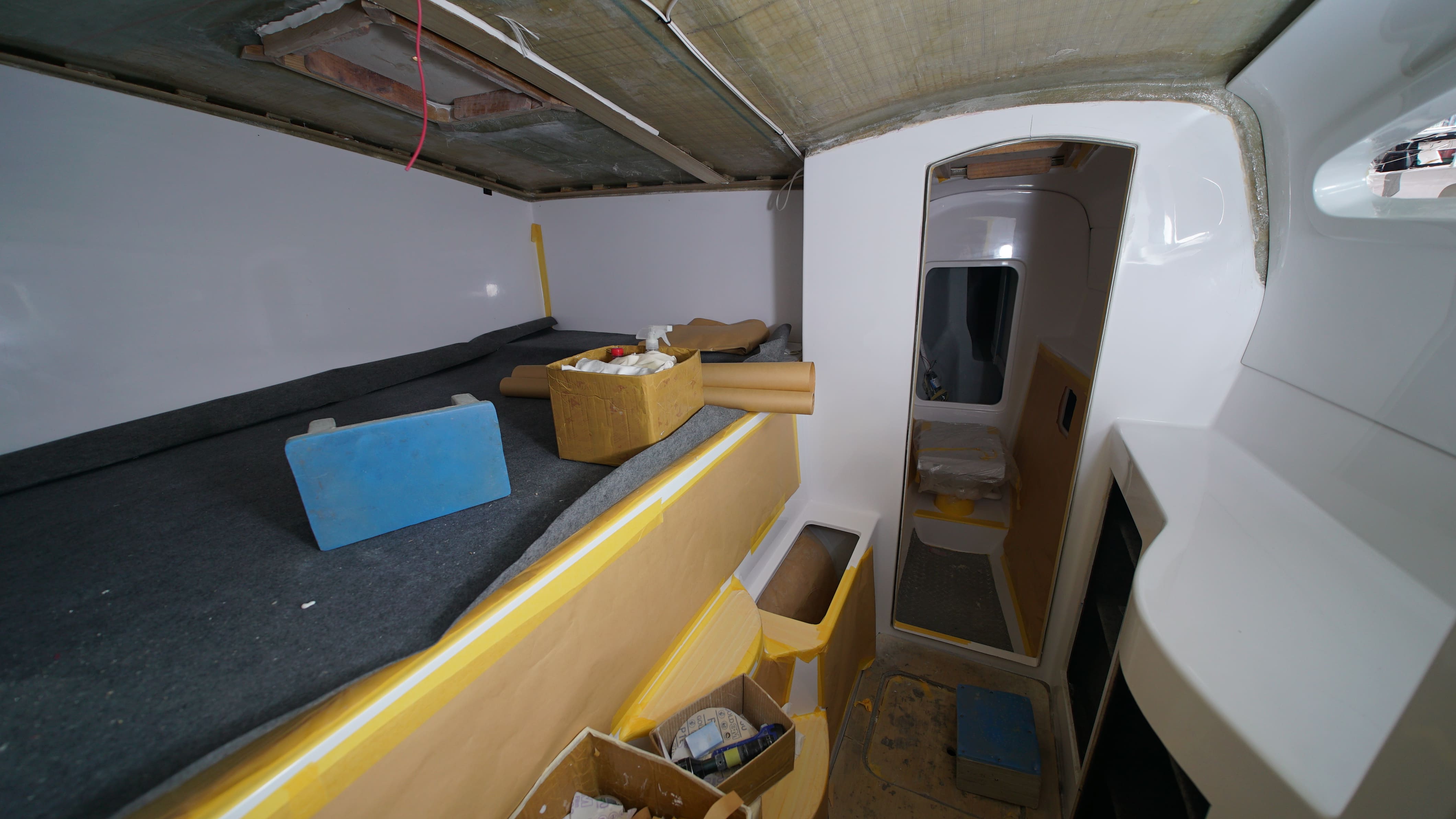

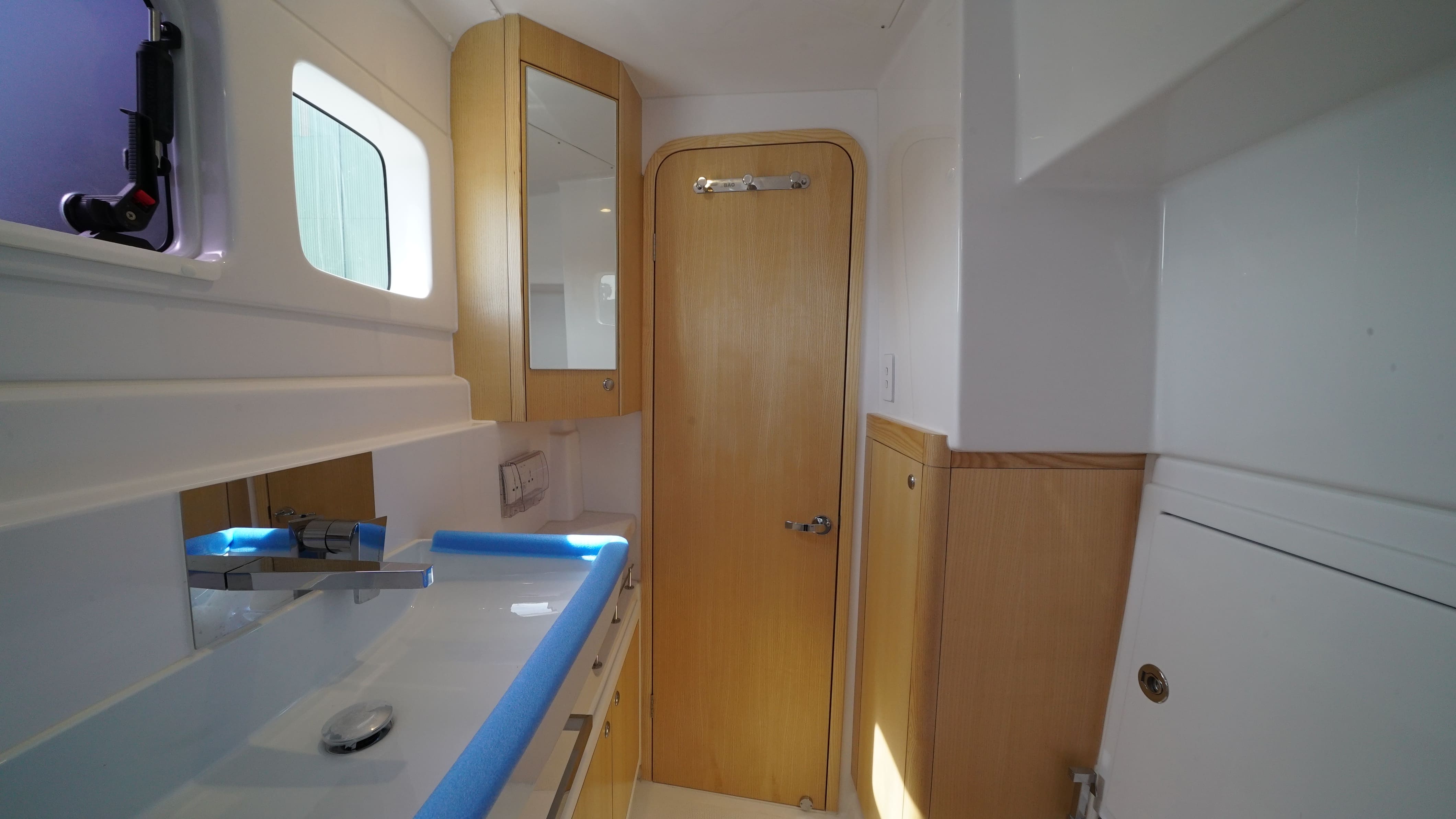

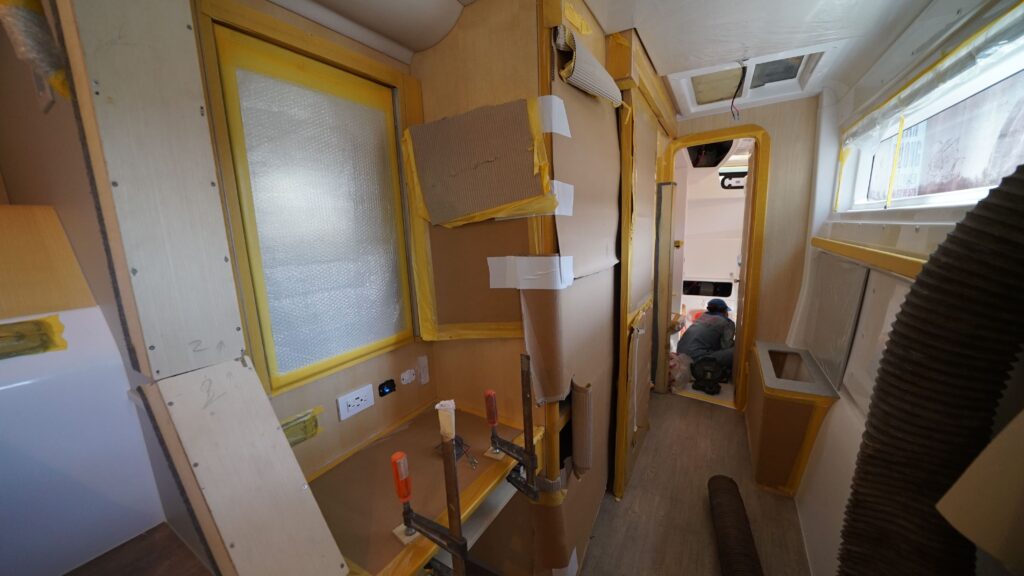

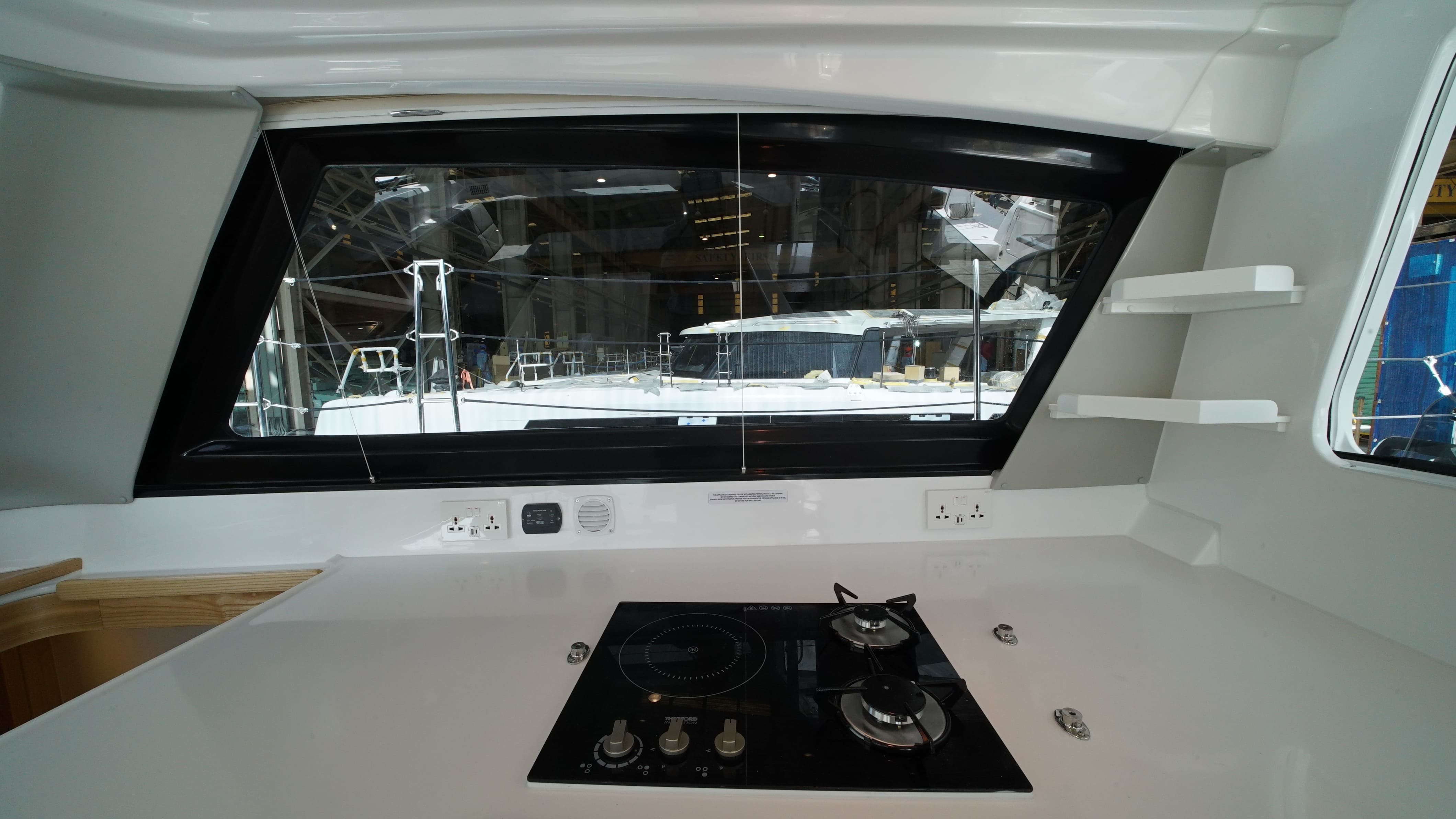

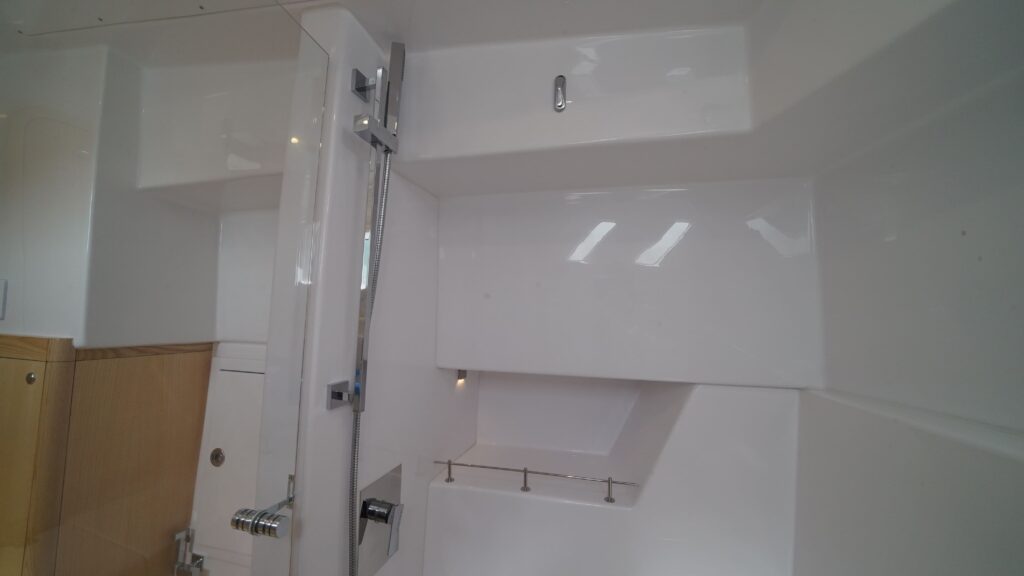

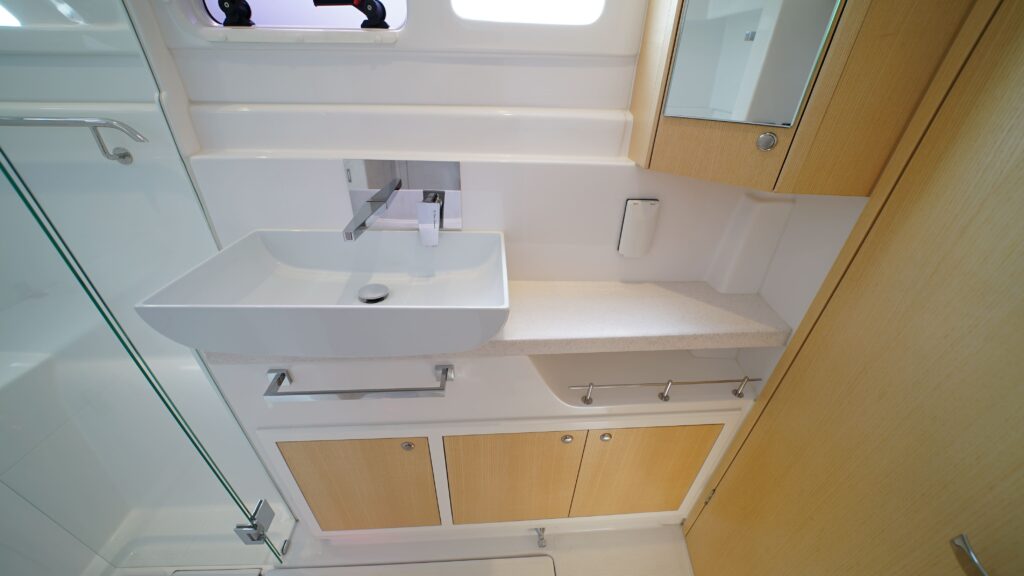

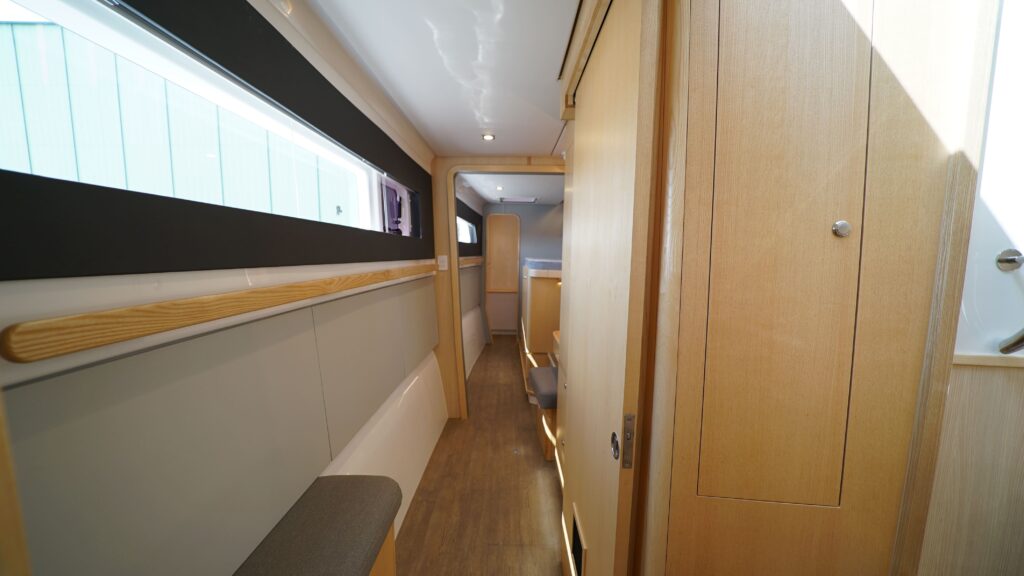

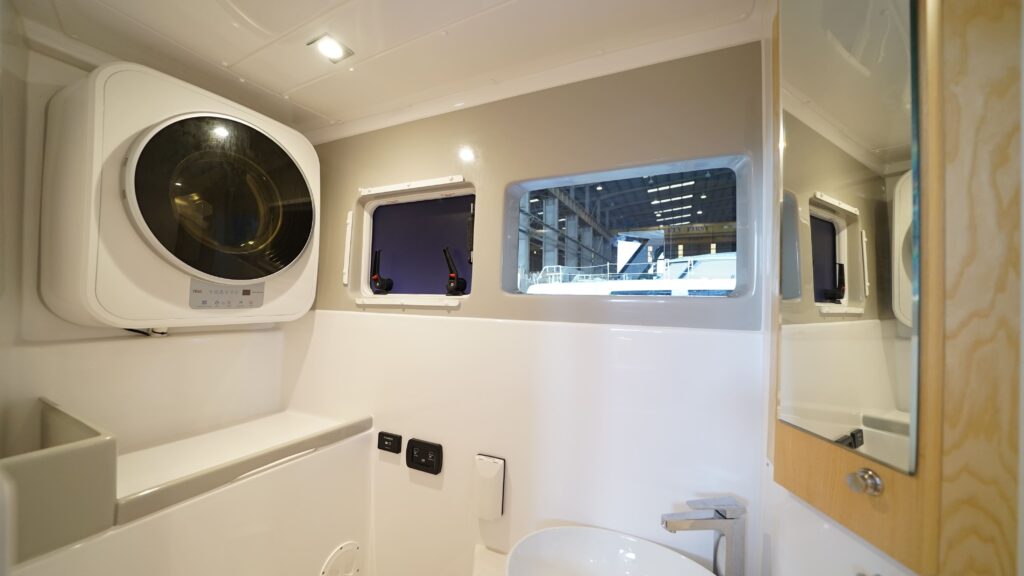

Production Update – Fit out

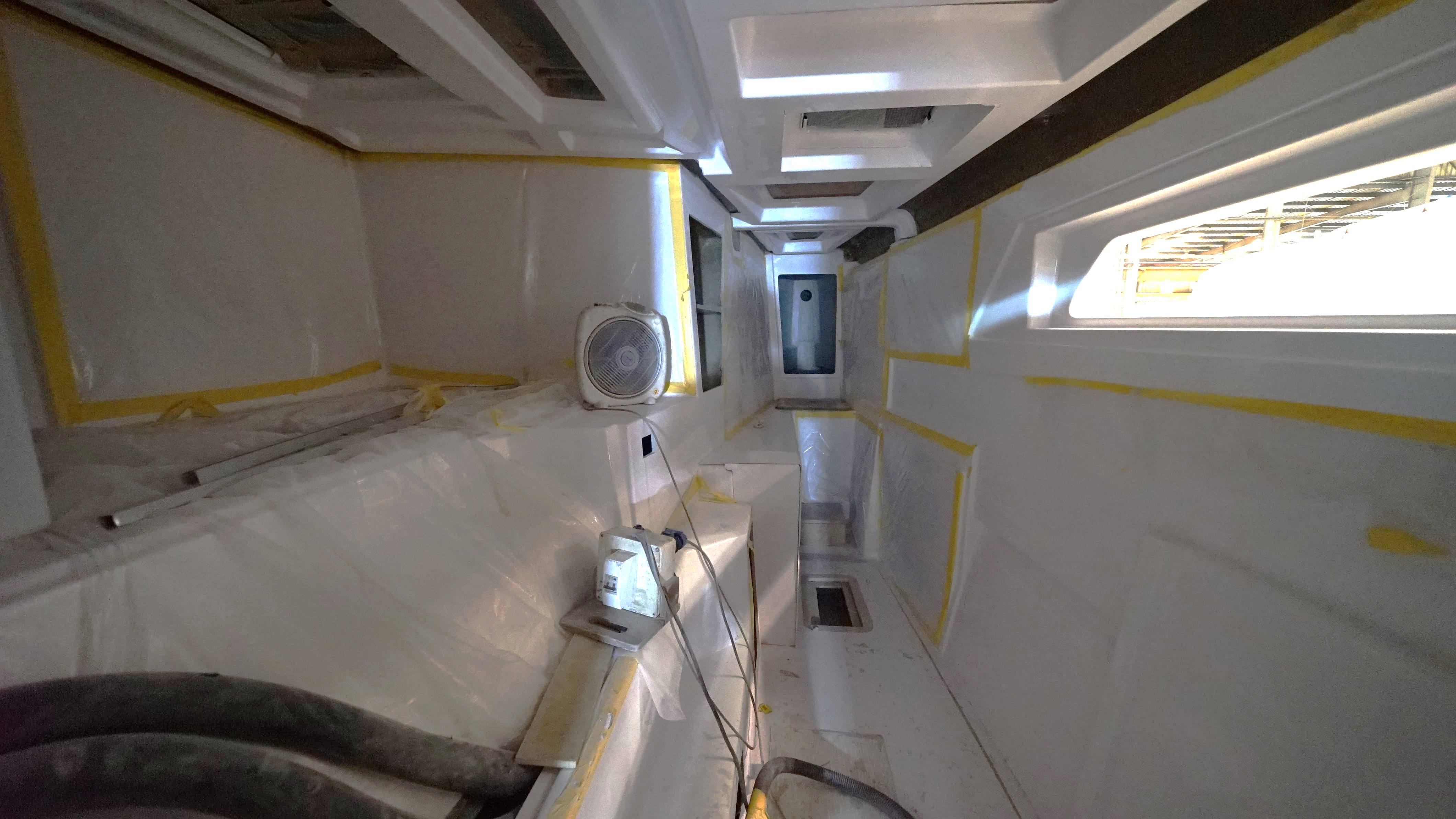

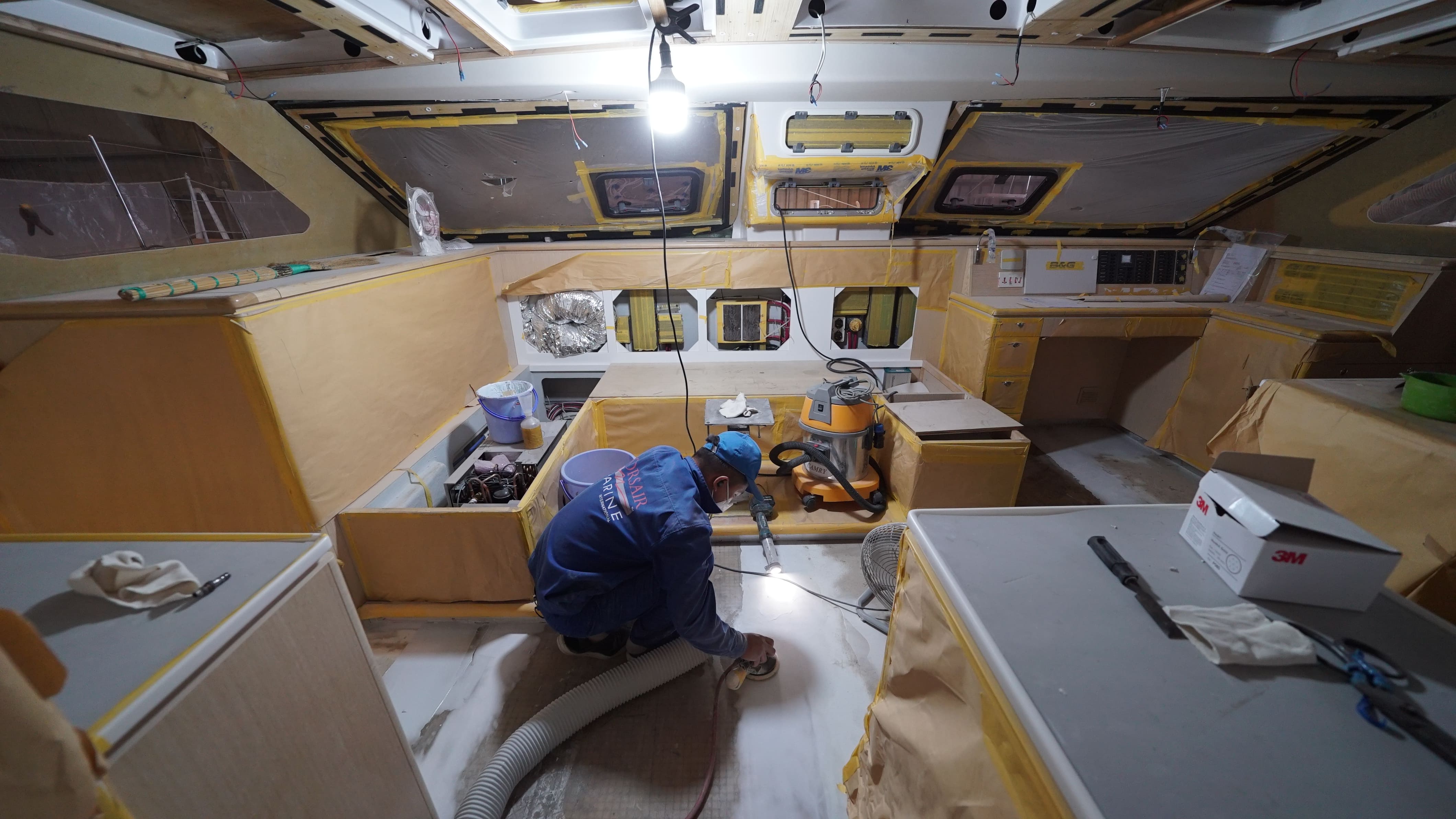

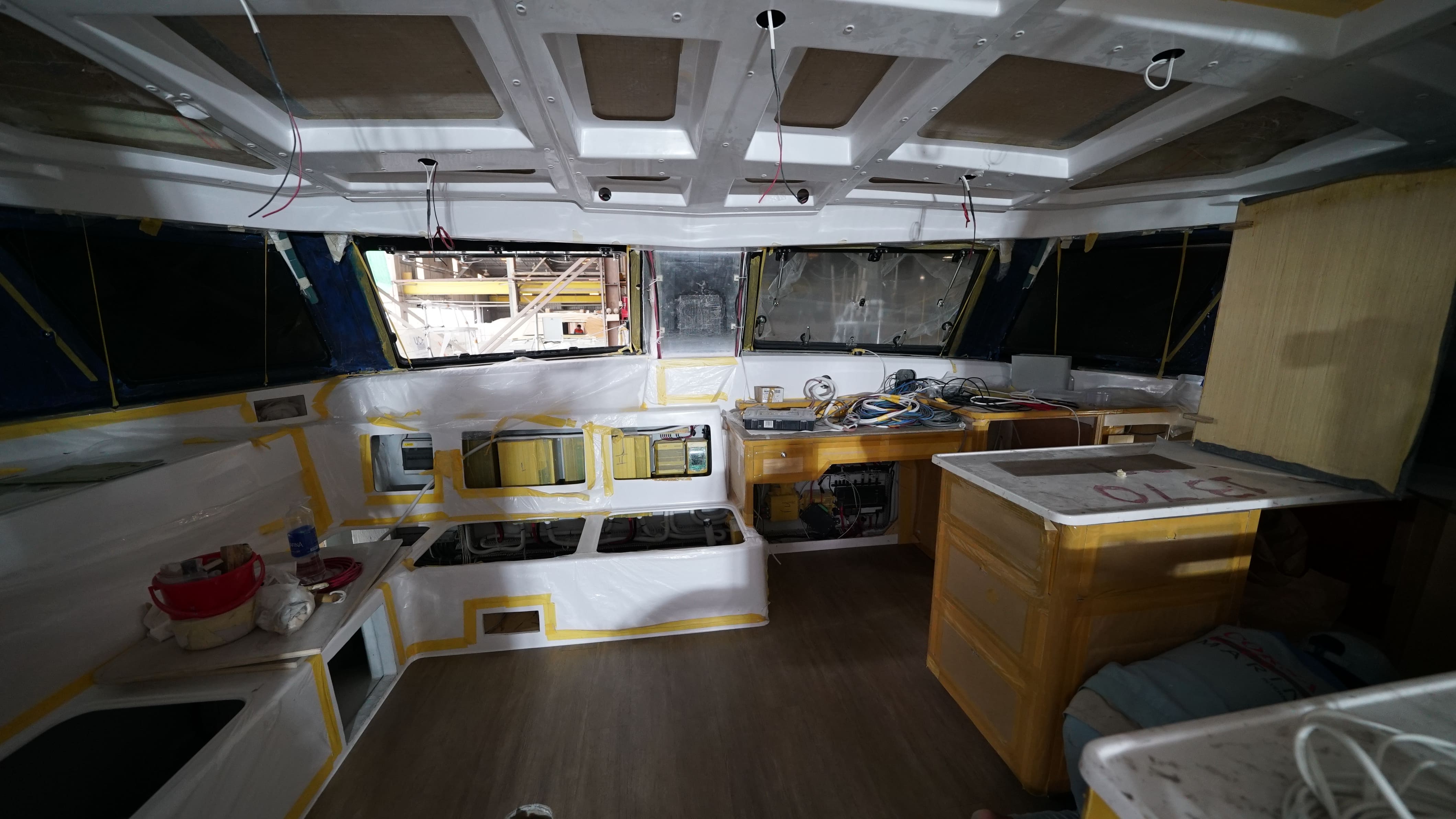

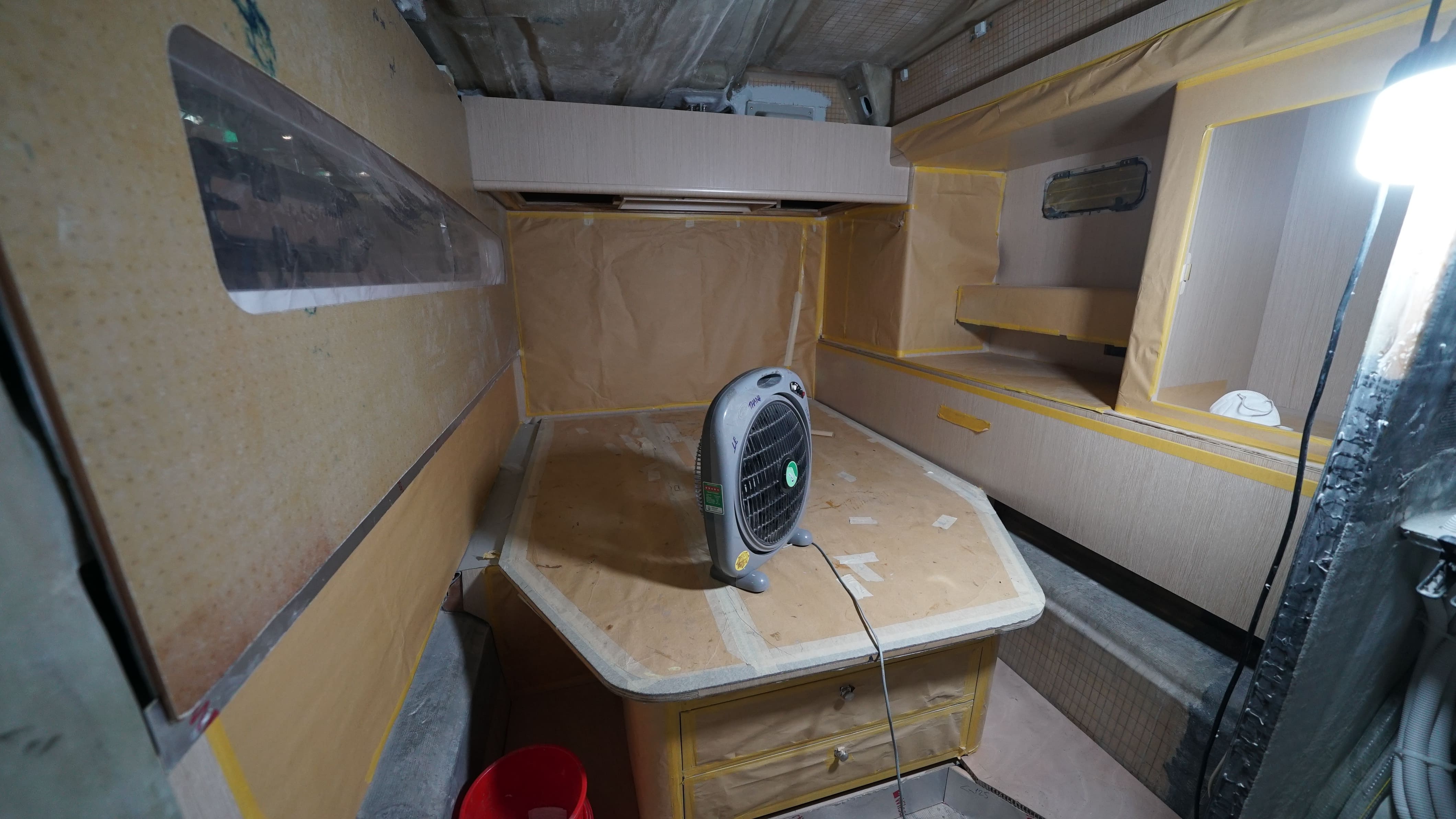

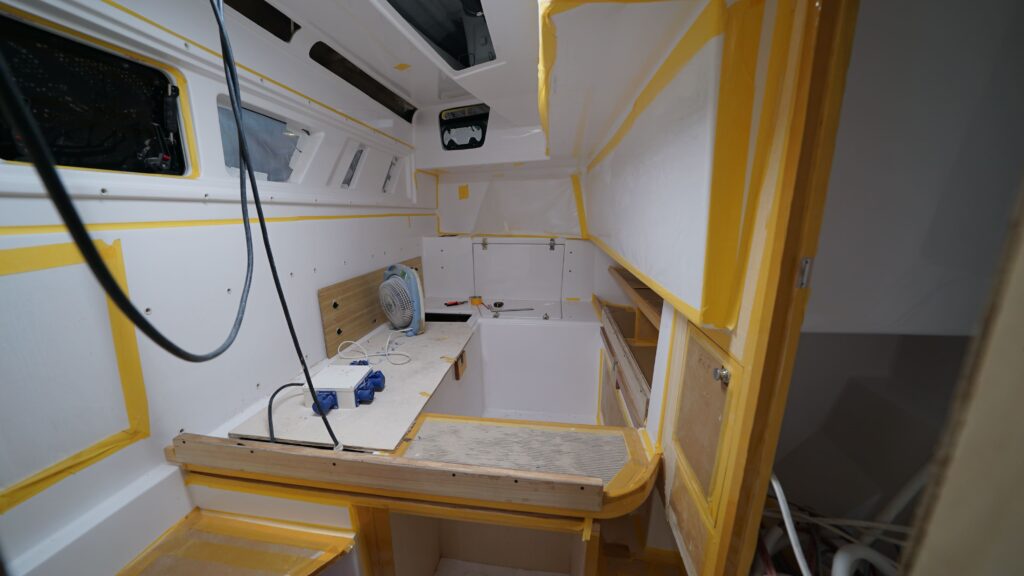

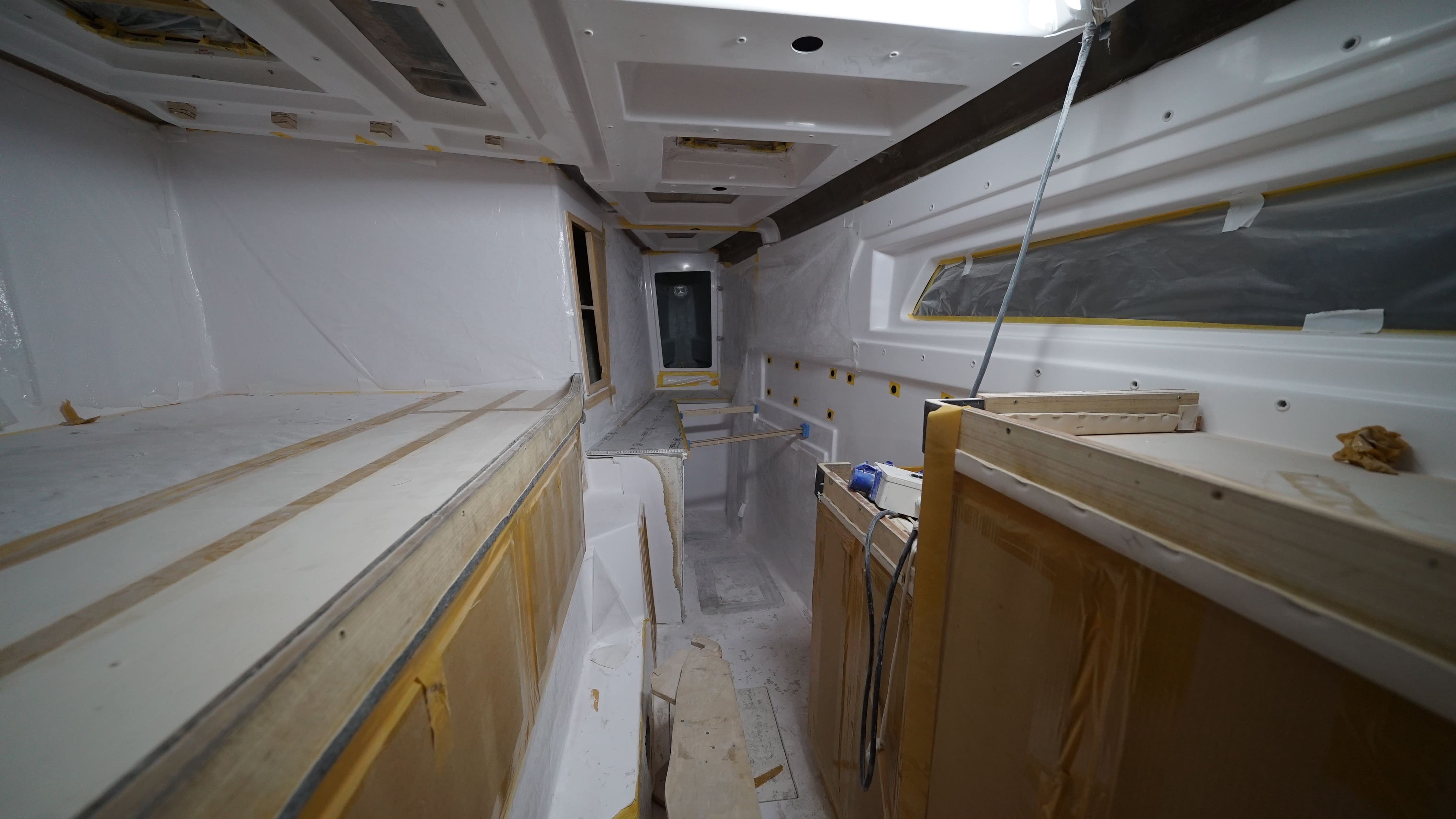

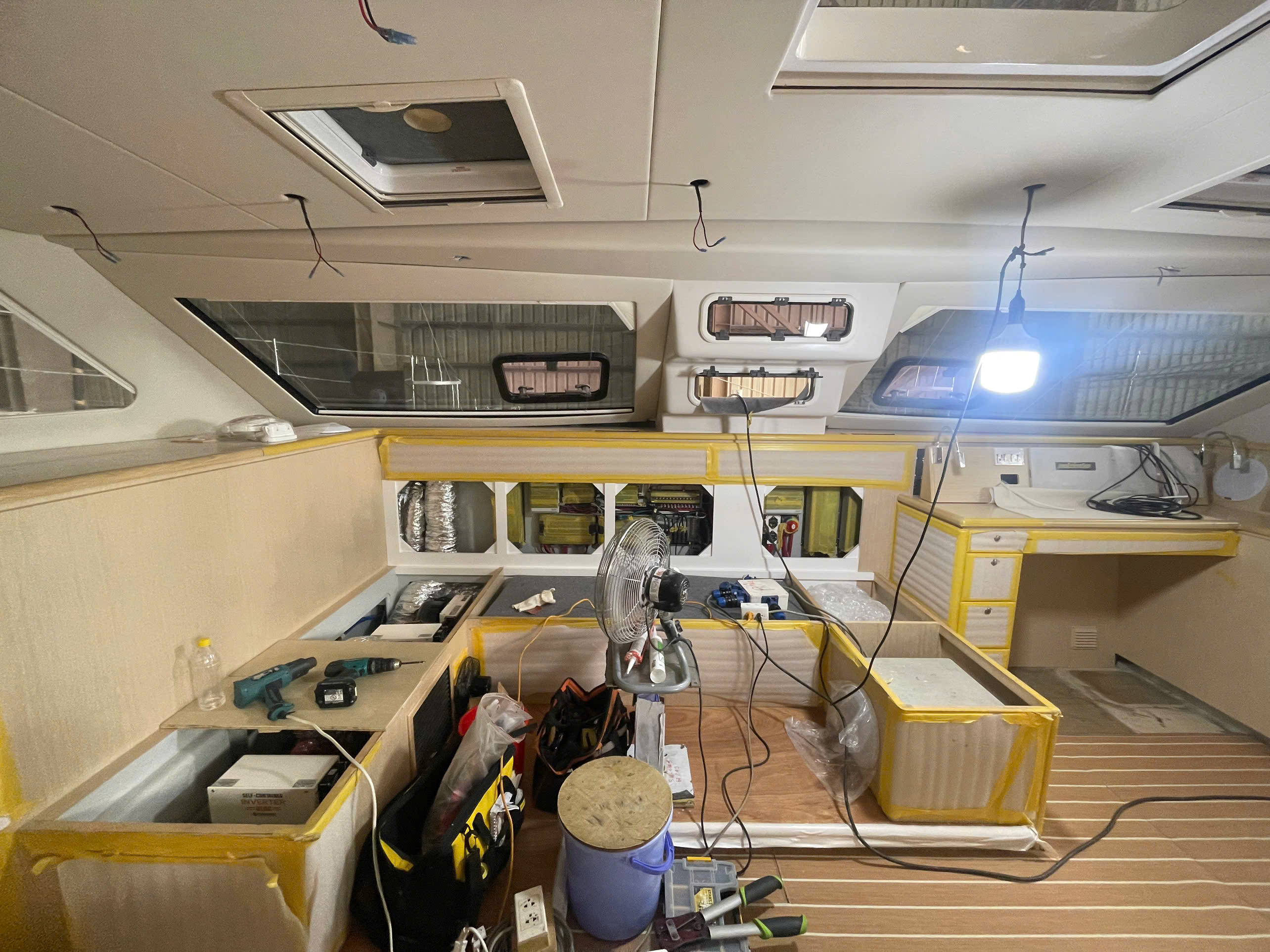

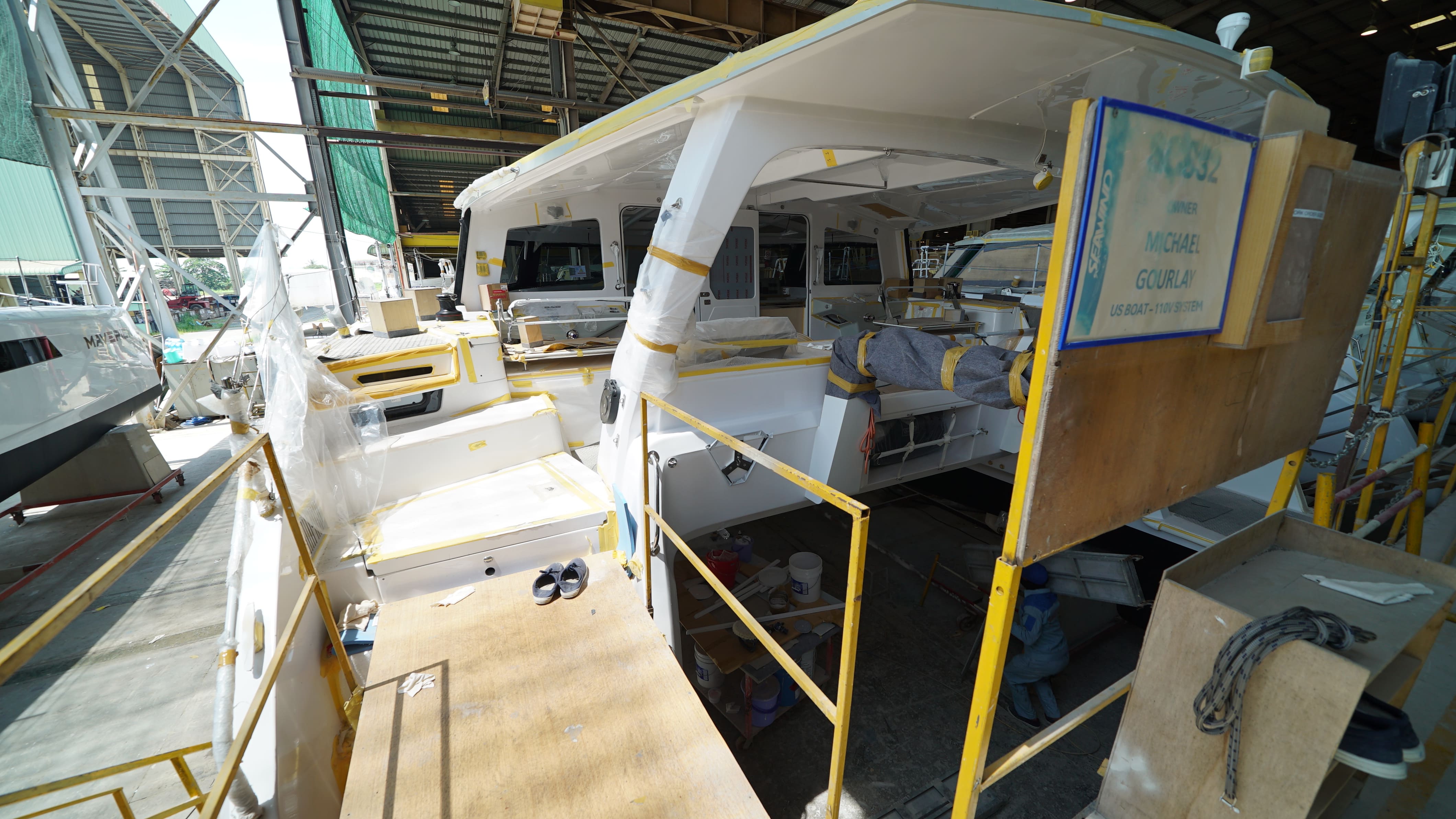

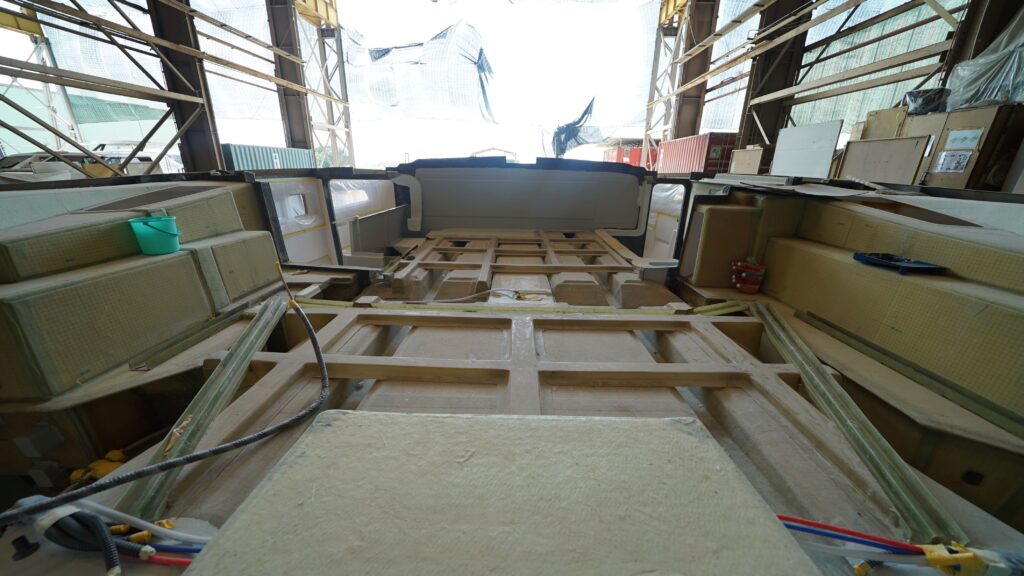

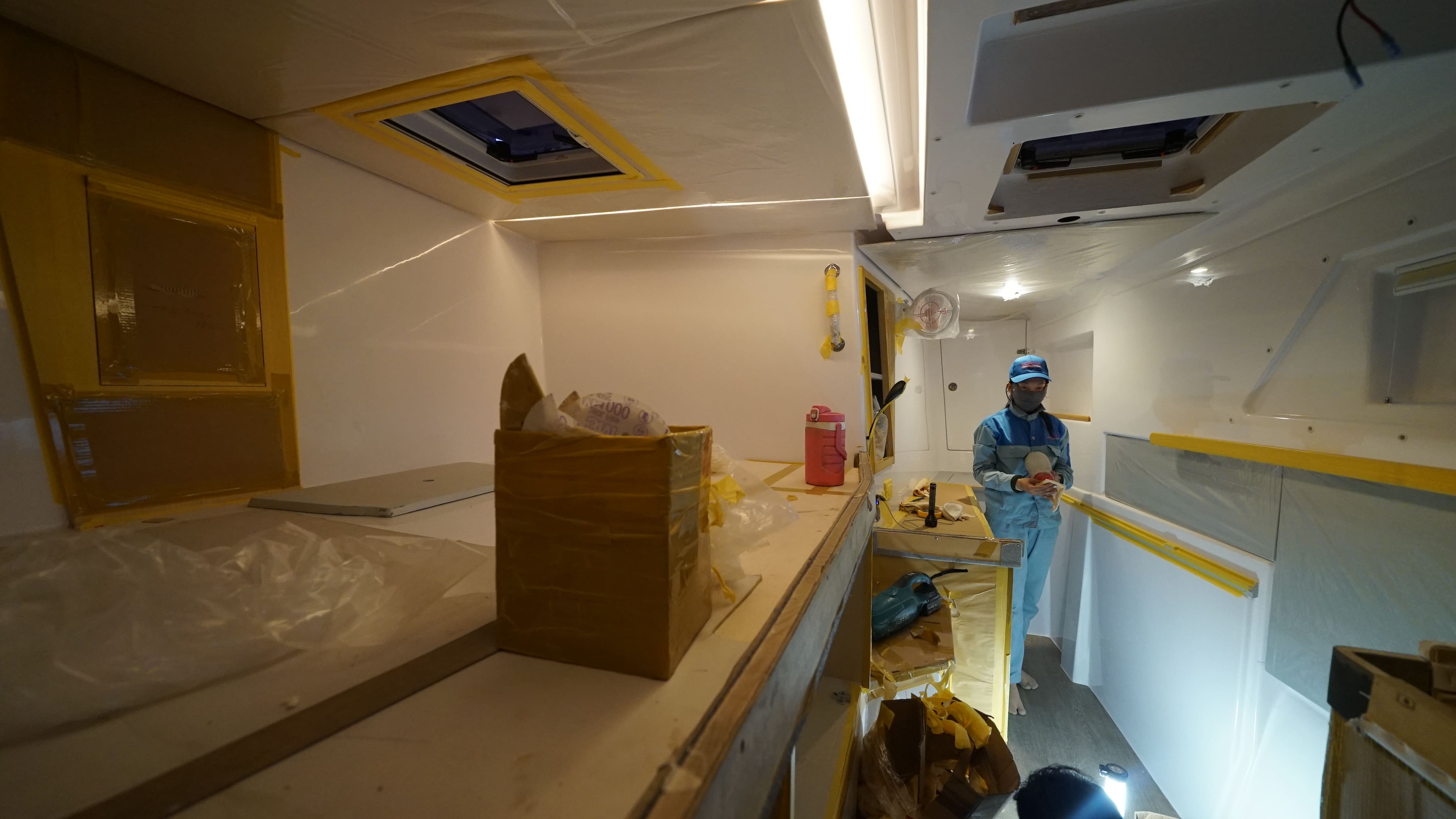

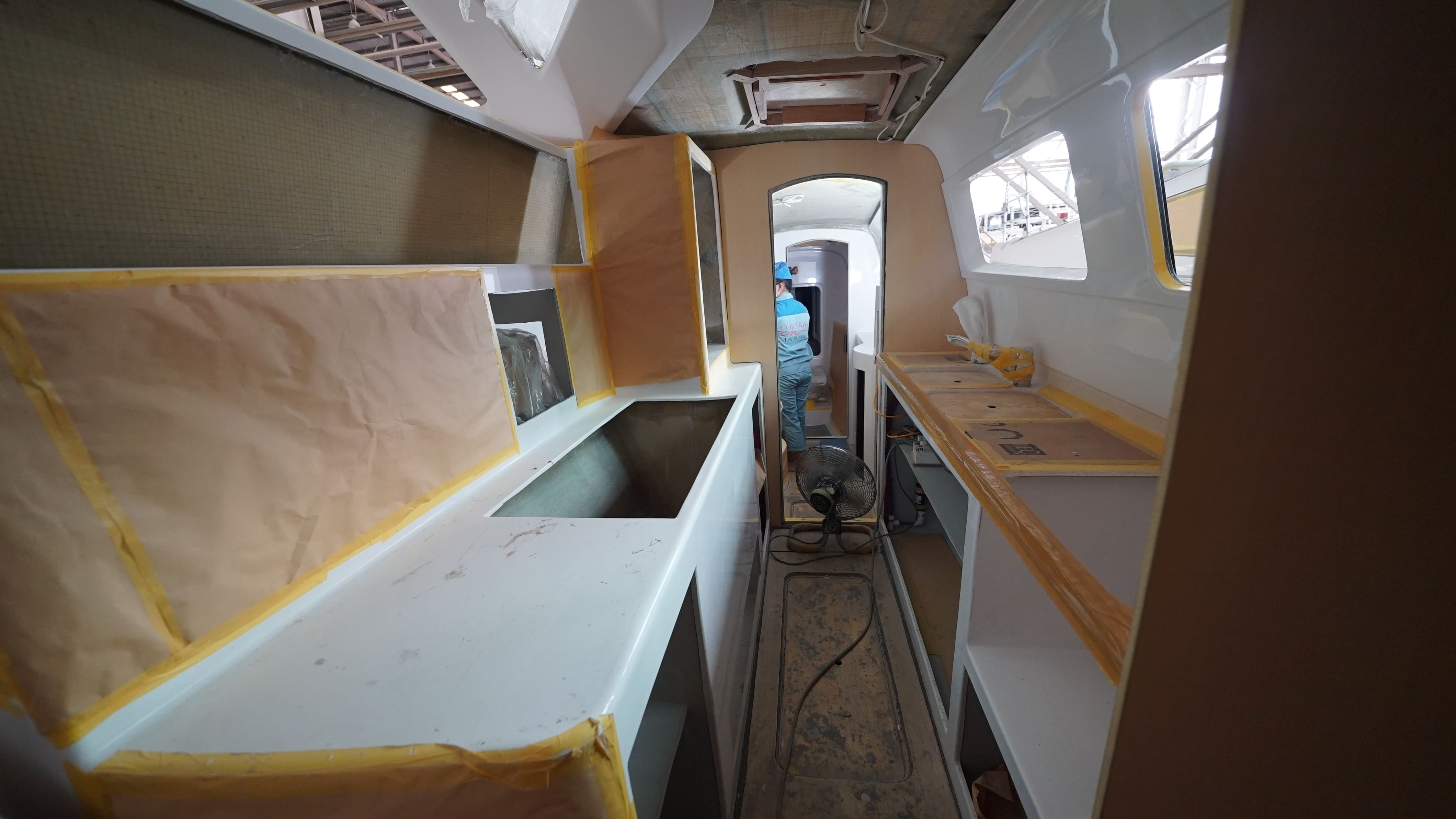

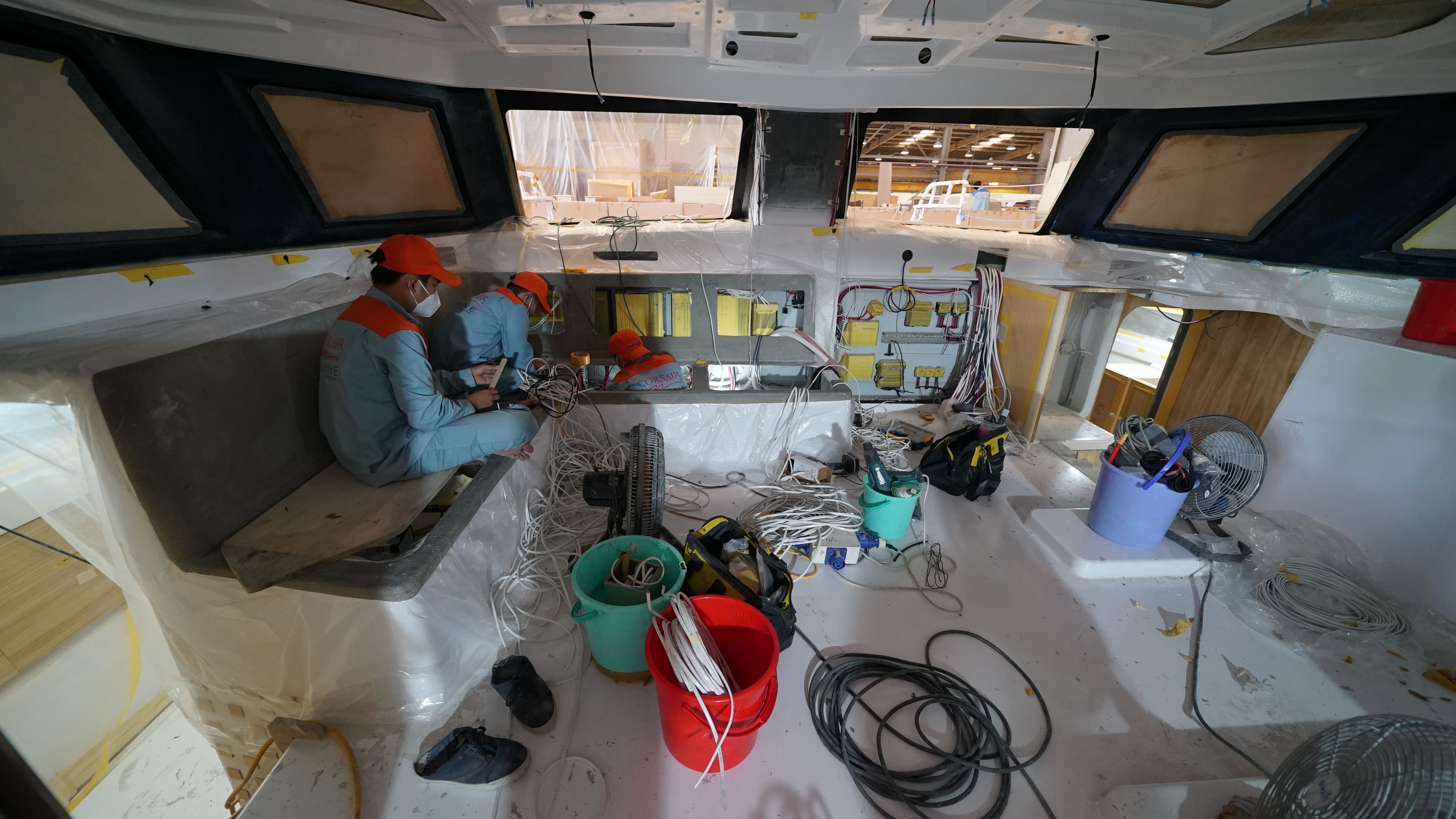

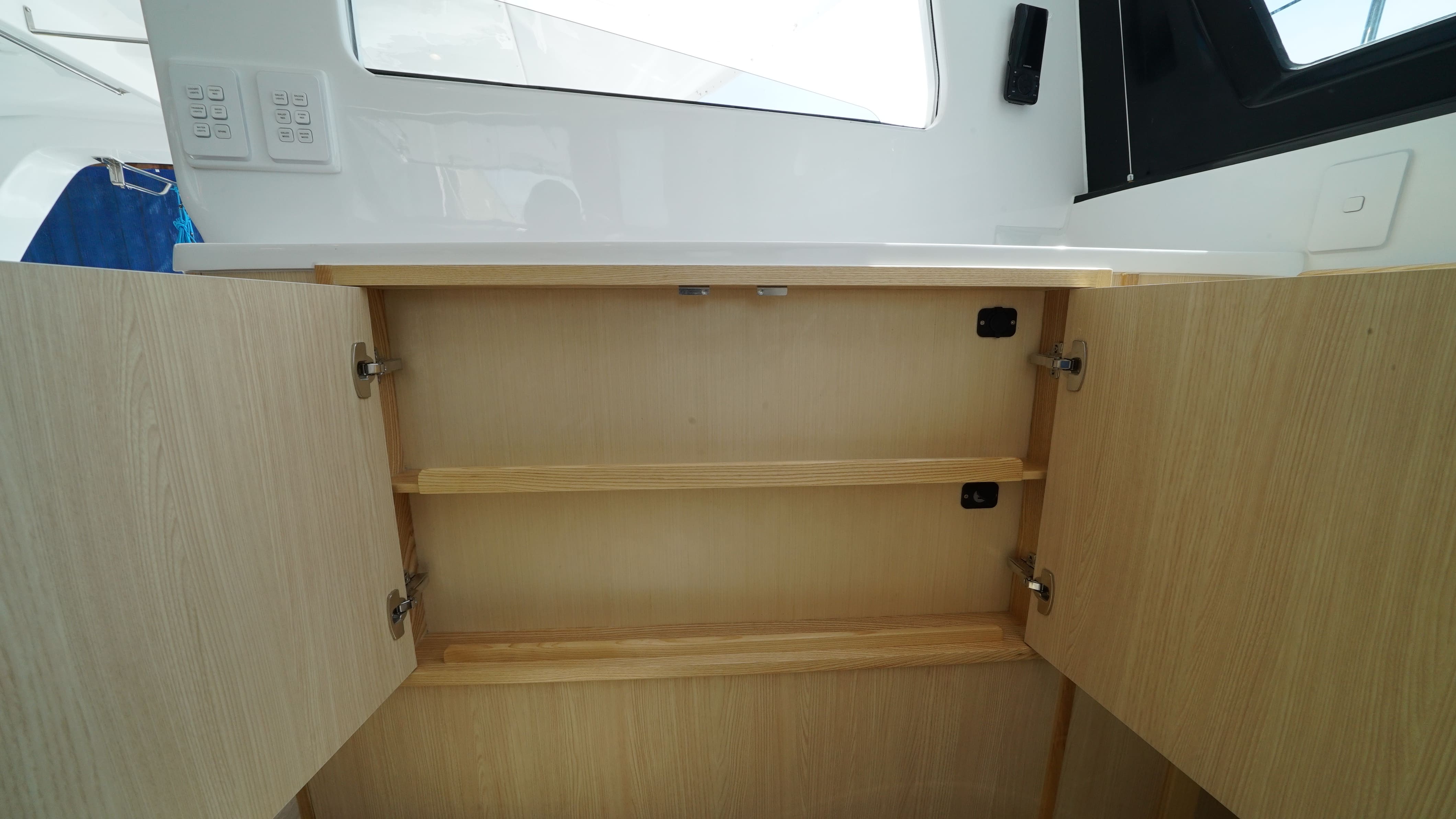

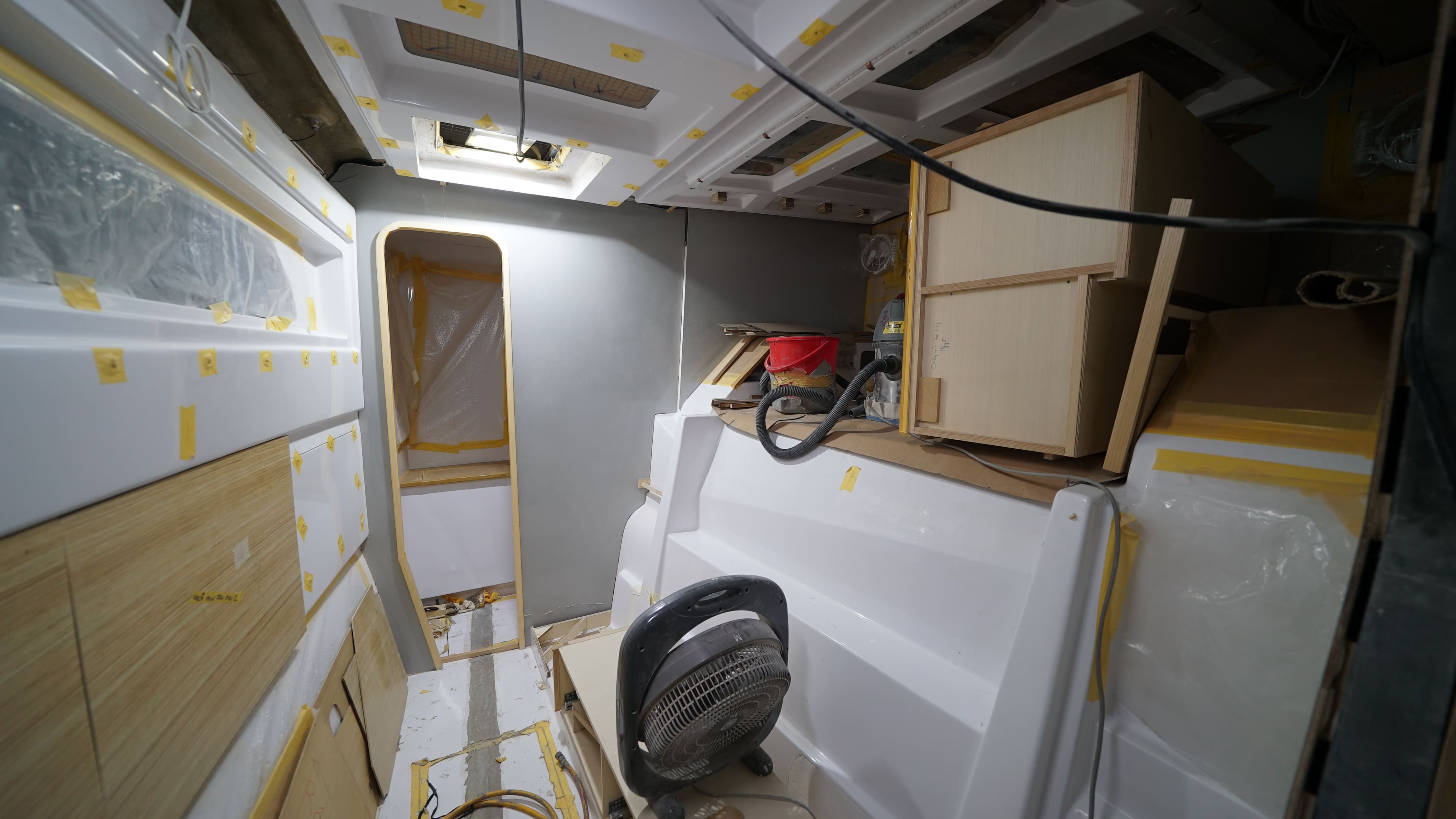

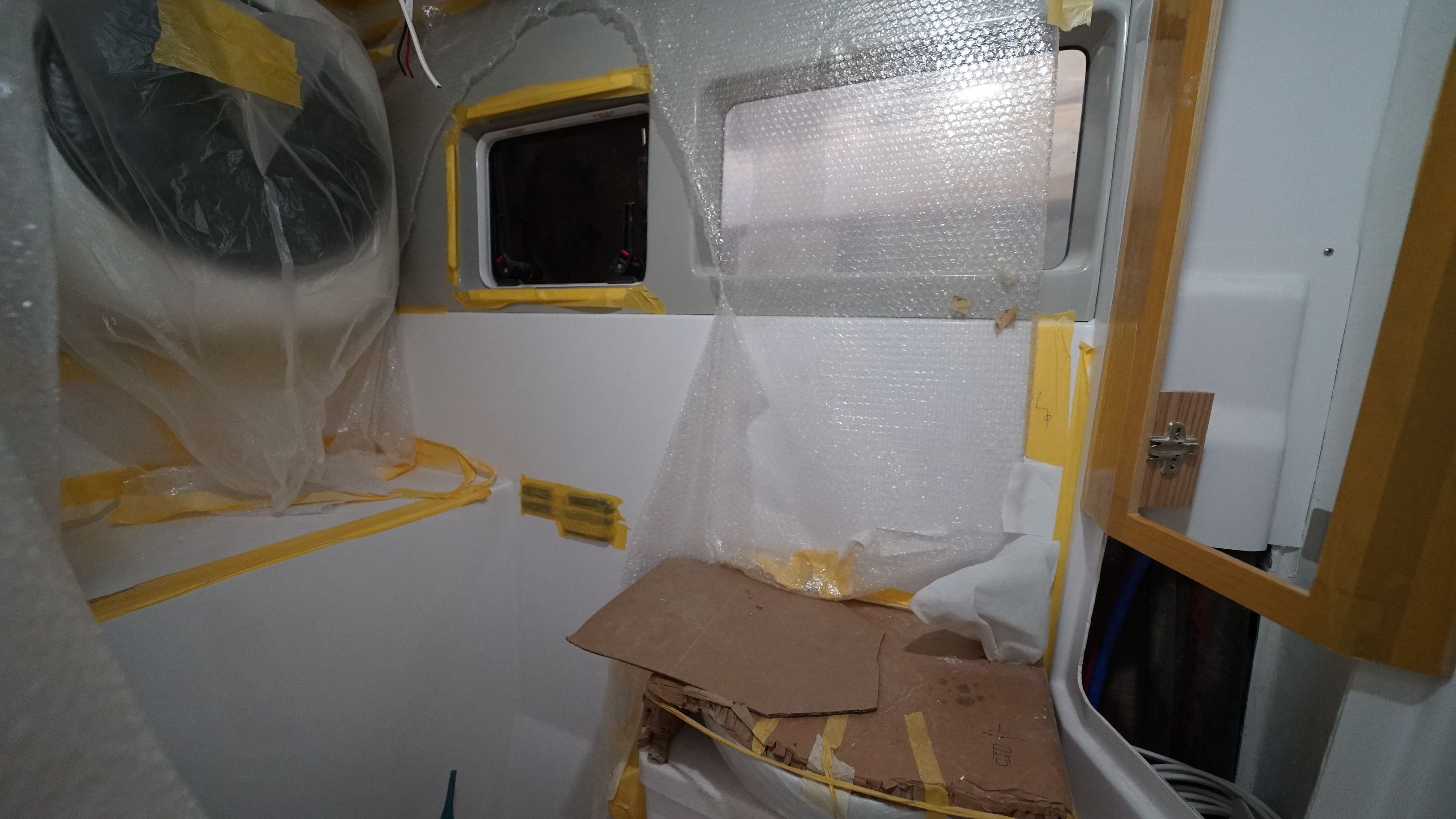

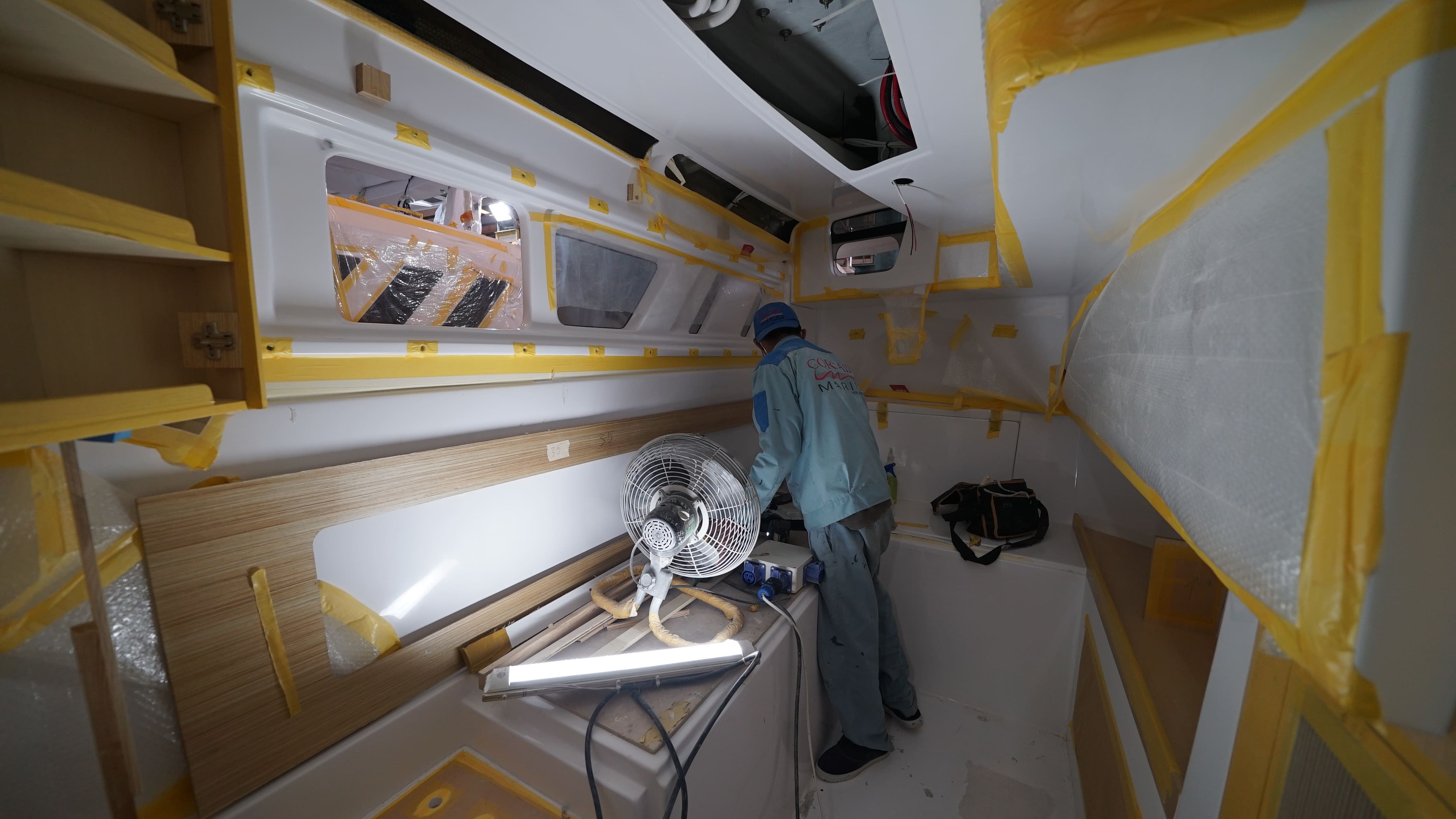

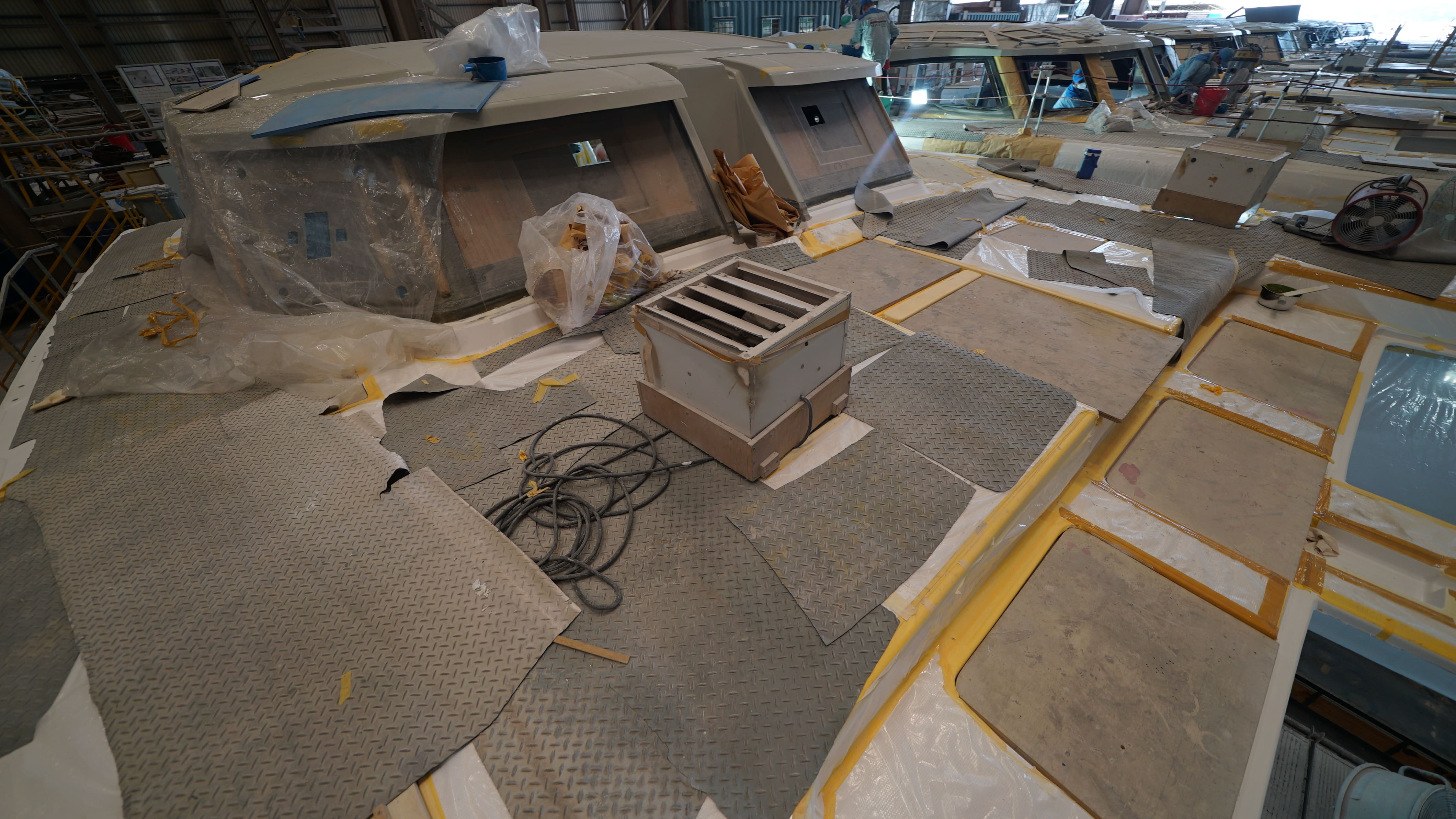

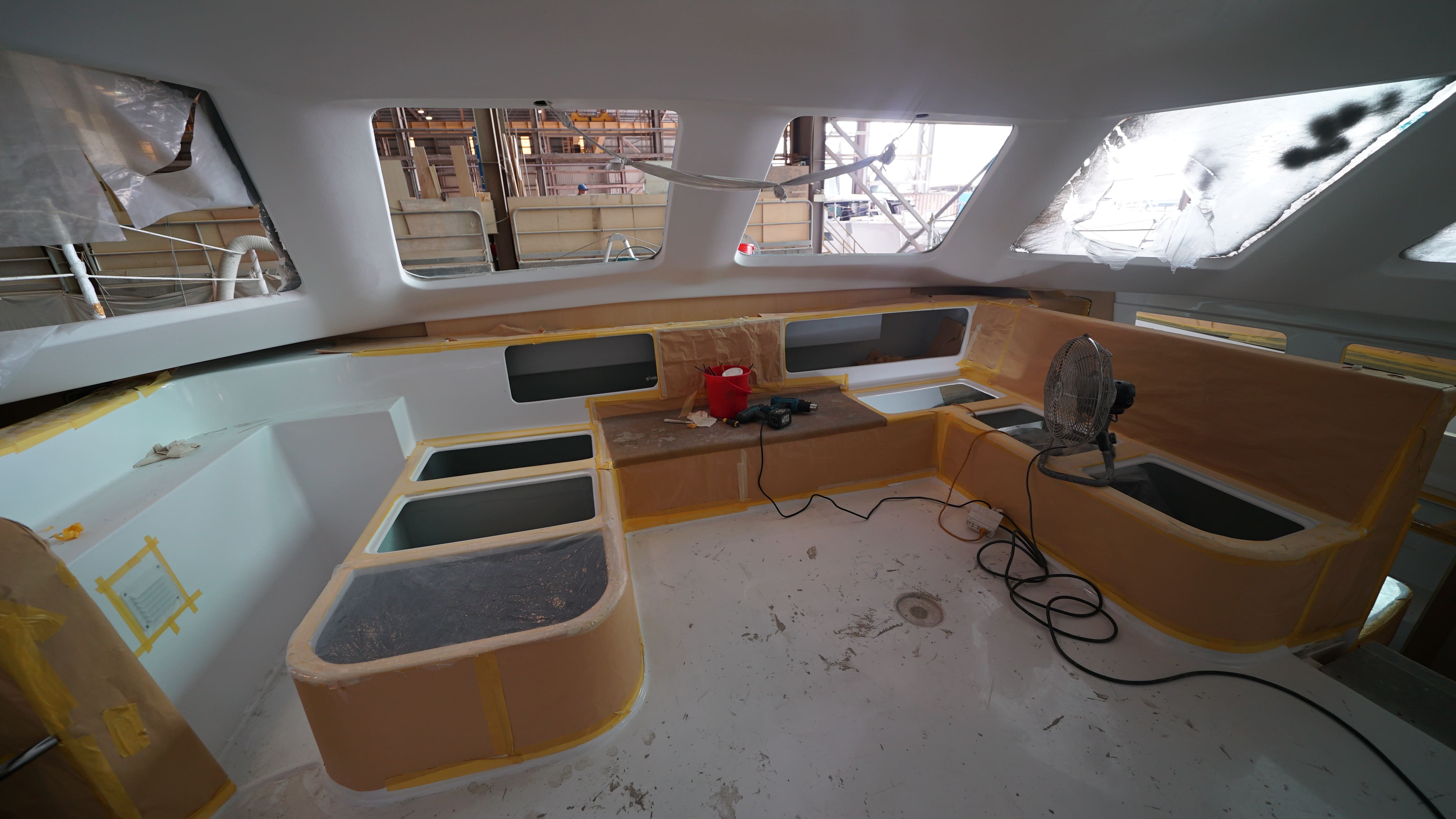

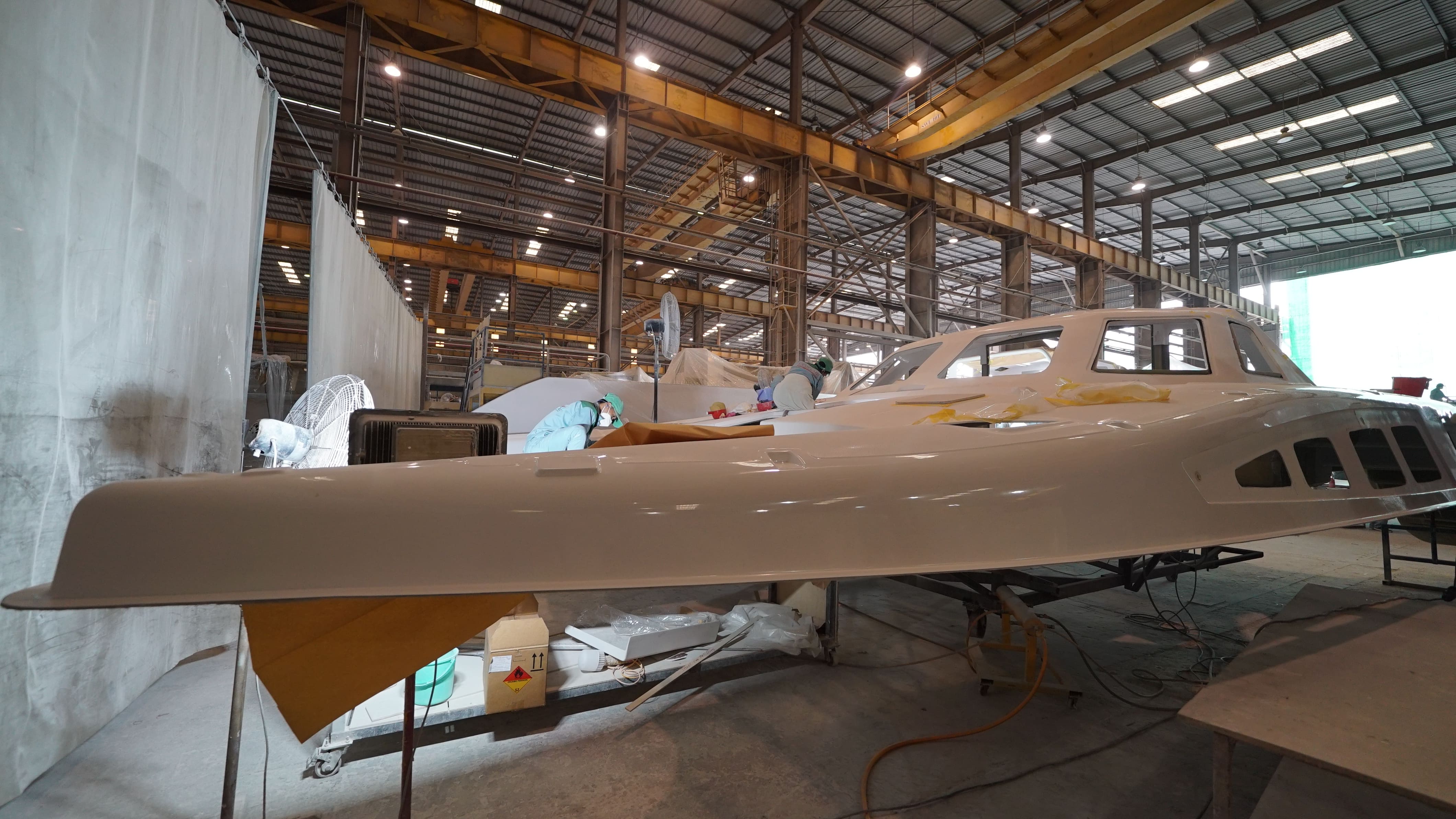

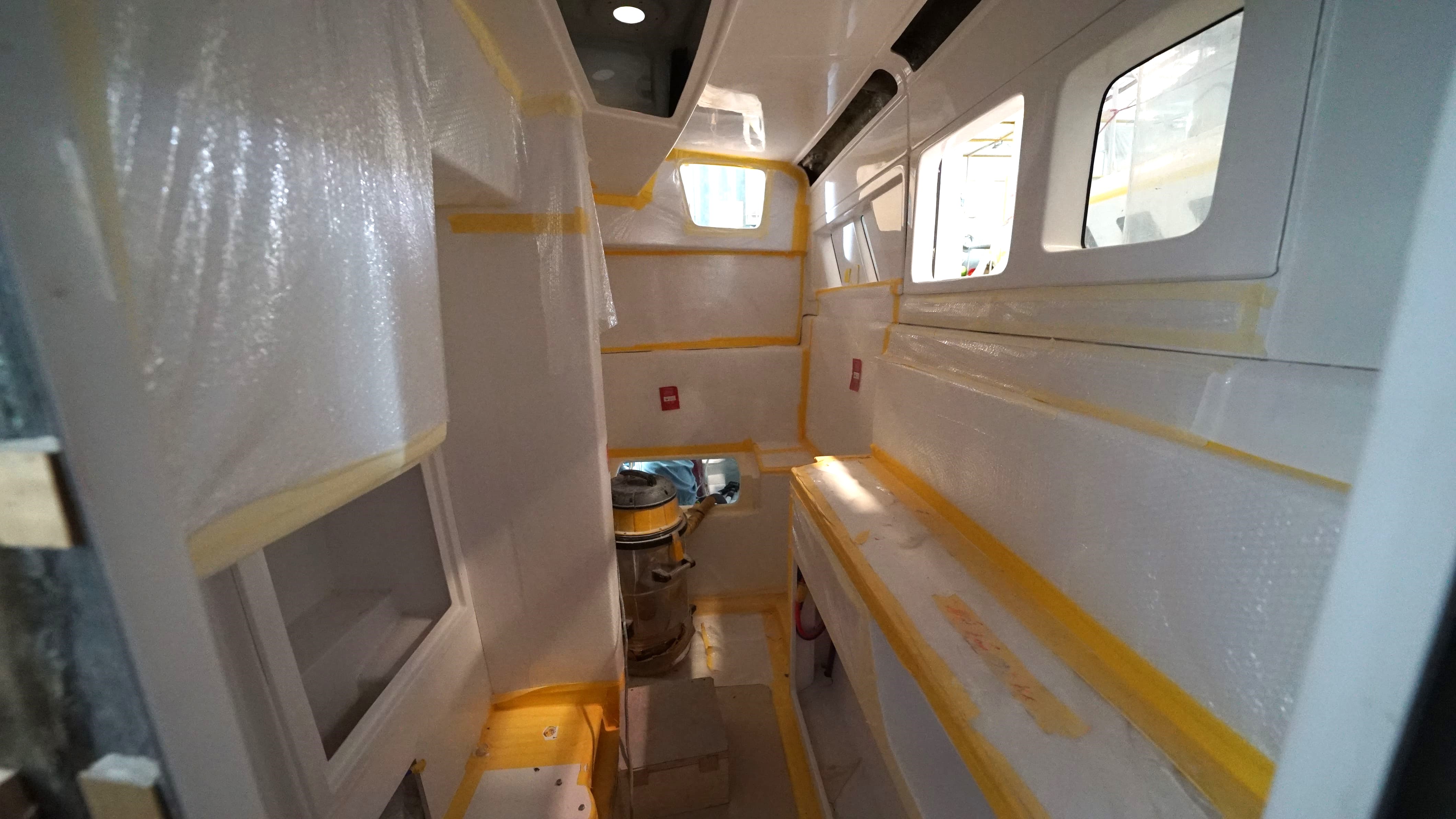

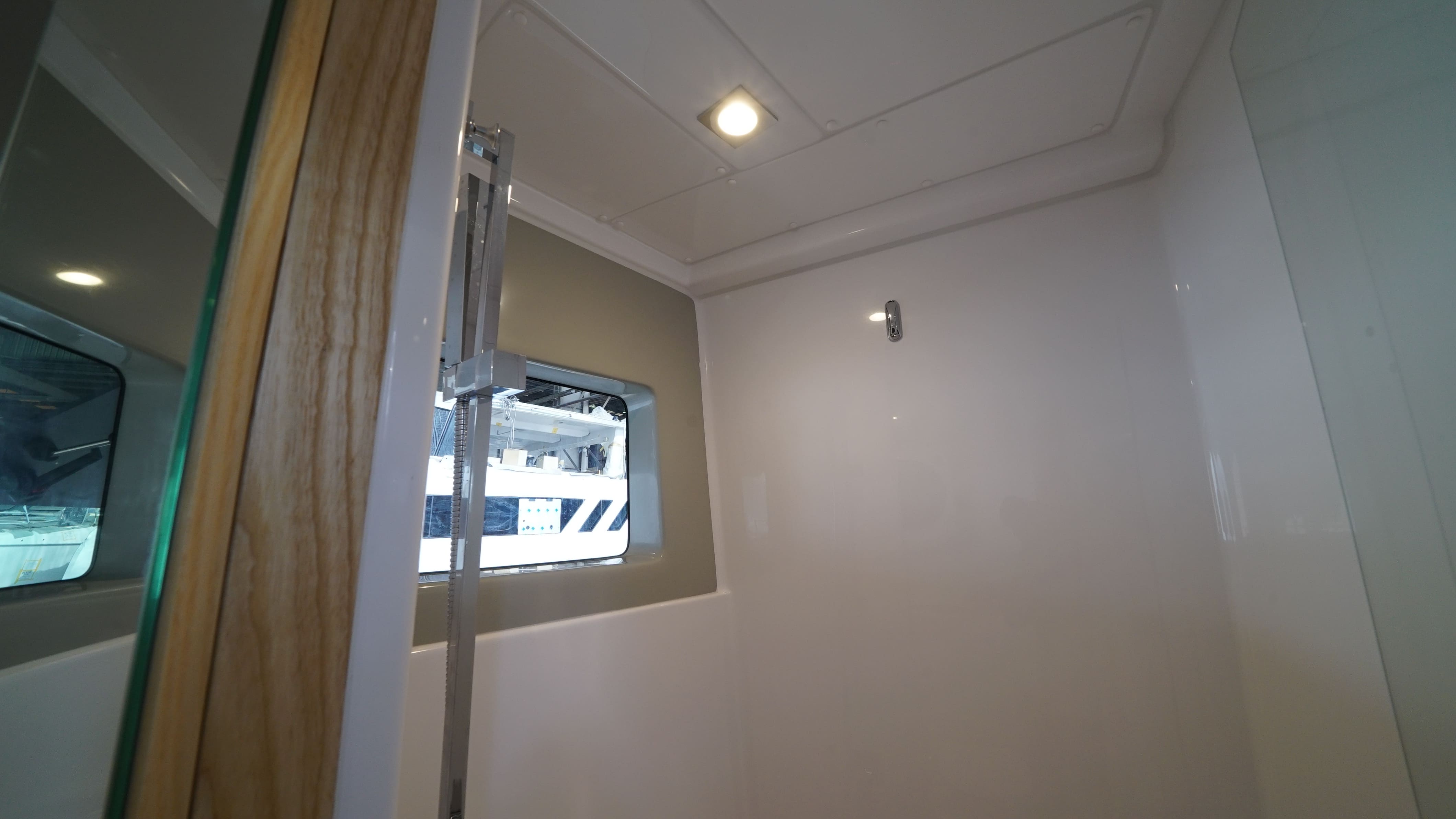

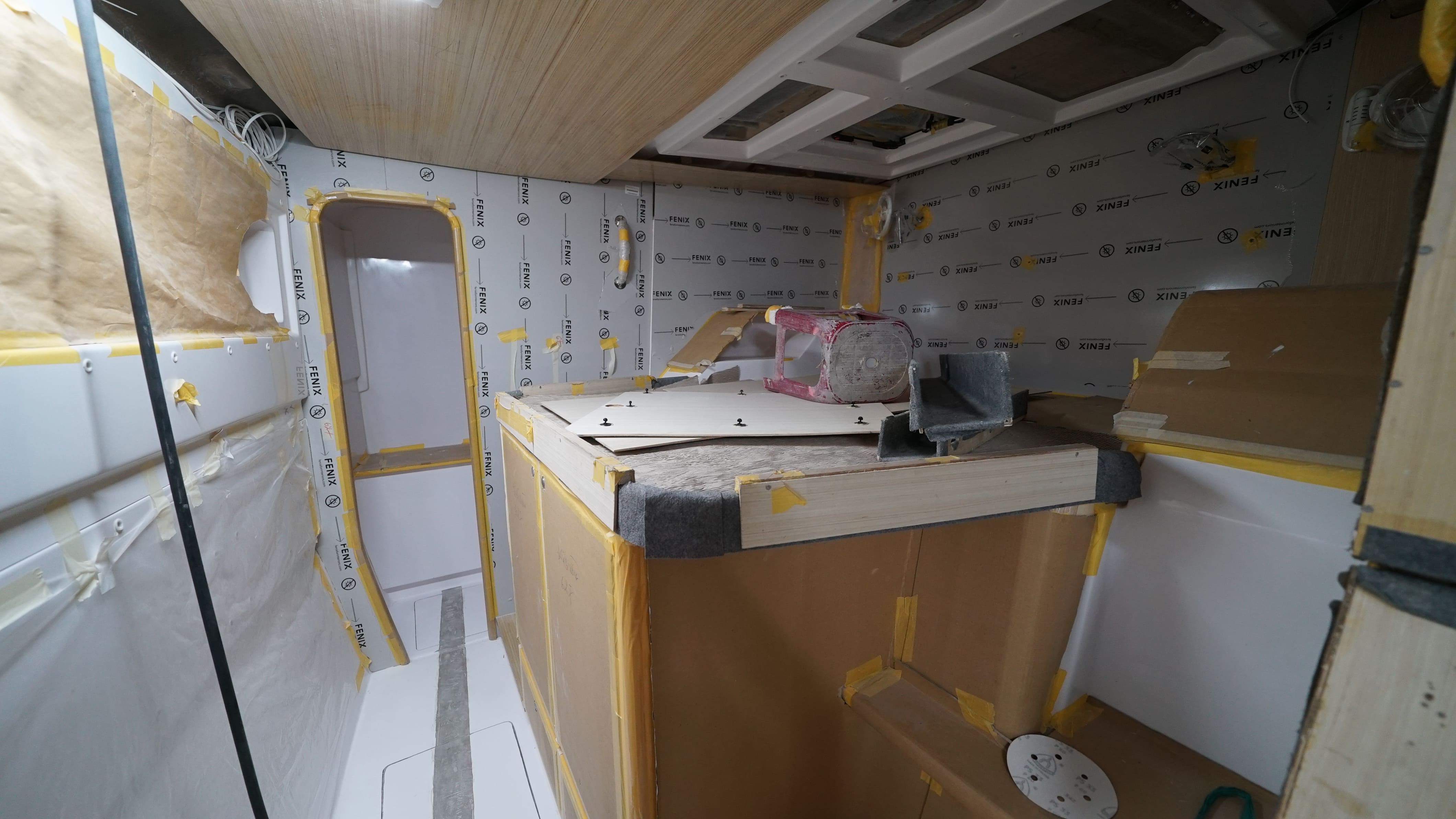

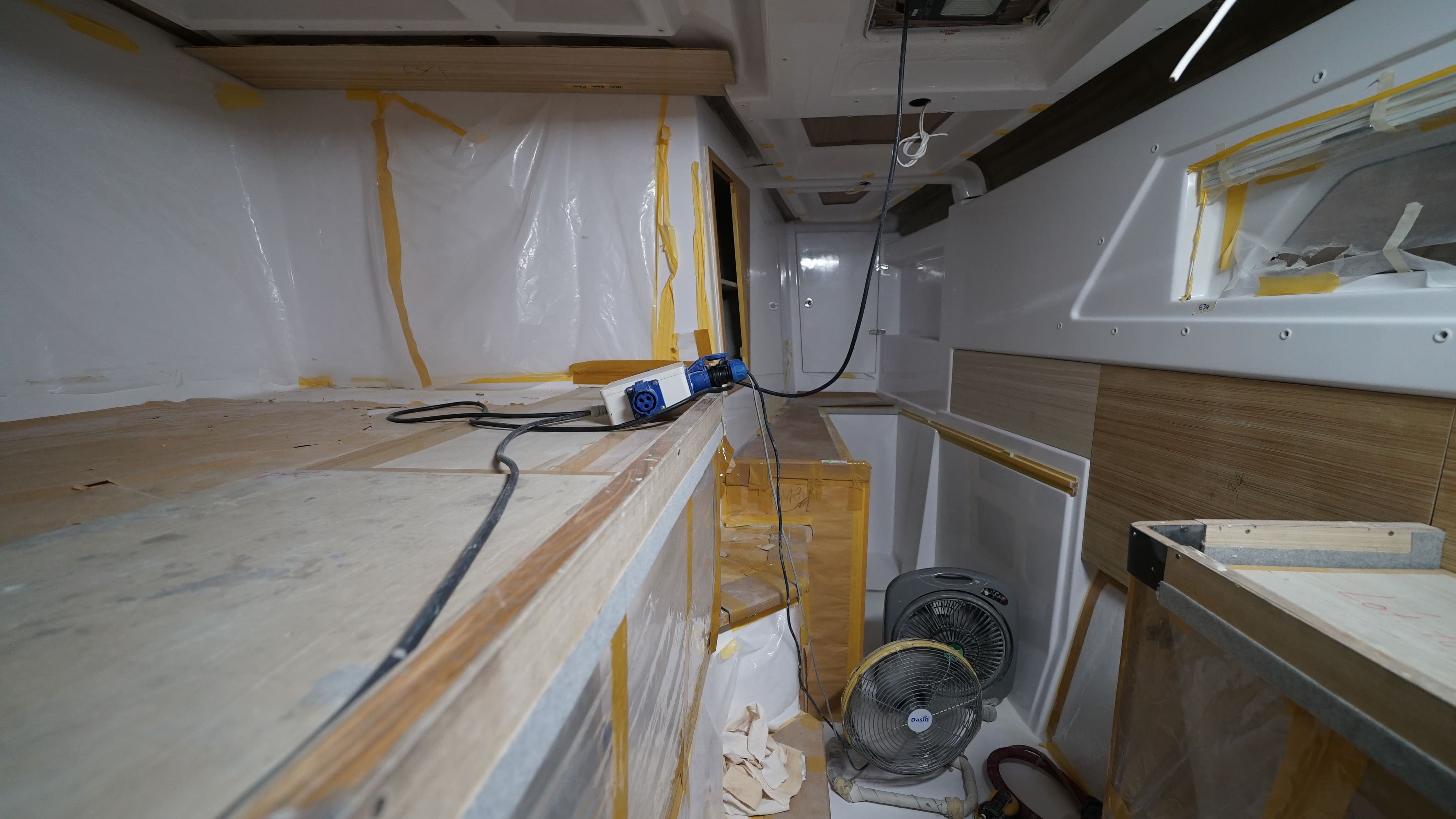

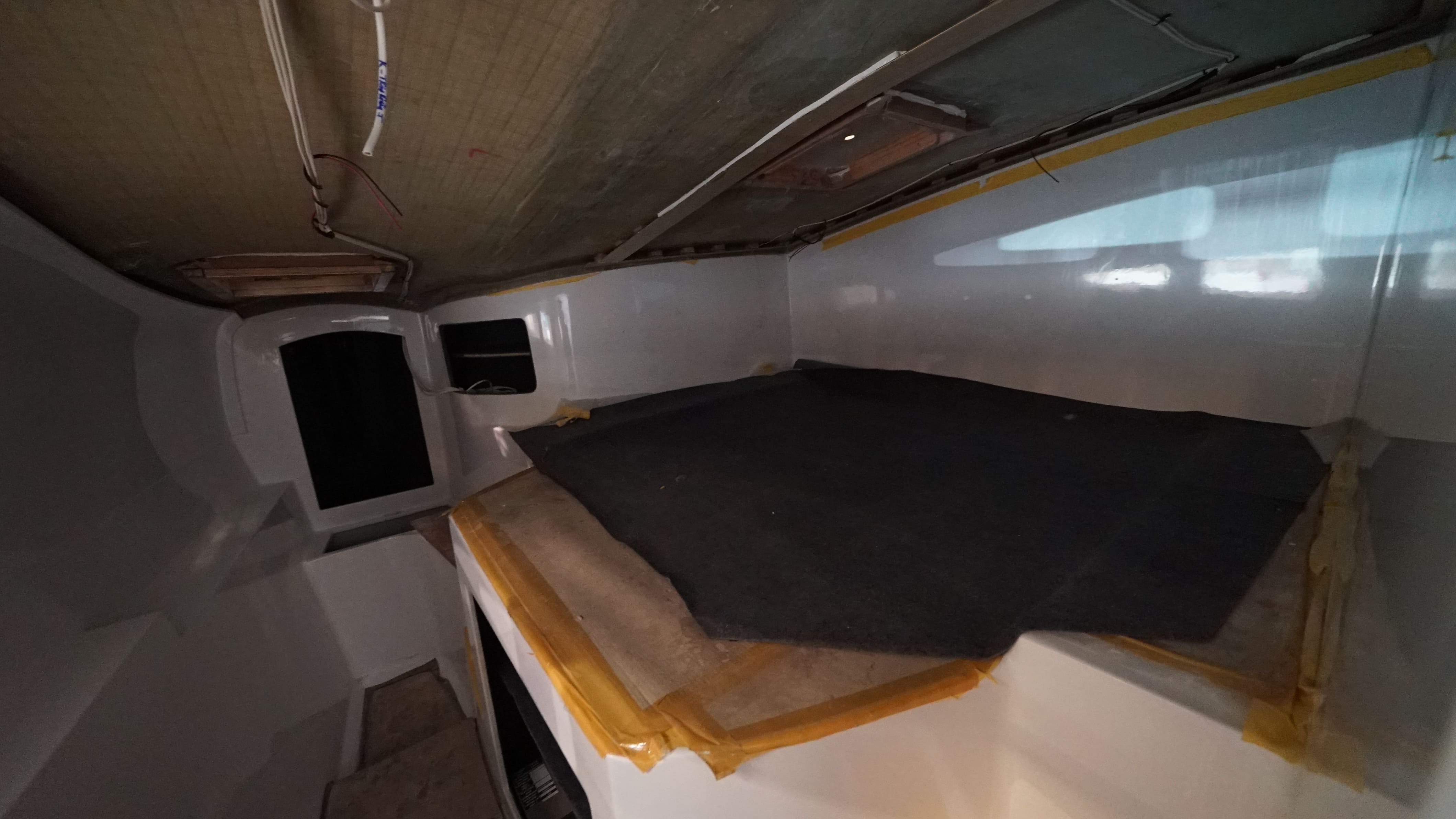

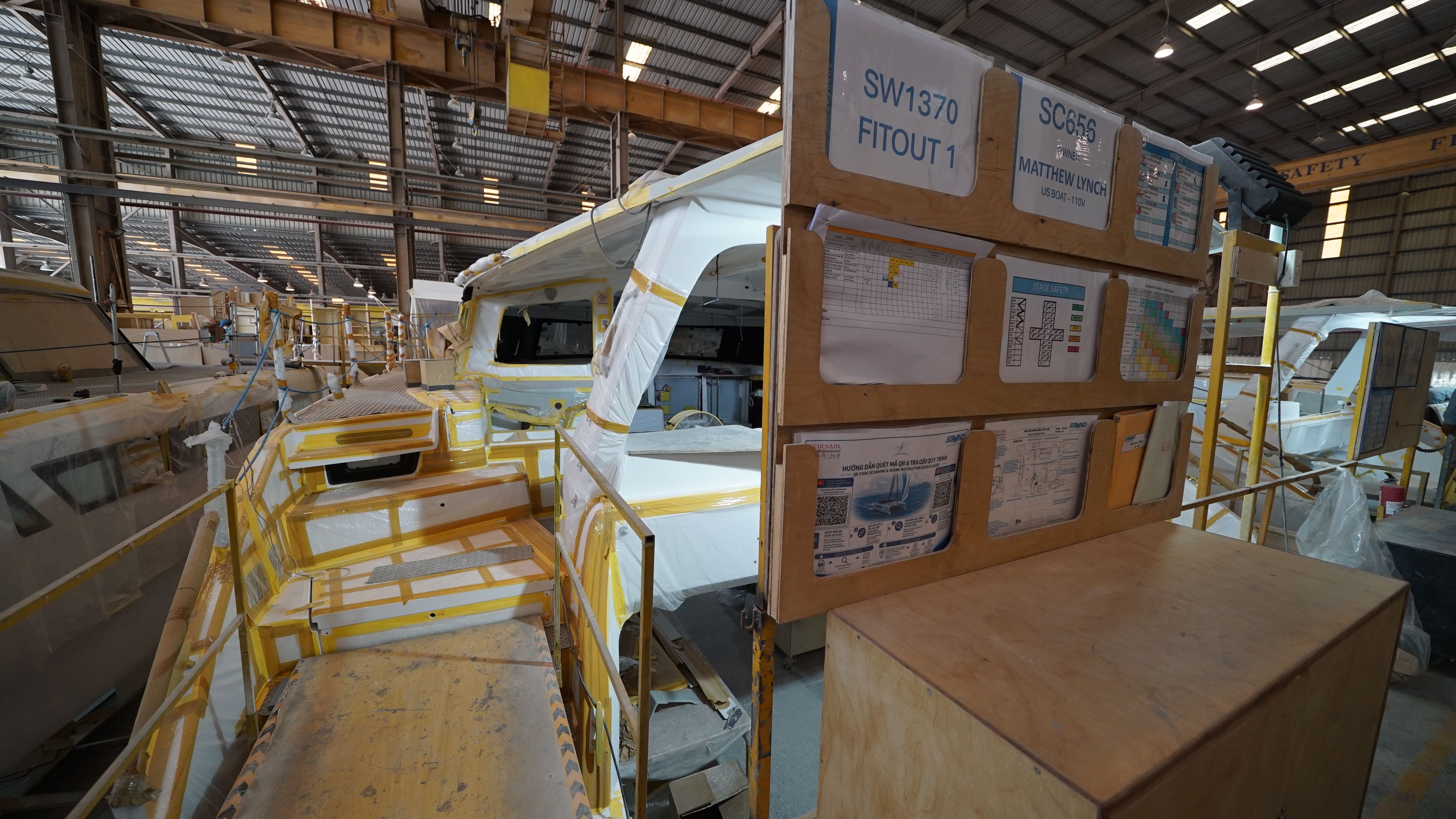

We are excited to inform you that your boat has been moved to the Fit out stage.

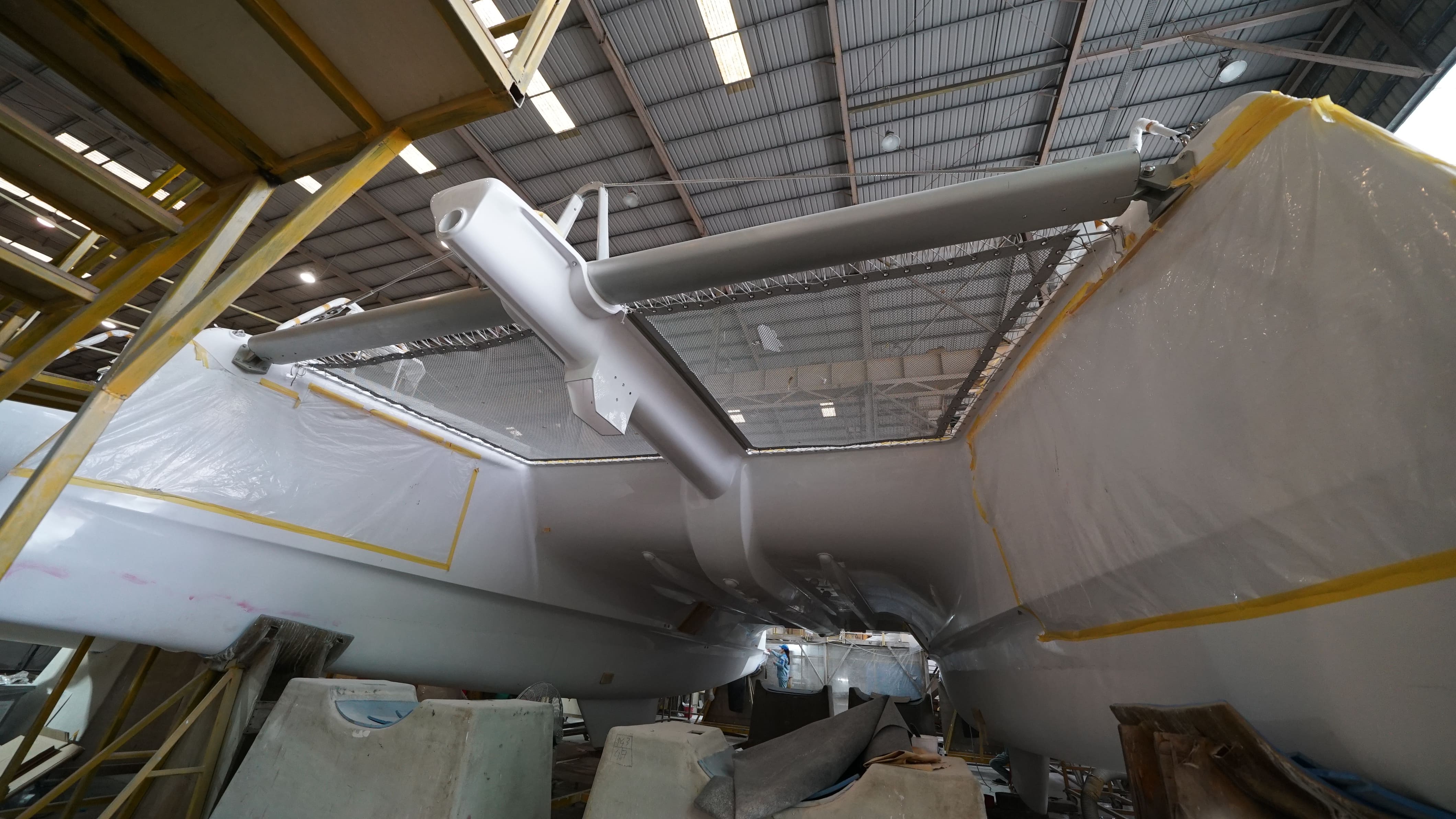

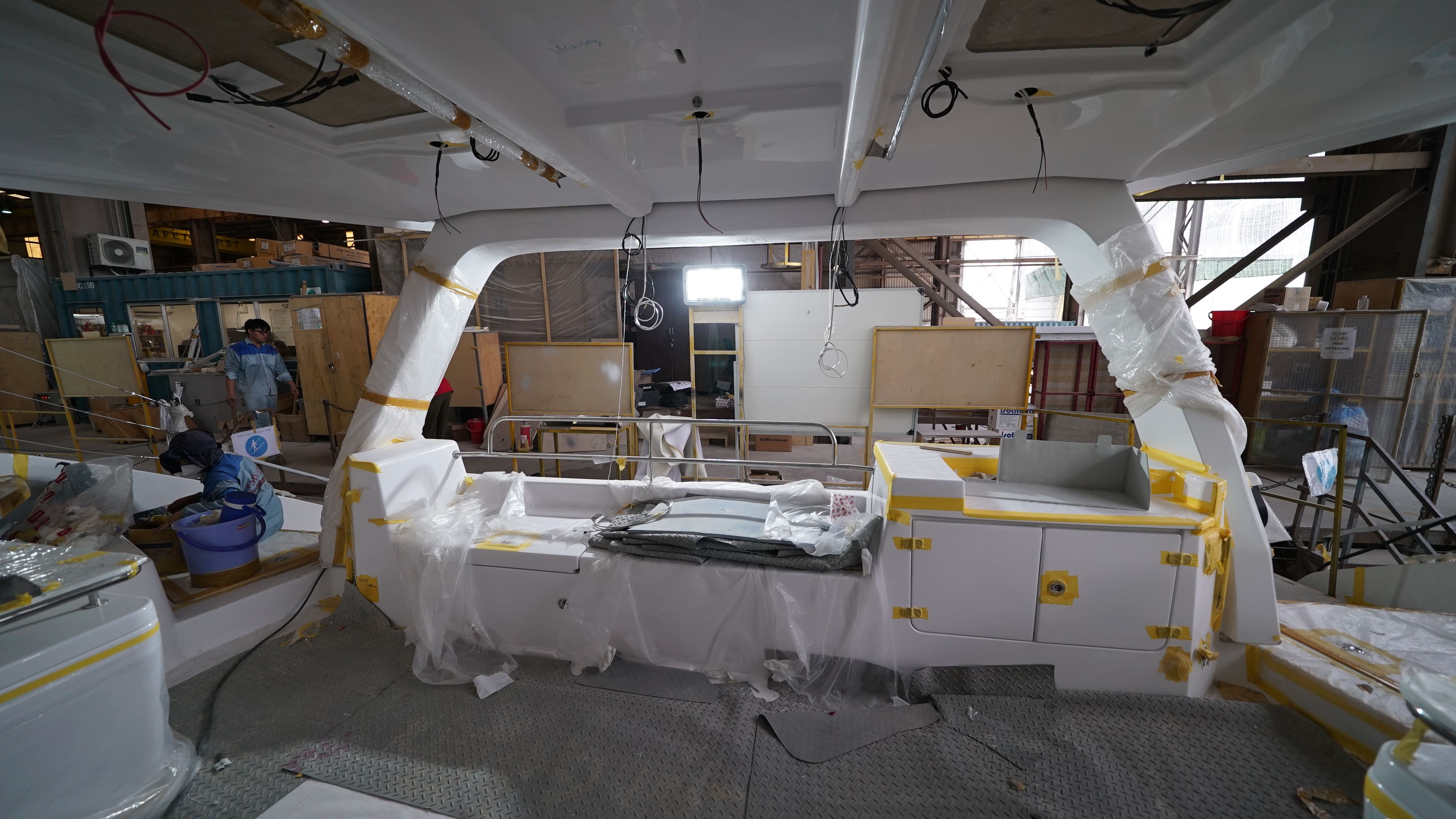

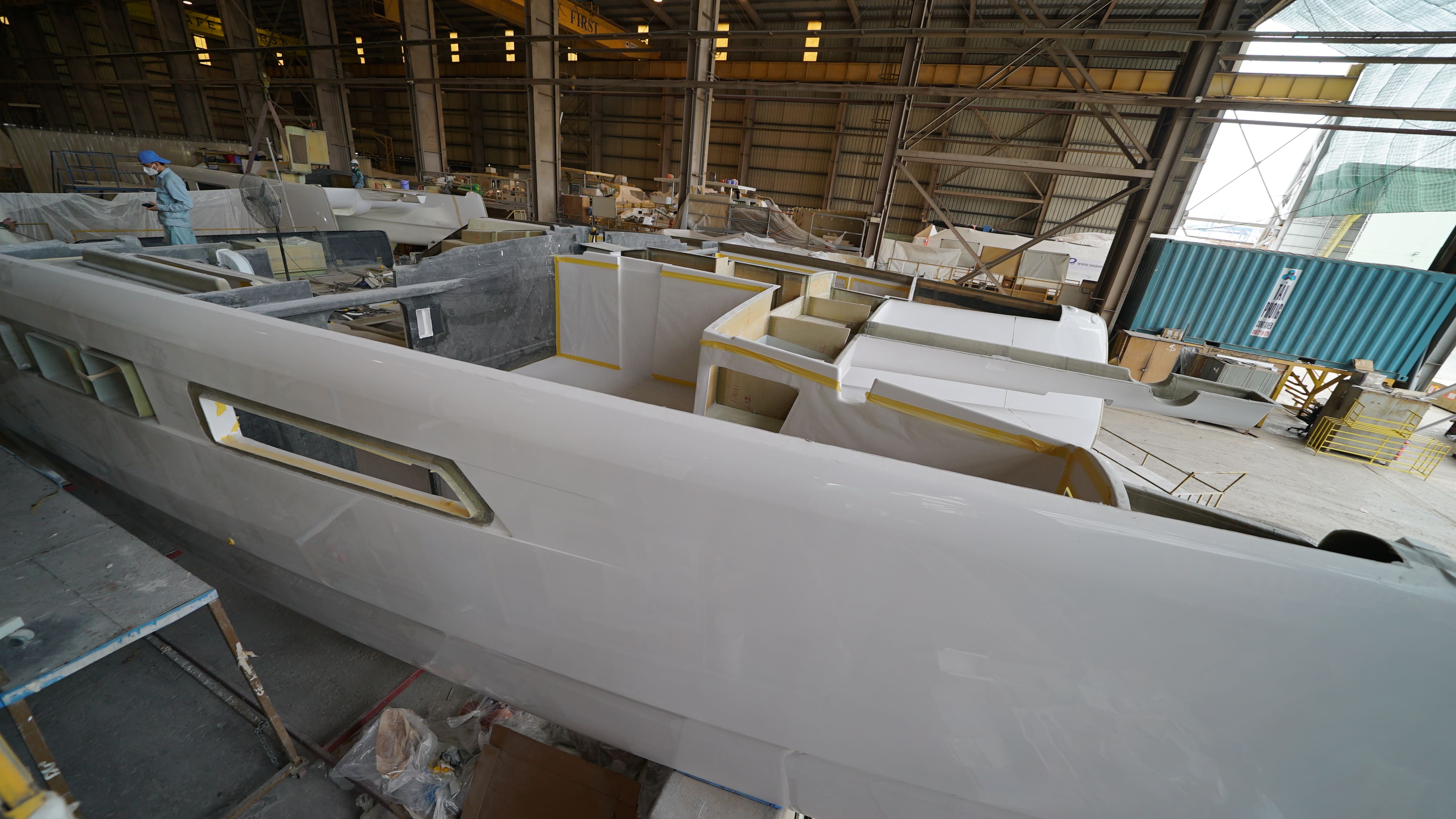

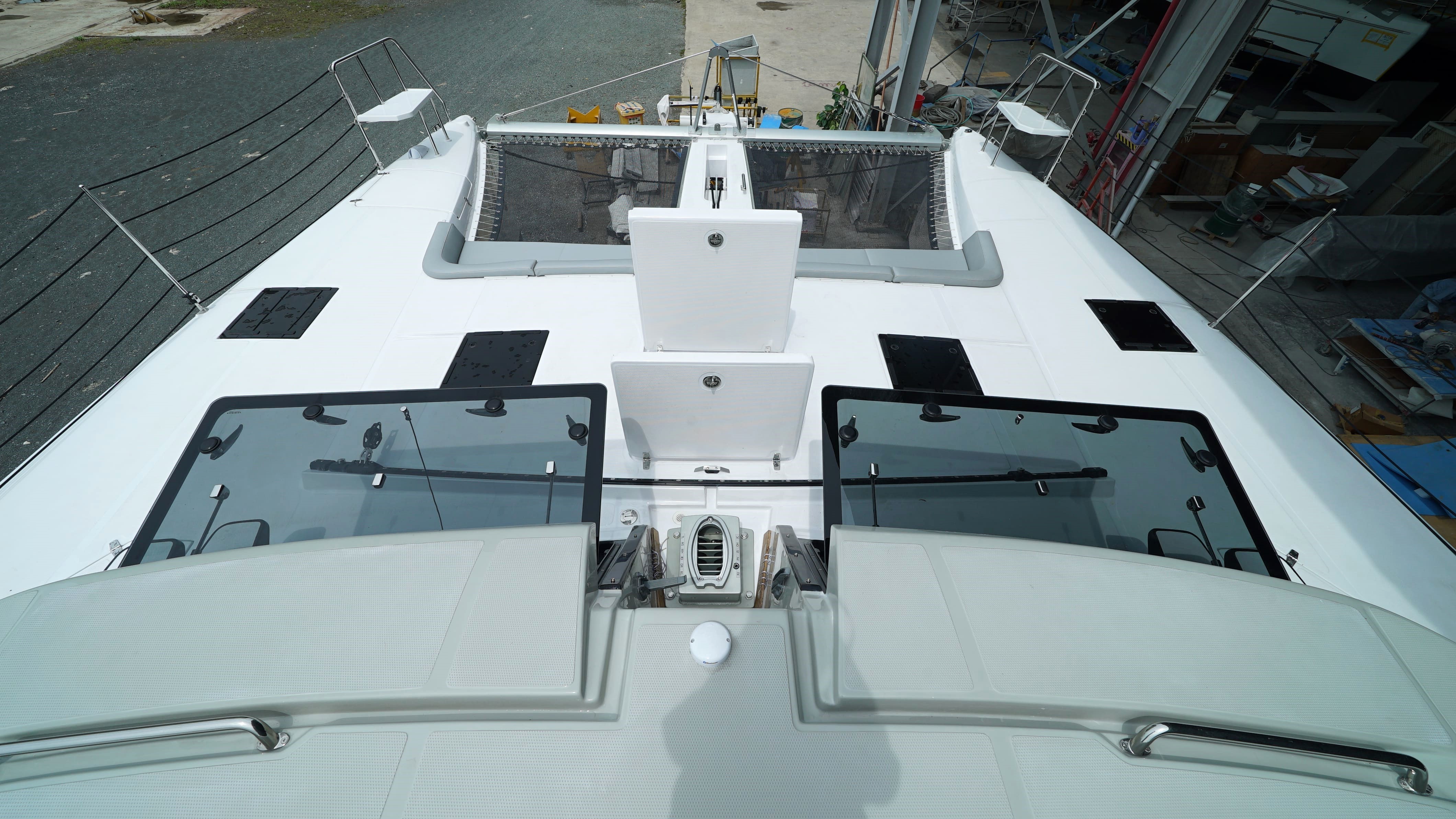

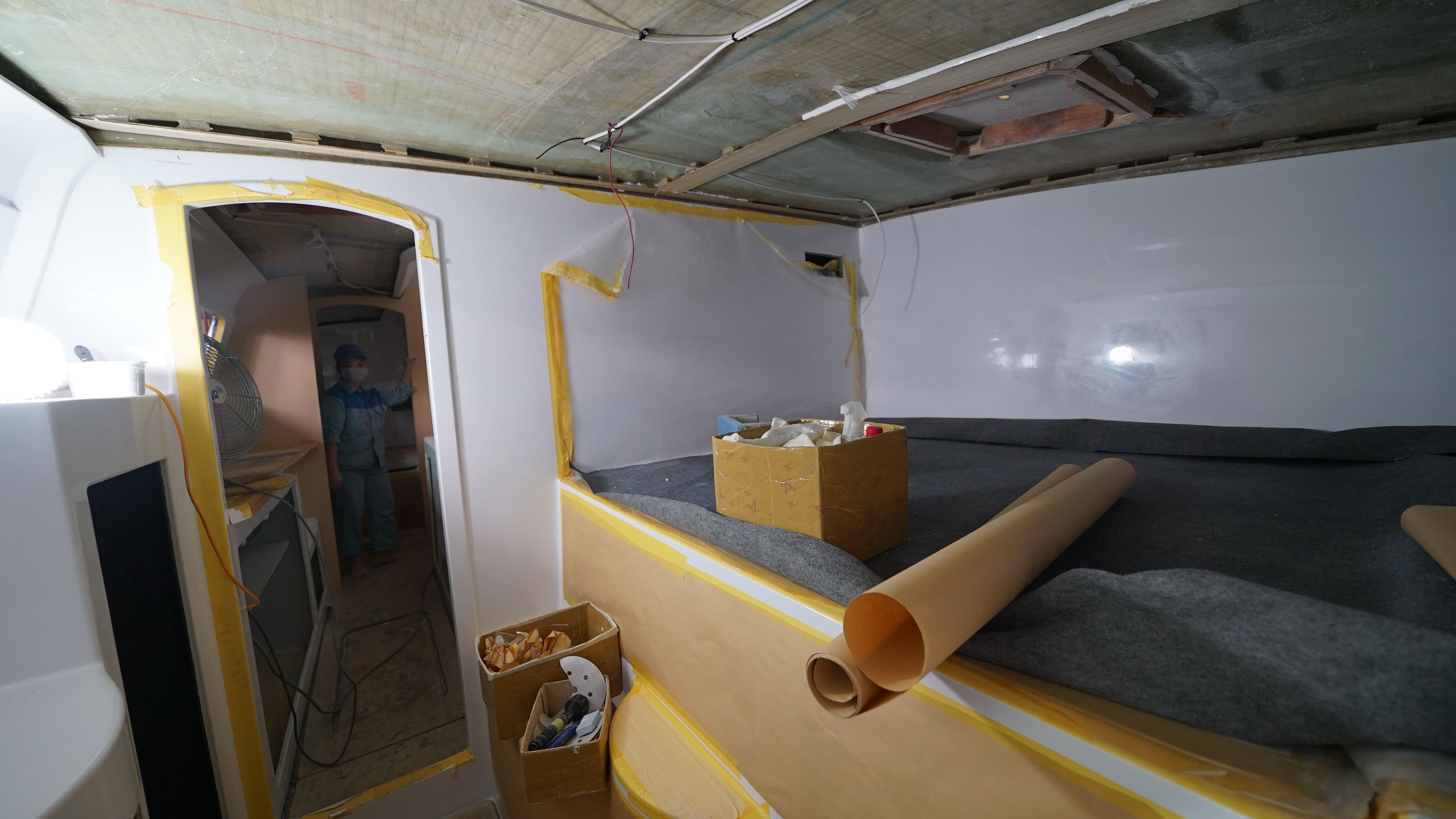

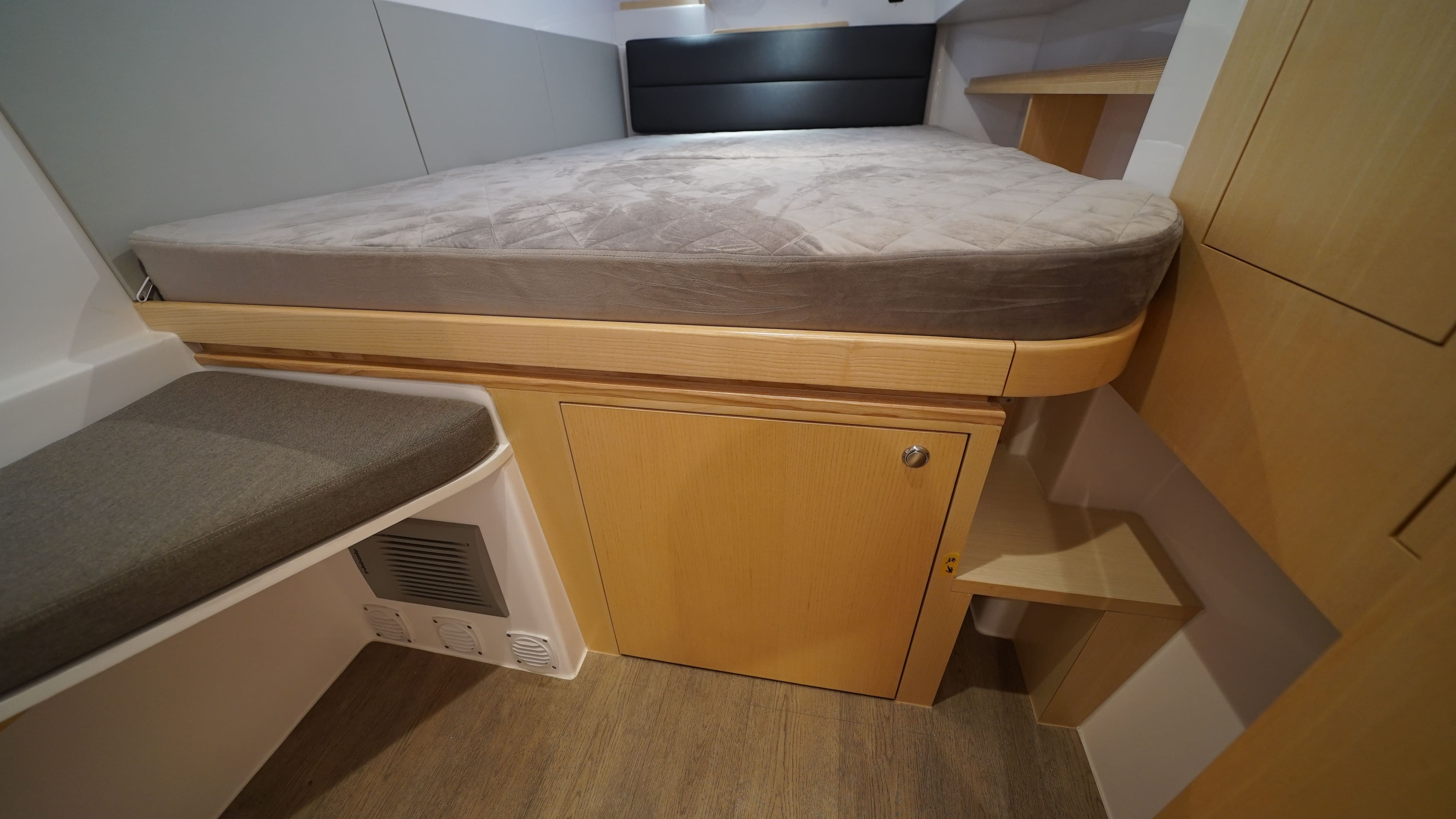

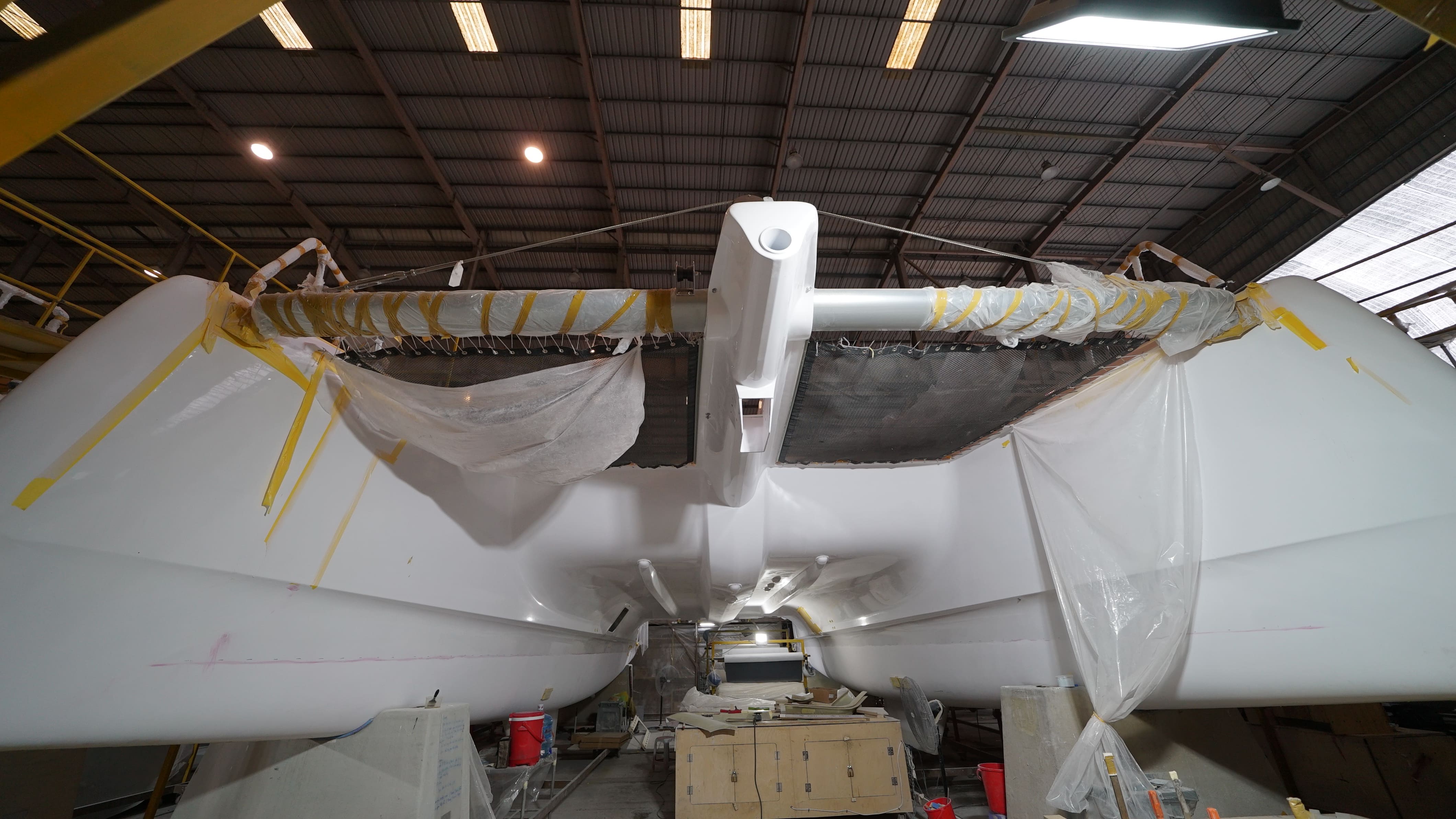

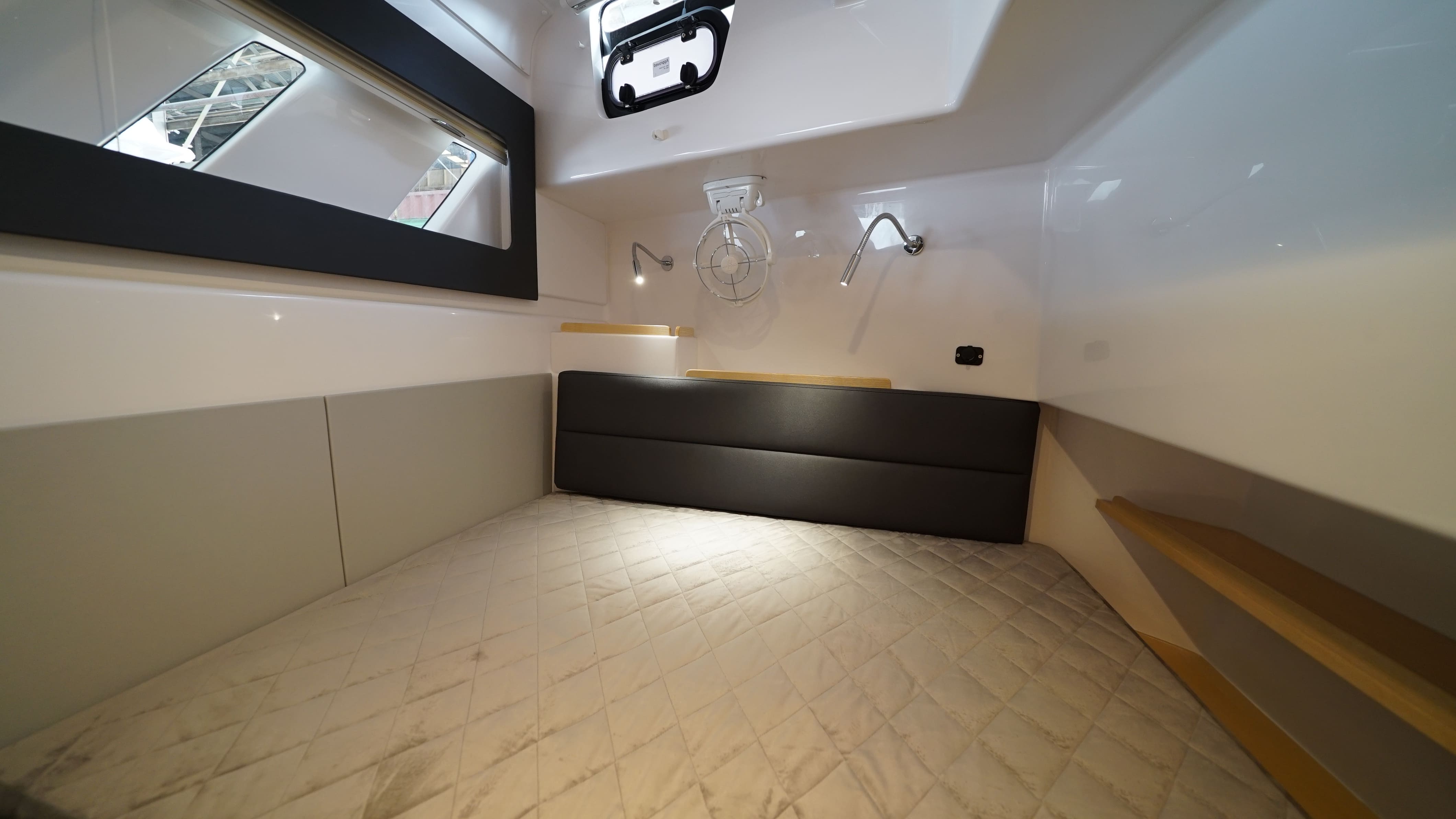

We recently completed the installation of the A-frame, forward beam, and engines.

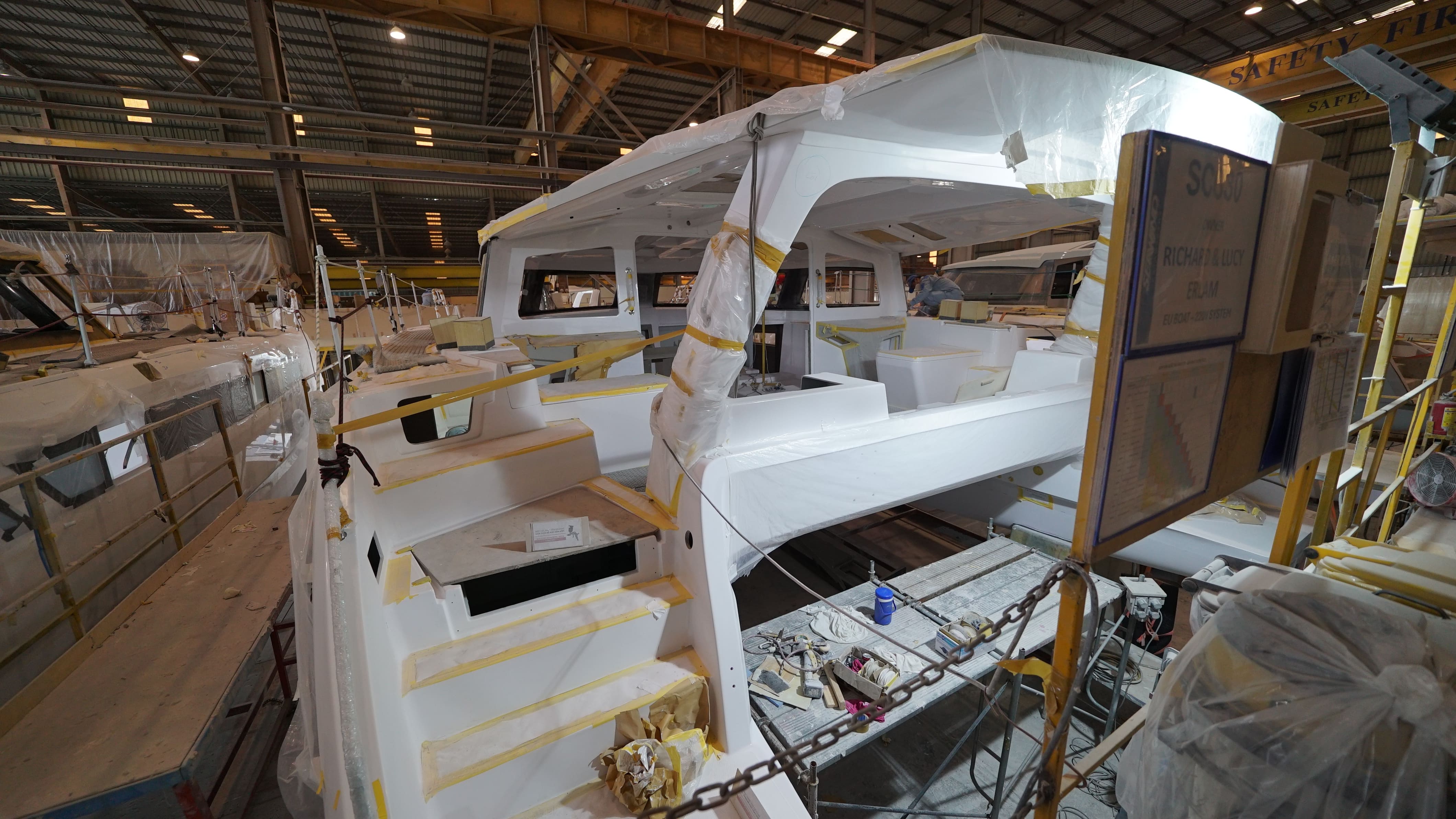

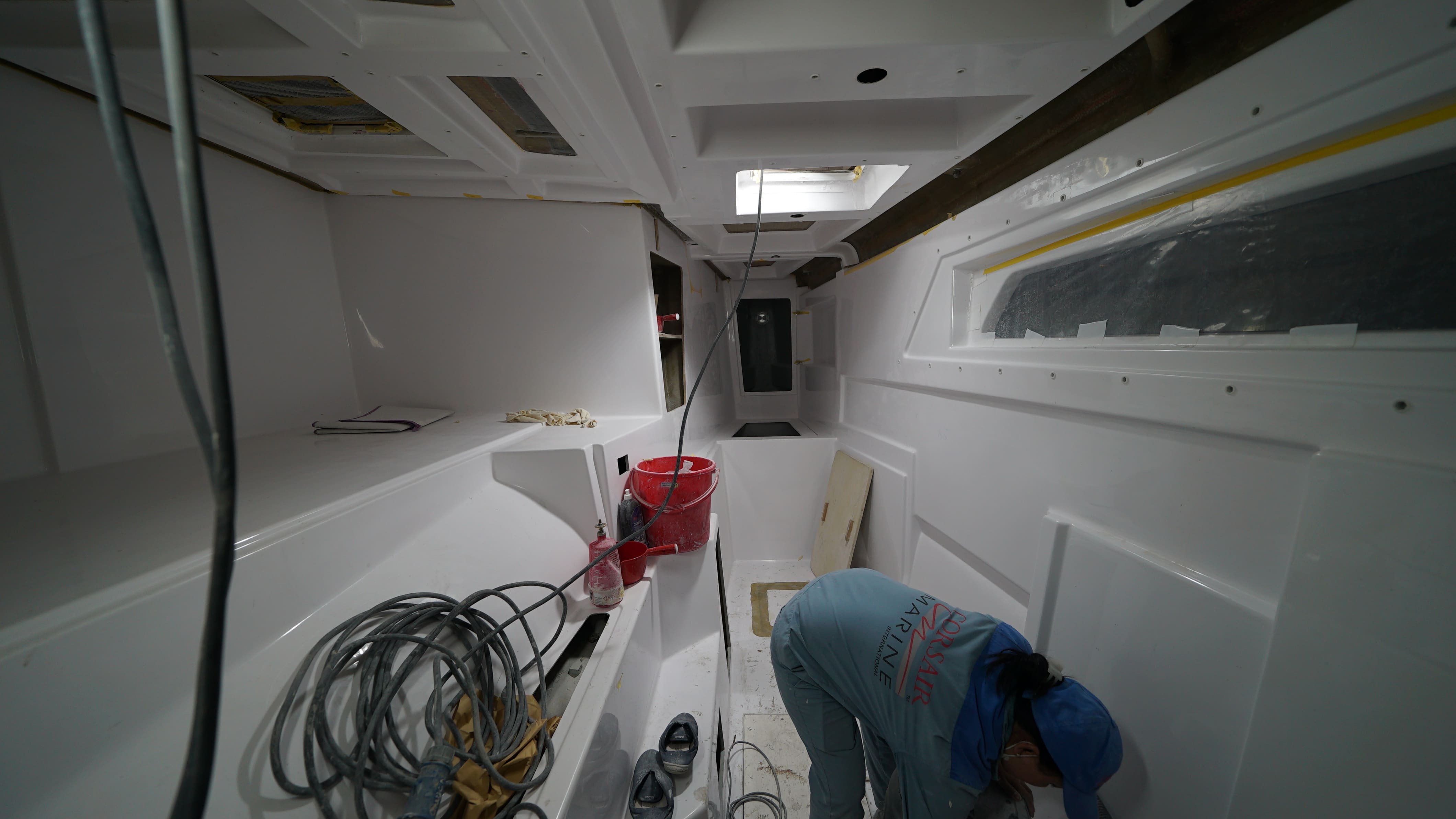

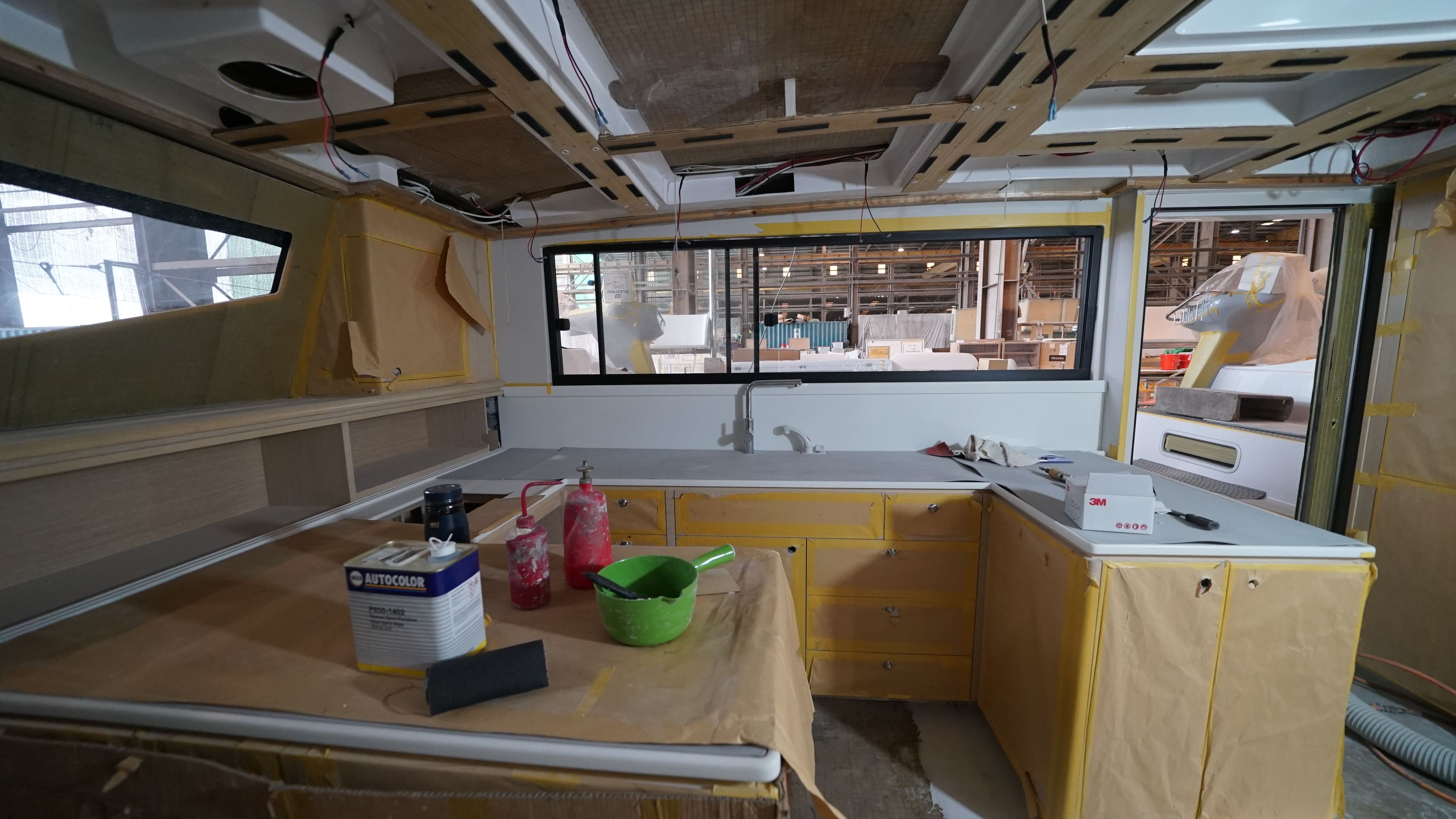

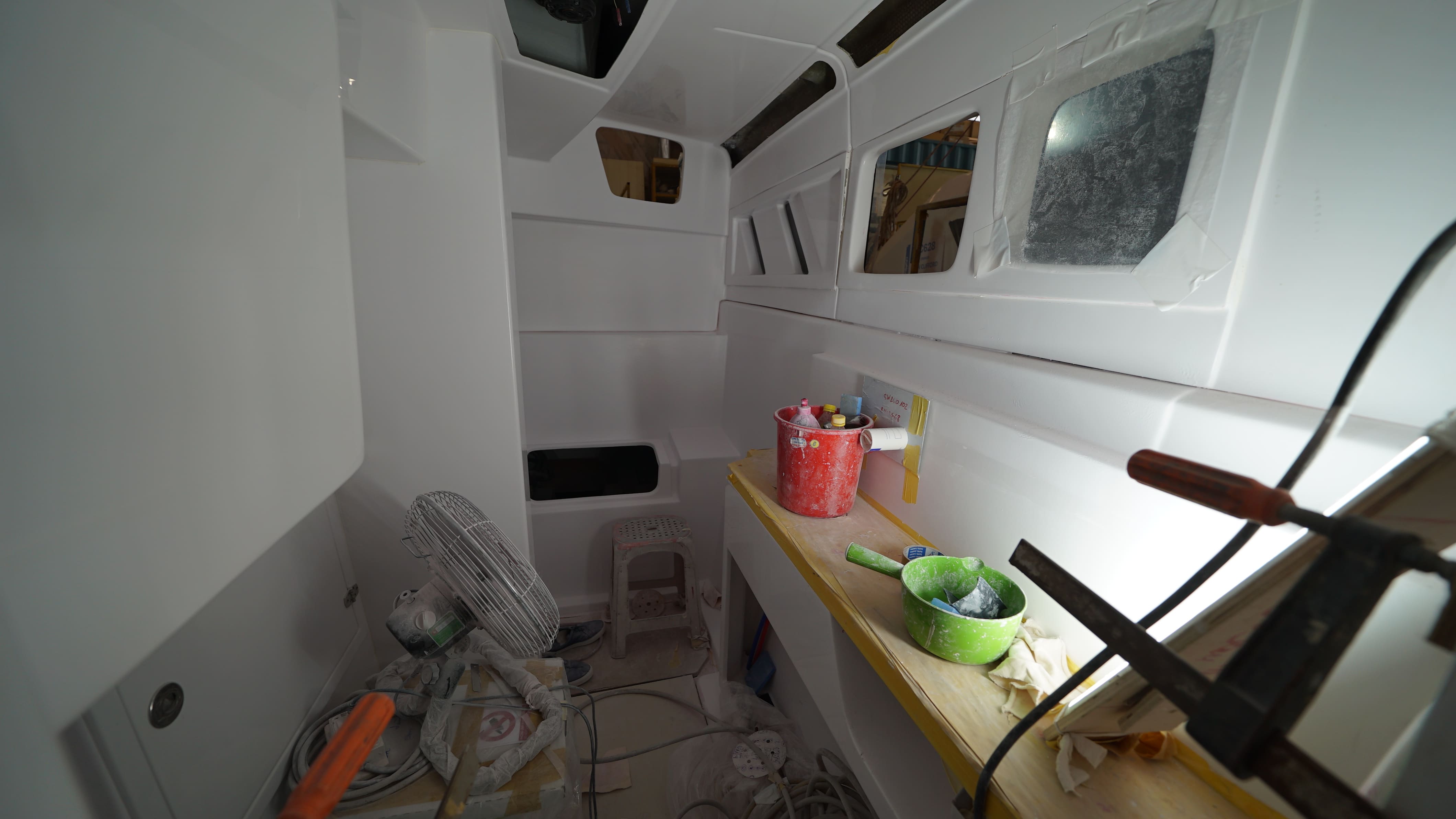

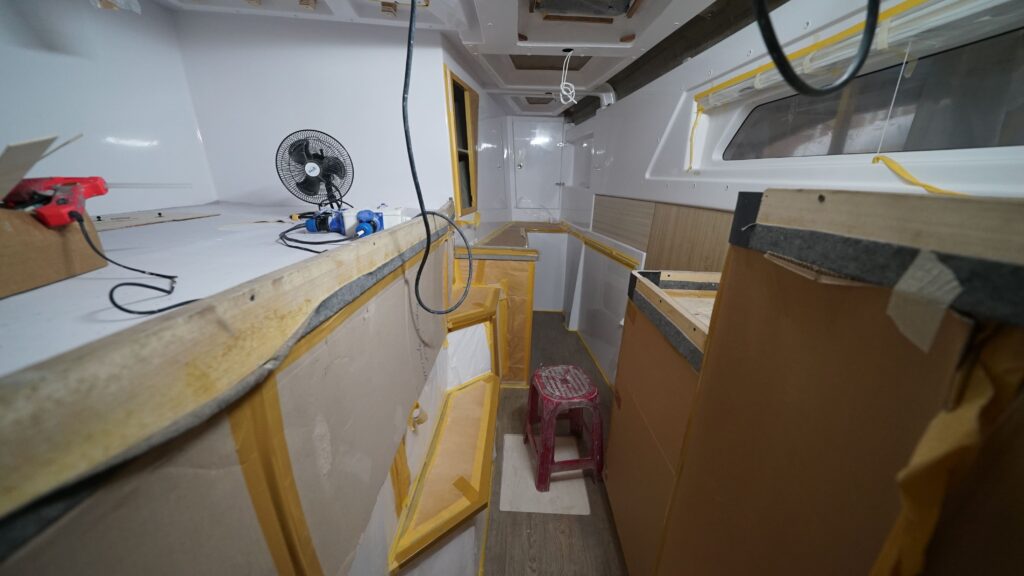

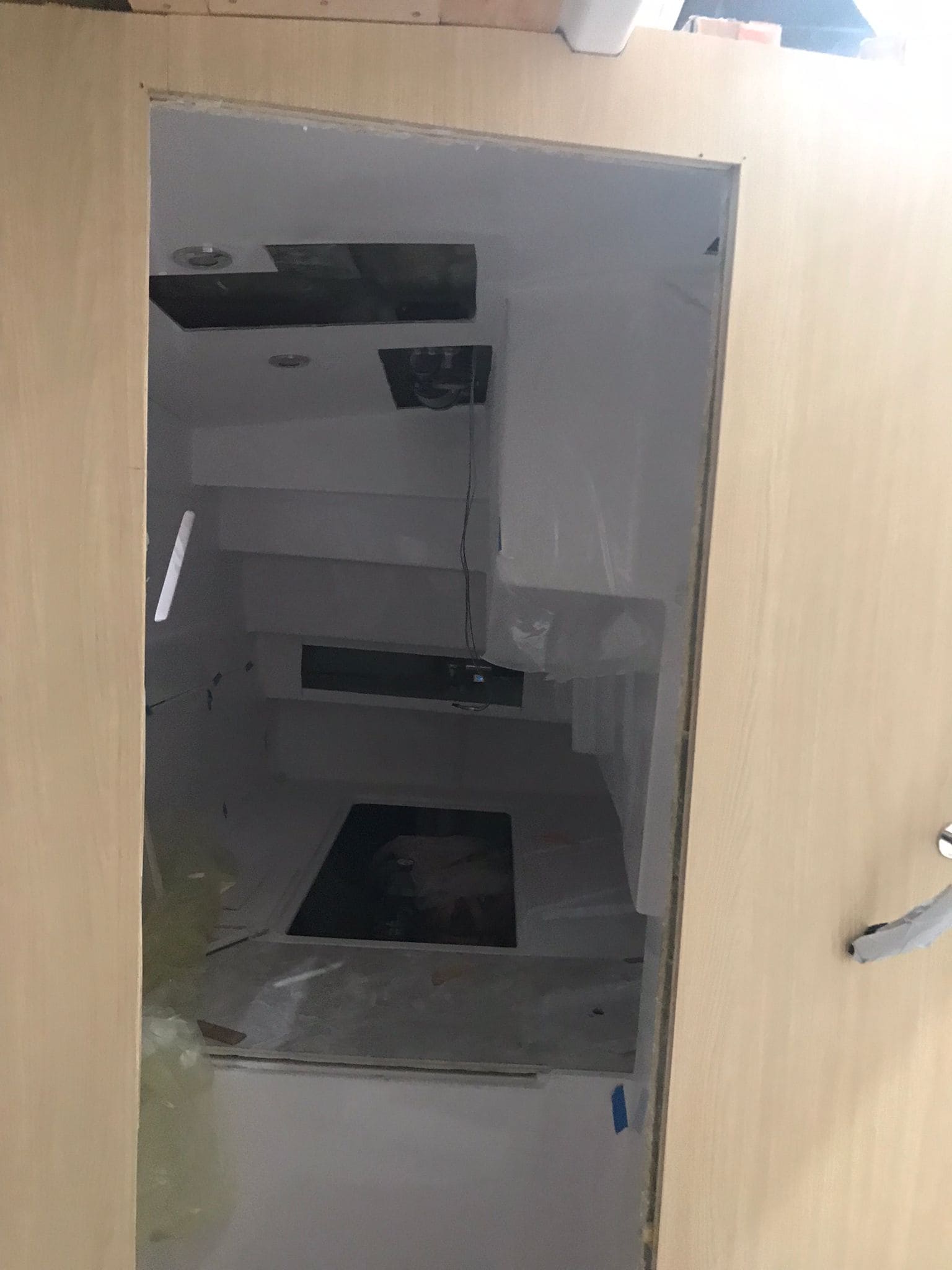

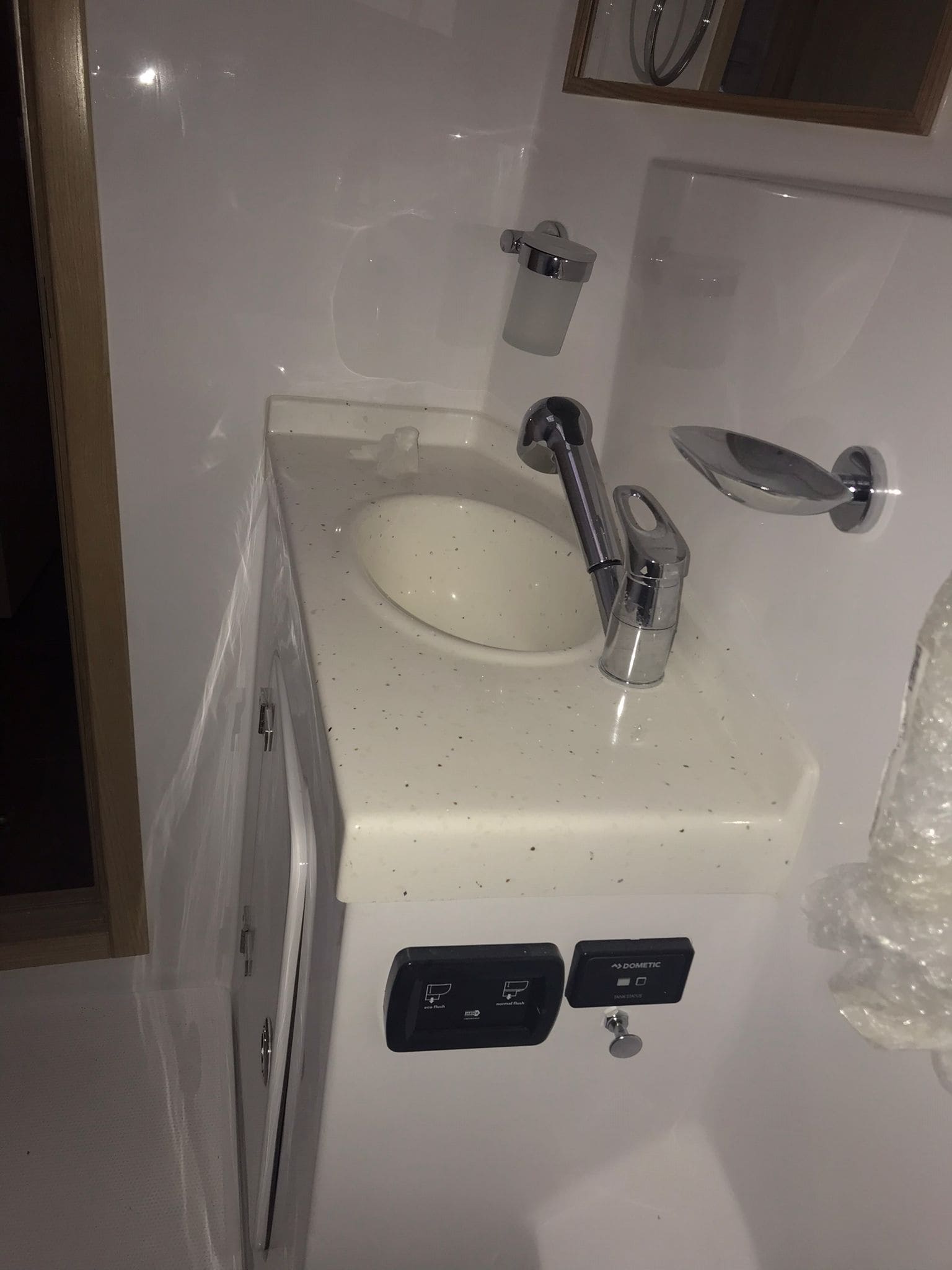

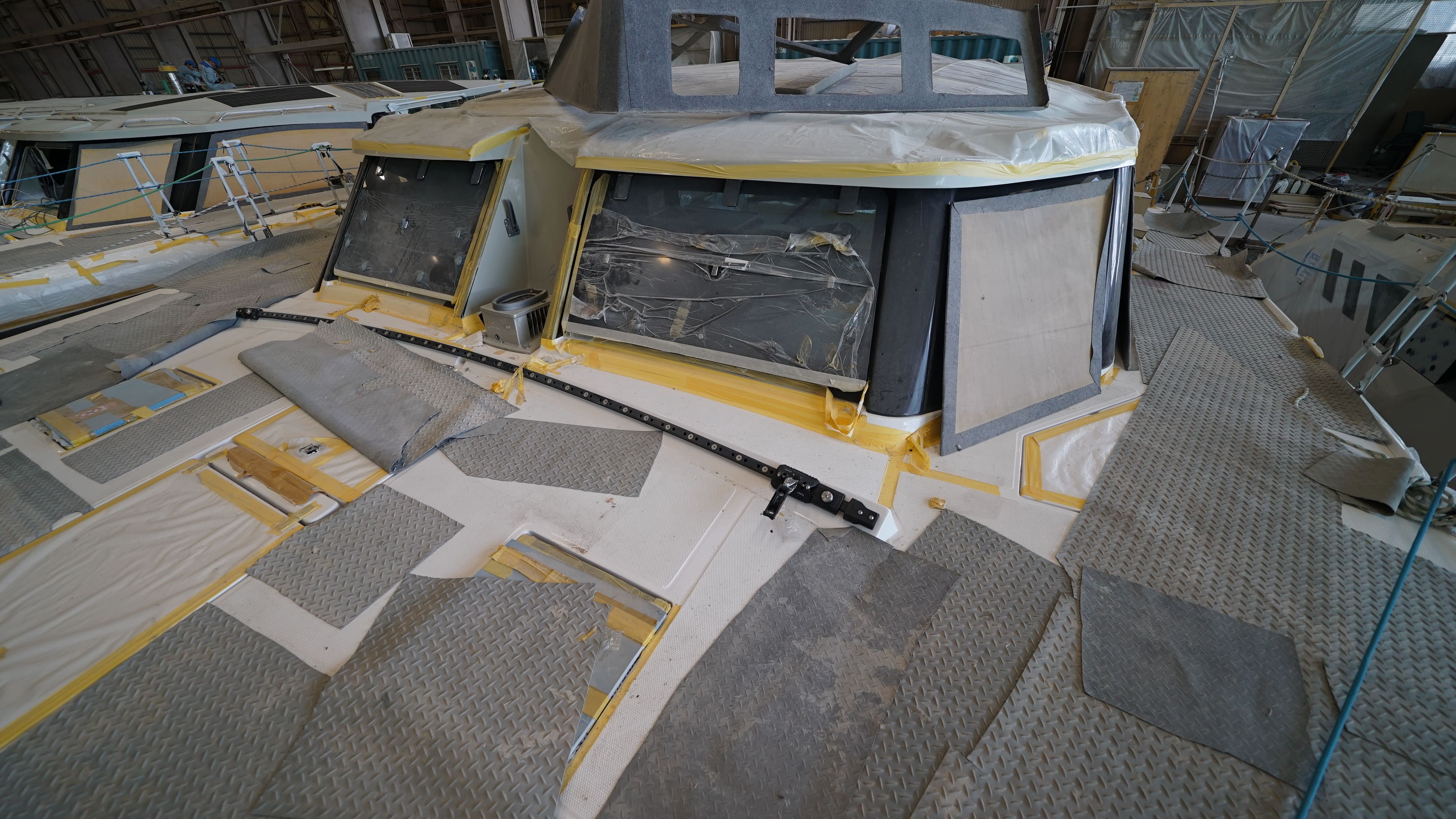

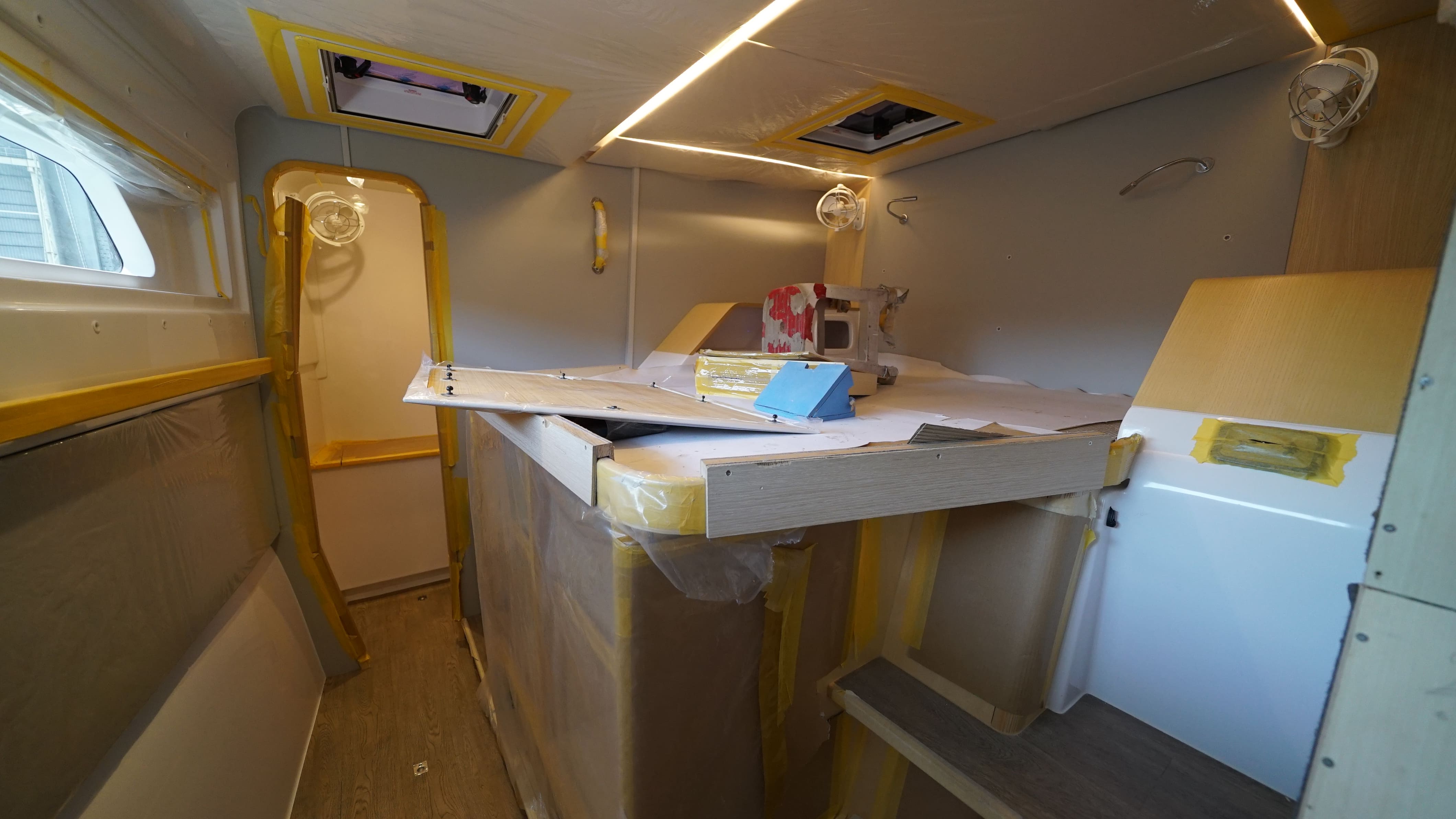

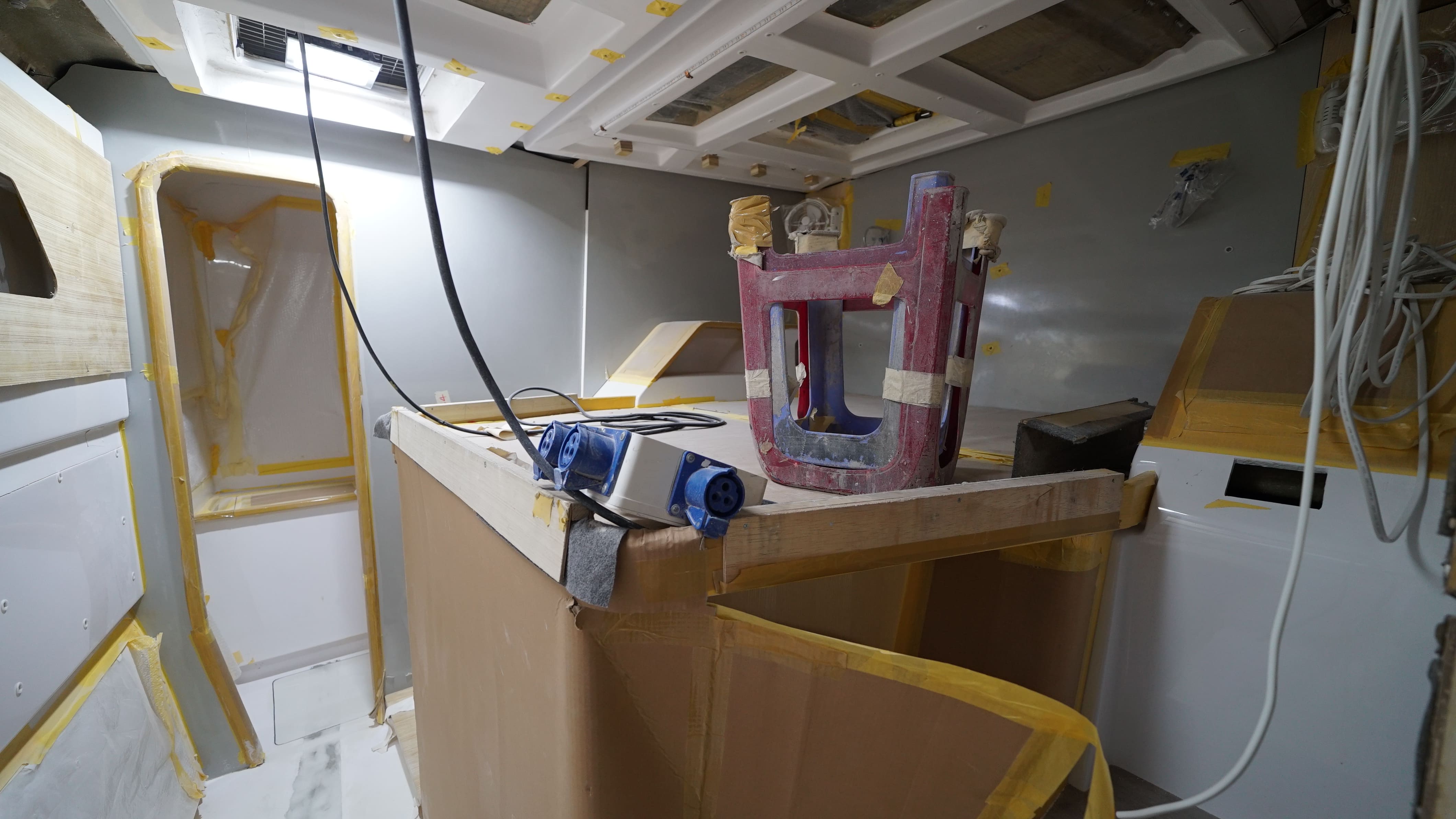

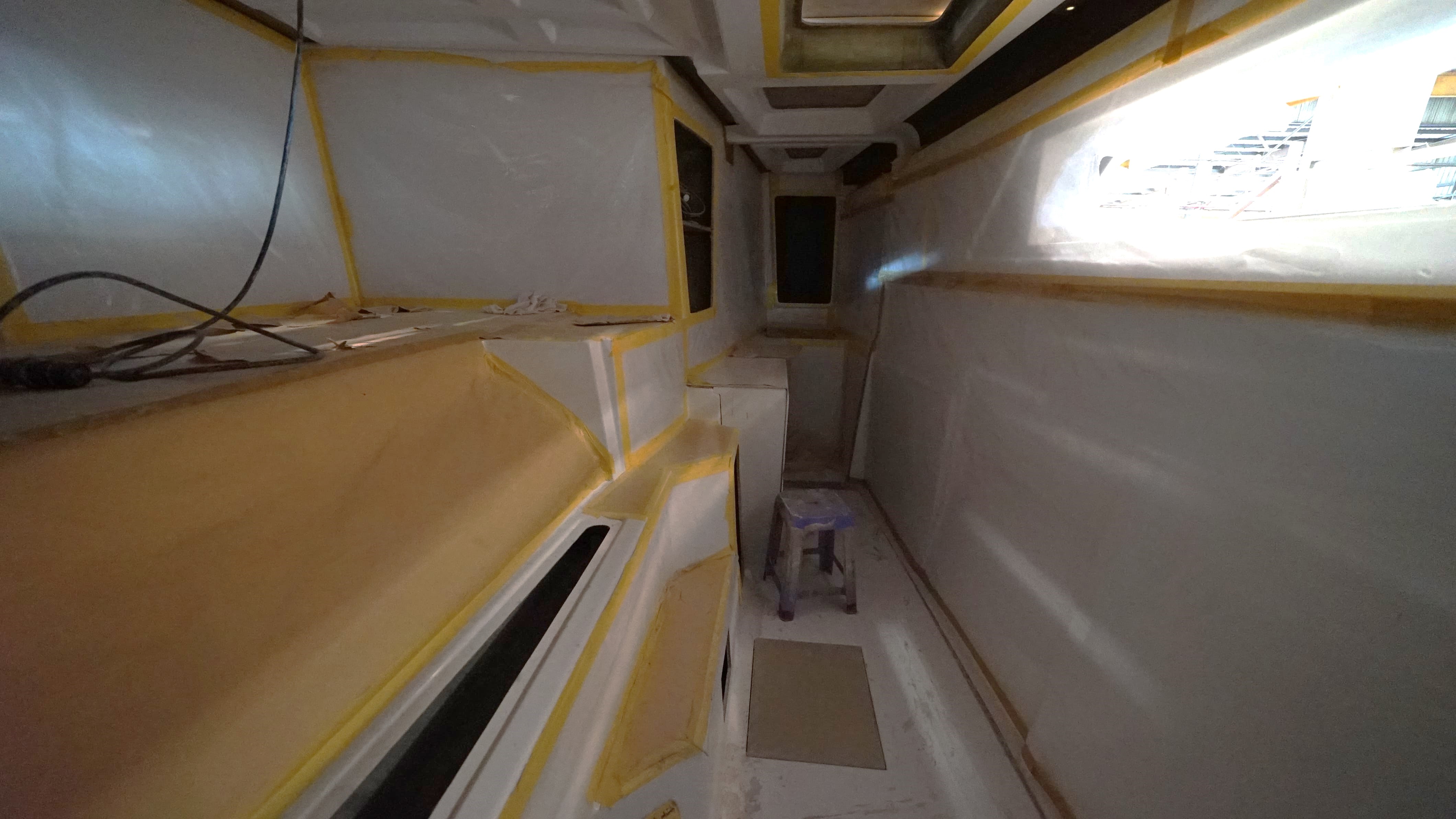

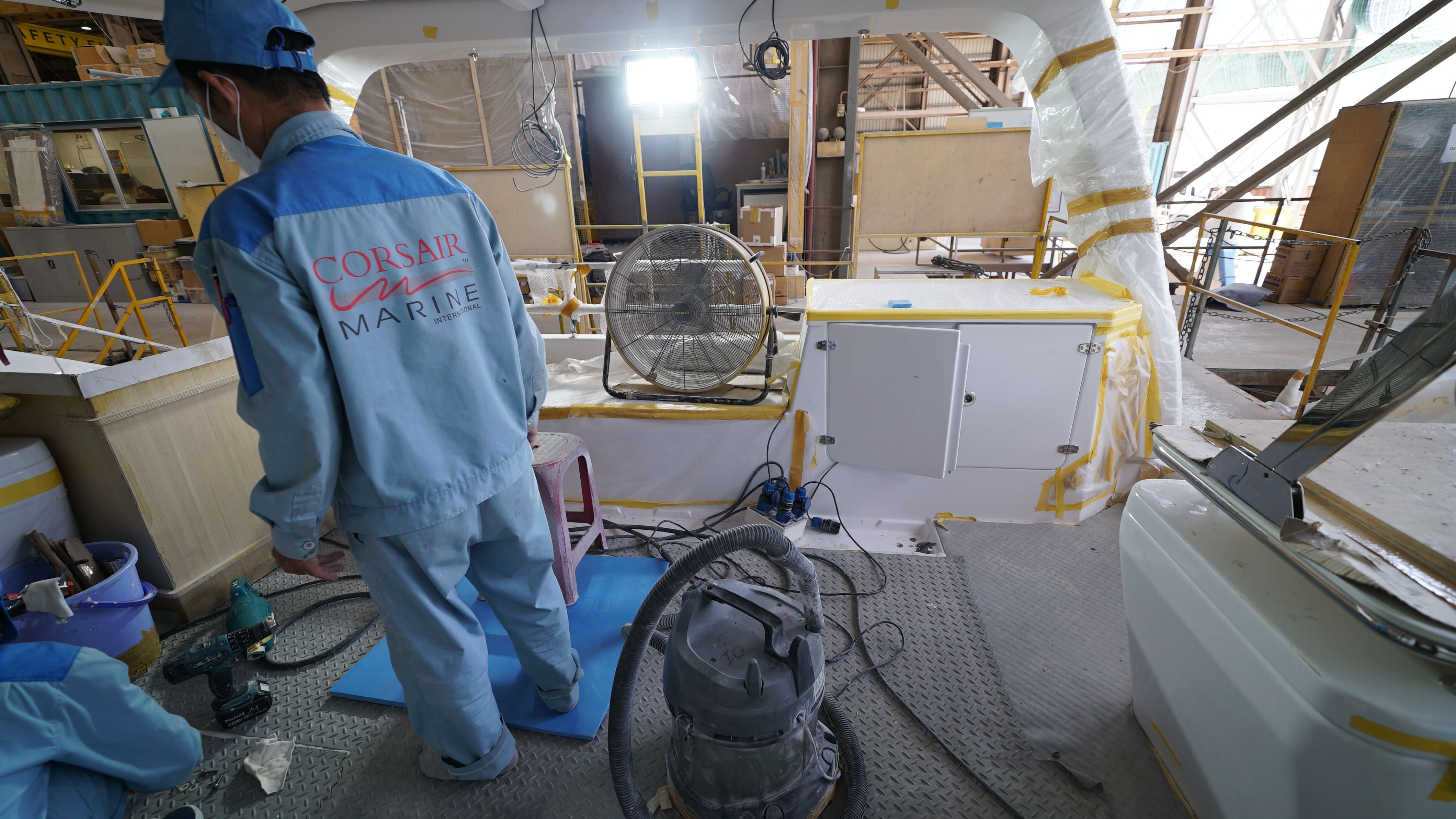

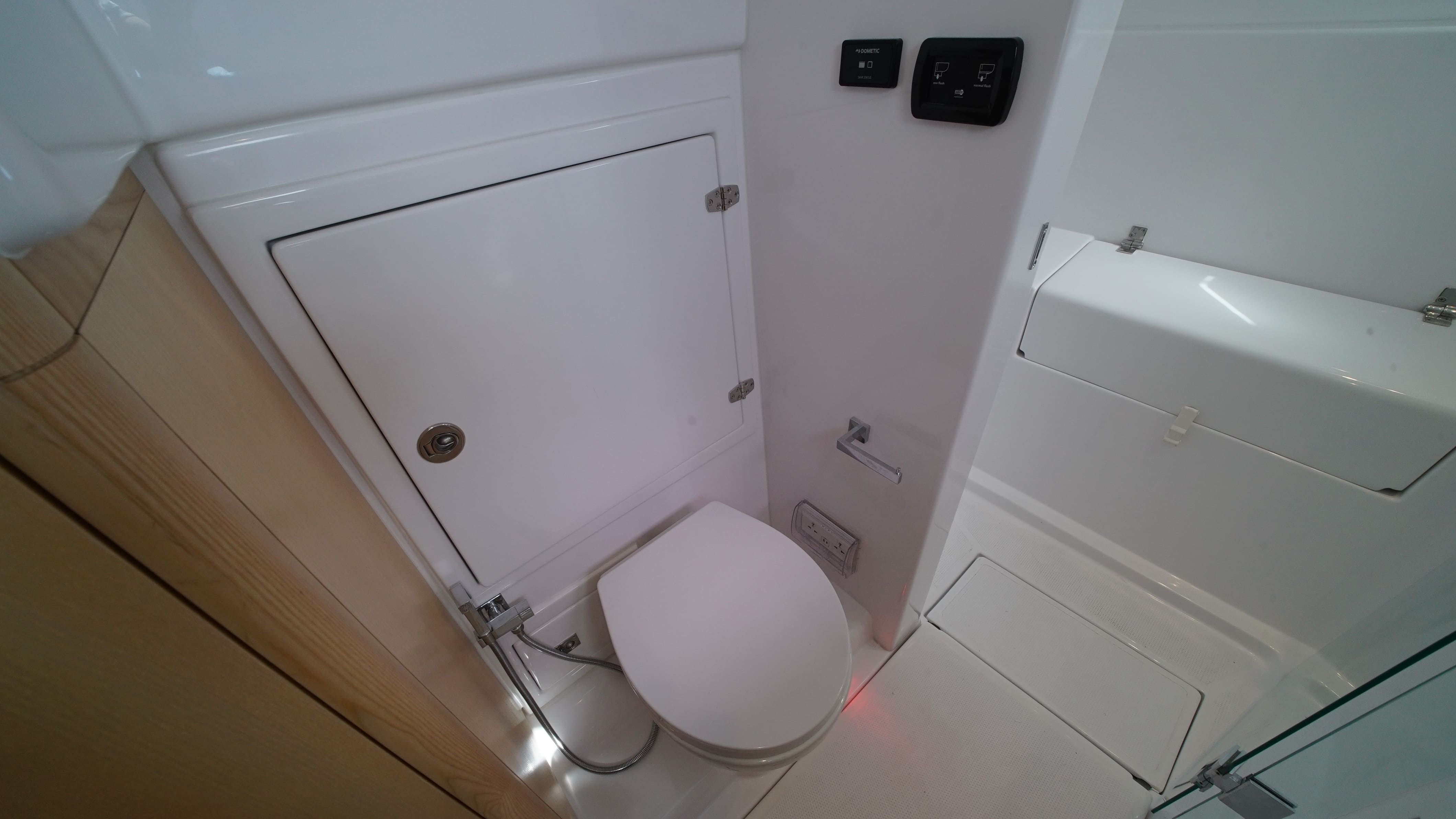

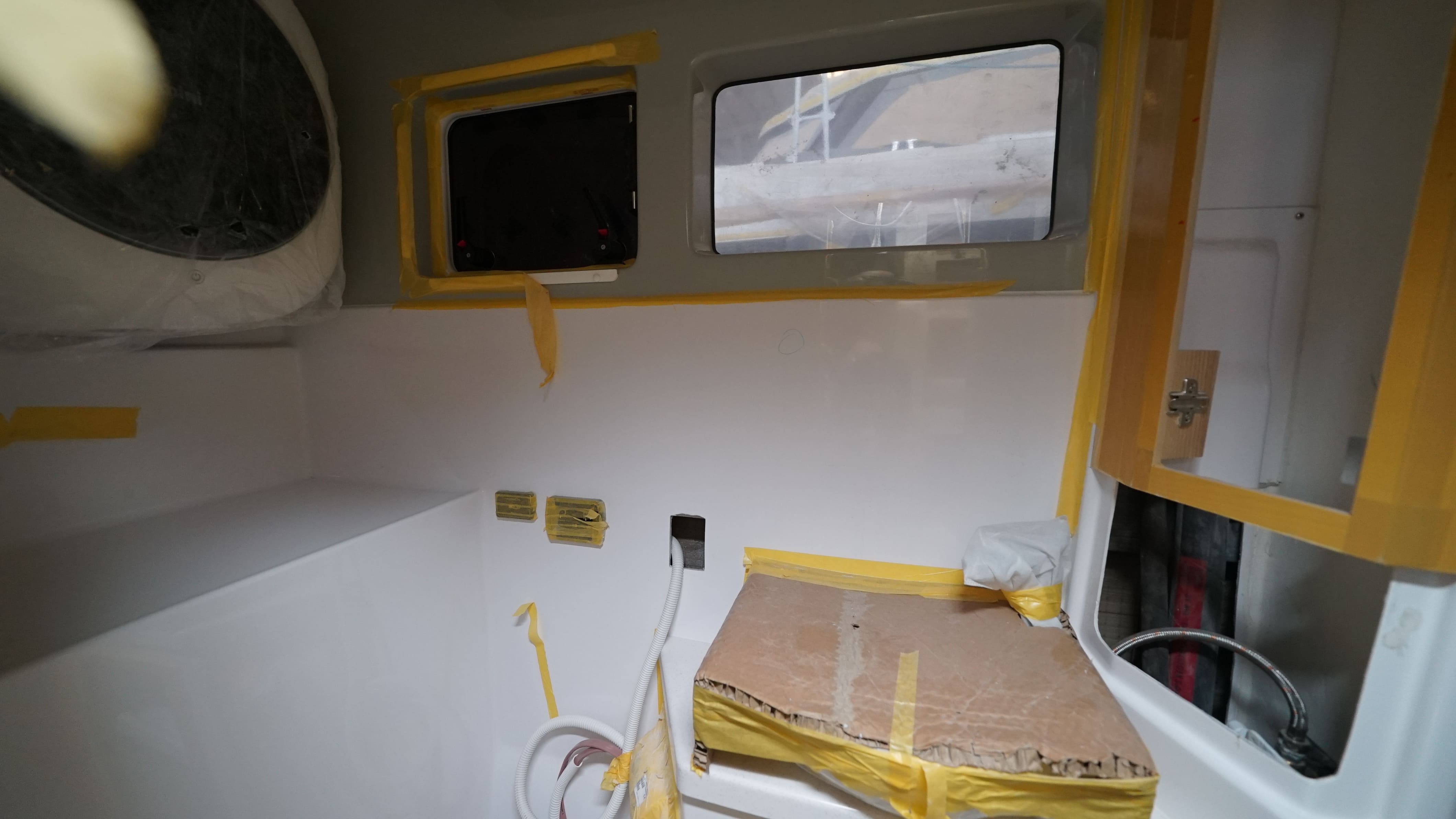

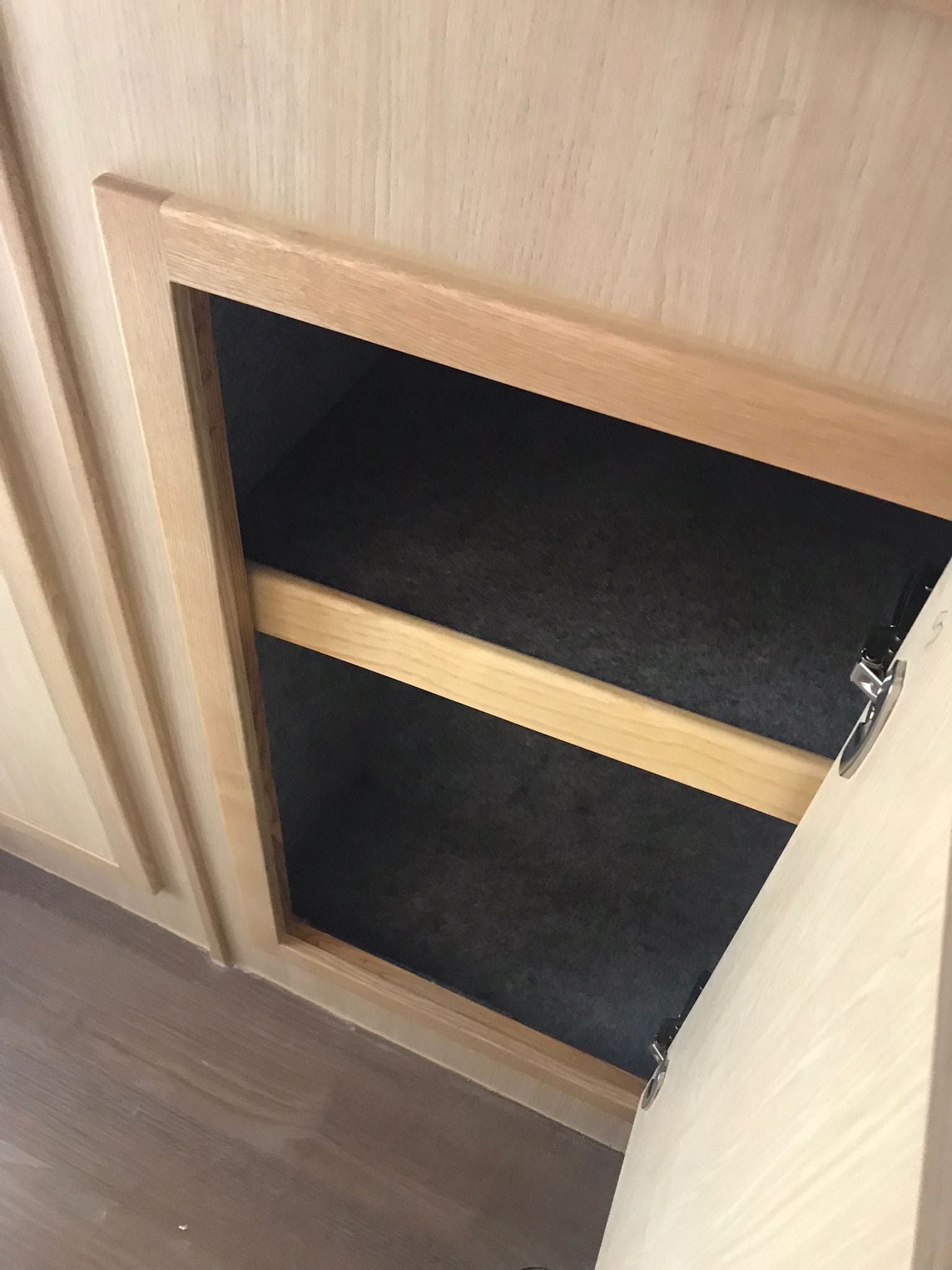

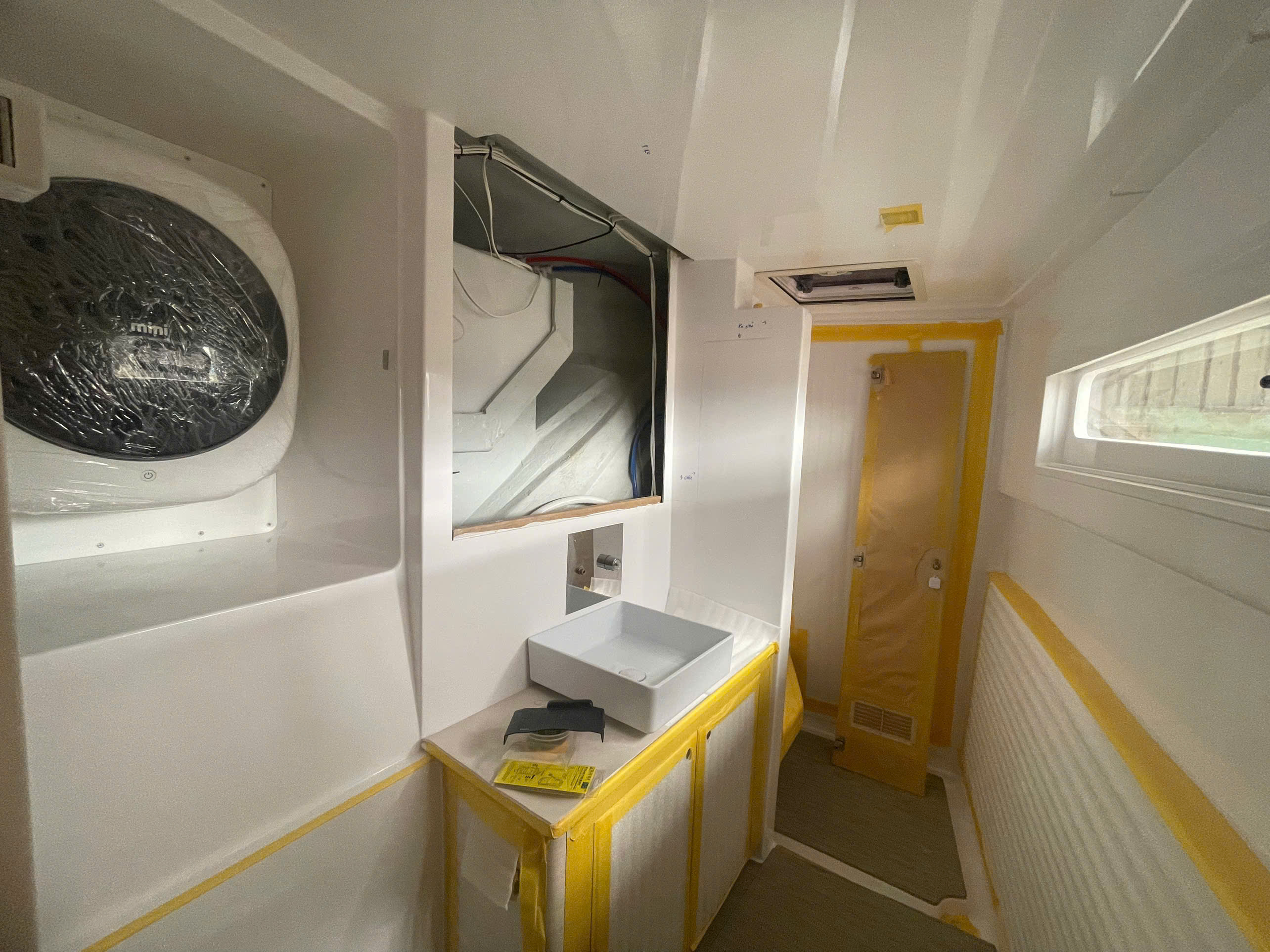

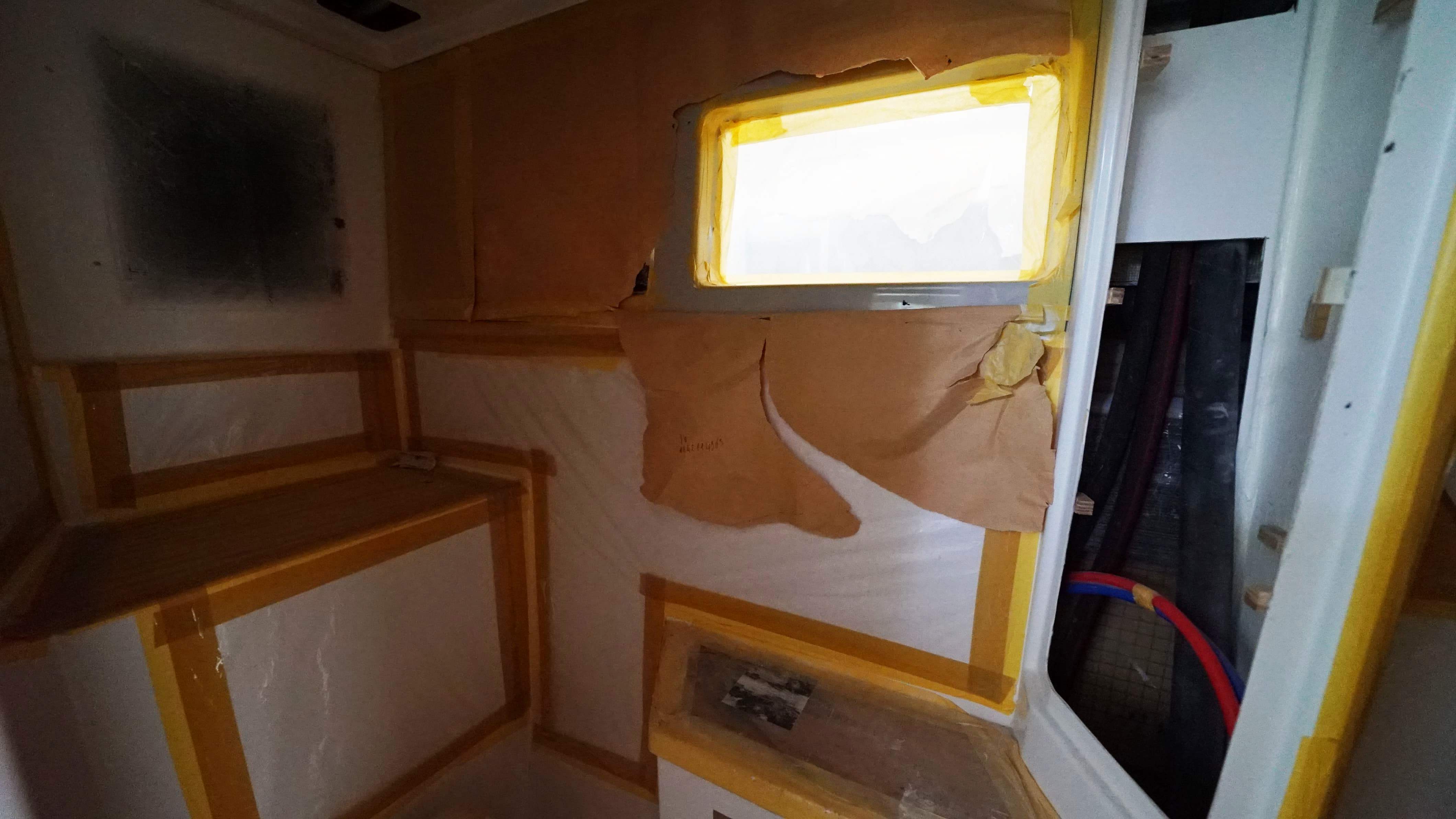

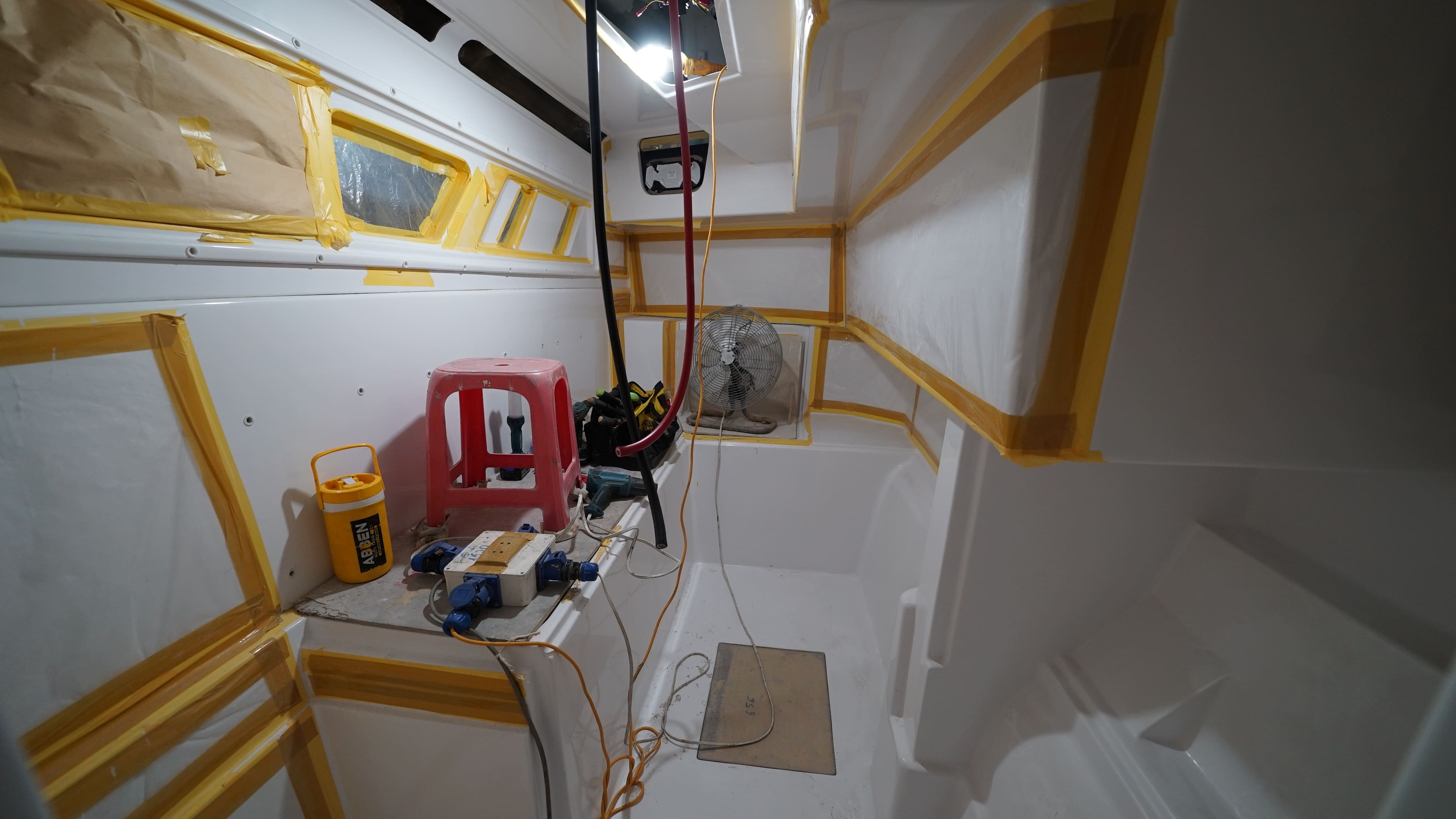

Our Production team is currently working on stanchion (75%), windows & hatches (40%), deck hardware (40%), electric (35%), plumbing & LPG (35%), steering (20%), and gelcoat at 85%.

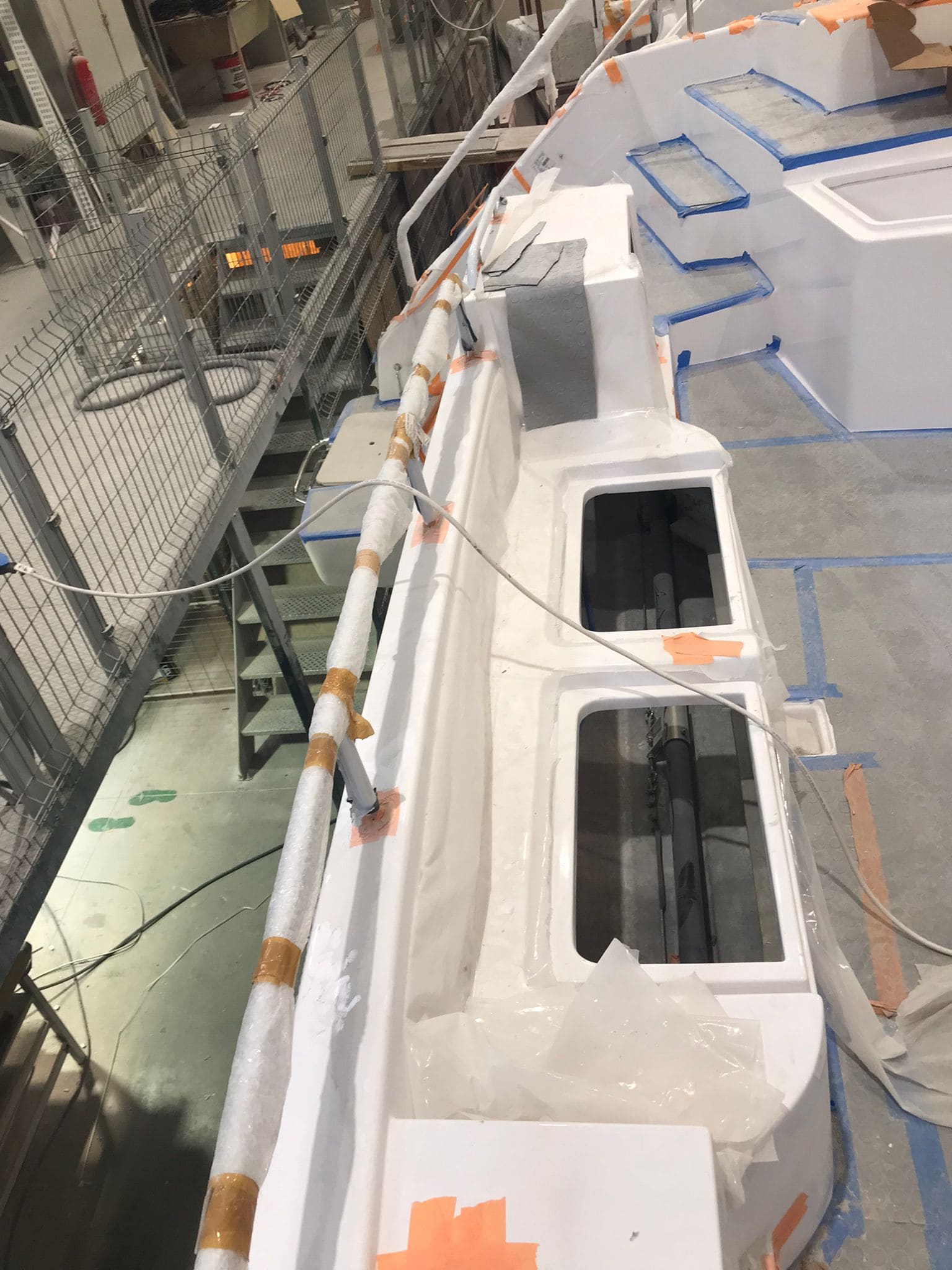

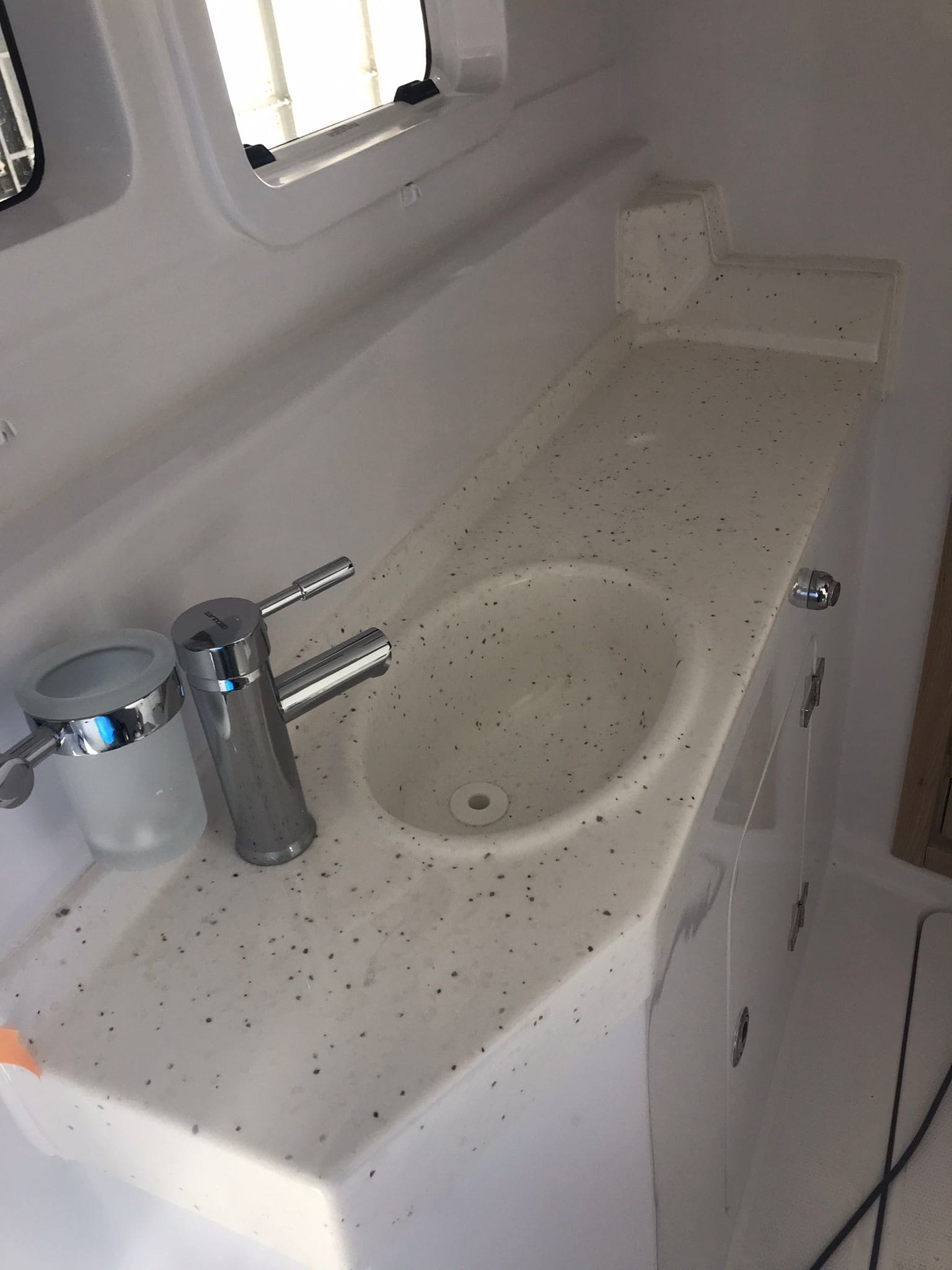

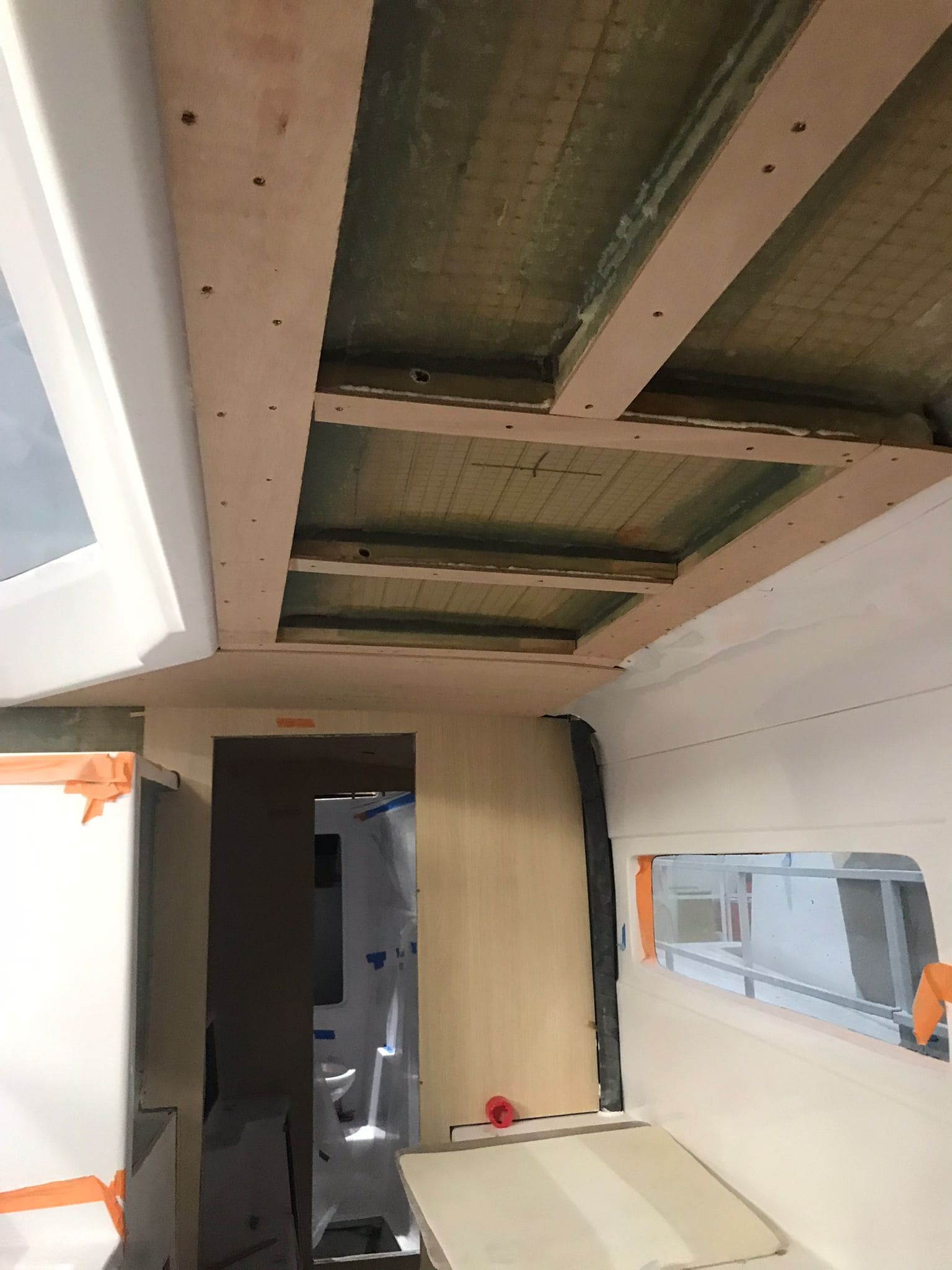

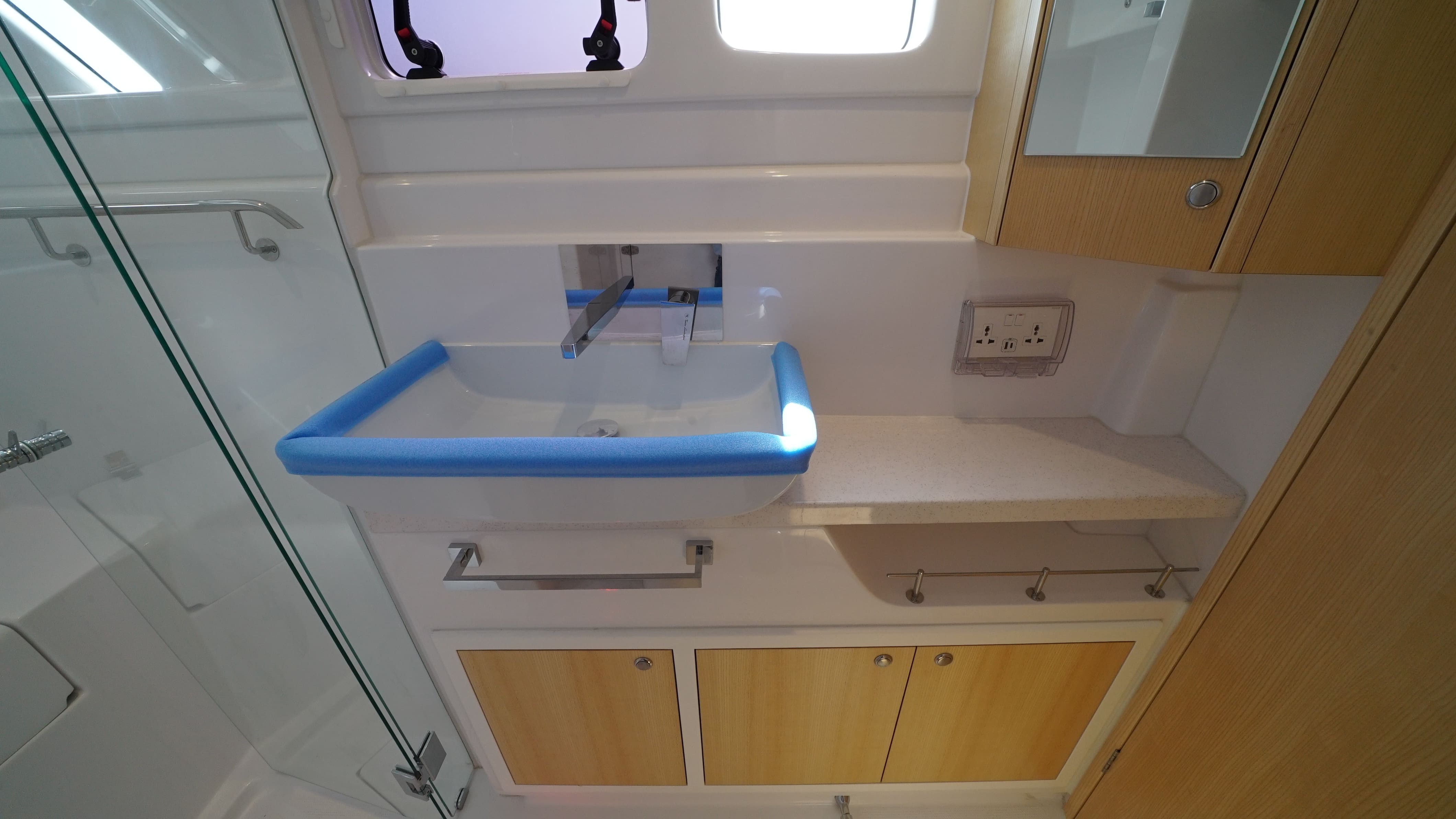

Production Update – Fit out

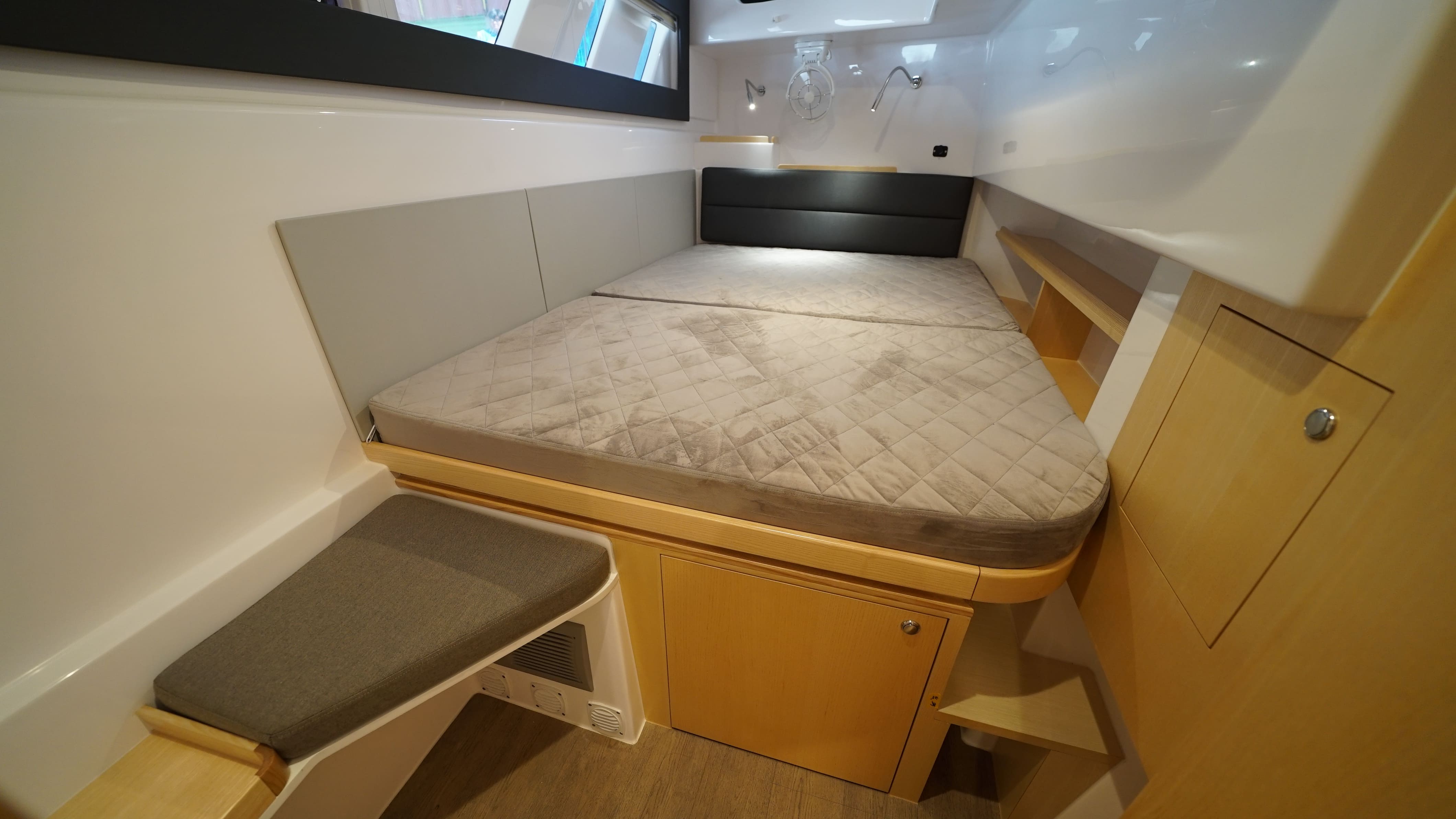

It is excited that your boat has been progressing well in the Fit out stage.

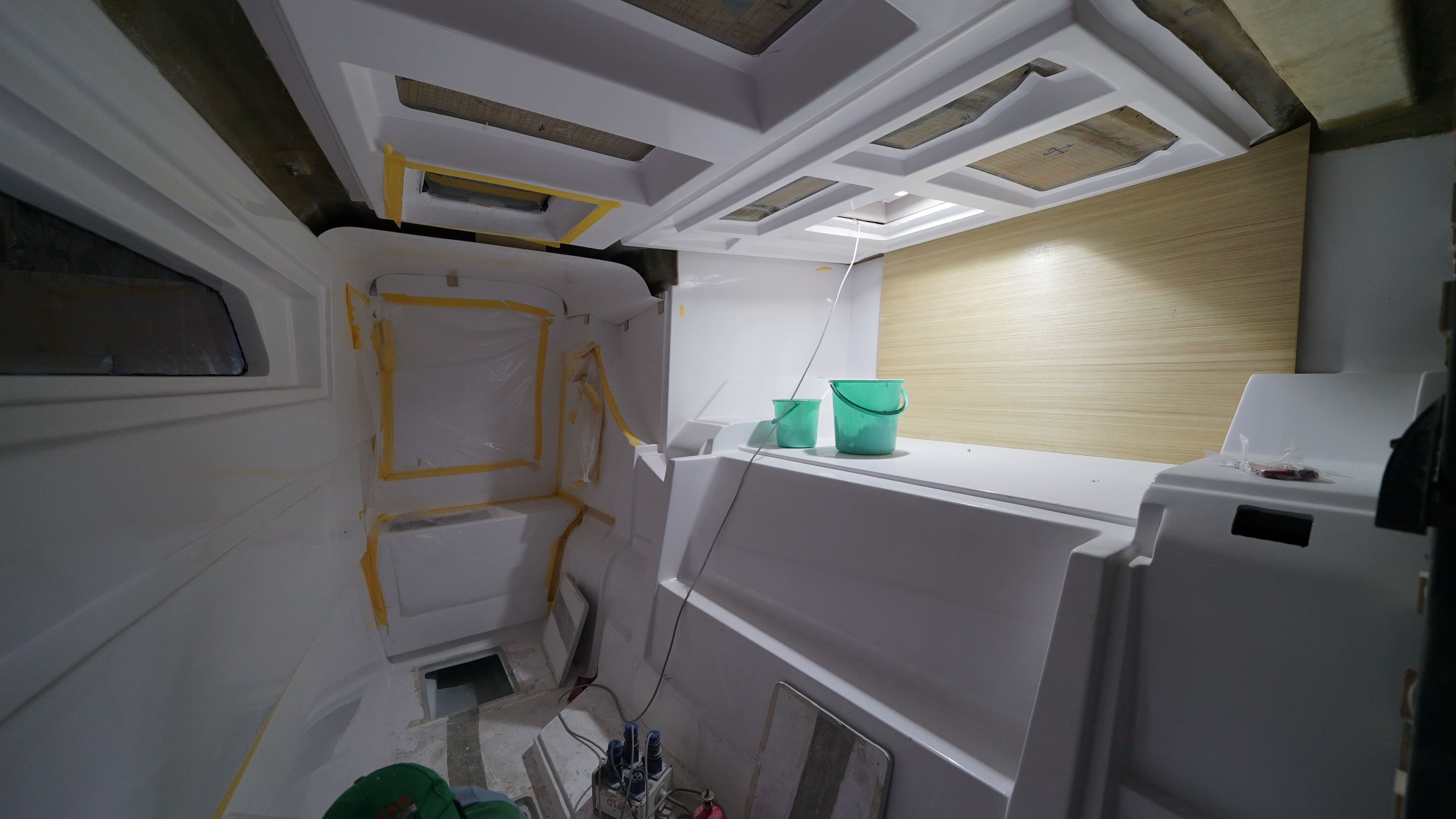

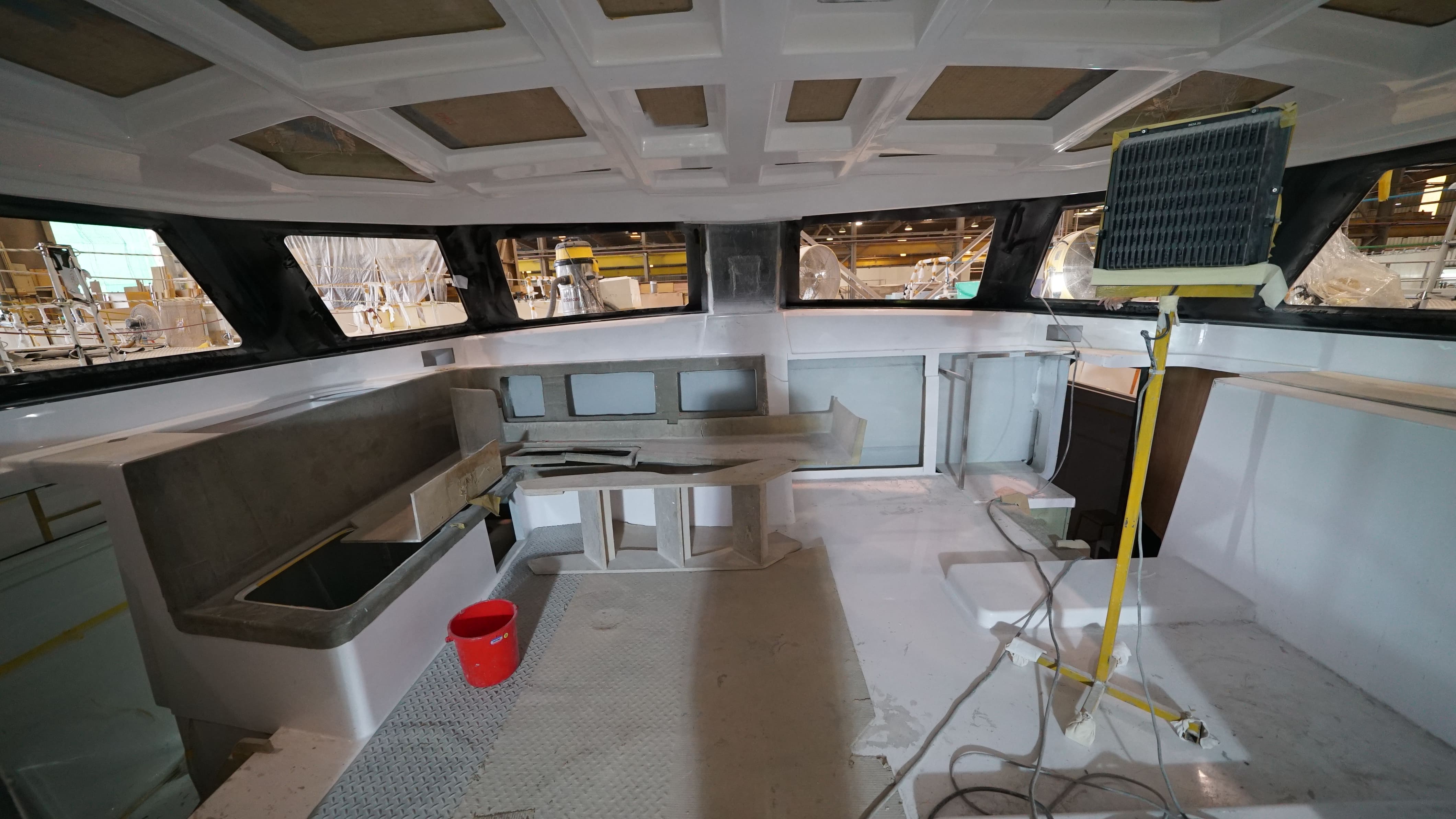

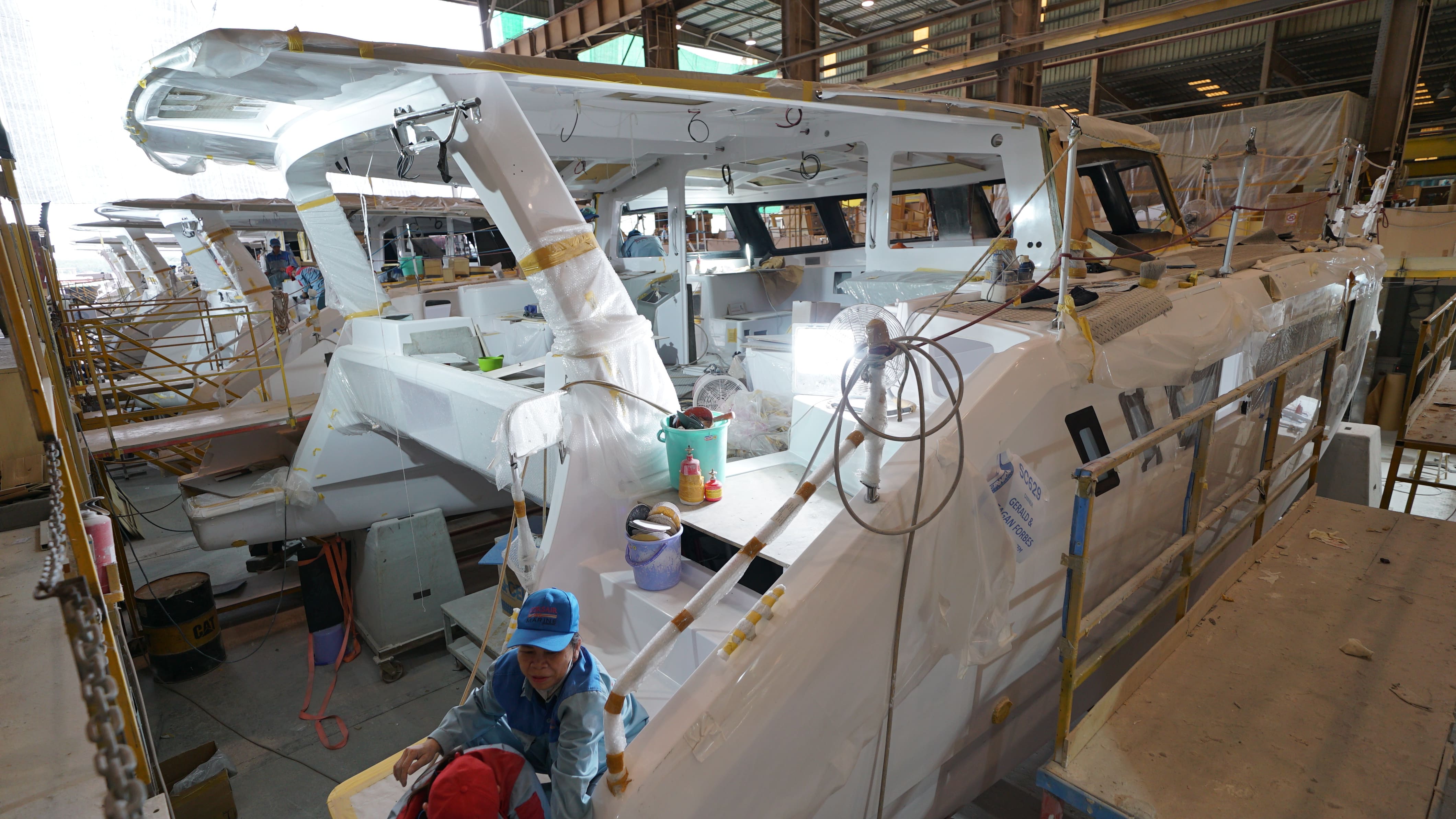

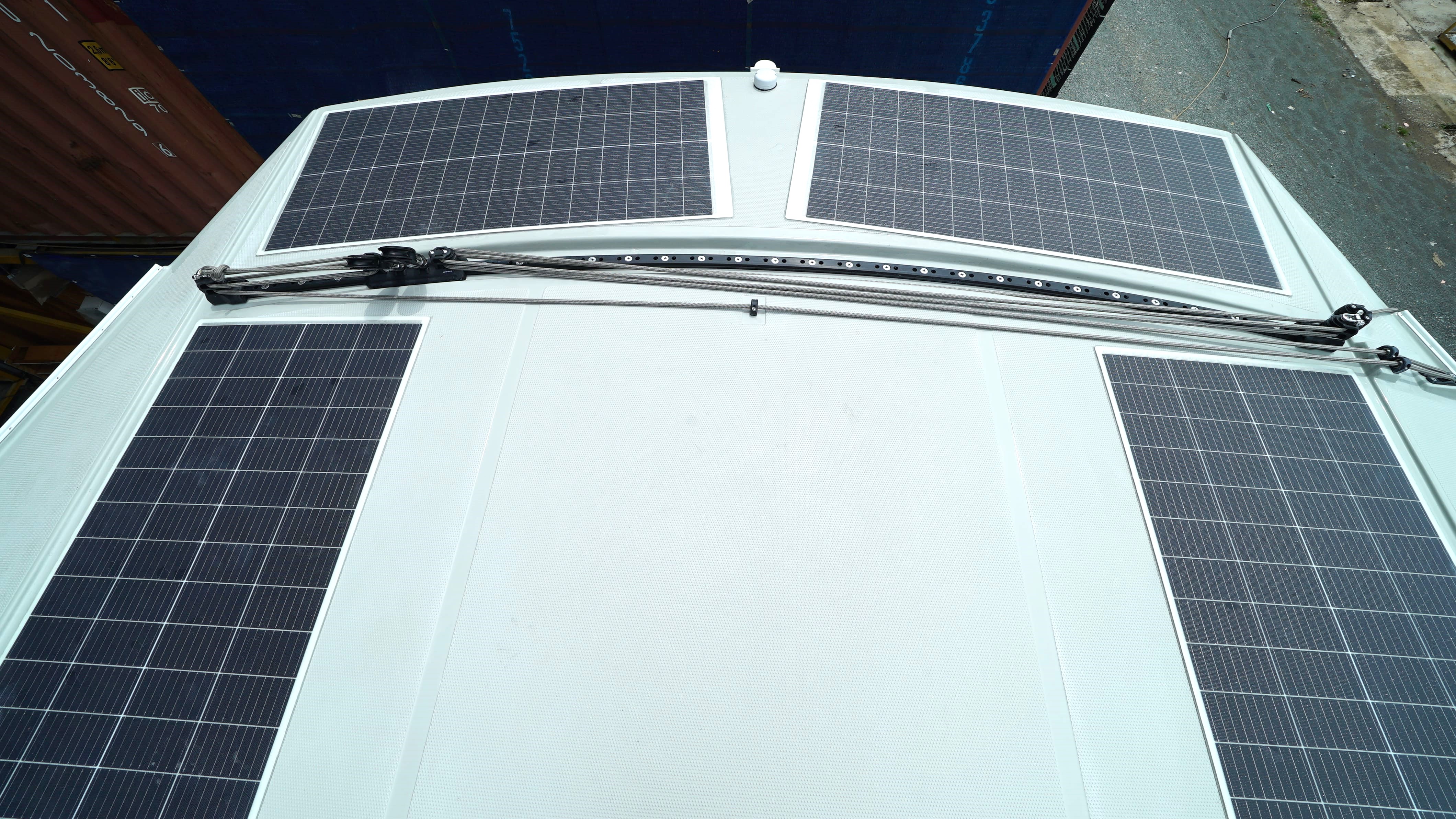

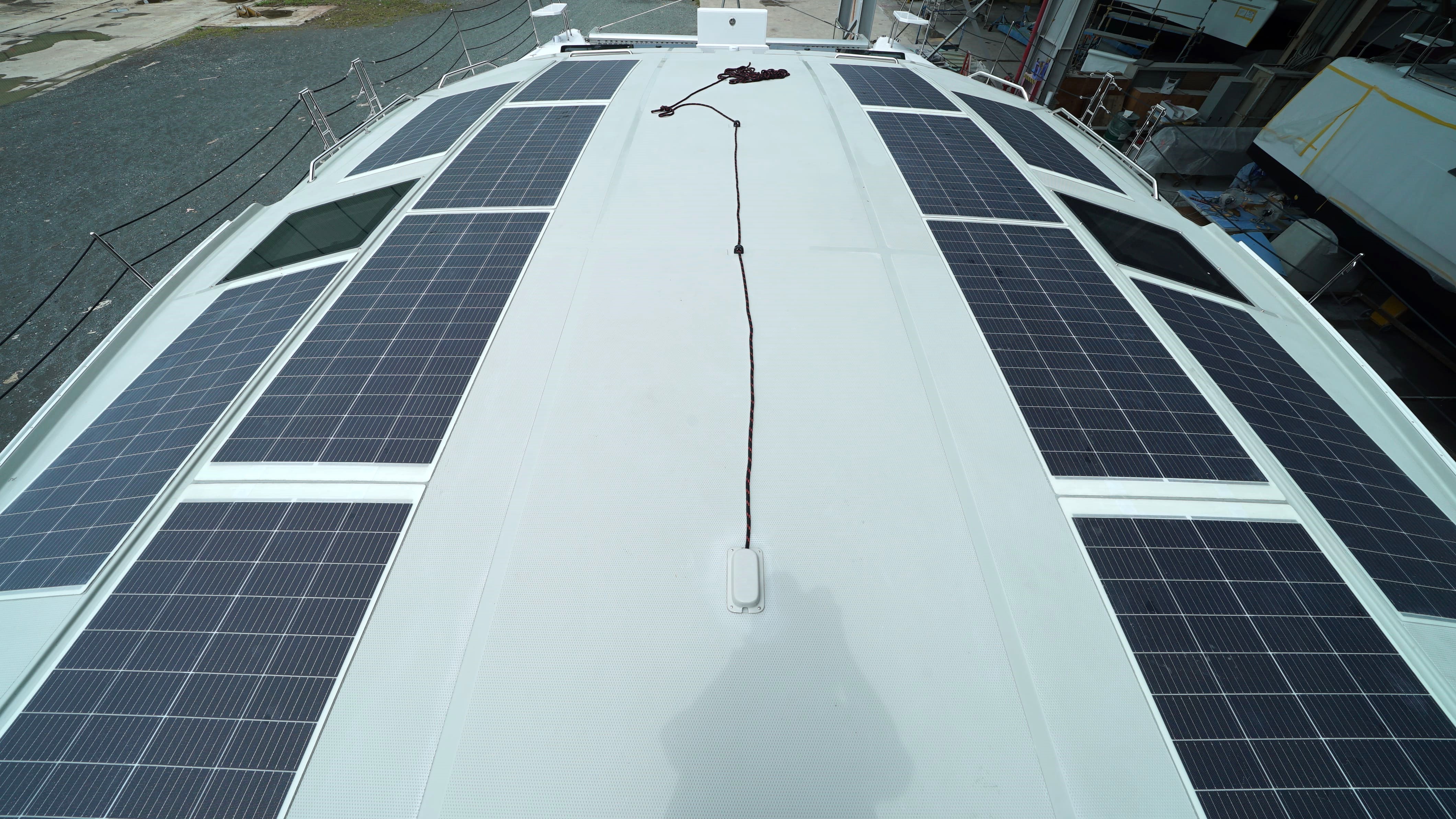

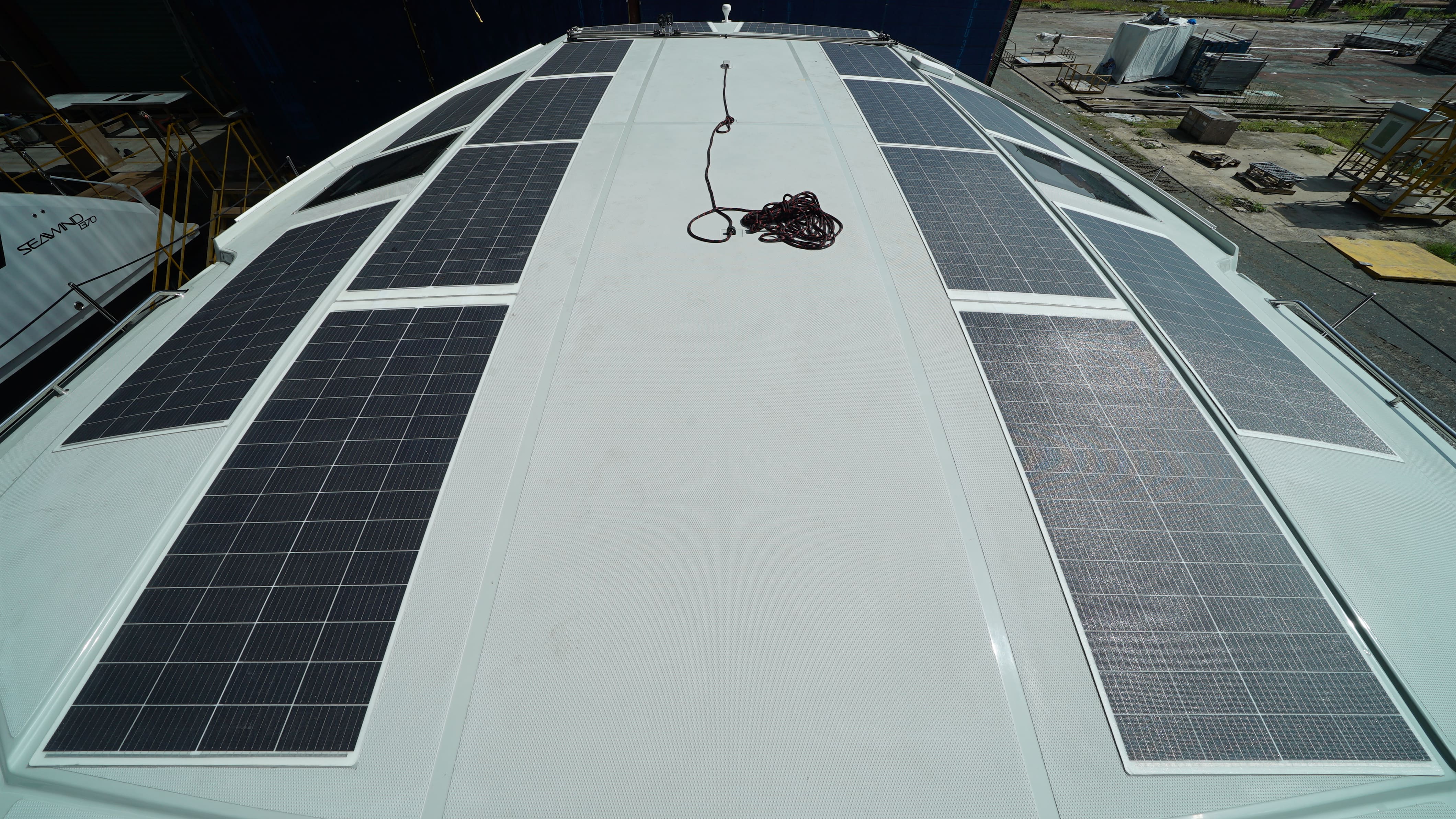

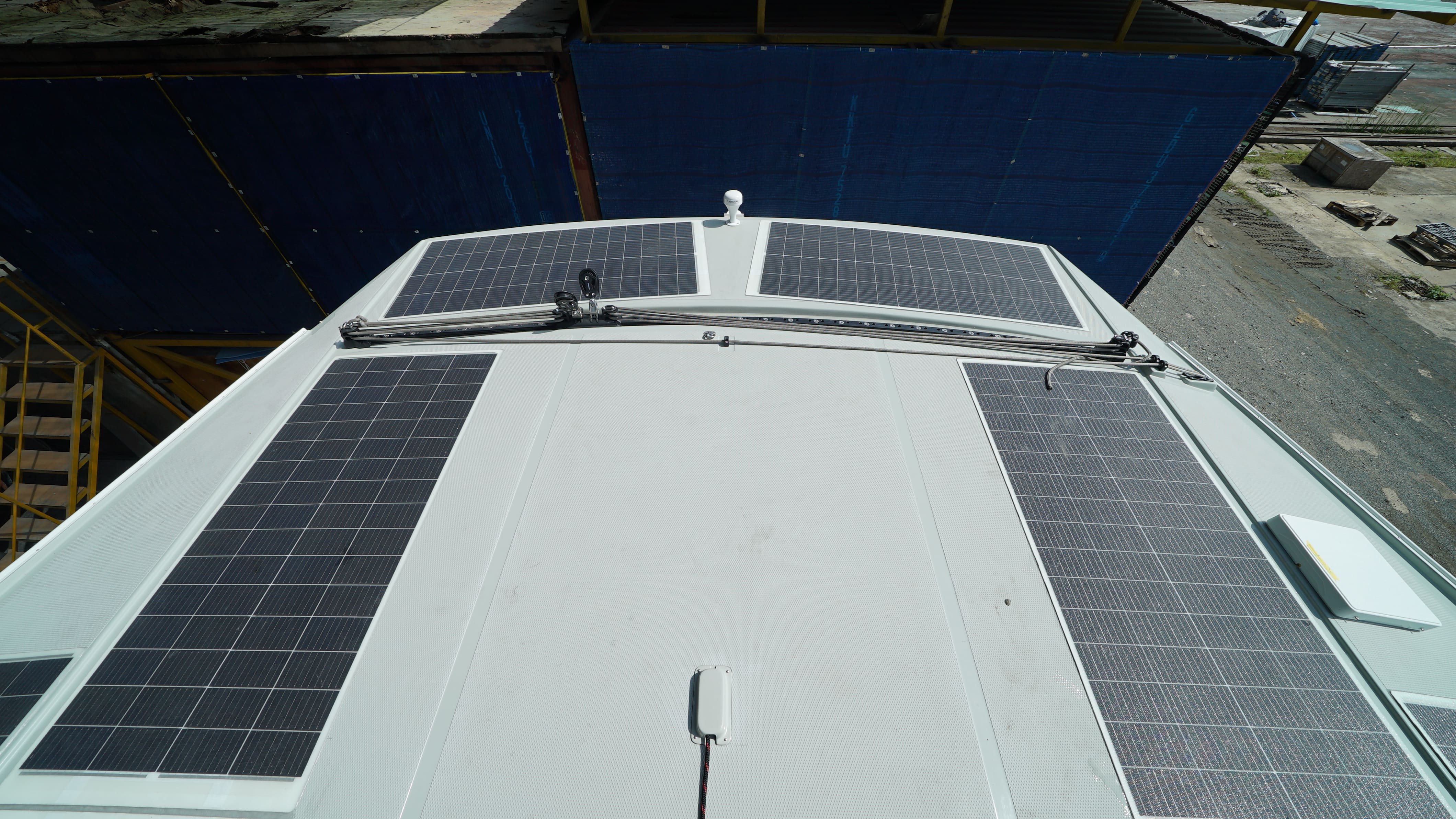

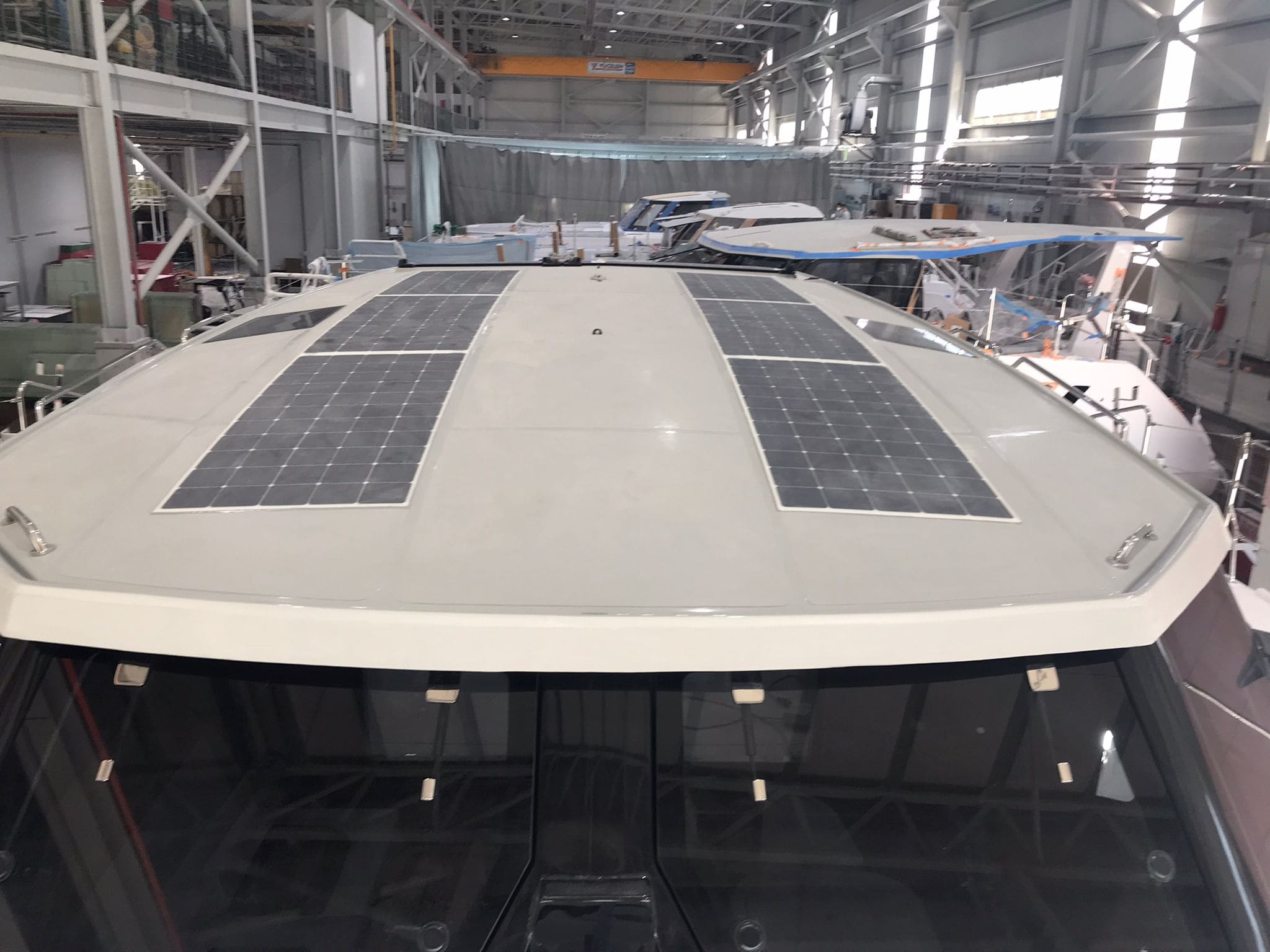

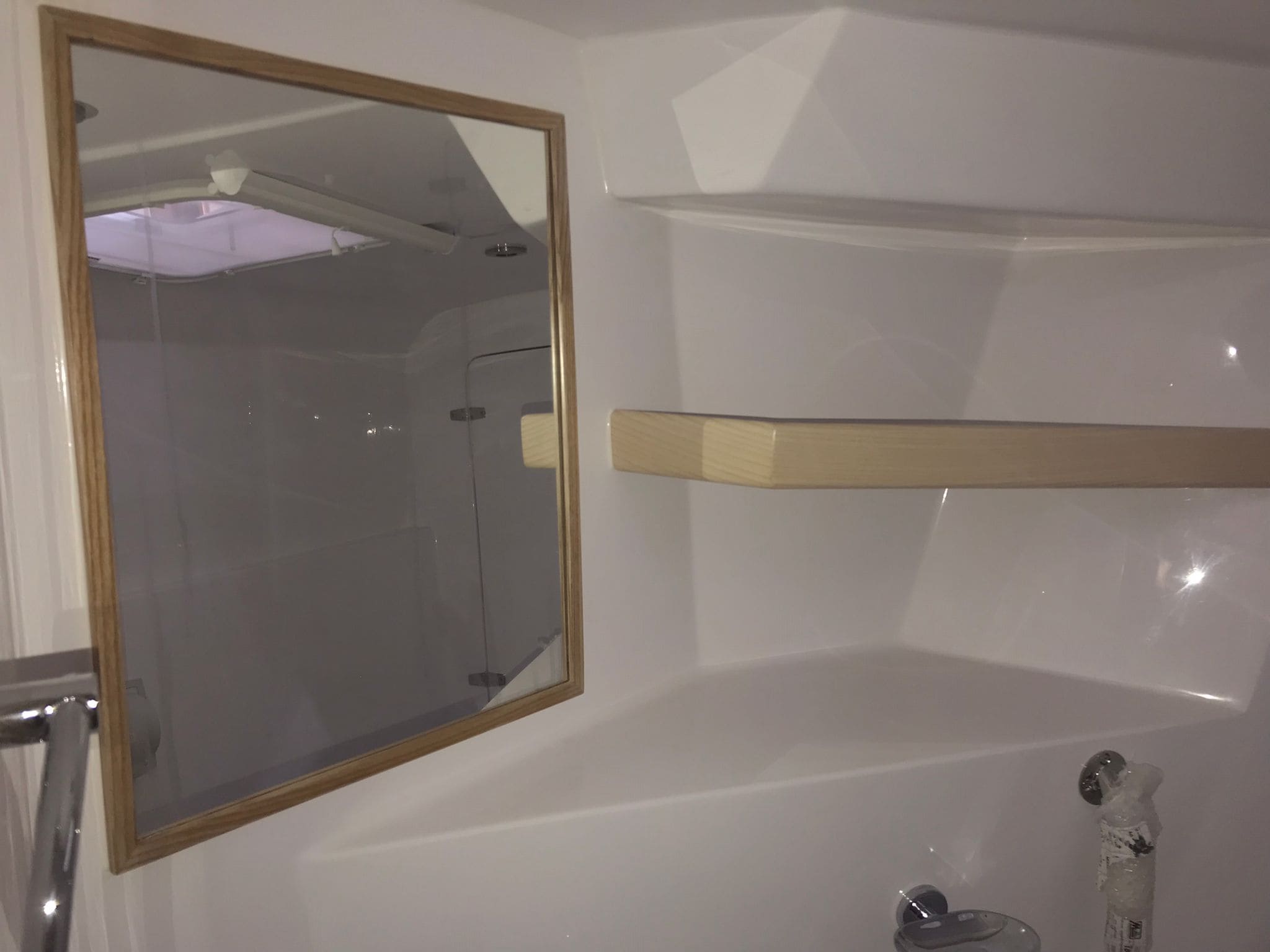

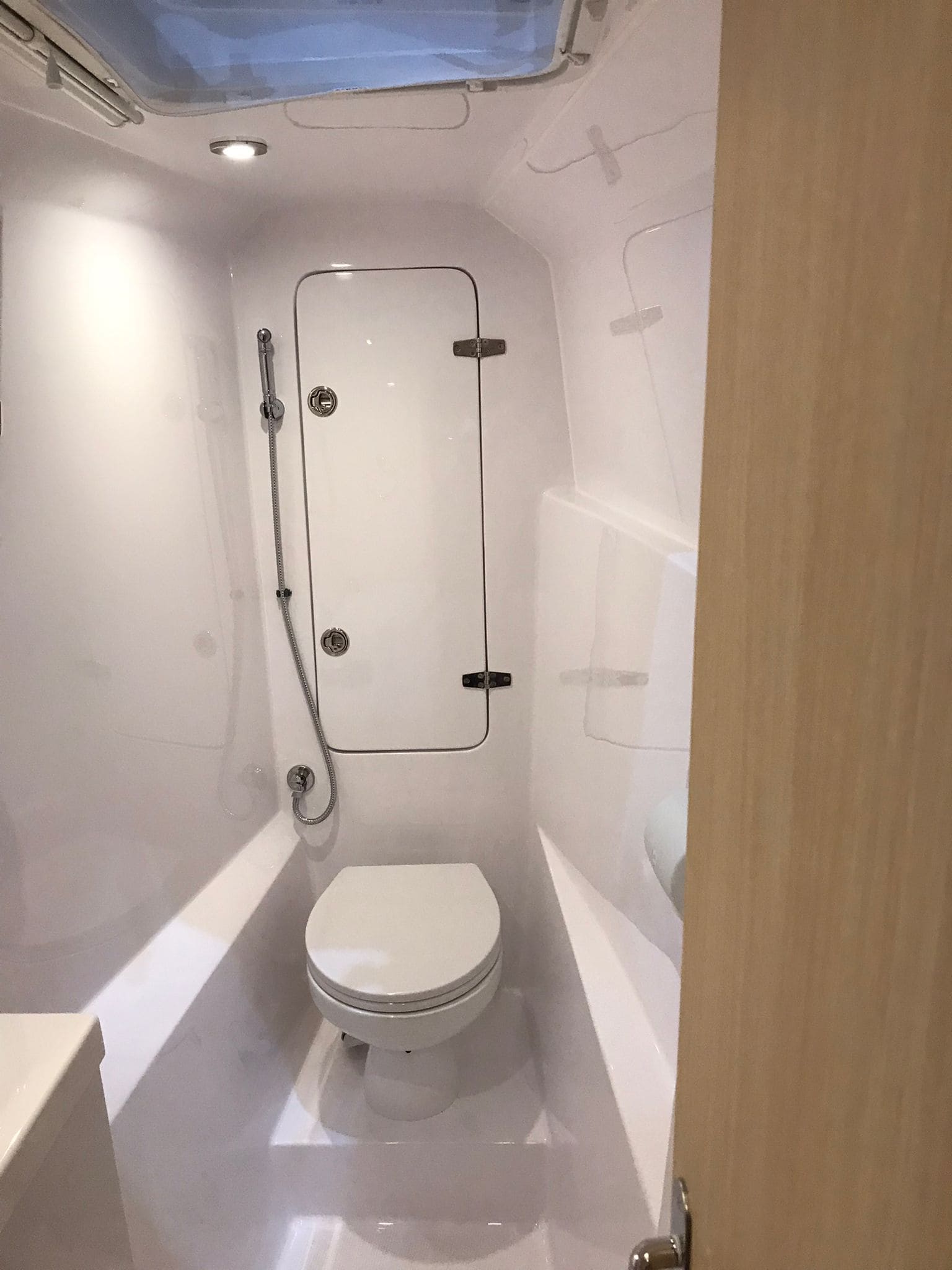

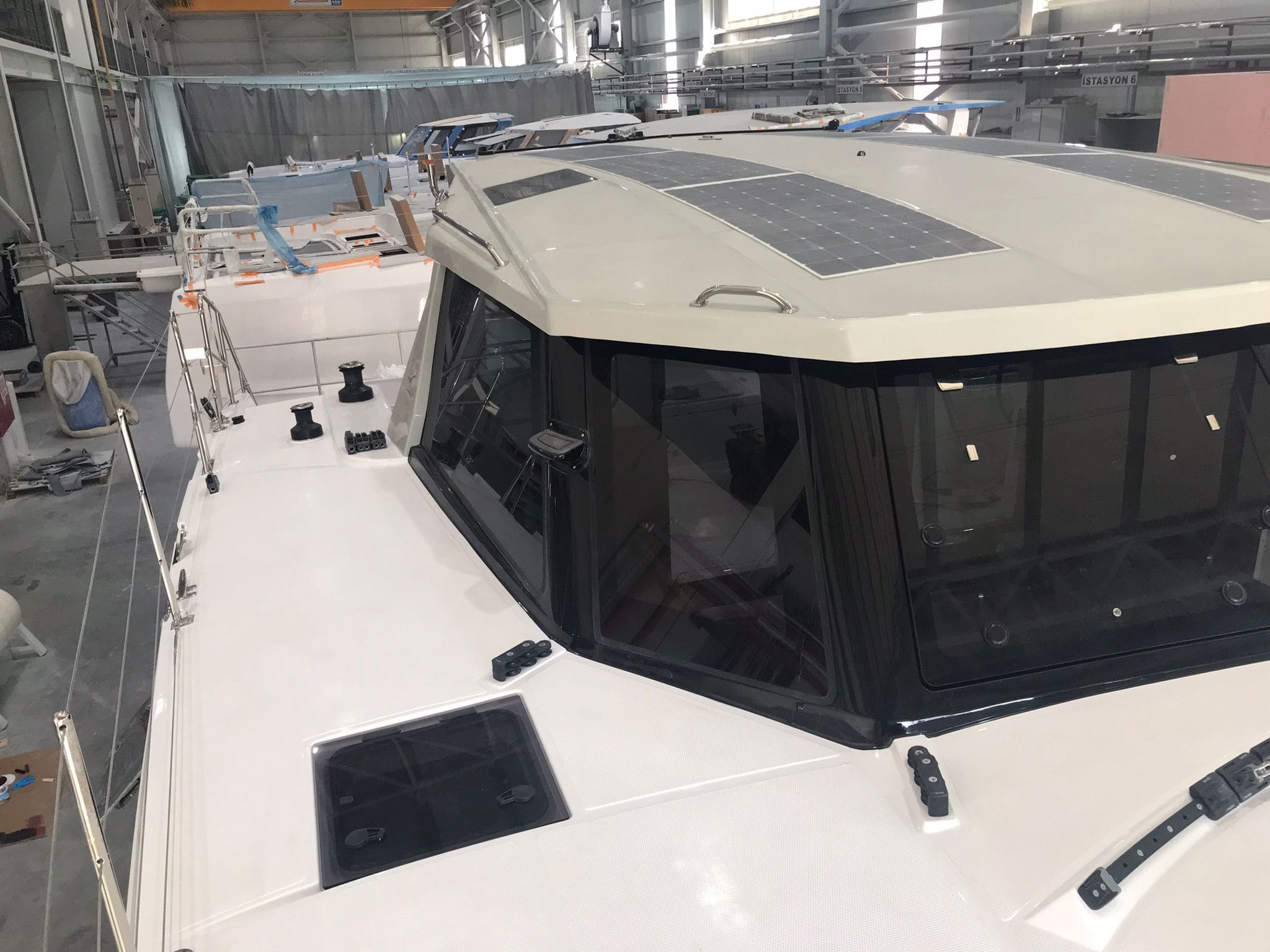

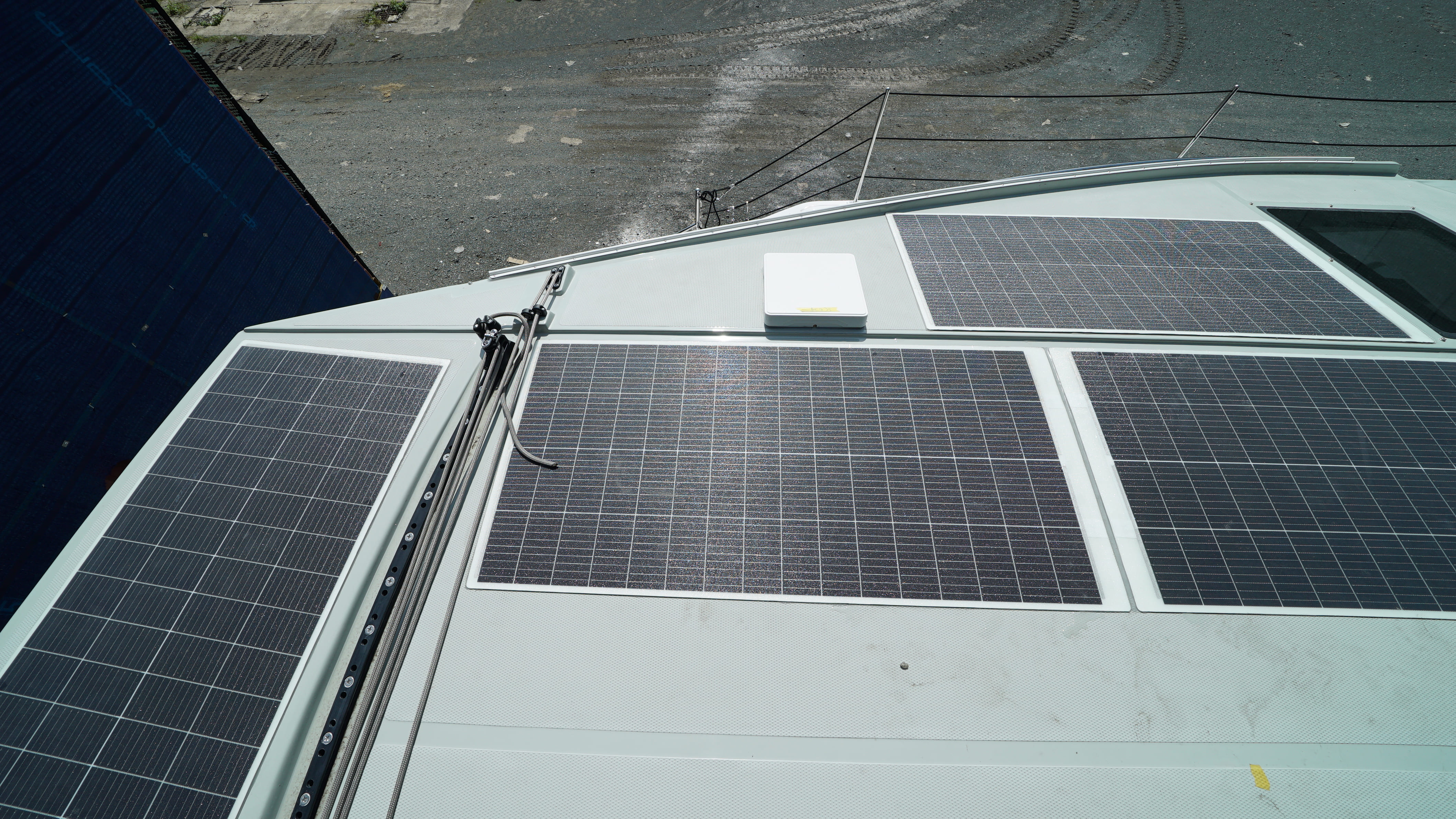

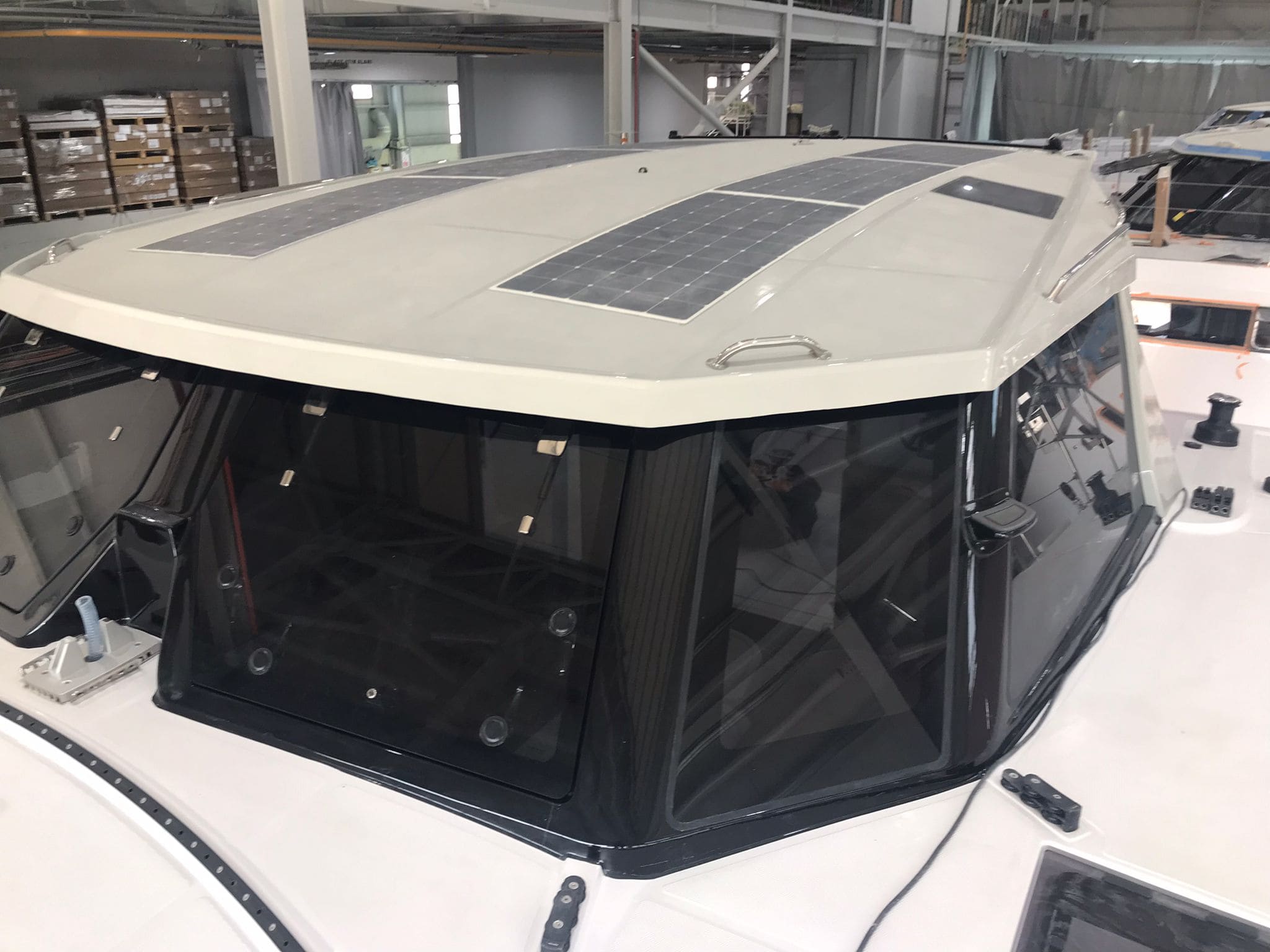

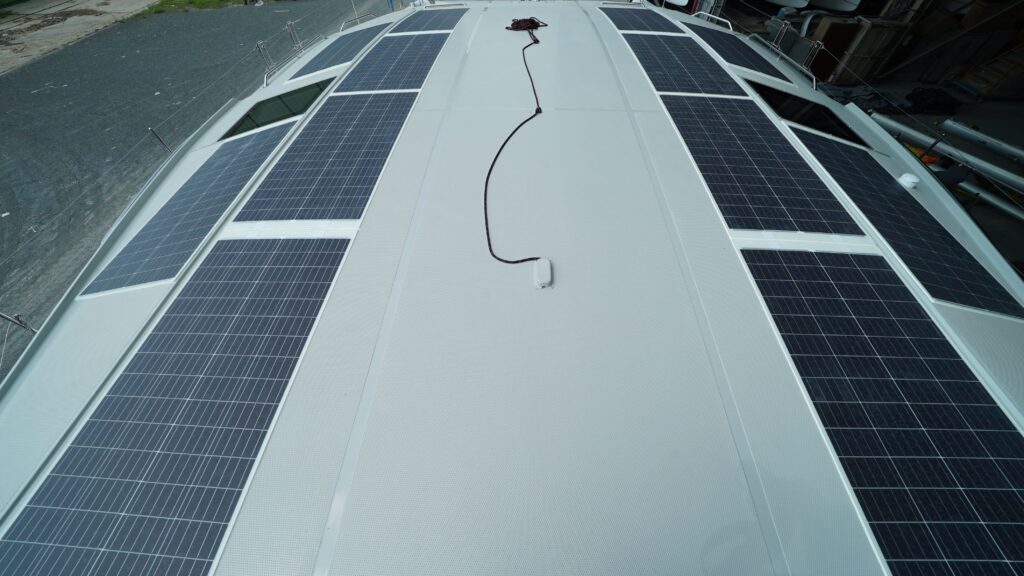

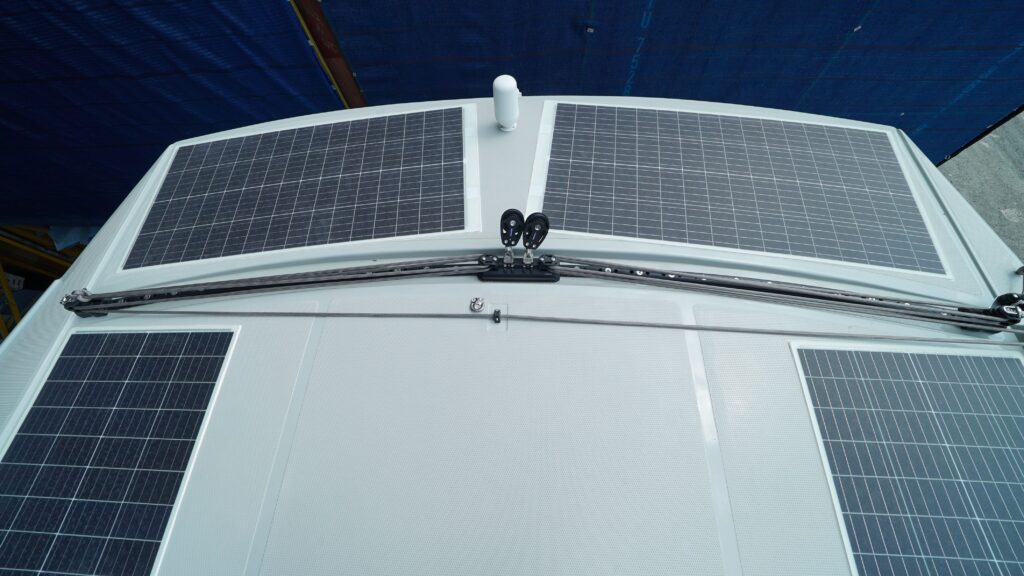

We recently completed the installation of windows & hatches, solar panels, A-frame, and fwd beam.

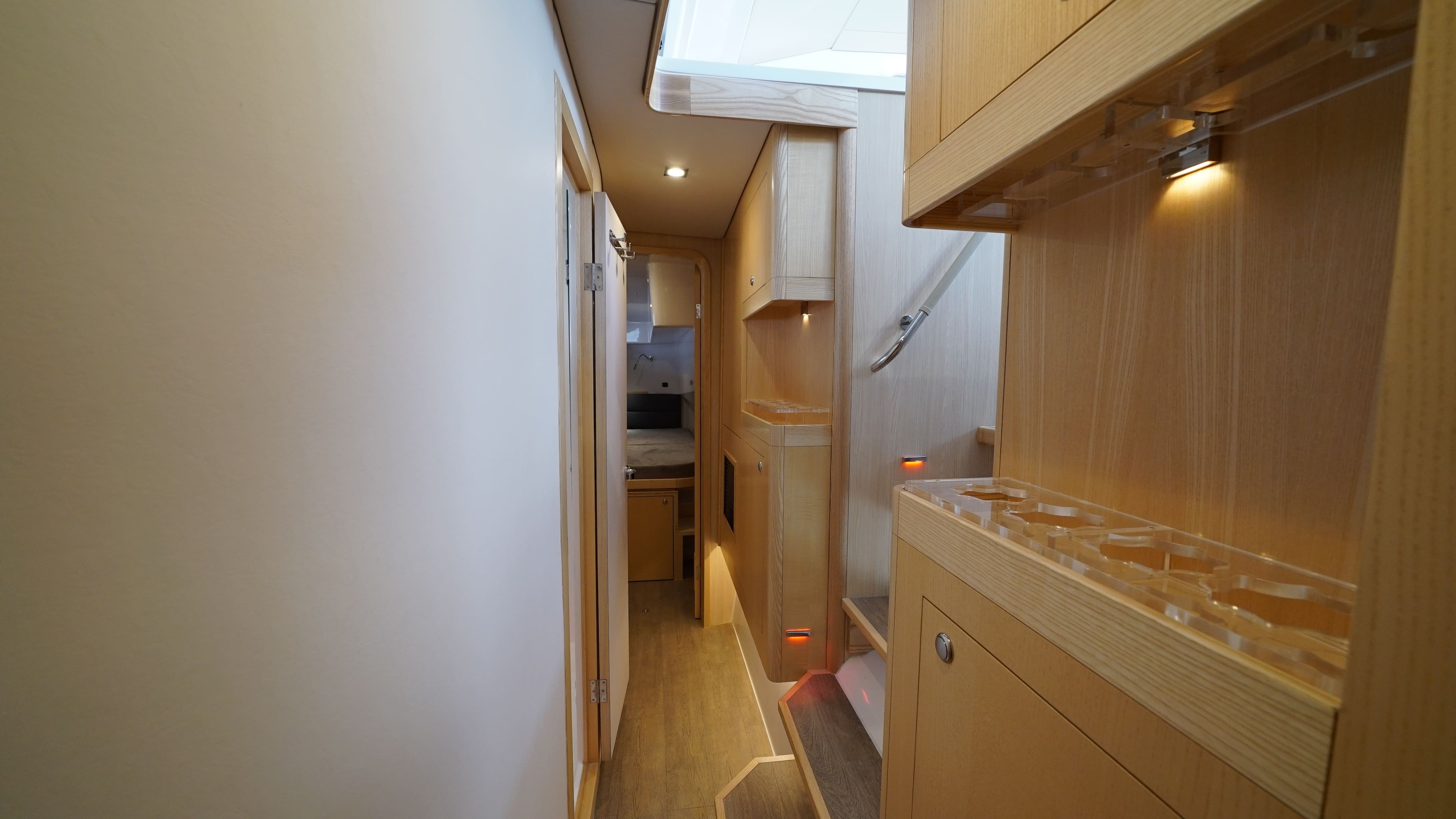

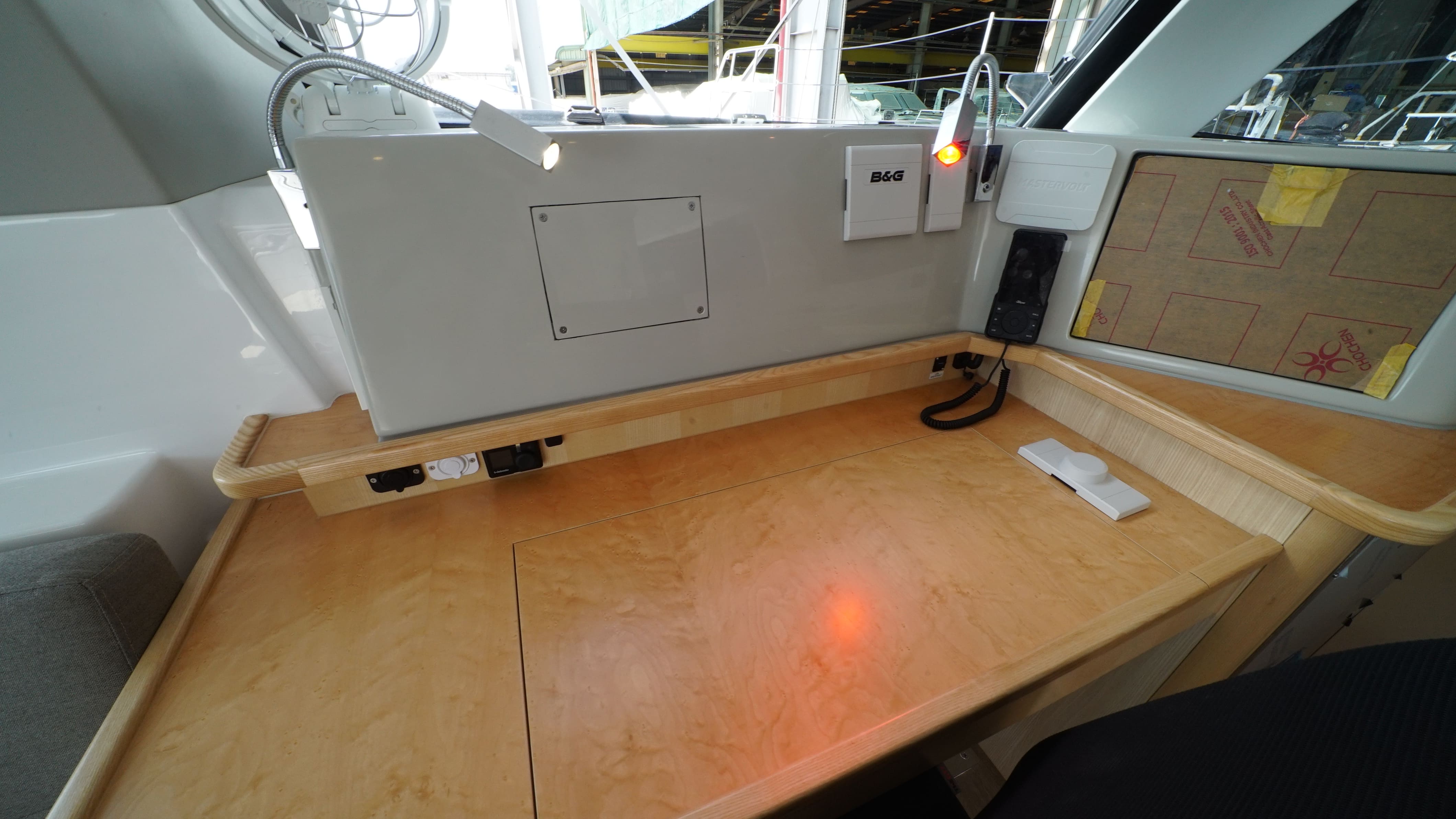

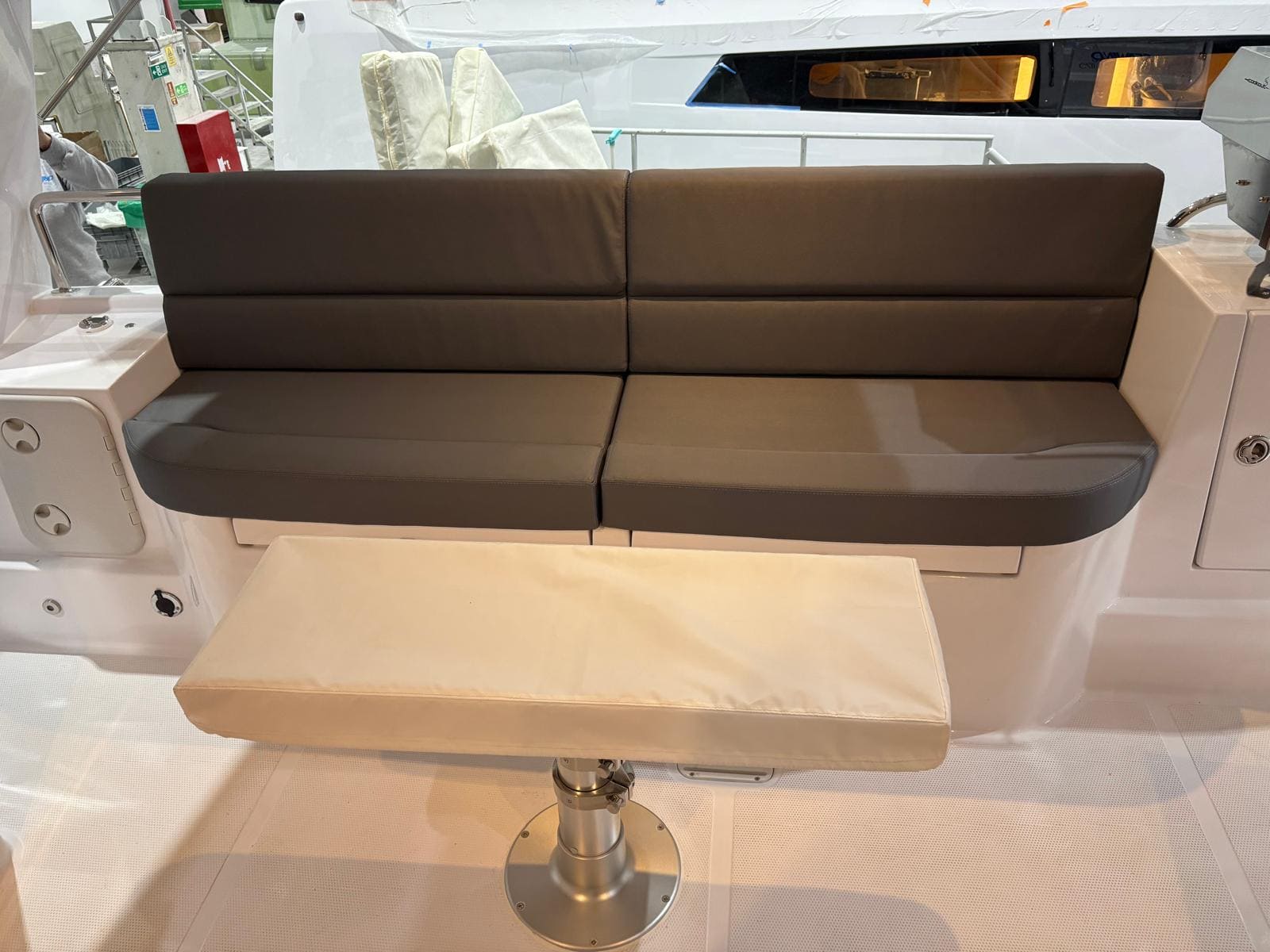

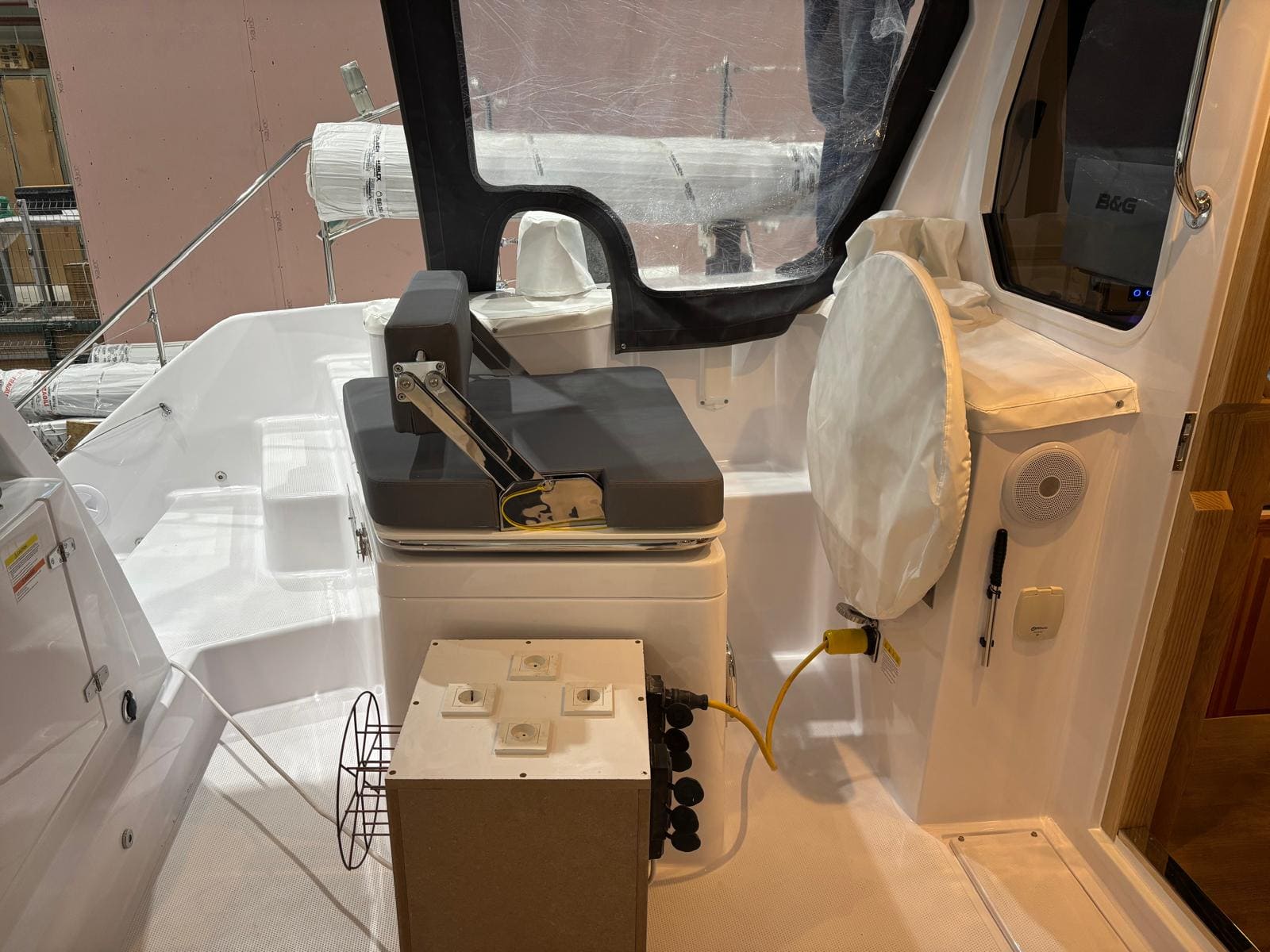

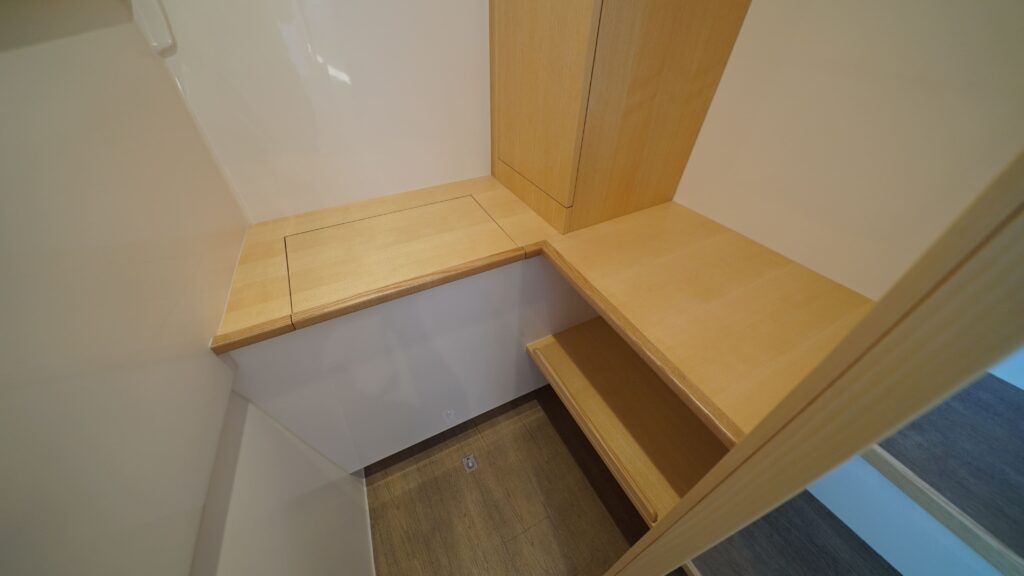

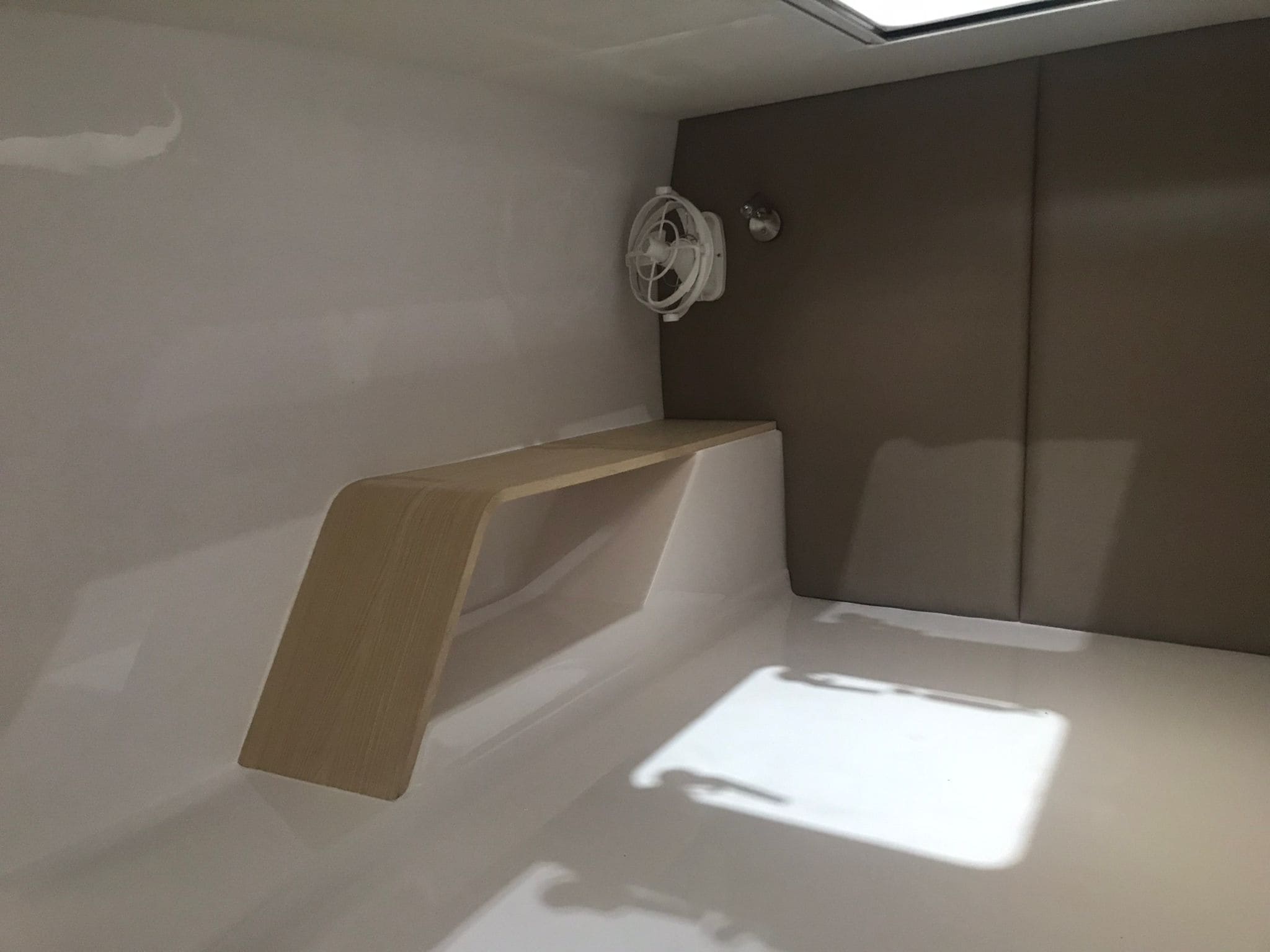

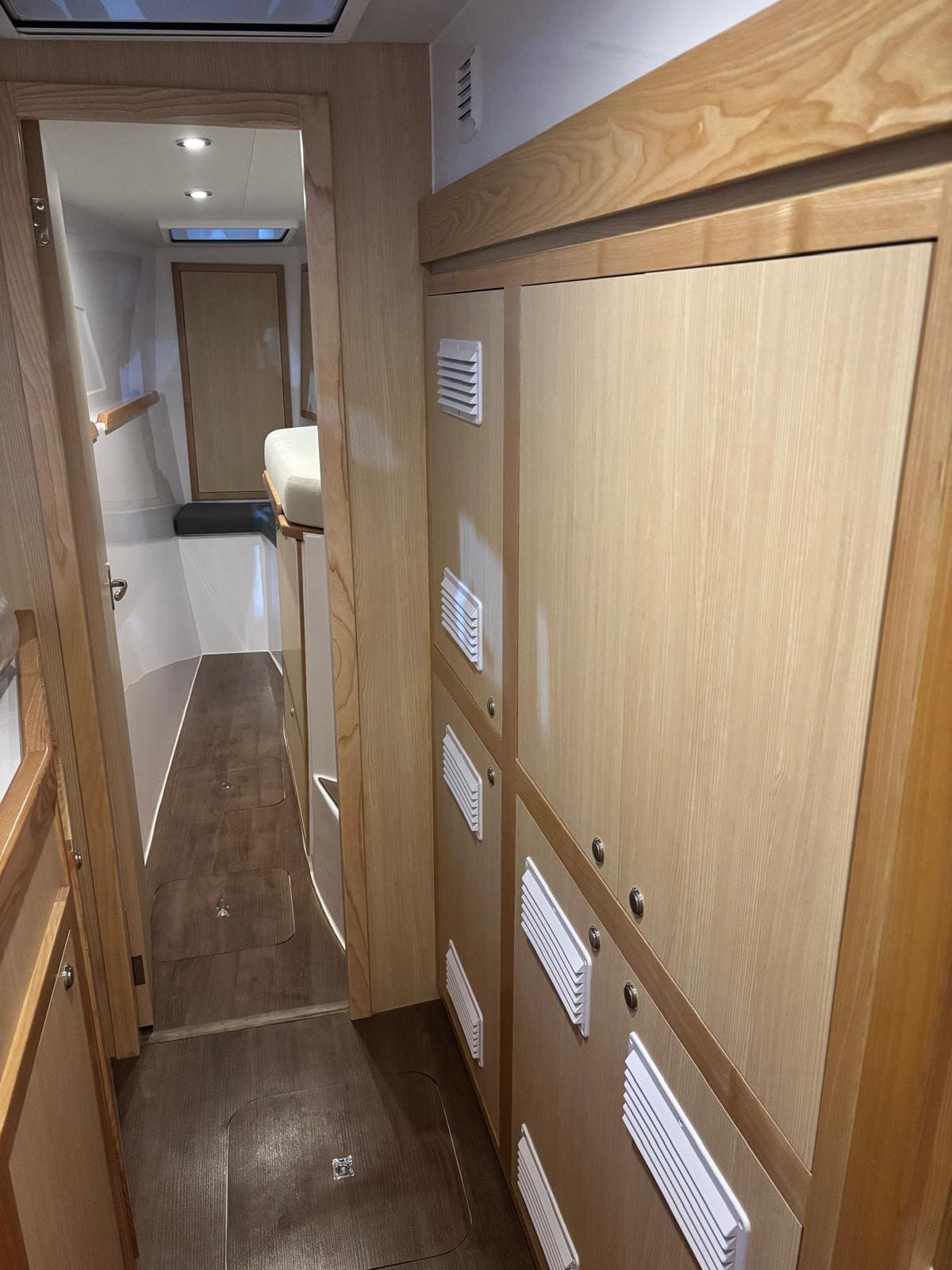

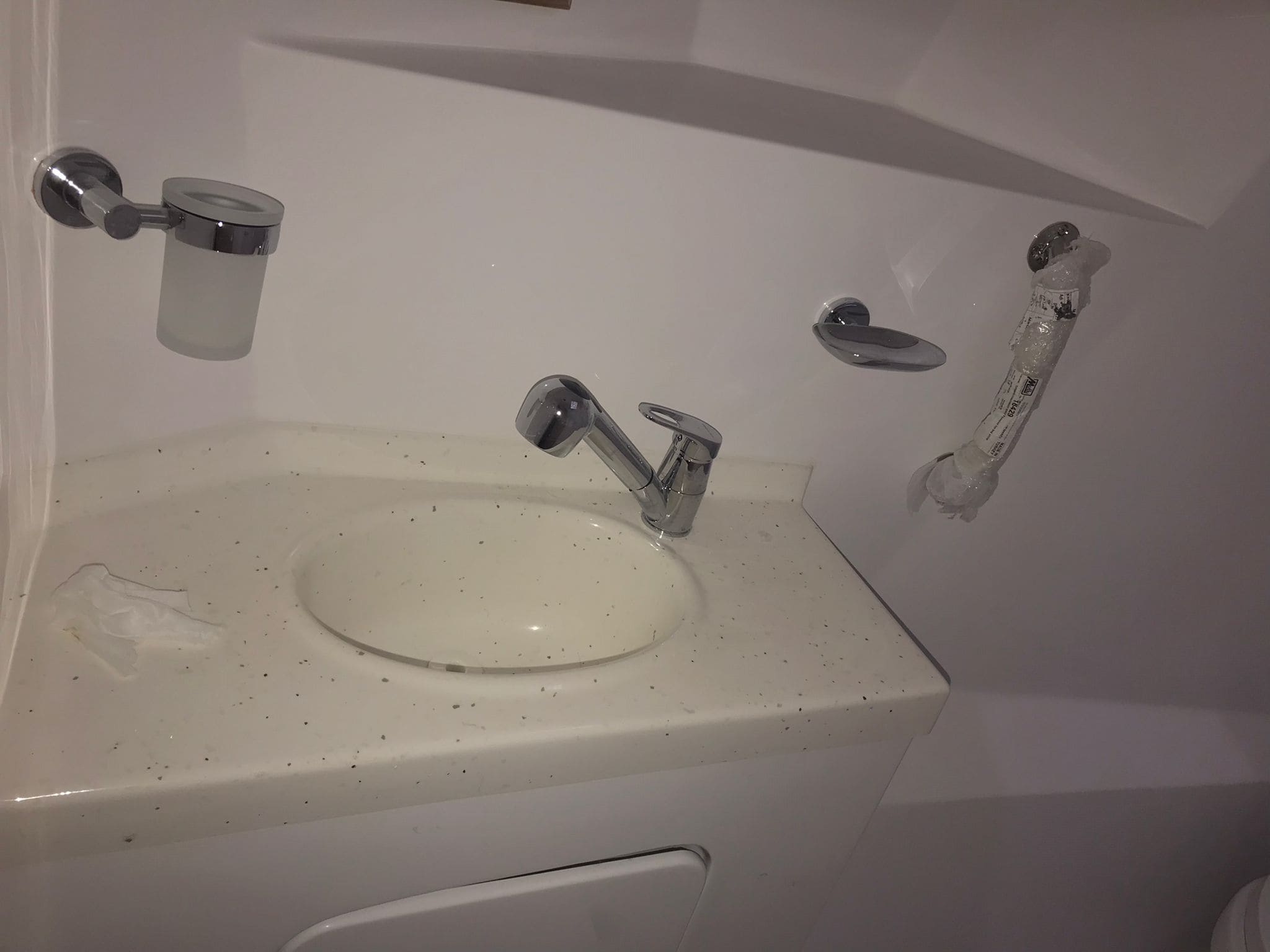

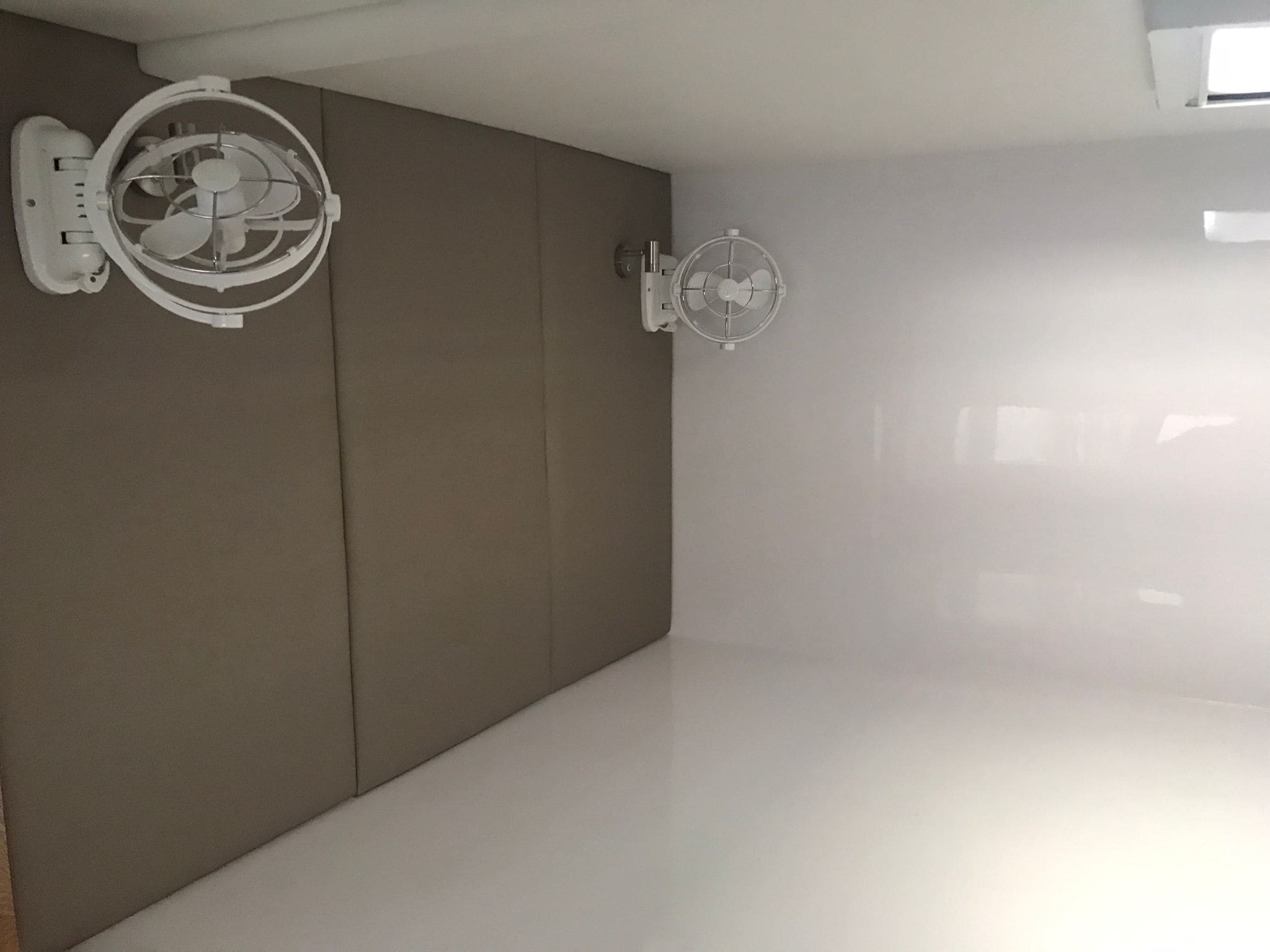

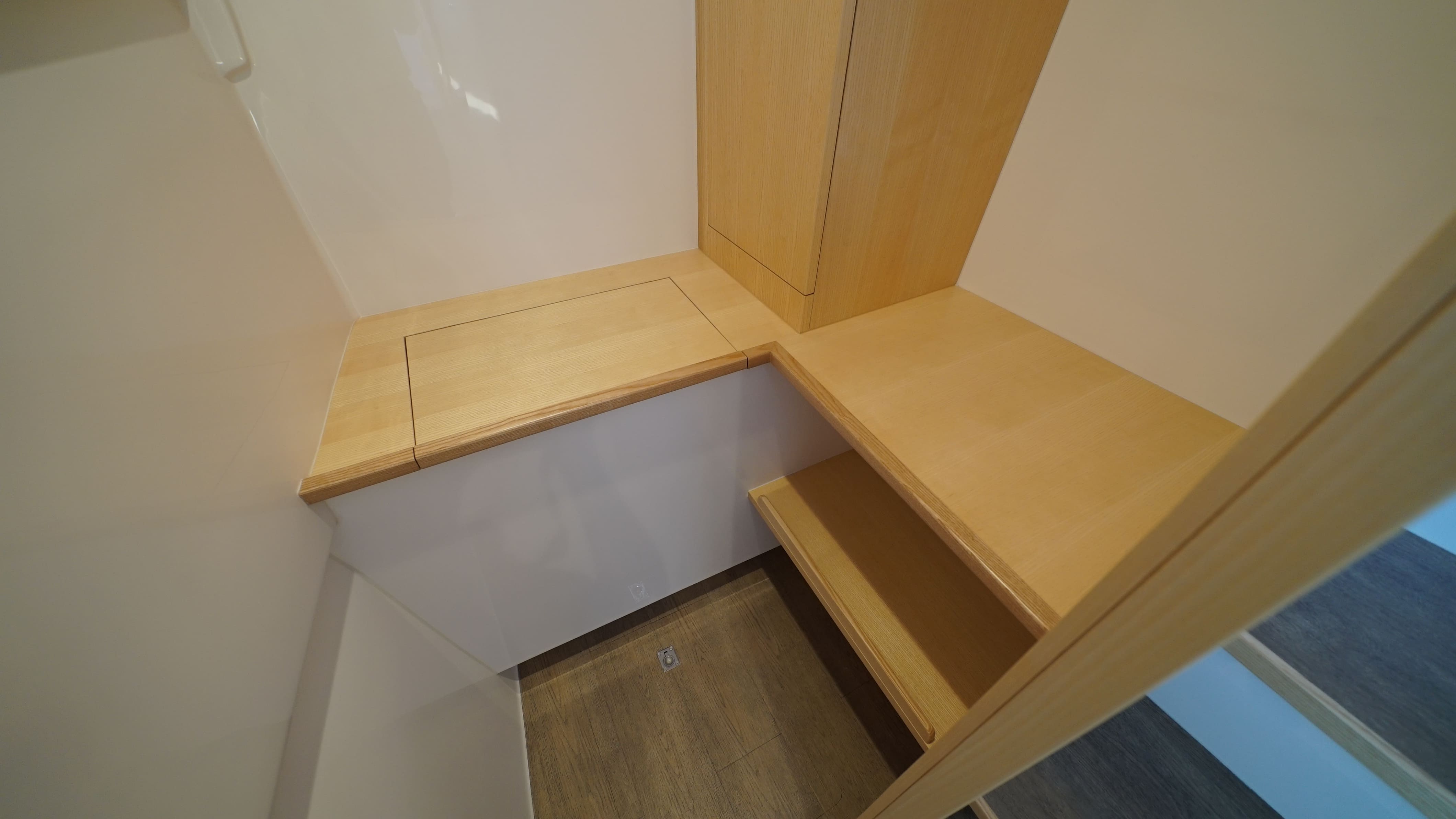

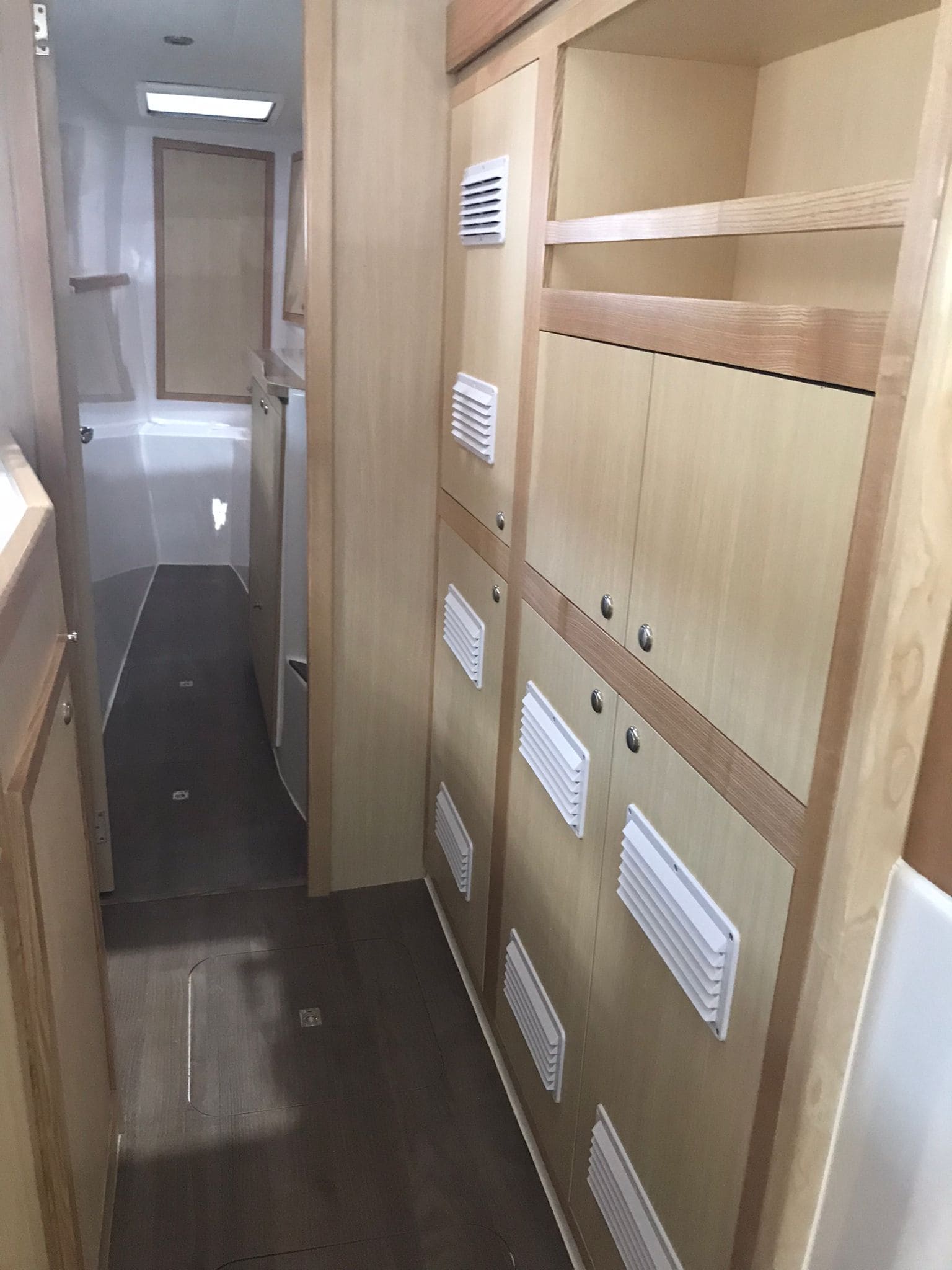

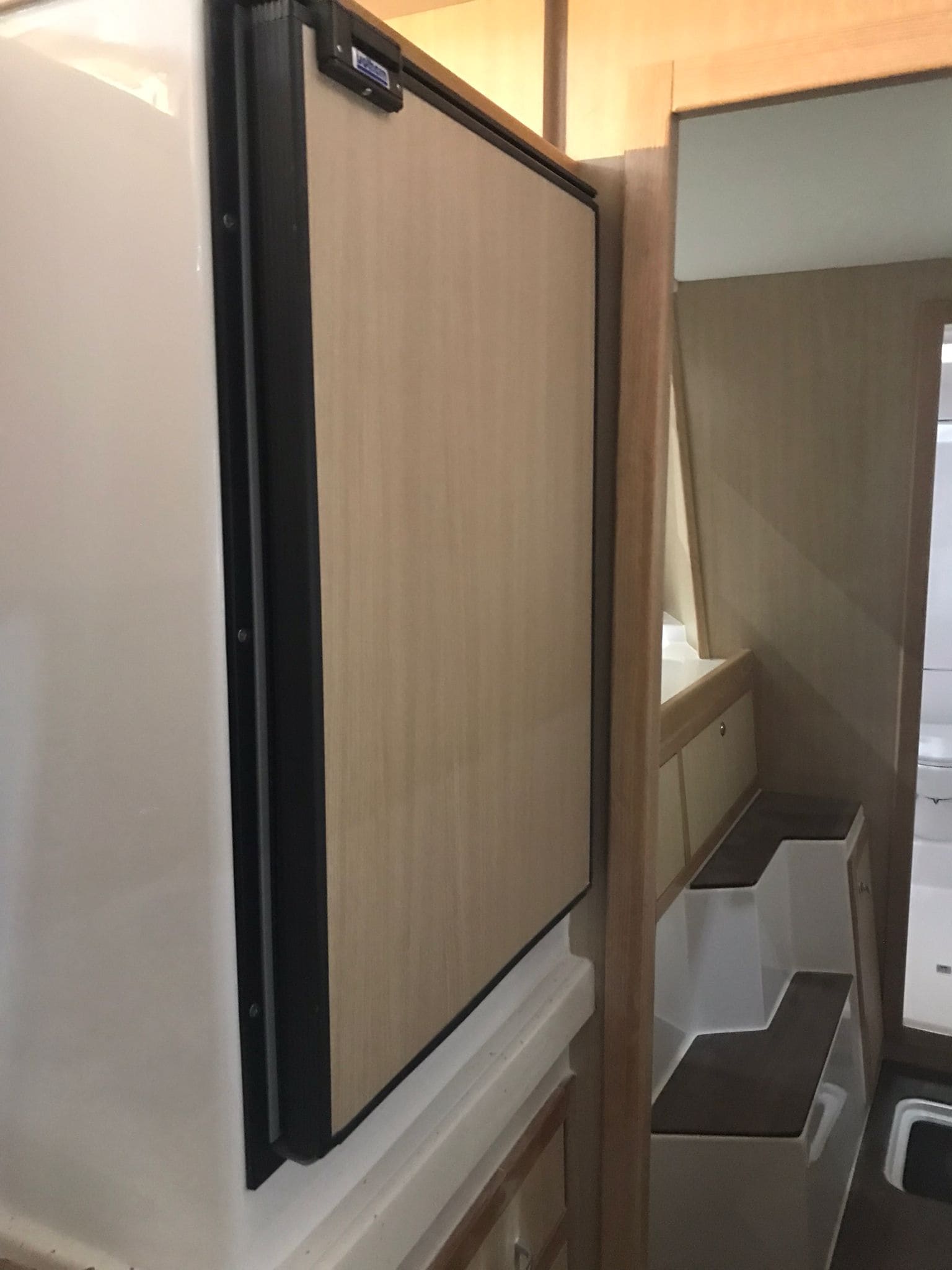

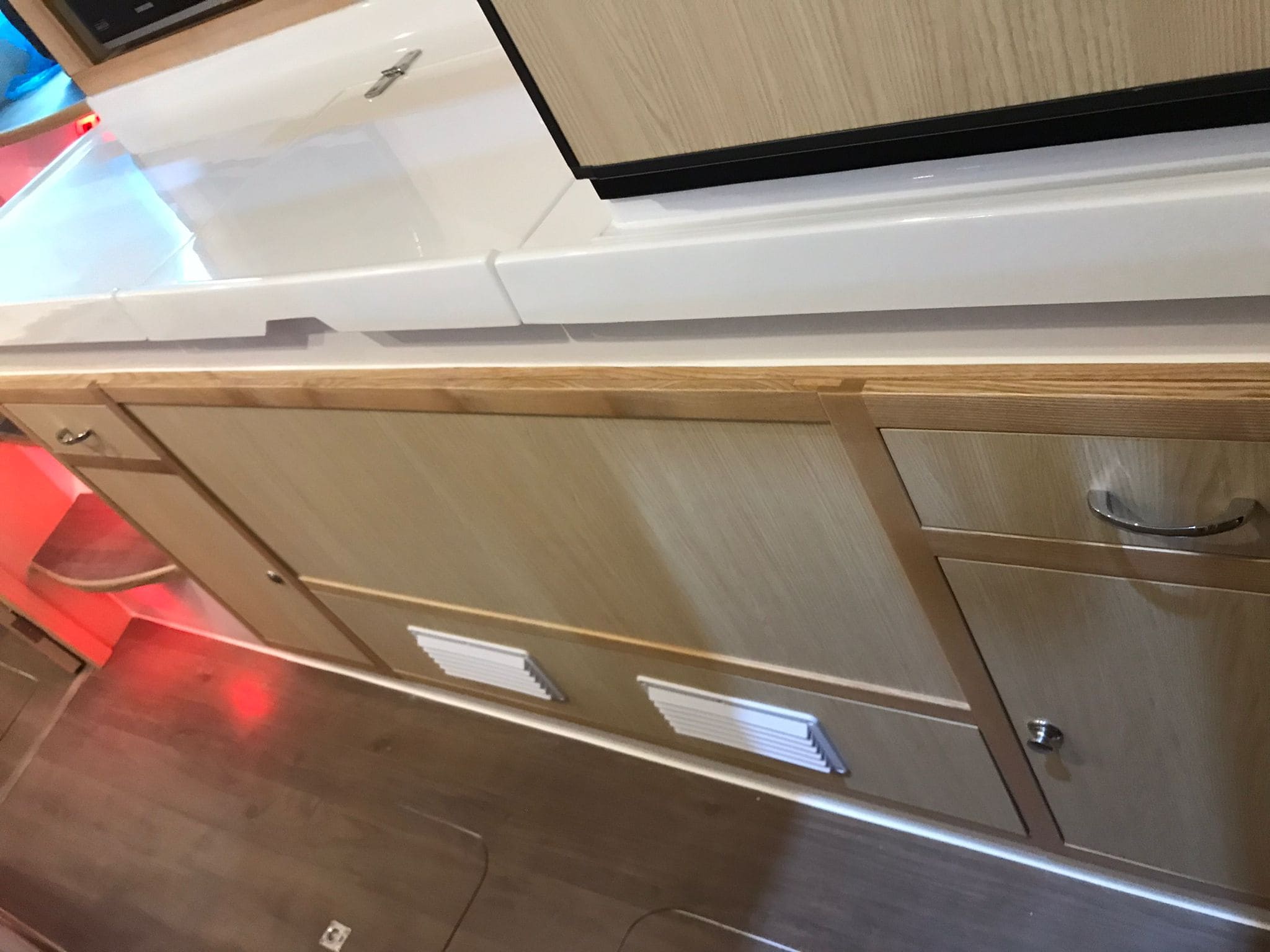

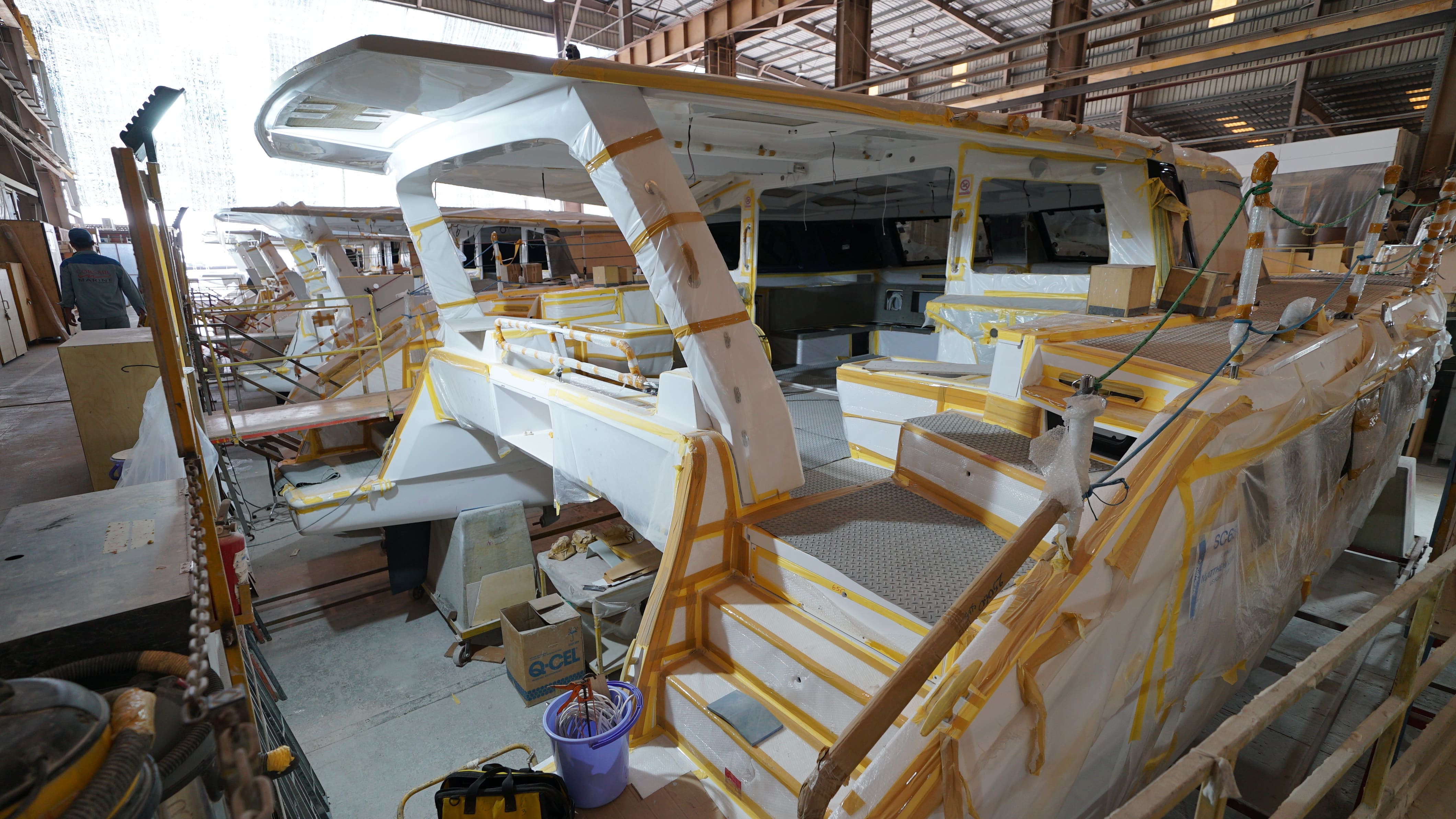

Our Production team is currently working on steering (50%), electric work (60%), plumbing & LPG (60%), timber fitout (50%), deck hardware at 70%, and stanchion (75%).

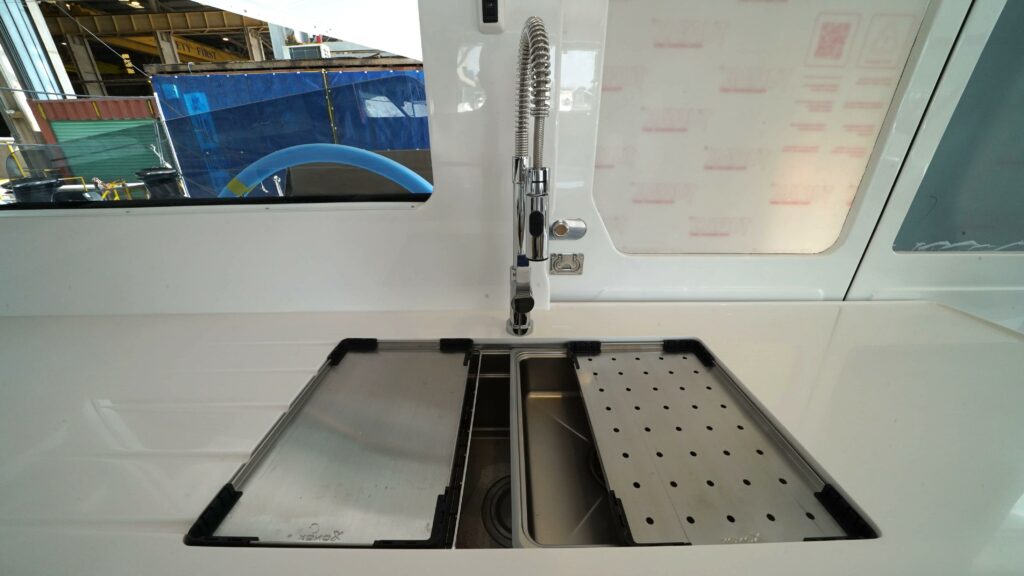

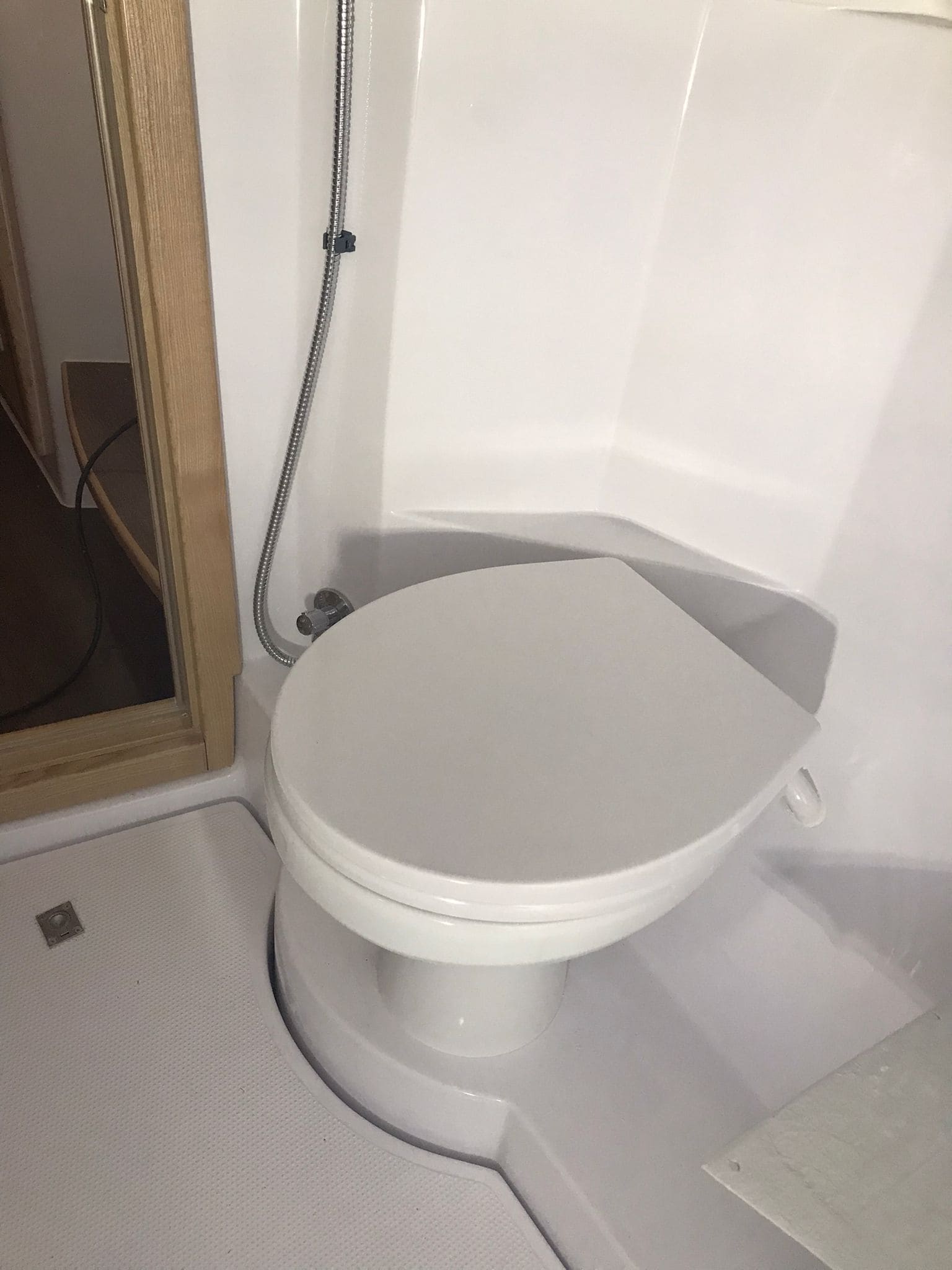

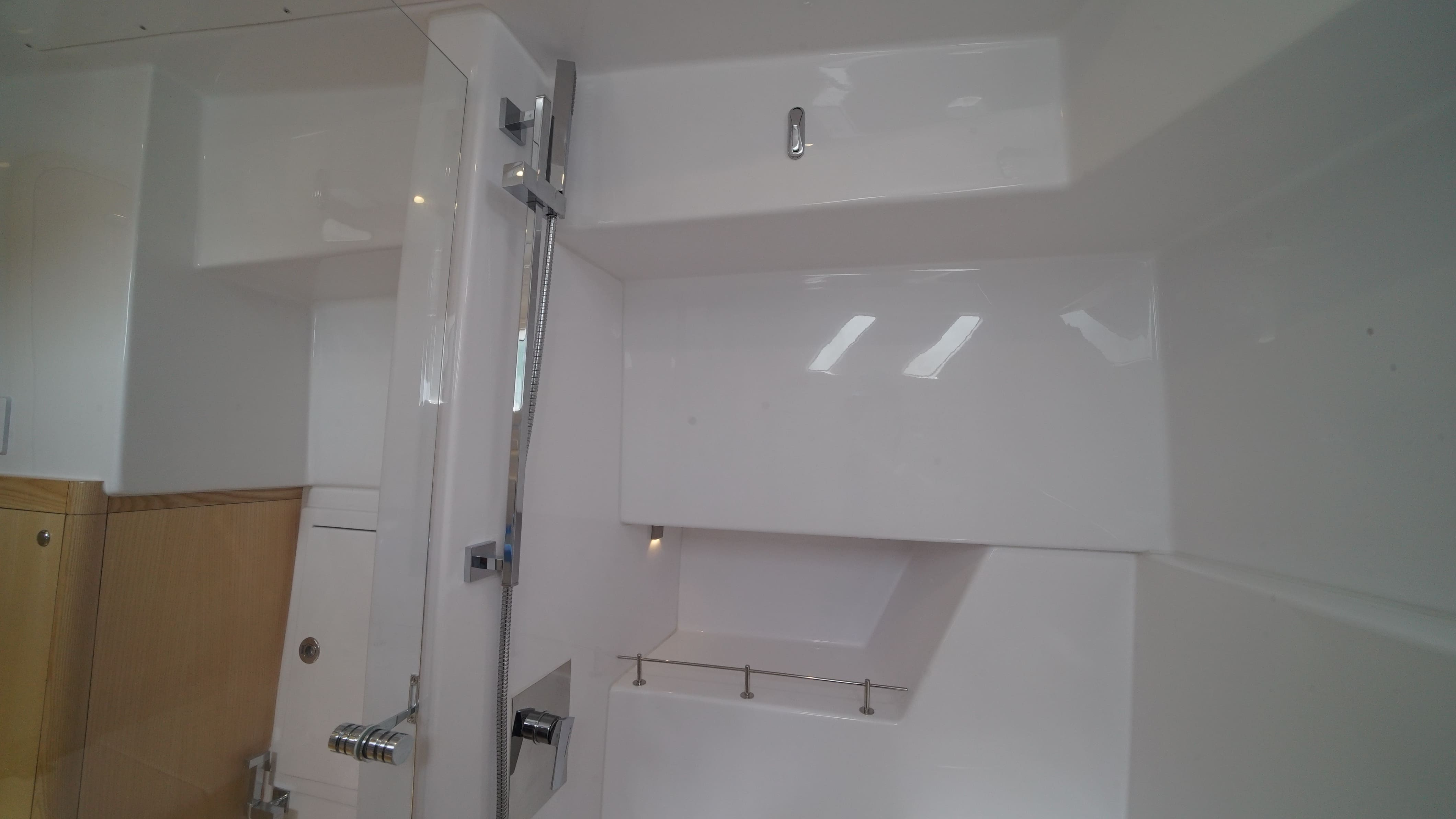

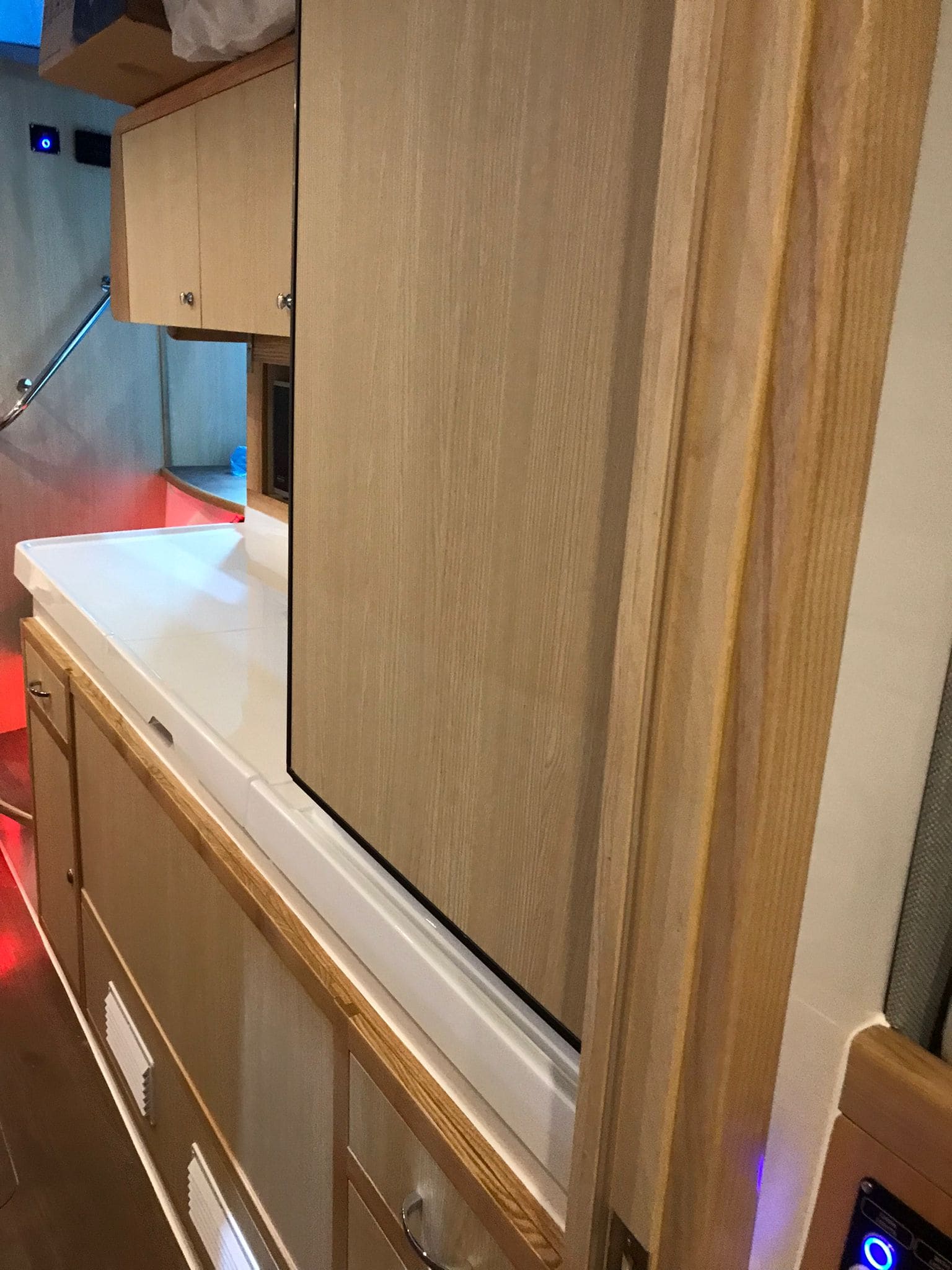

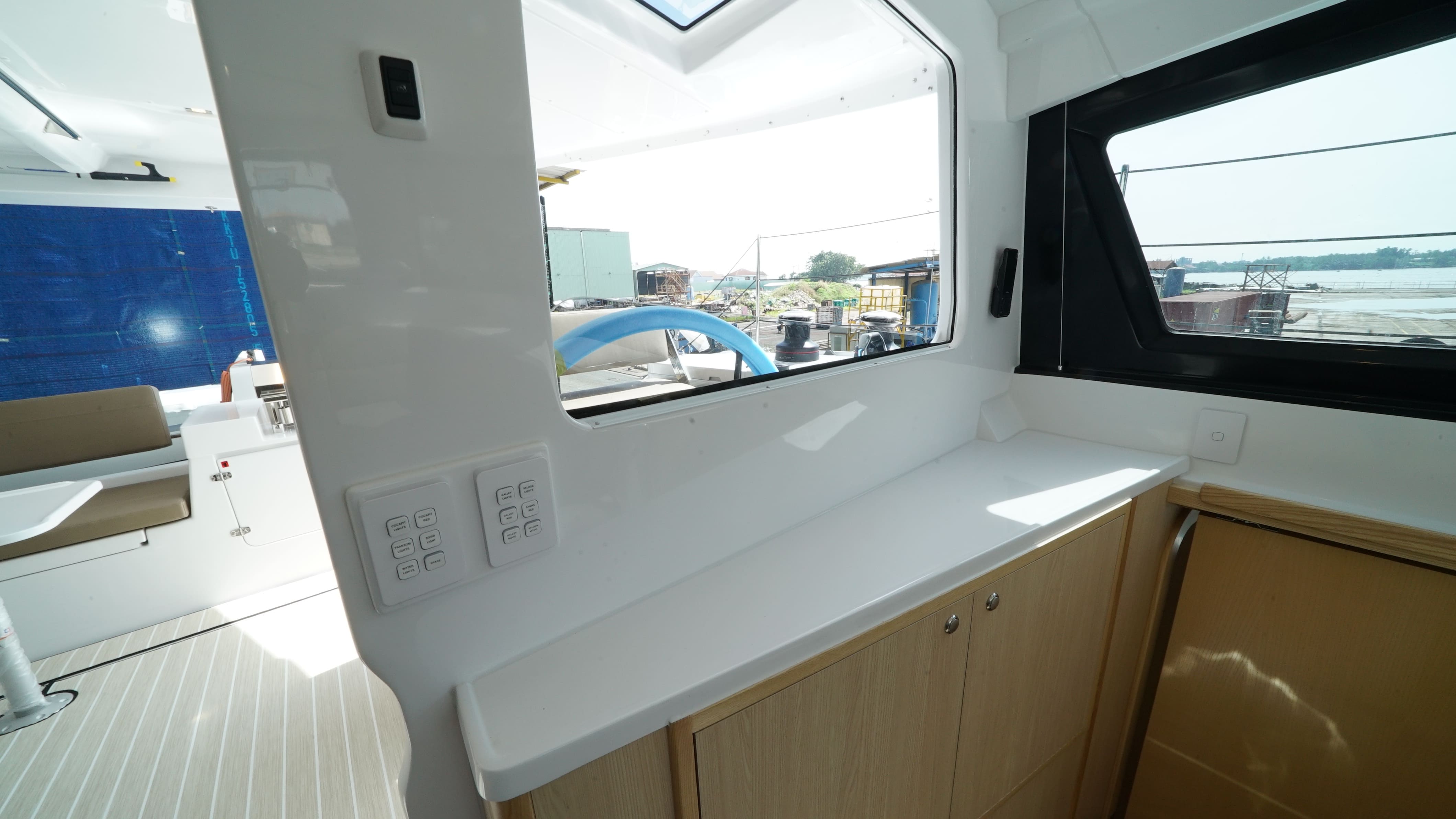

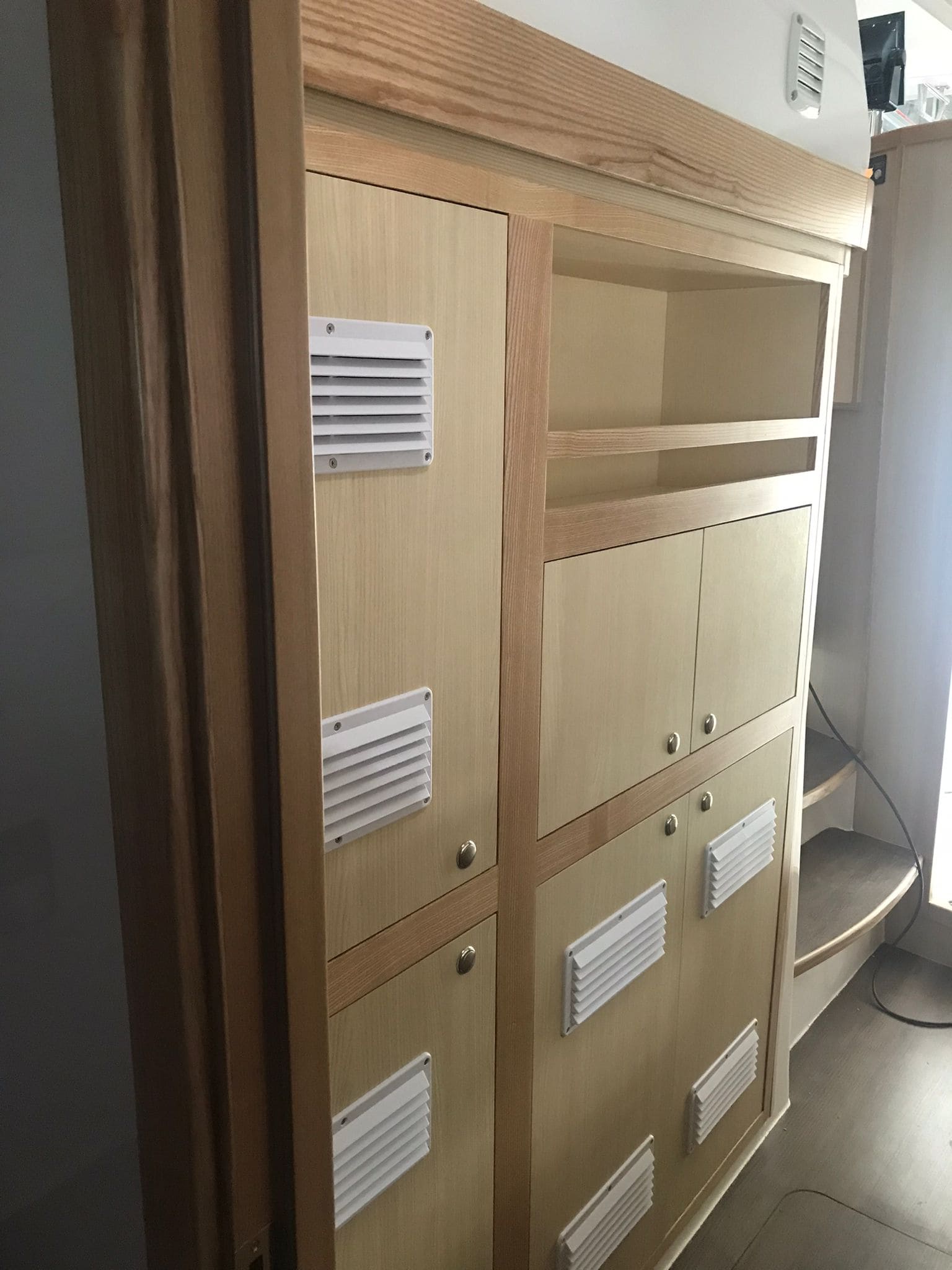

Production Update – Fit out

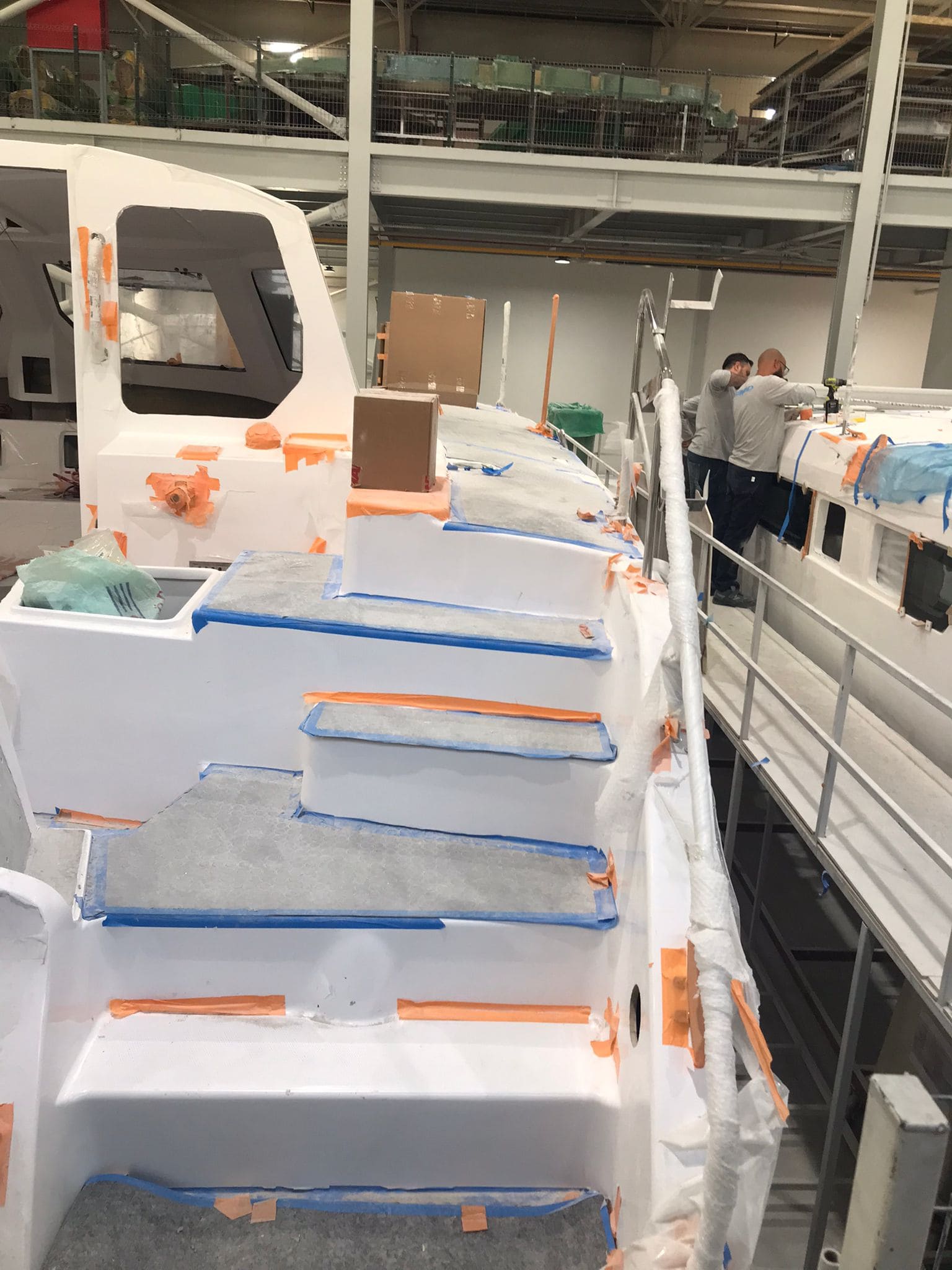

Your boat is progressing well in the Fit out stage.

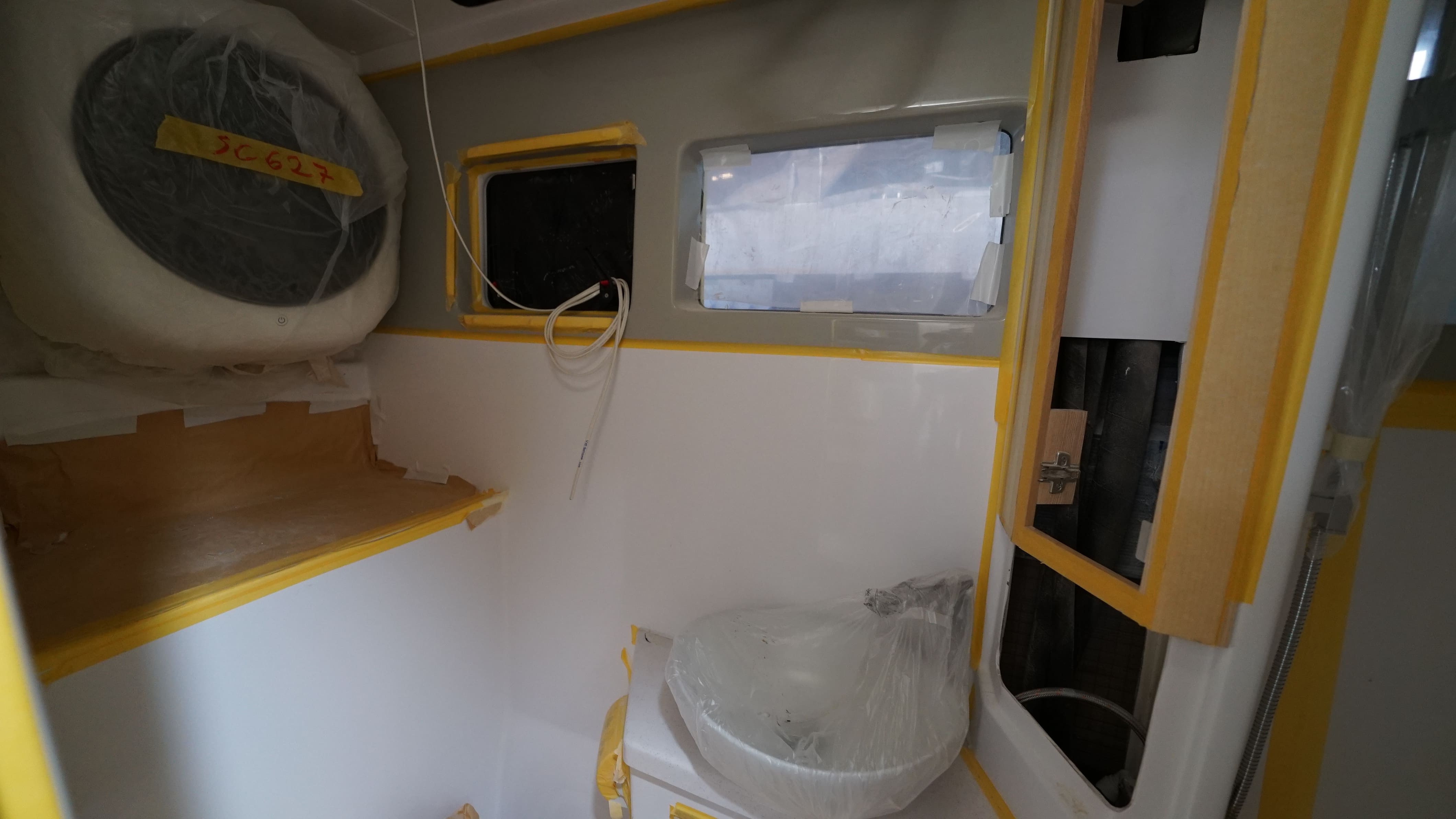

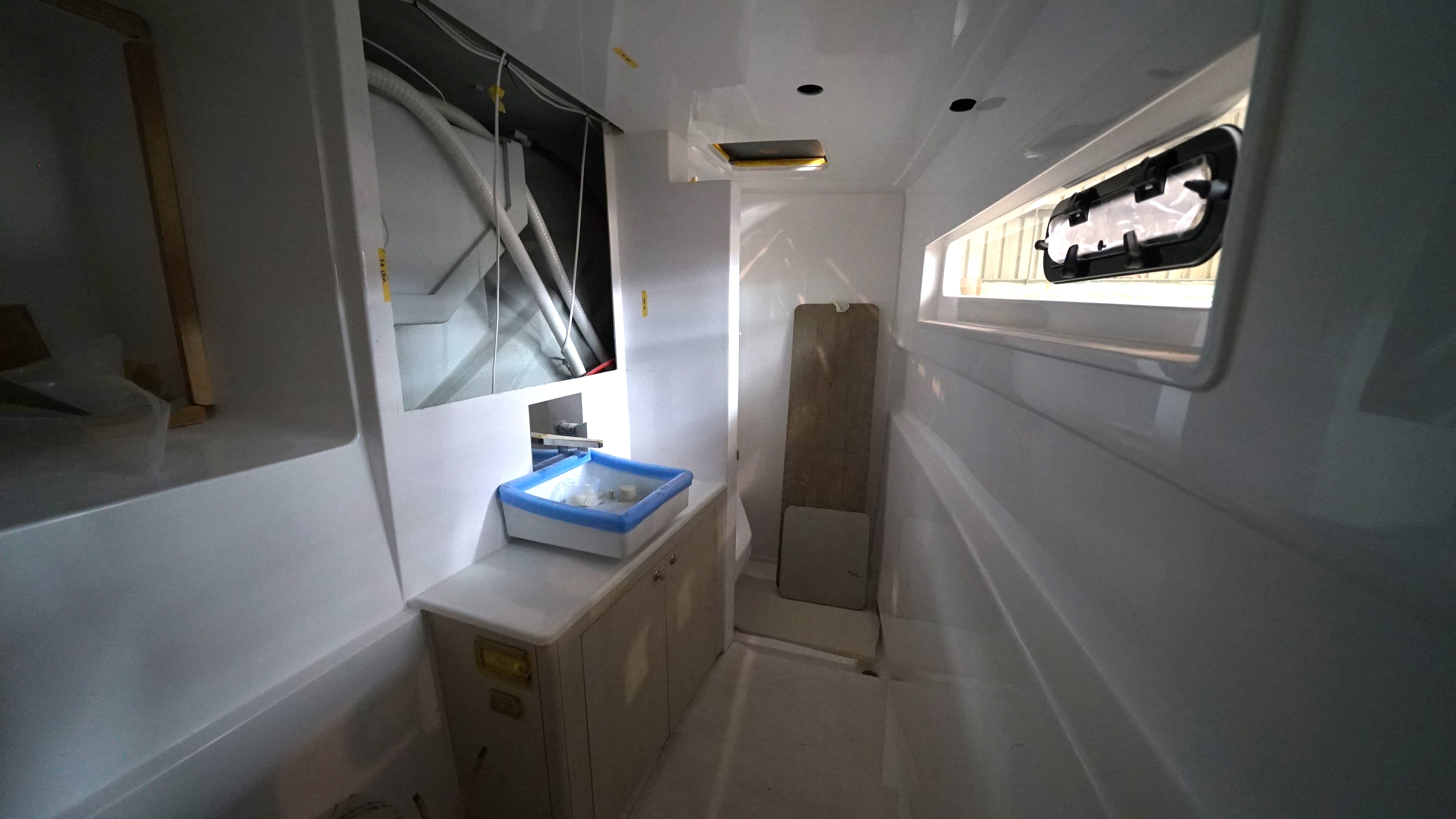

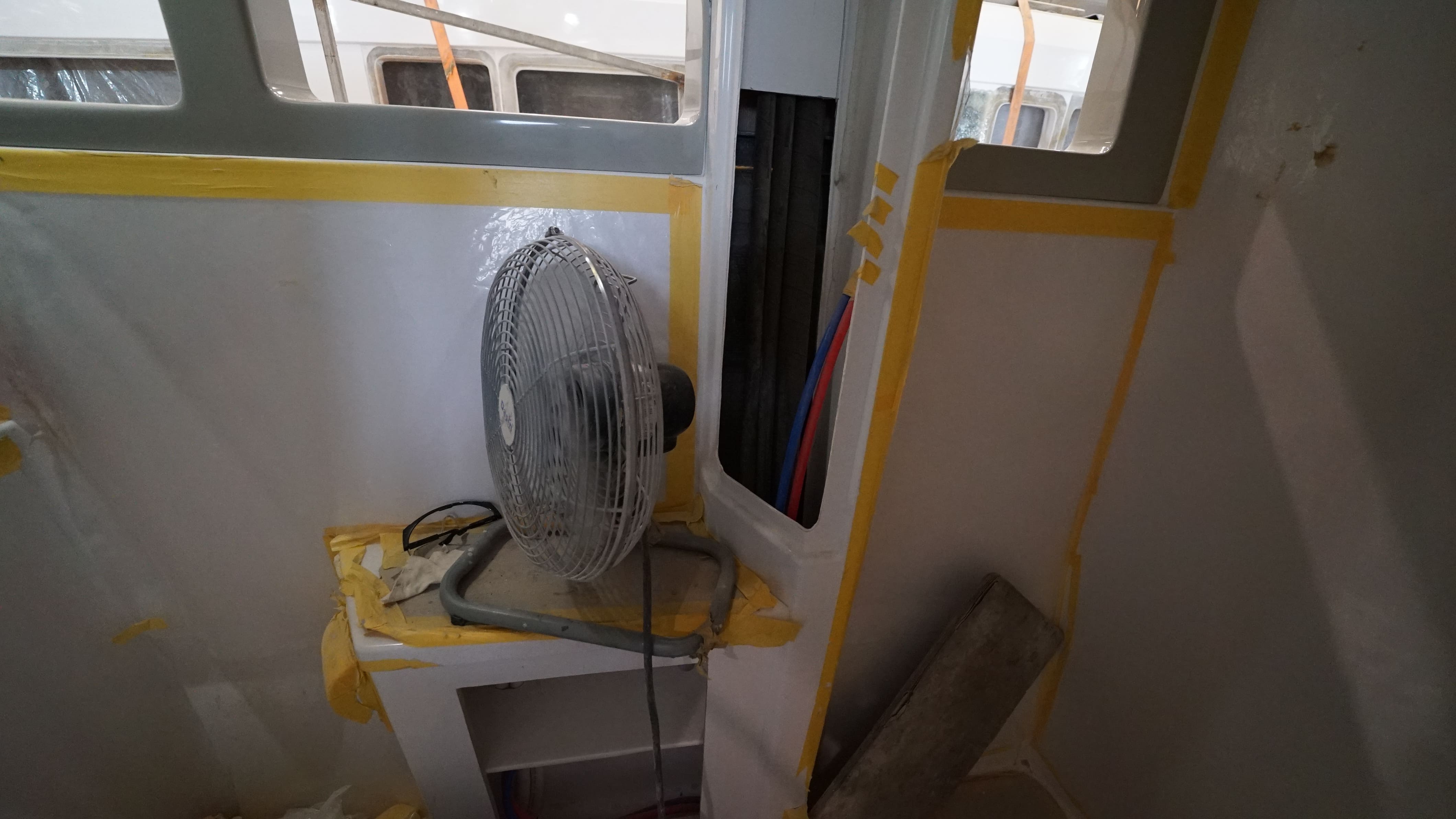

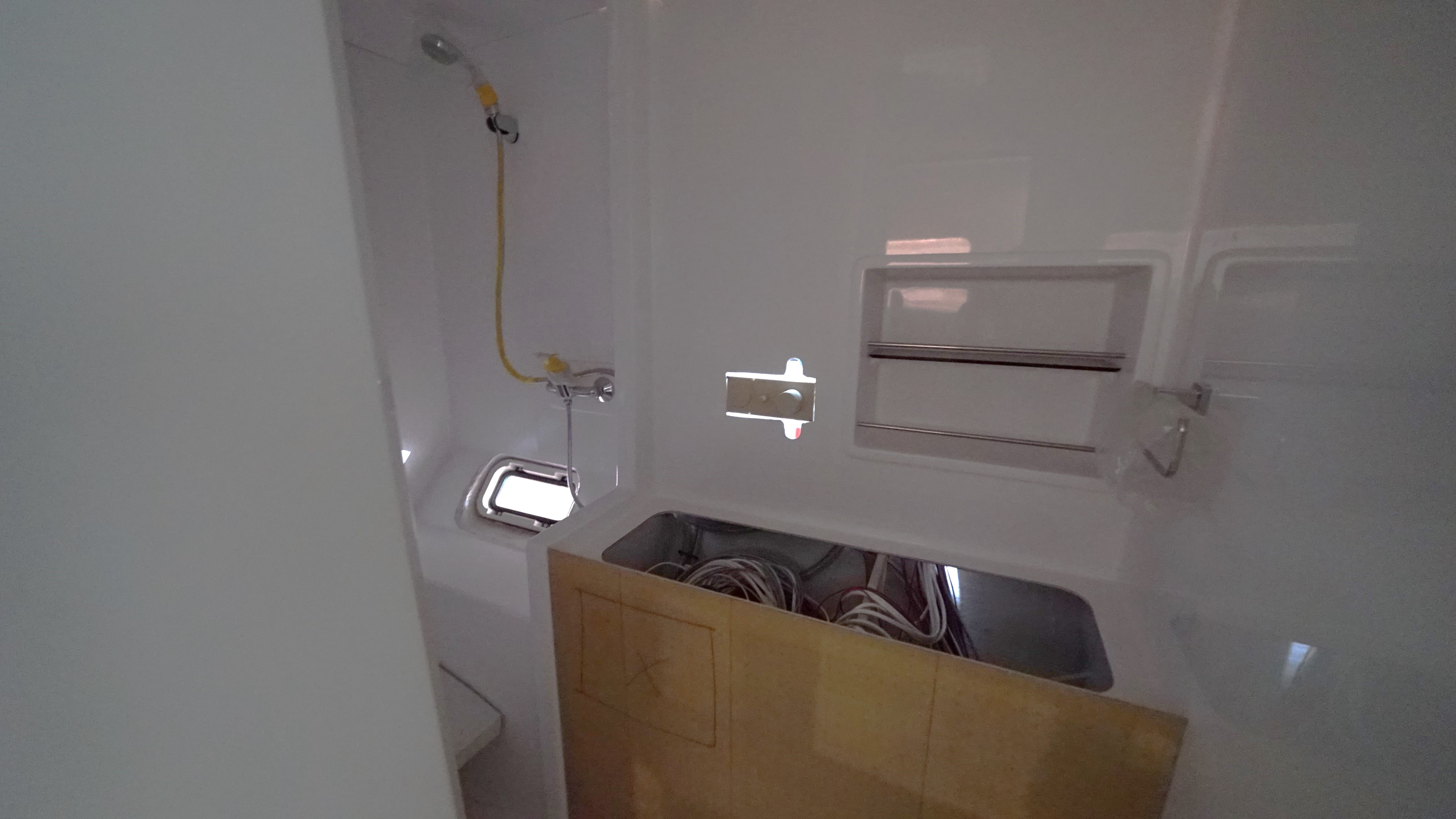

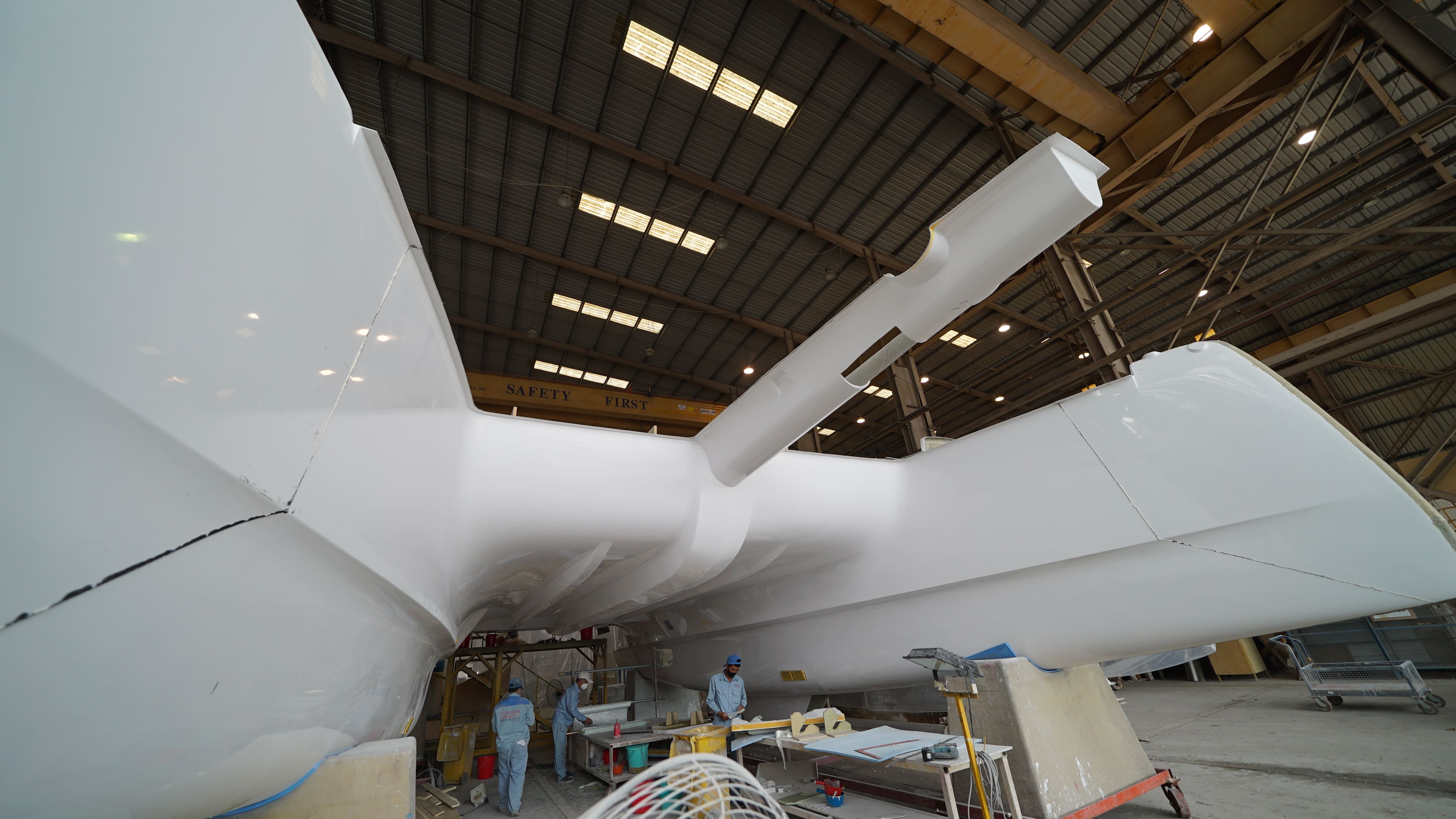

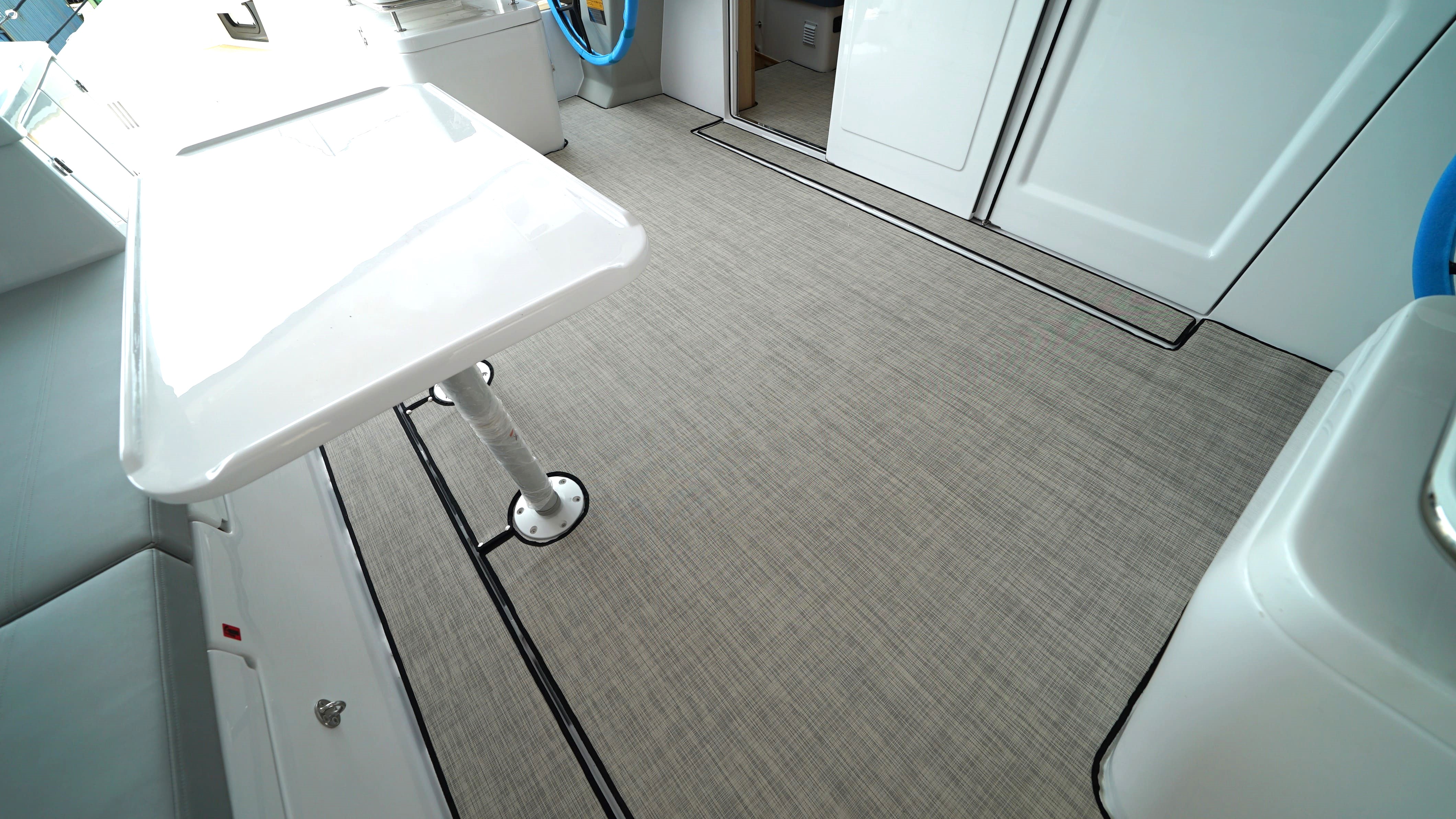

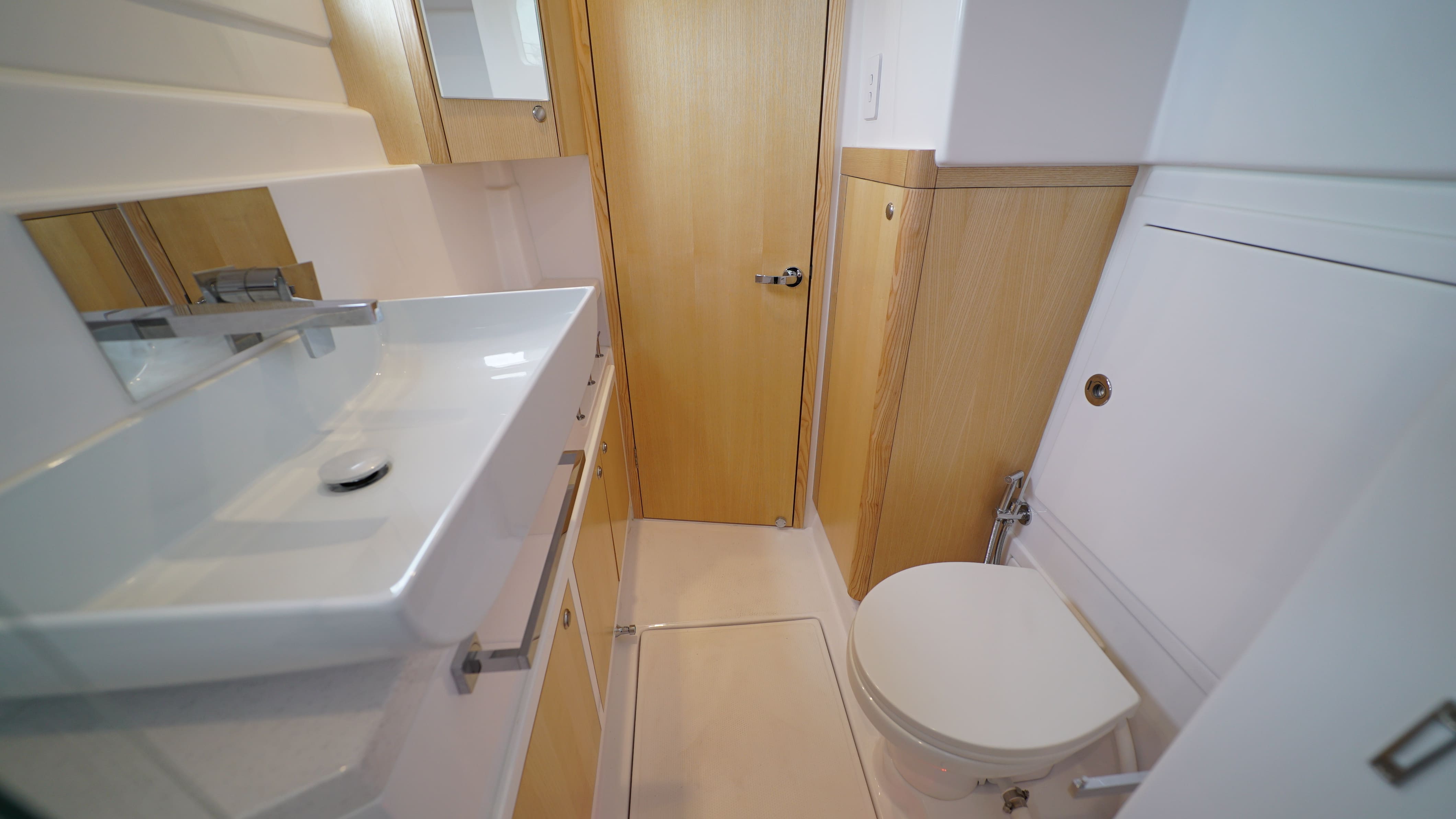

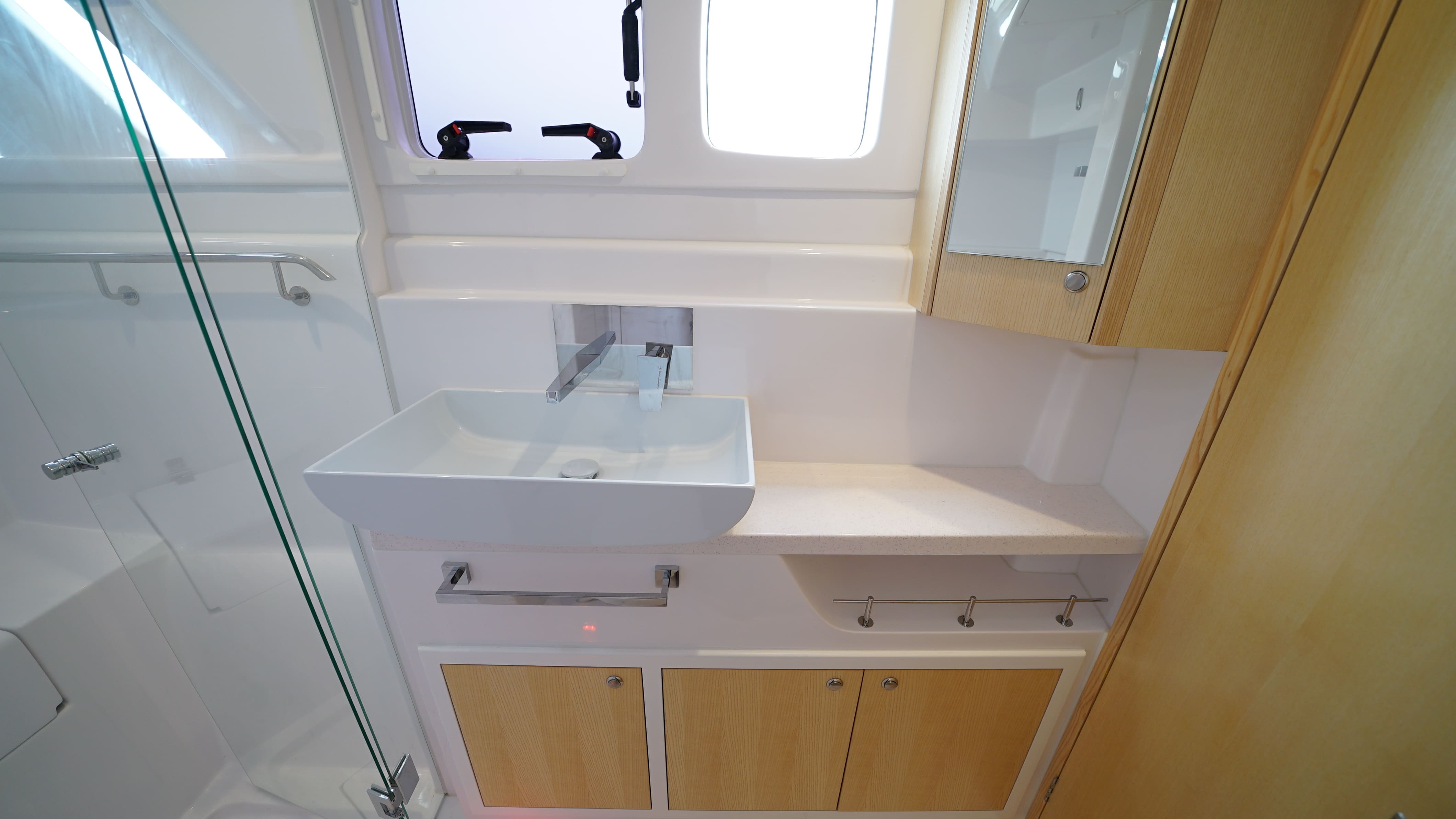

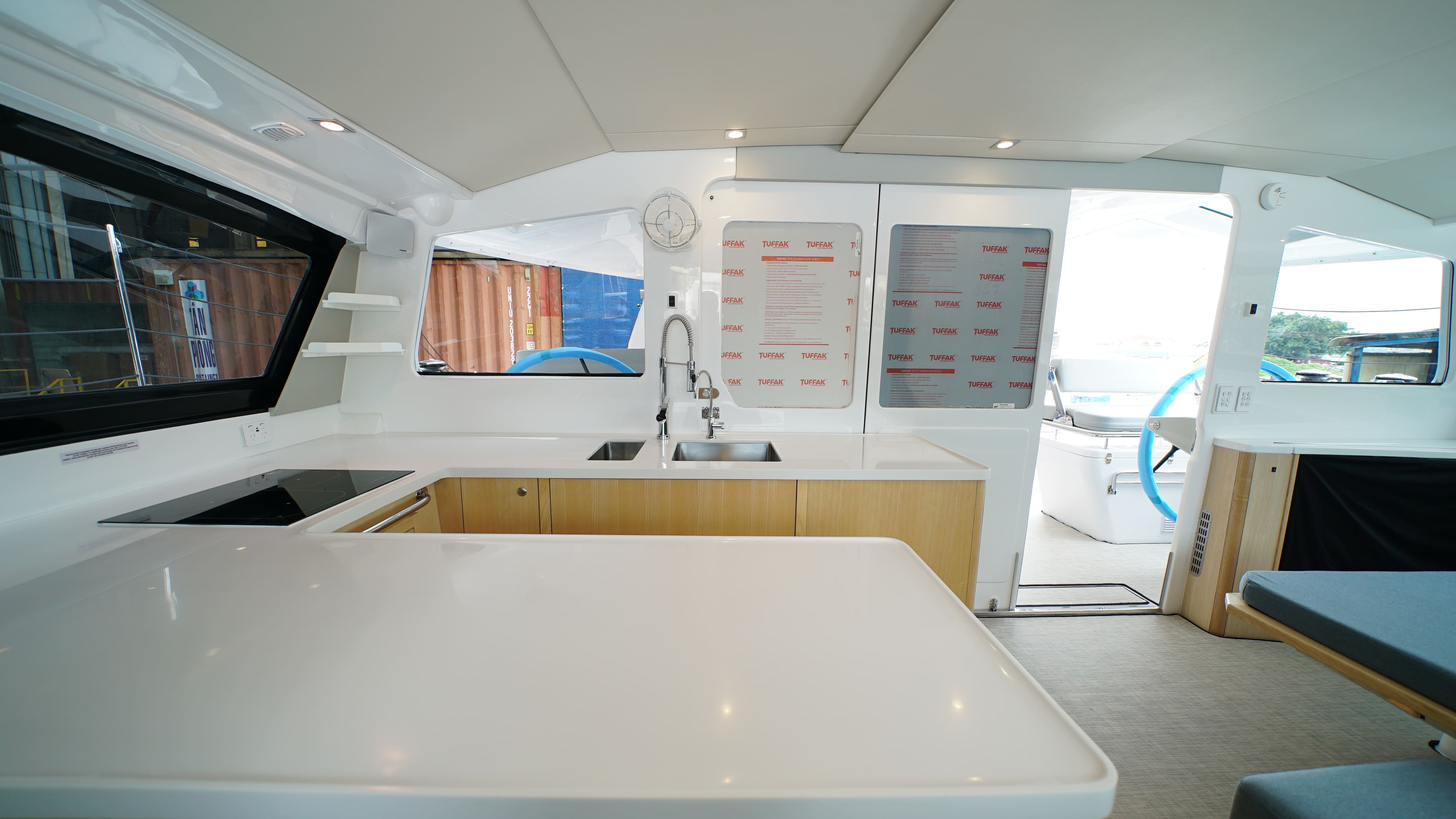

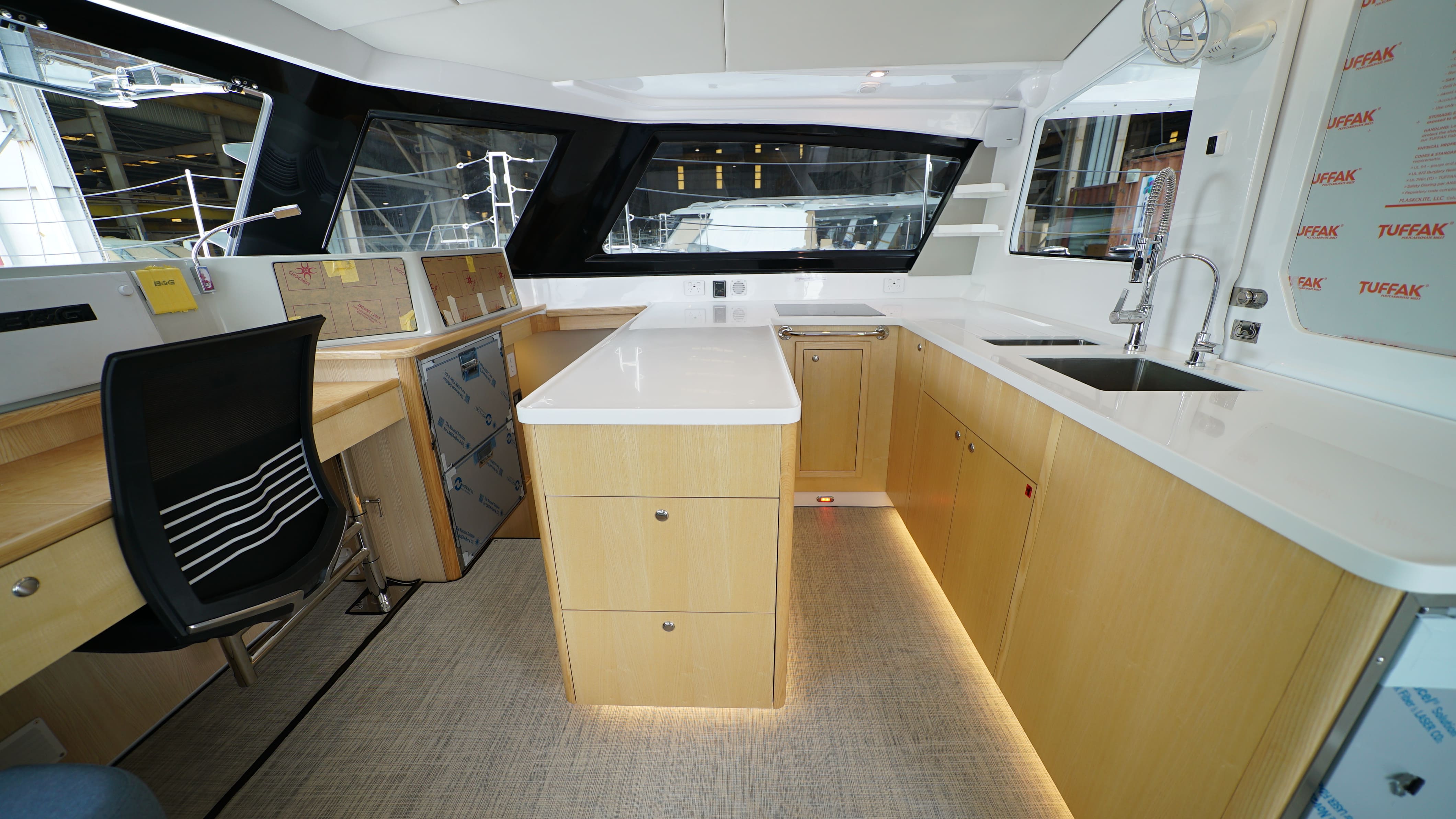

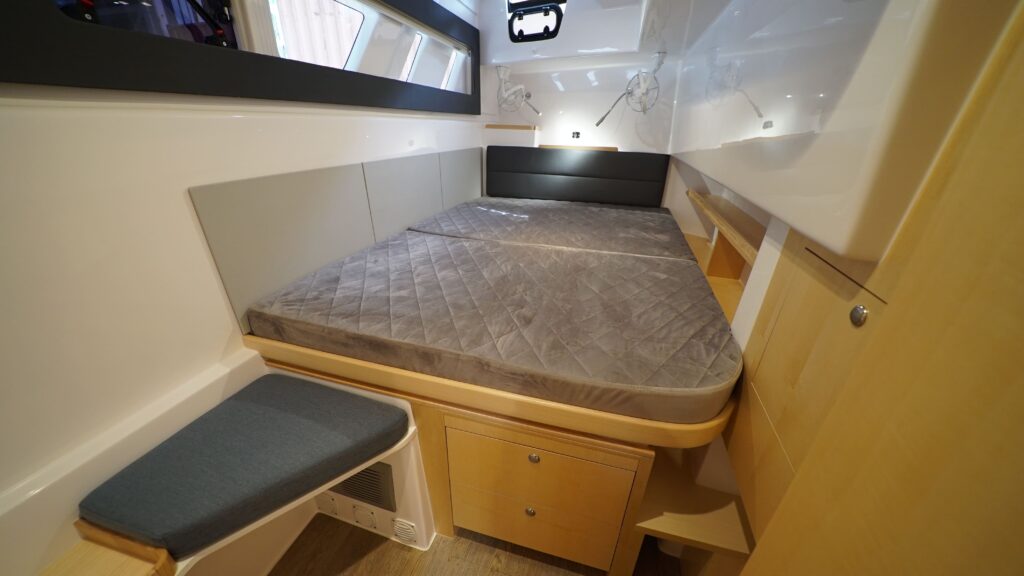

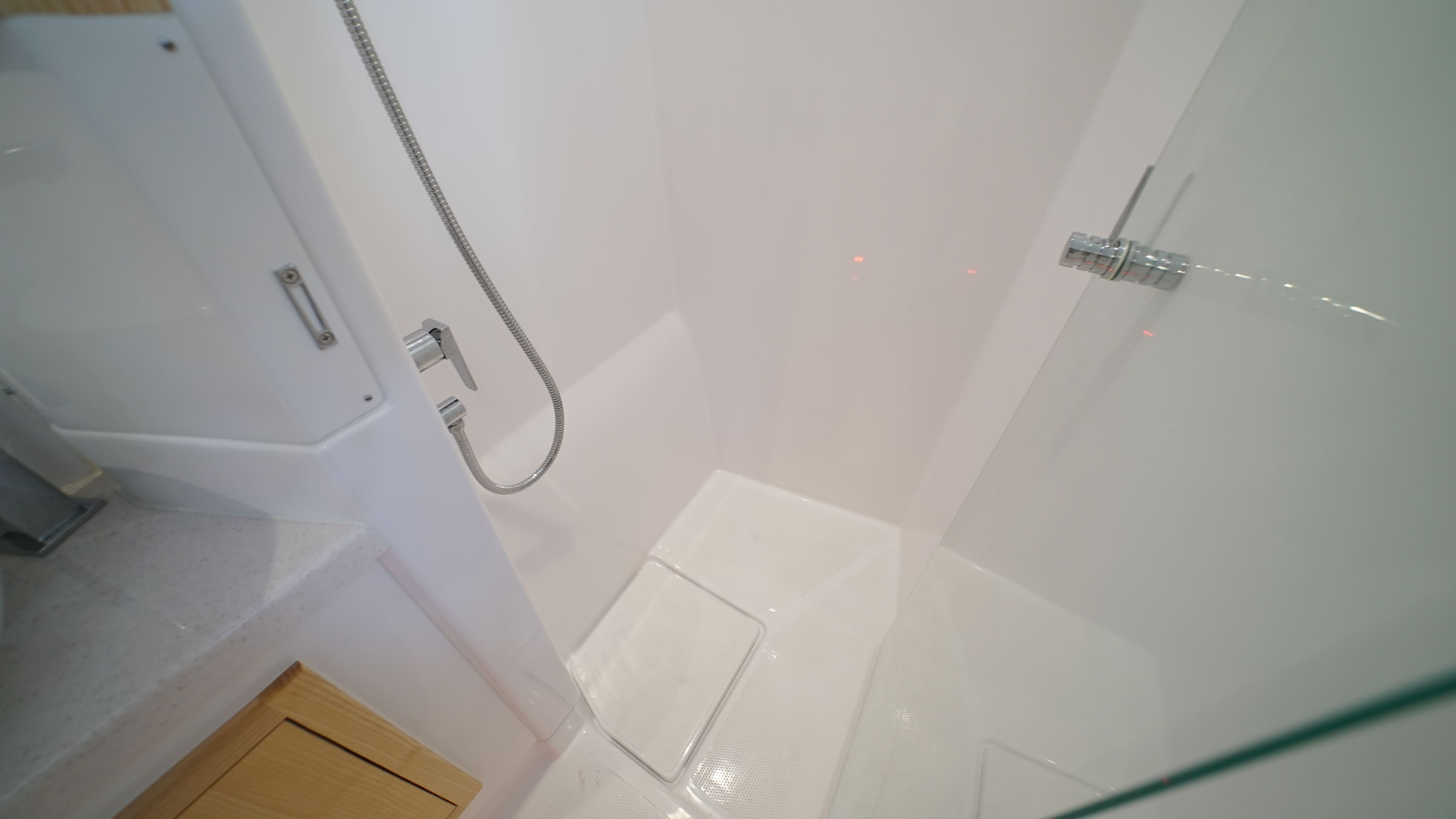

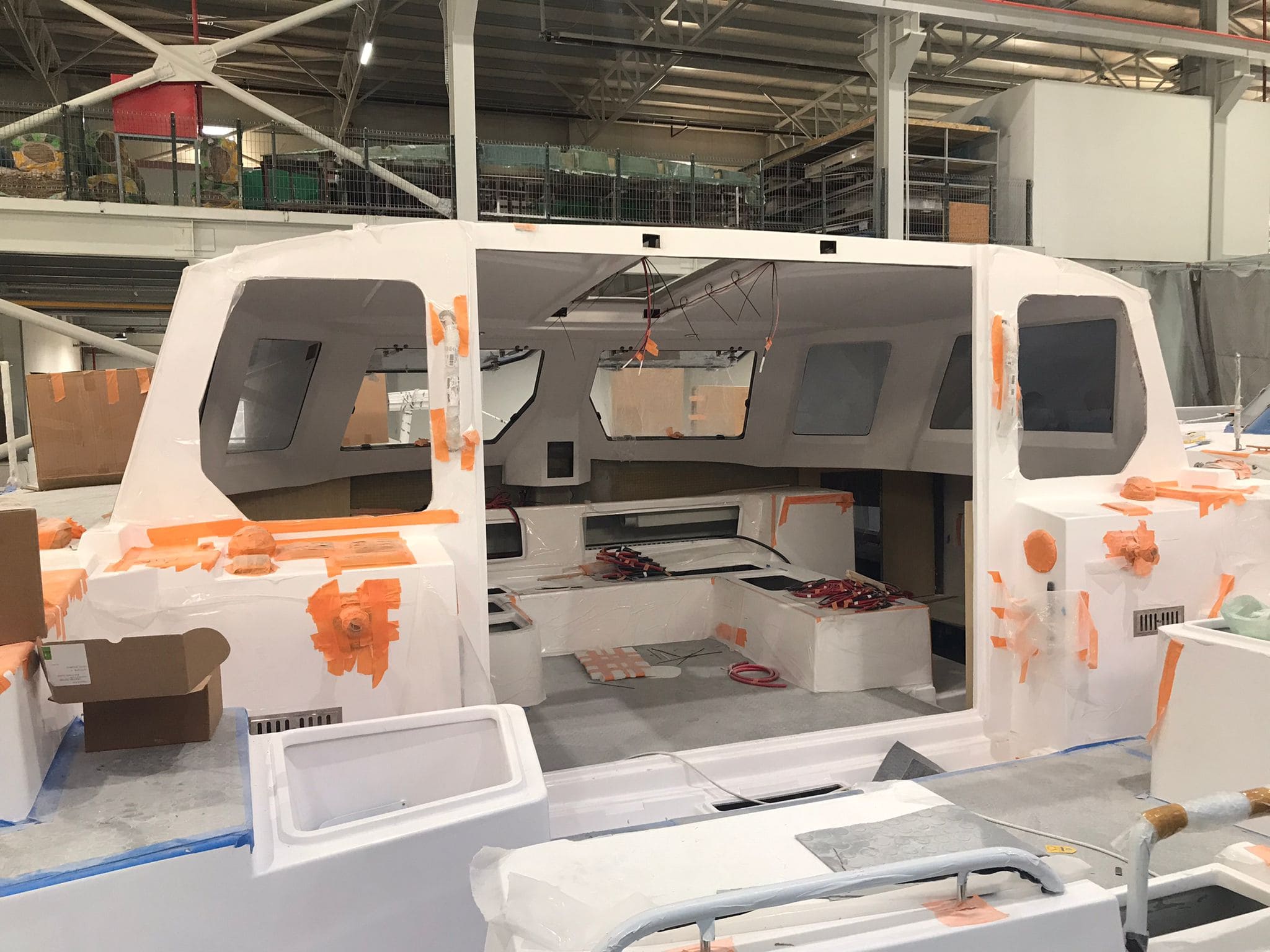

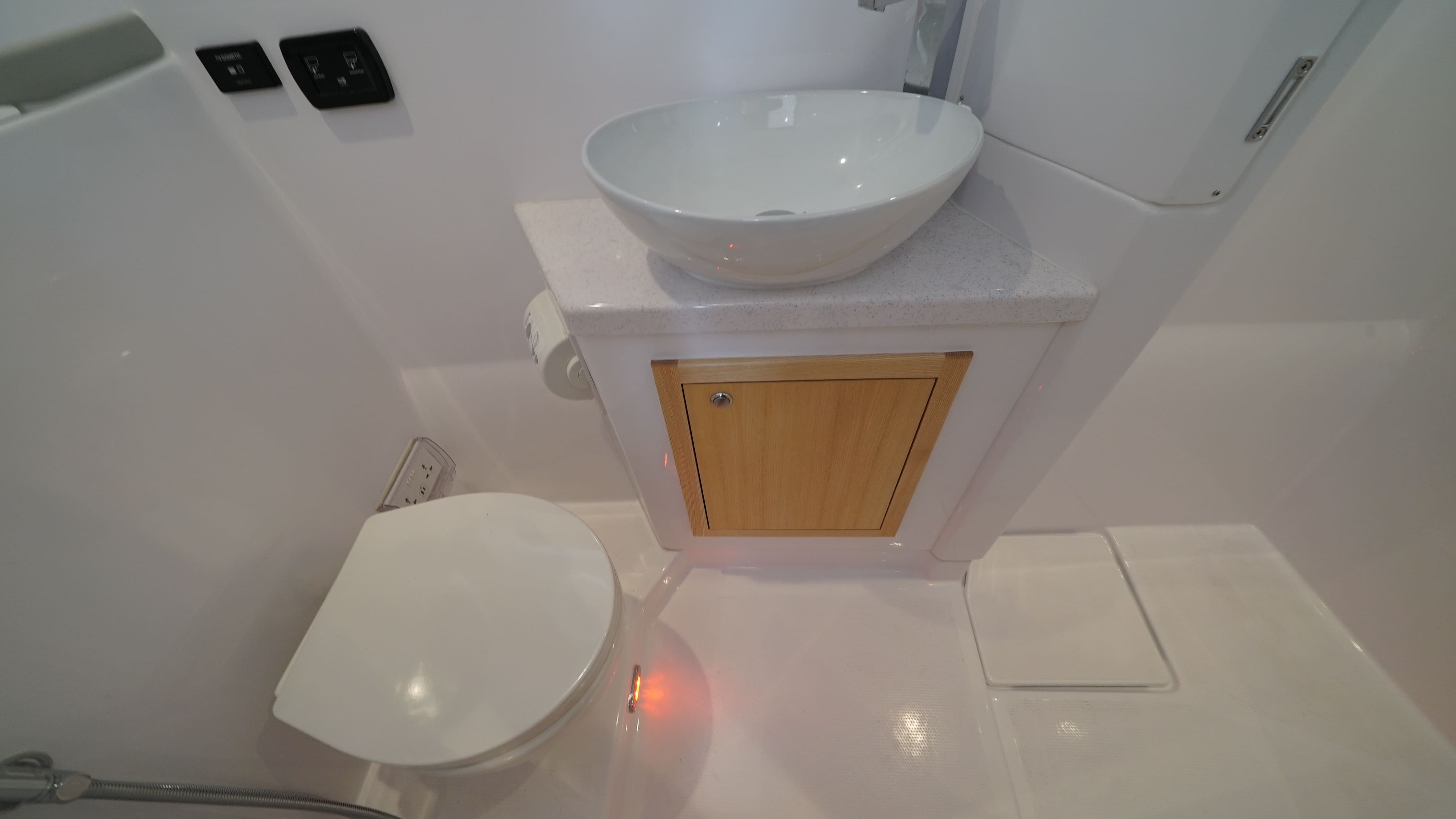

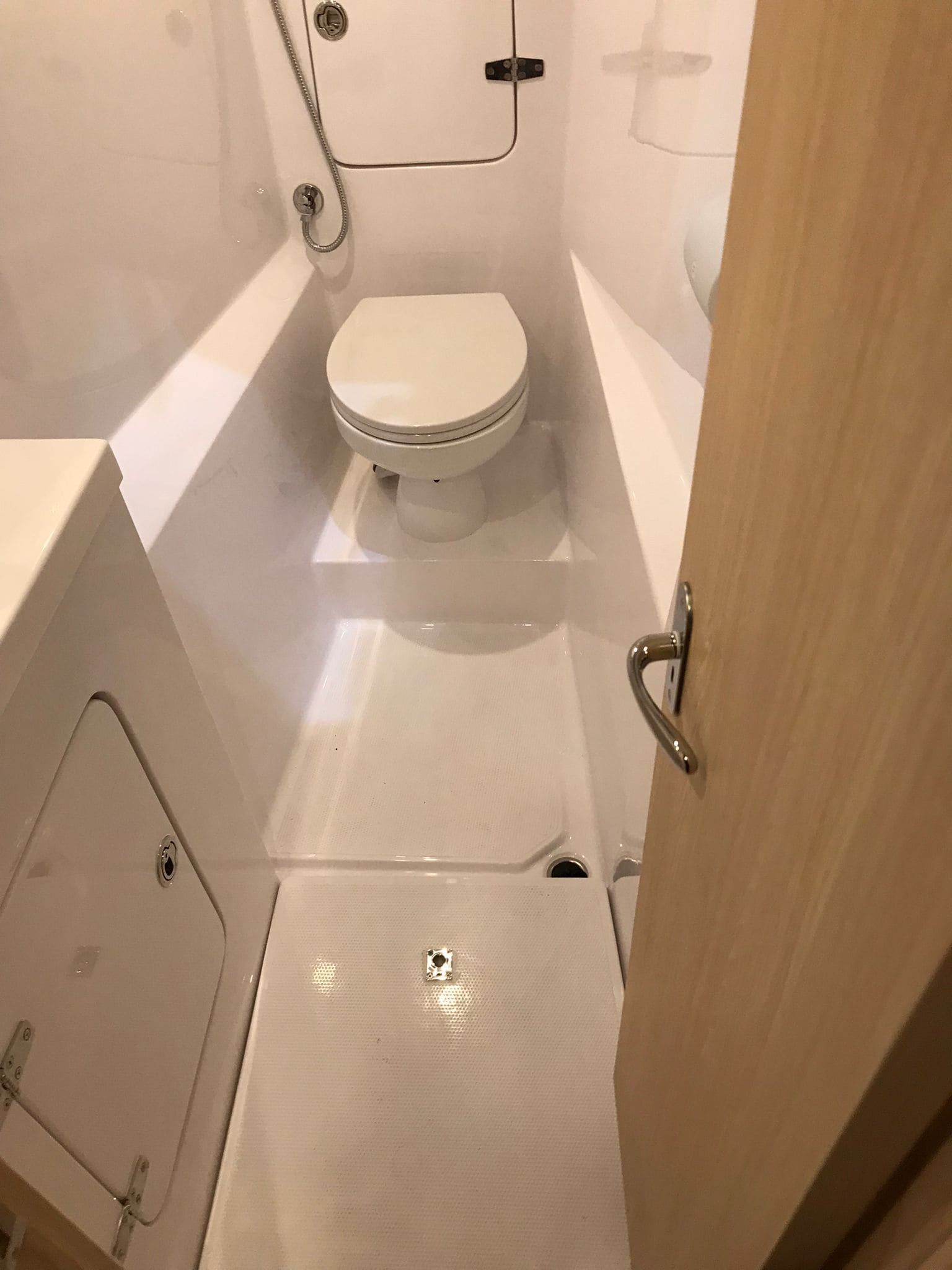

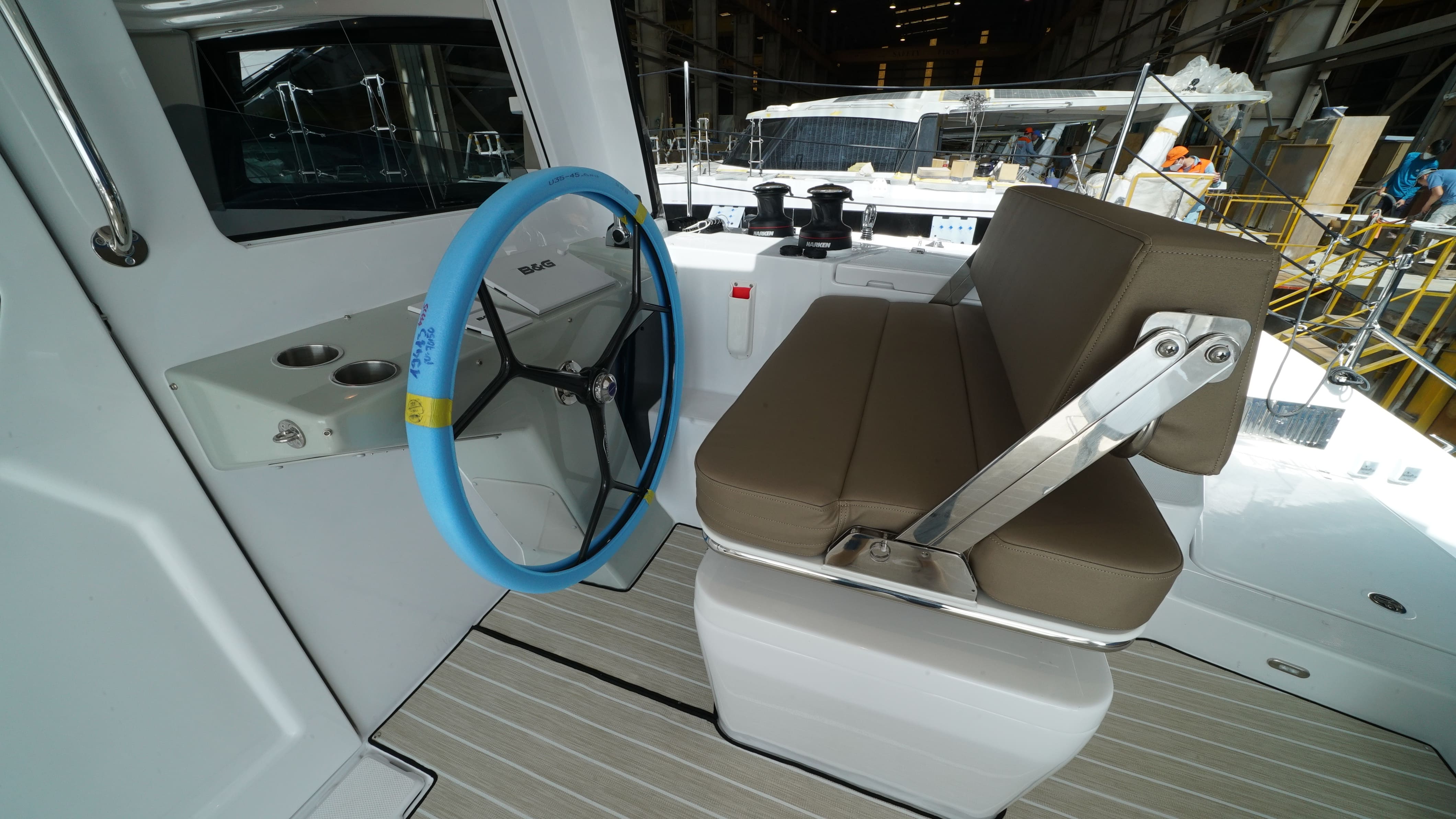

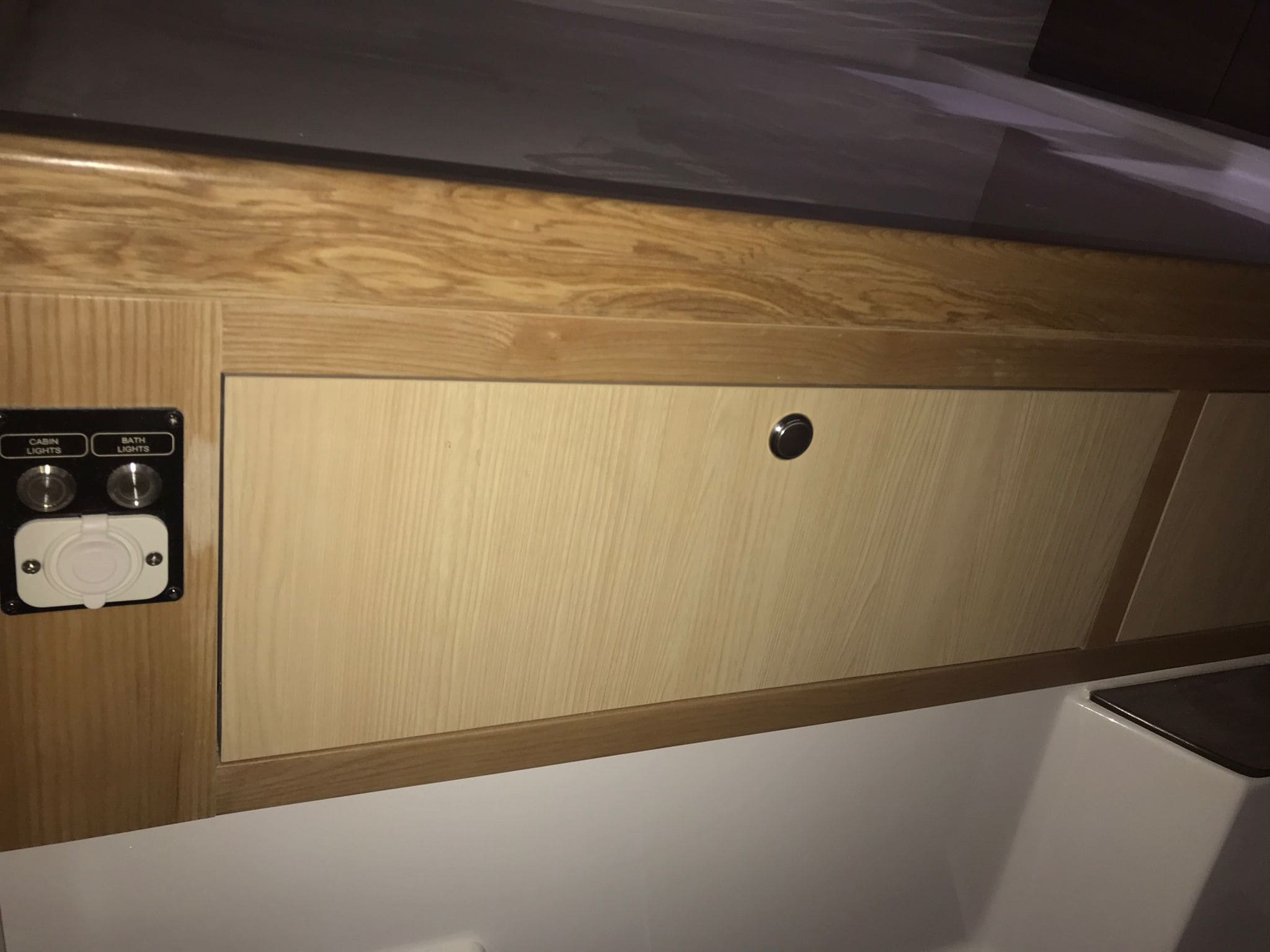

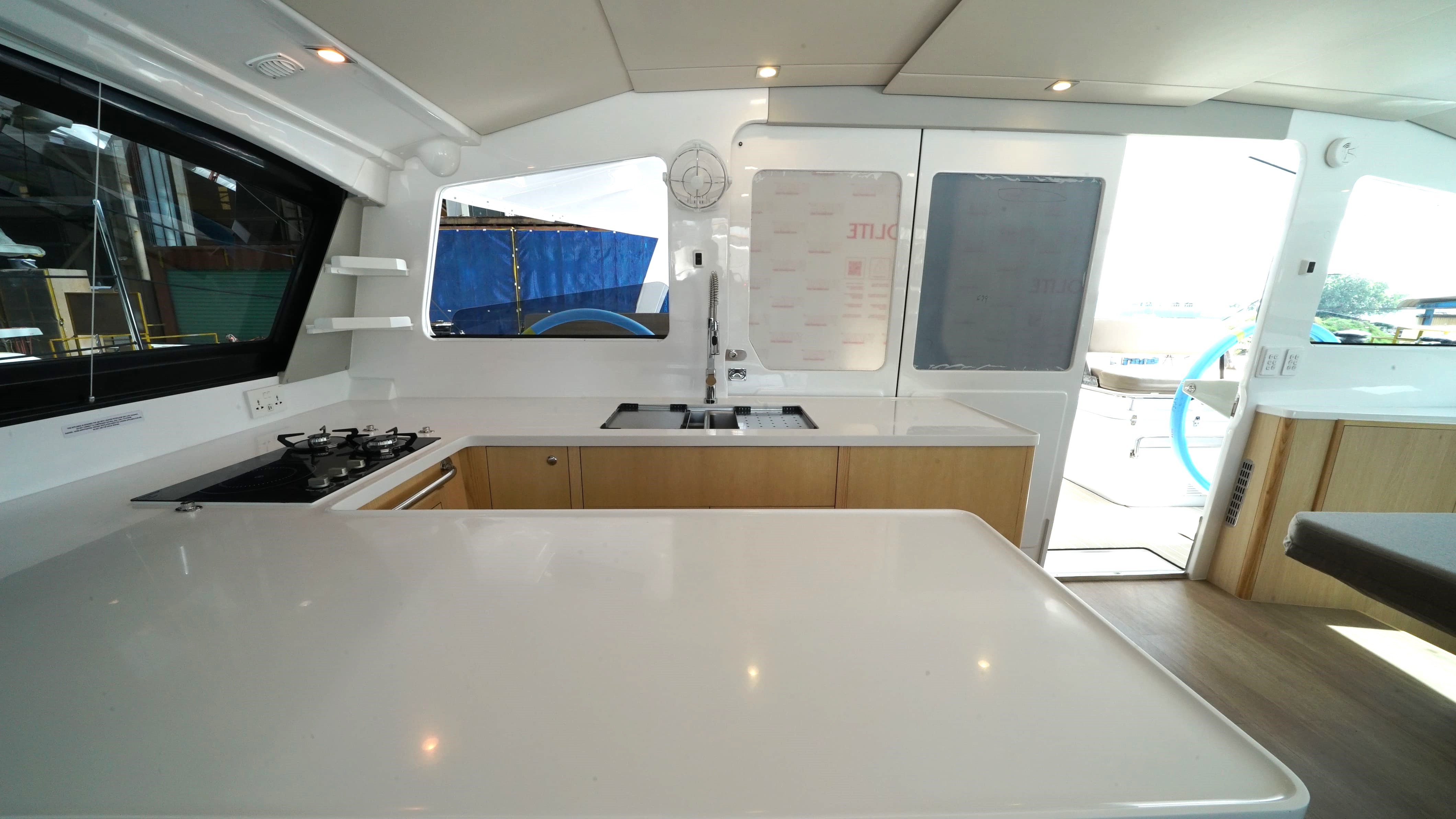

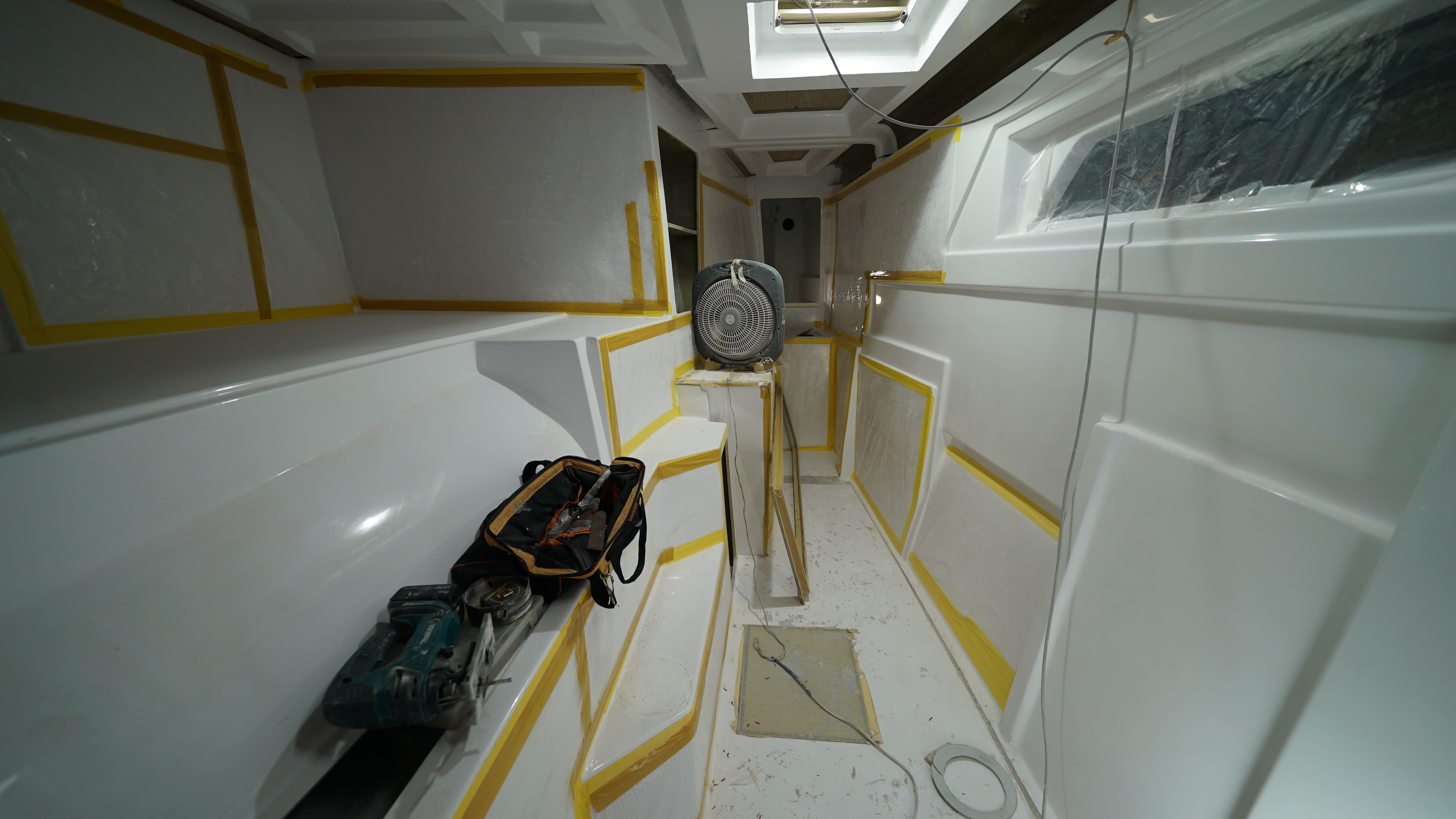

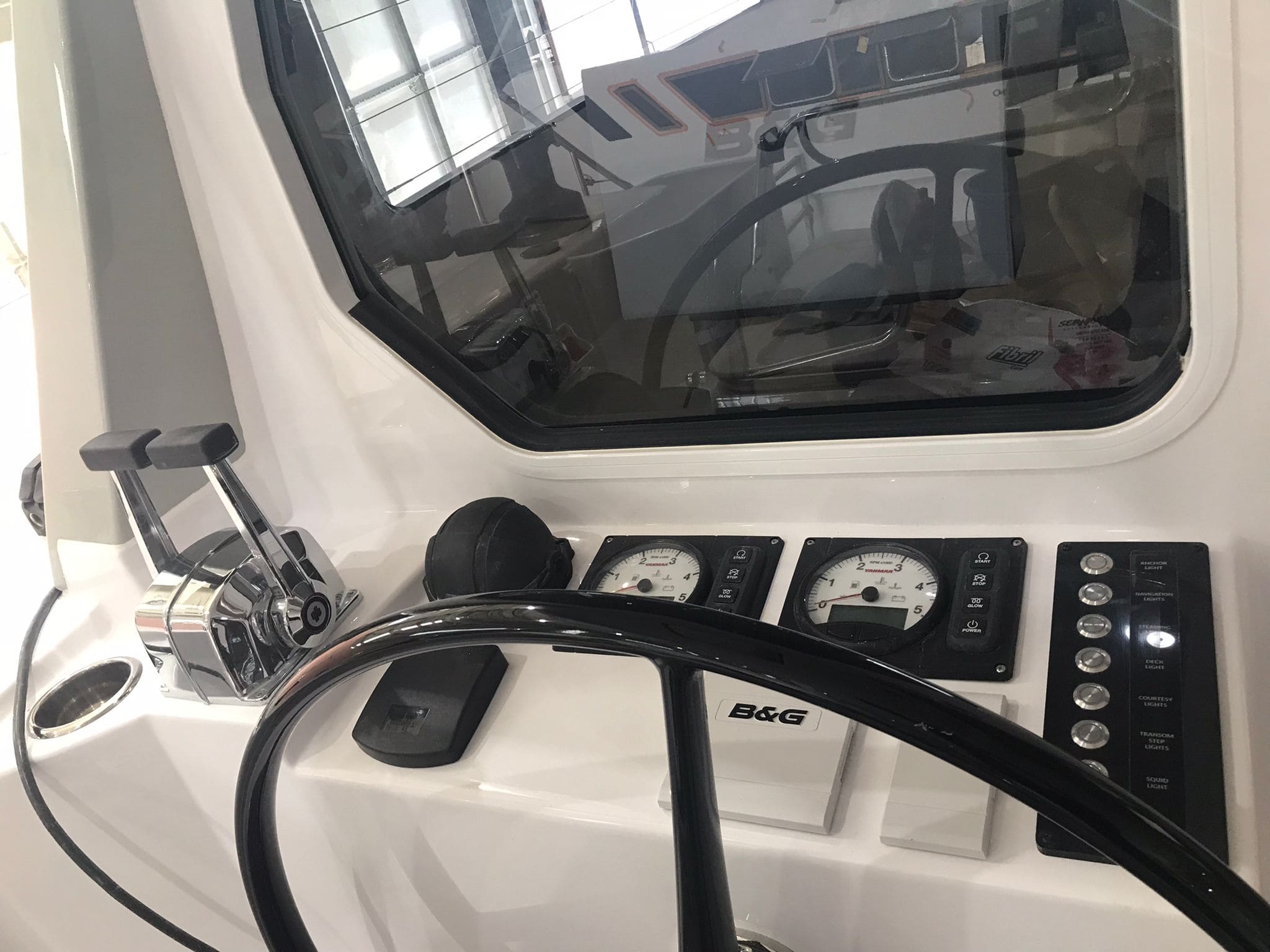

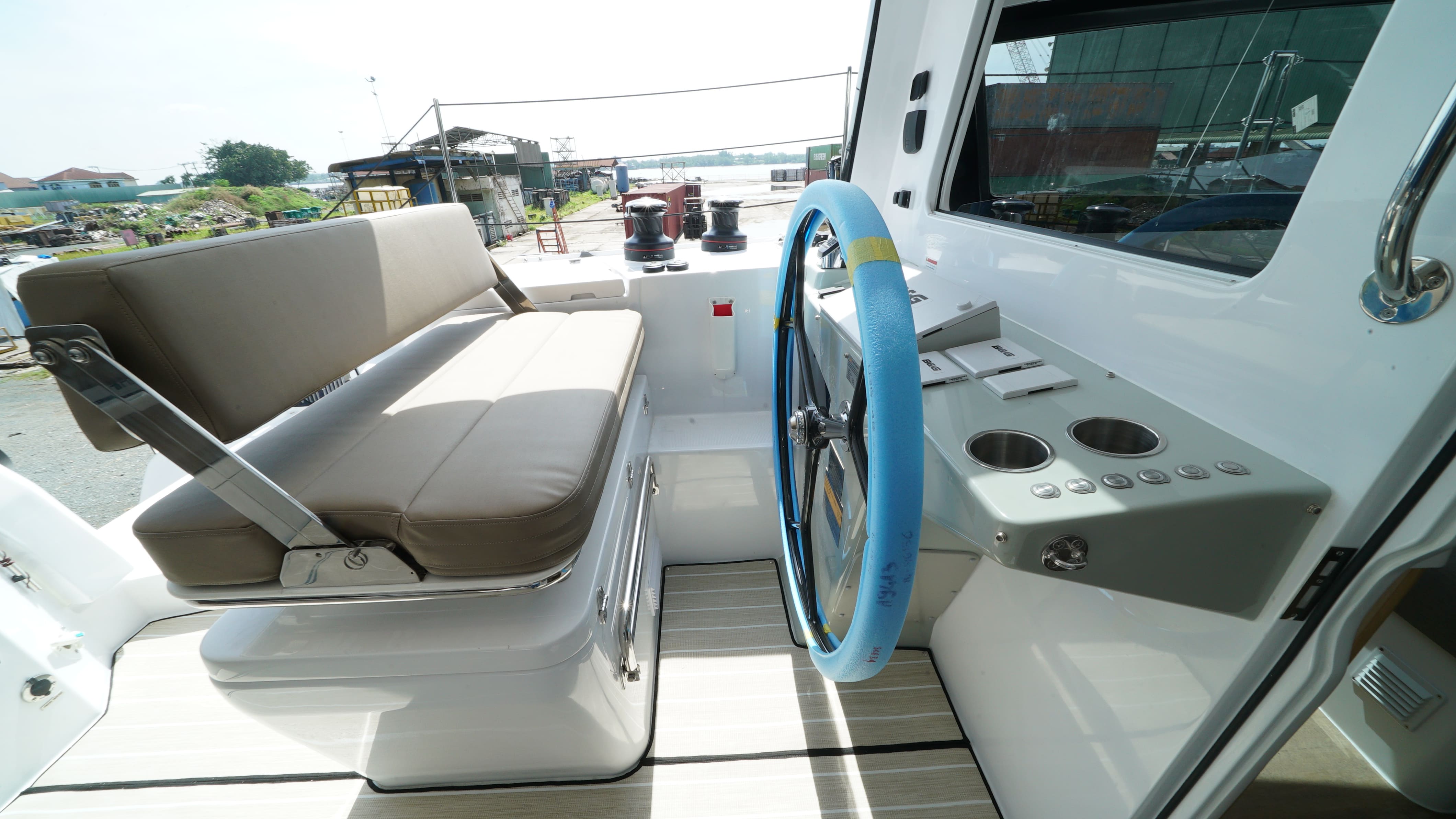

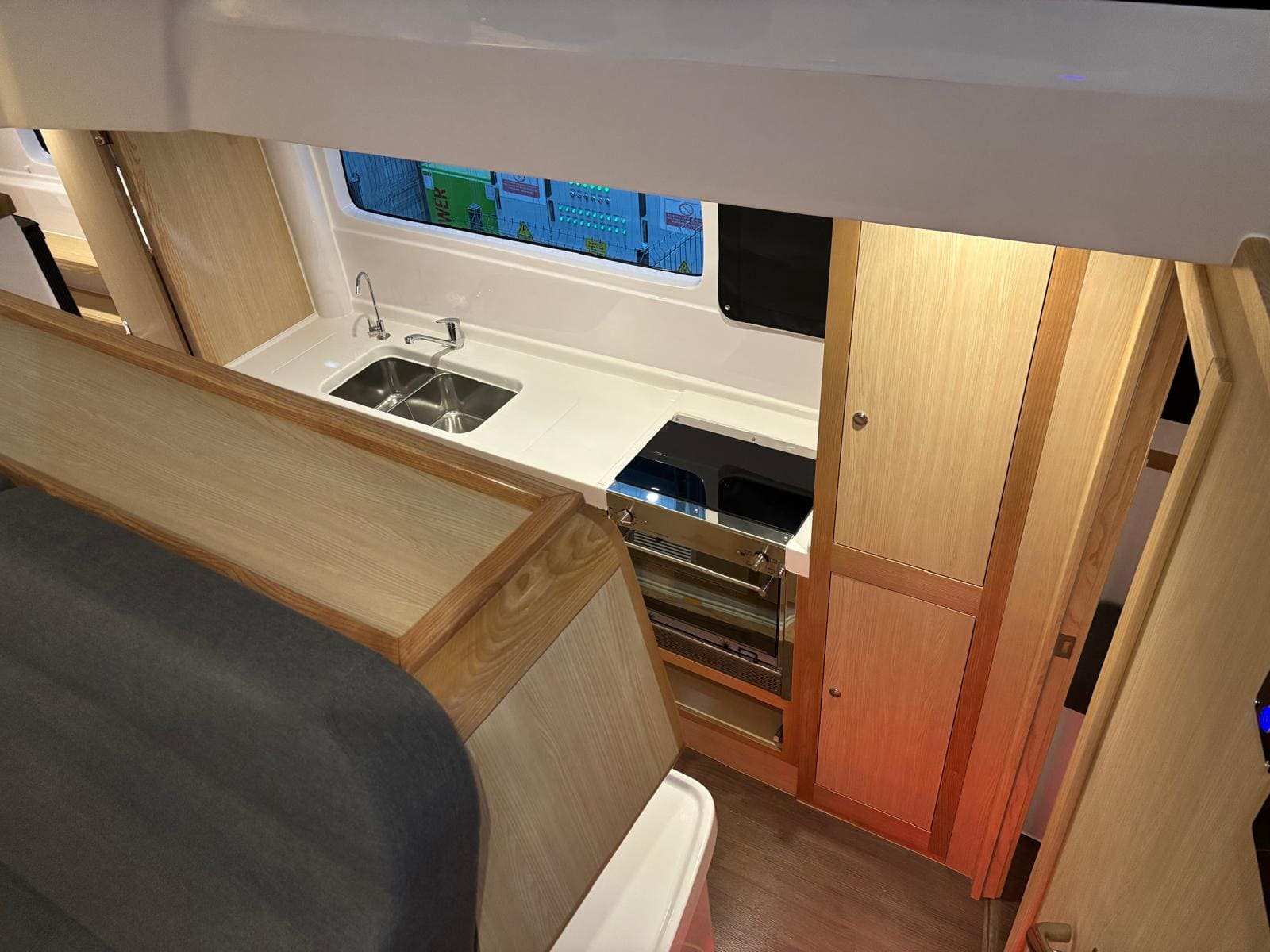

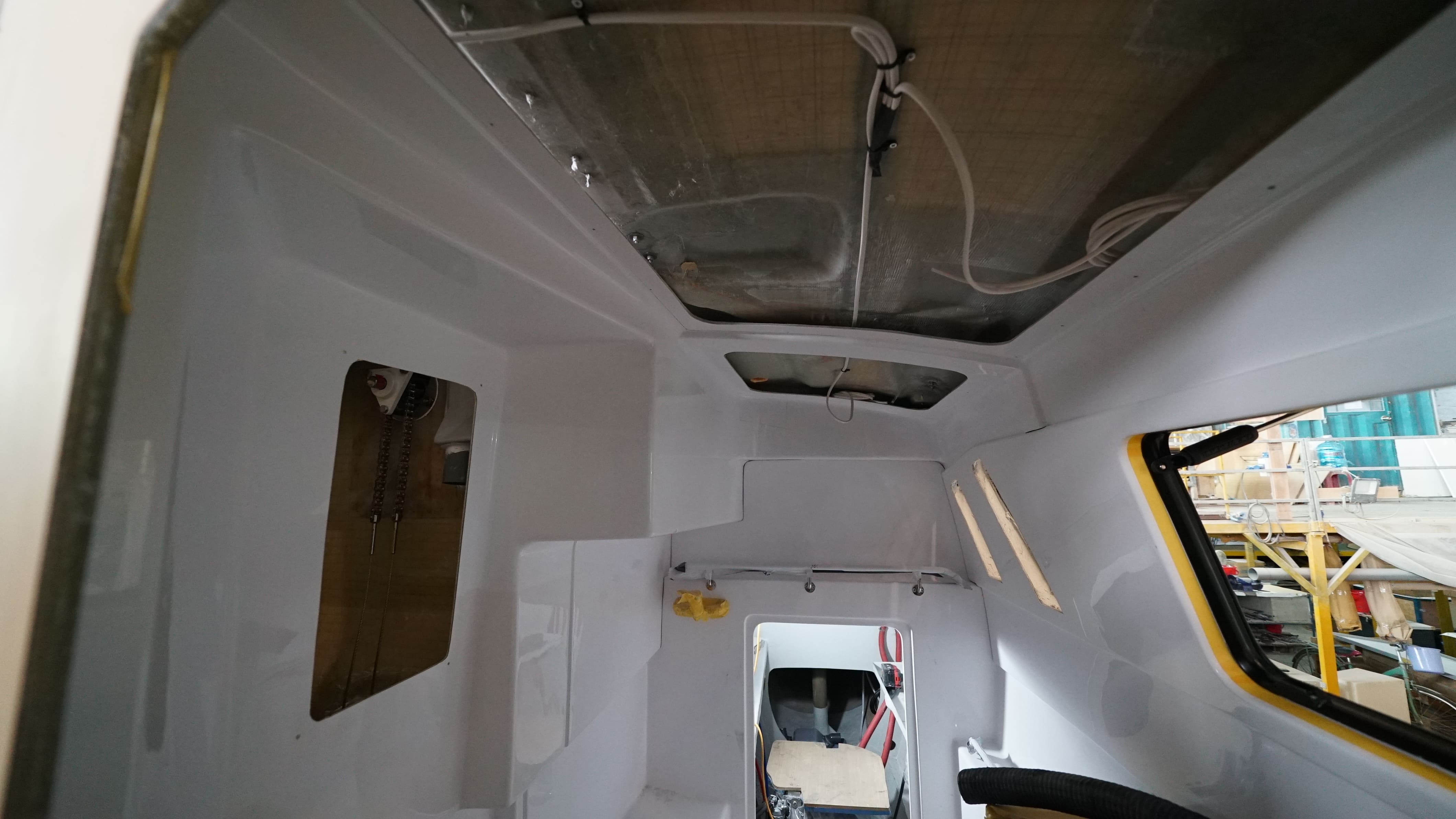

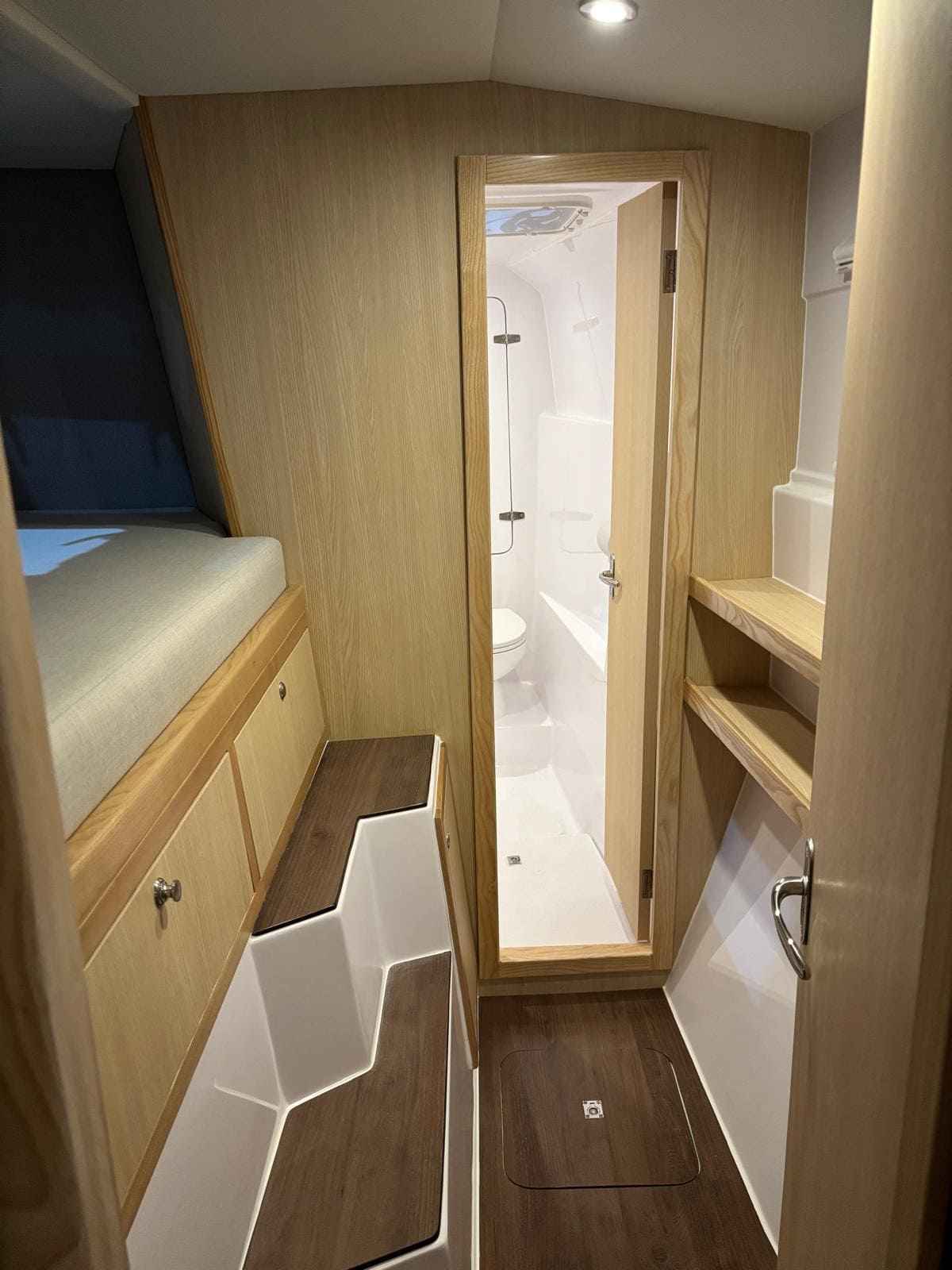

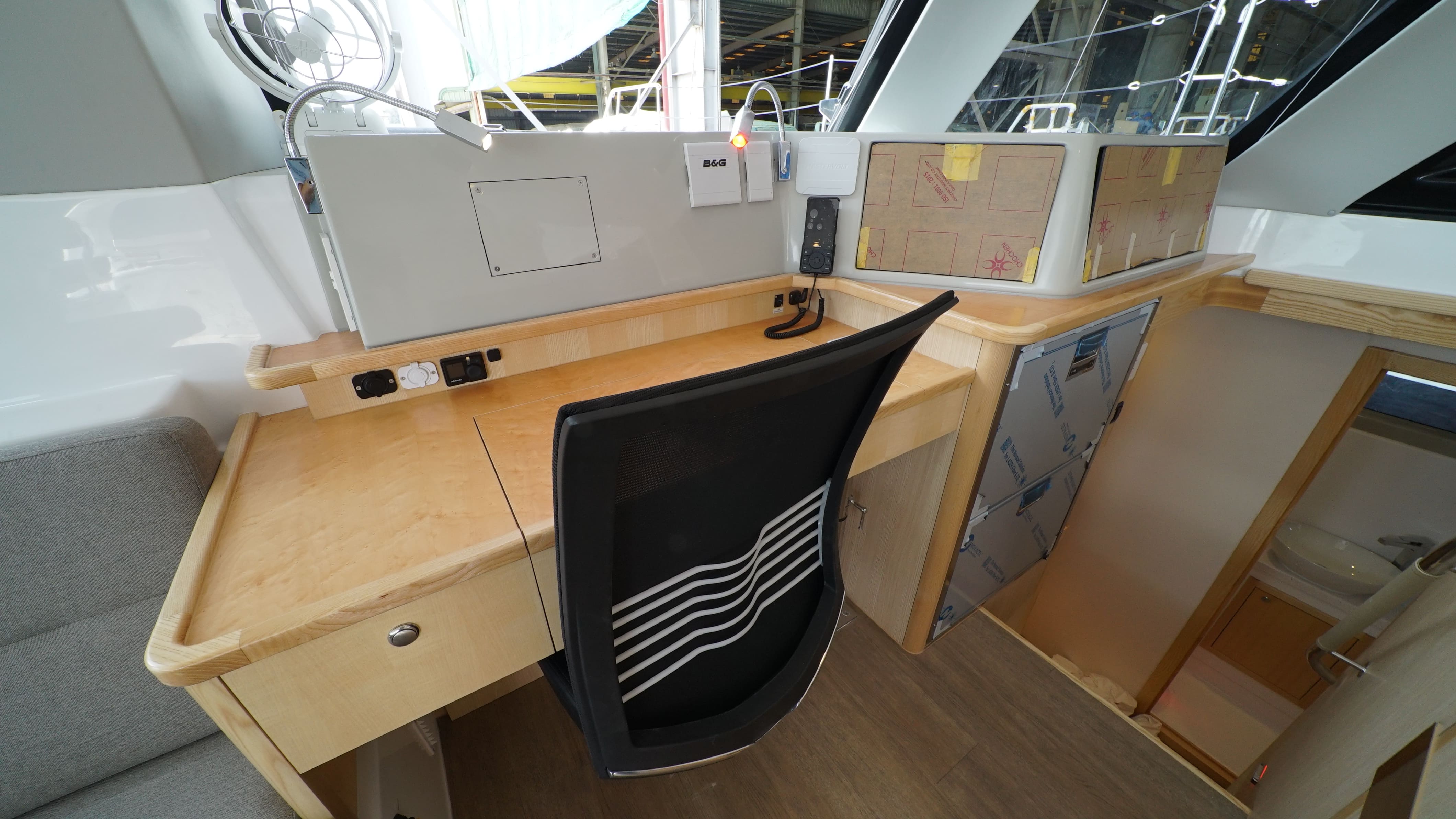

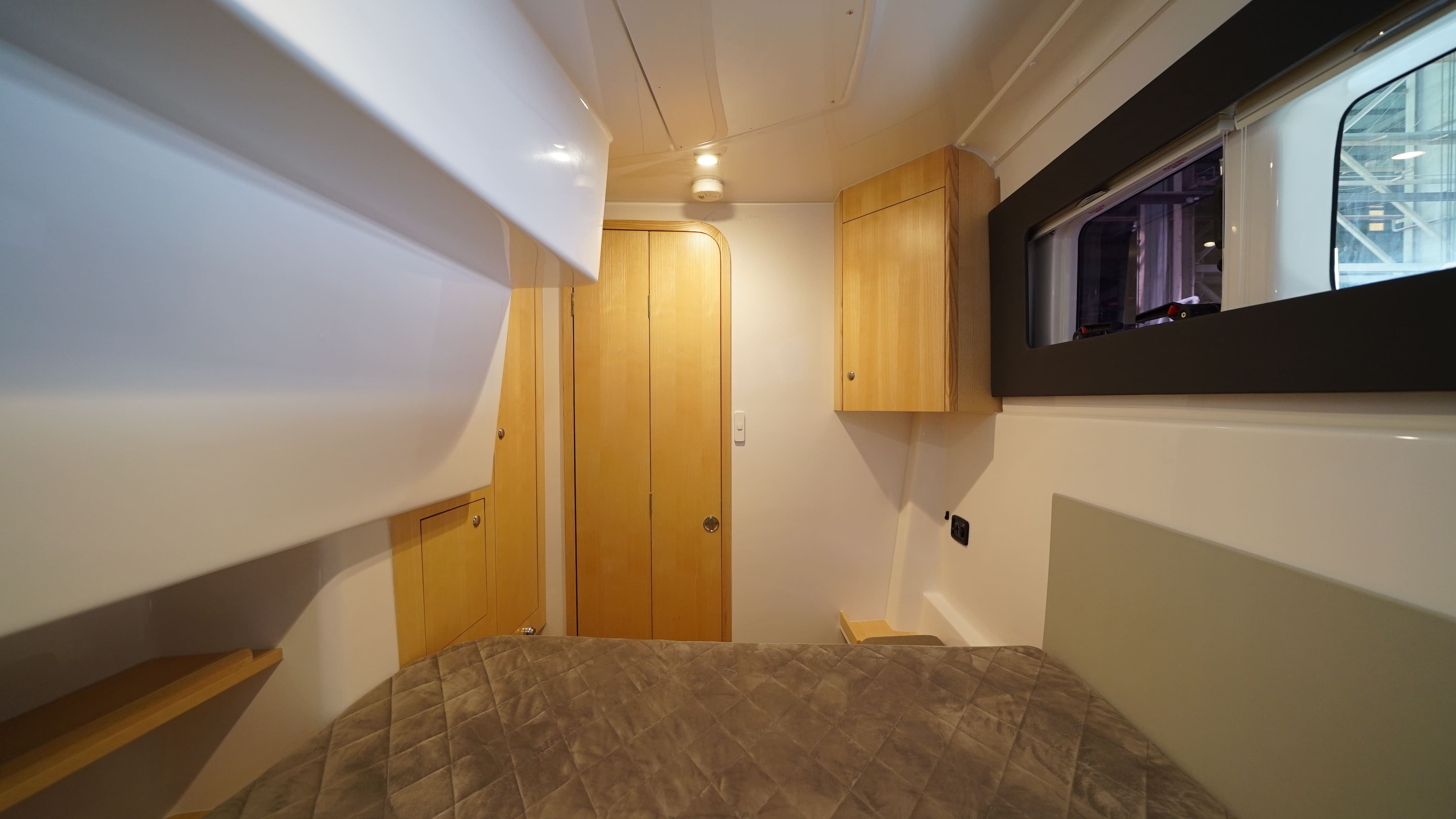

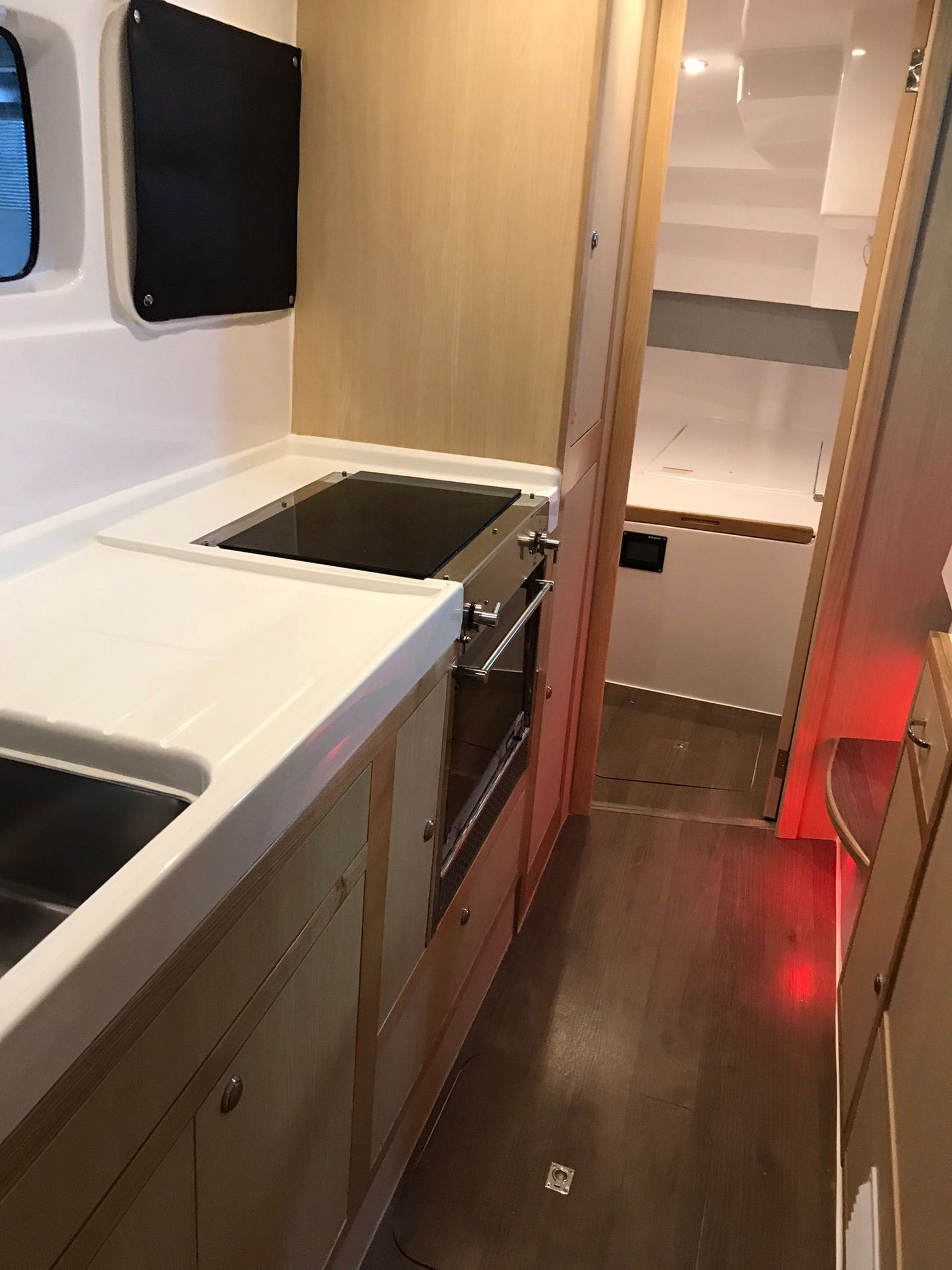

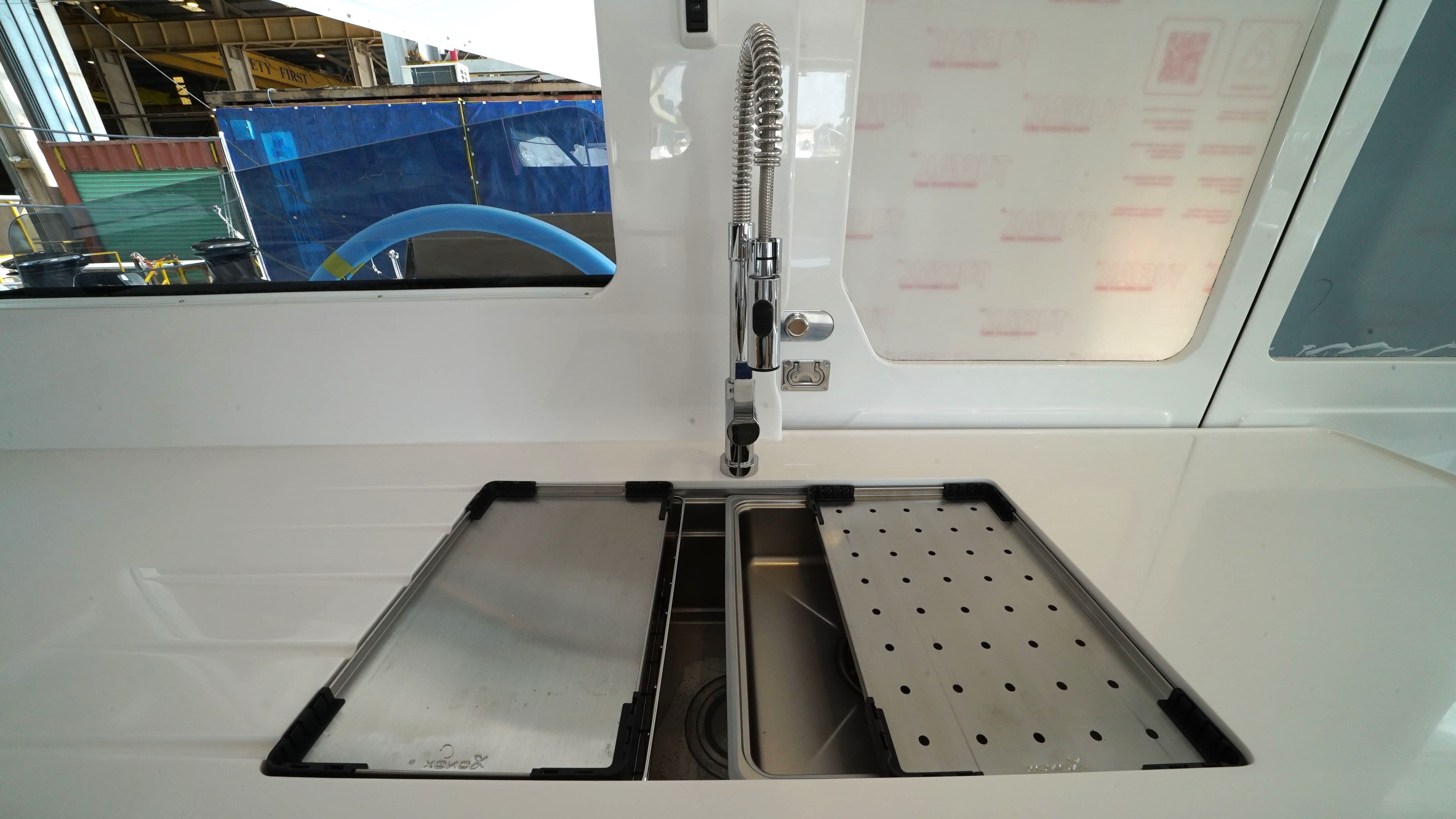

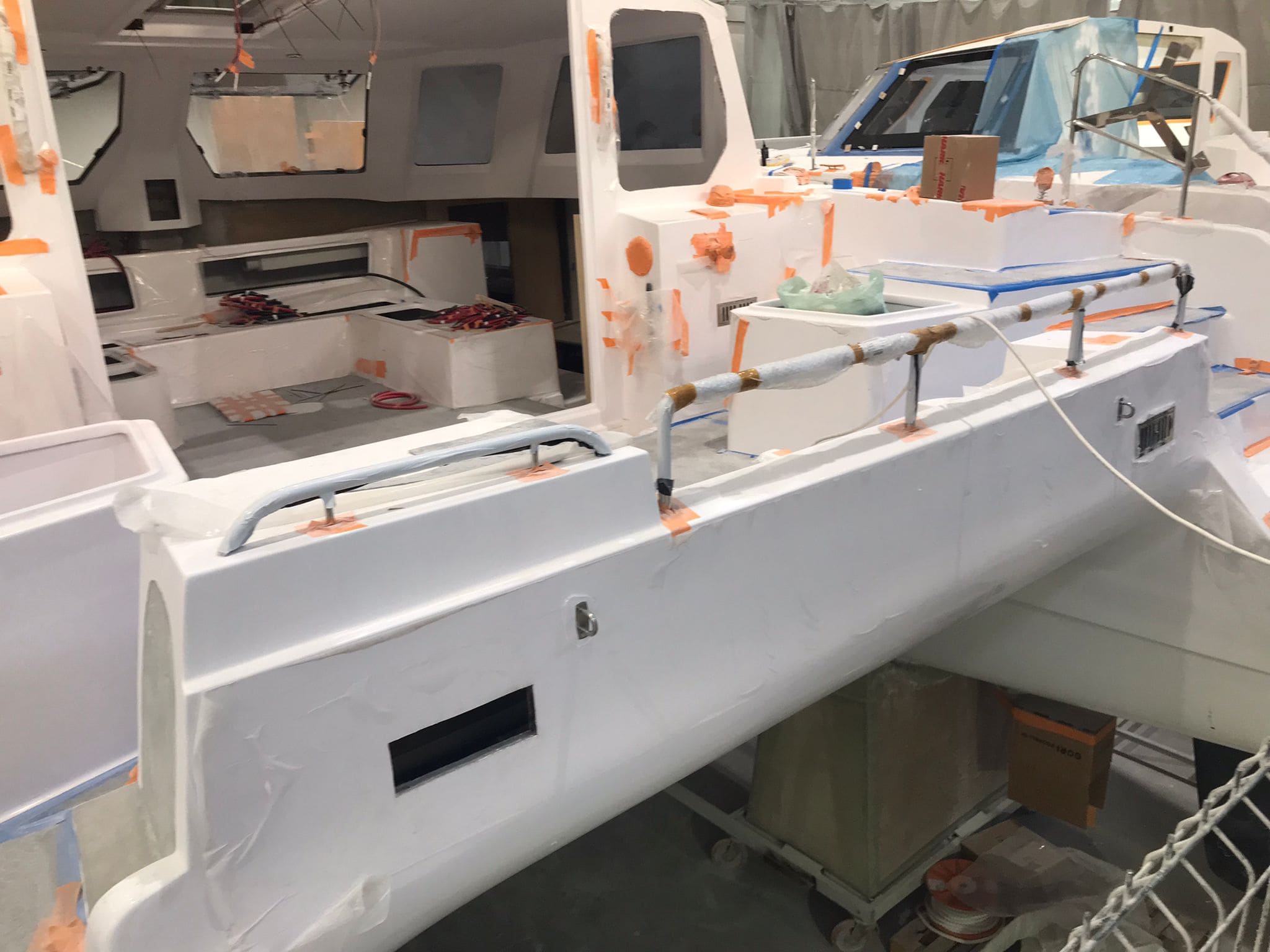

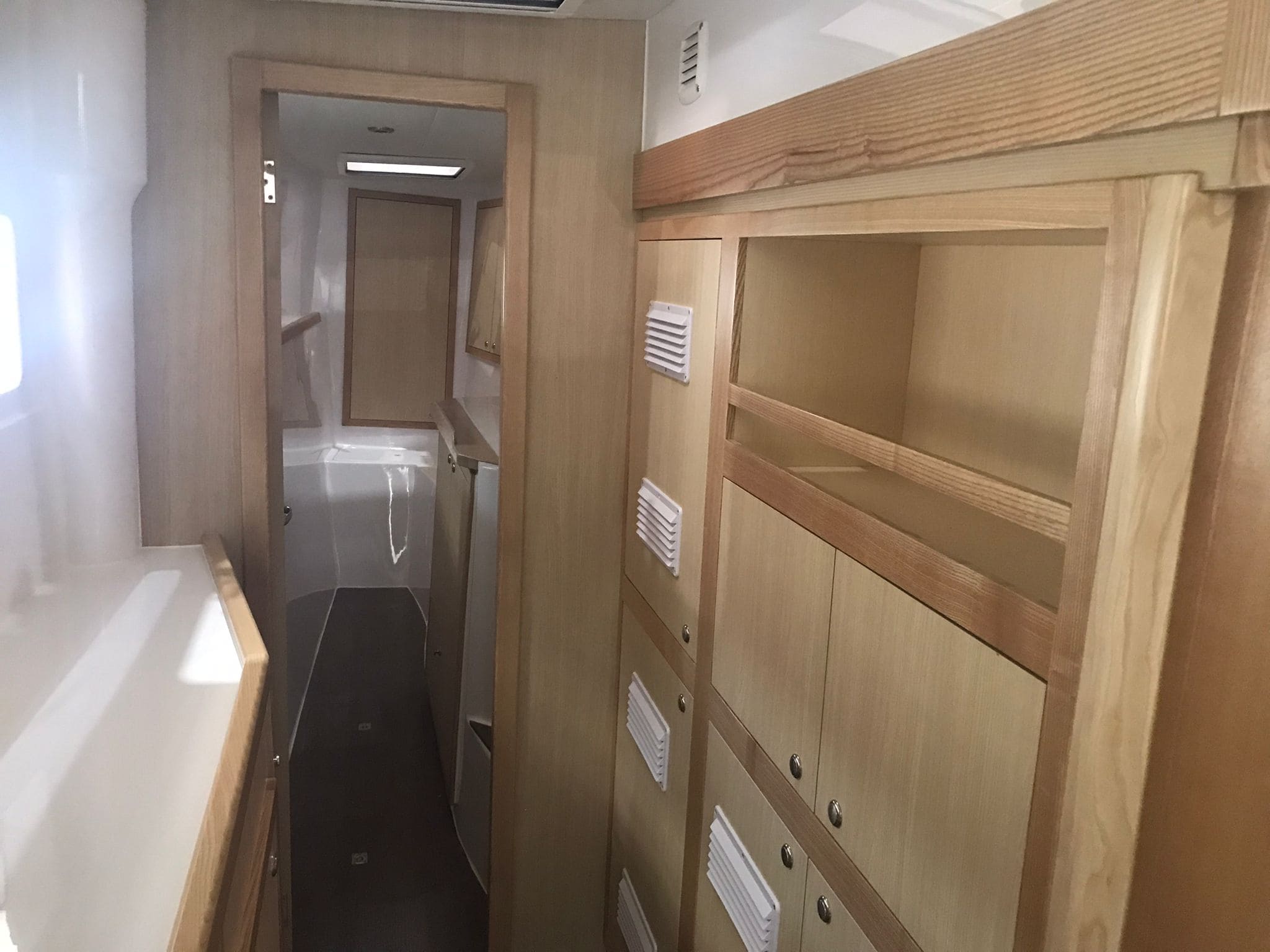

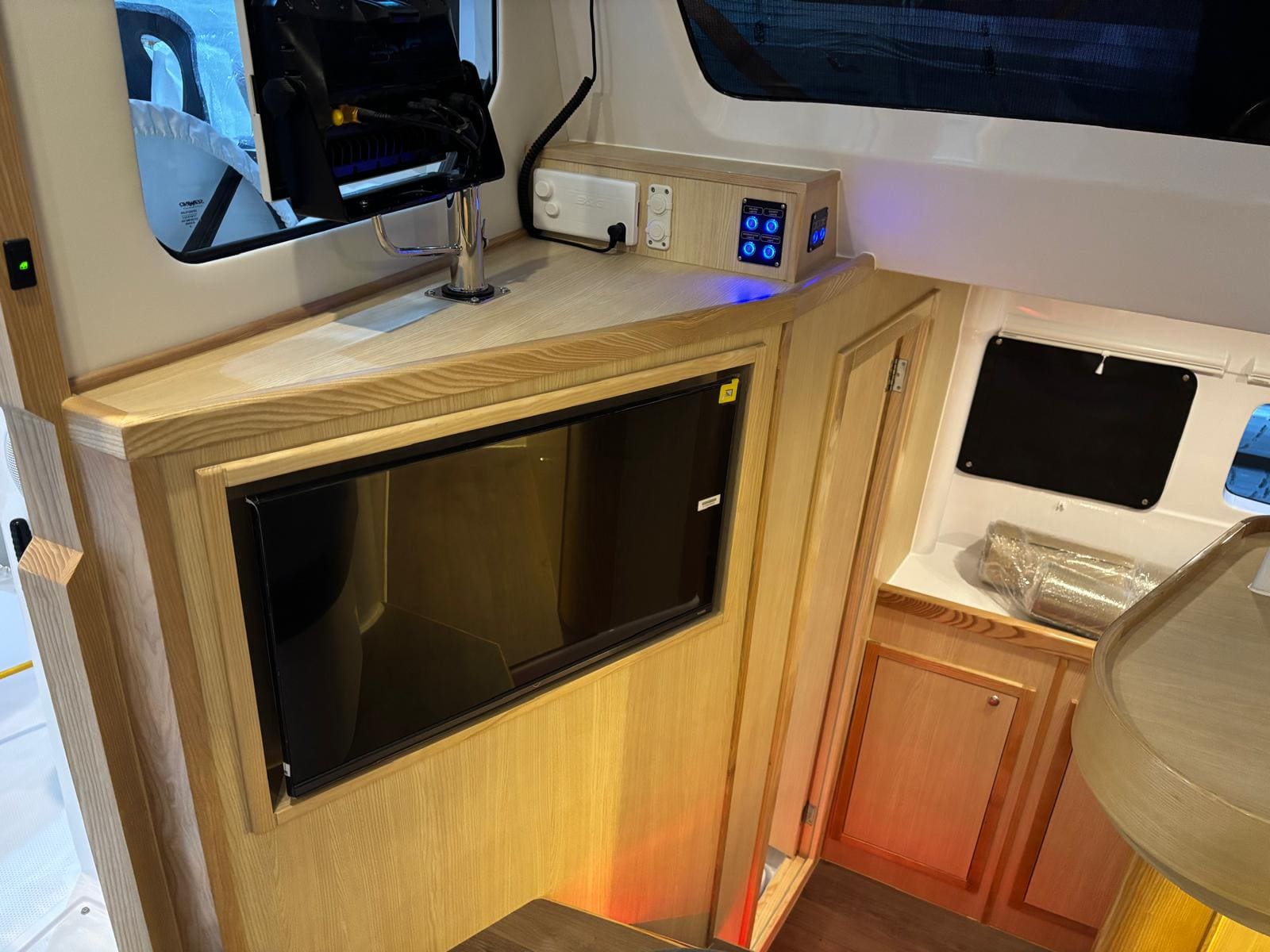

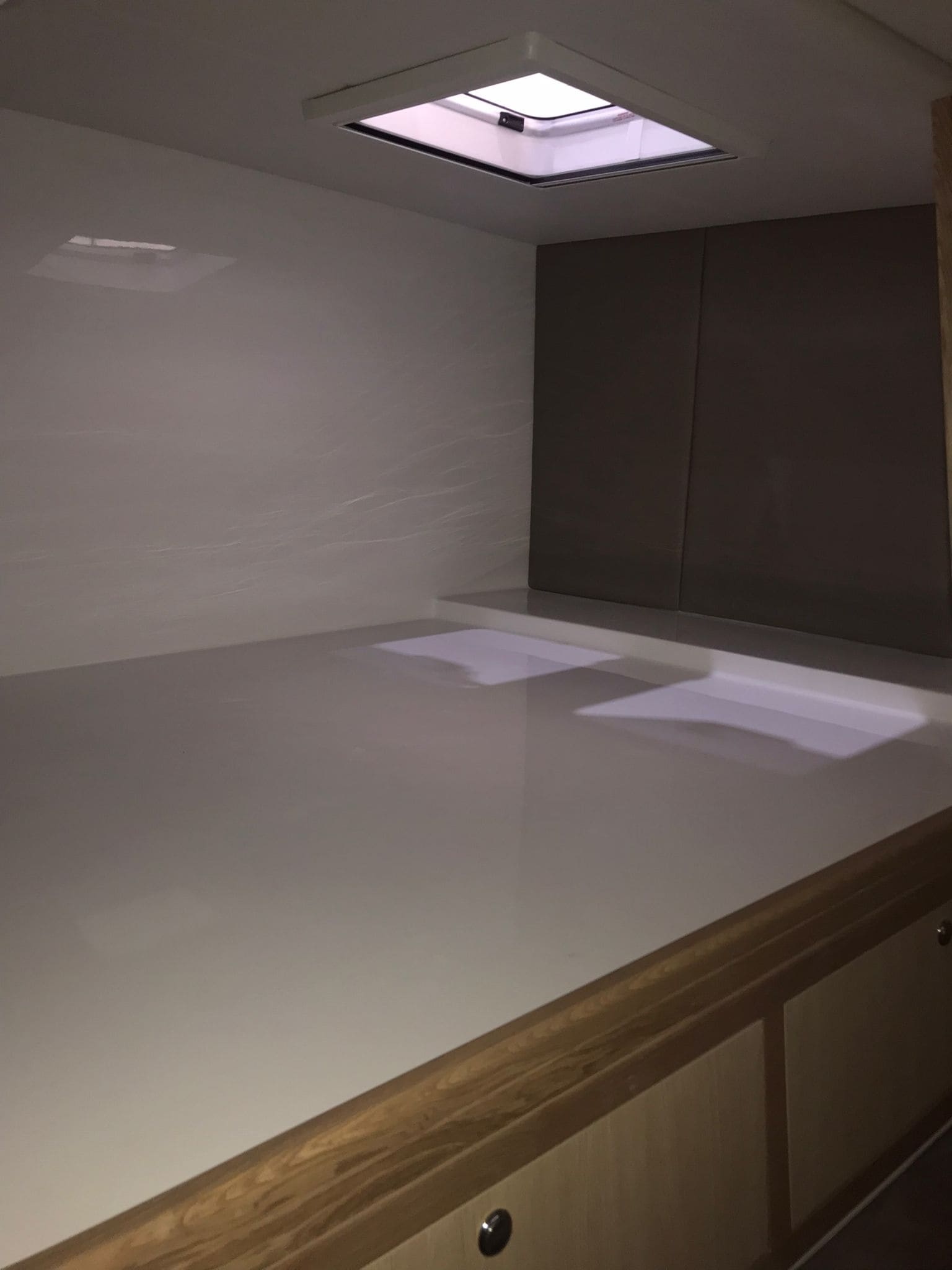

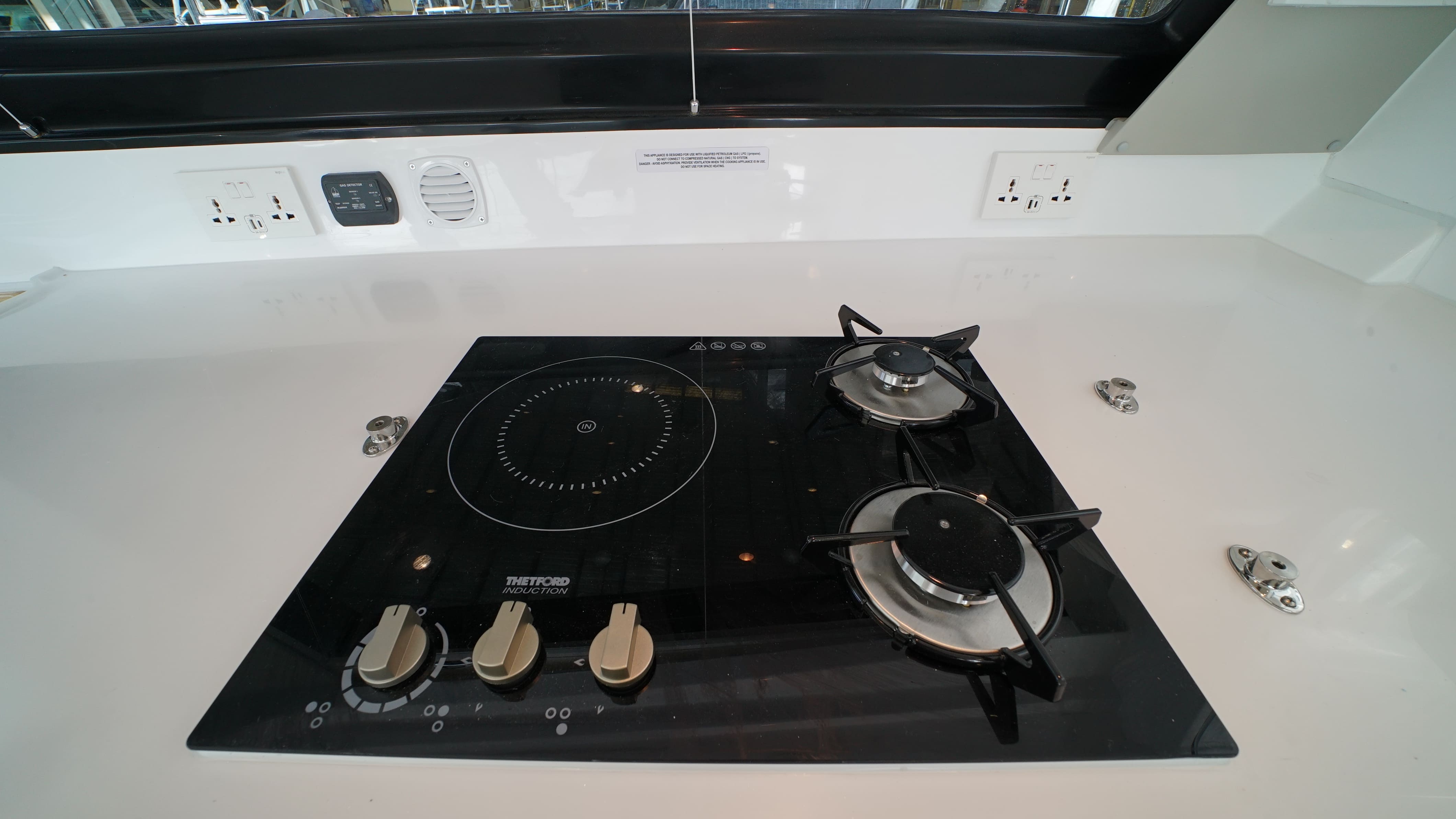

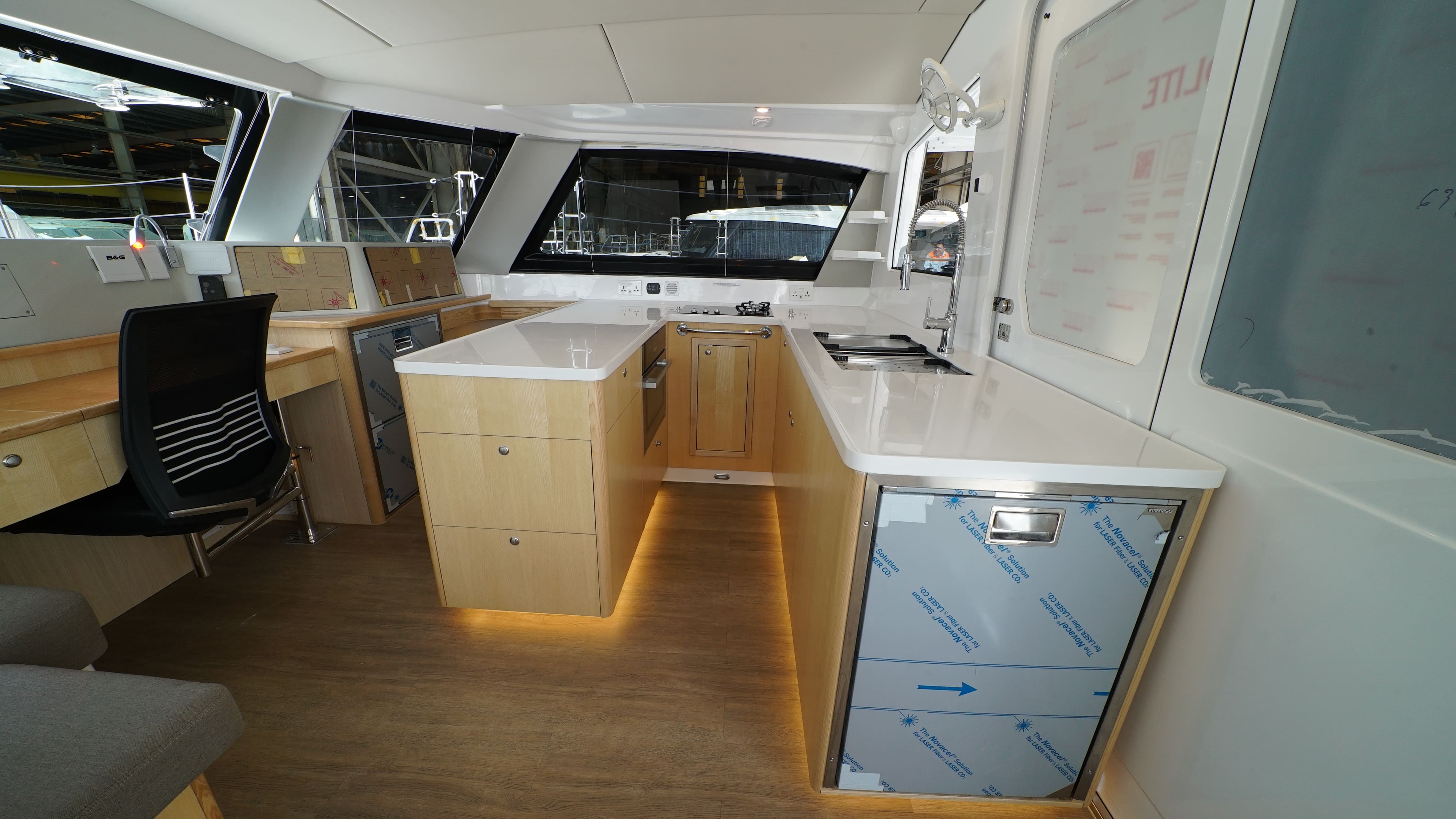

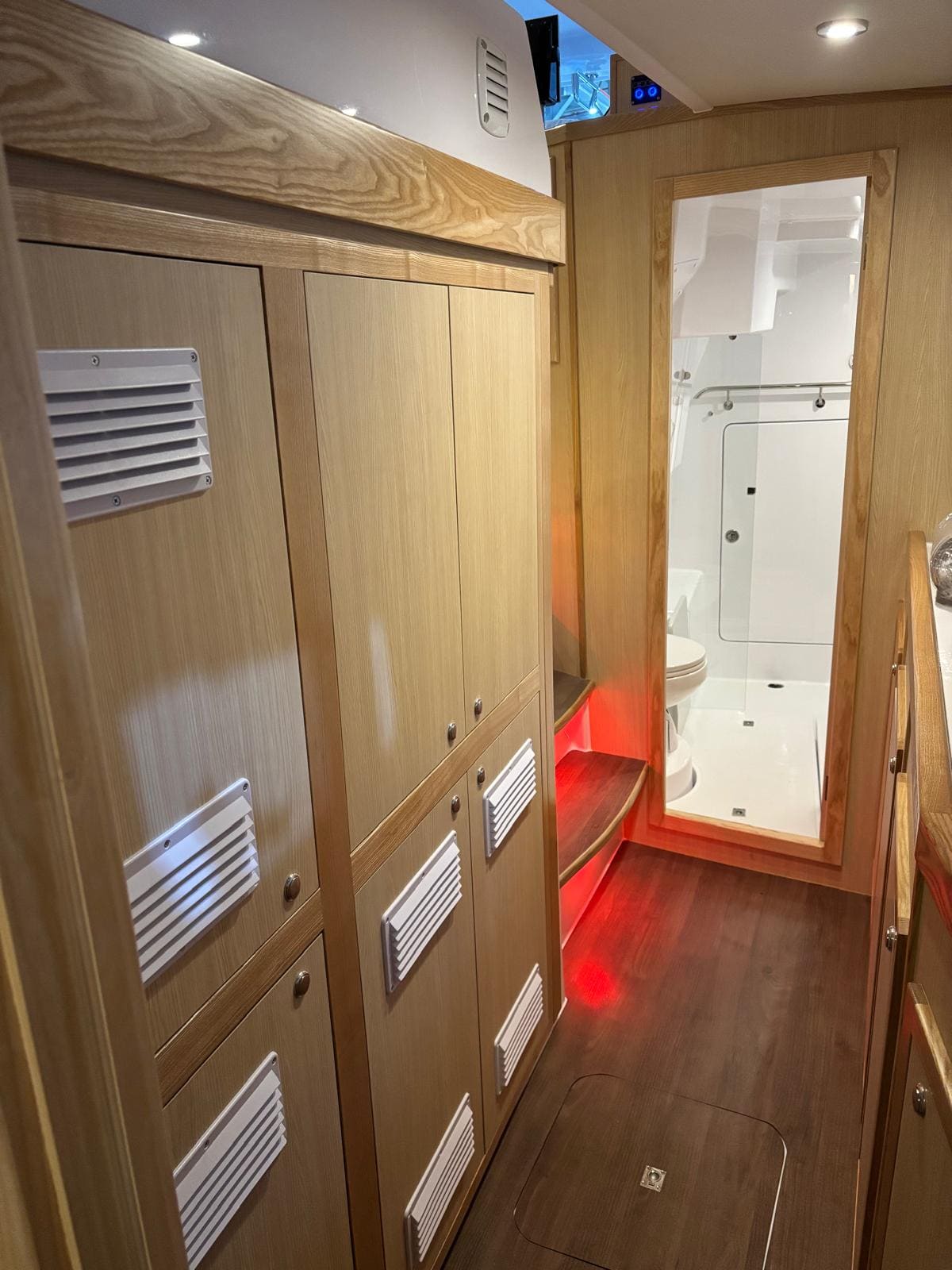

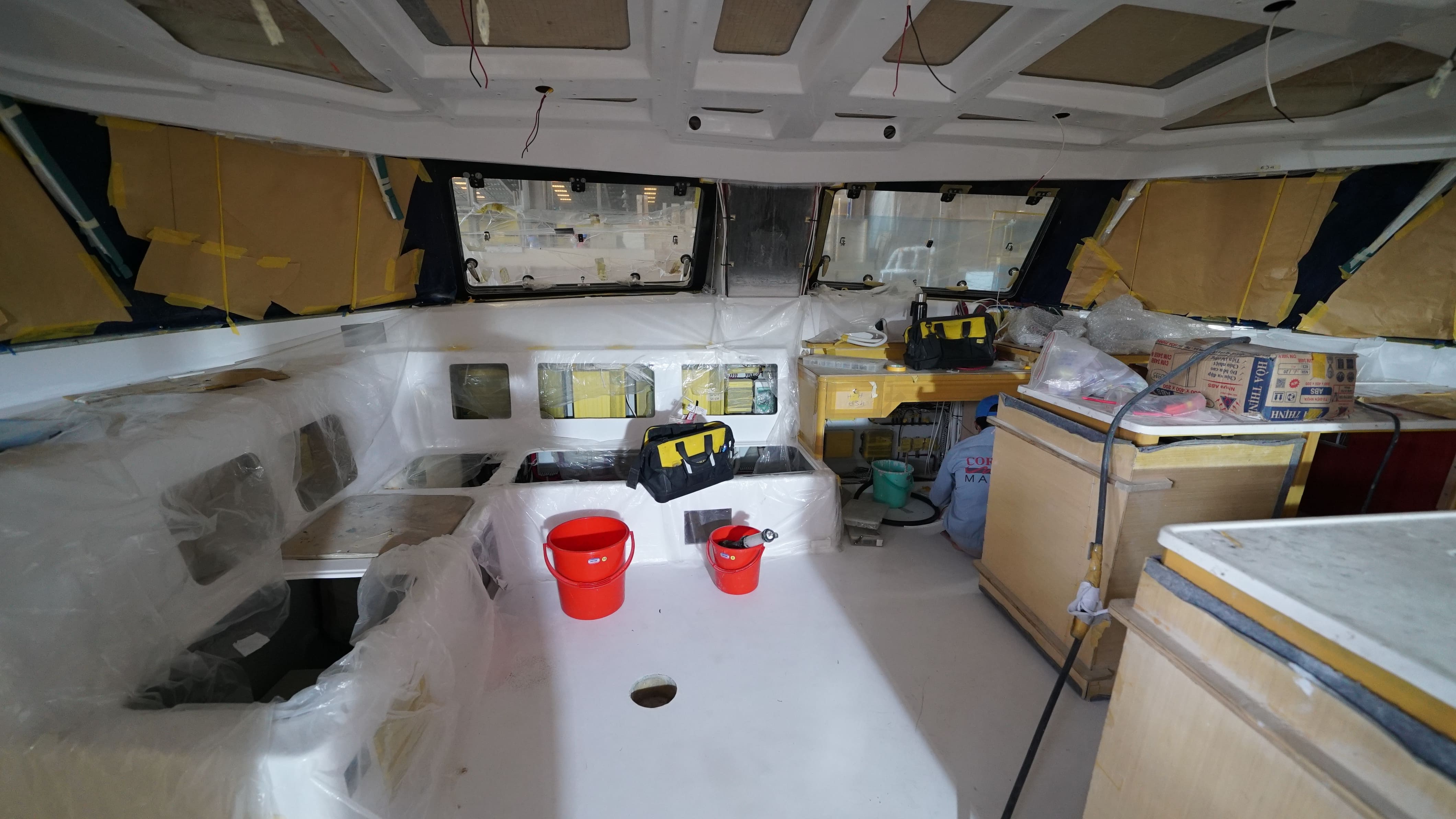

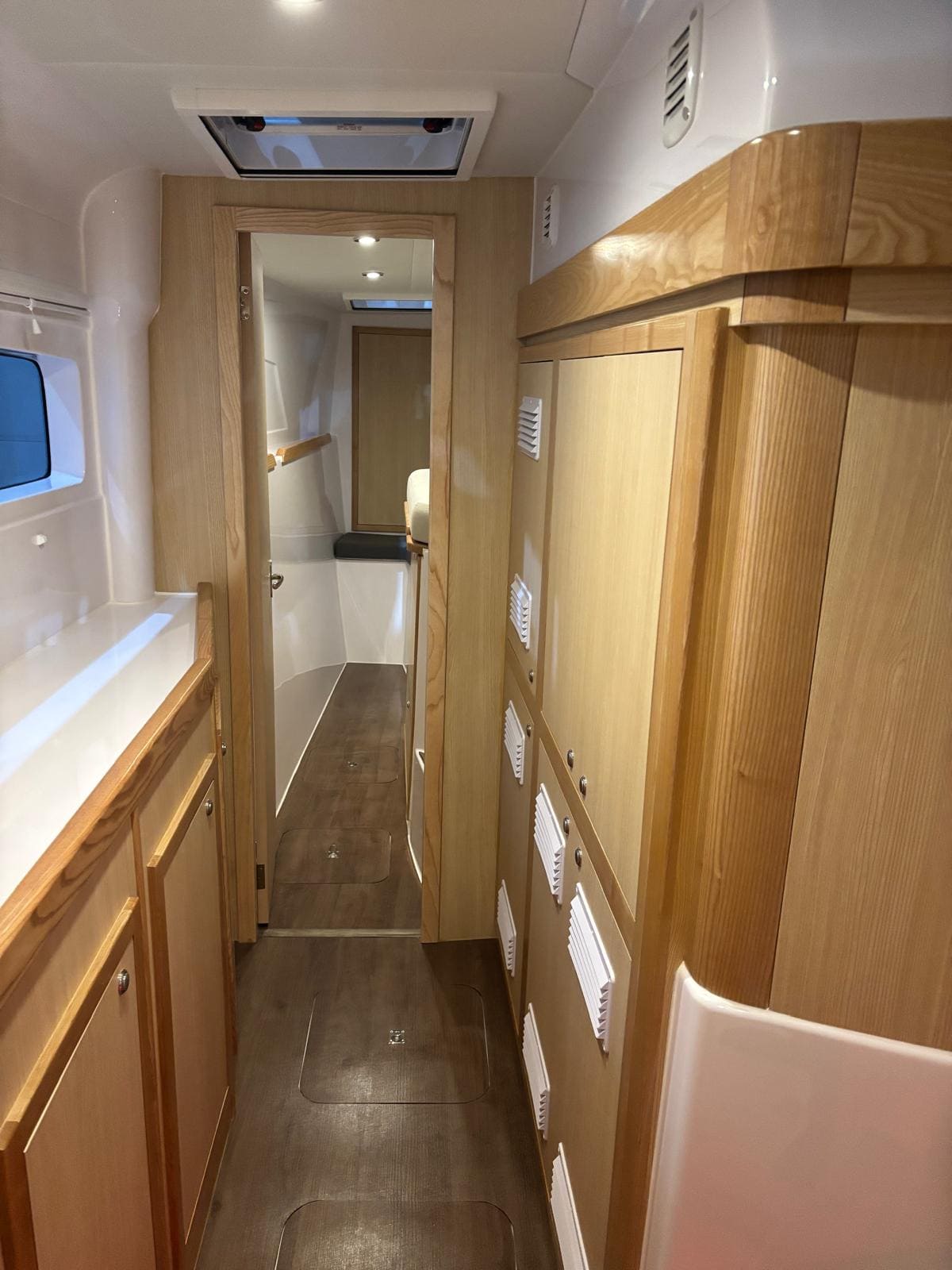

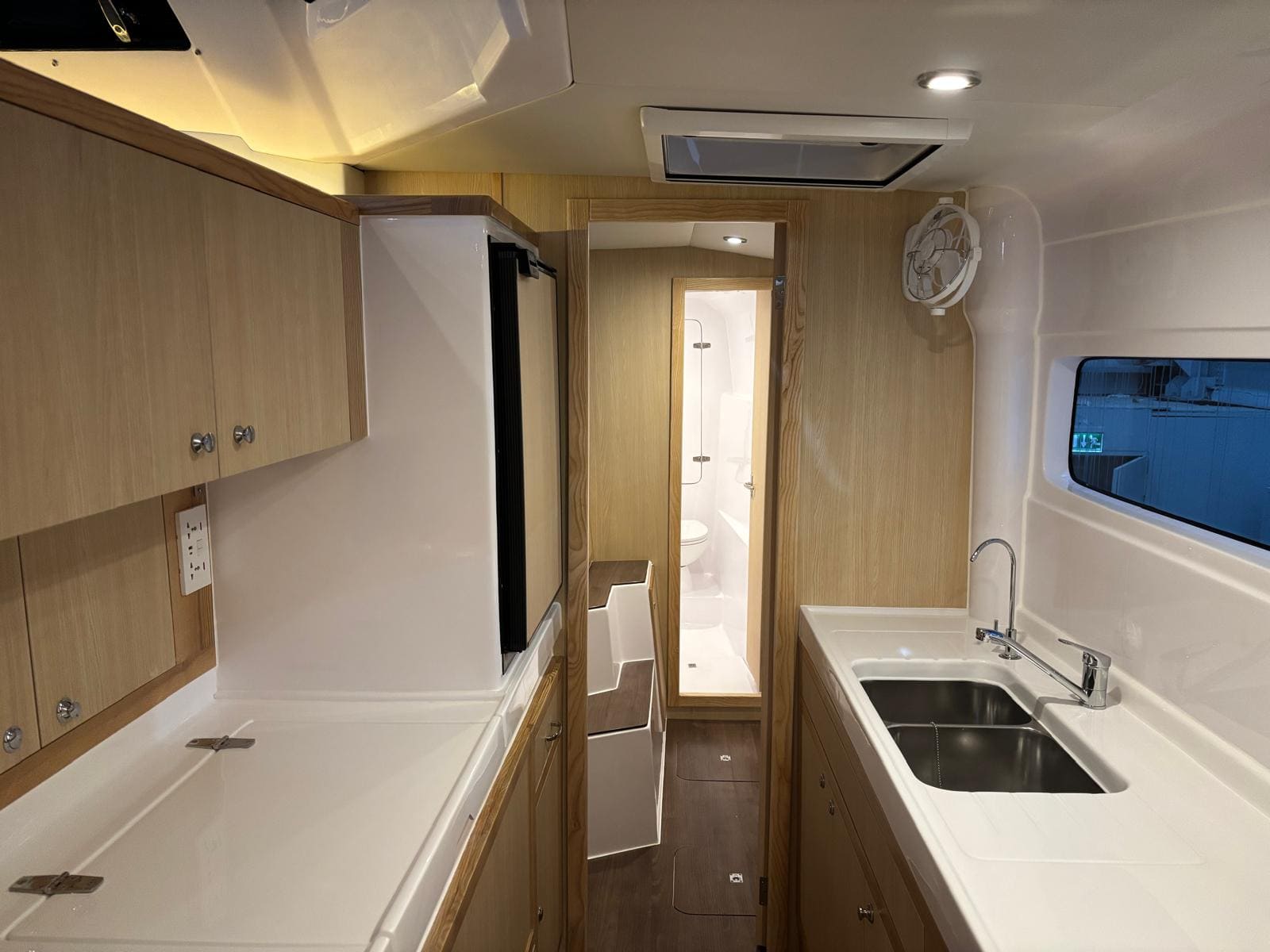

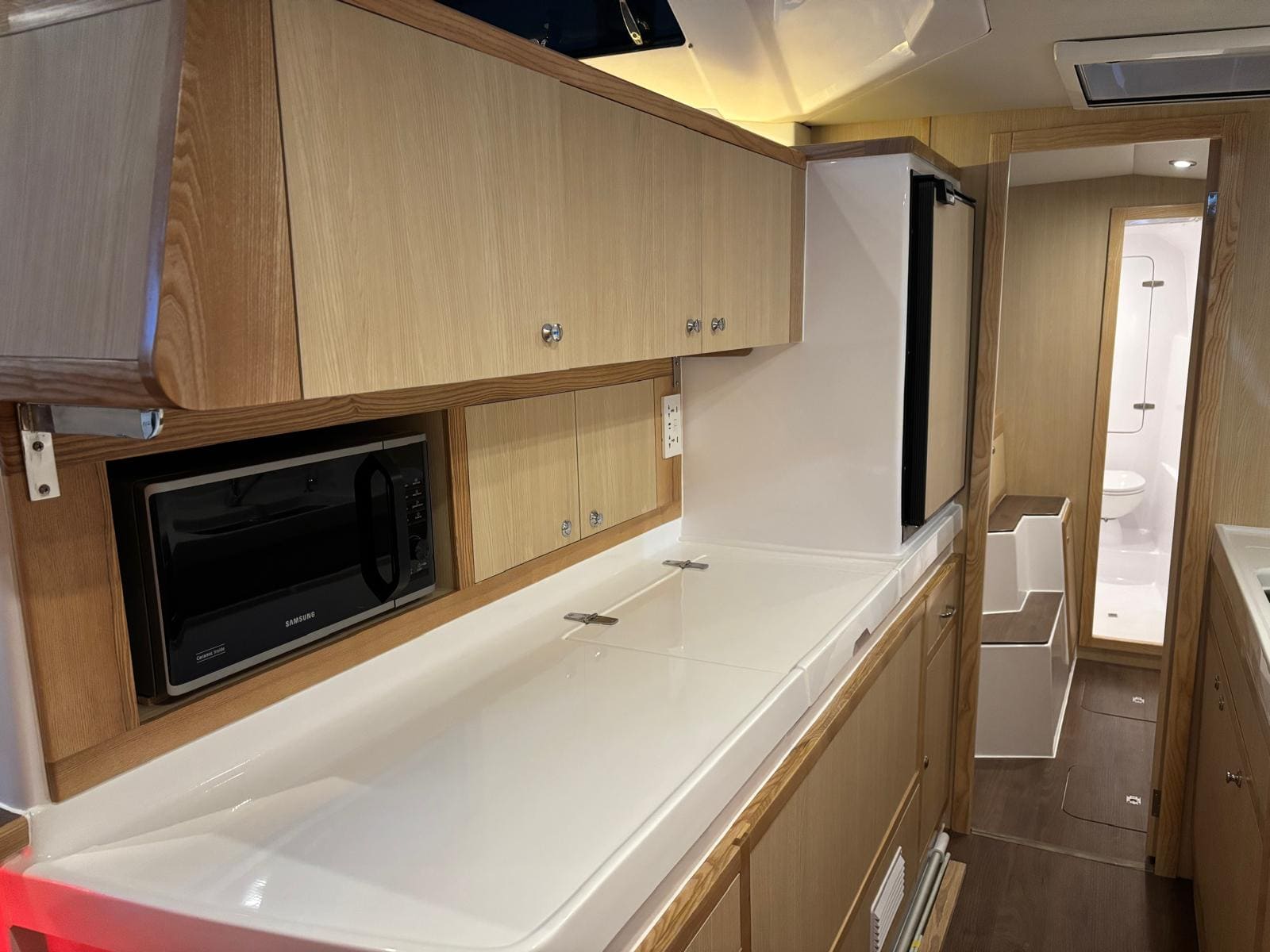

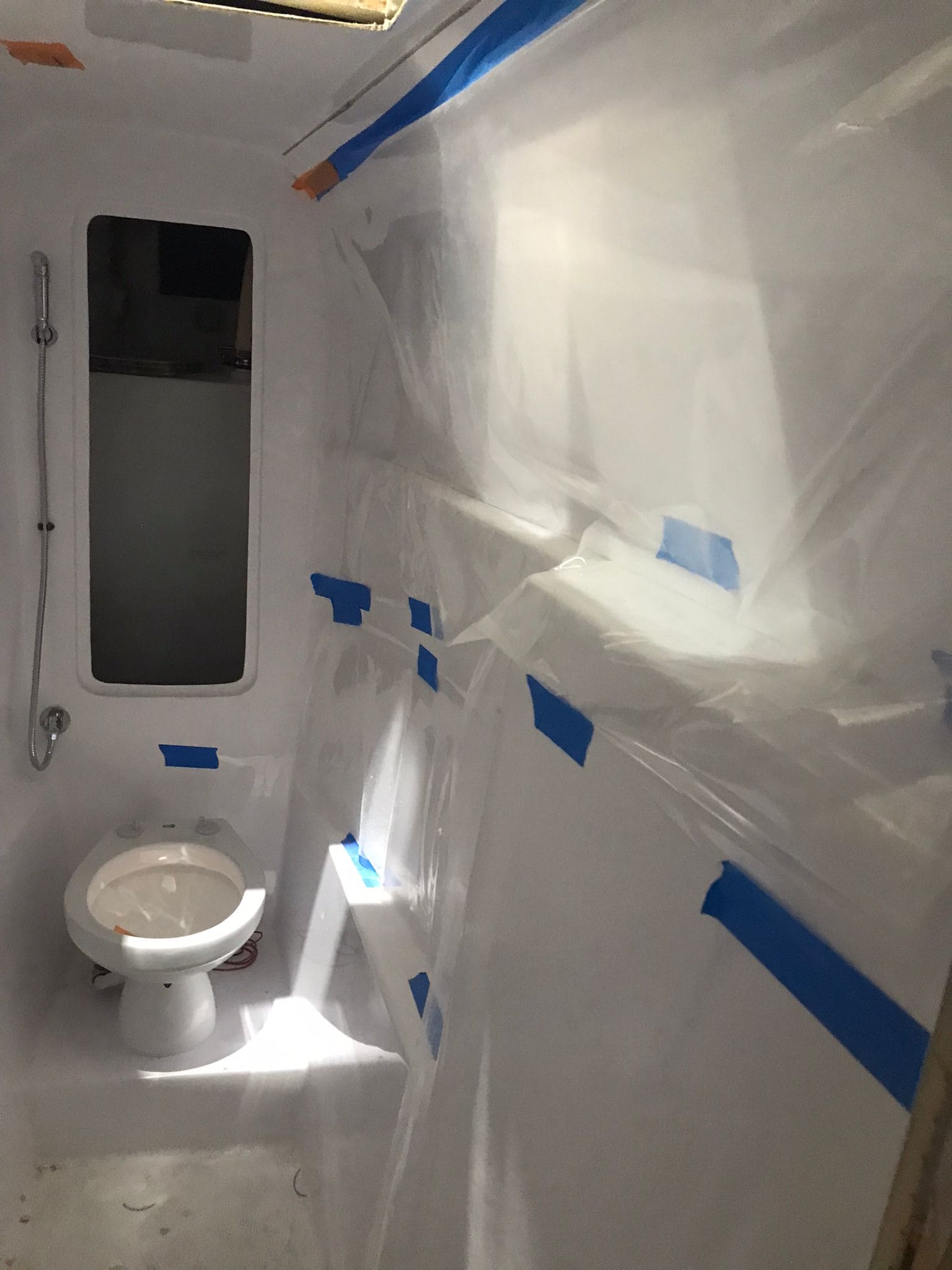

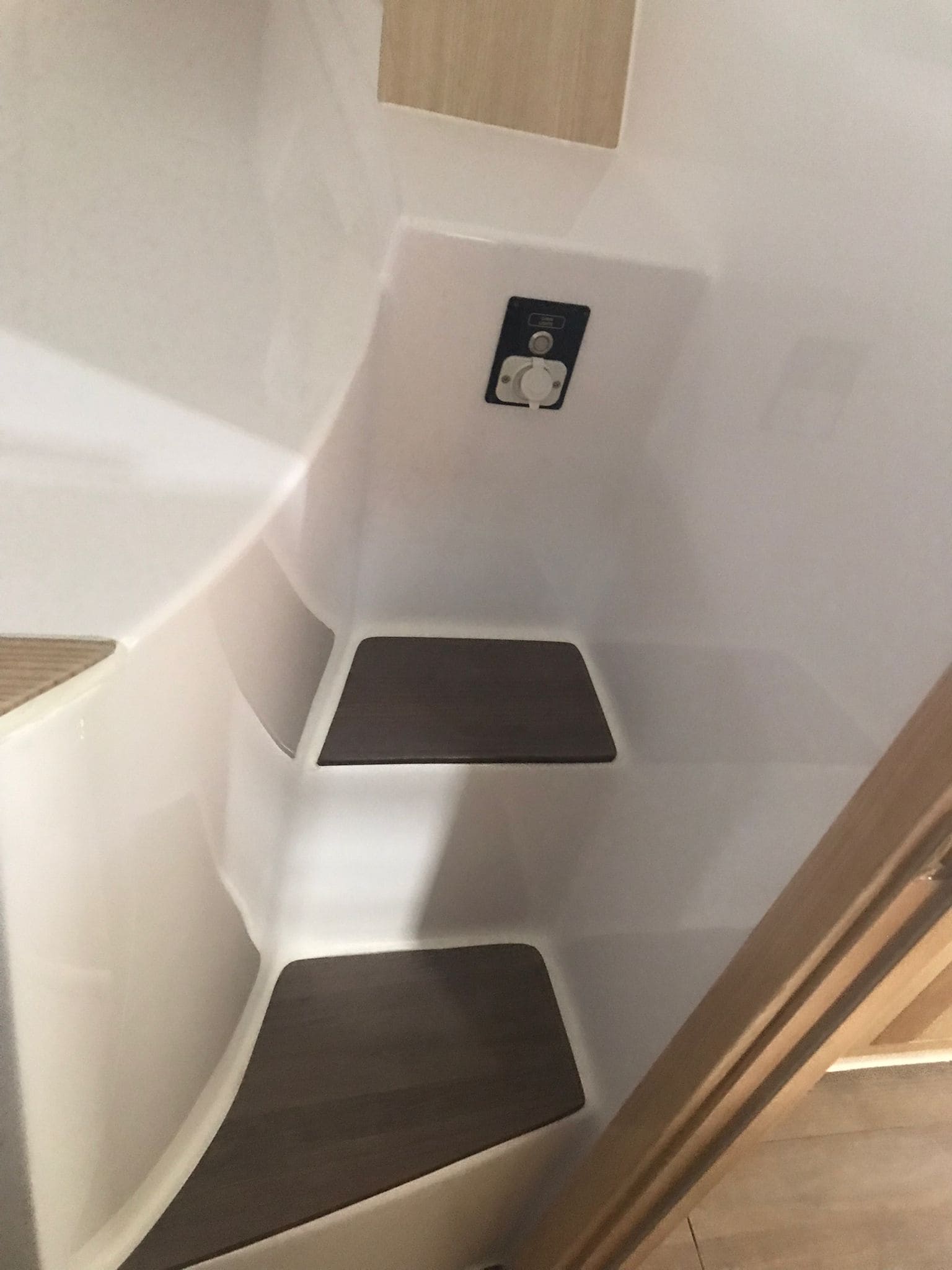

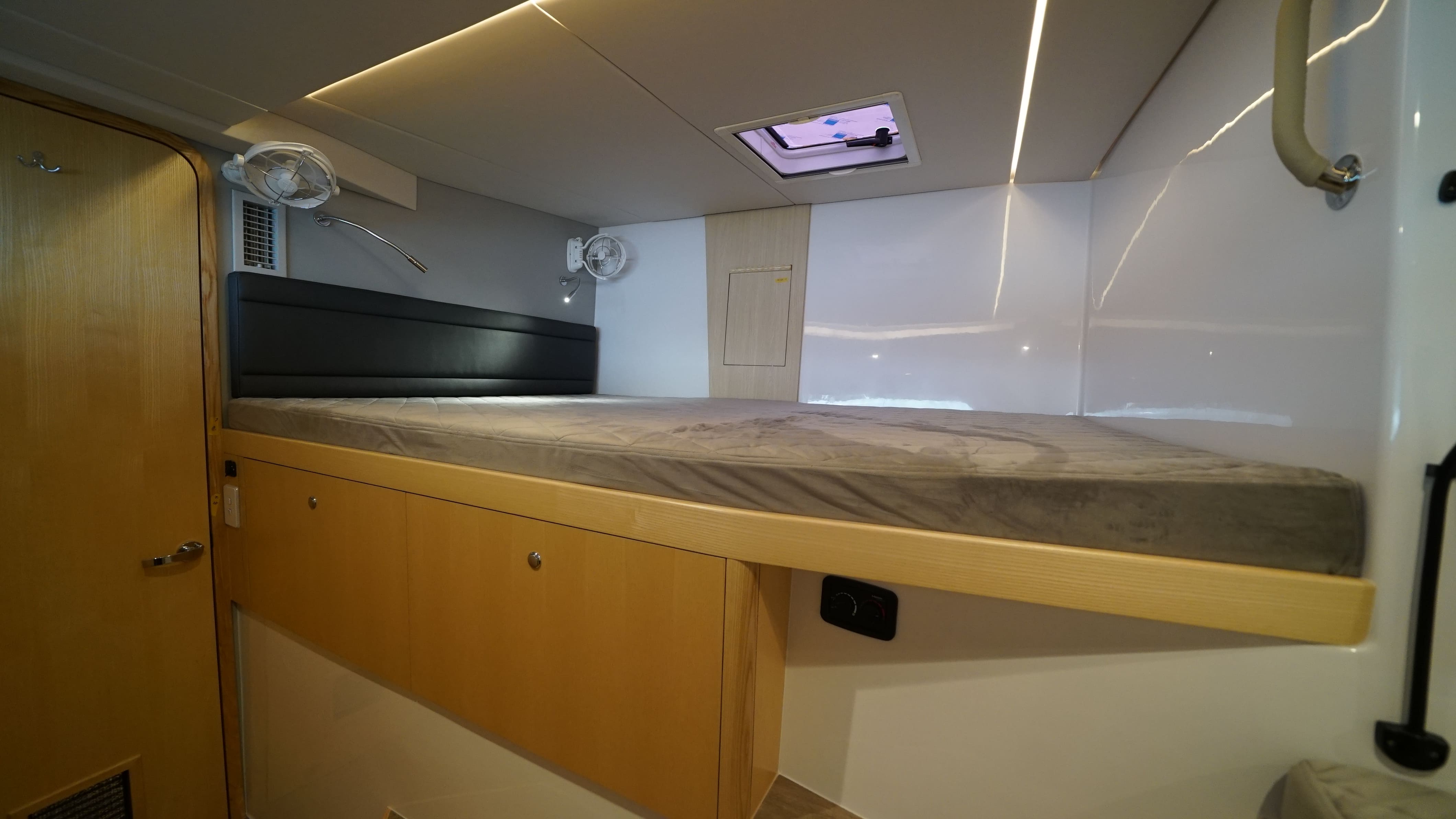

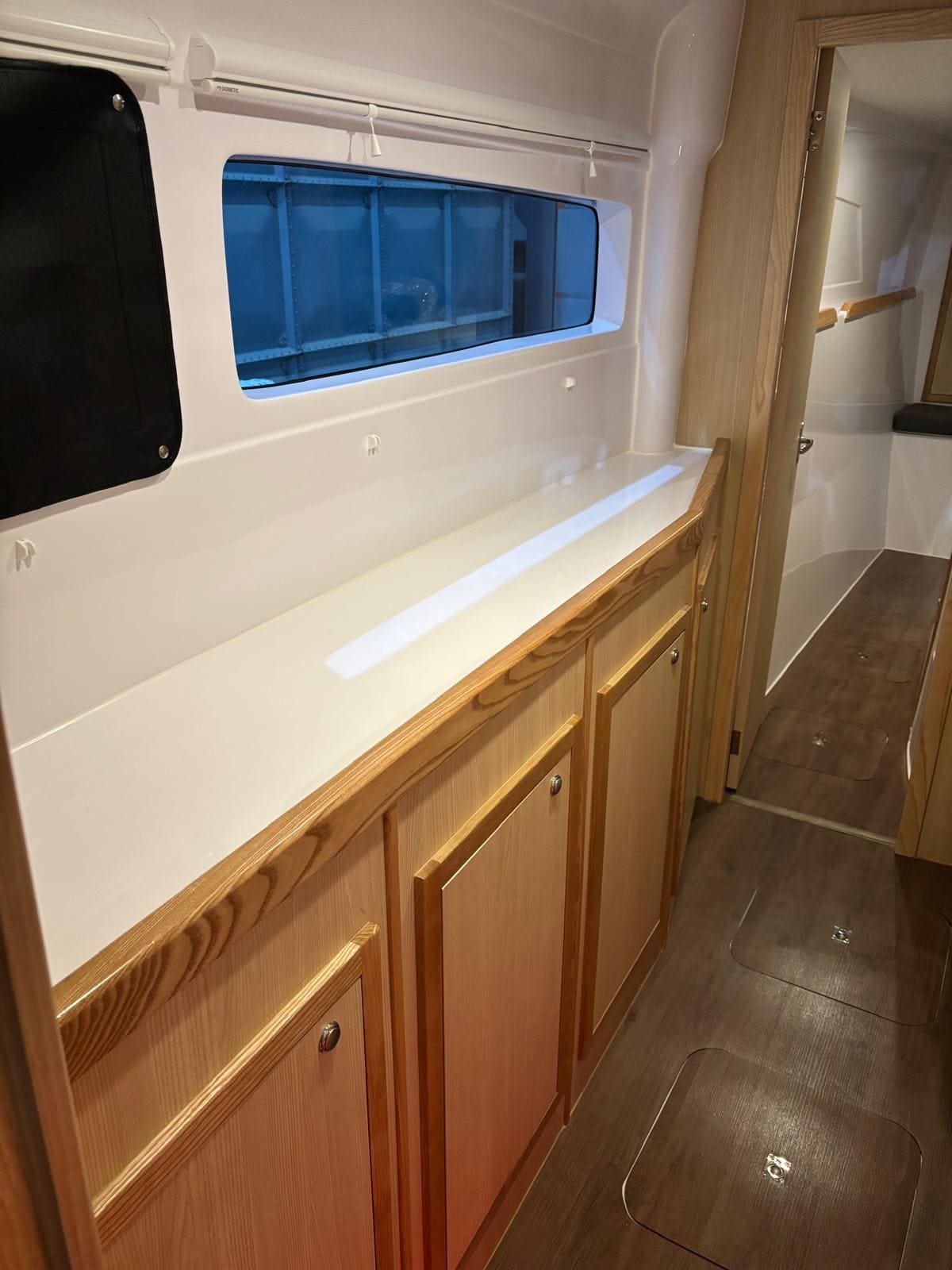

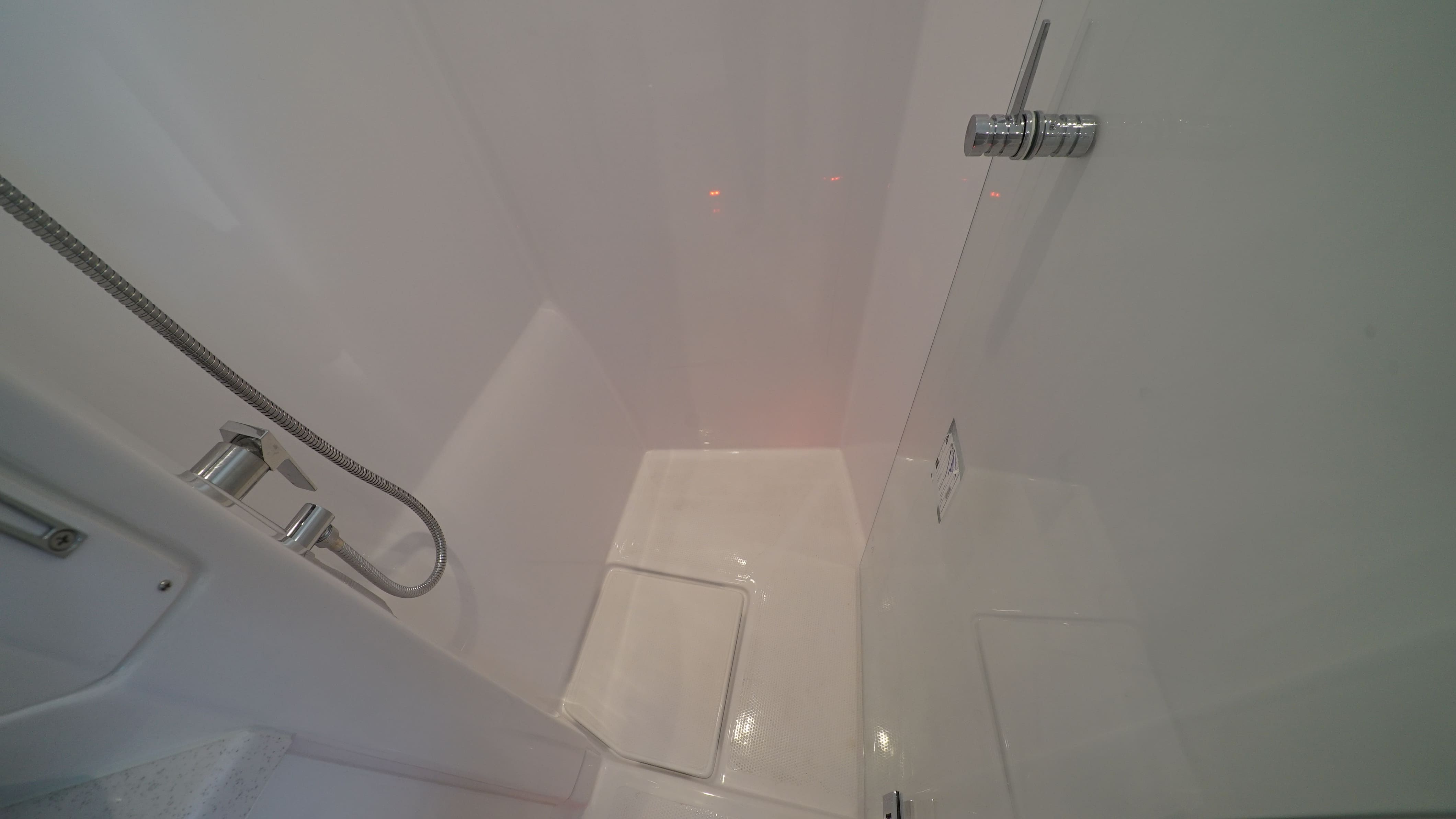

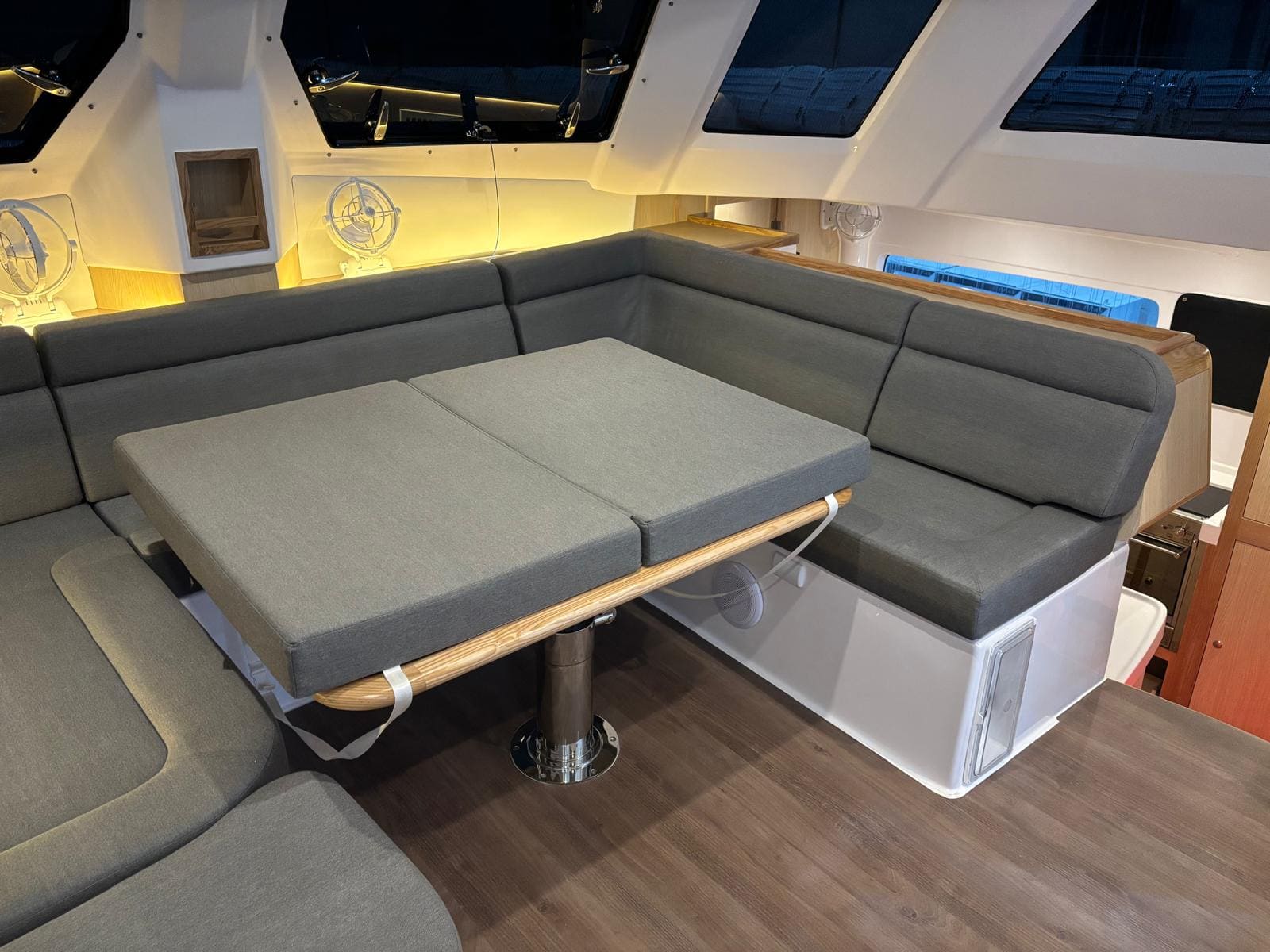

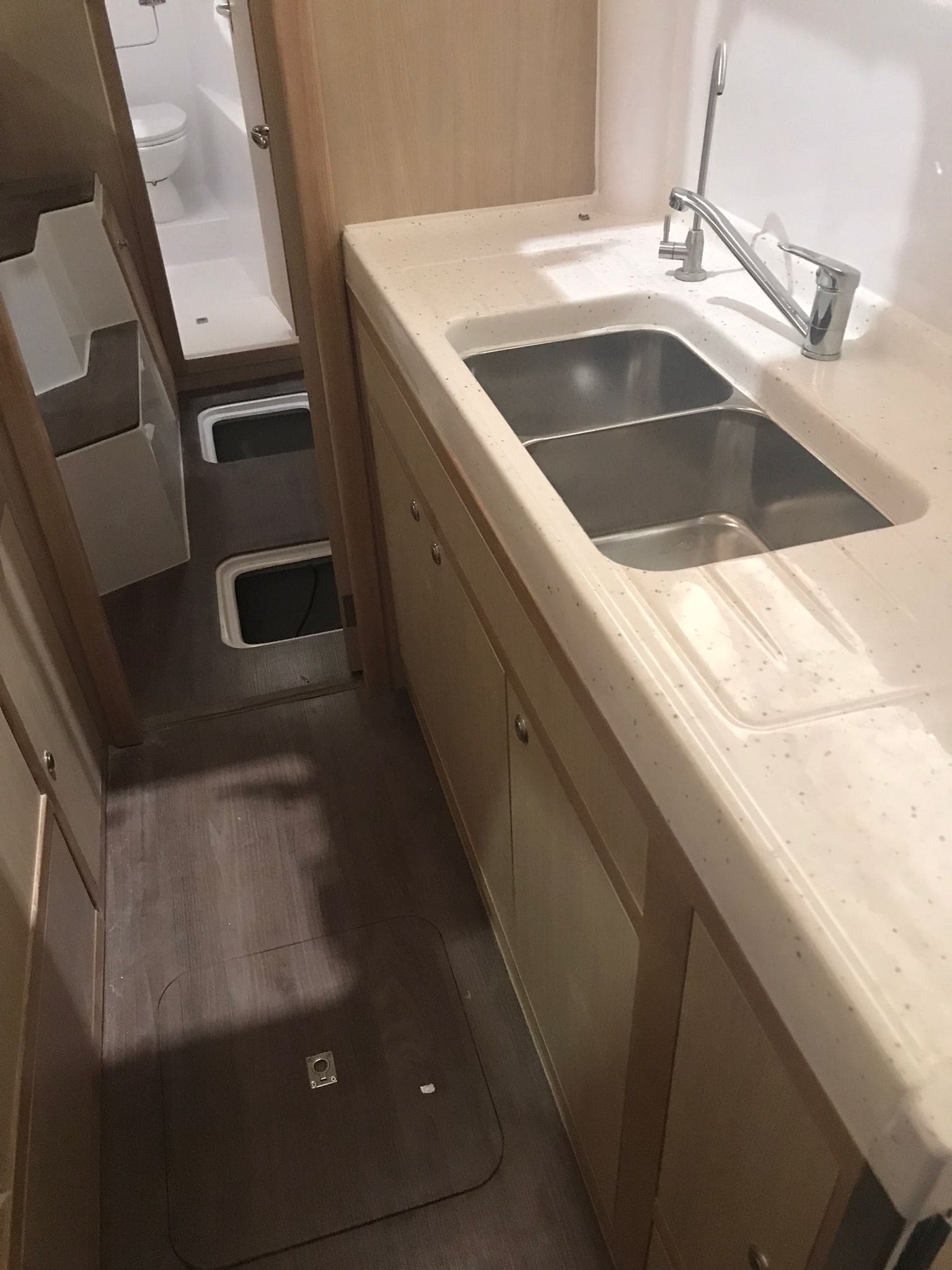

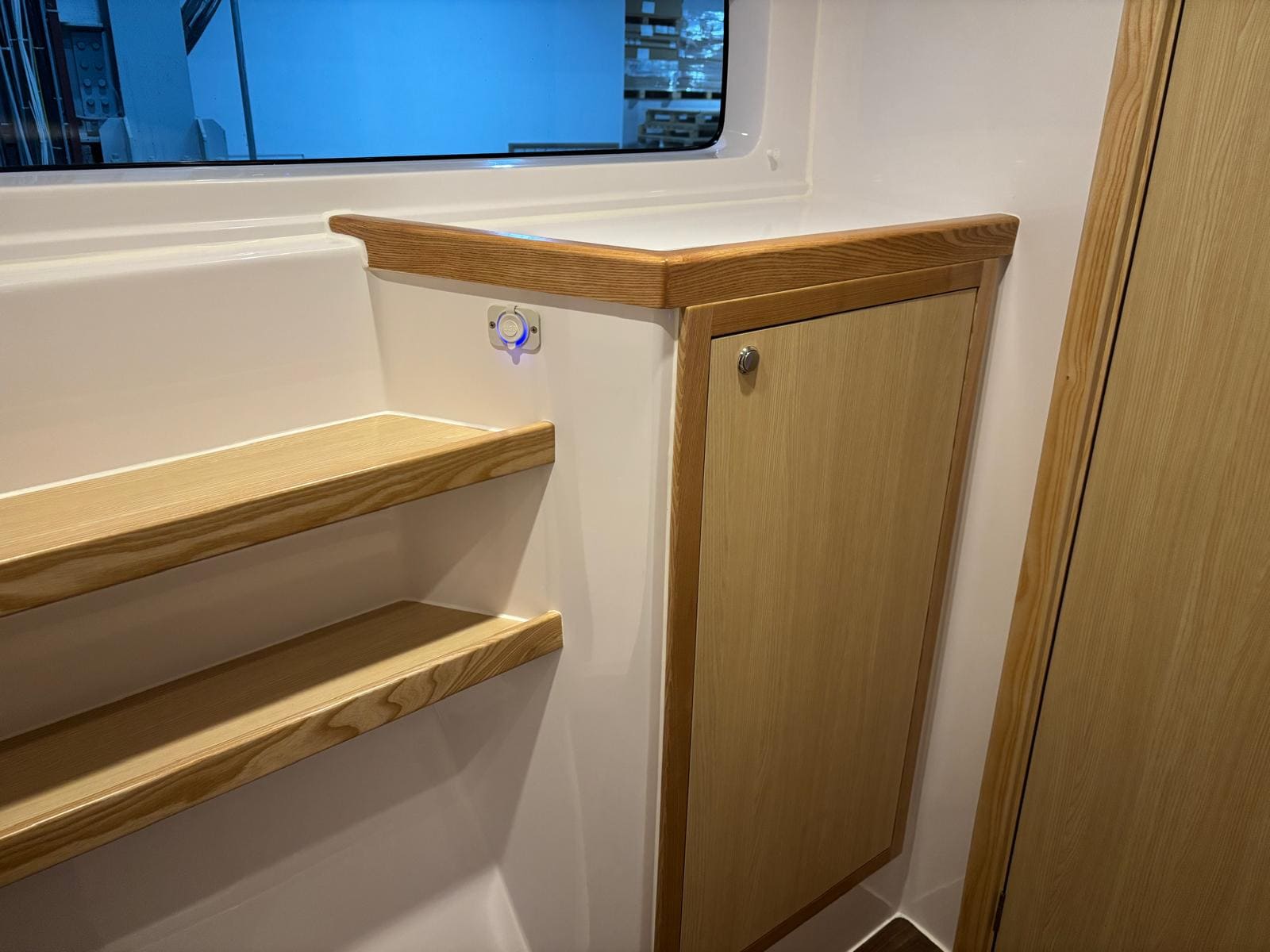

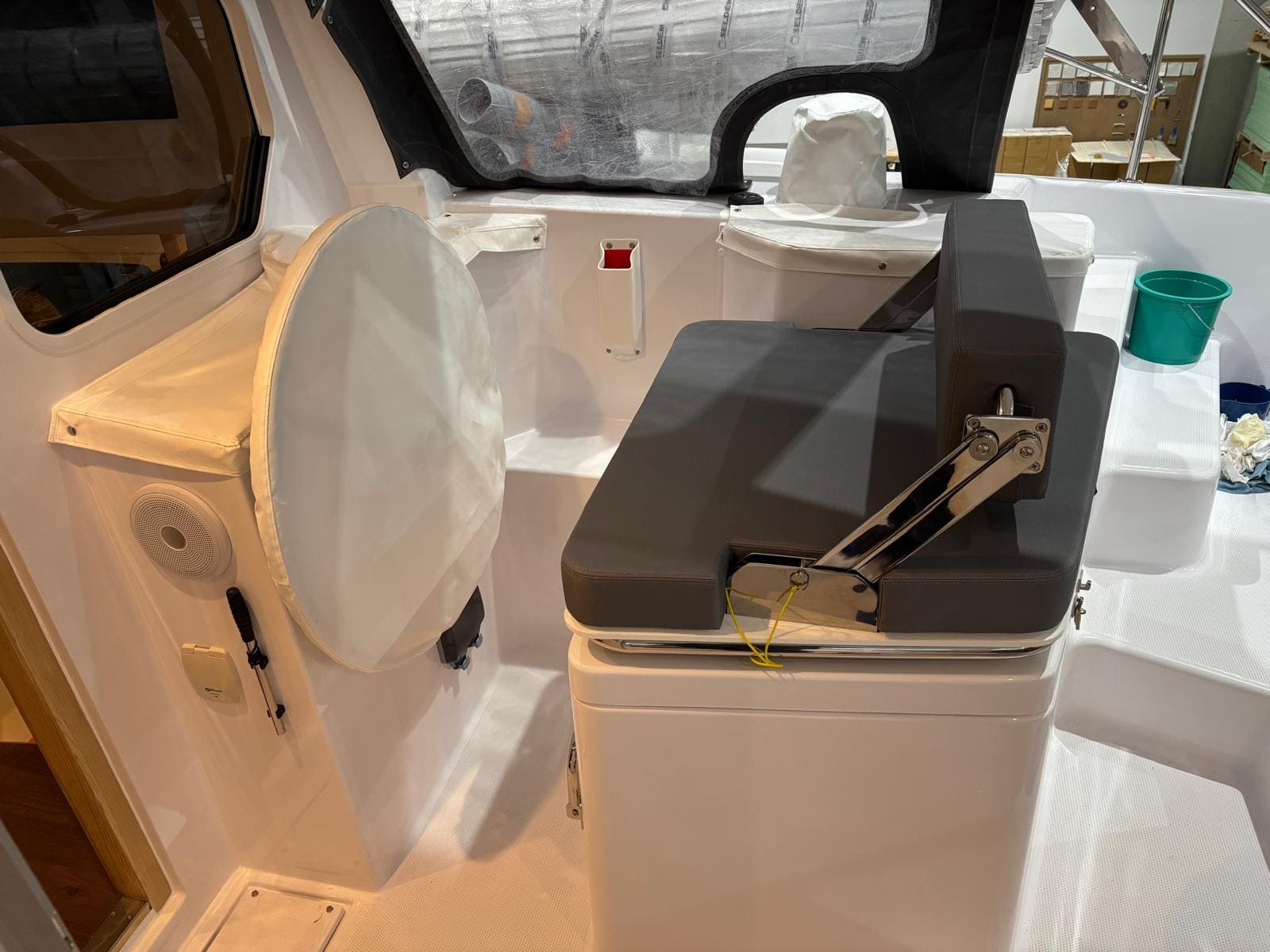

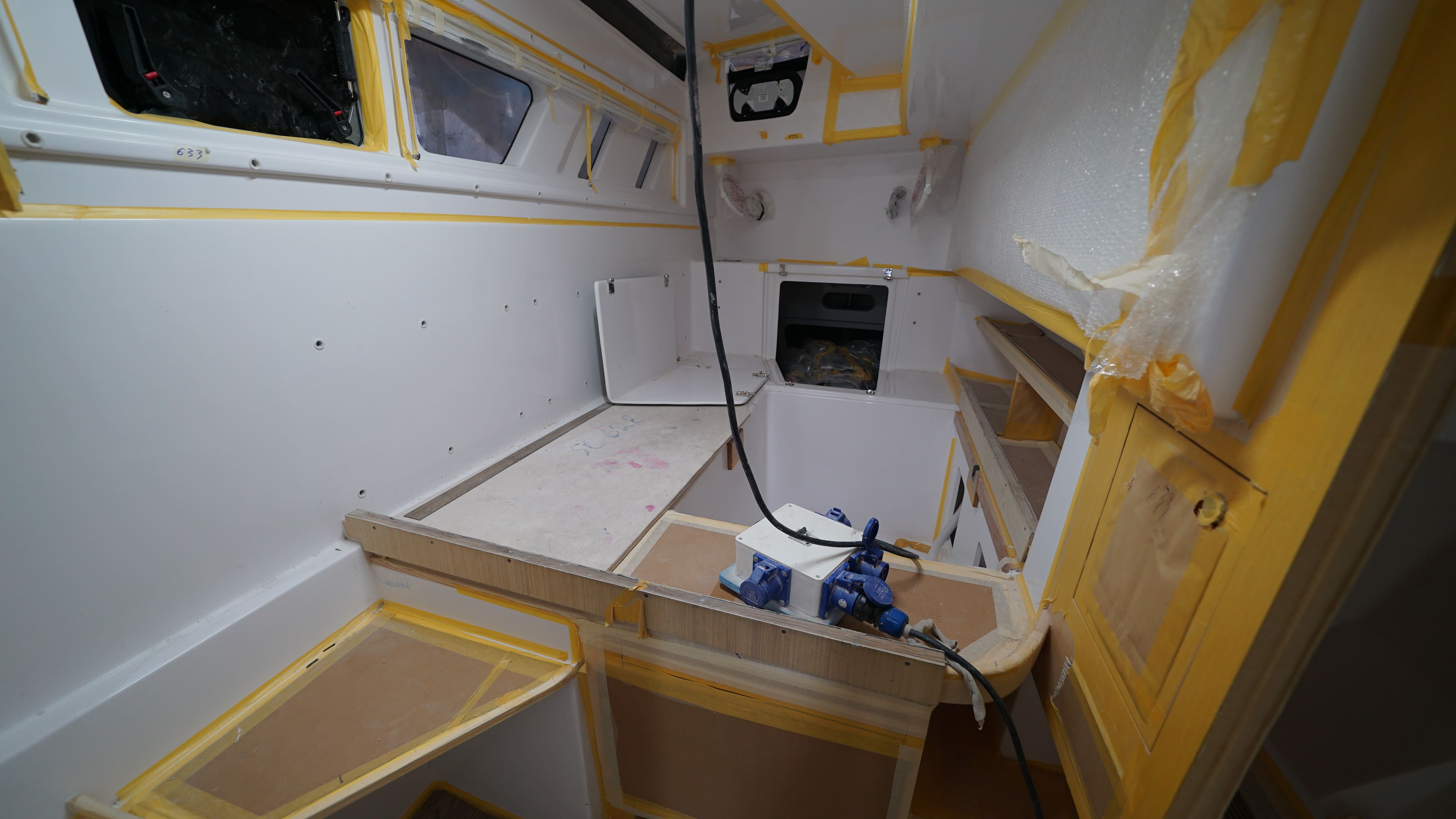

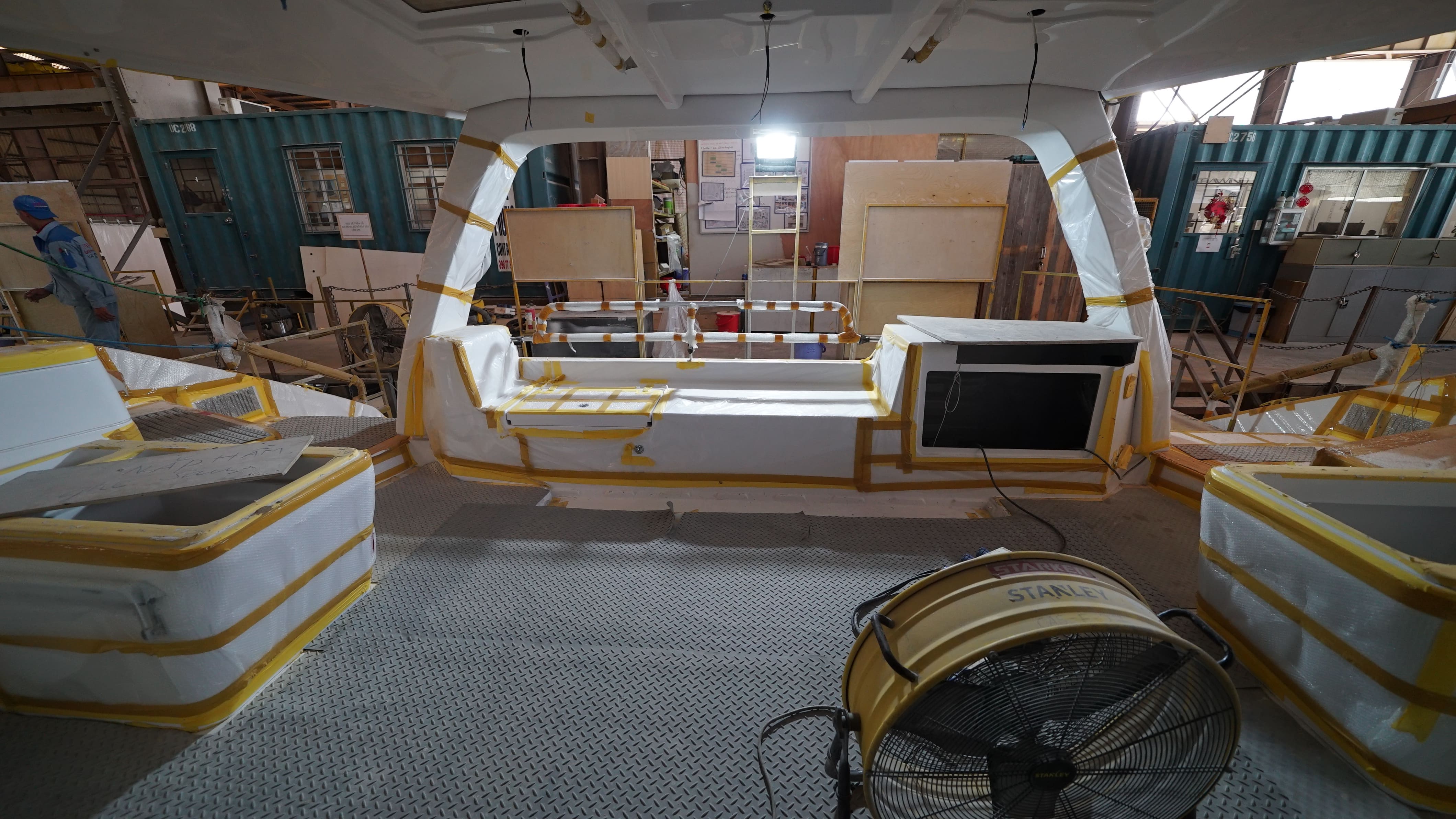

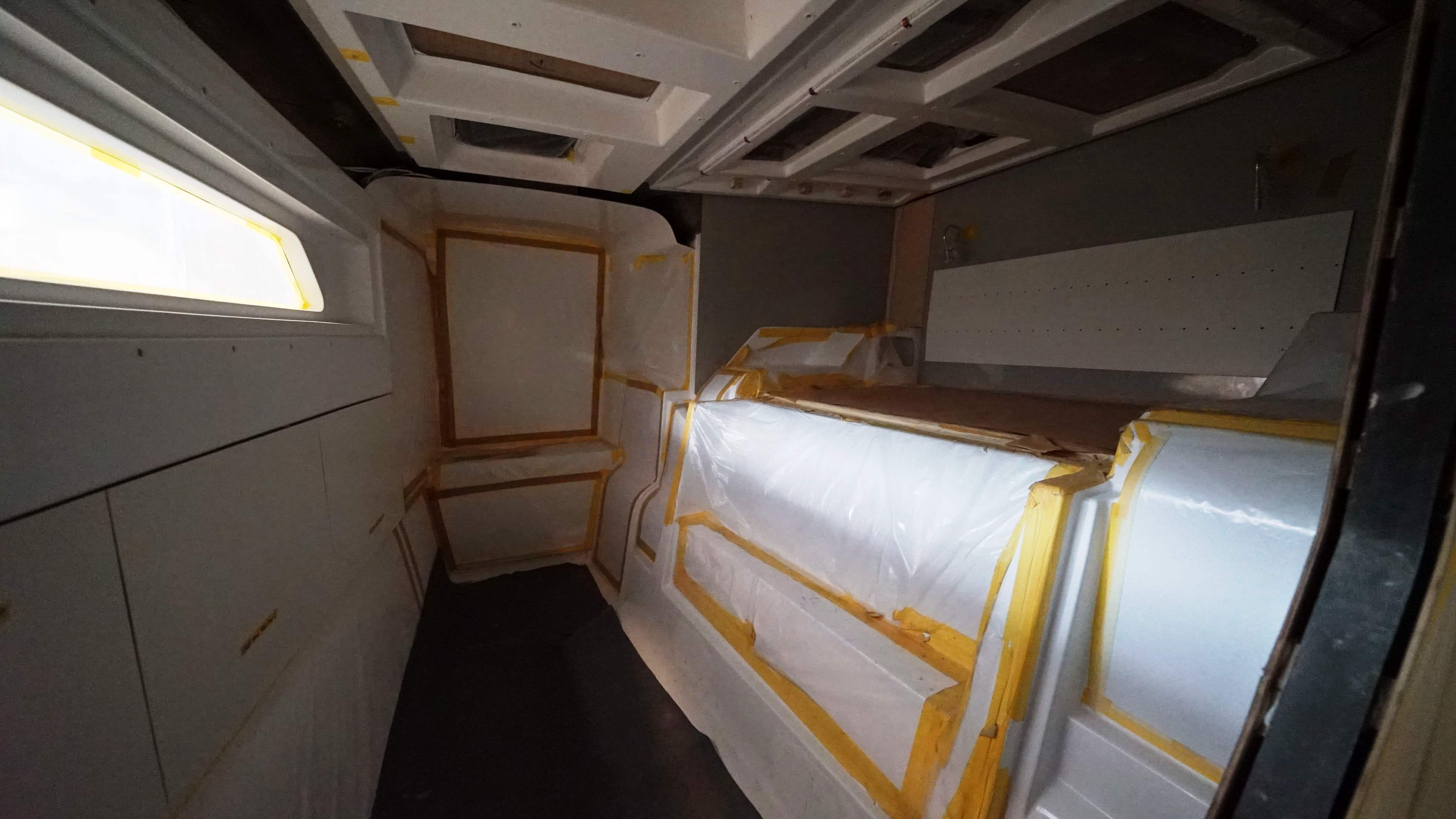

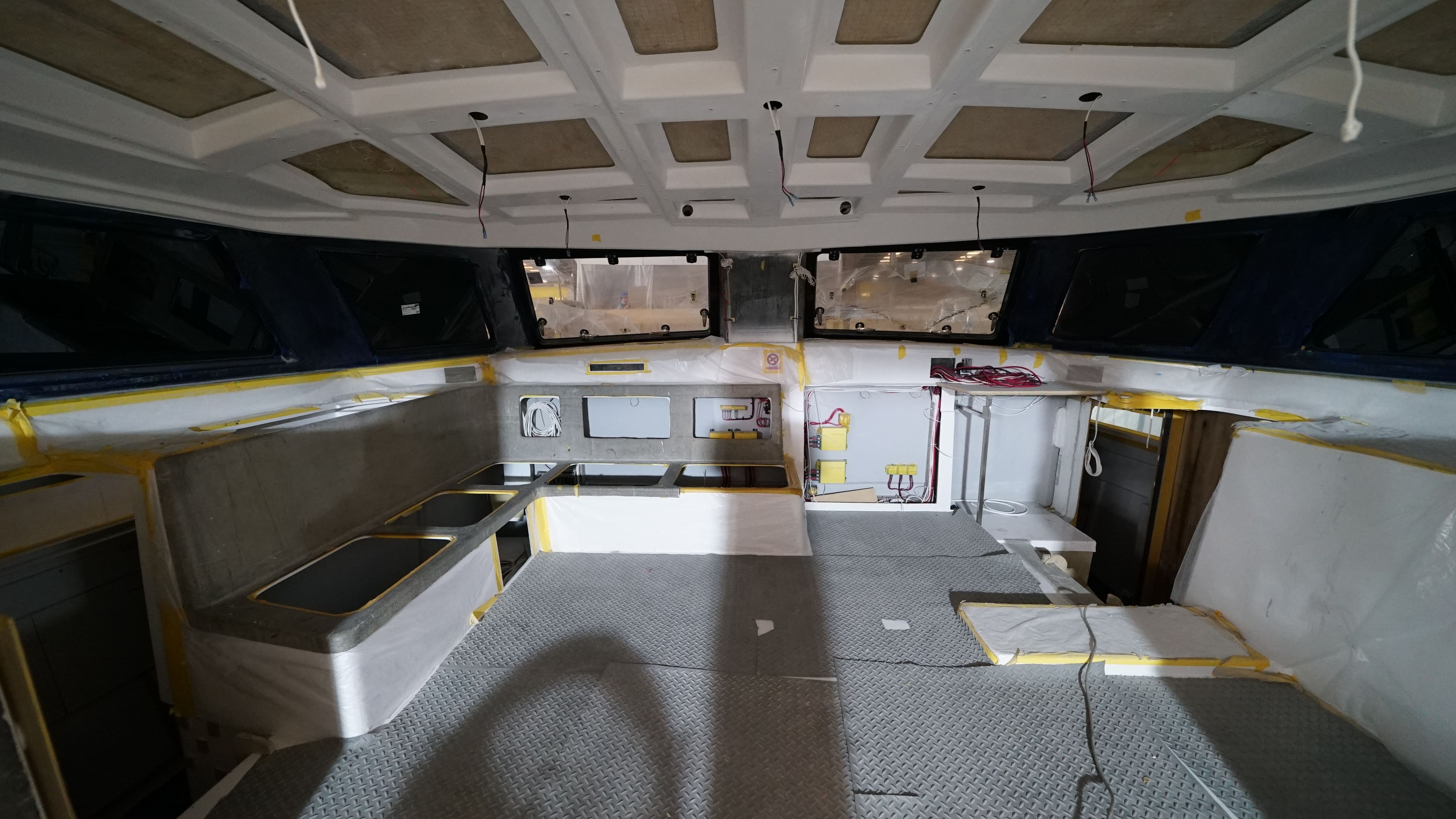

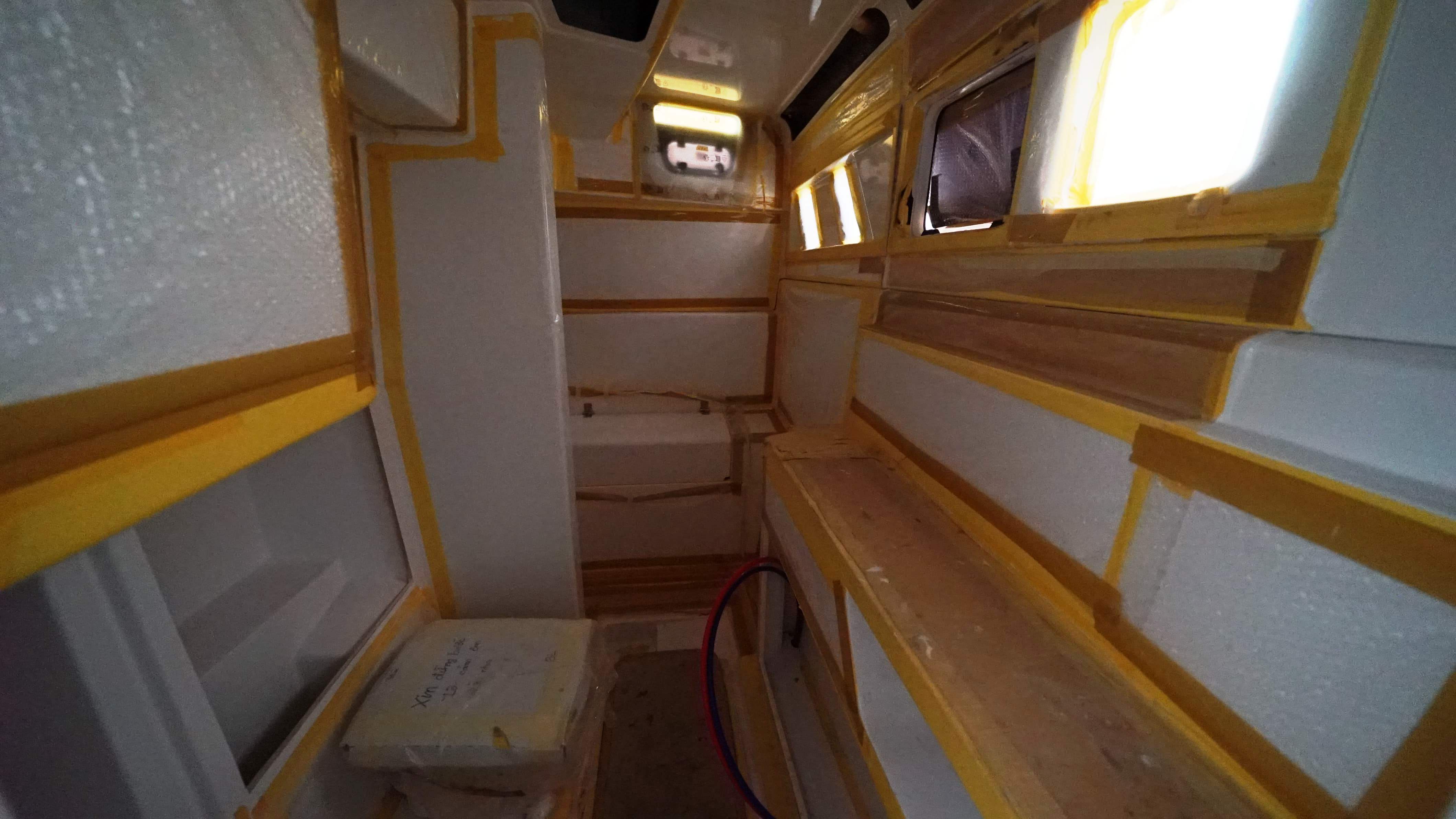

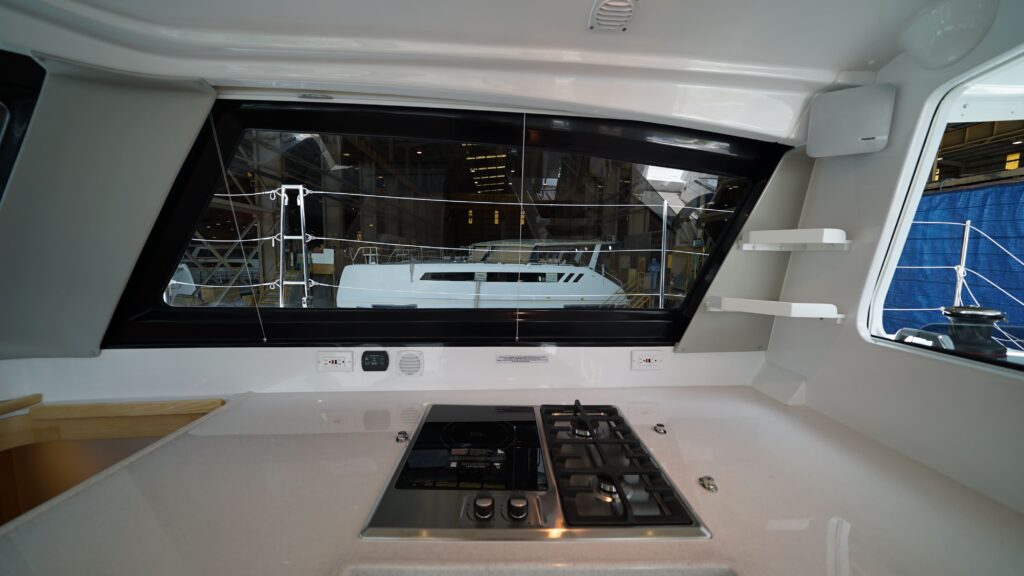

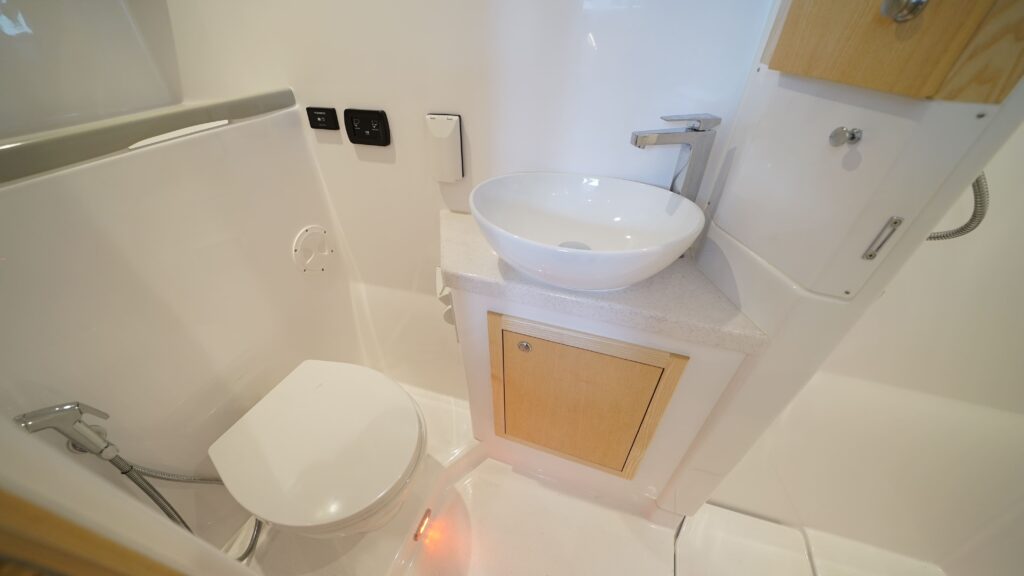

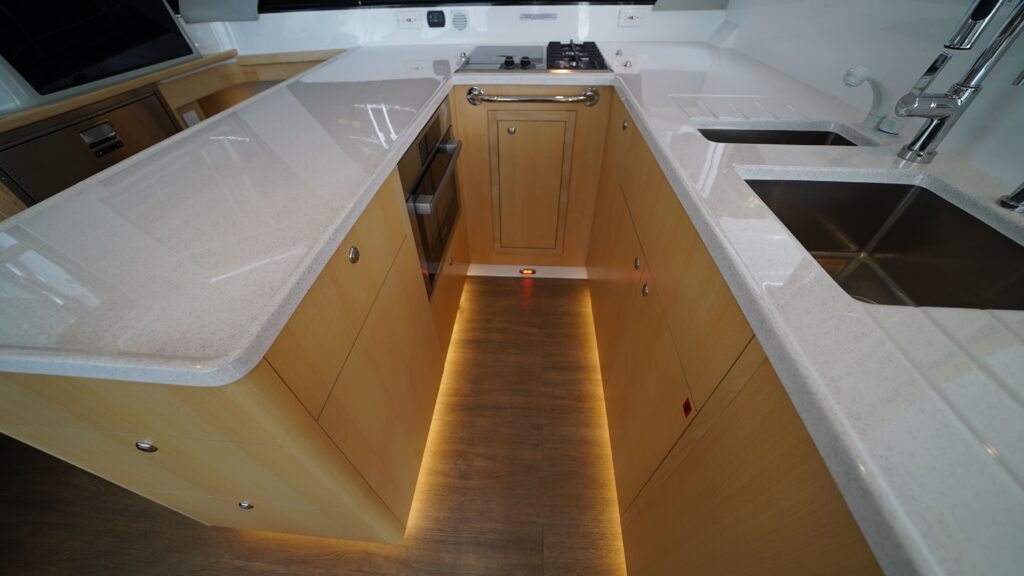

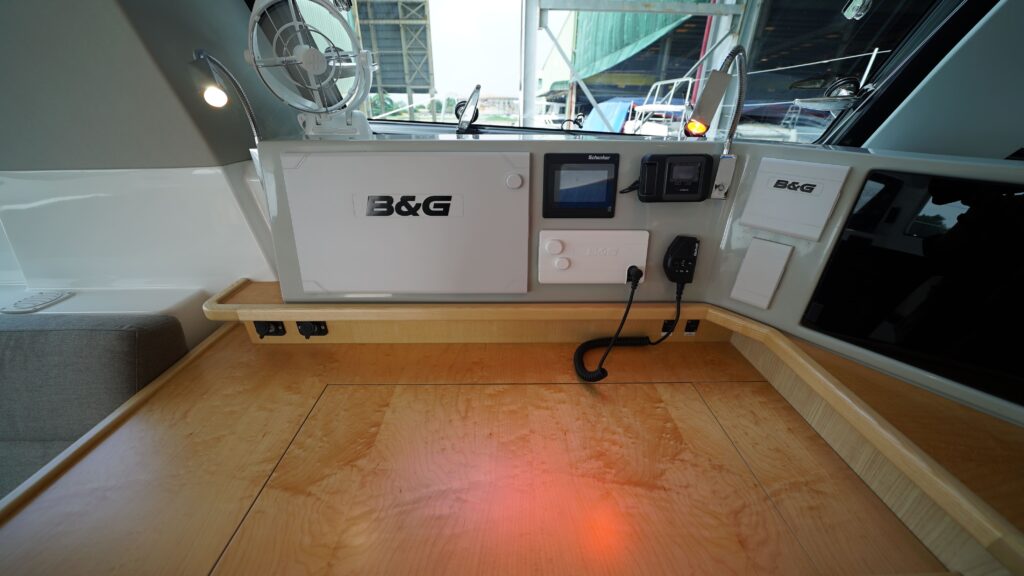

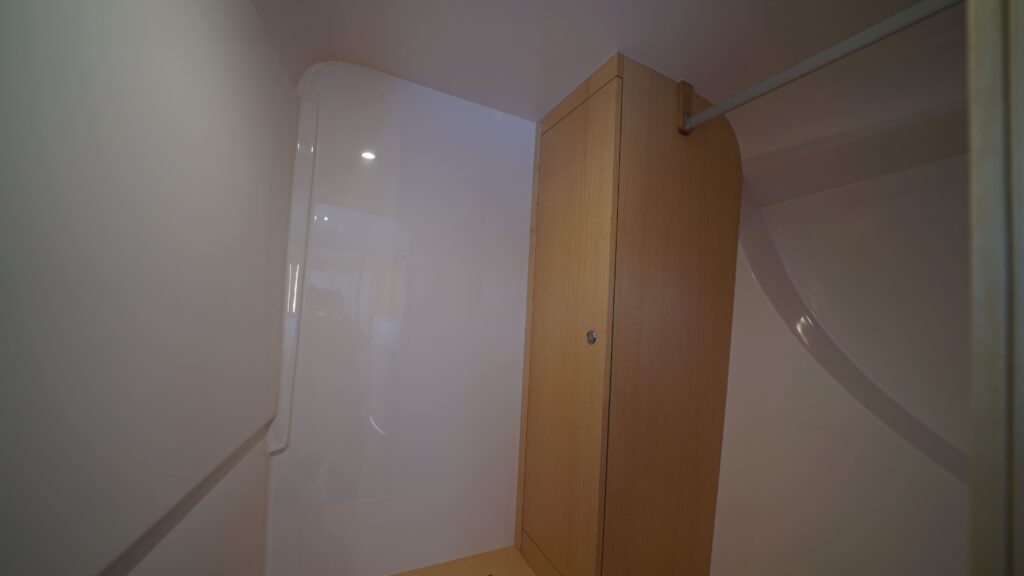

We recently completed the engines, saloon windows, hullside windows, A-frame, gelcoat repair, deck hardware, hatches.

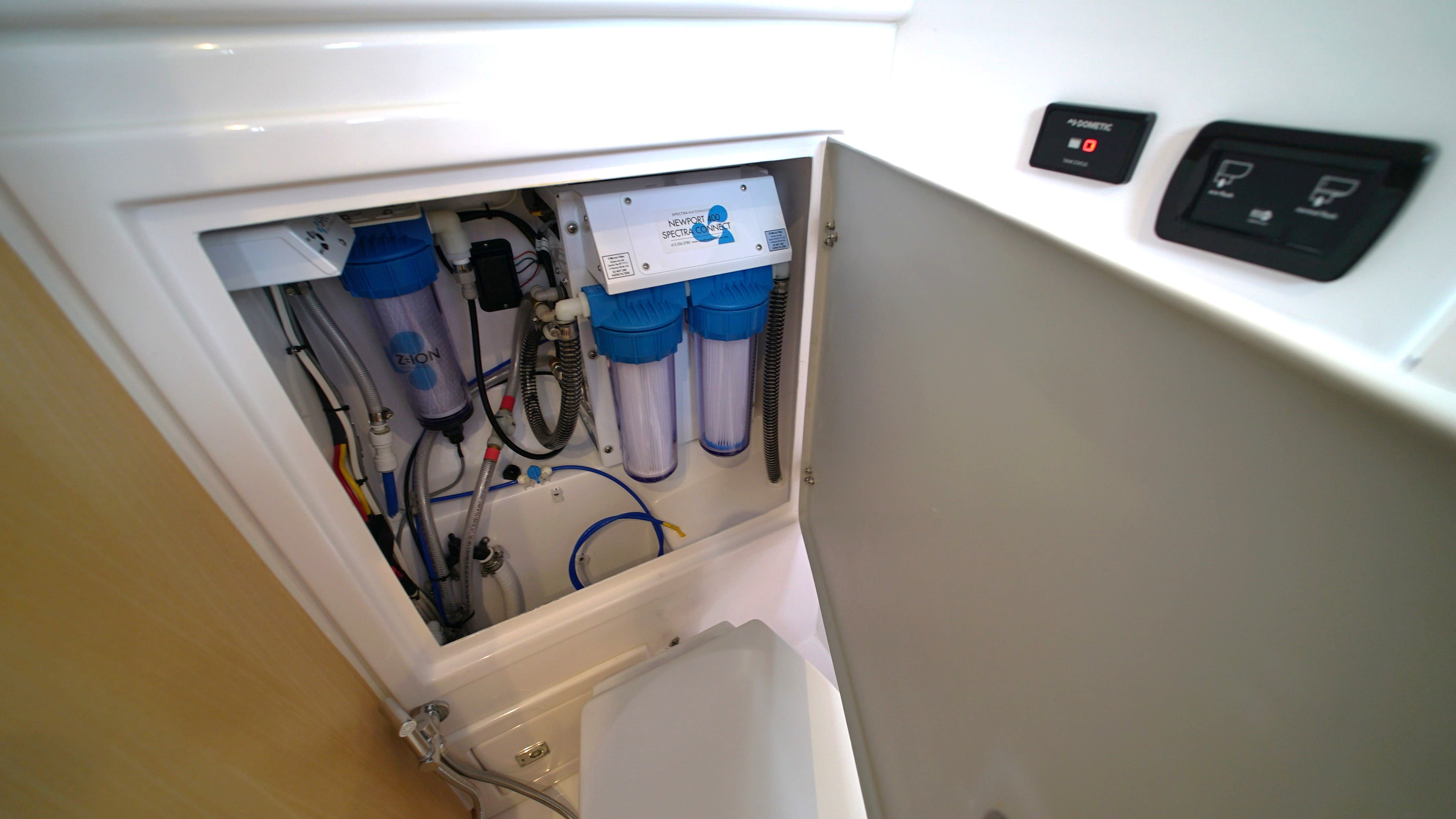

Our Production team is working on LPG, plumbing, and electrical parts.
