Production Update – Fit out

Your boat is progressing well in the last phase of the Fit out stage.

We recently completed anchor box, forward beam & A-frame, trampoline, windows, deck hardware, solar panels, aircon, heating system, hatches, watermaker, and fuel polishing system.

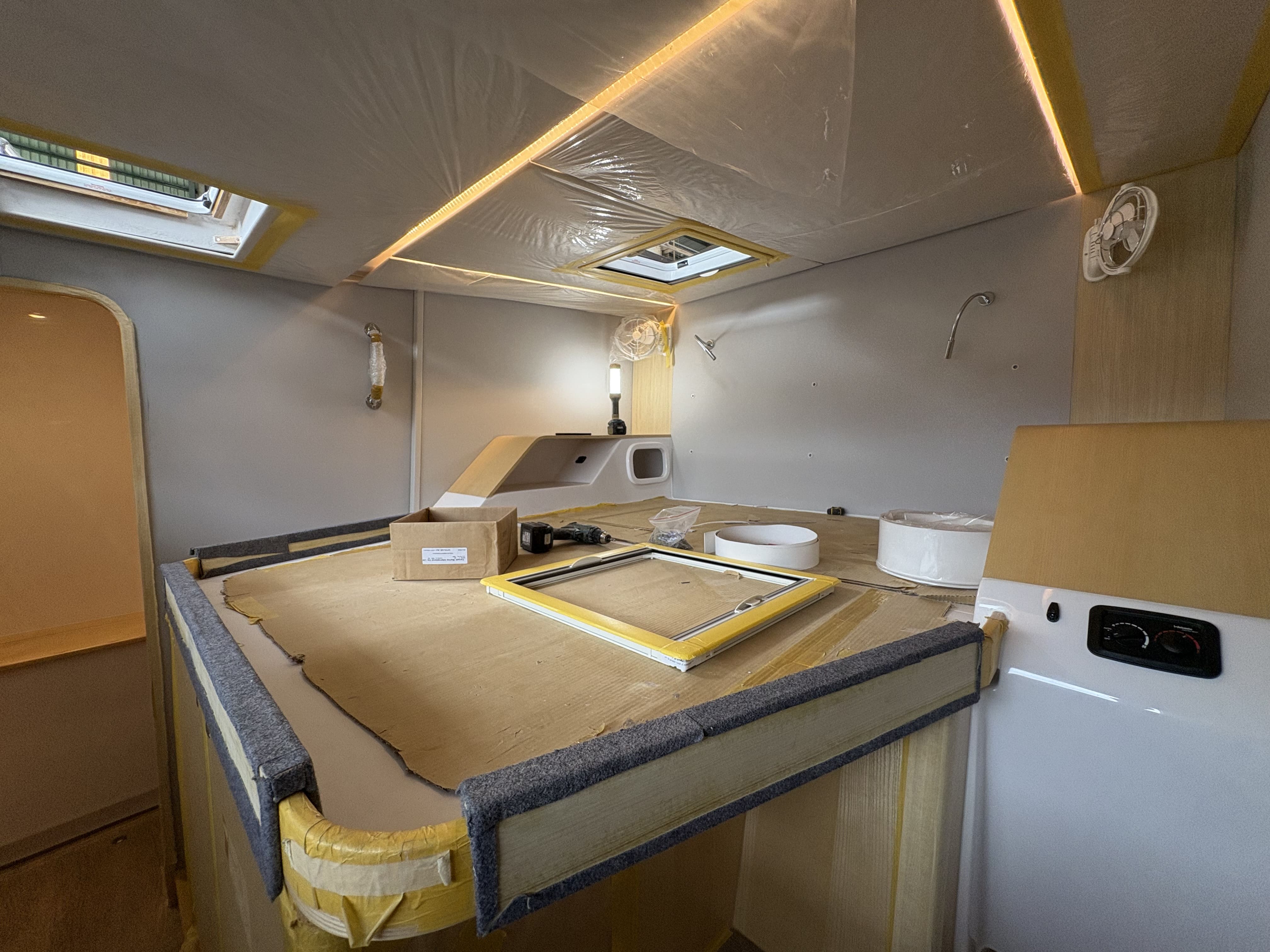

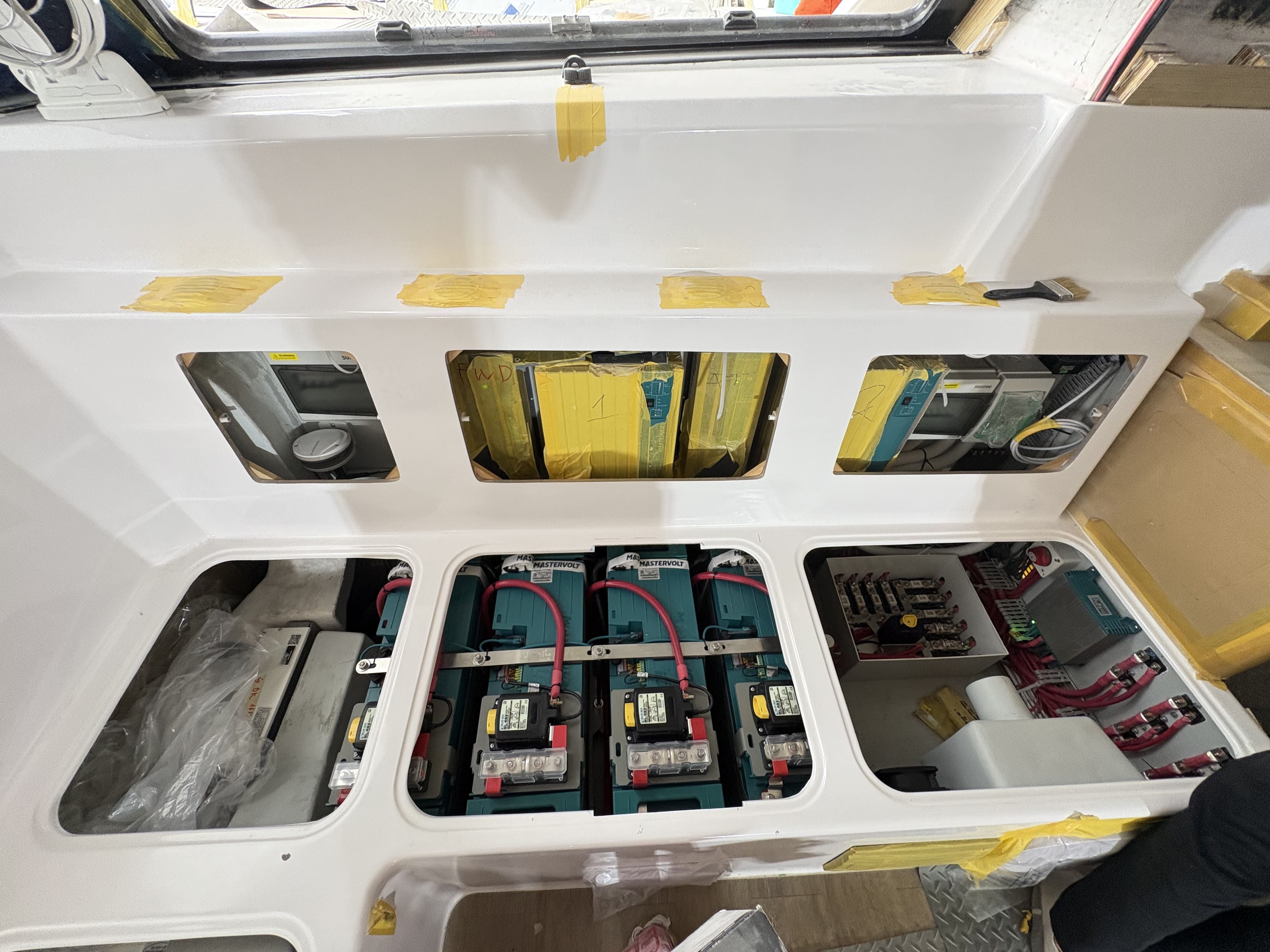

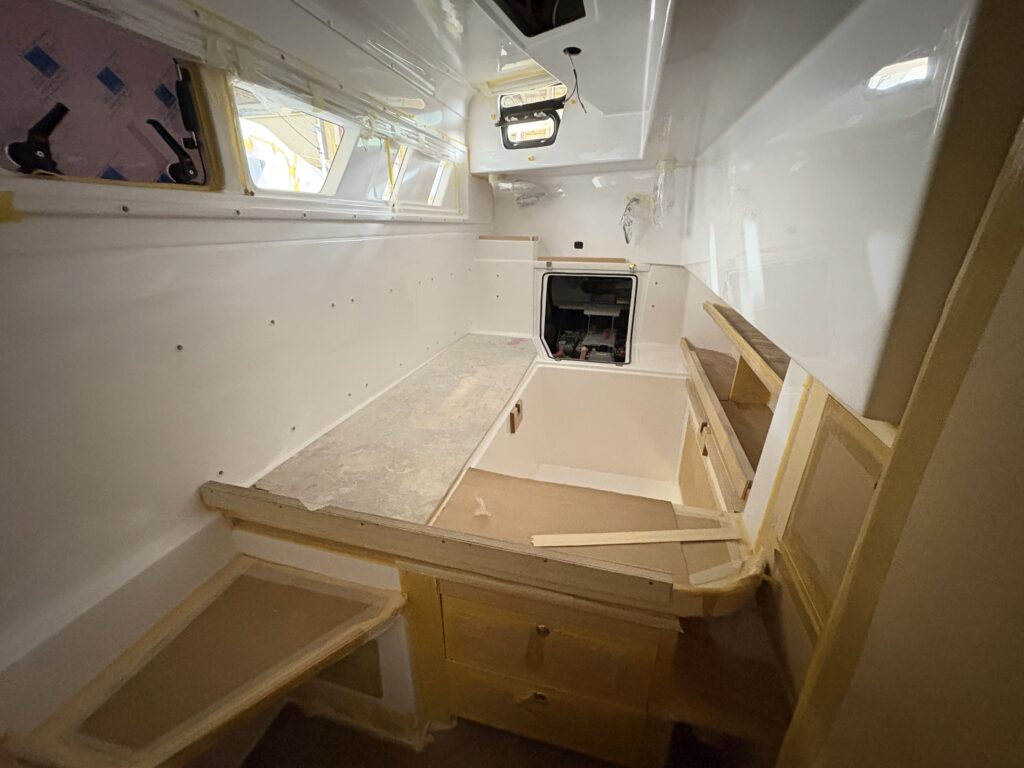

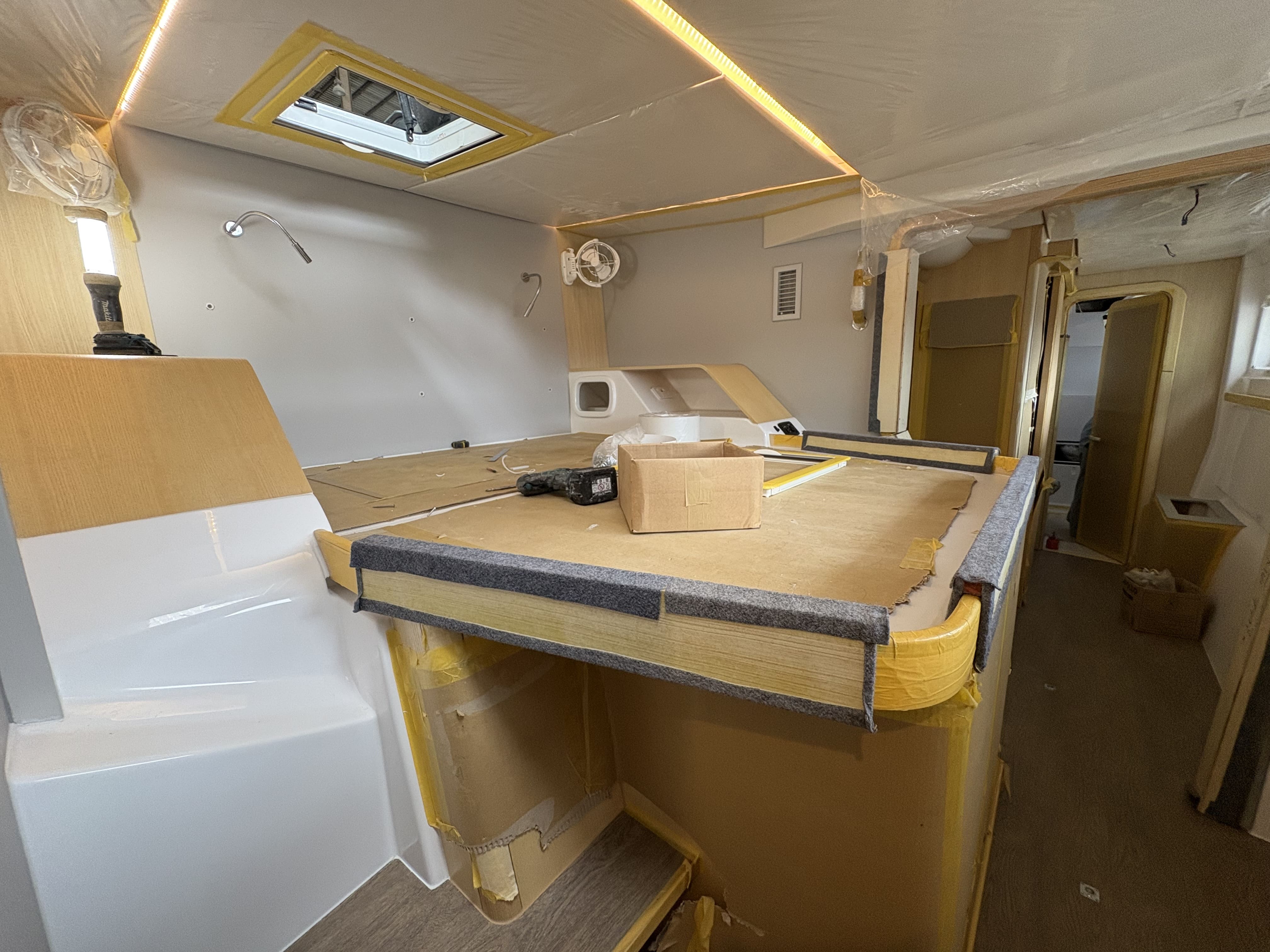

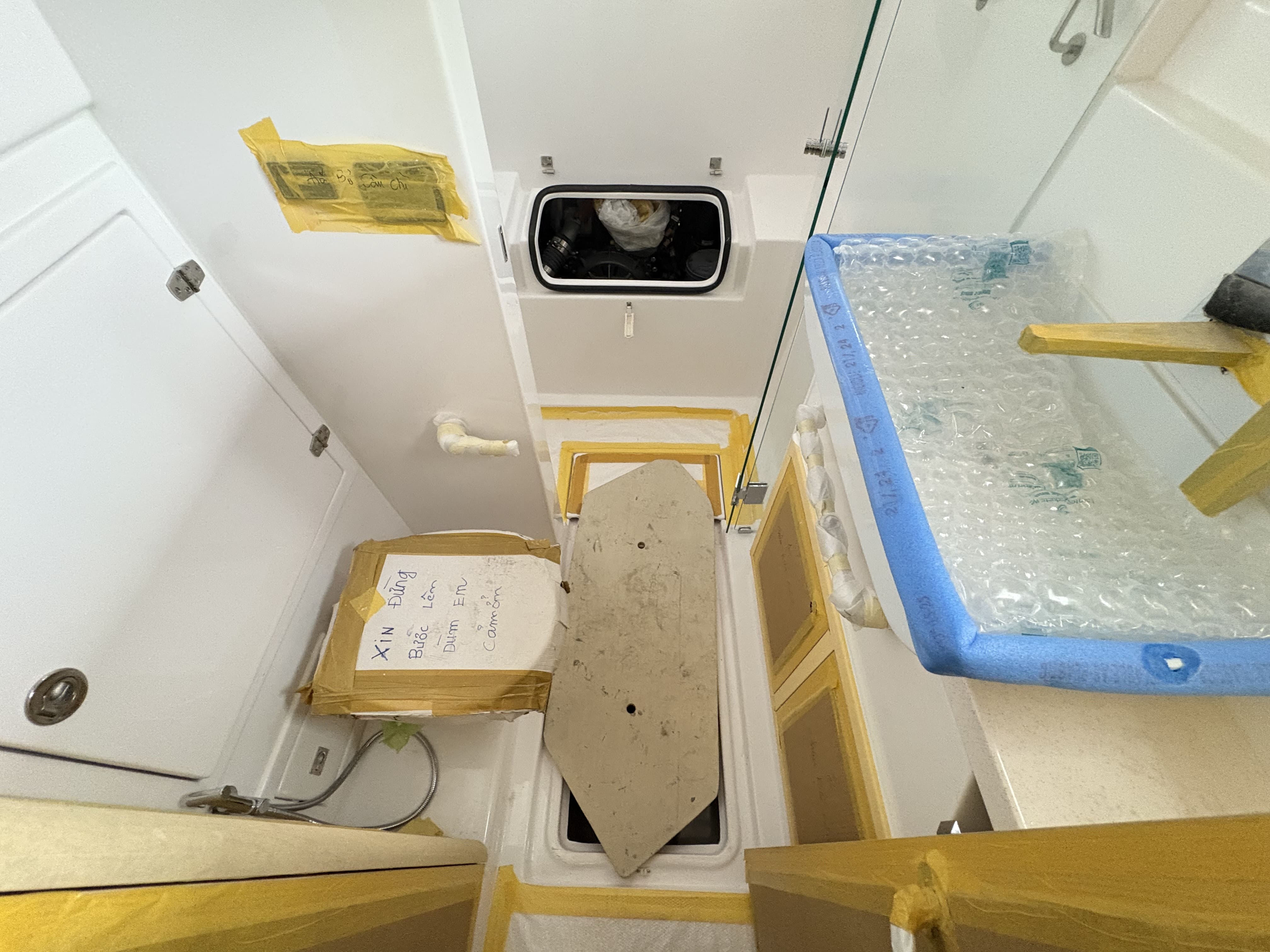

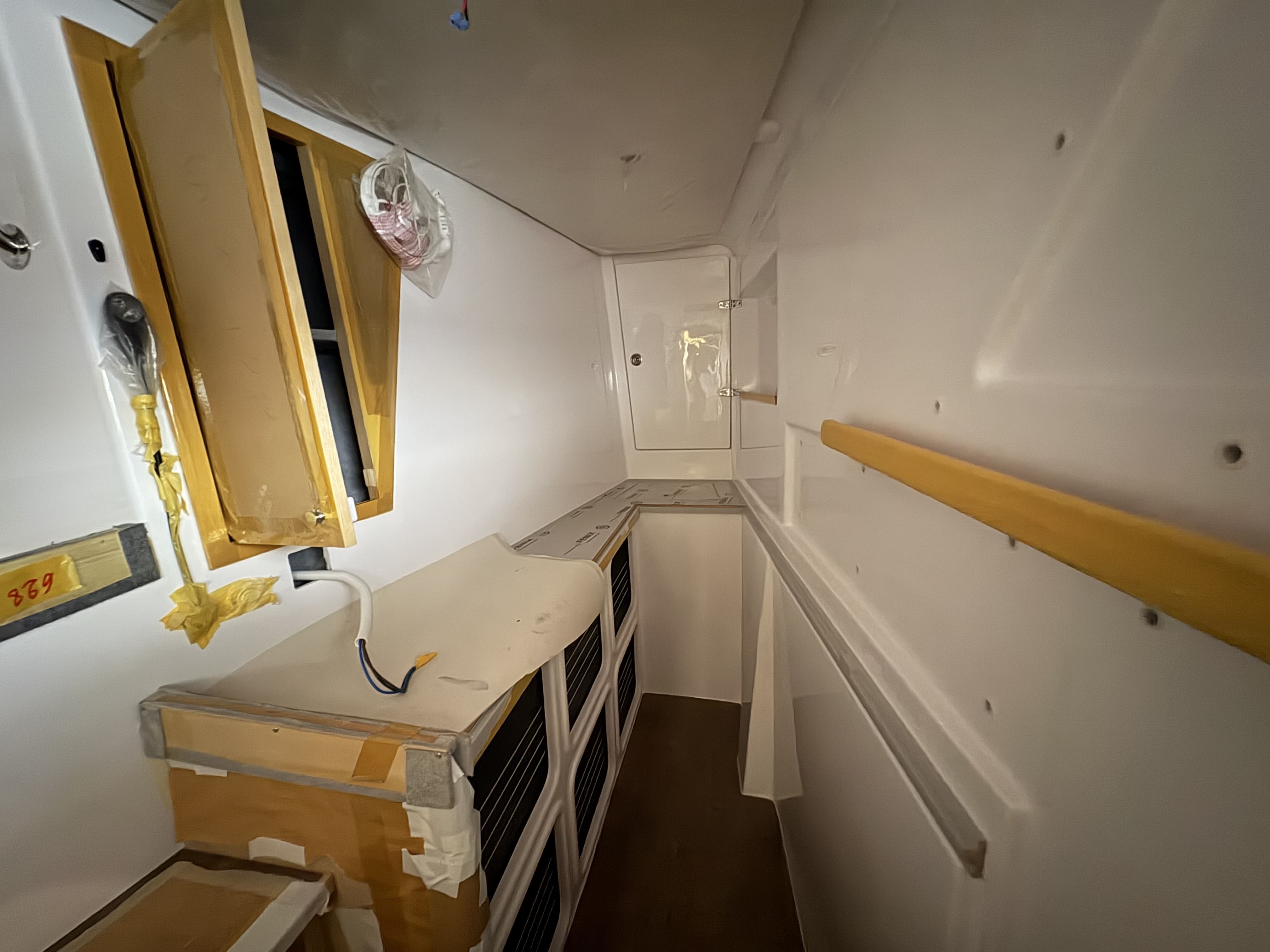

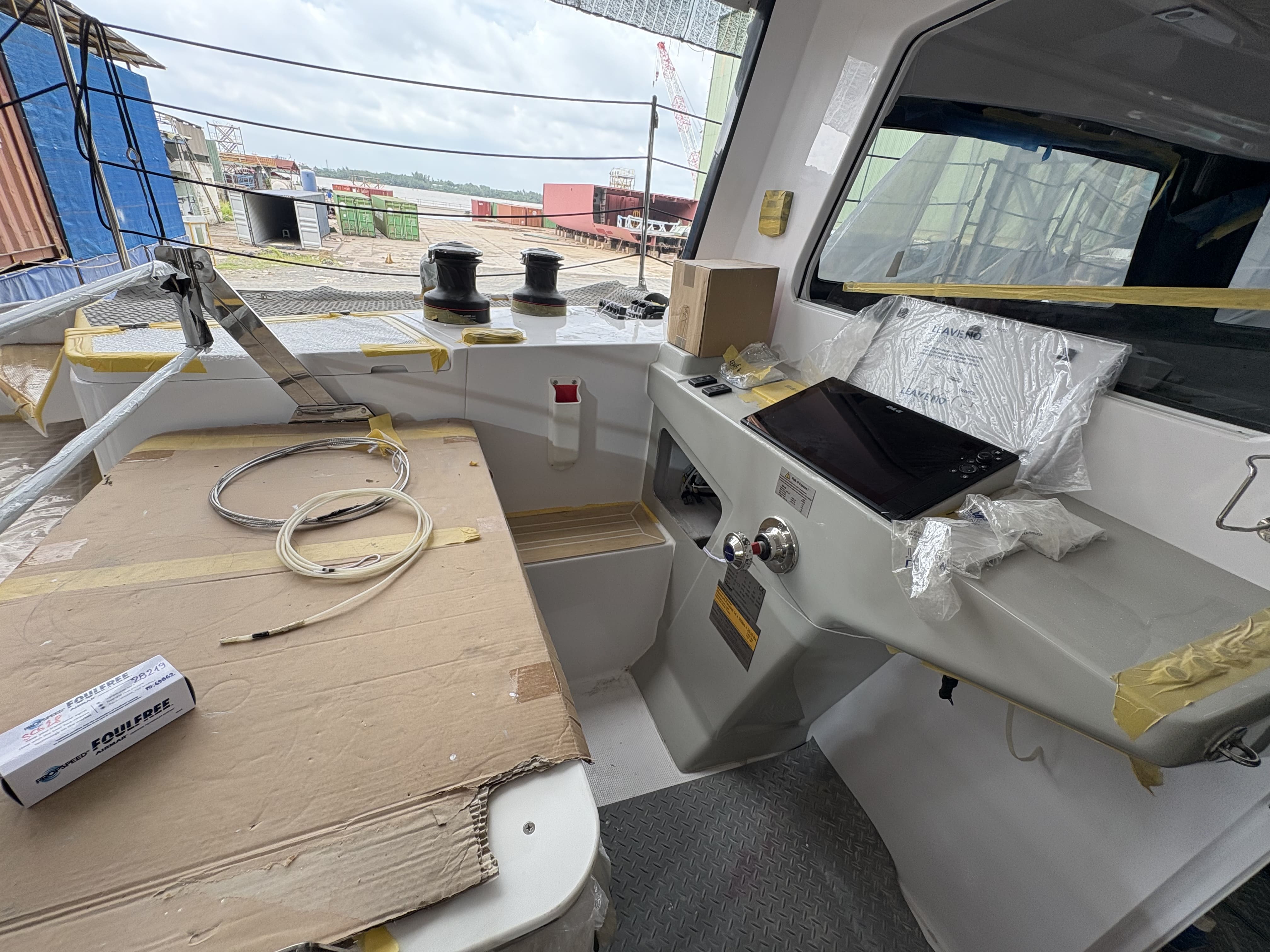

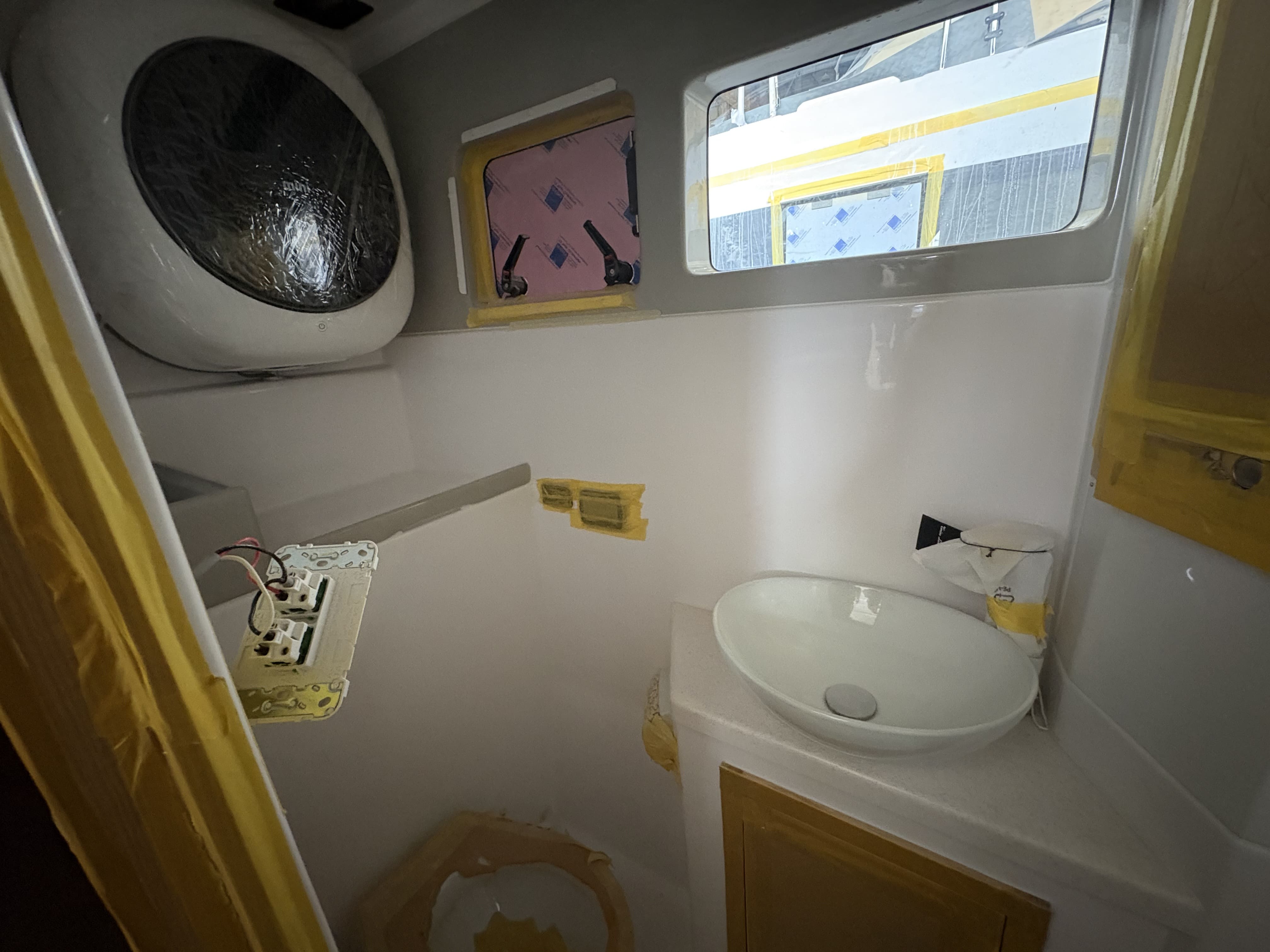

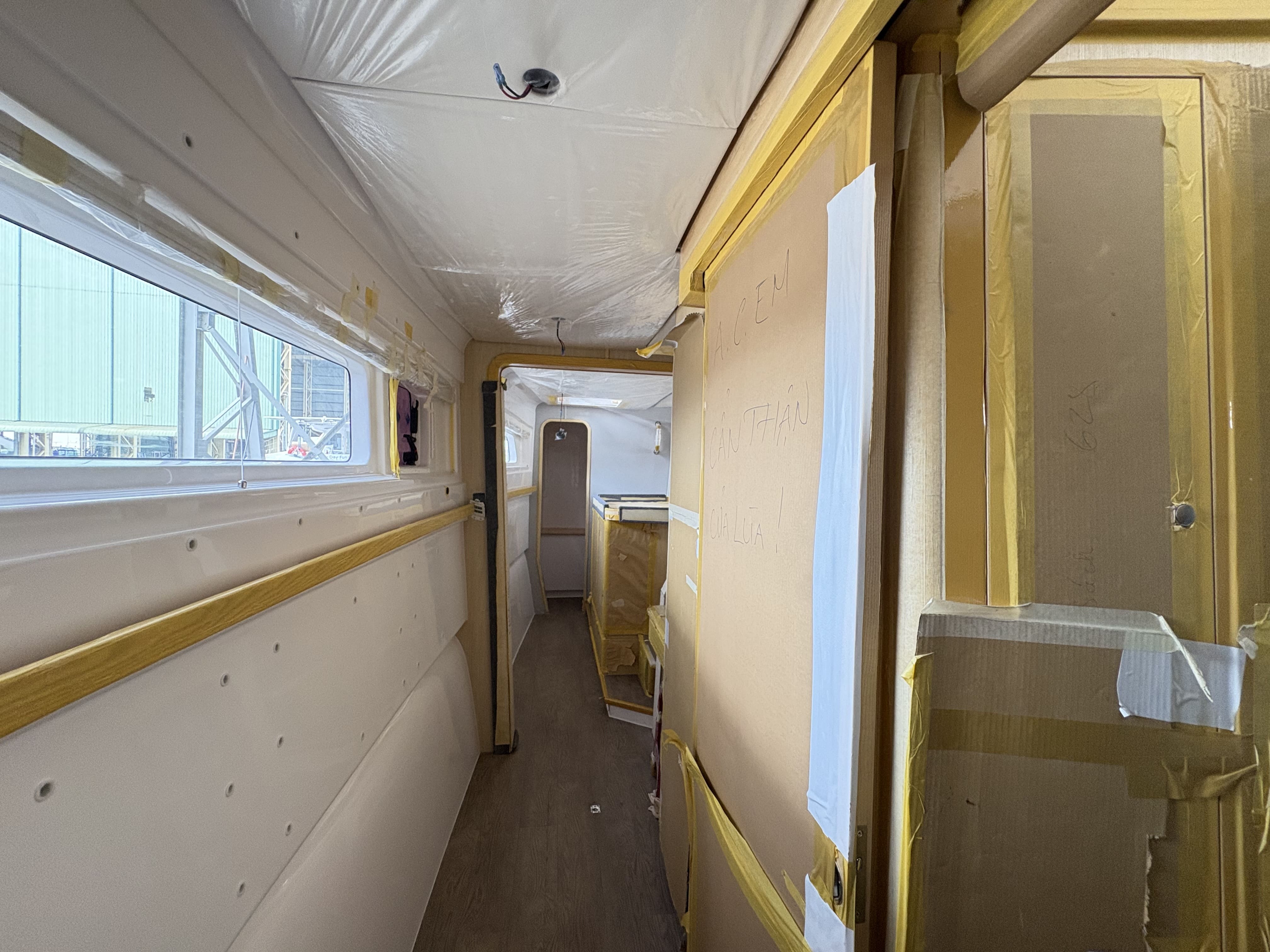

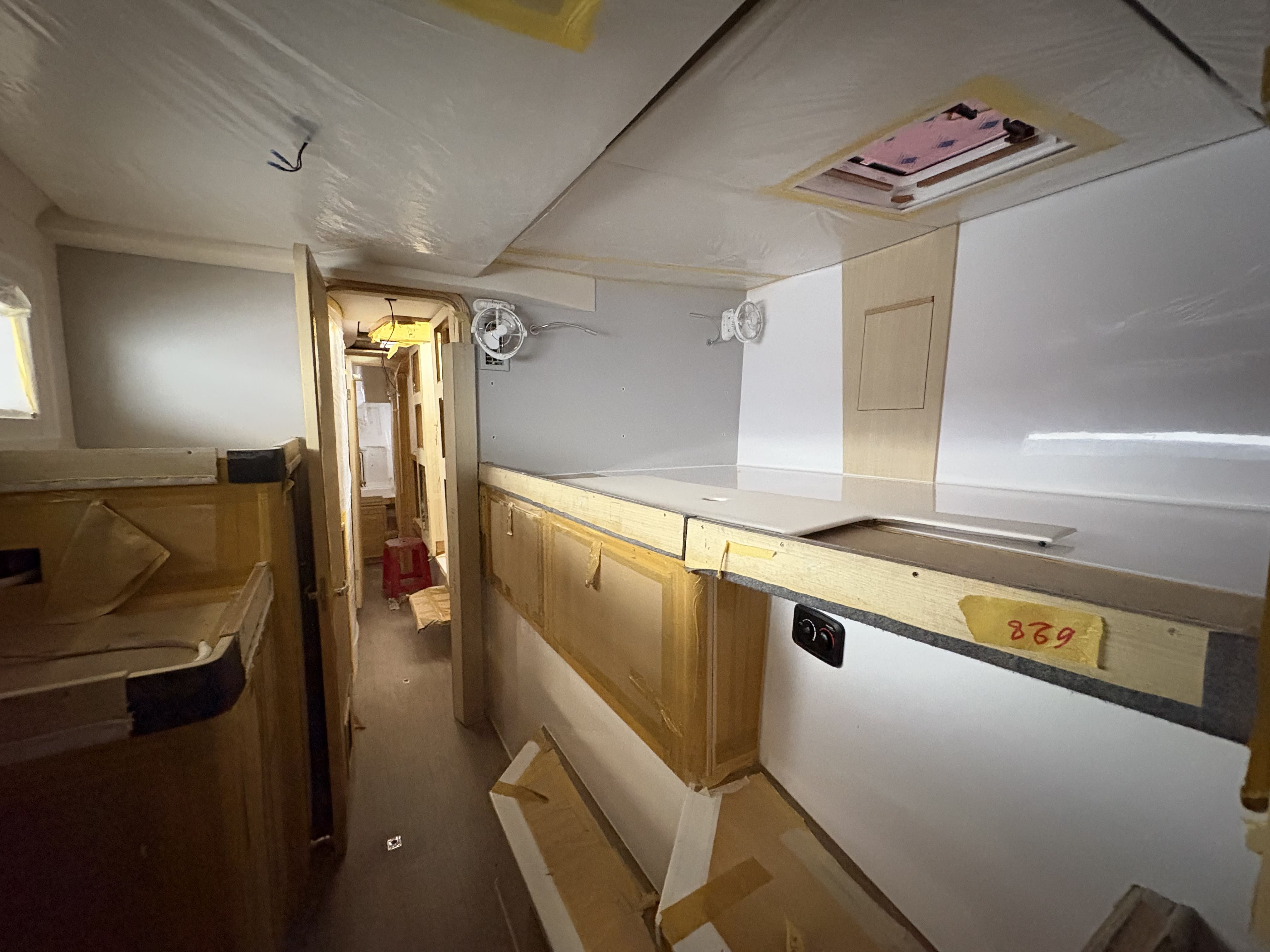

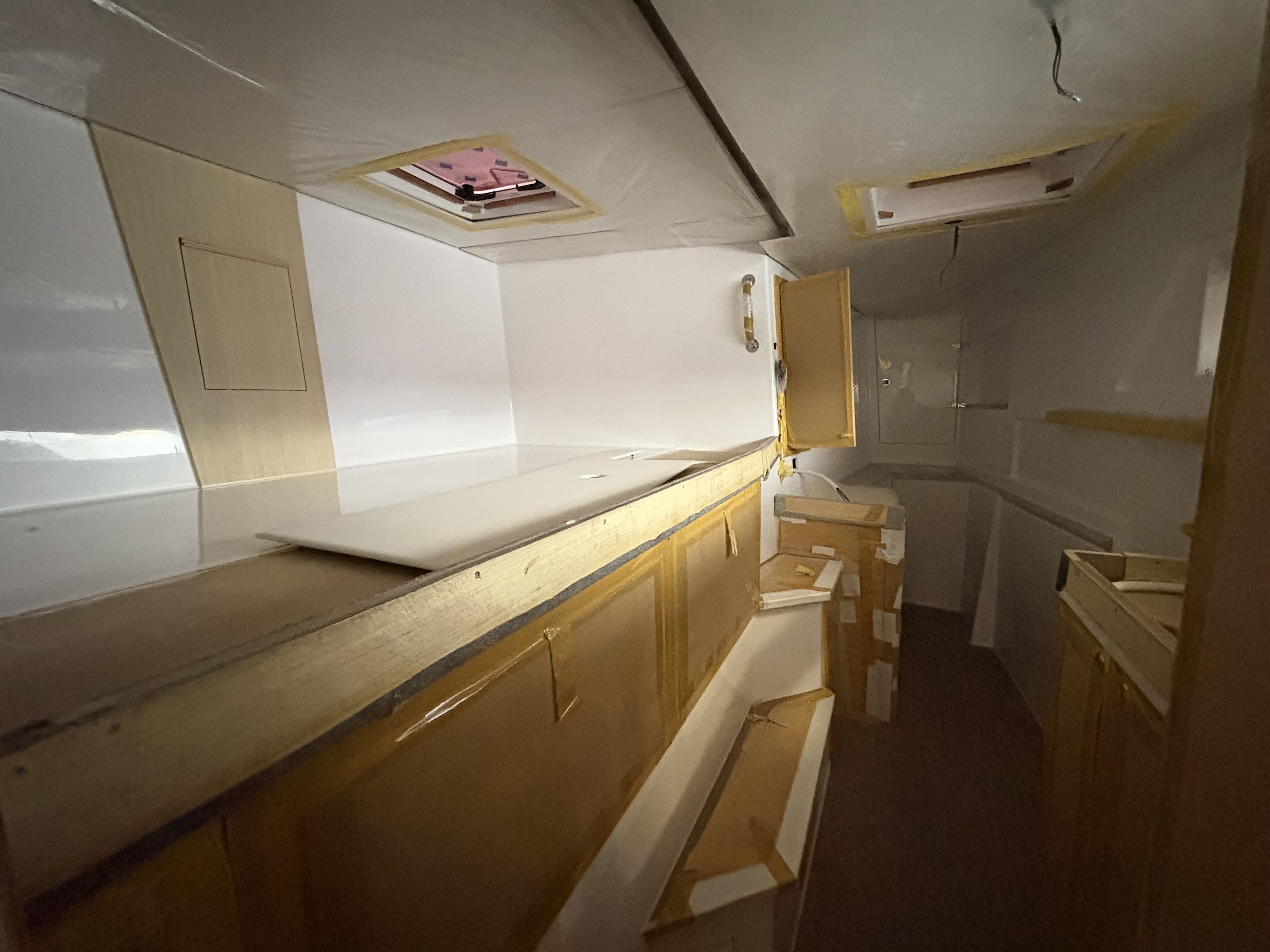

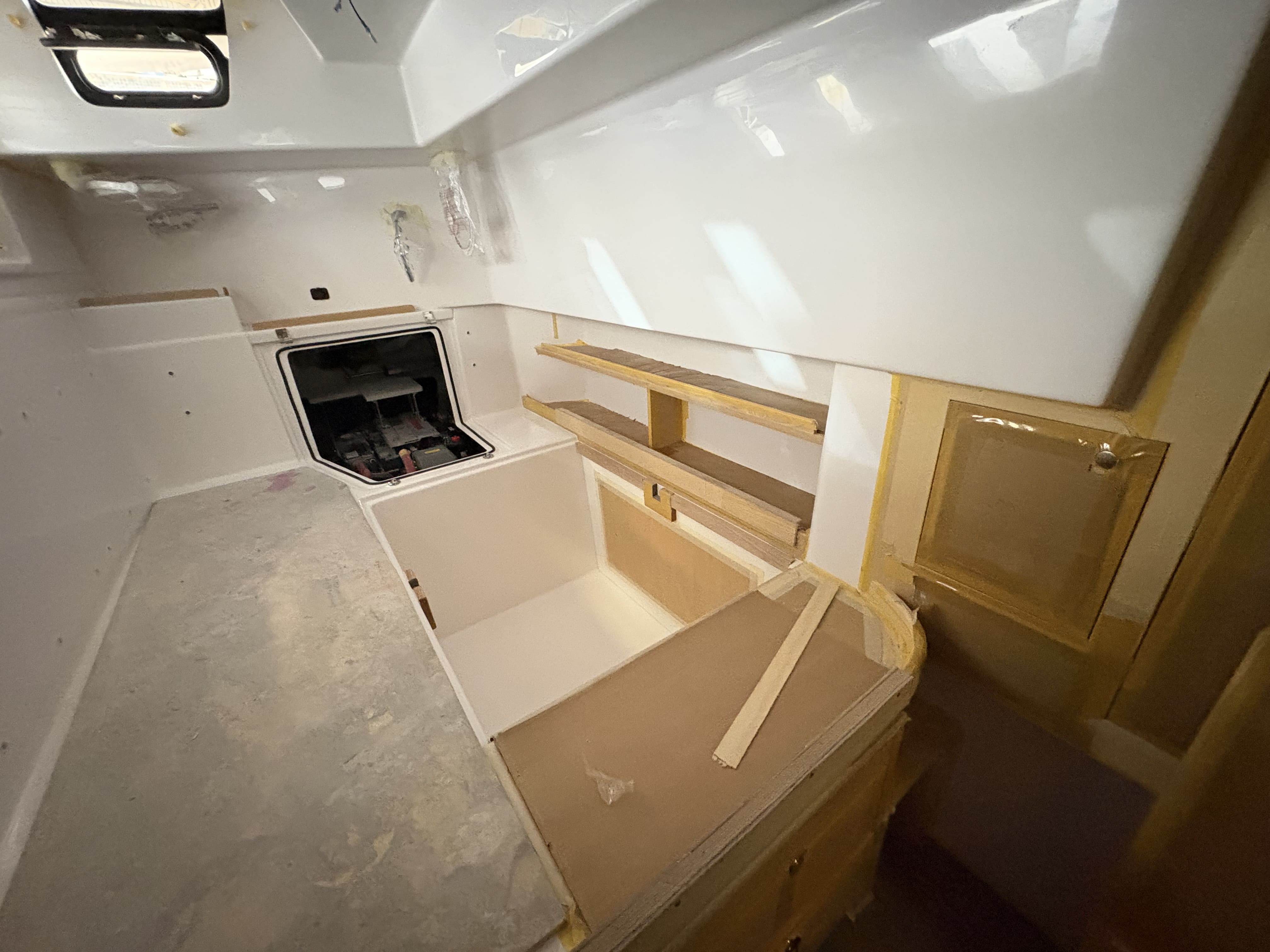

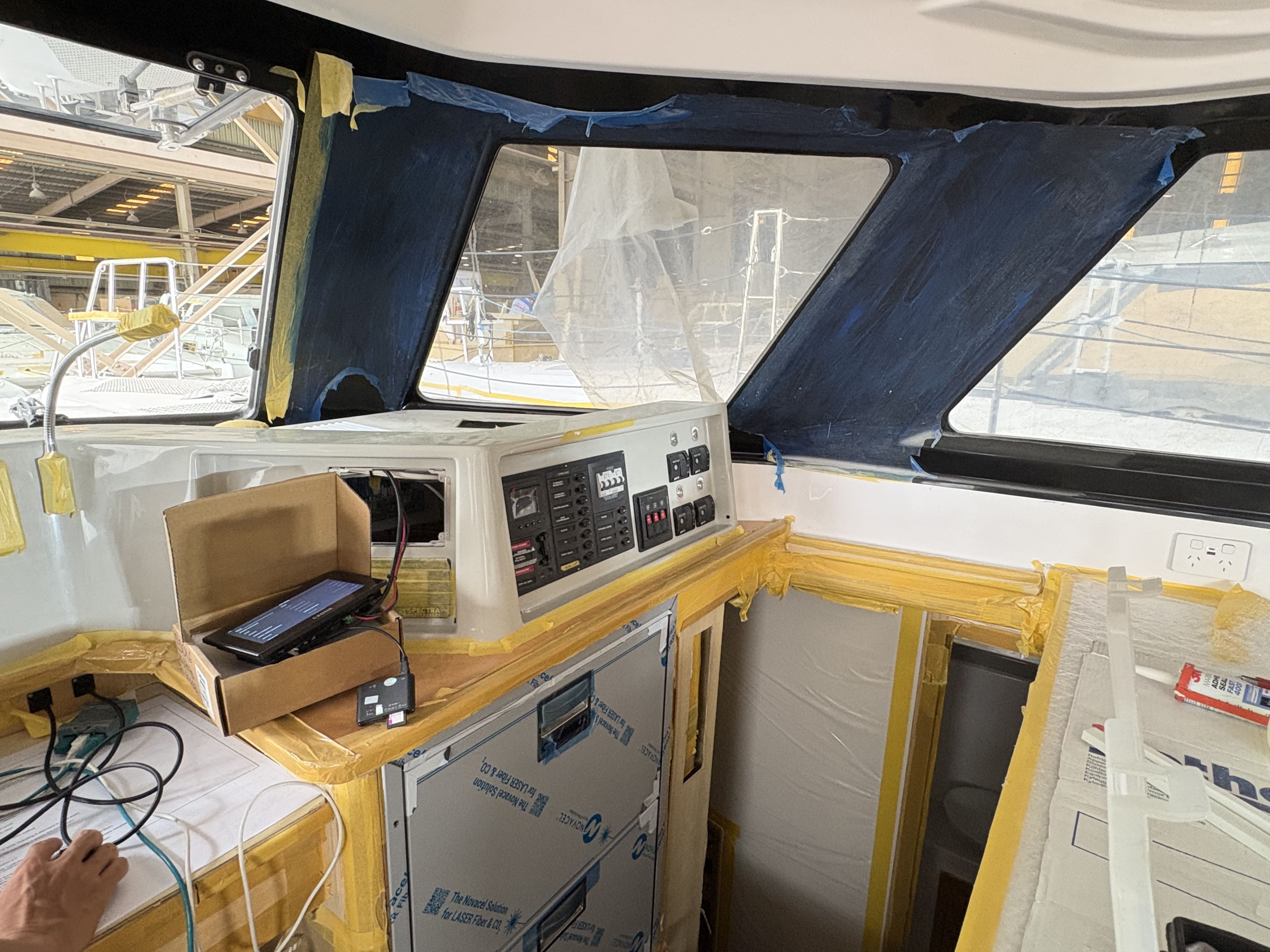

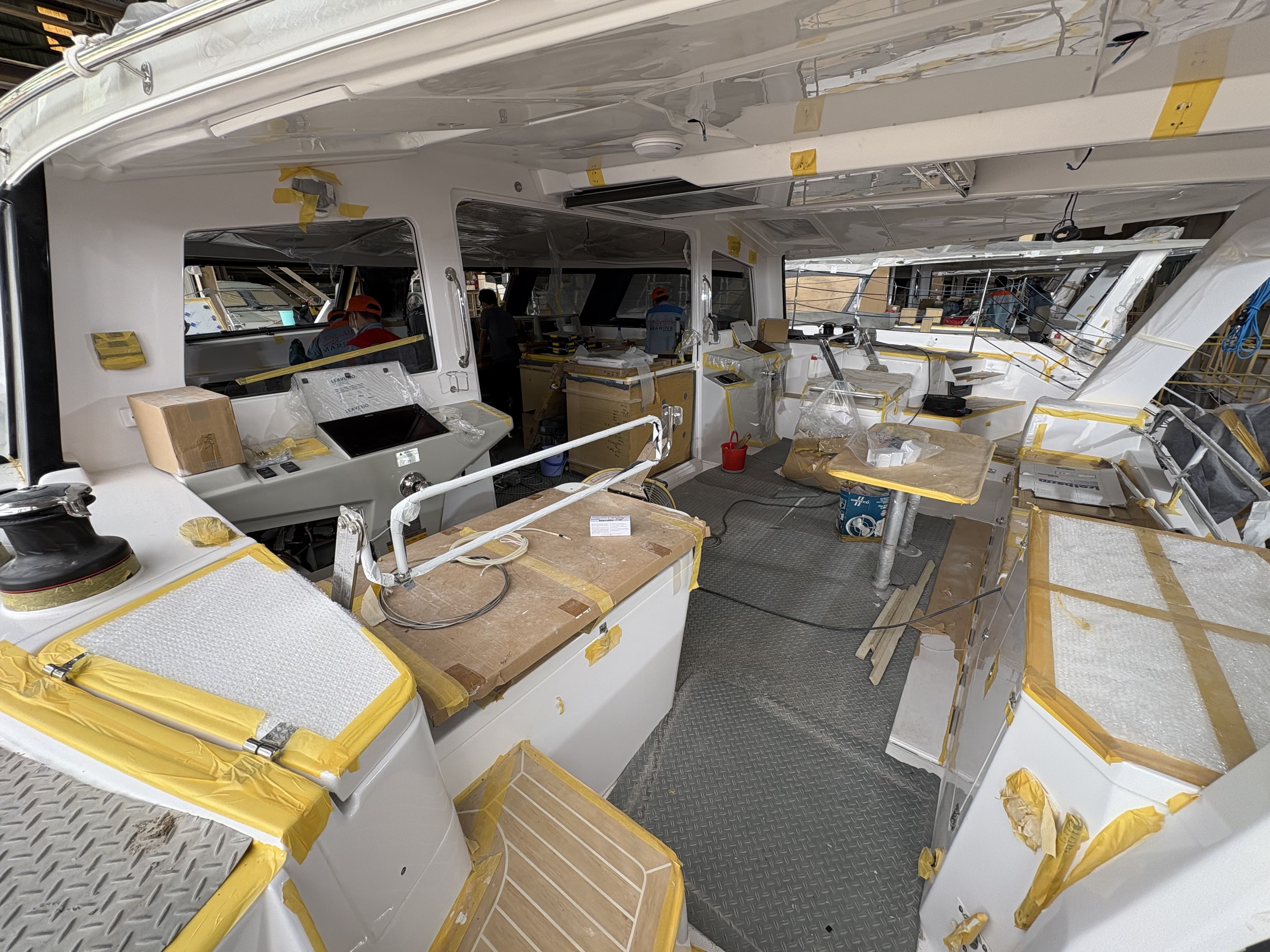

Our Production team currently working on antifouling (25%), stanchion & lifelines (90%), steering (85%), electric & instrument devices (90%), galley and countertop, plumbing and timber fitout (85%).

Production Update – Fit out

It is exciting that your boat has been progressing well in the Fit out stage.

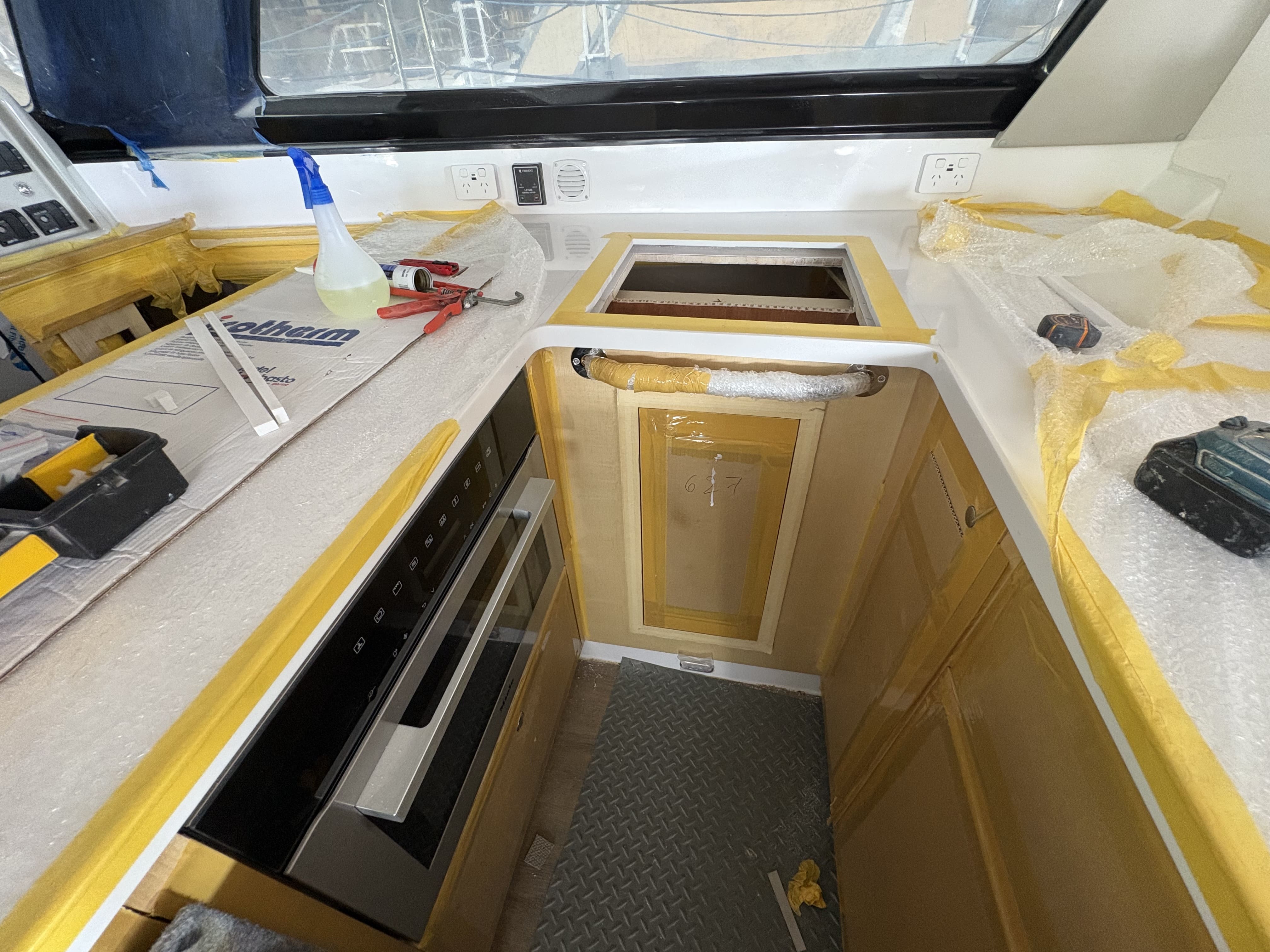

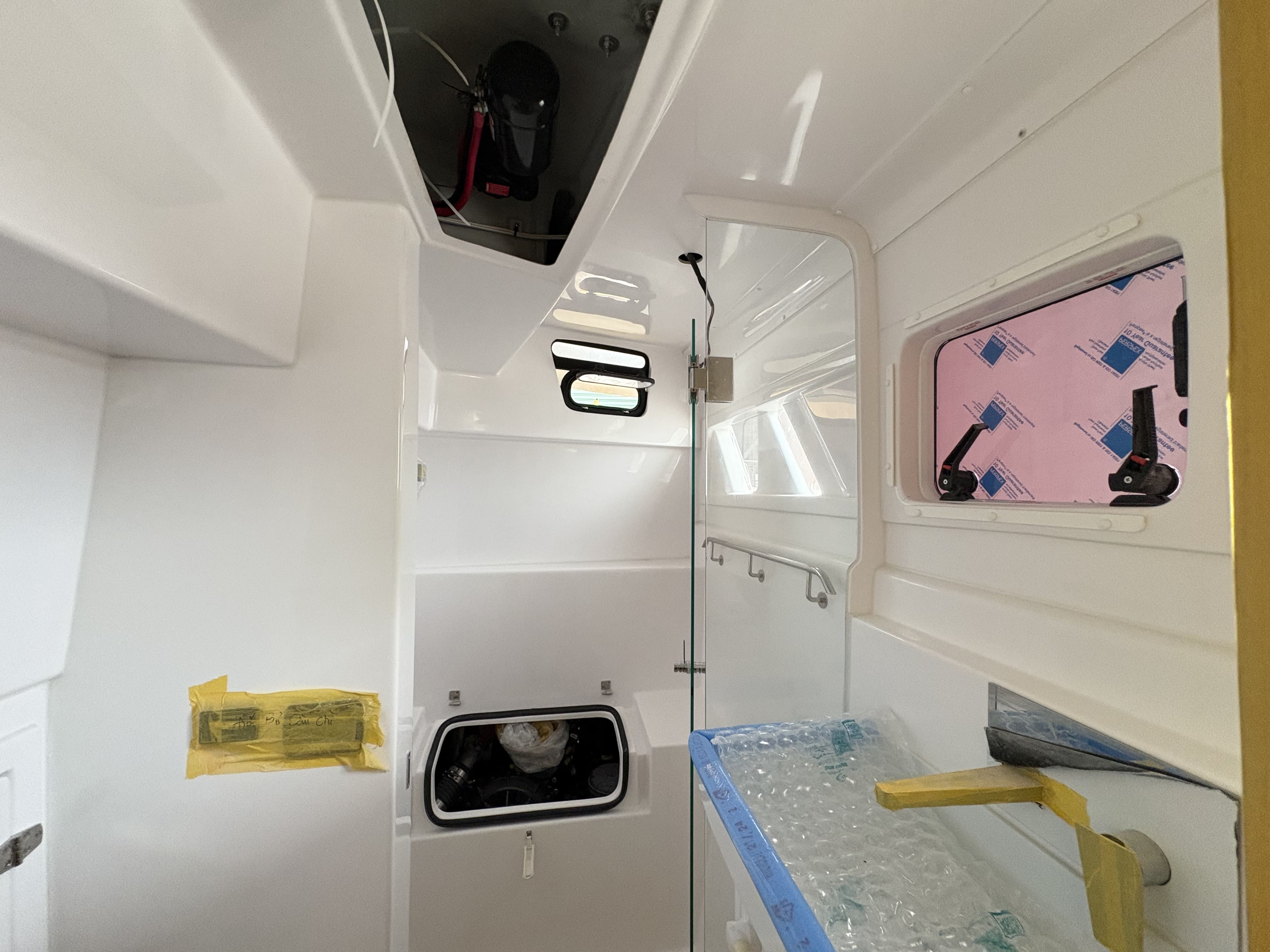

We recently completed the engine installation, forward beam and trampoline.
Our Production team is currently working on composite deck hatches, aircon installation, plumbing (30% done), electric work (40%), continuing engine room fitout.
